Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Springs

Adyar

Enquire Now

Amenities

Generator Backup Generator Backup
CCTV CCTV
Lobby Lobby
Rain Water Harvesting Rain Water Harvesting

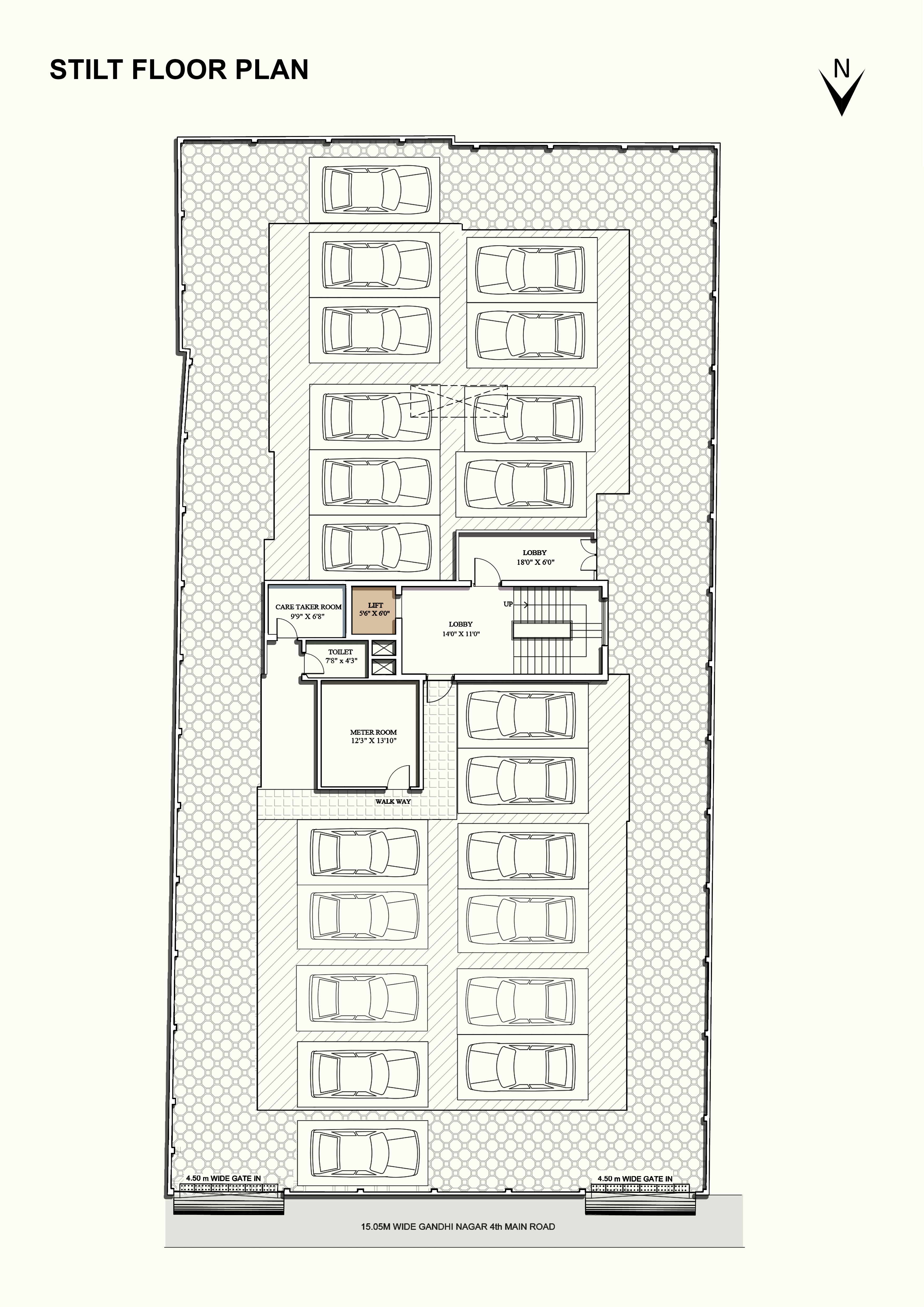

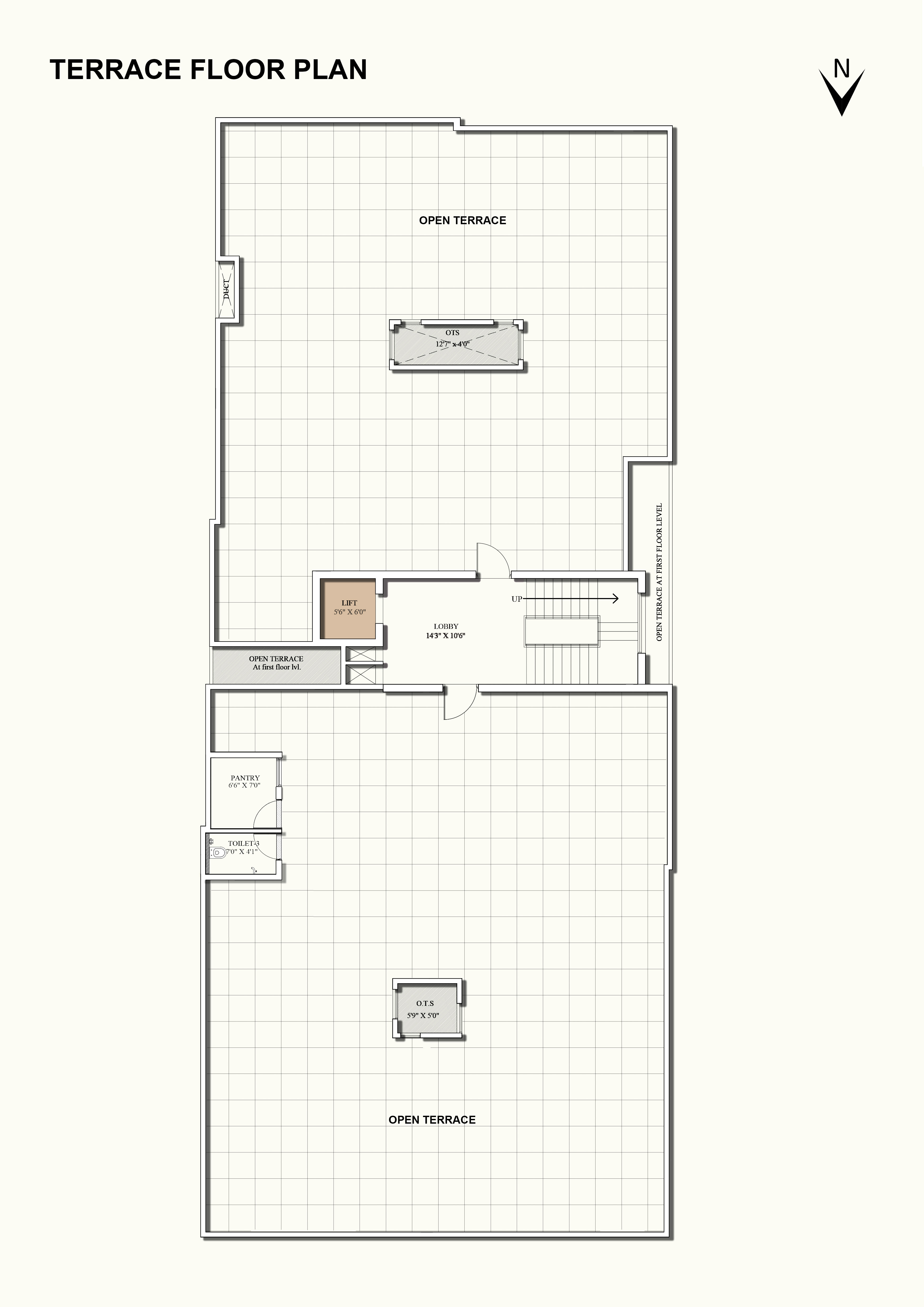

Master Layout Plan

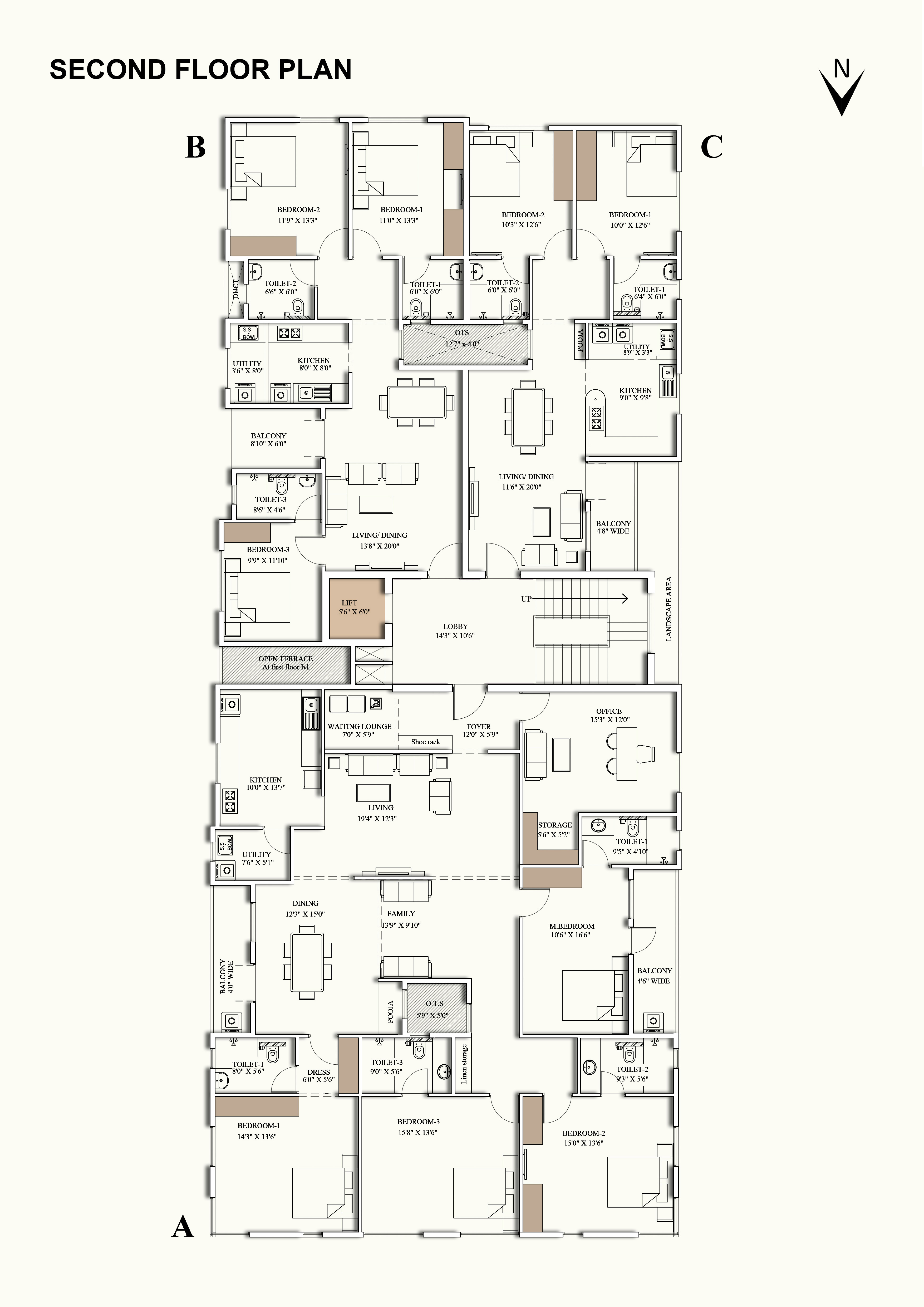

Springs - Floor Plan

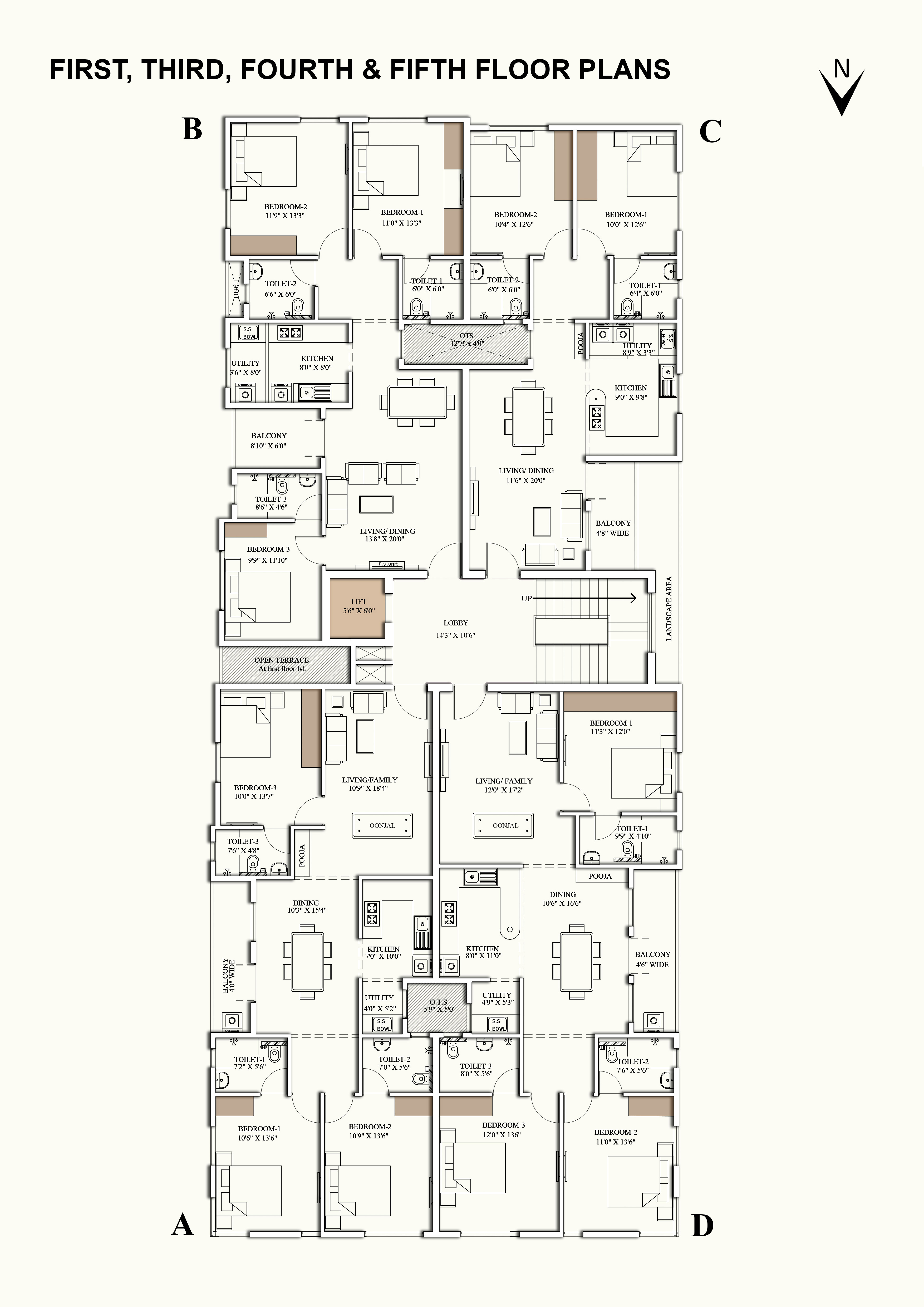

Springs - Floor Plan
Springs - Floor Plan
Springs - Floor Plan

Approvals

Planning Permit No:

OL-PP/NHRB/0177/2025, Permit No. OL-01802

Date of Permit:

2025-05-16

Building Permission No:

: CEBA / WDCN13 / 00215 / 2025

Date of Permit:

2025-05-26

TNRERA:

TN / 29 / Building / 0236 / 2025

Dated:

2025-07-04

Project Update Images

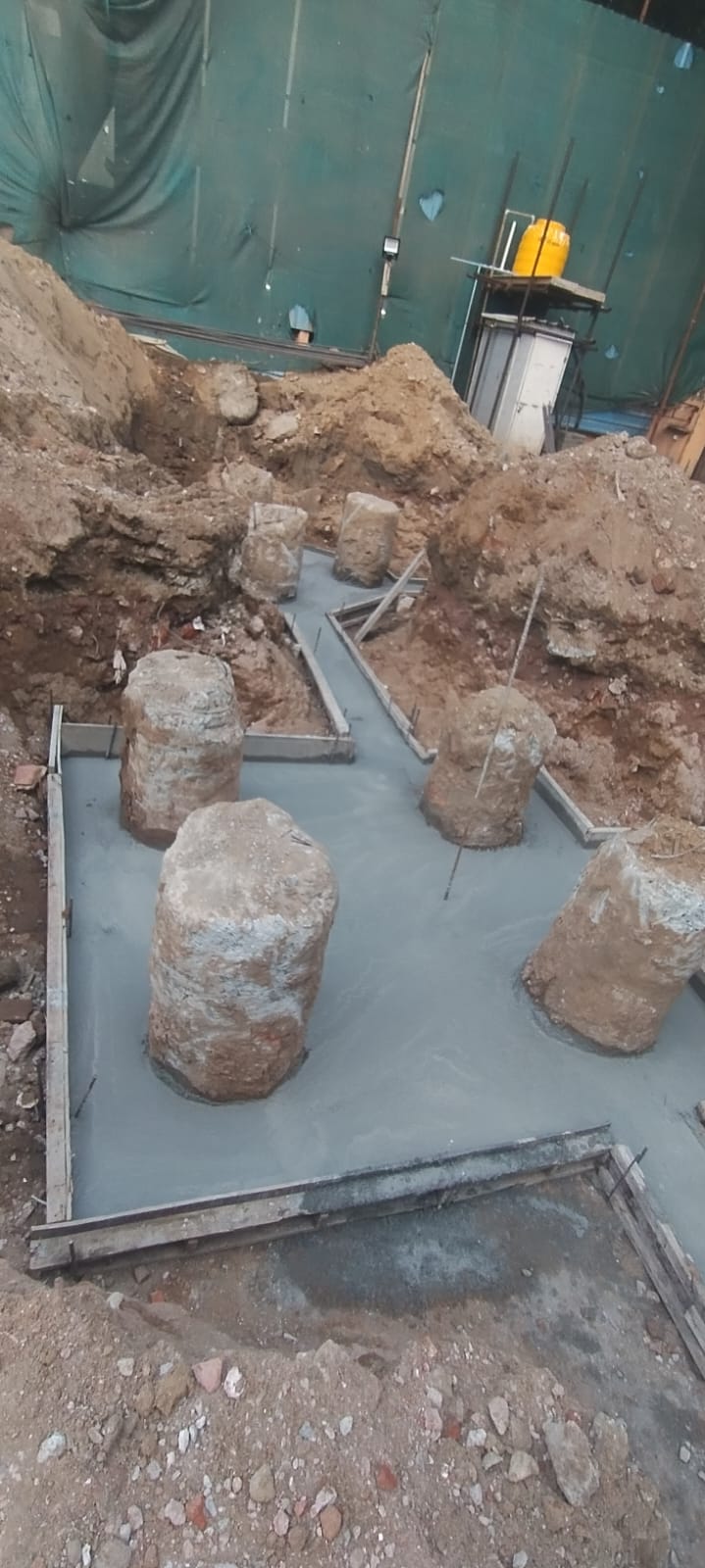

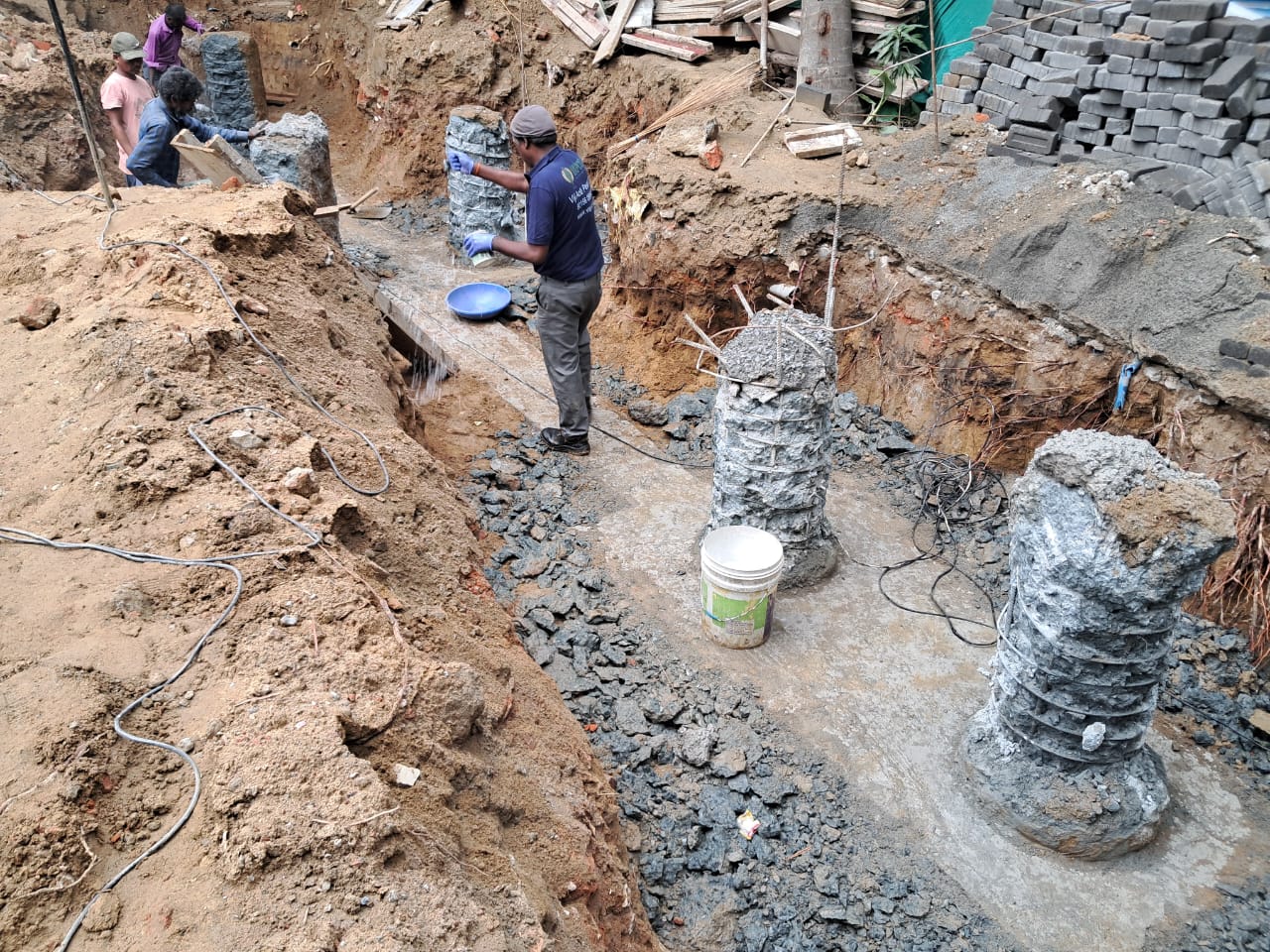

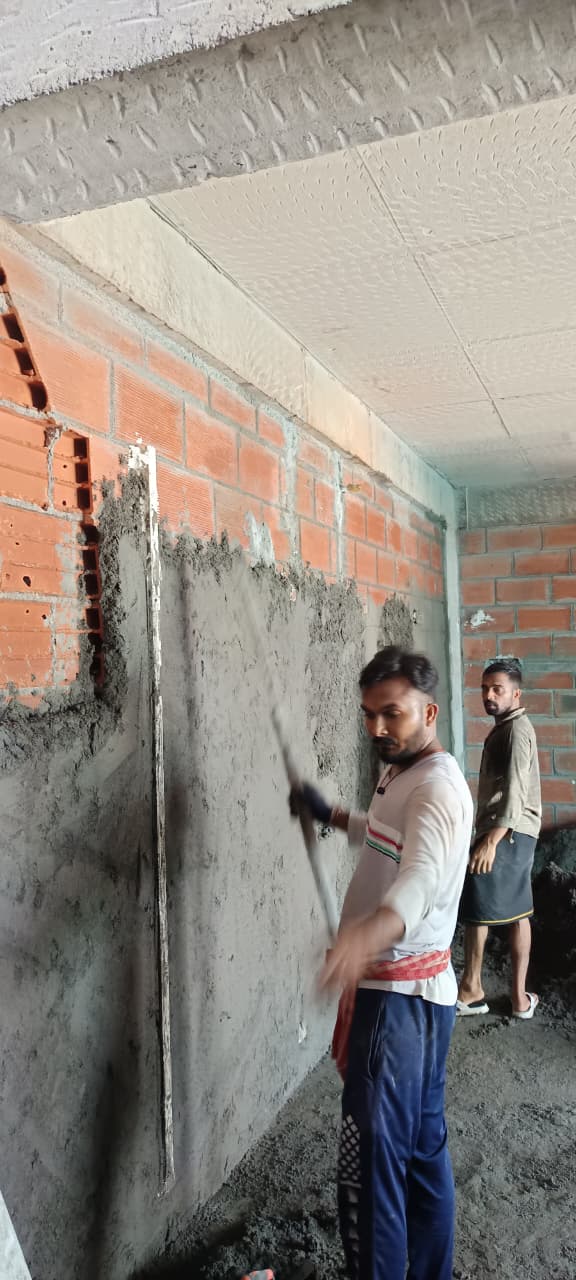

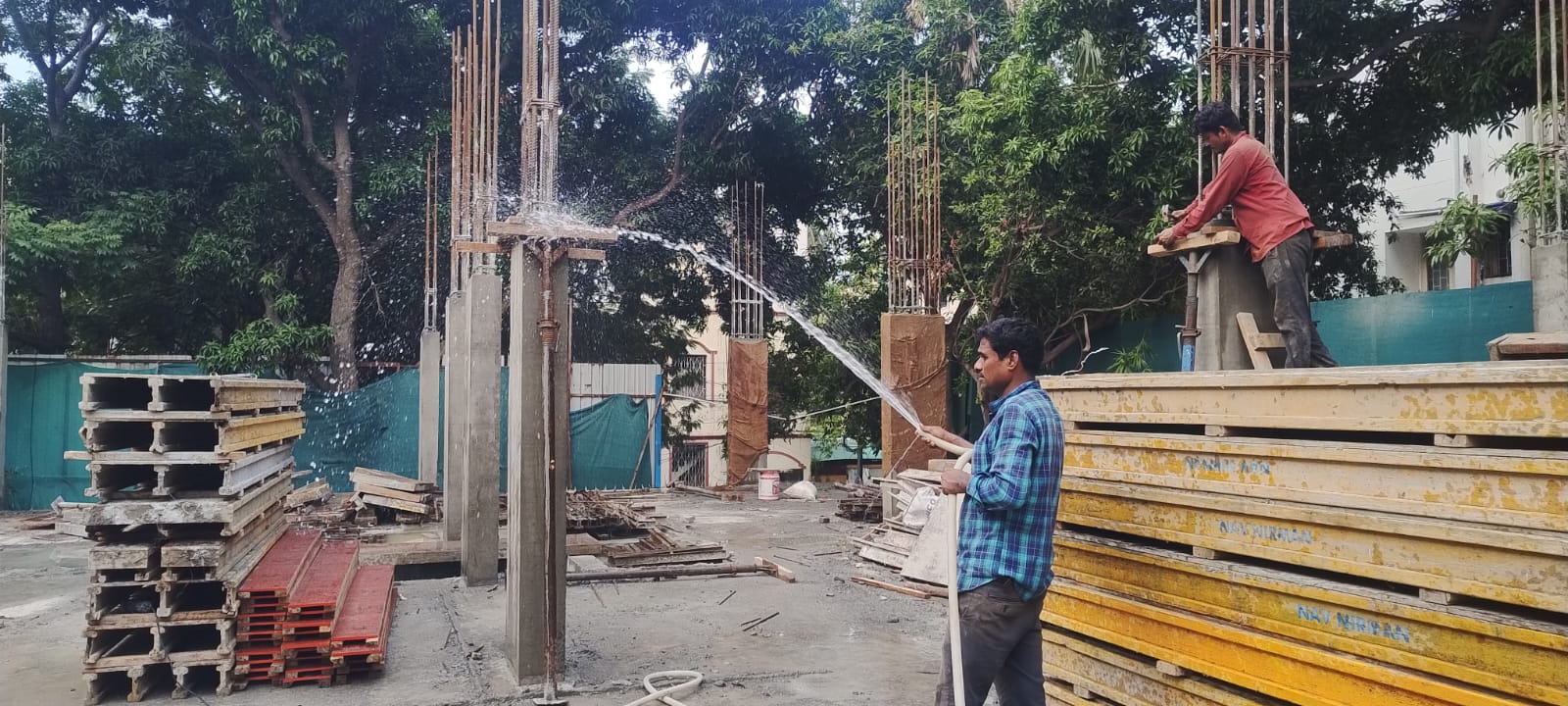

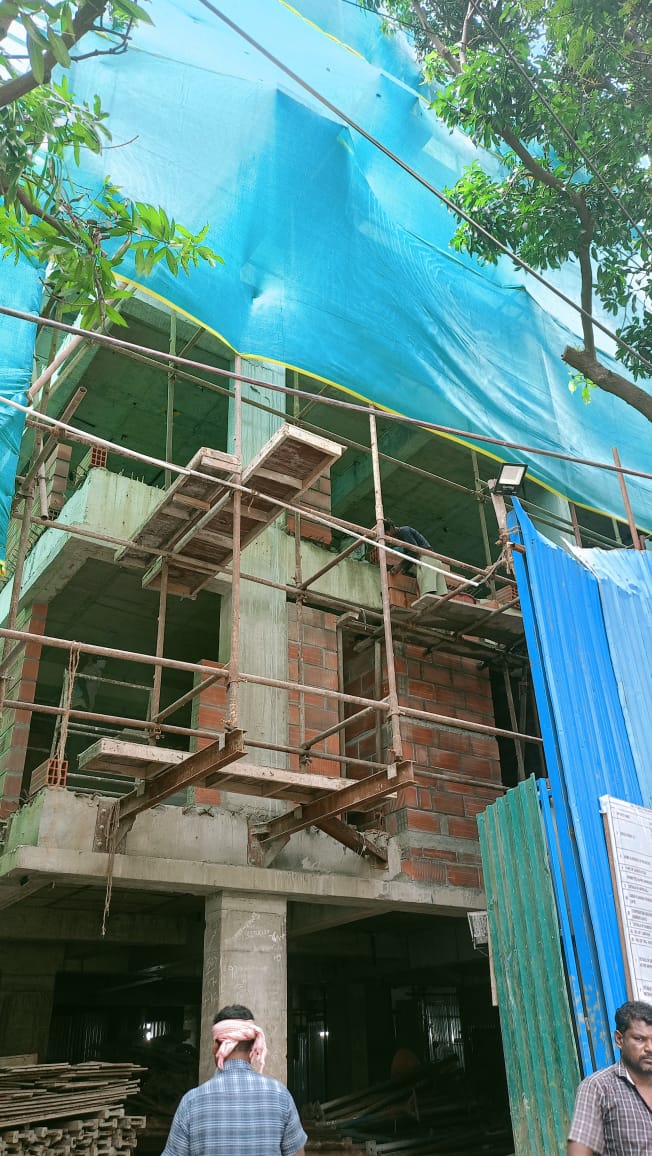

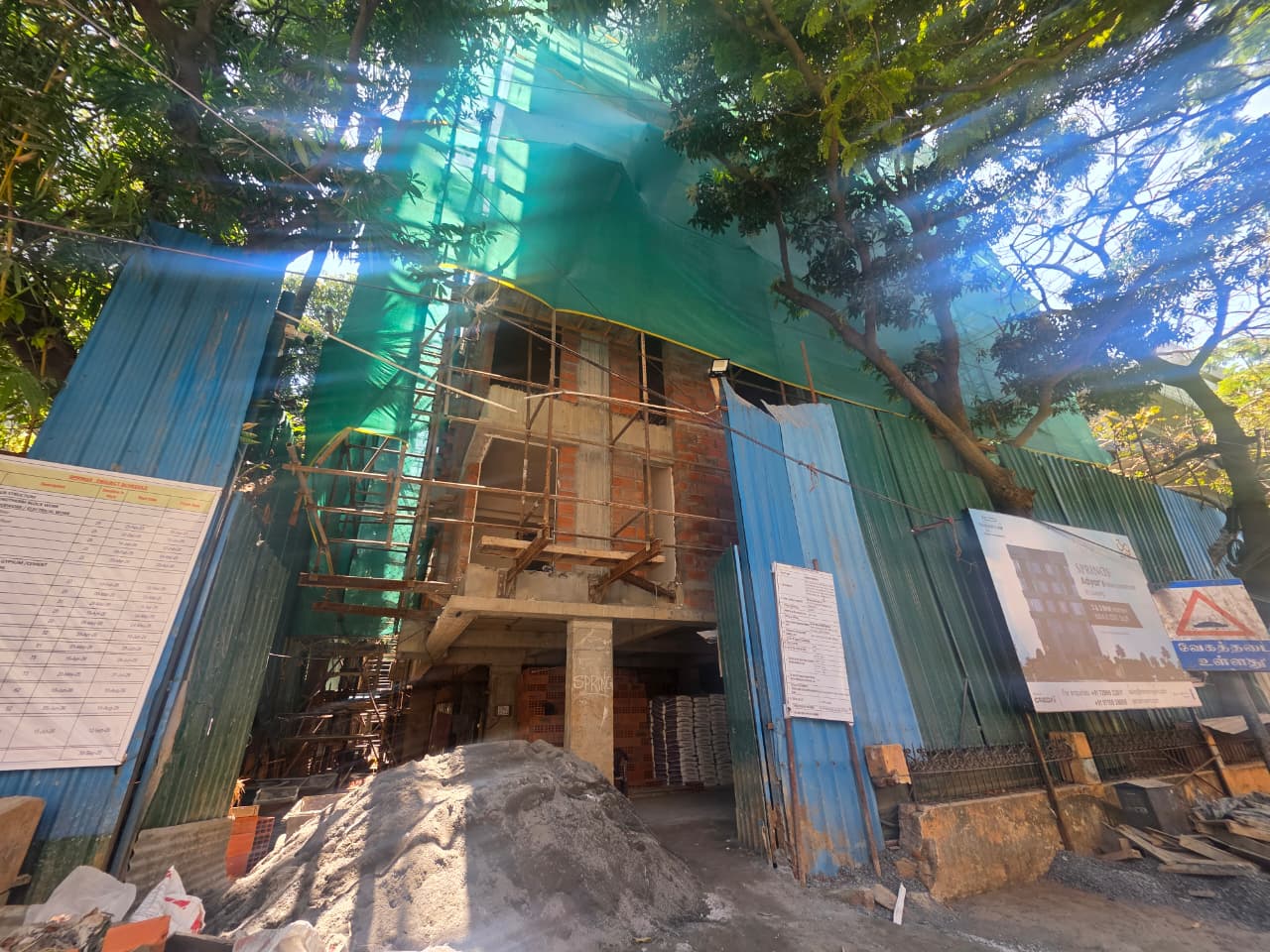

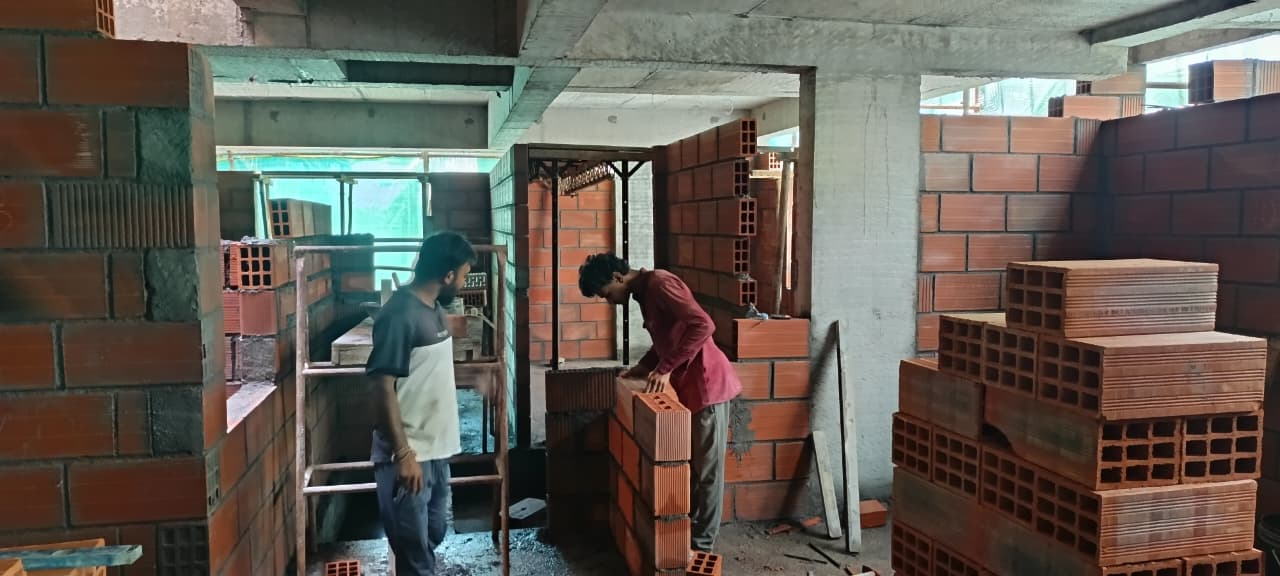

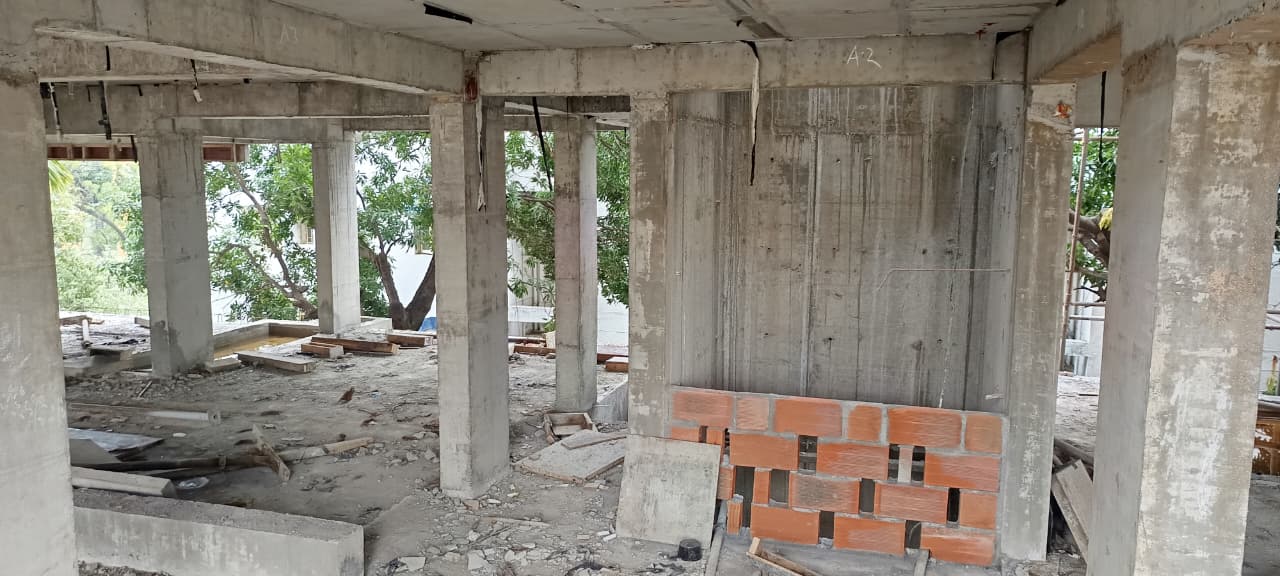

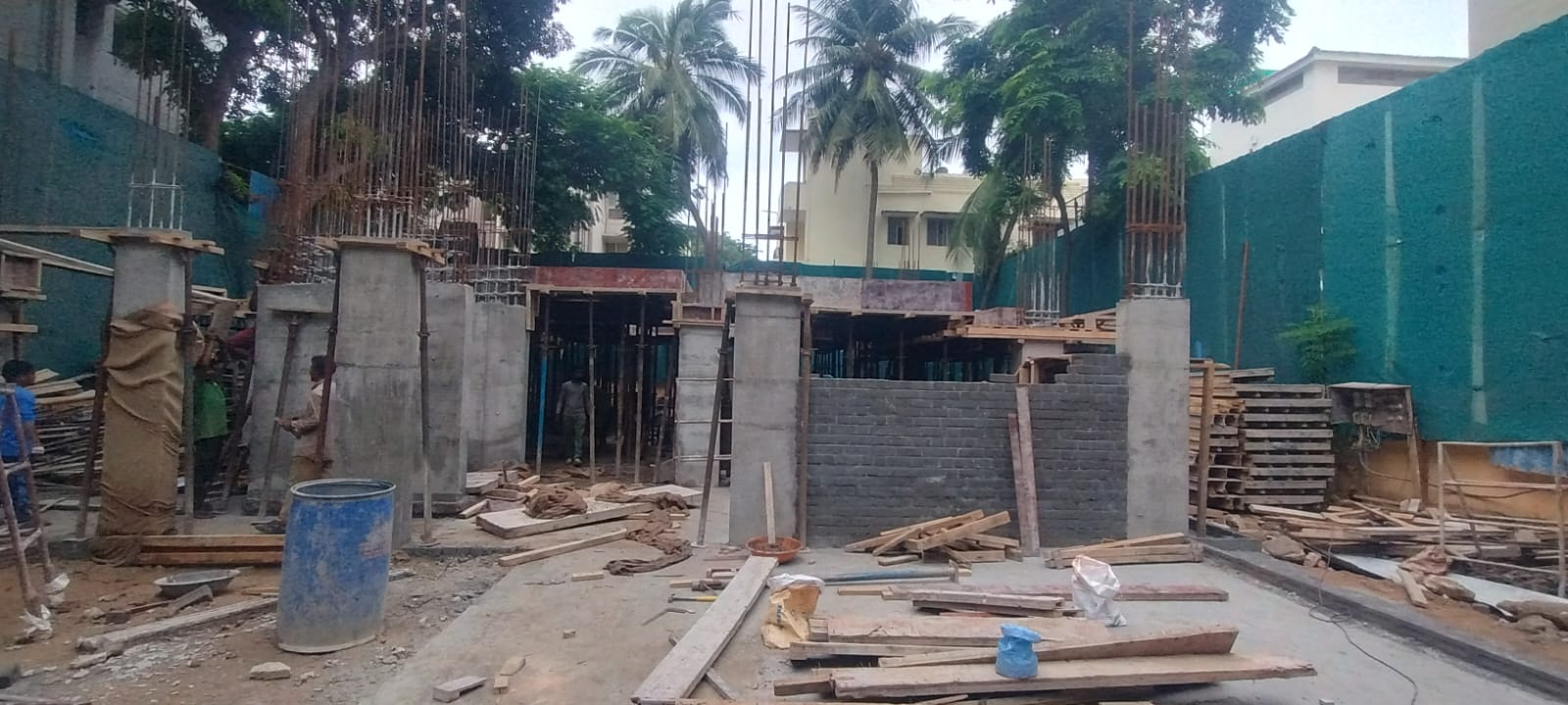

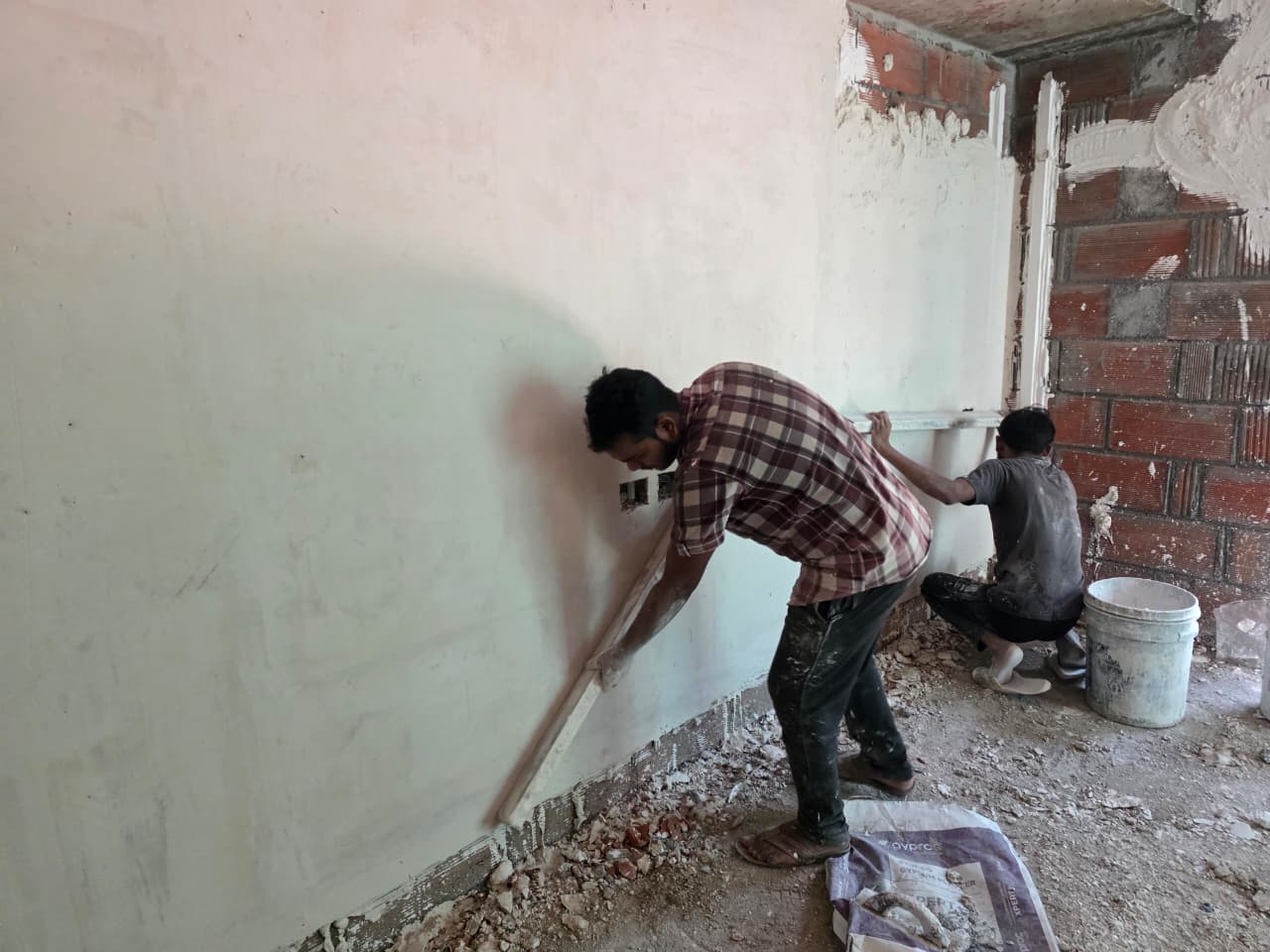

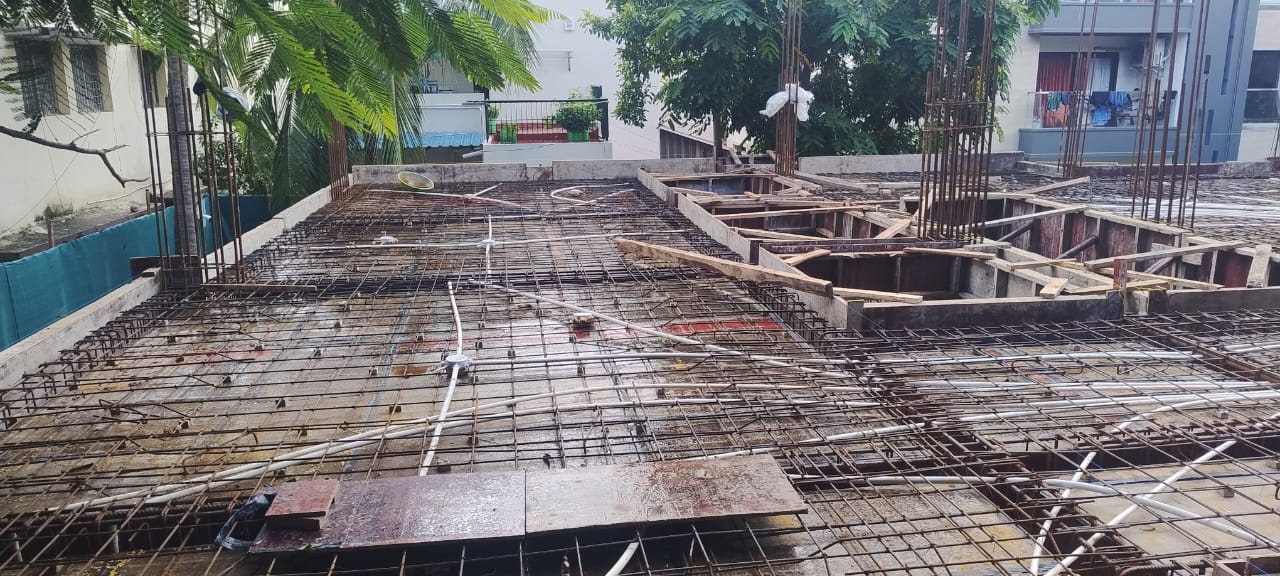

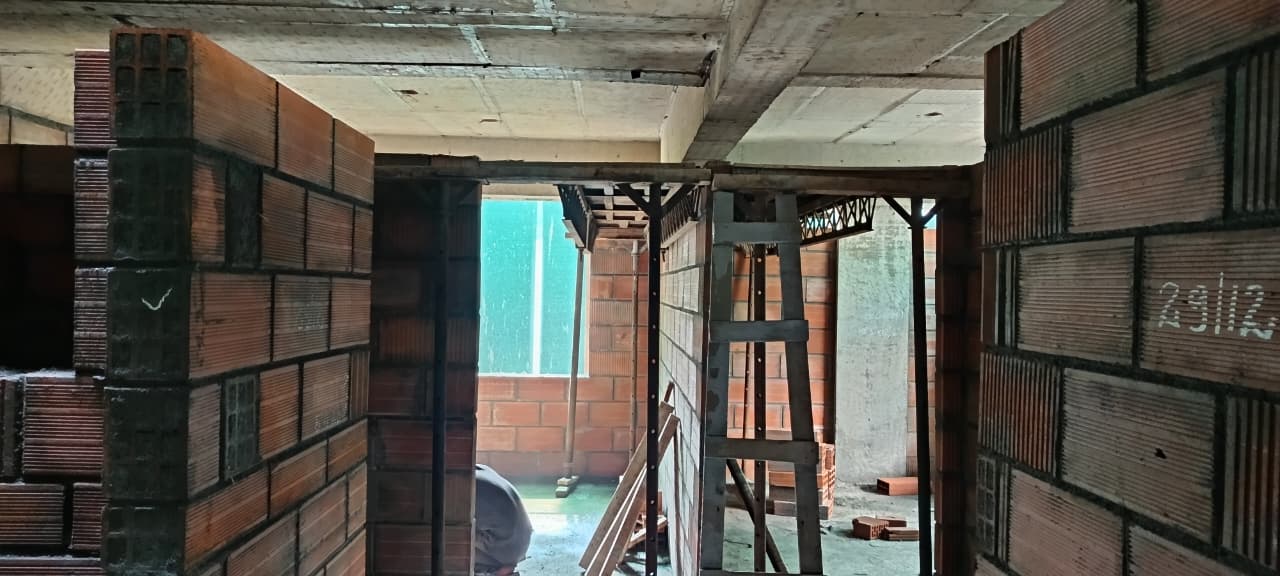

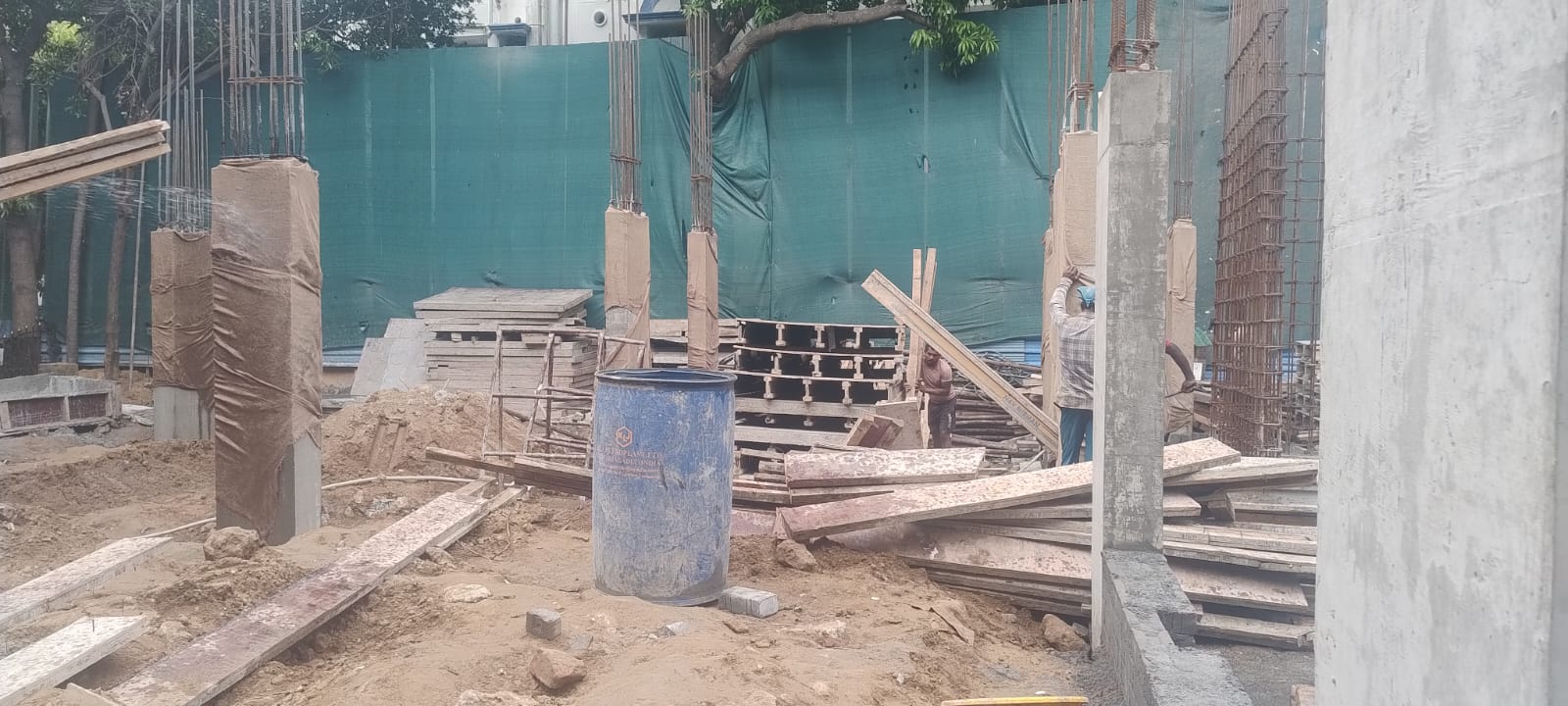

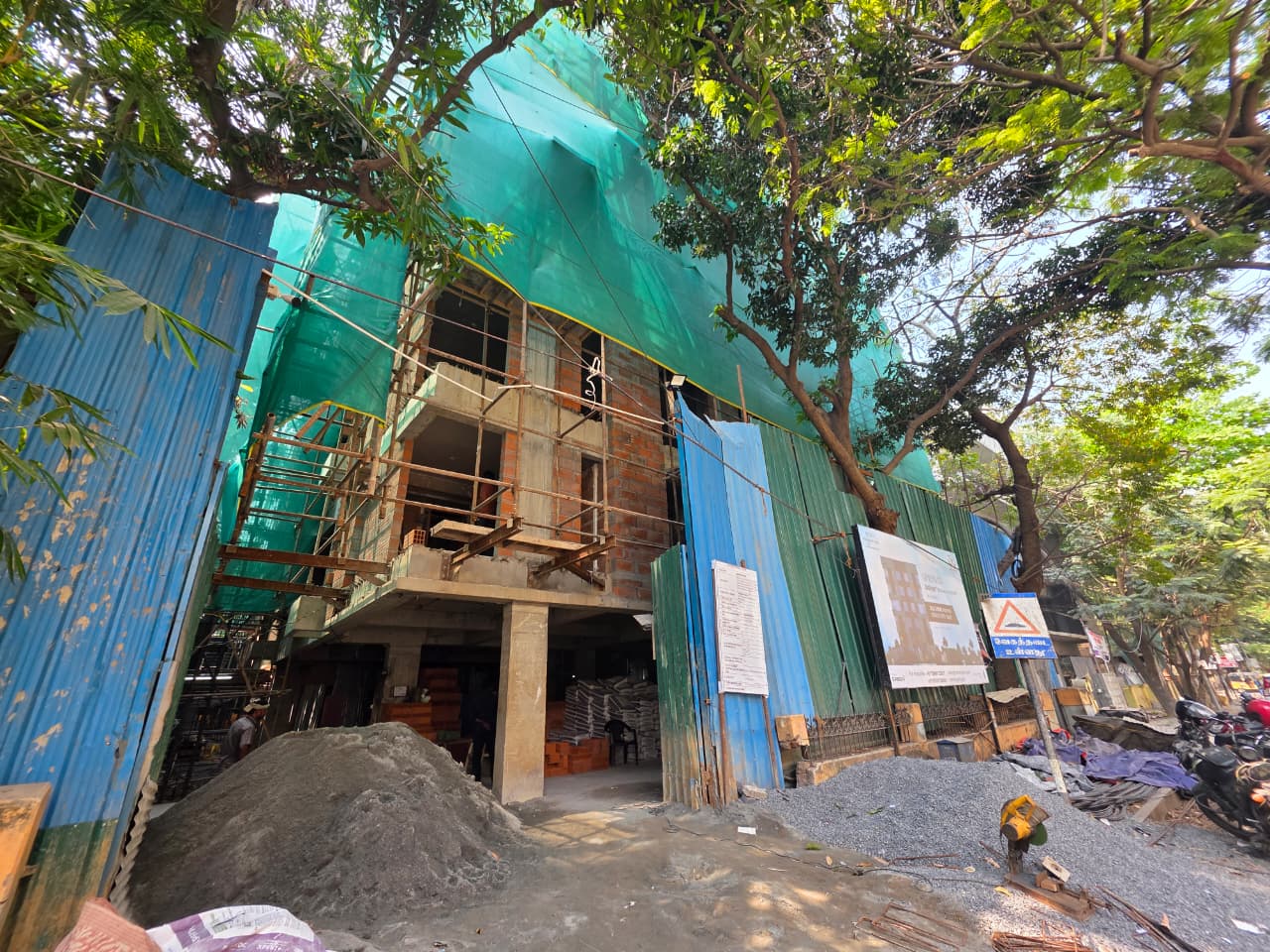

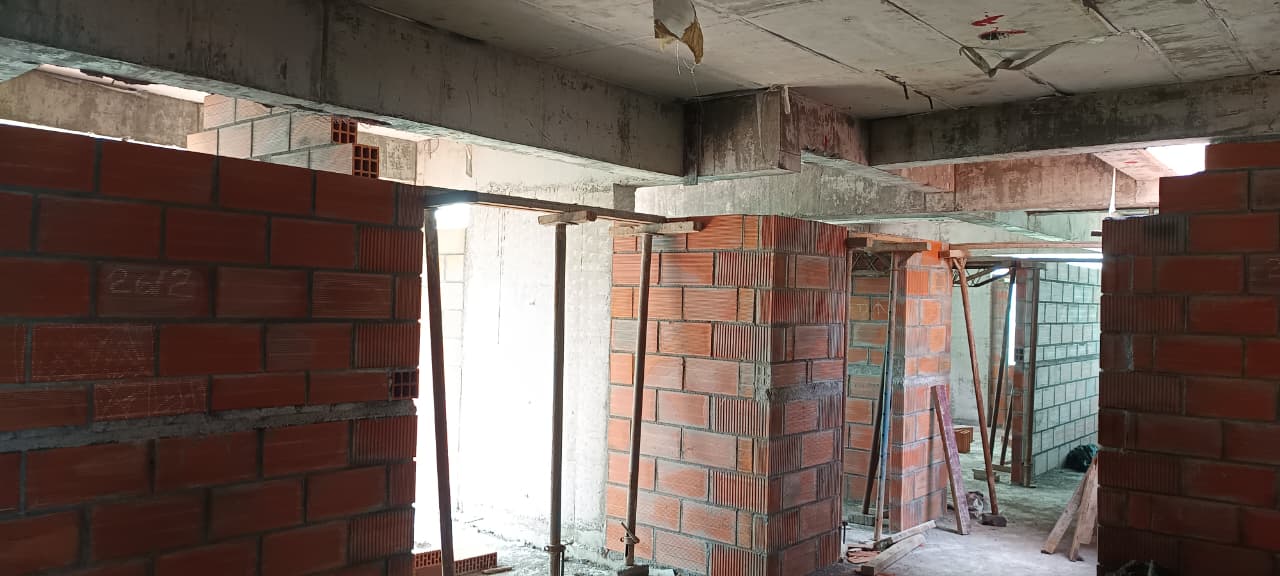

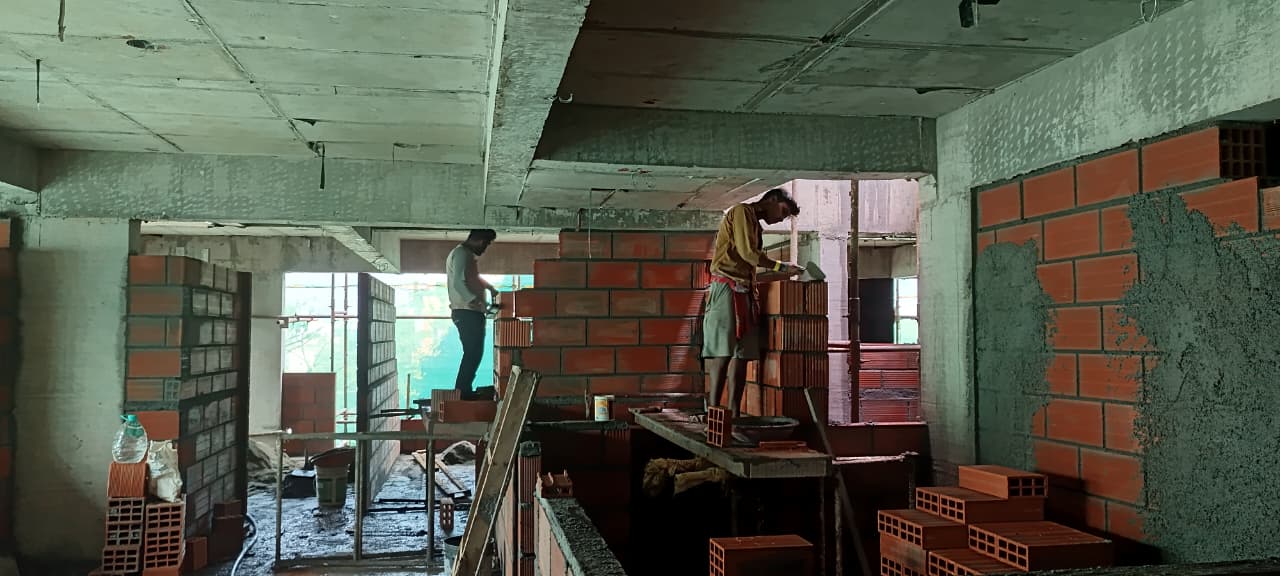

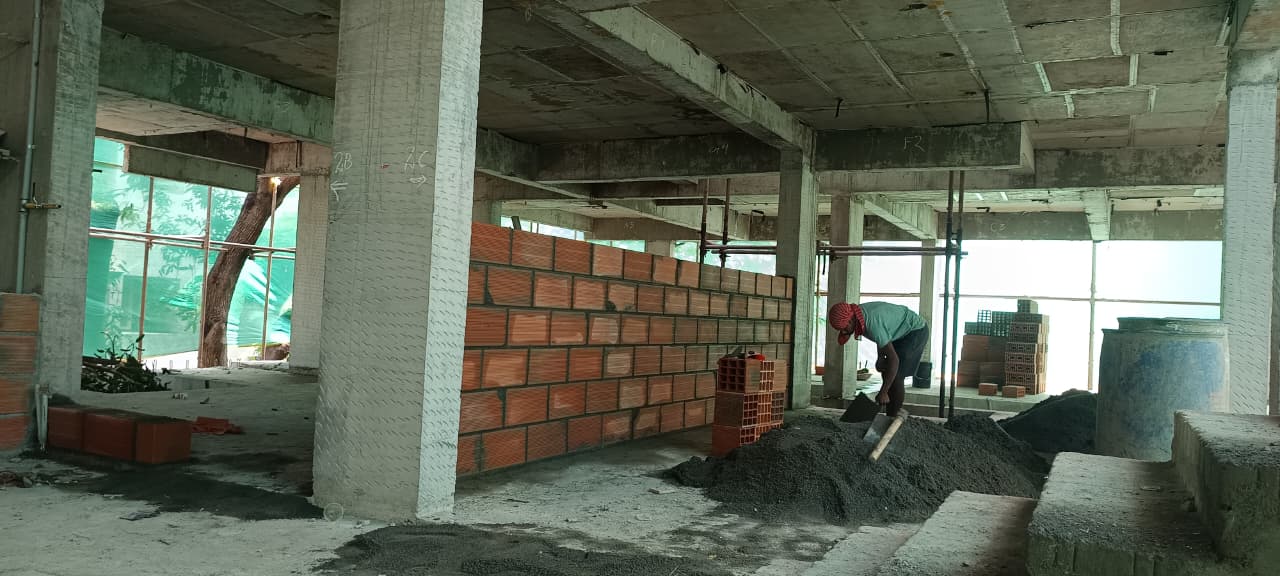

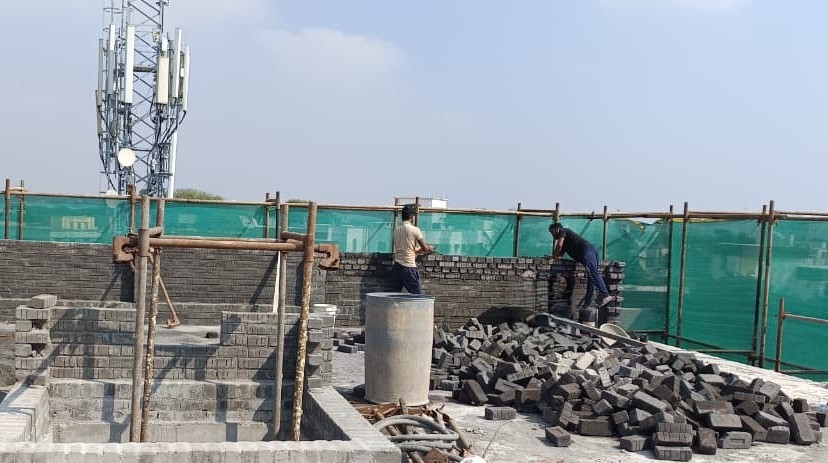

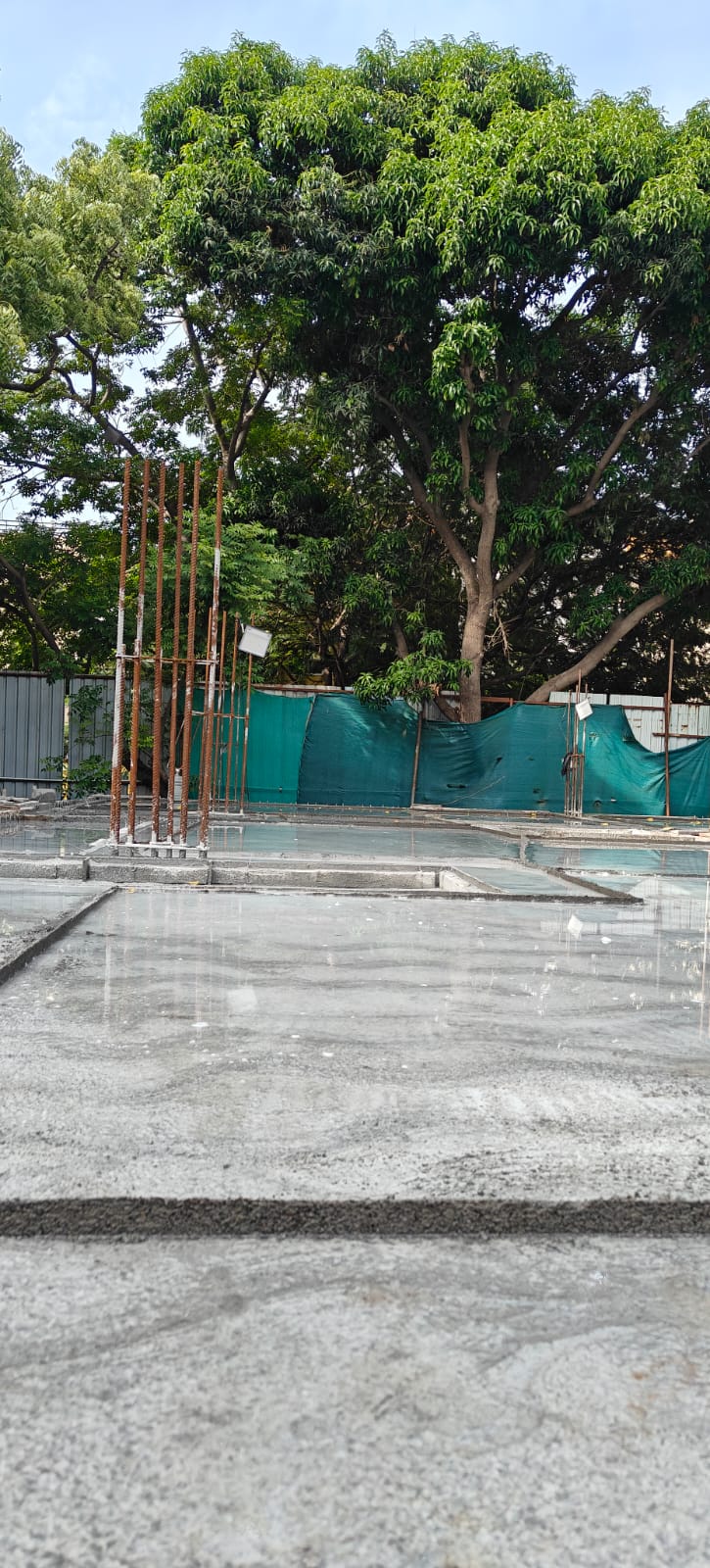

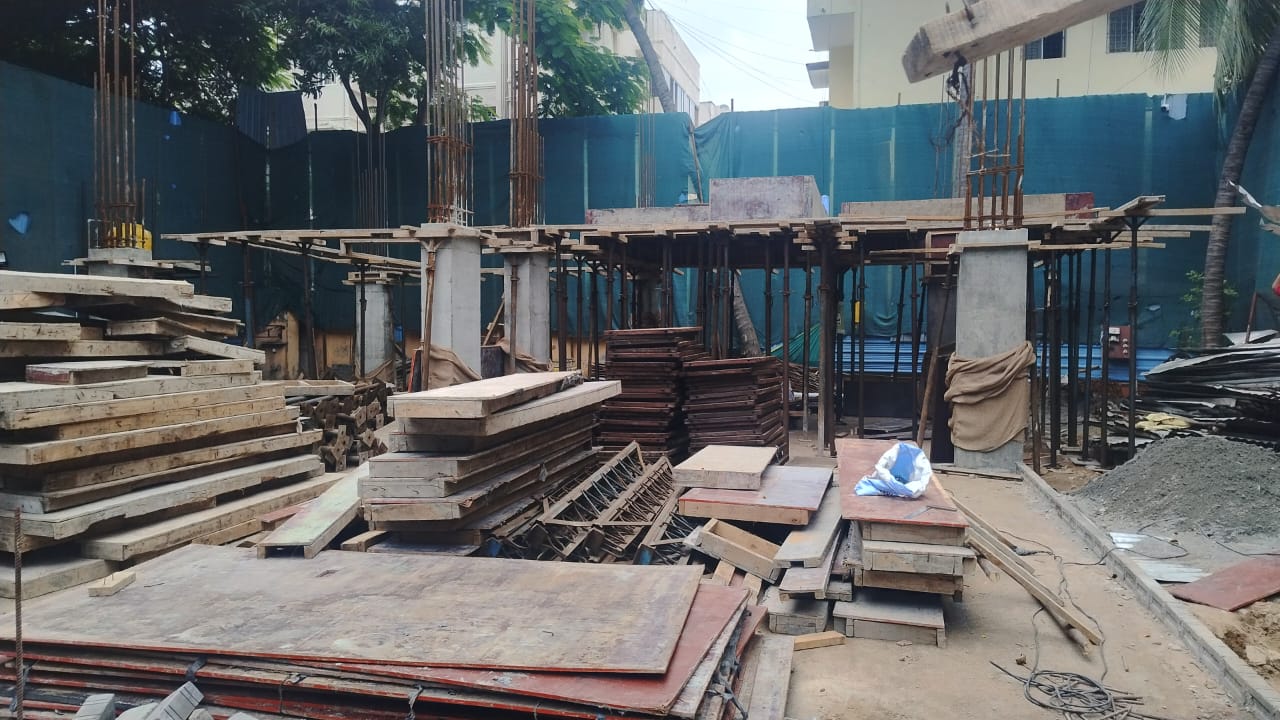

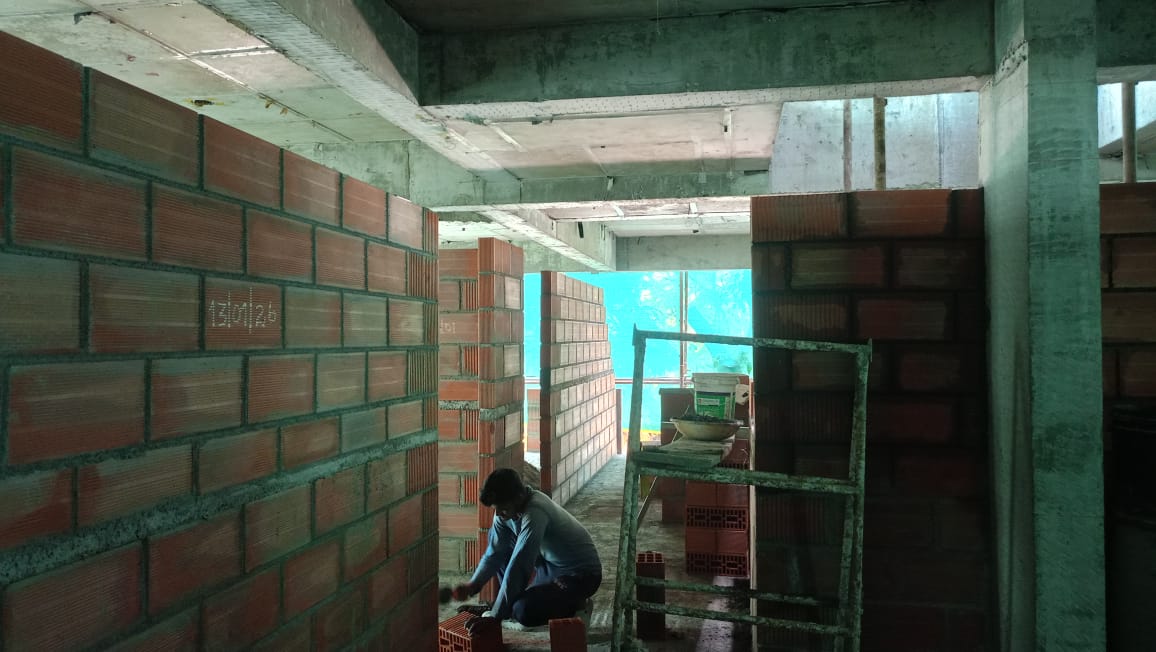

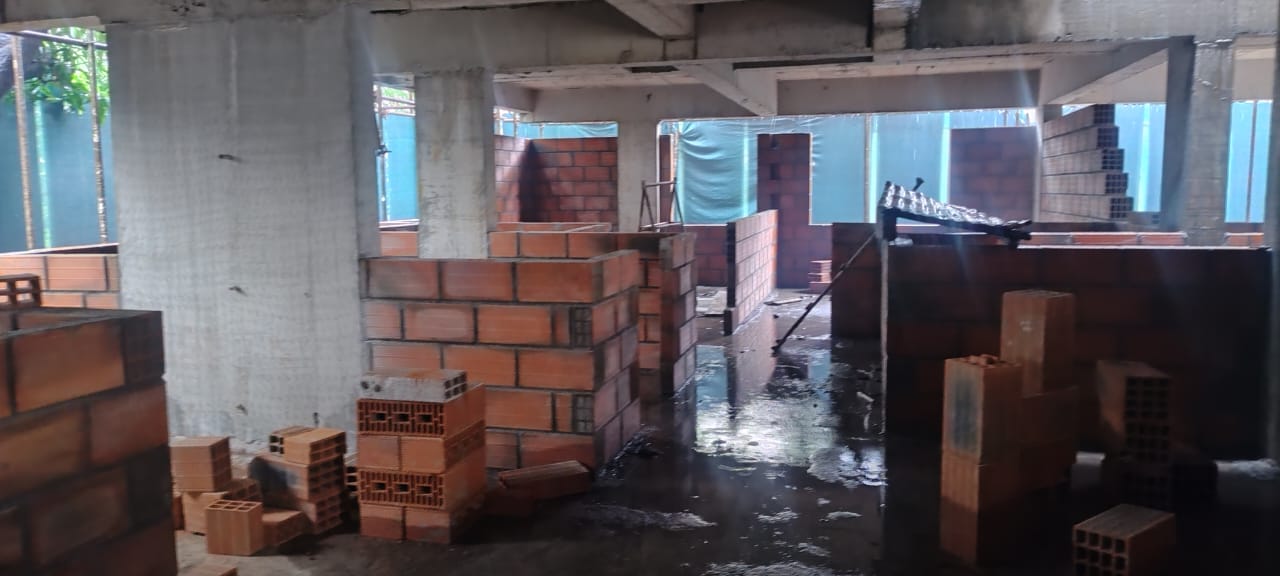

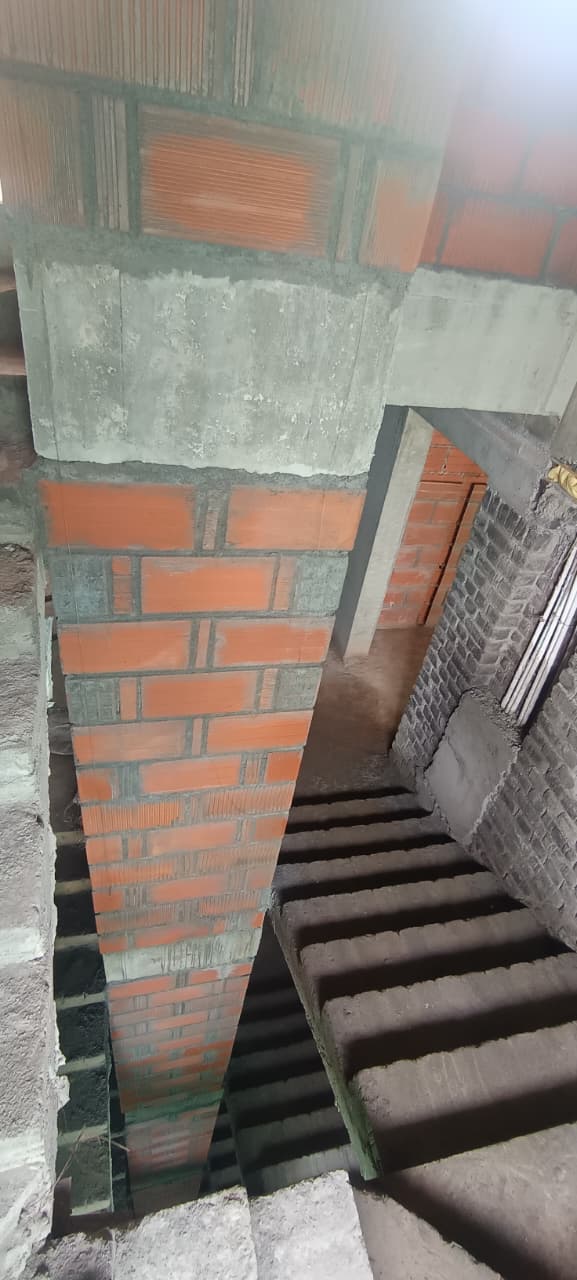

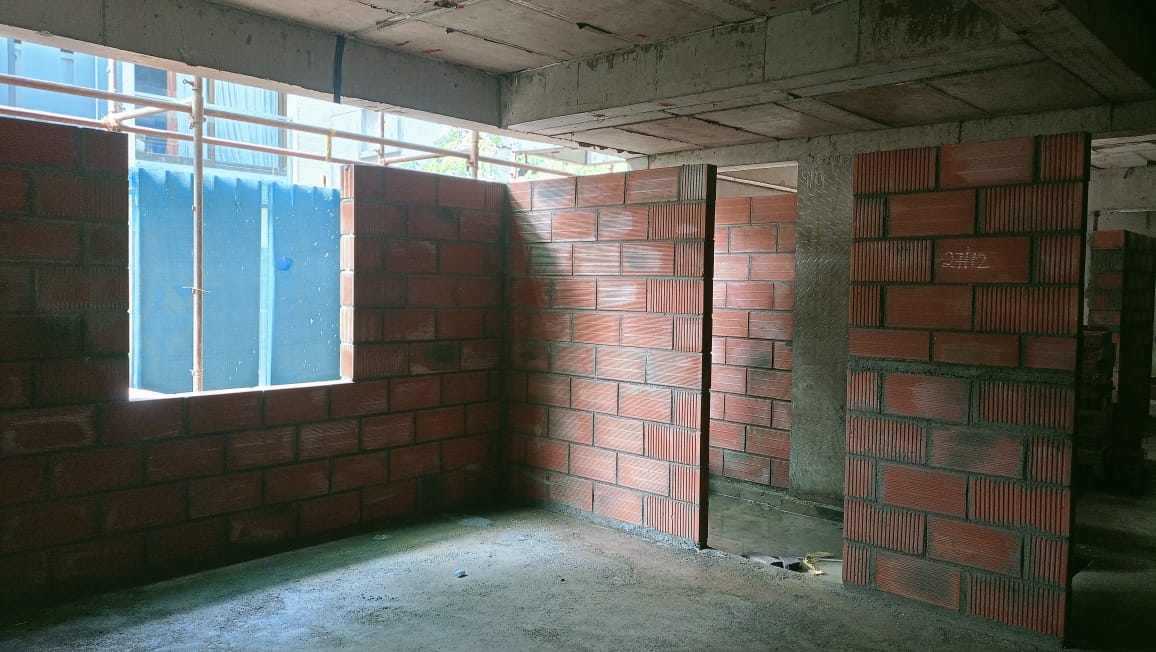

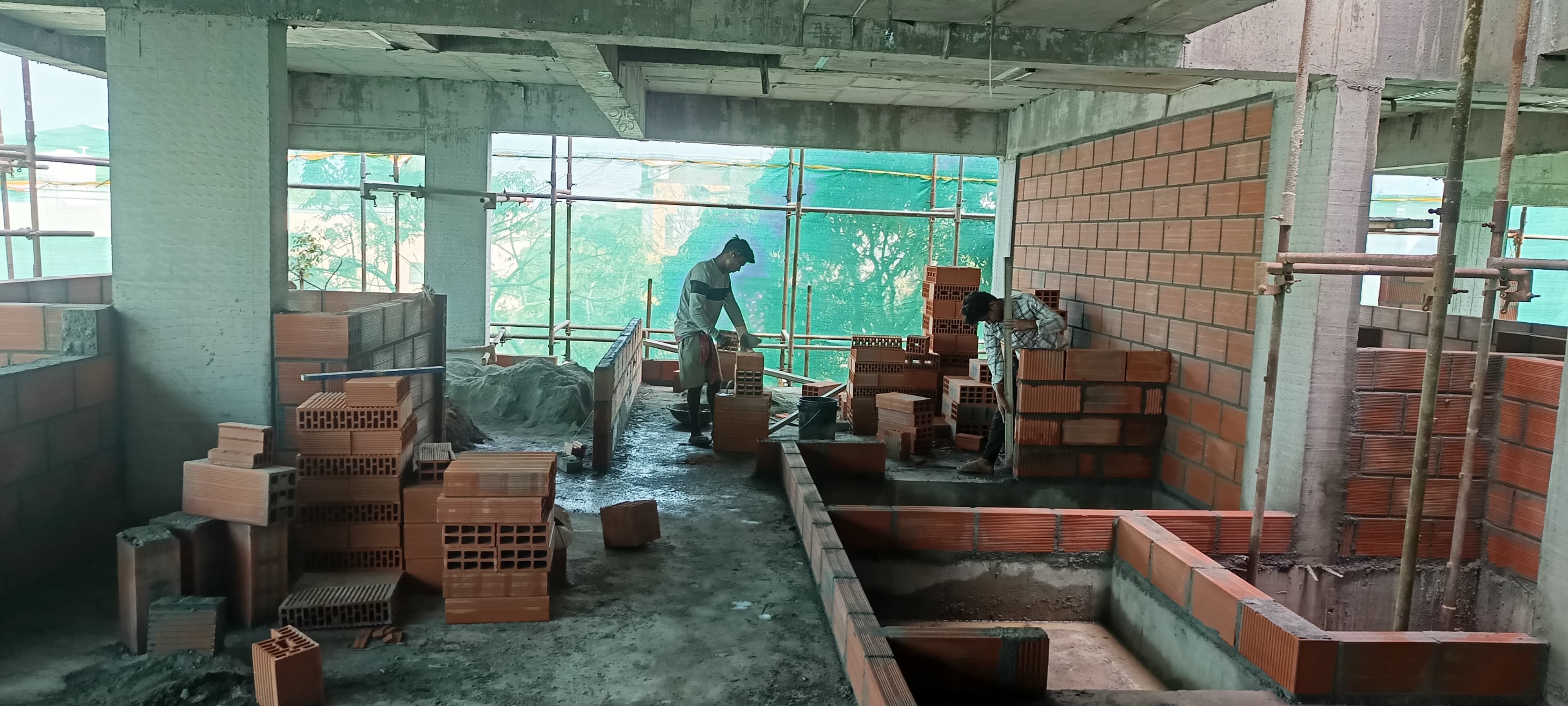

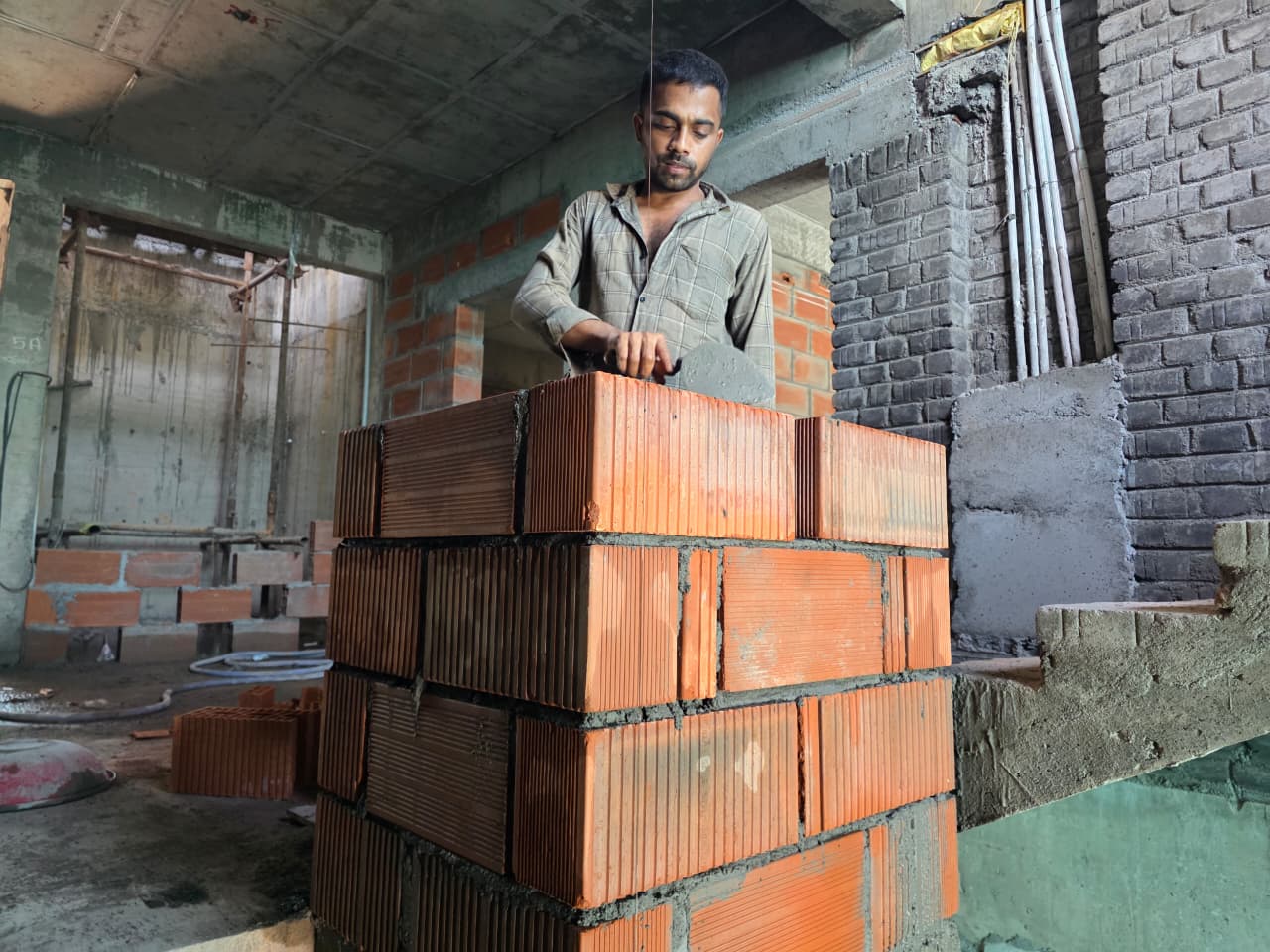

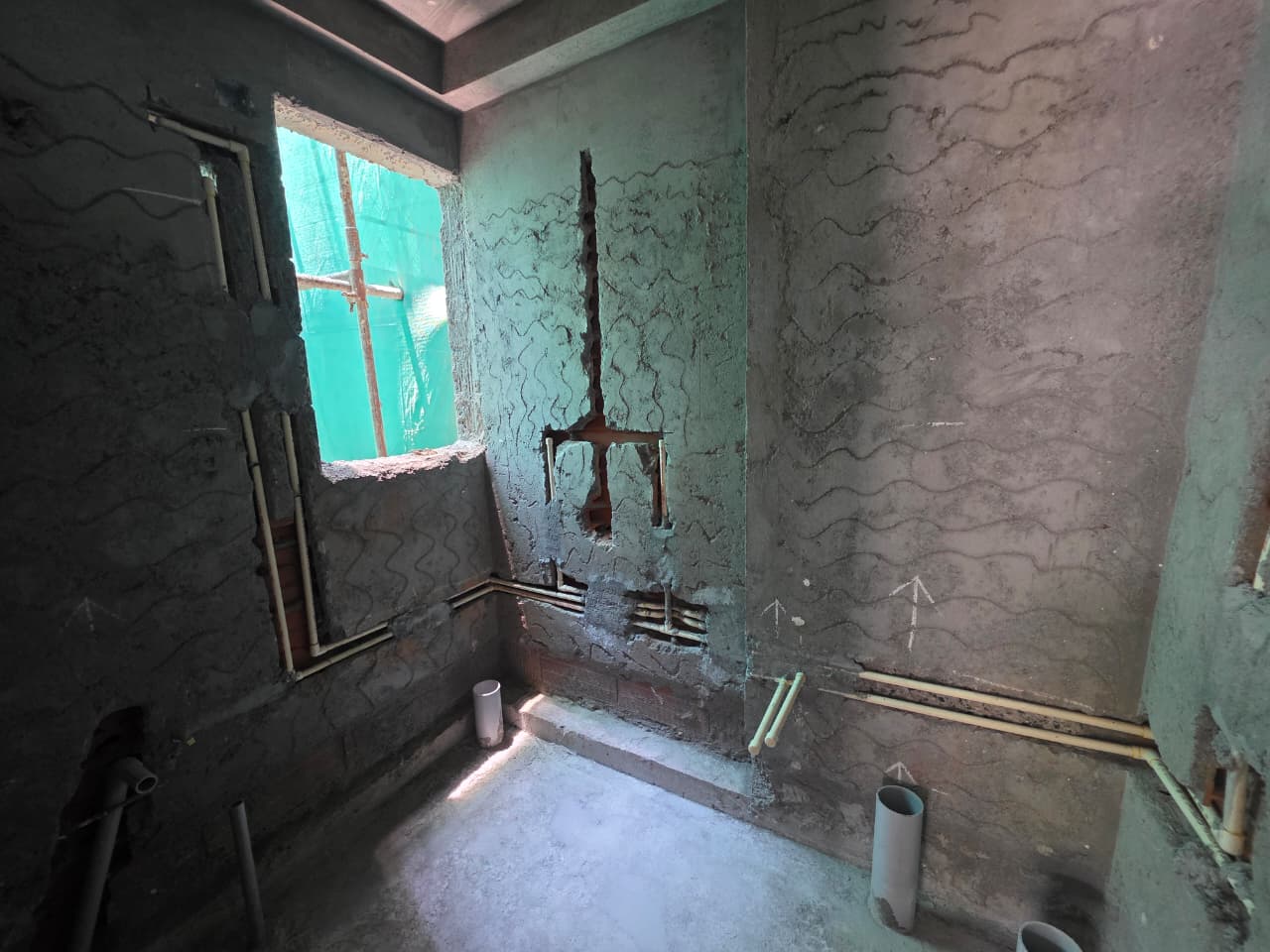

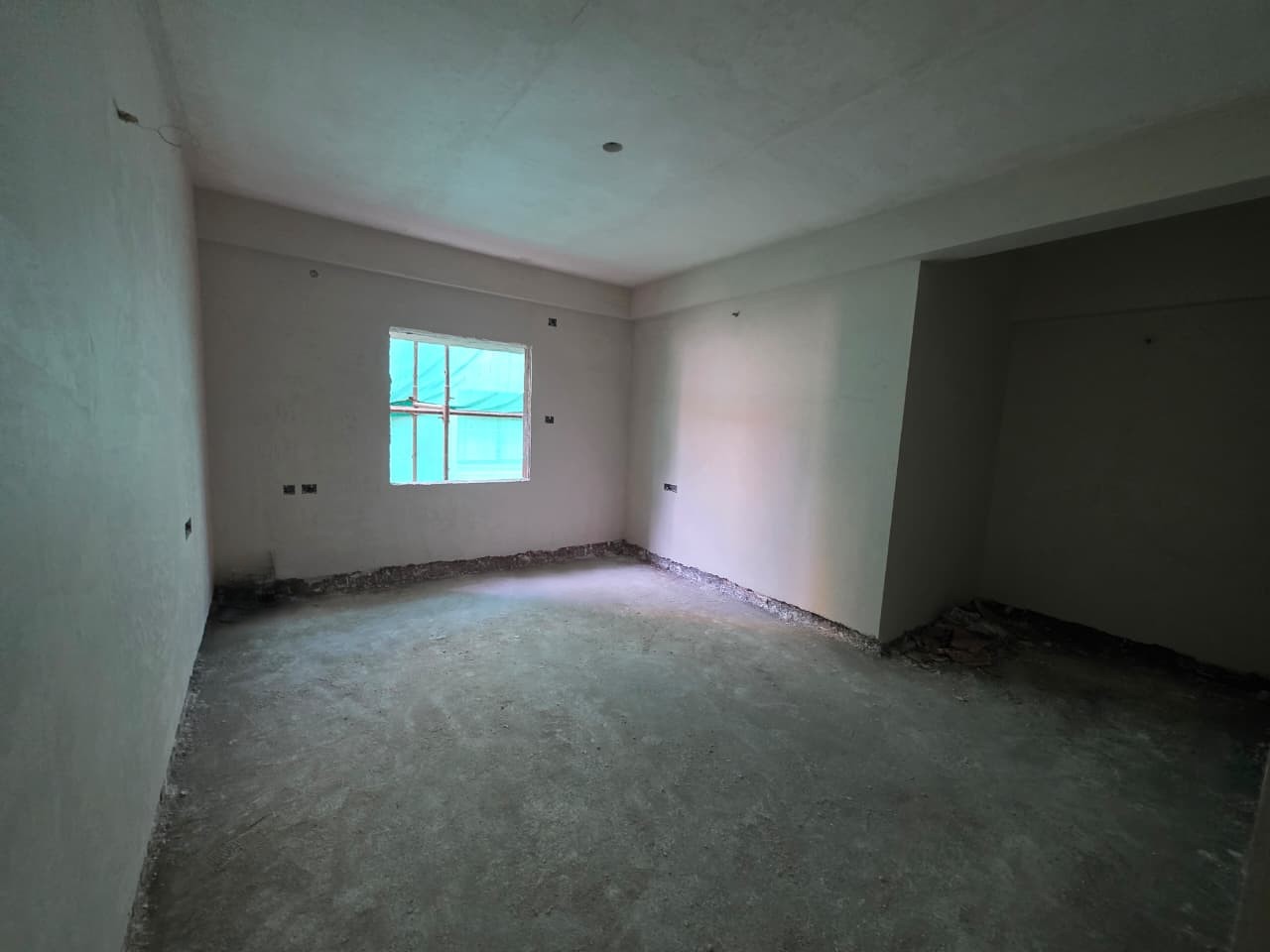

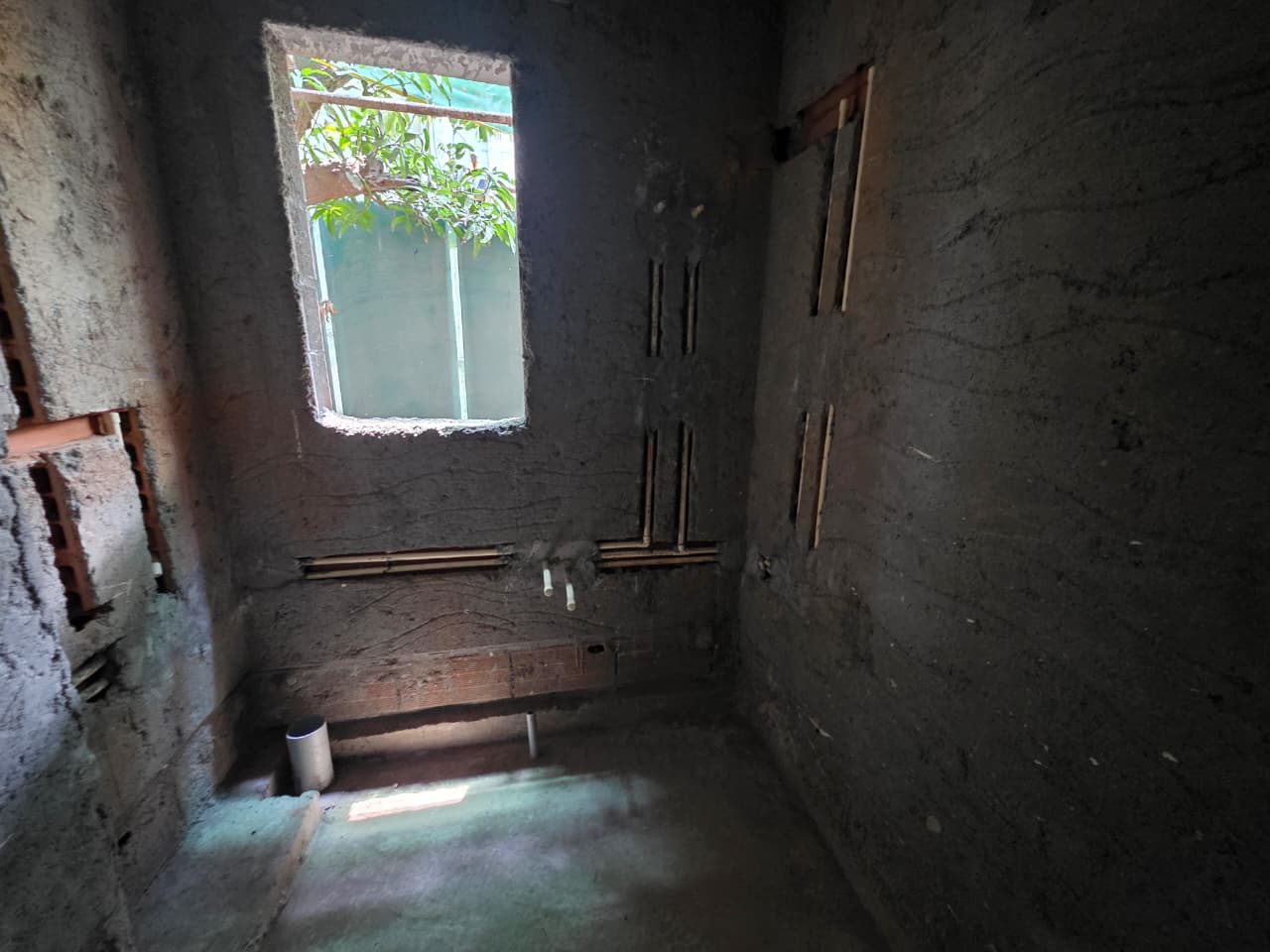

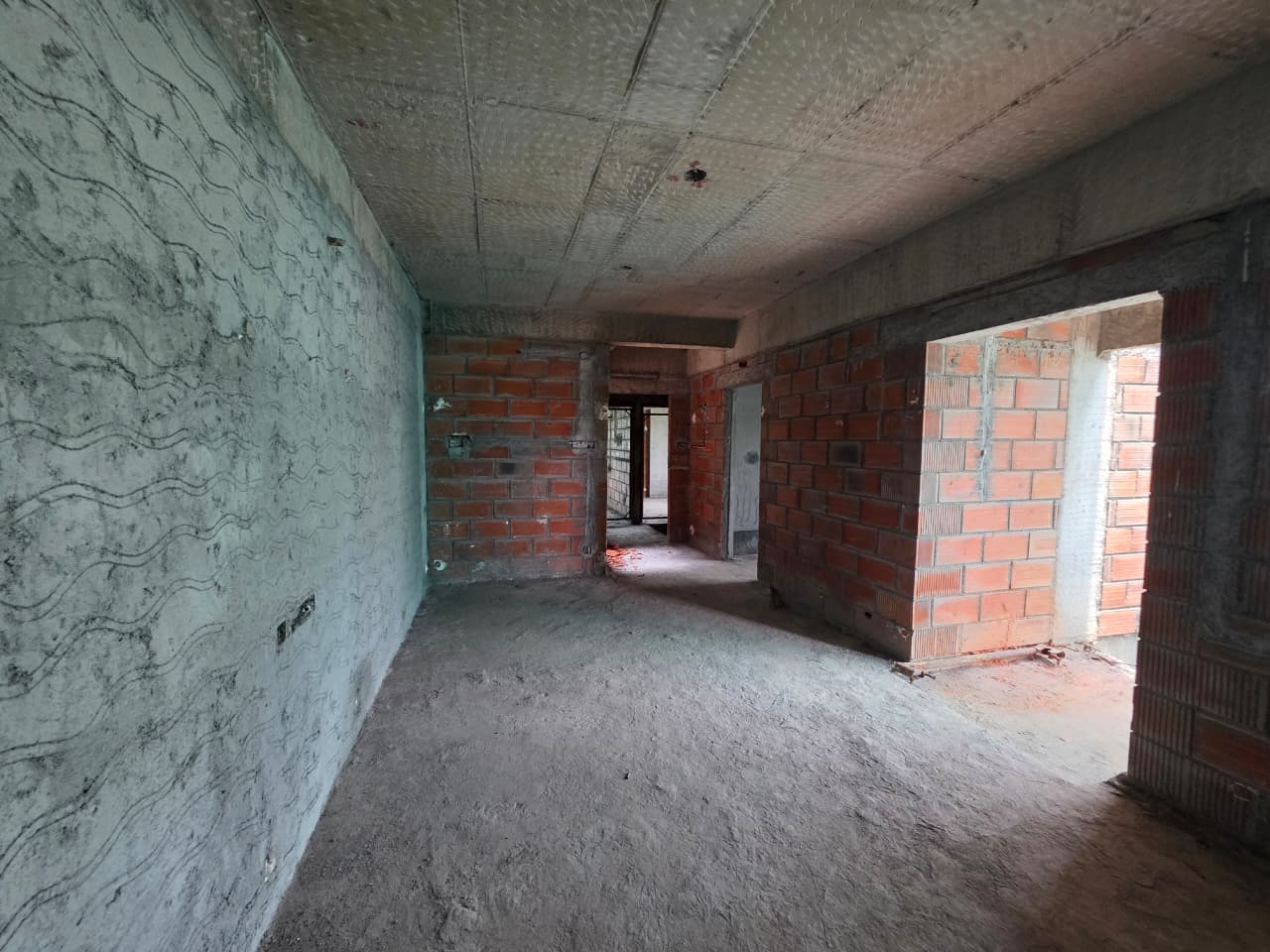

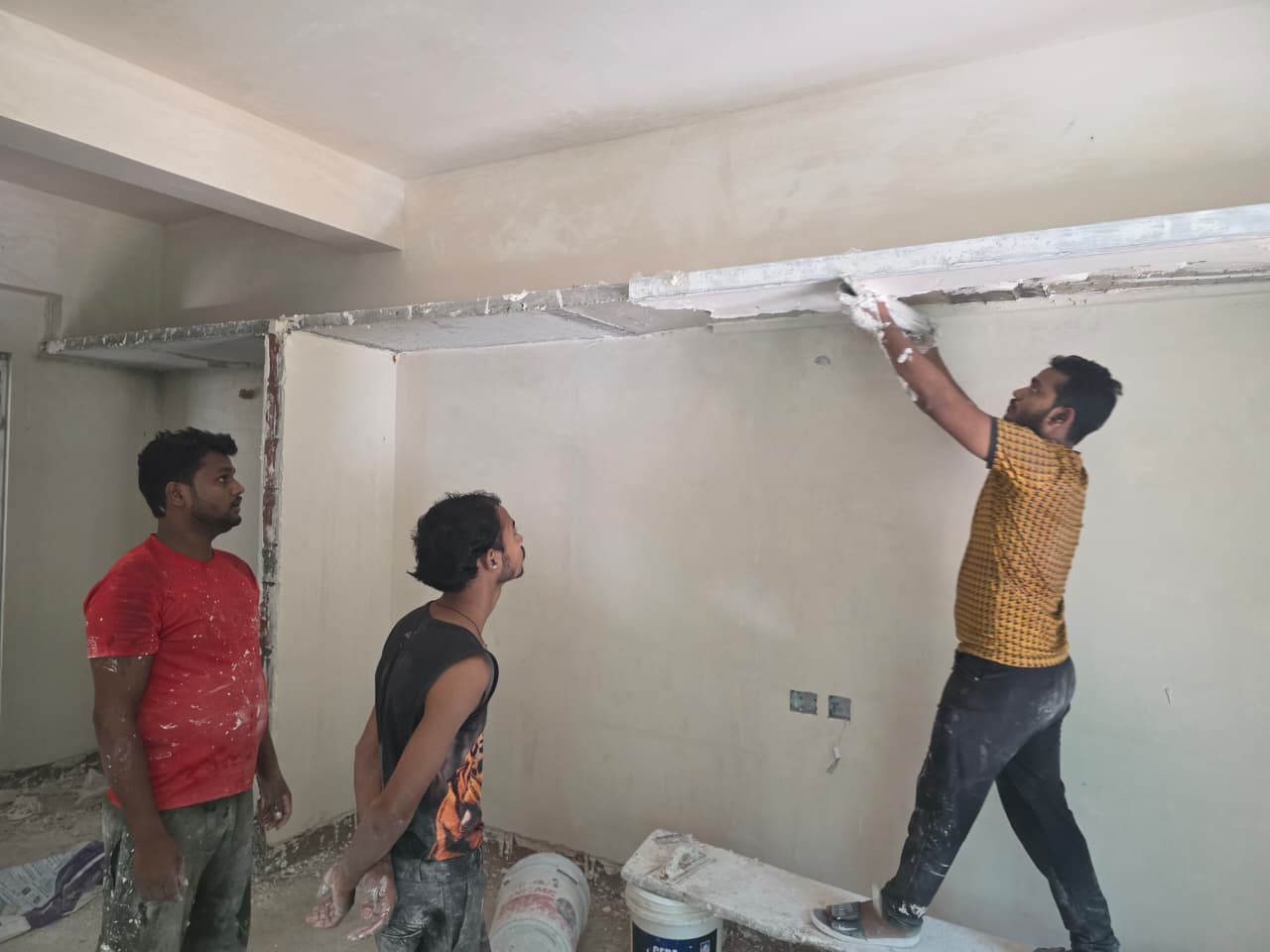

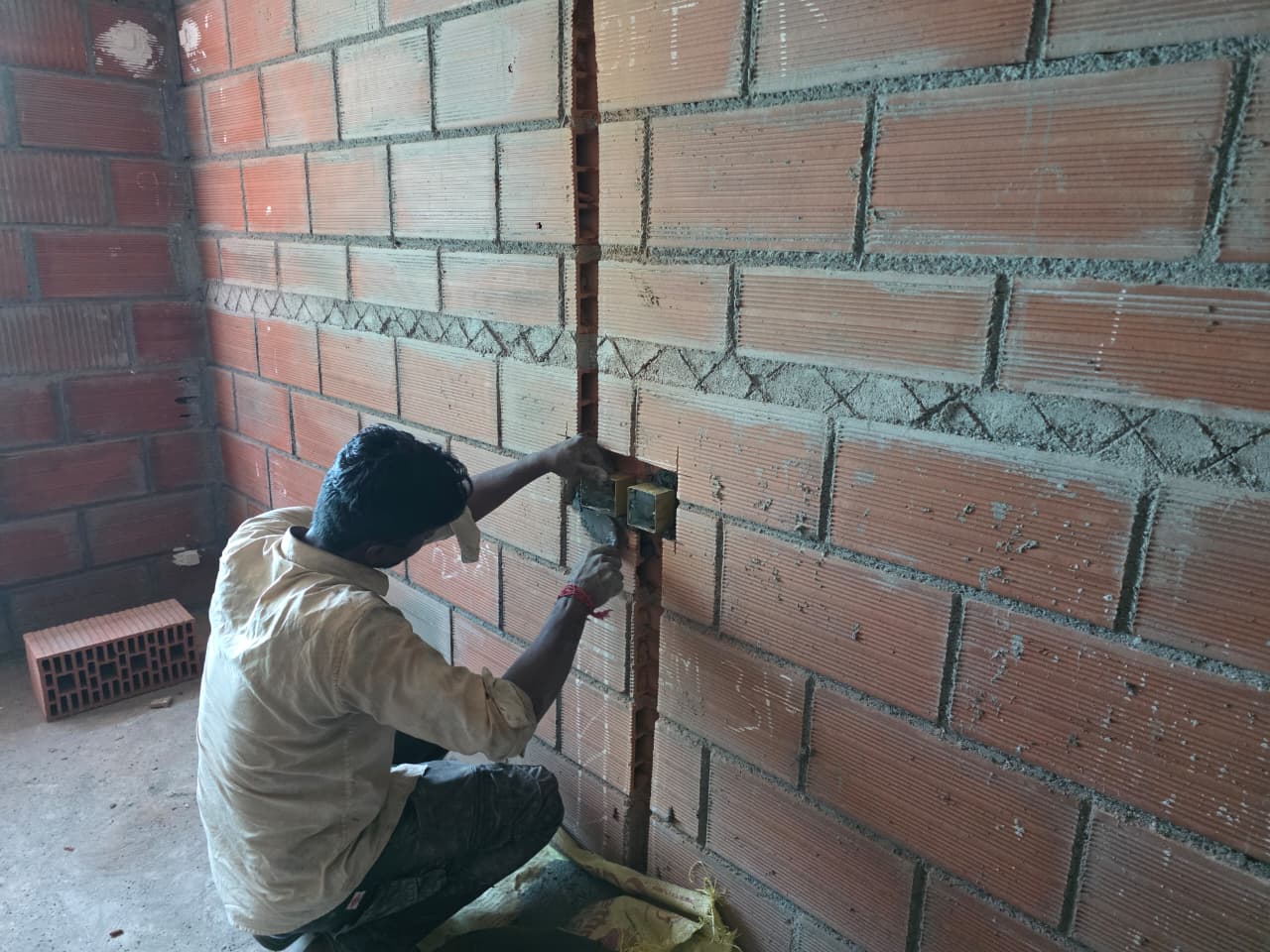

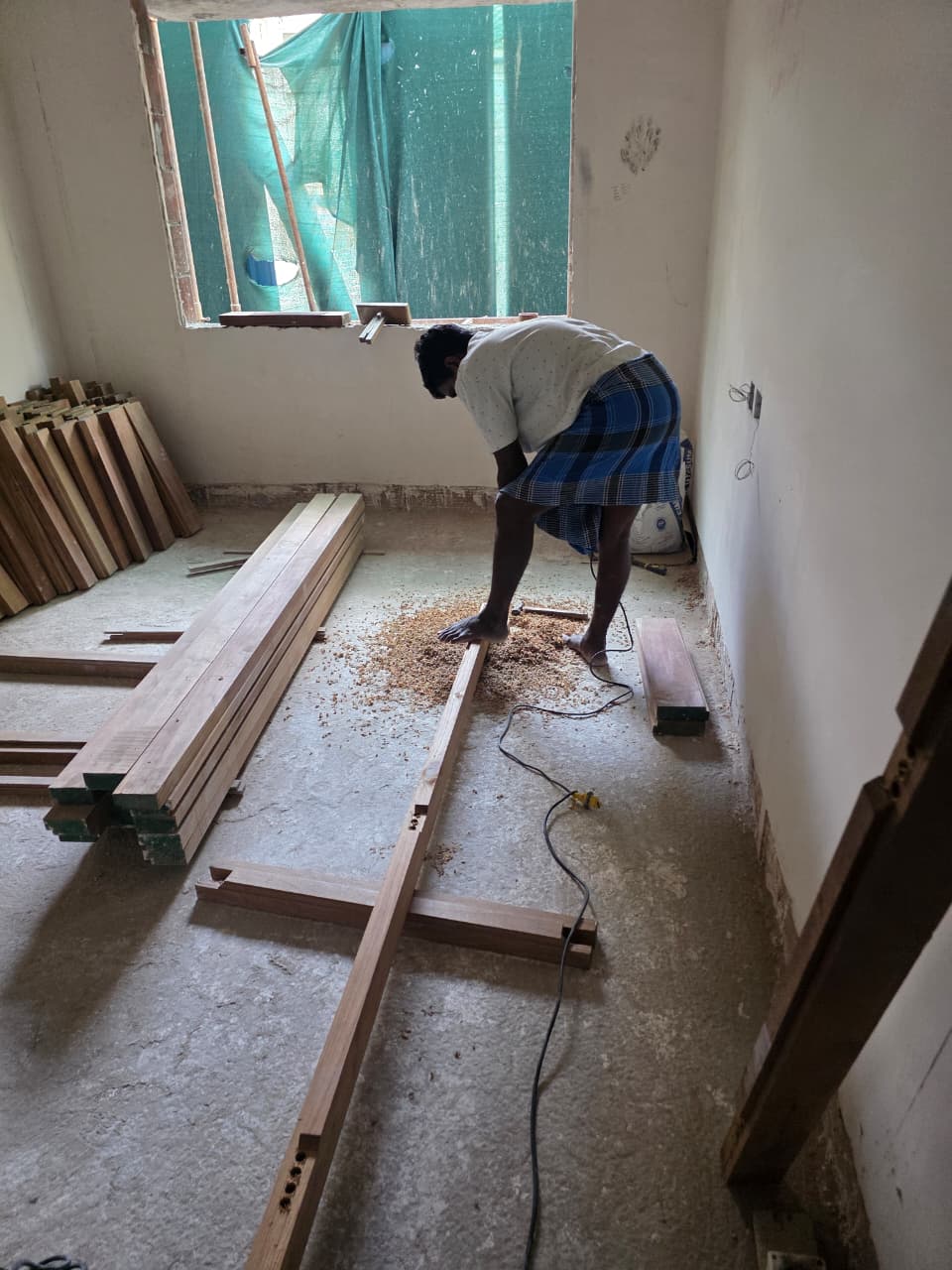

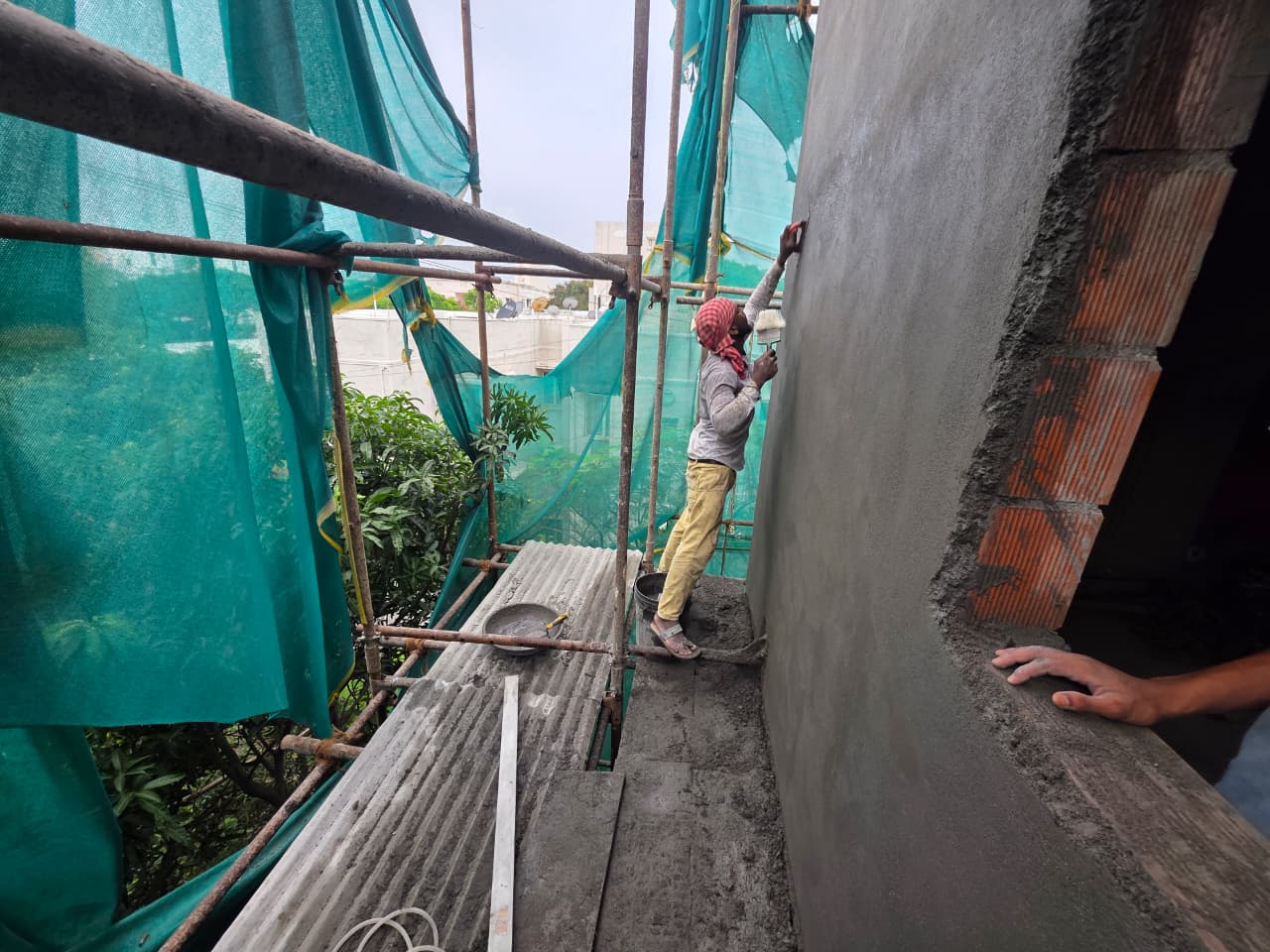

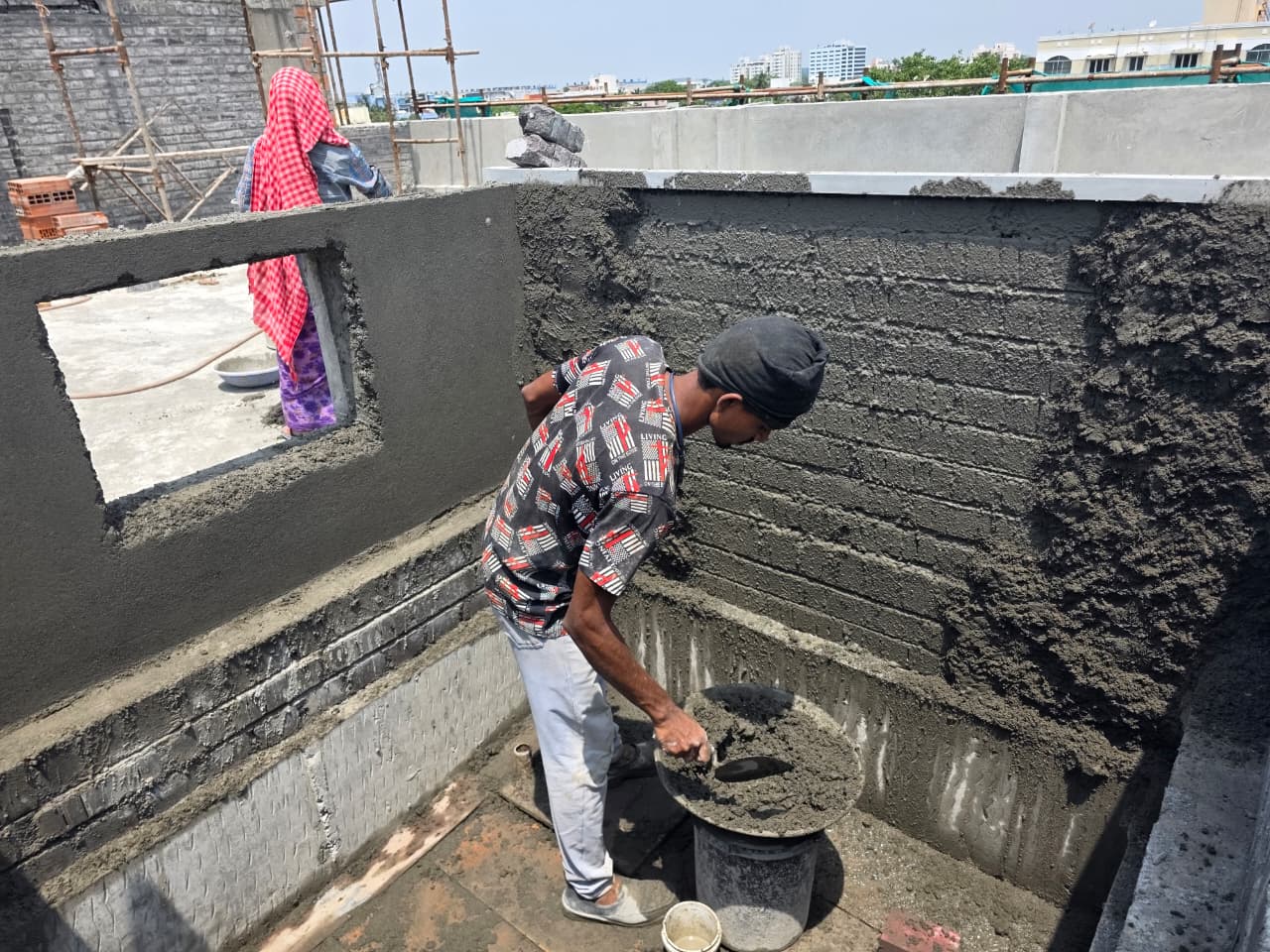

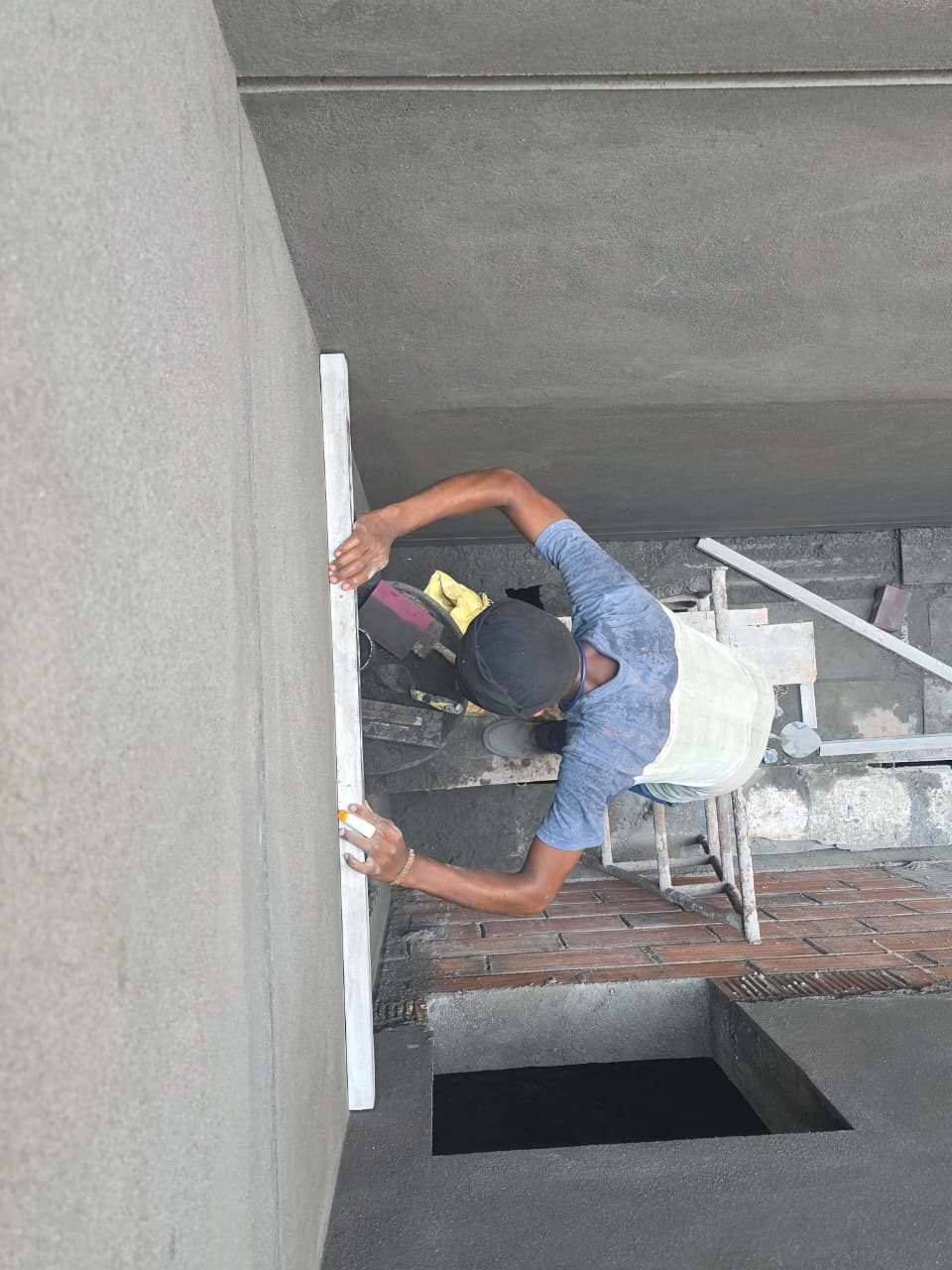

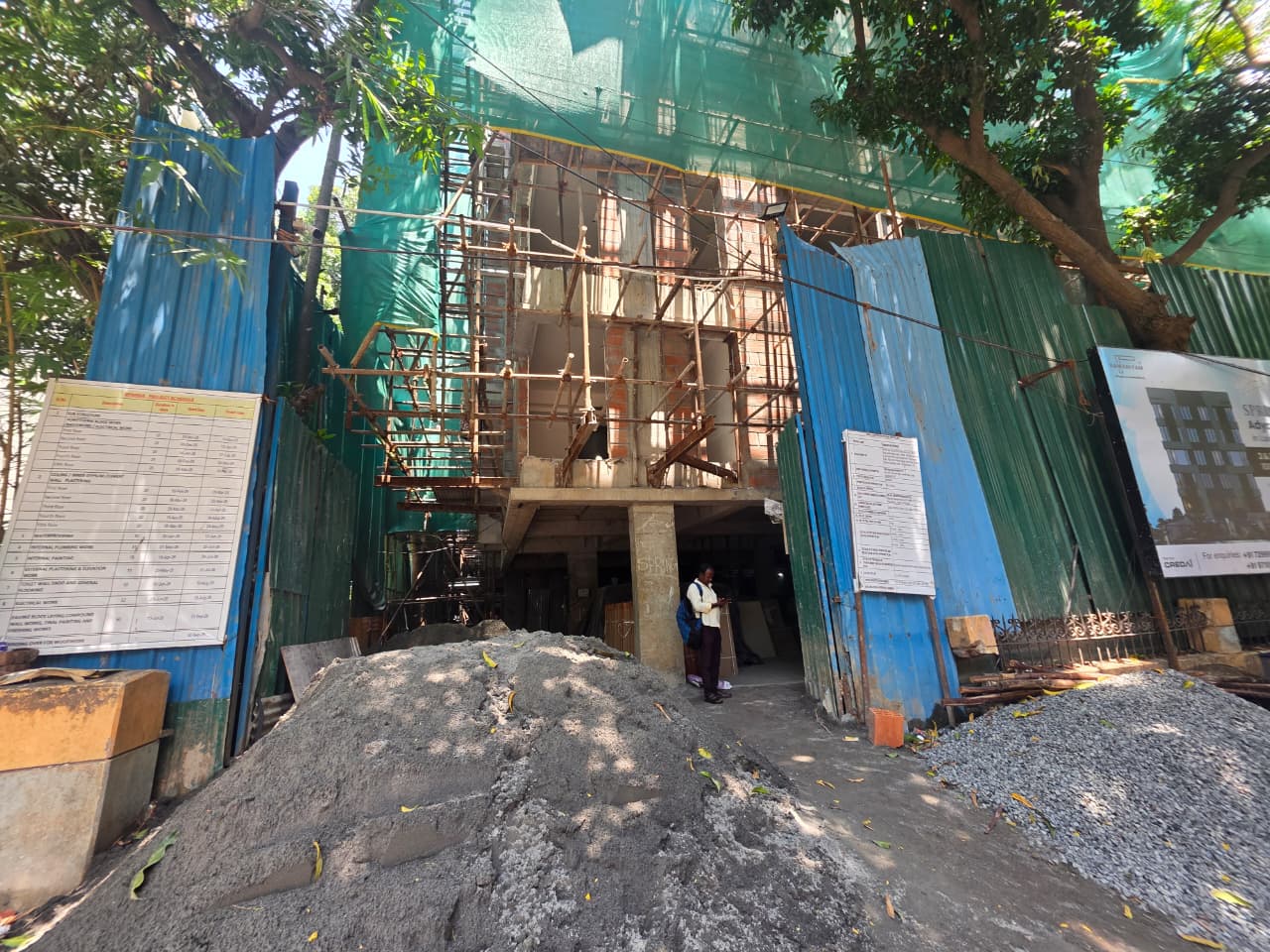

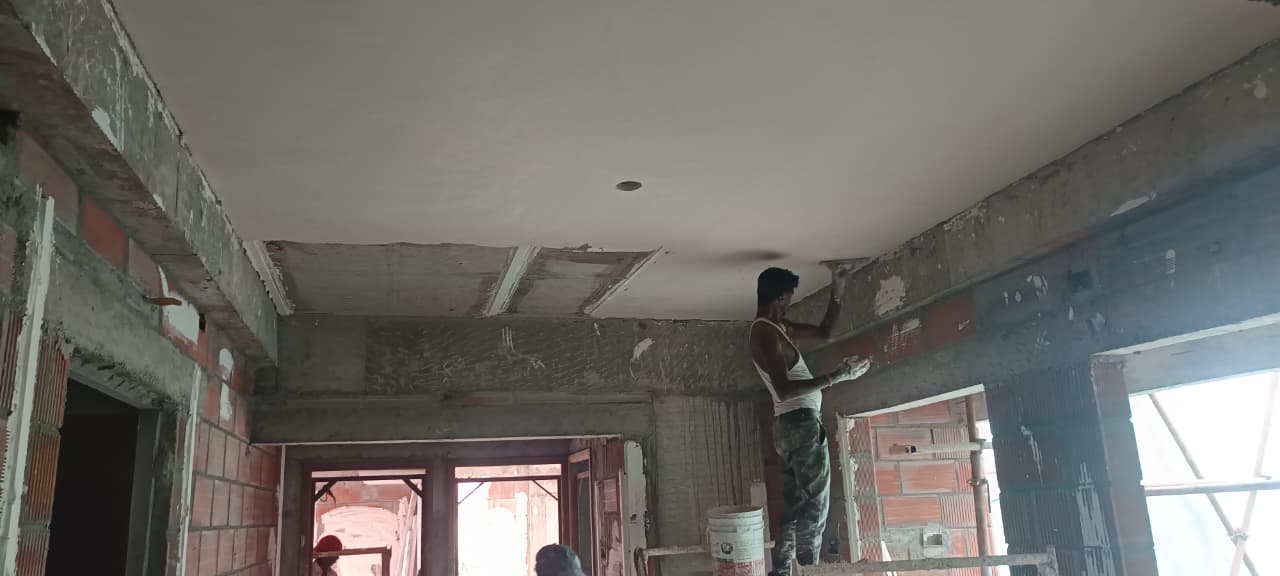

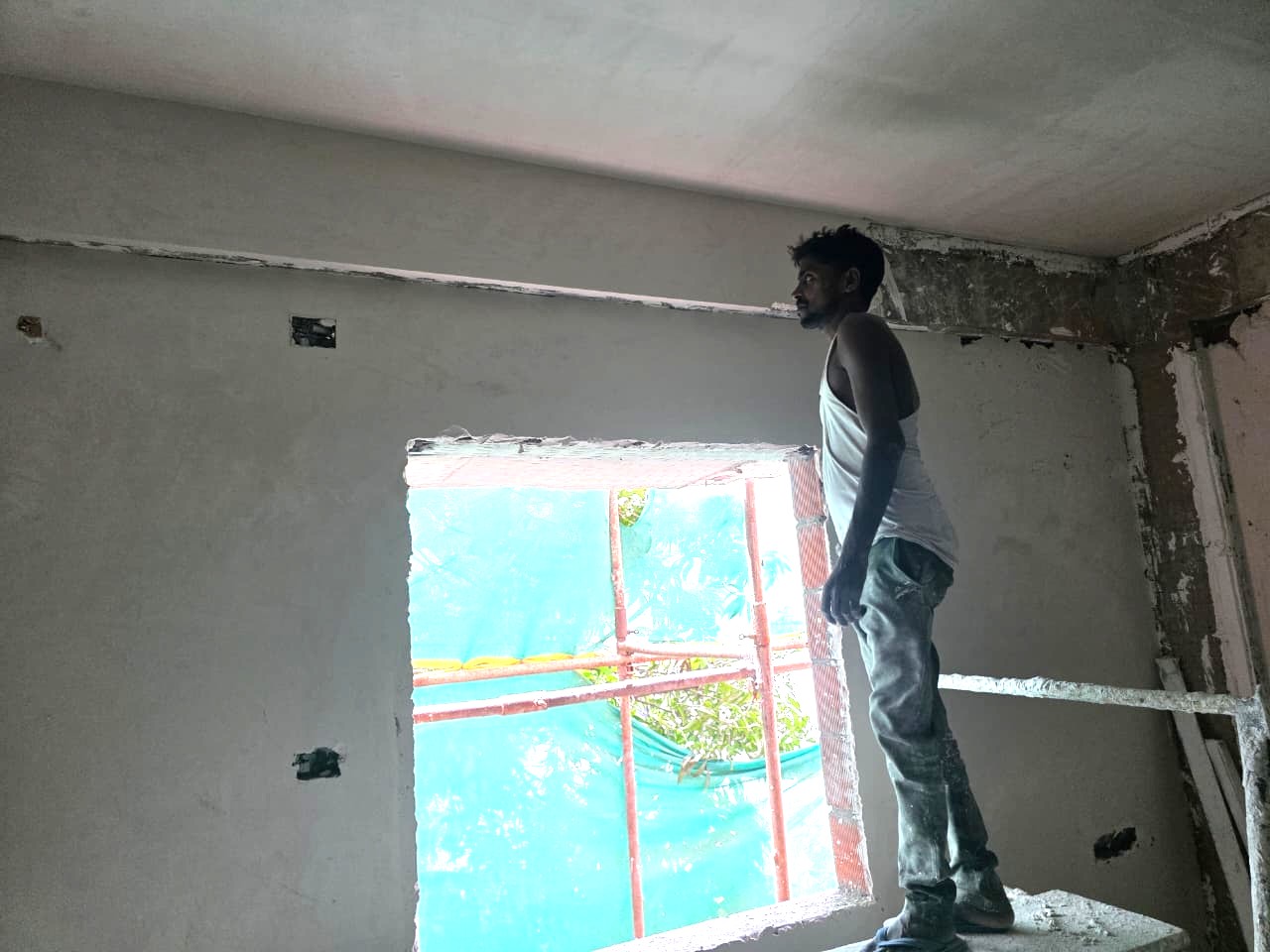

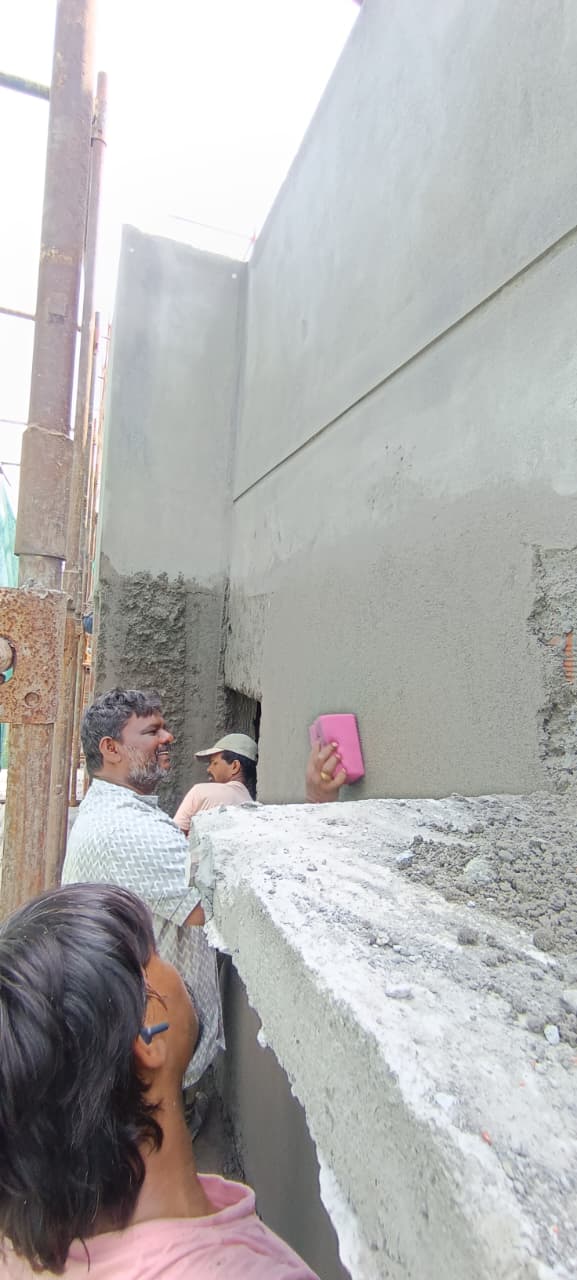

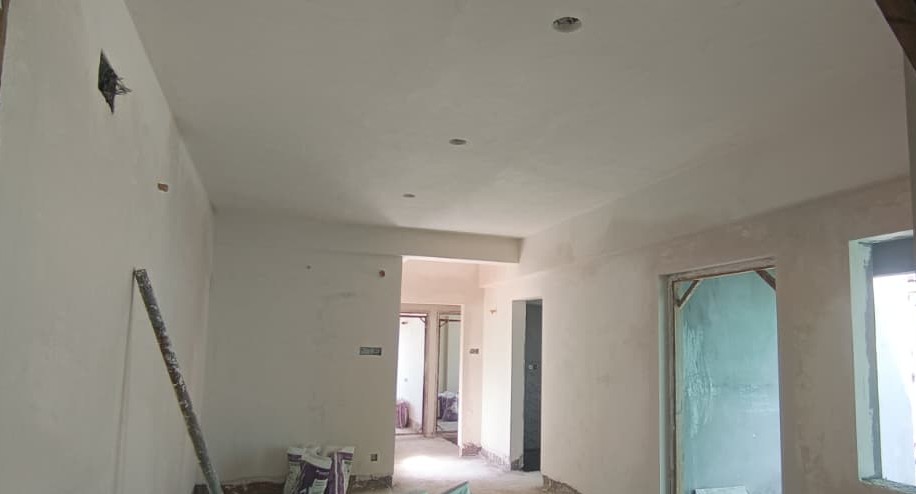

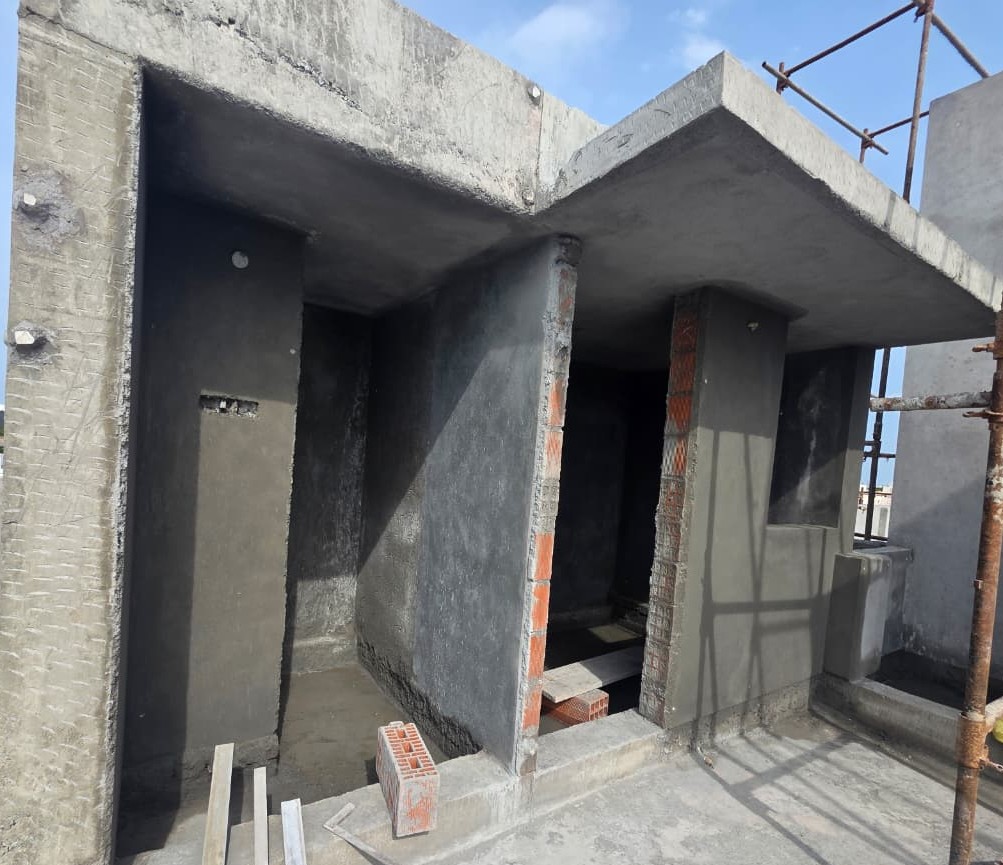

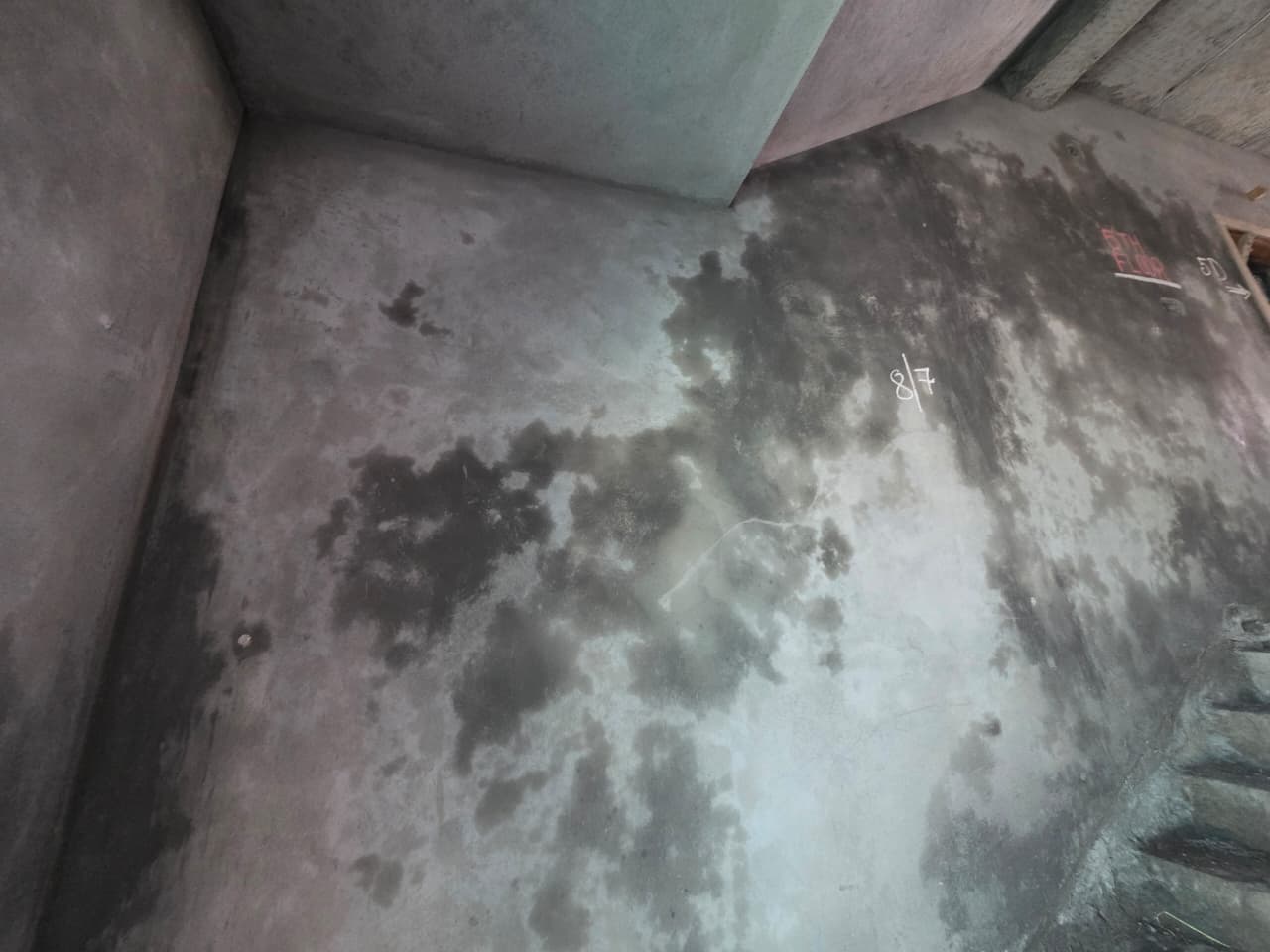

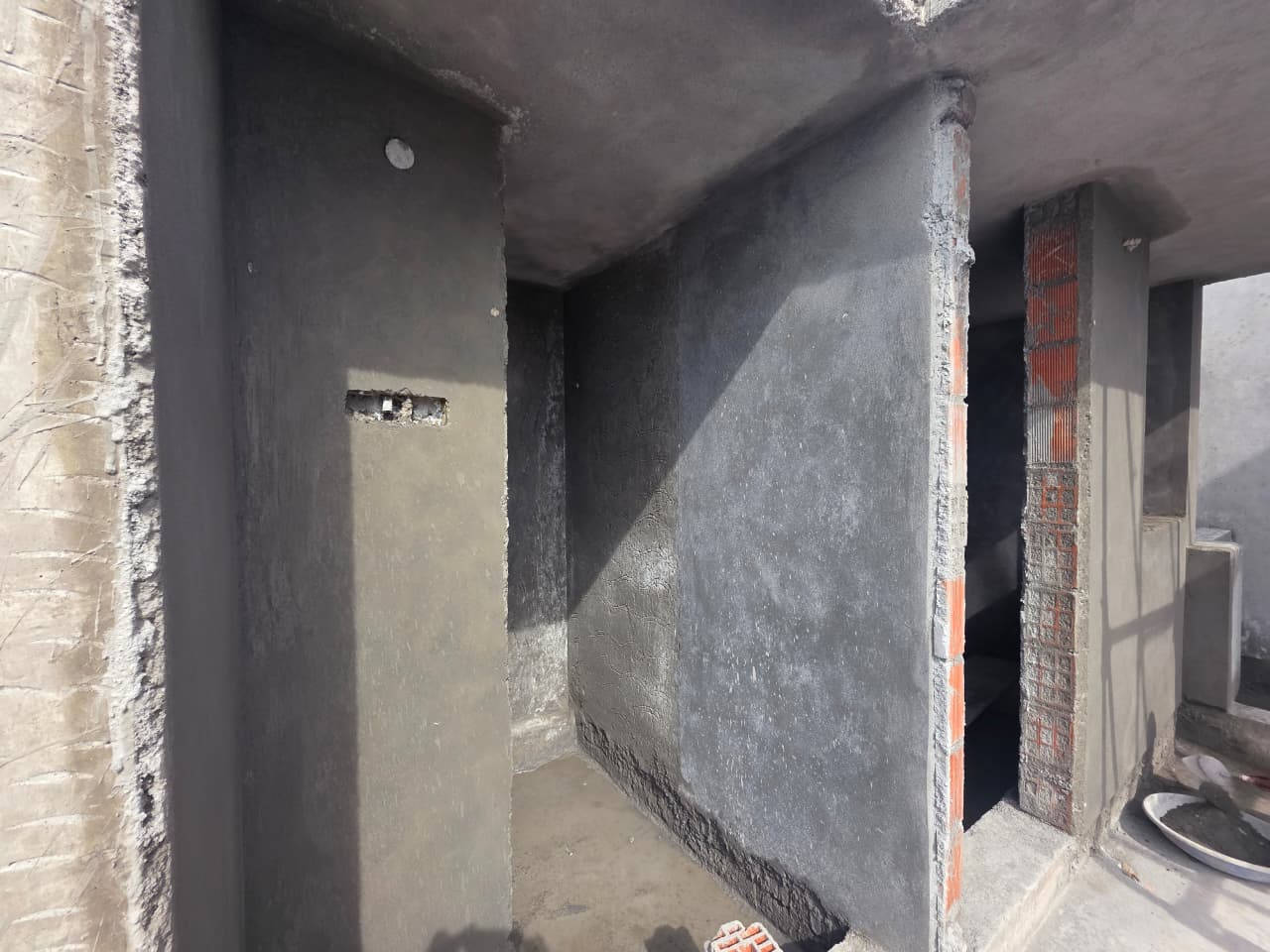

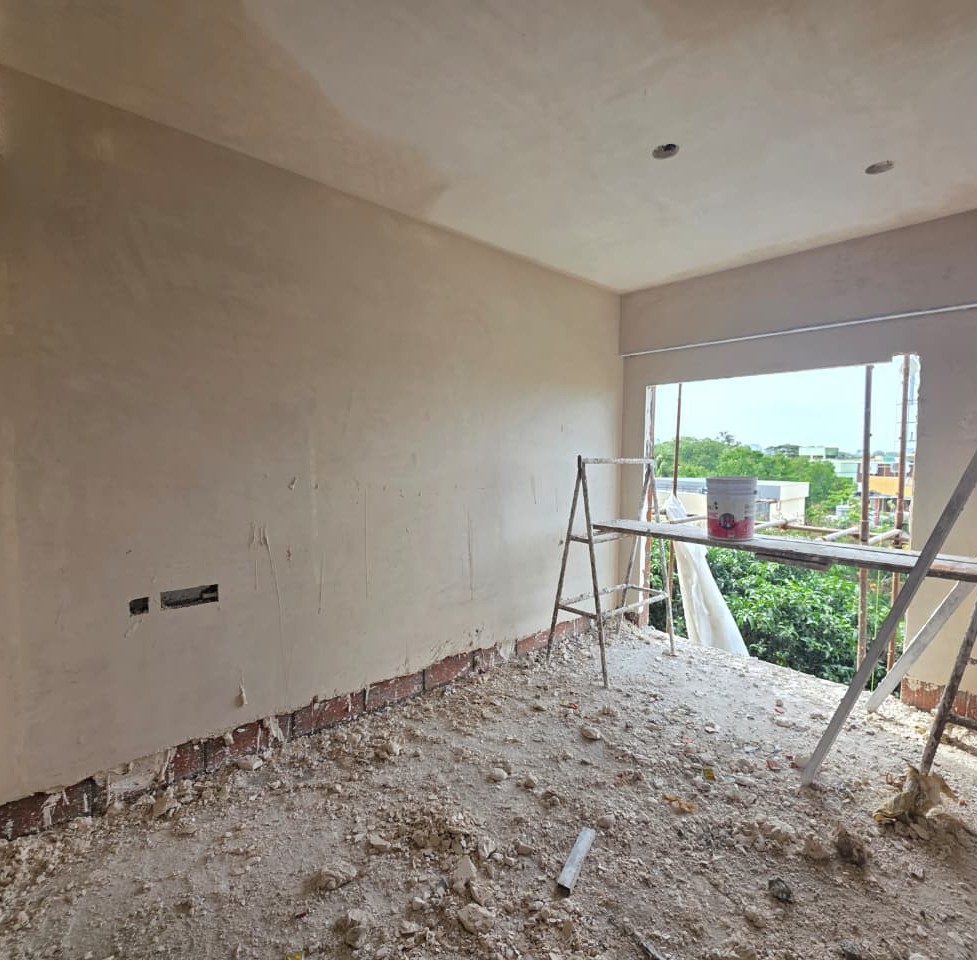

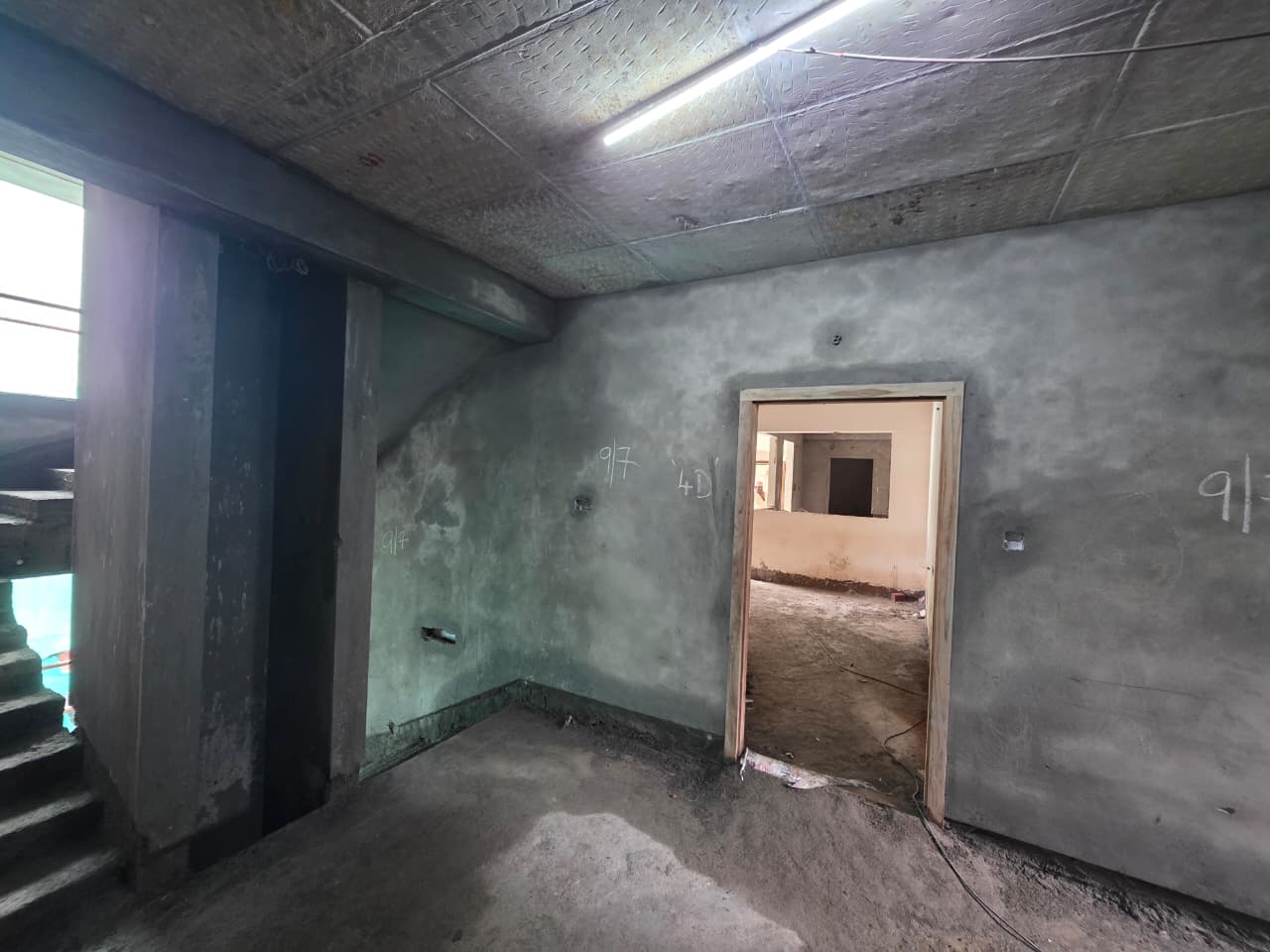

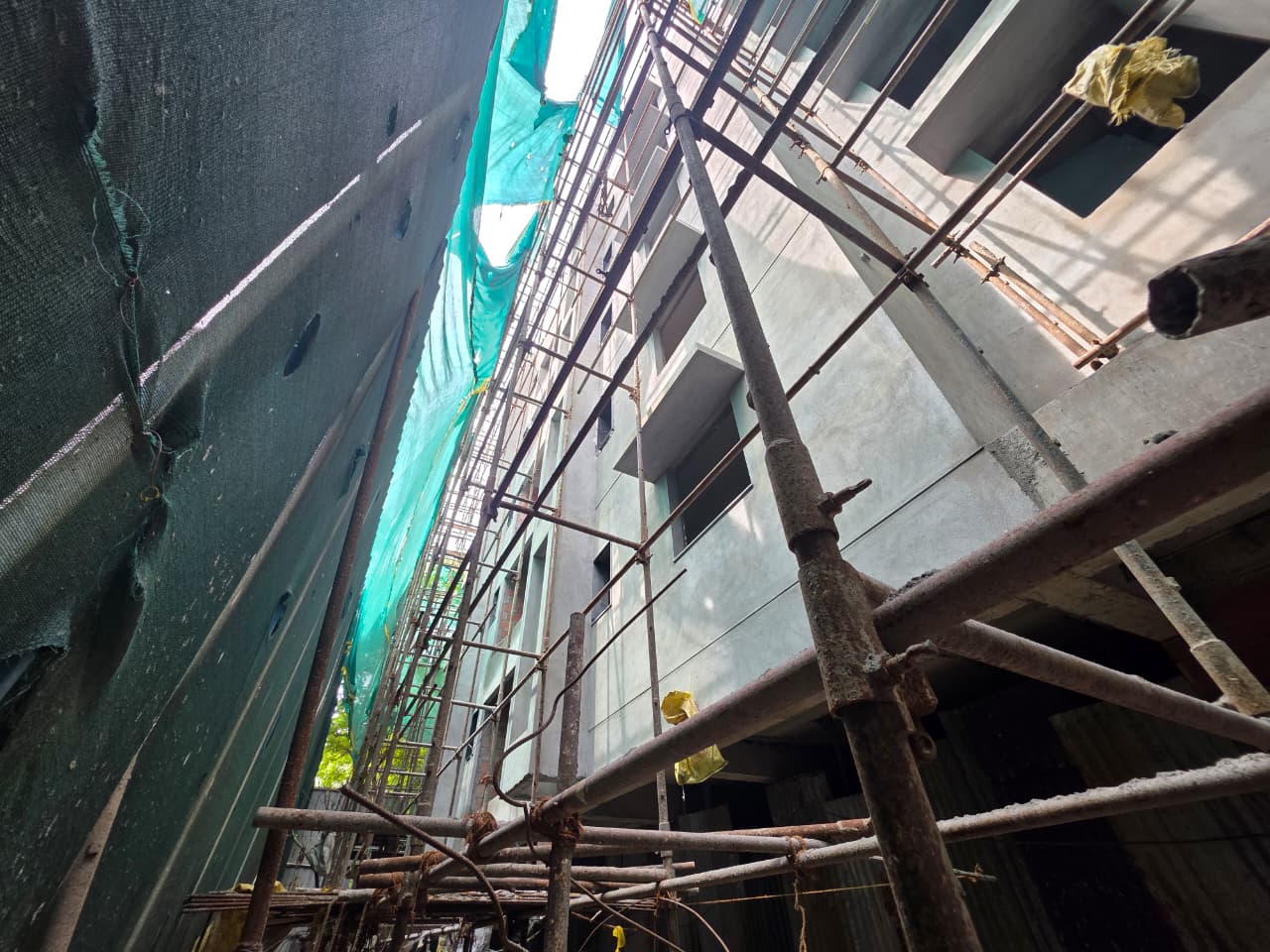

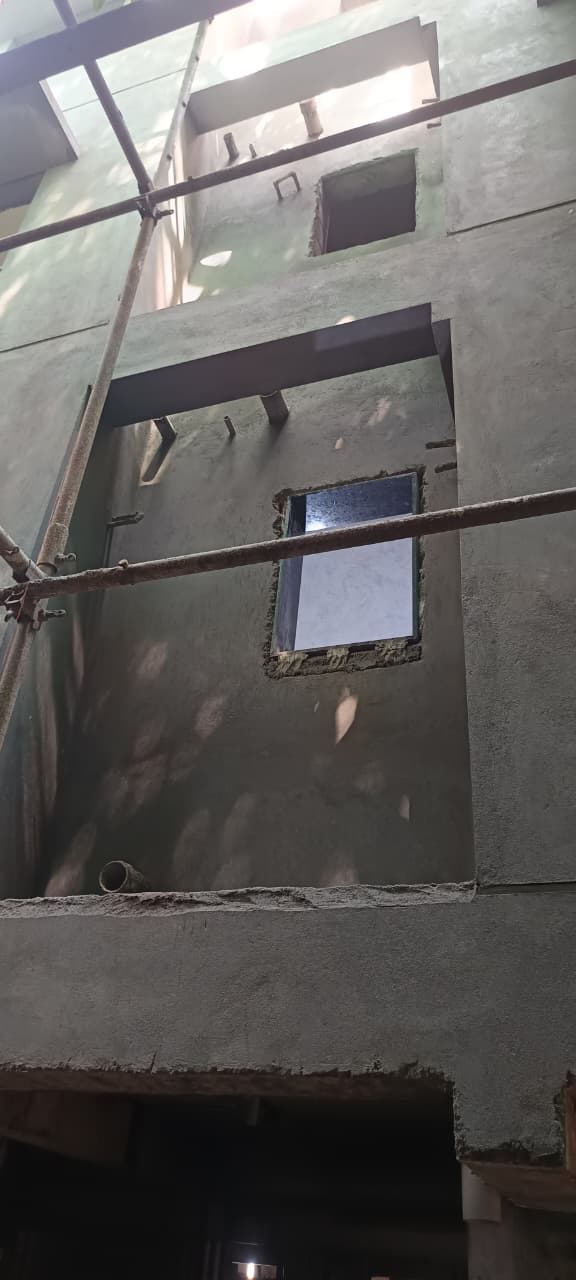

  • 2nd Floor plastering work is in progress.(90% completed)
  • 3rd Floor plastering work is in progress.(90% completed)
  • 4th Floor plastering work is in progress.(80% completed)
  • 5th floor plastering work is in progress.(30% completed)

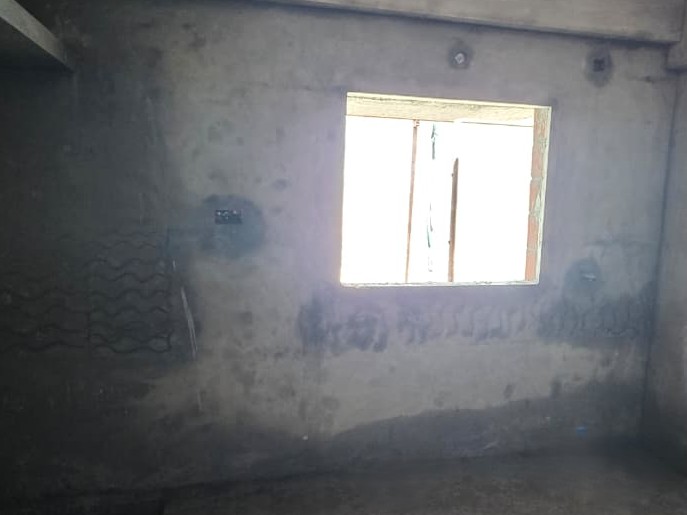

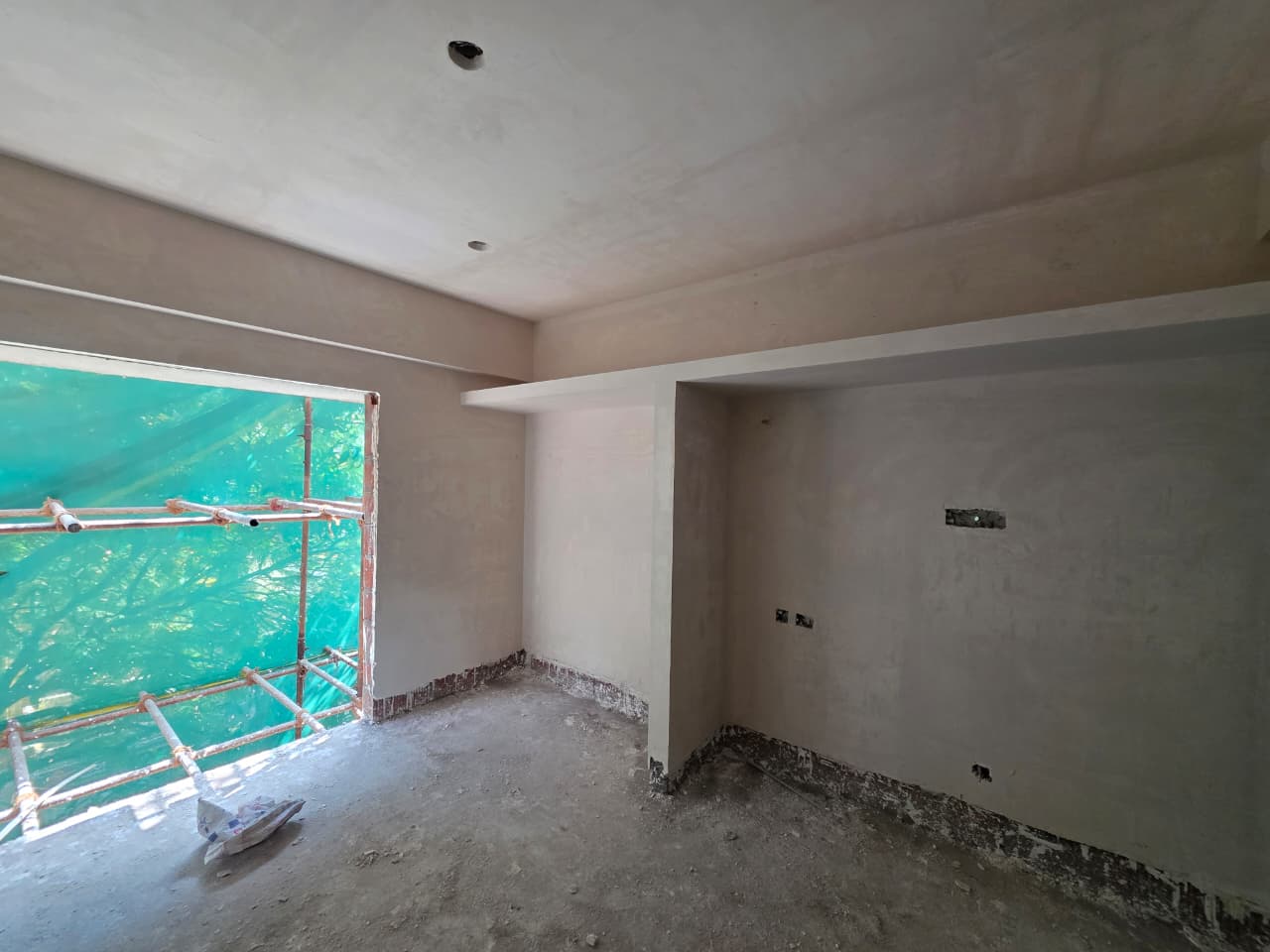

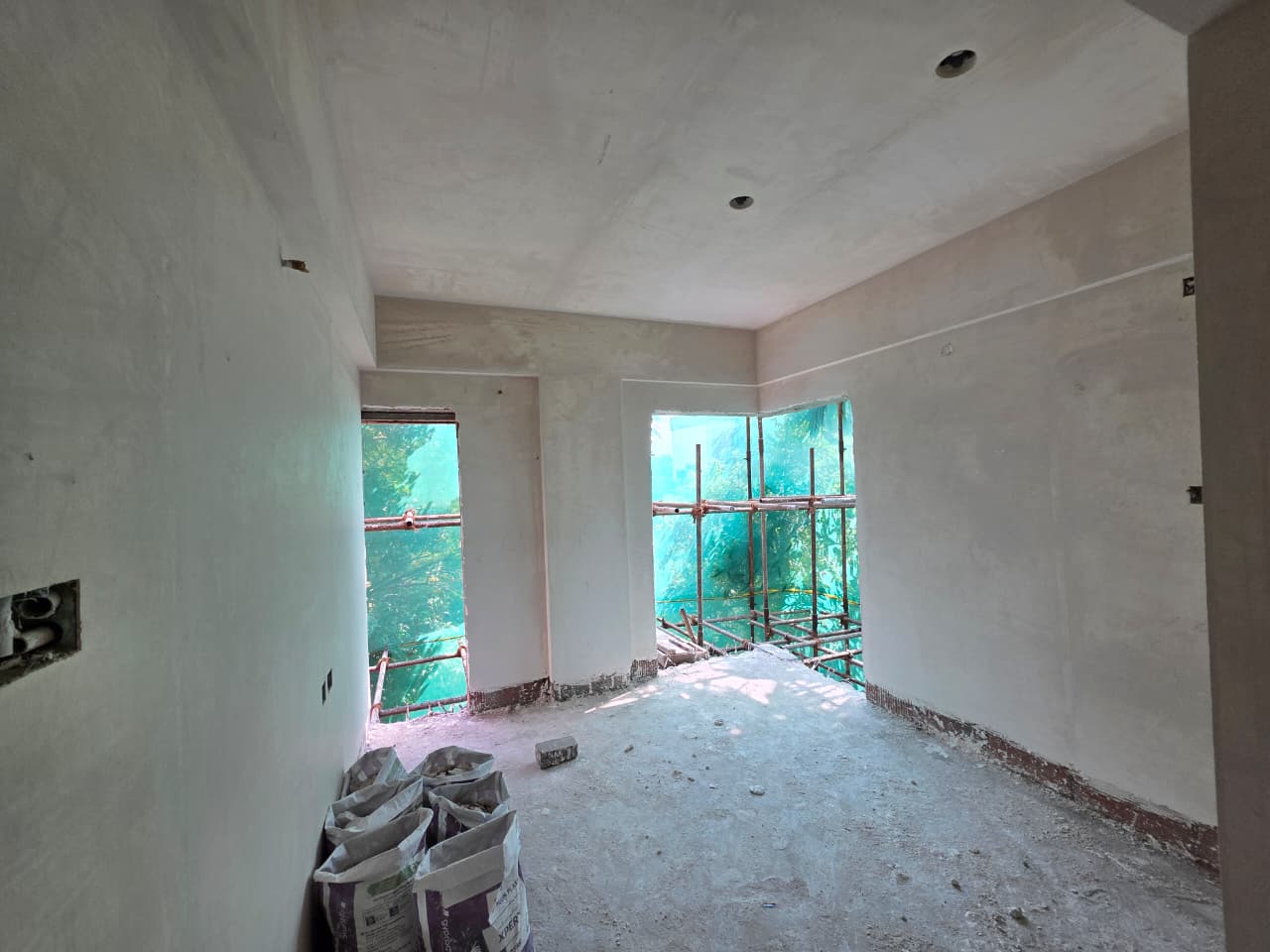

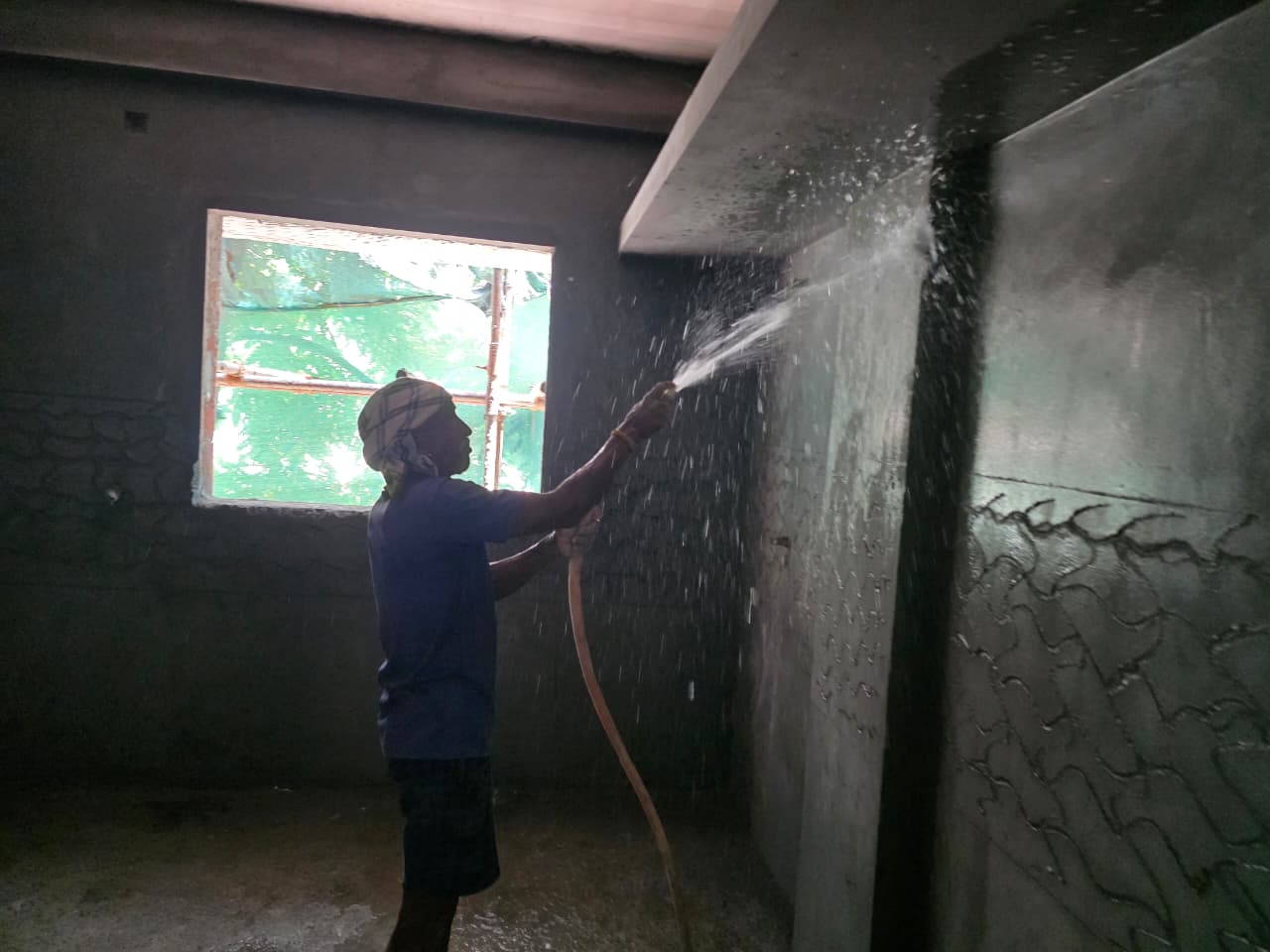

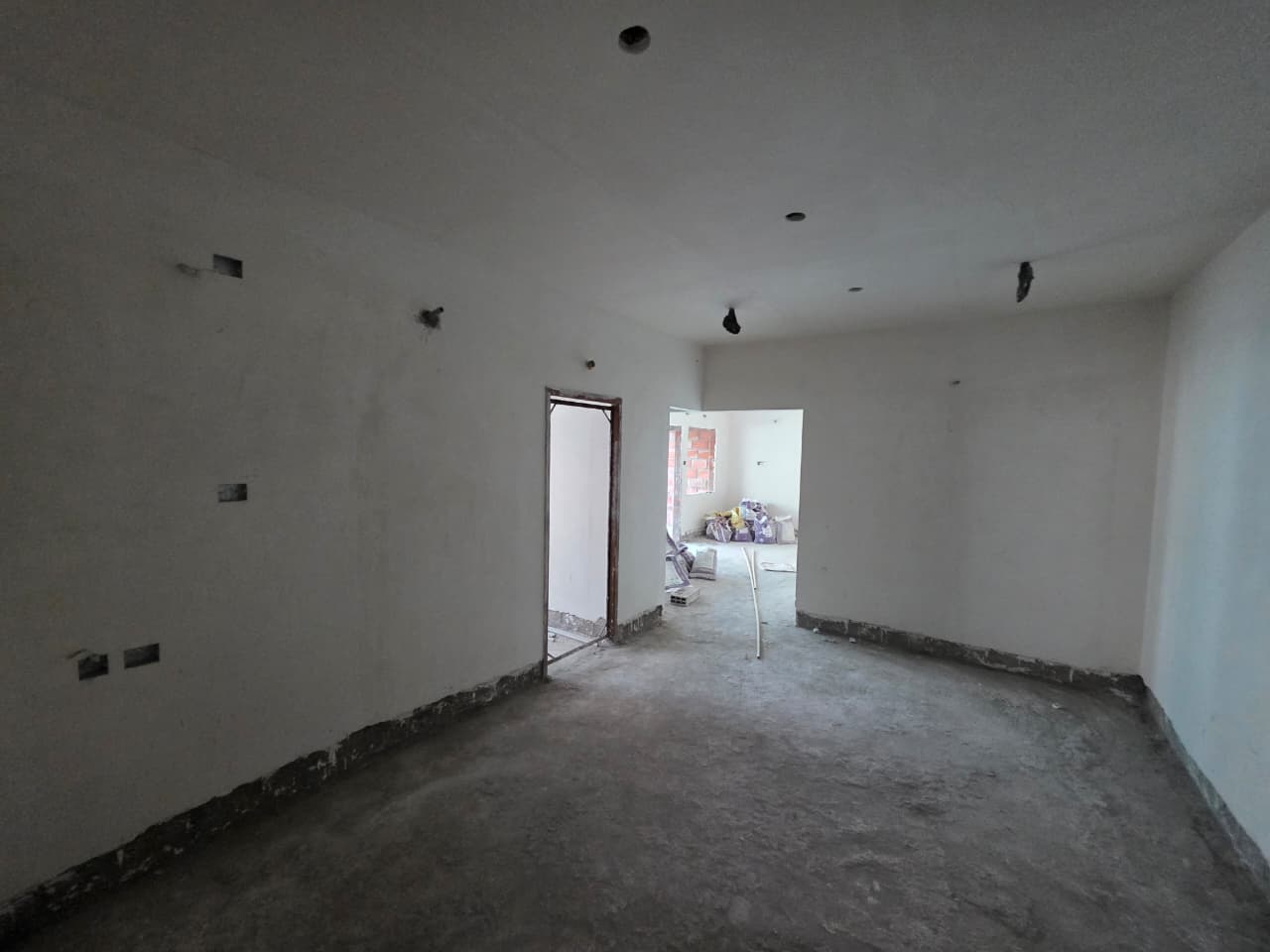

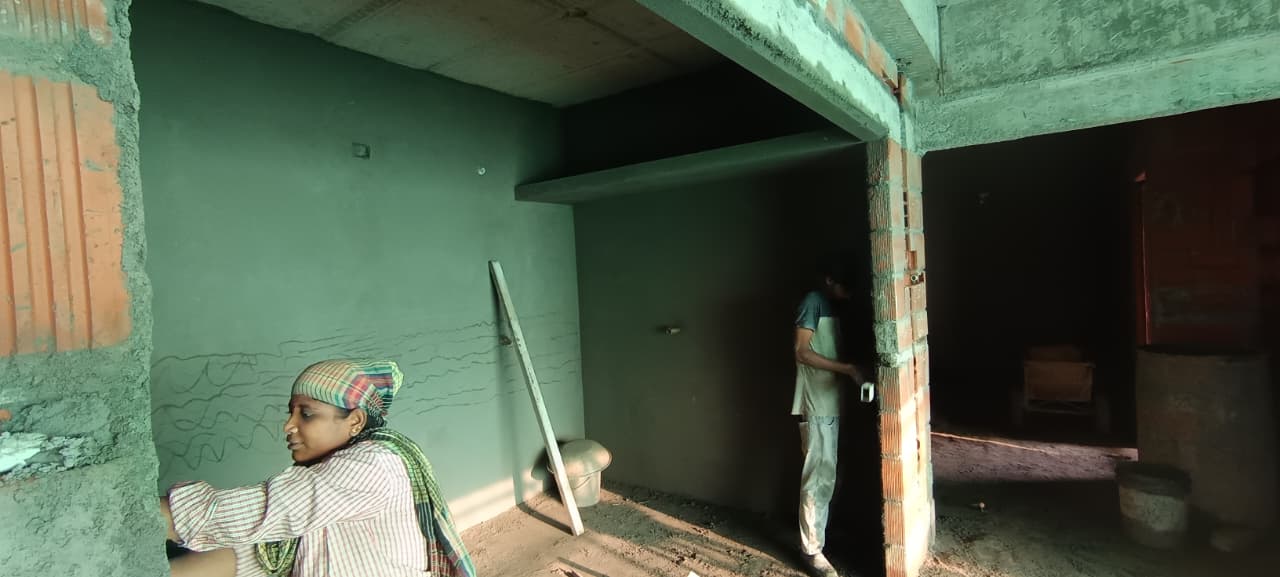

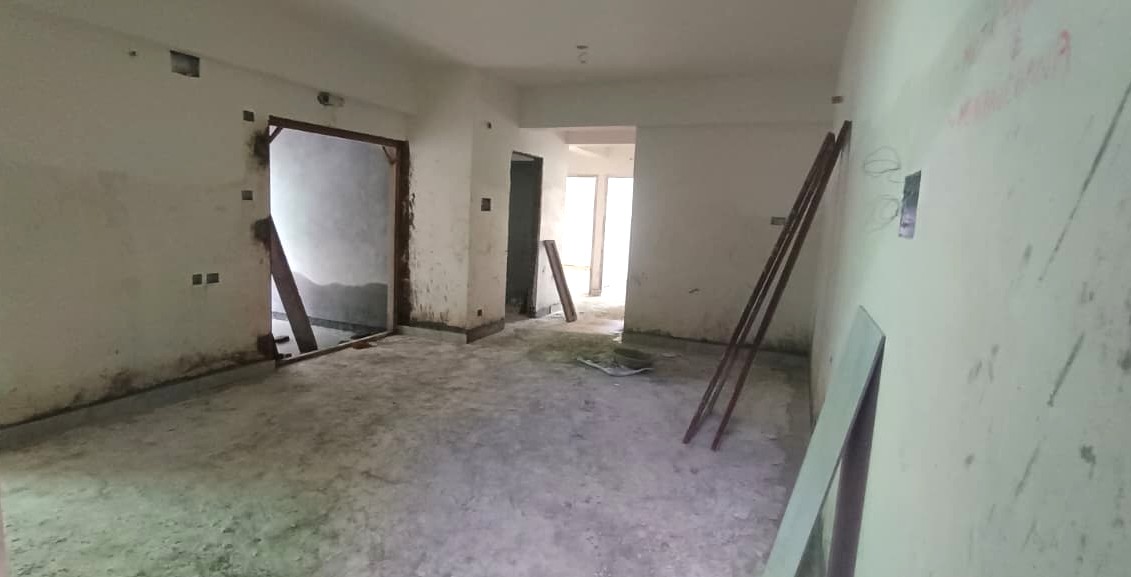

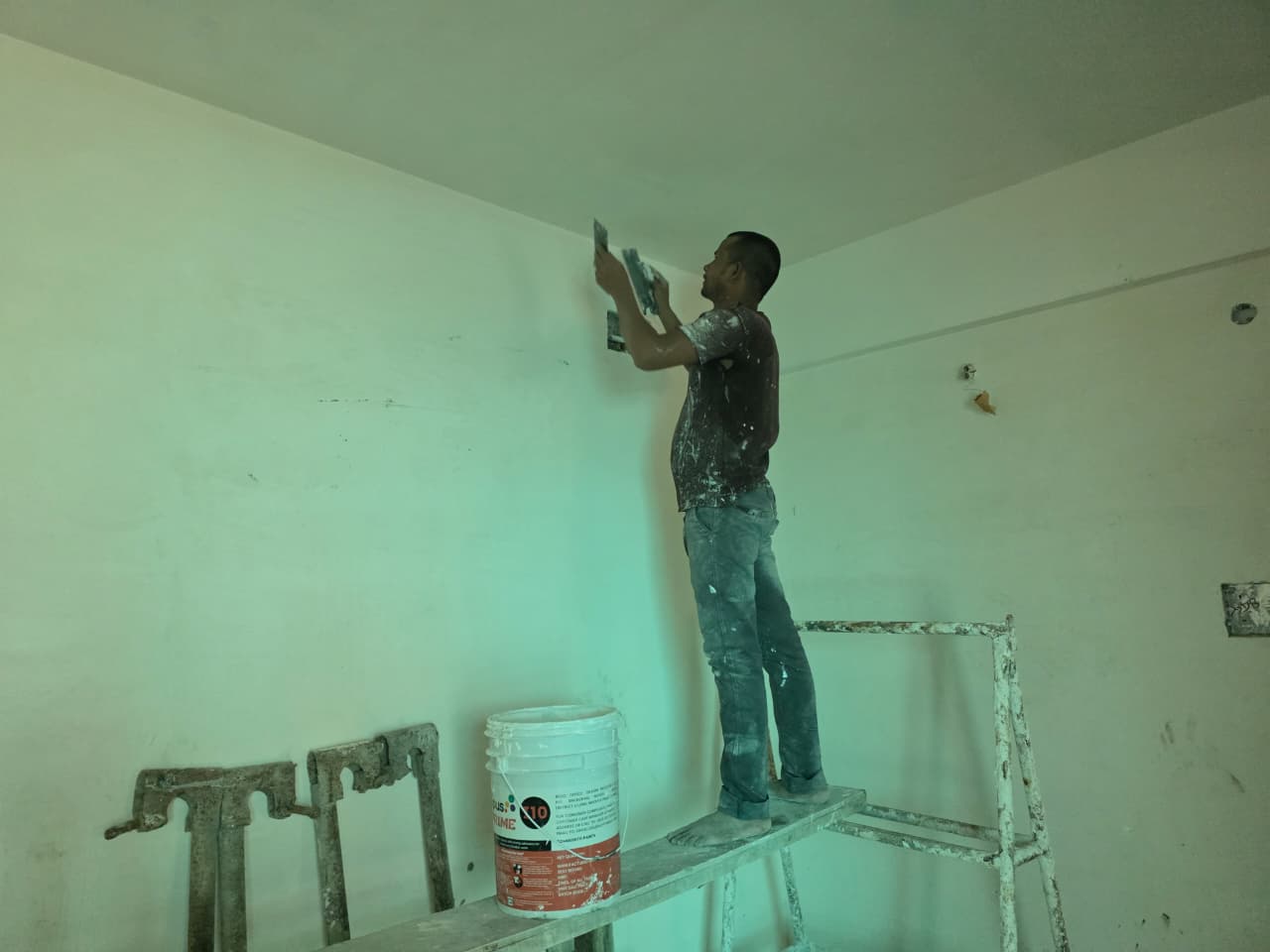

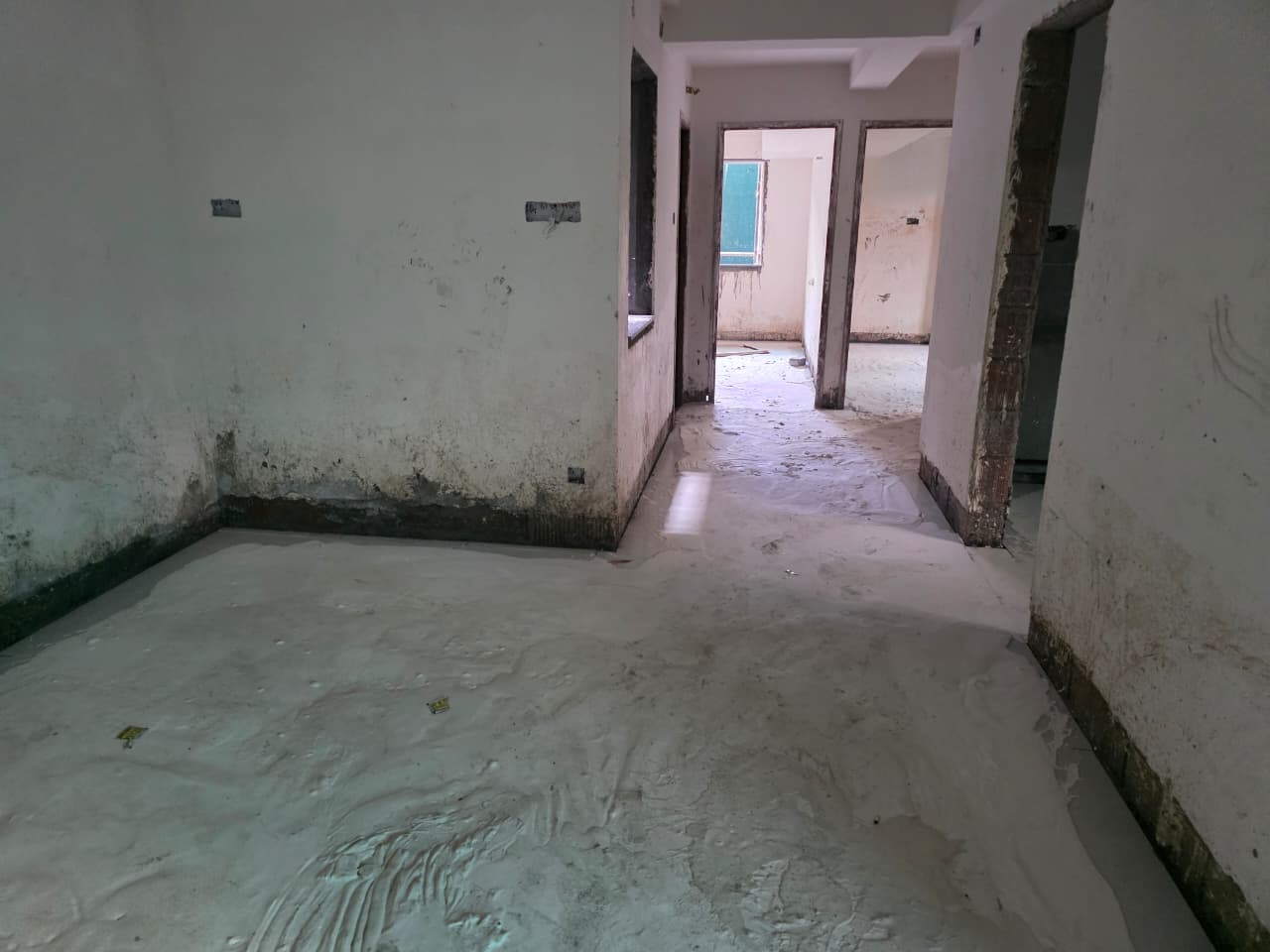

  • Inner putty work is in progress.(1st floor progress)

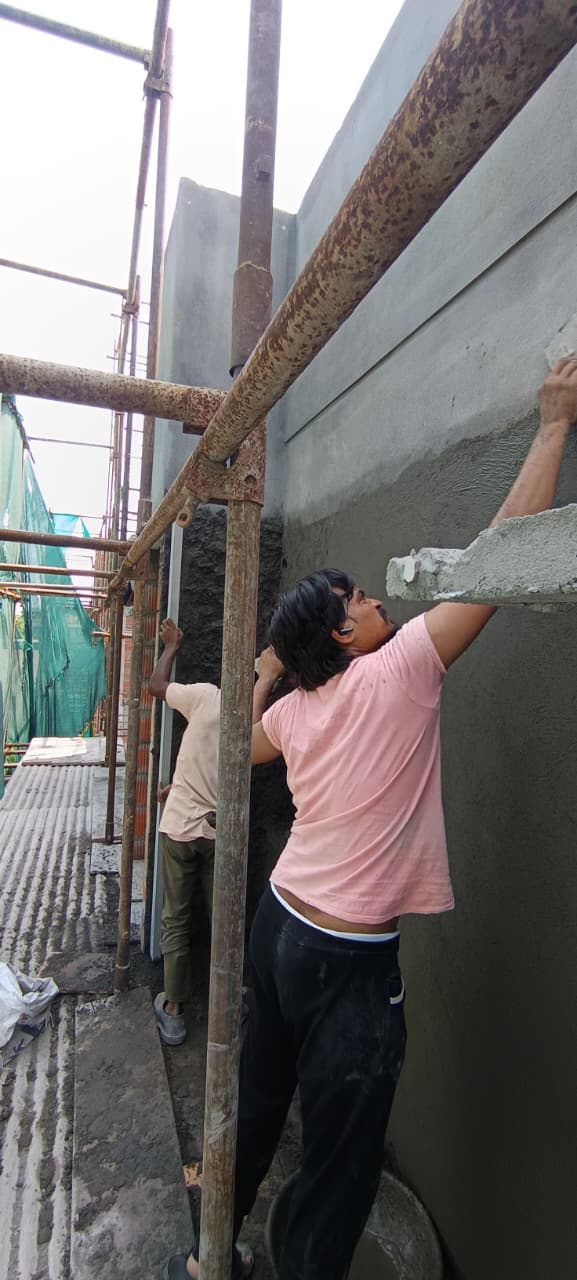

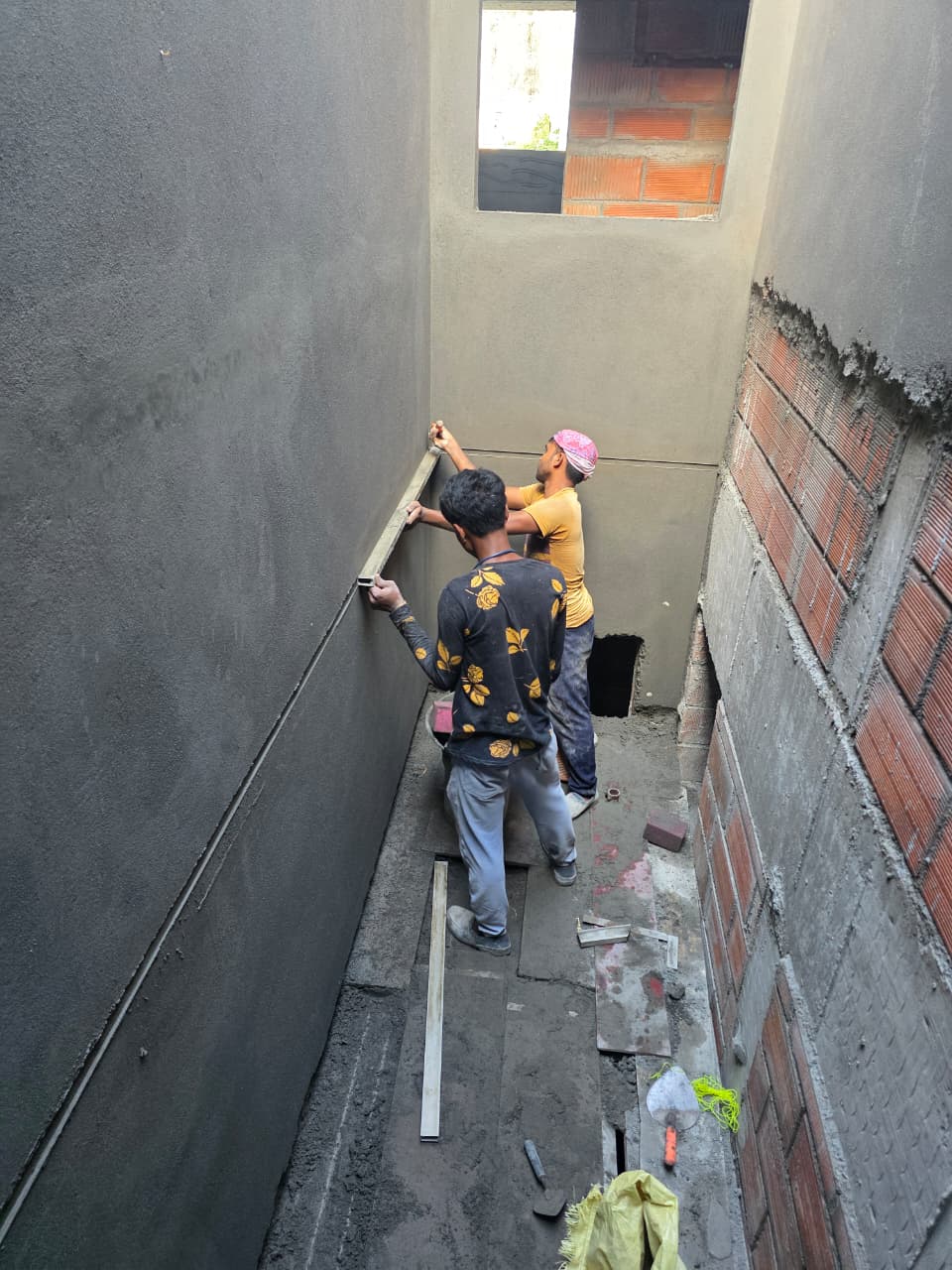

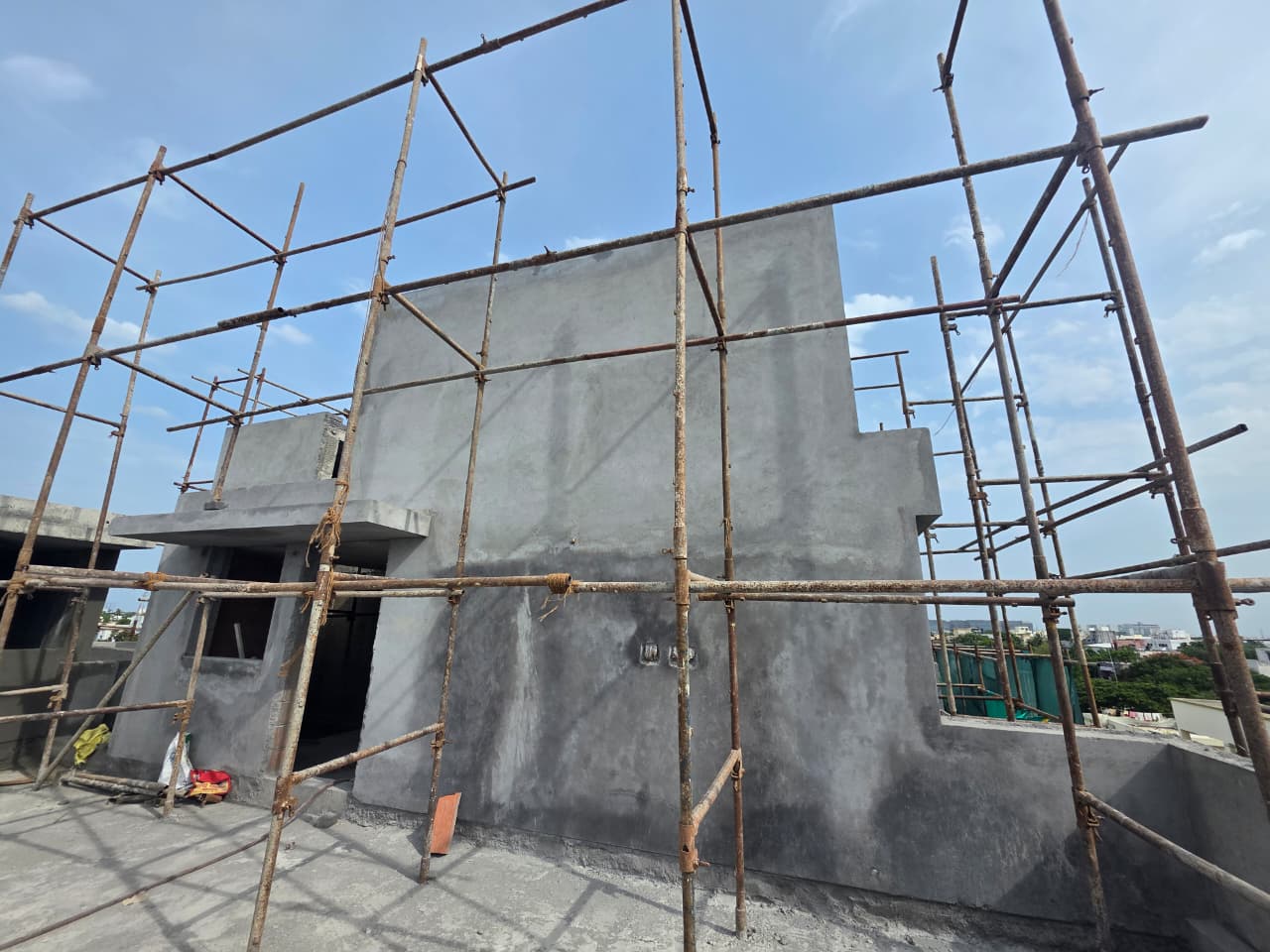

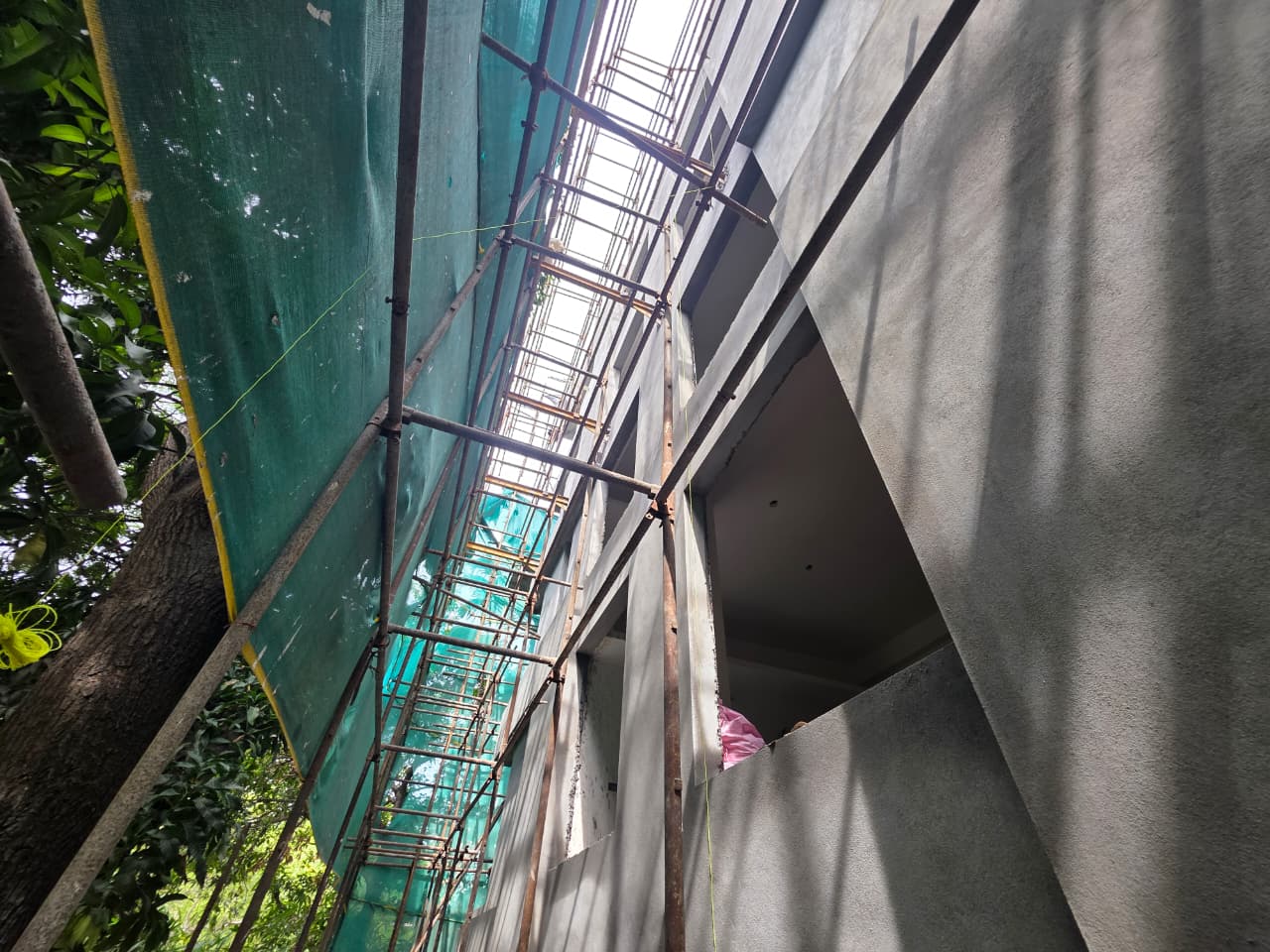

  • External plastering work is in progress.(50% completed)

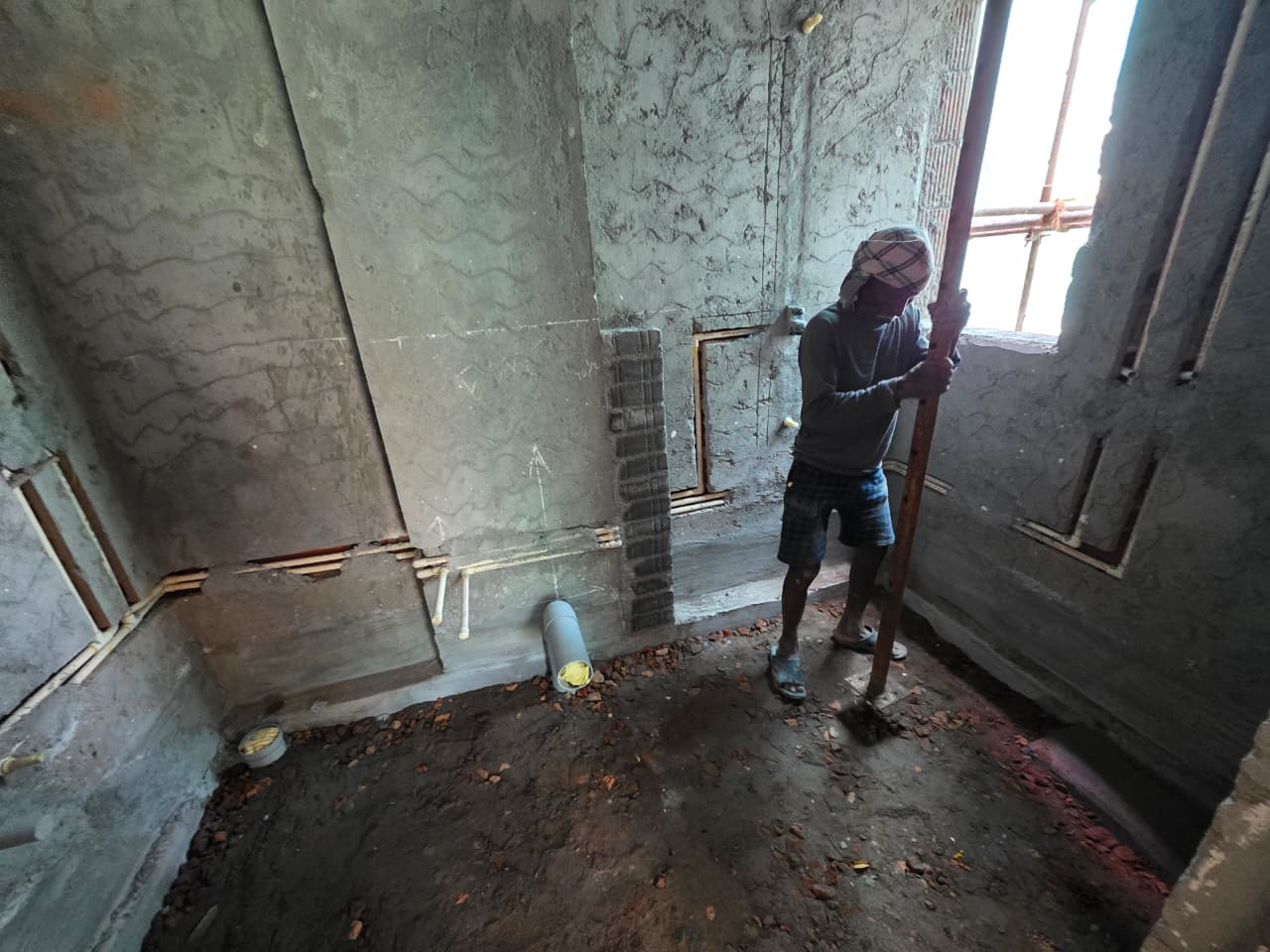

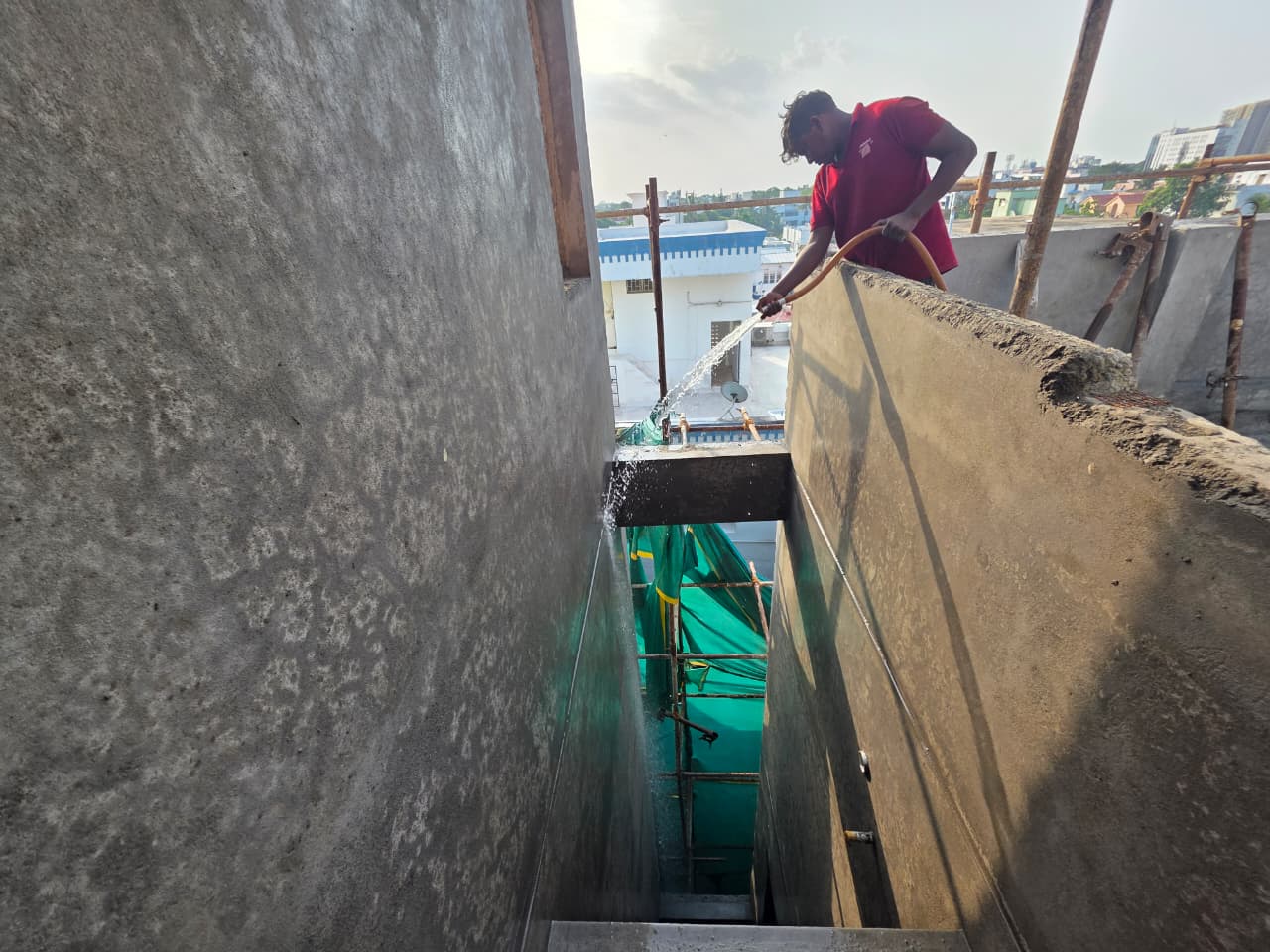

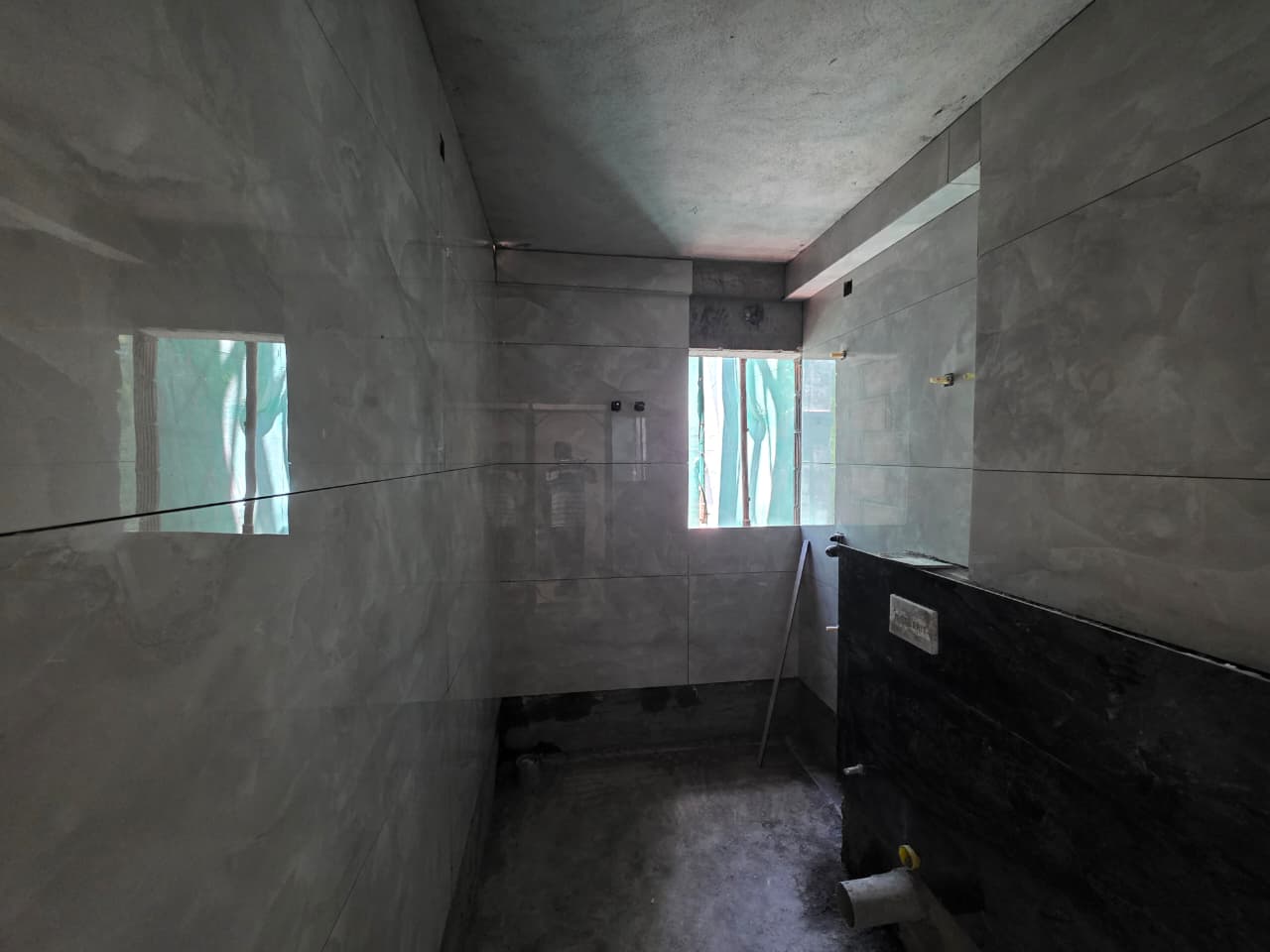

  • Toilet plumbing work is in progress.(up to 3rd floor completed, 4th & 5th floor progress)

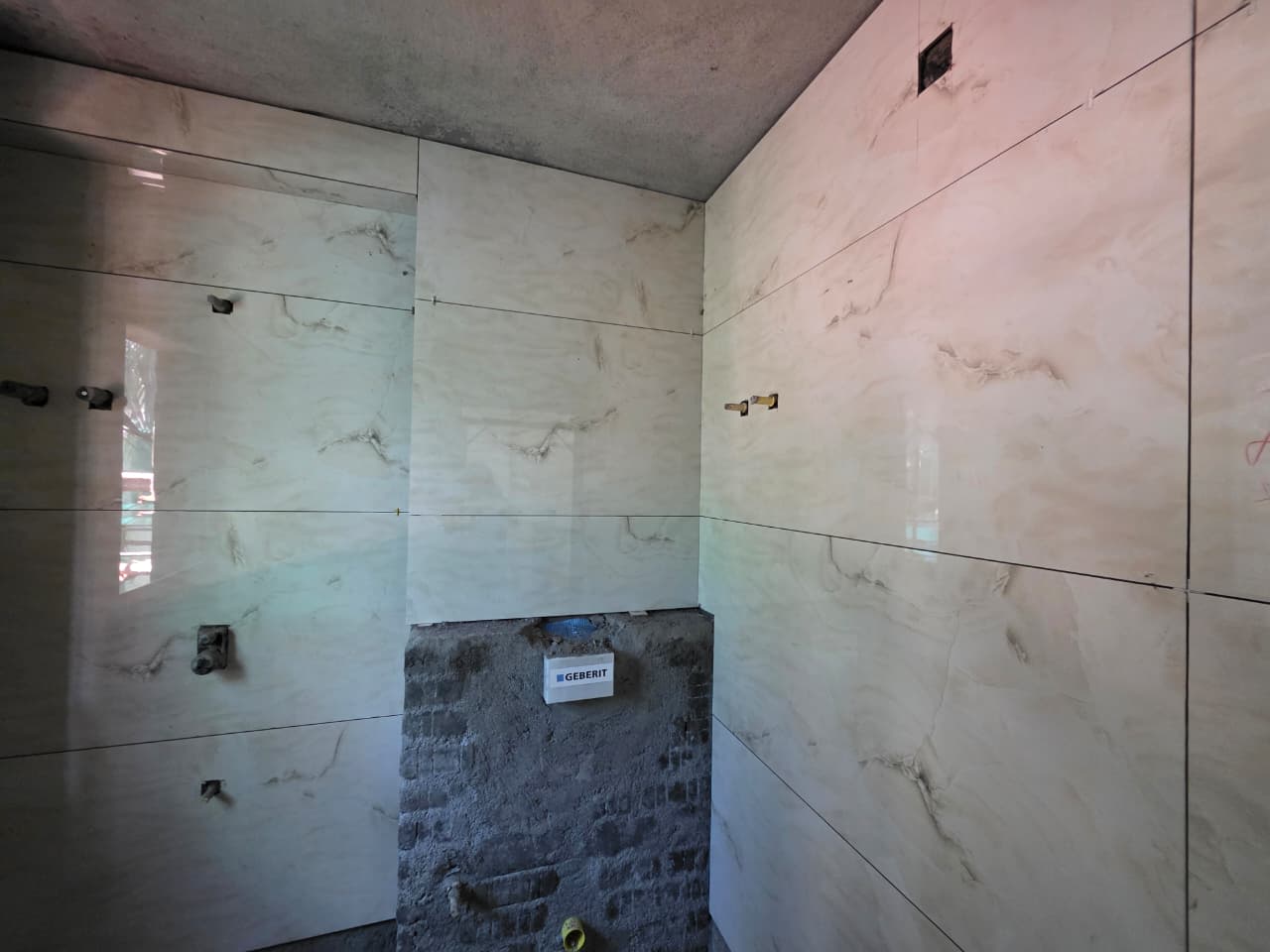

  • Toilet wall tiles work is in progress. (1st & 2nd floor progress)

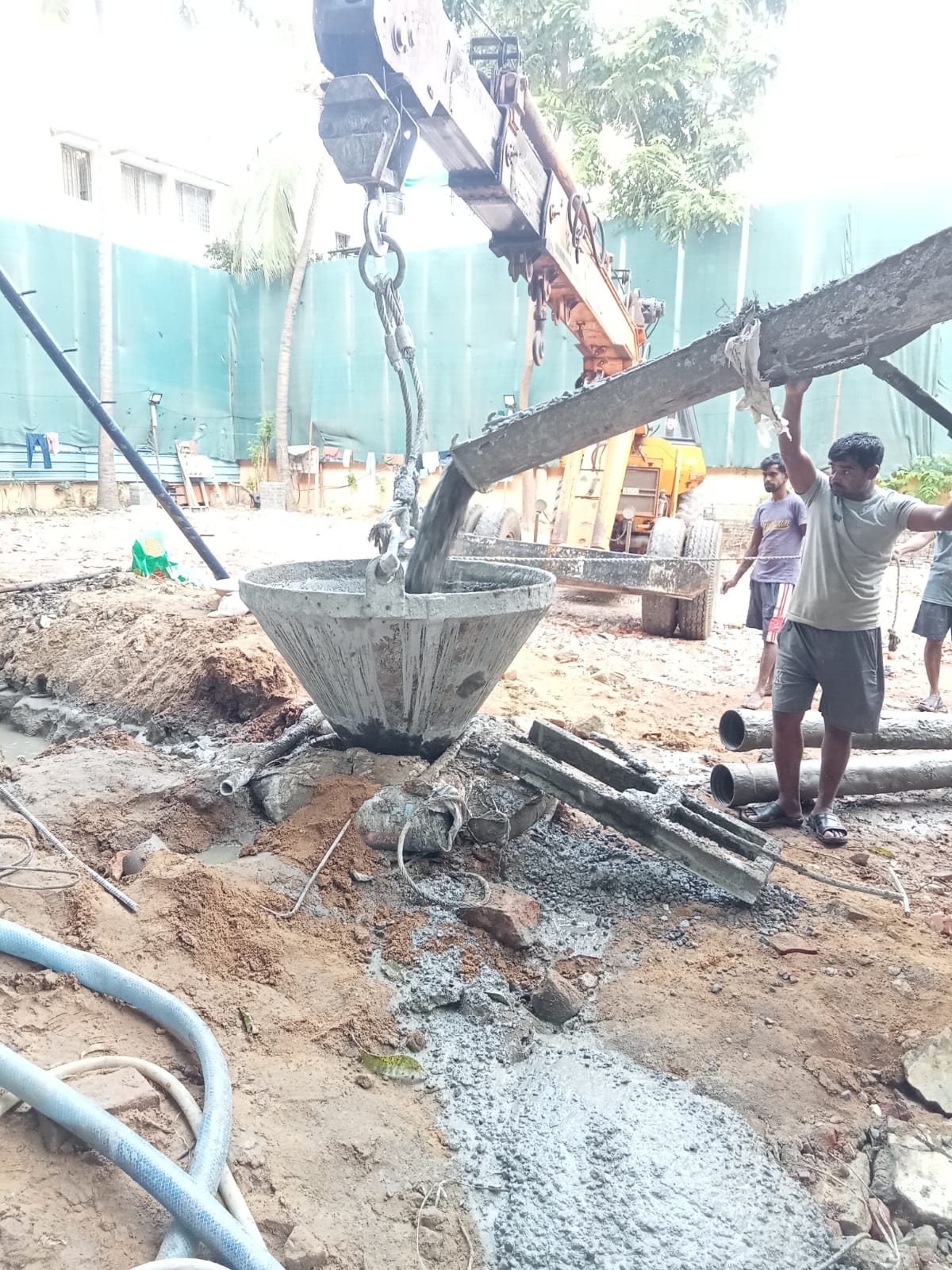

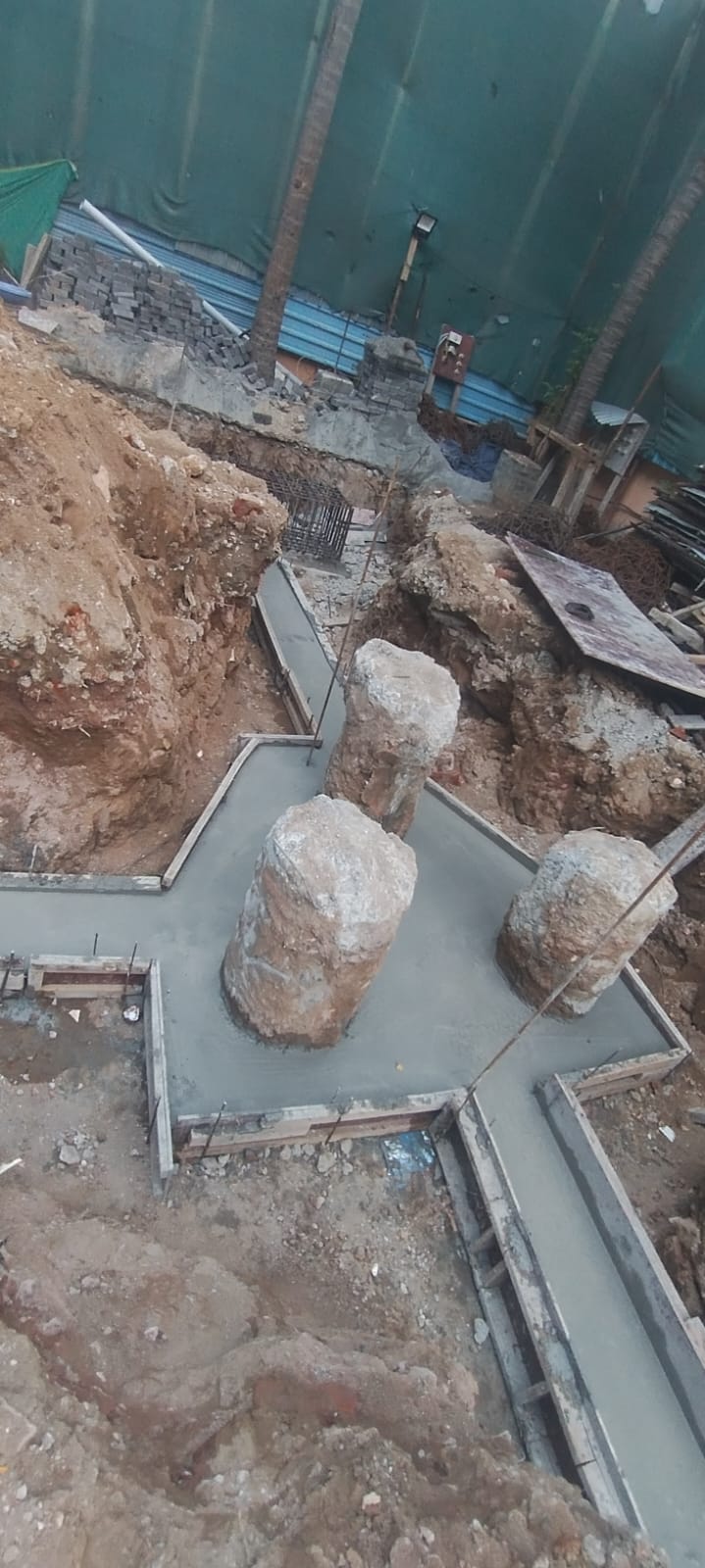

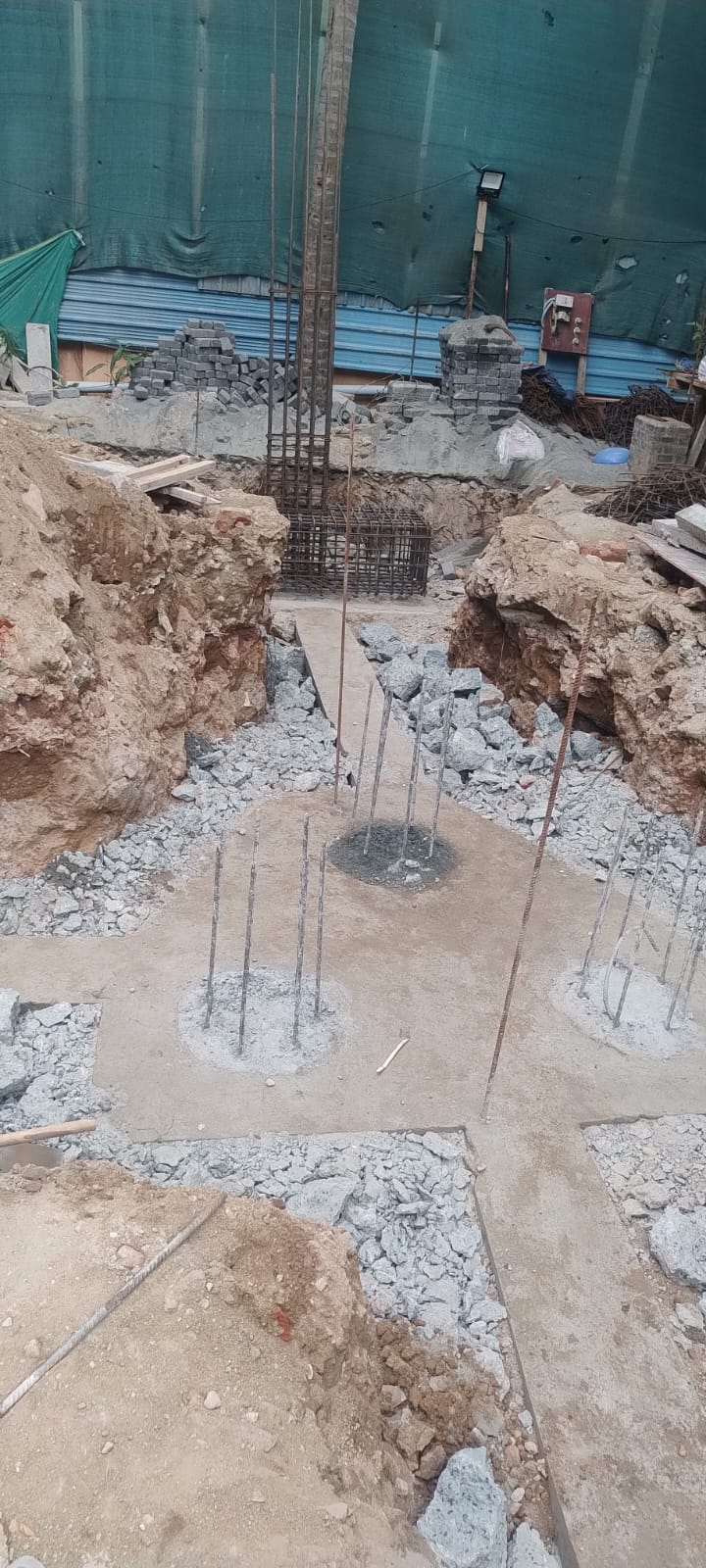

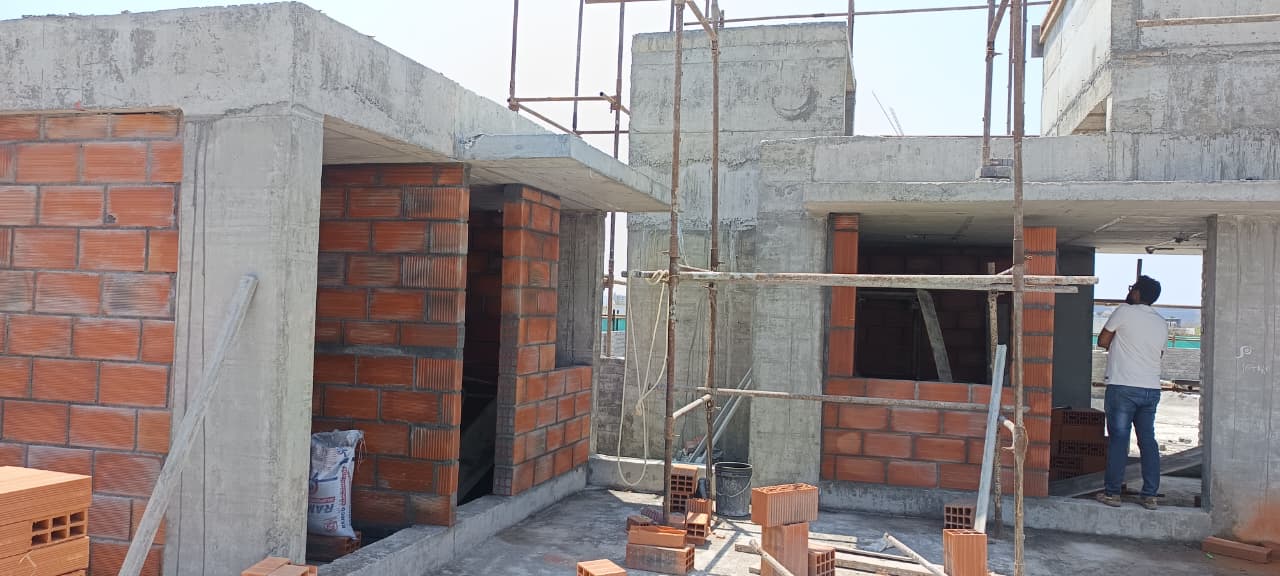

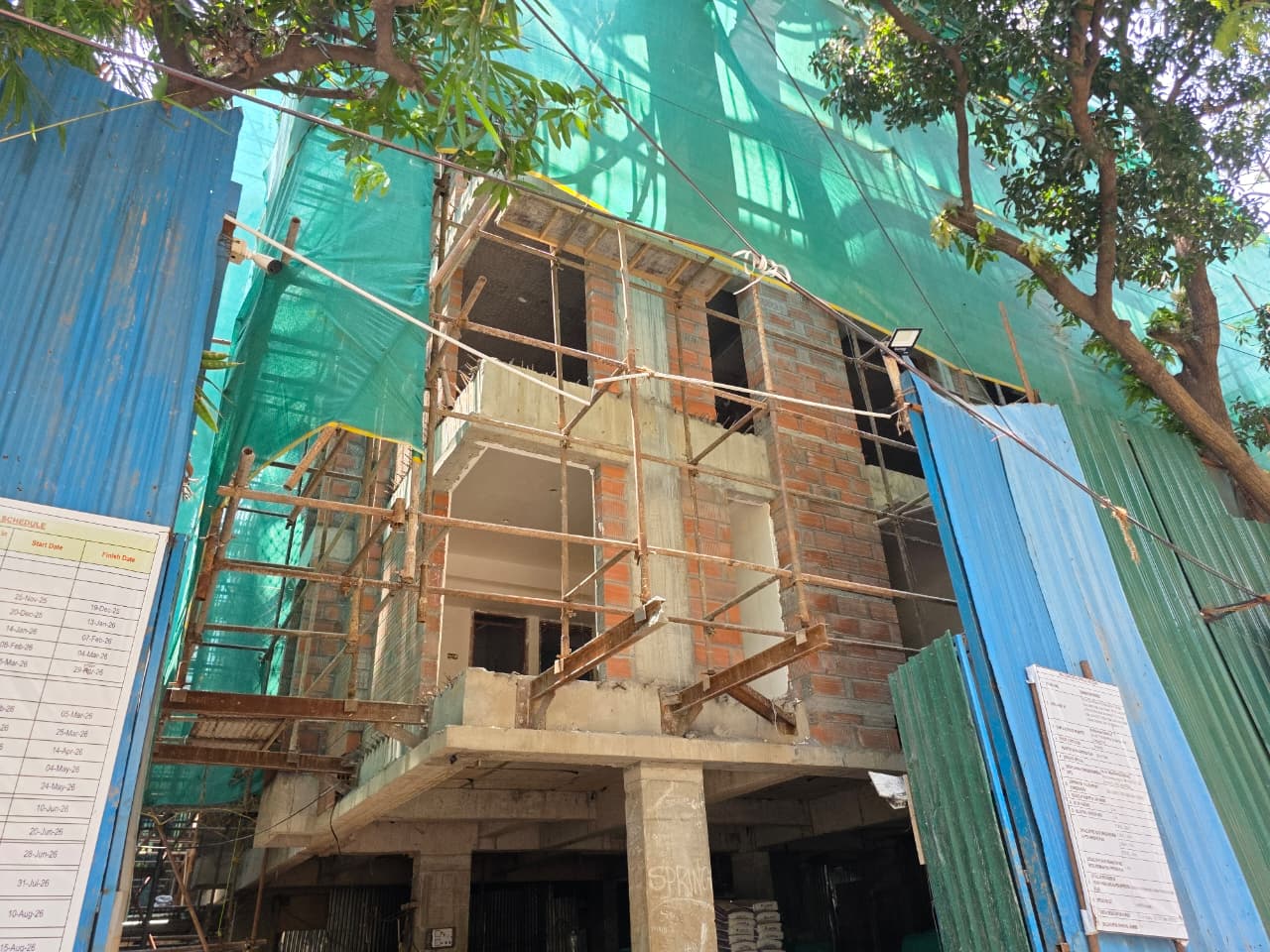

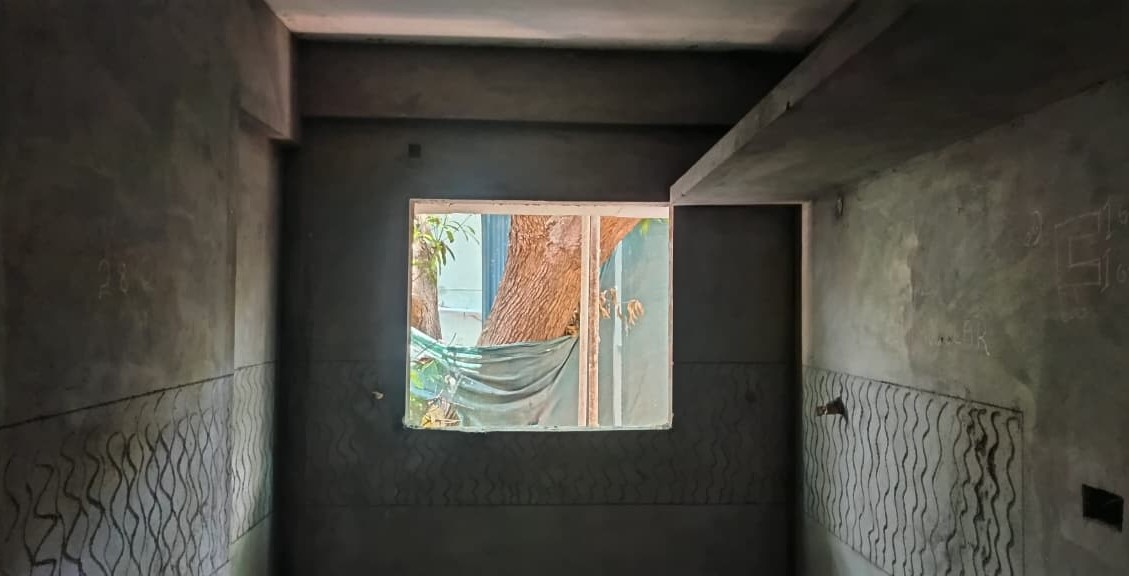

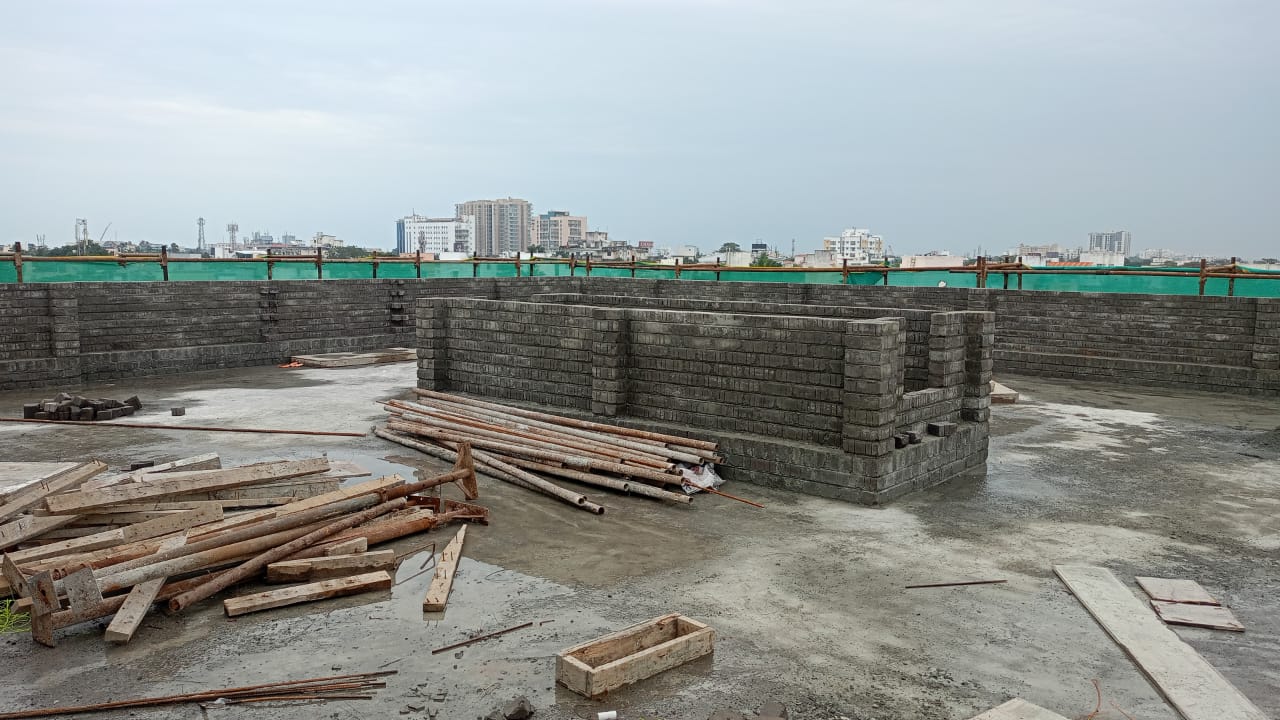

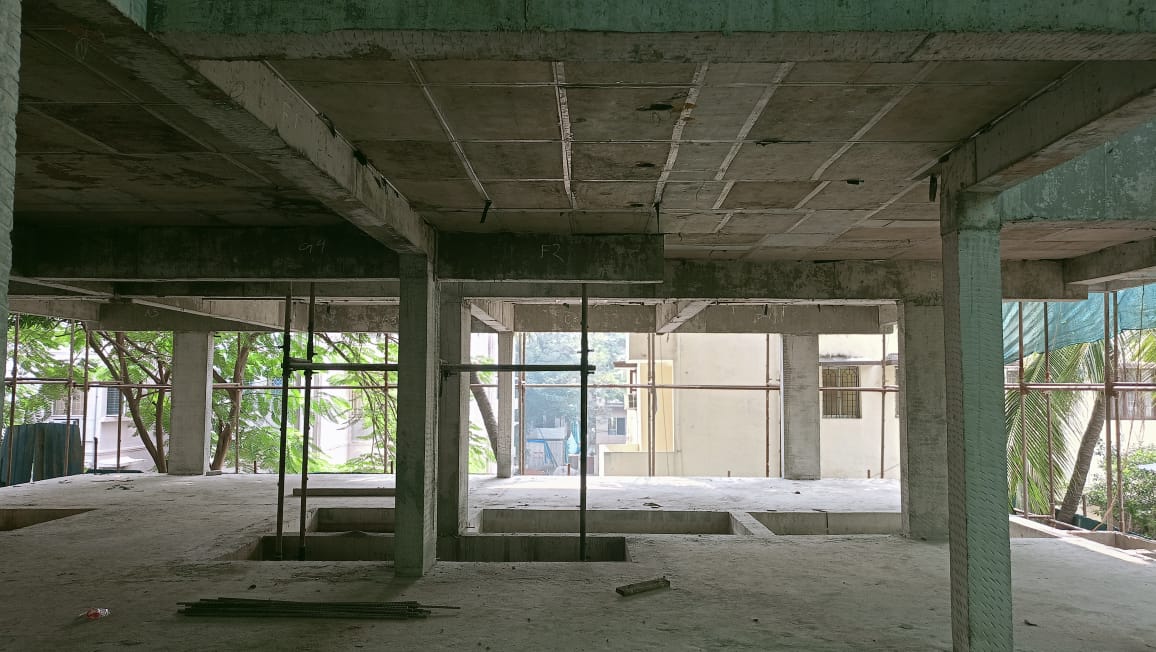

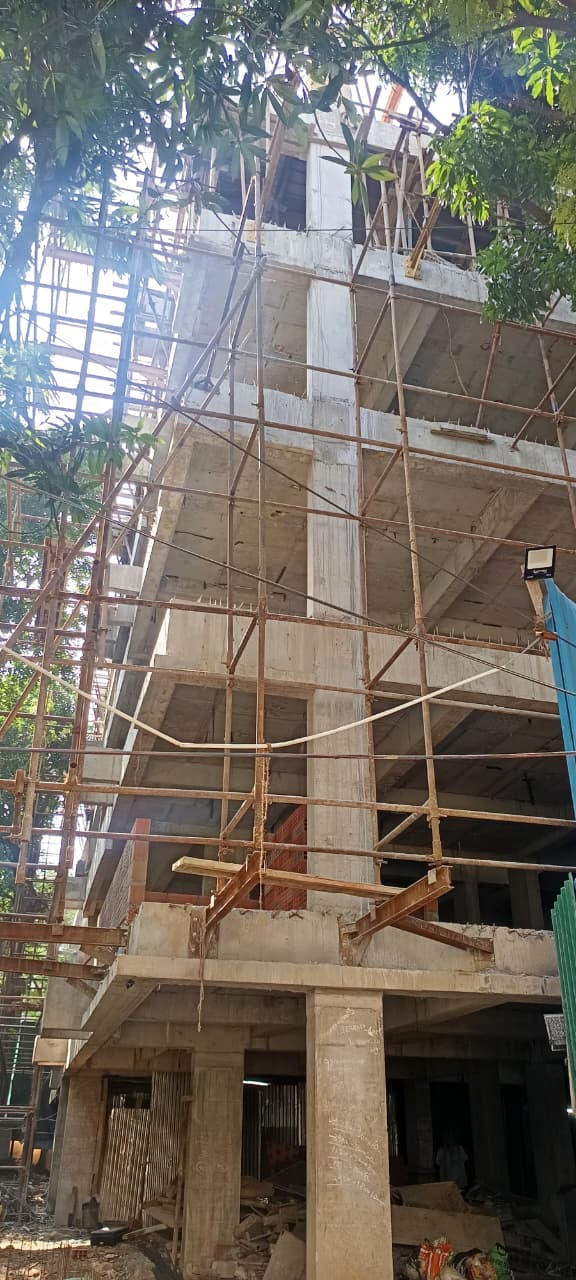

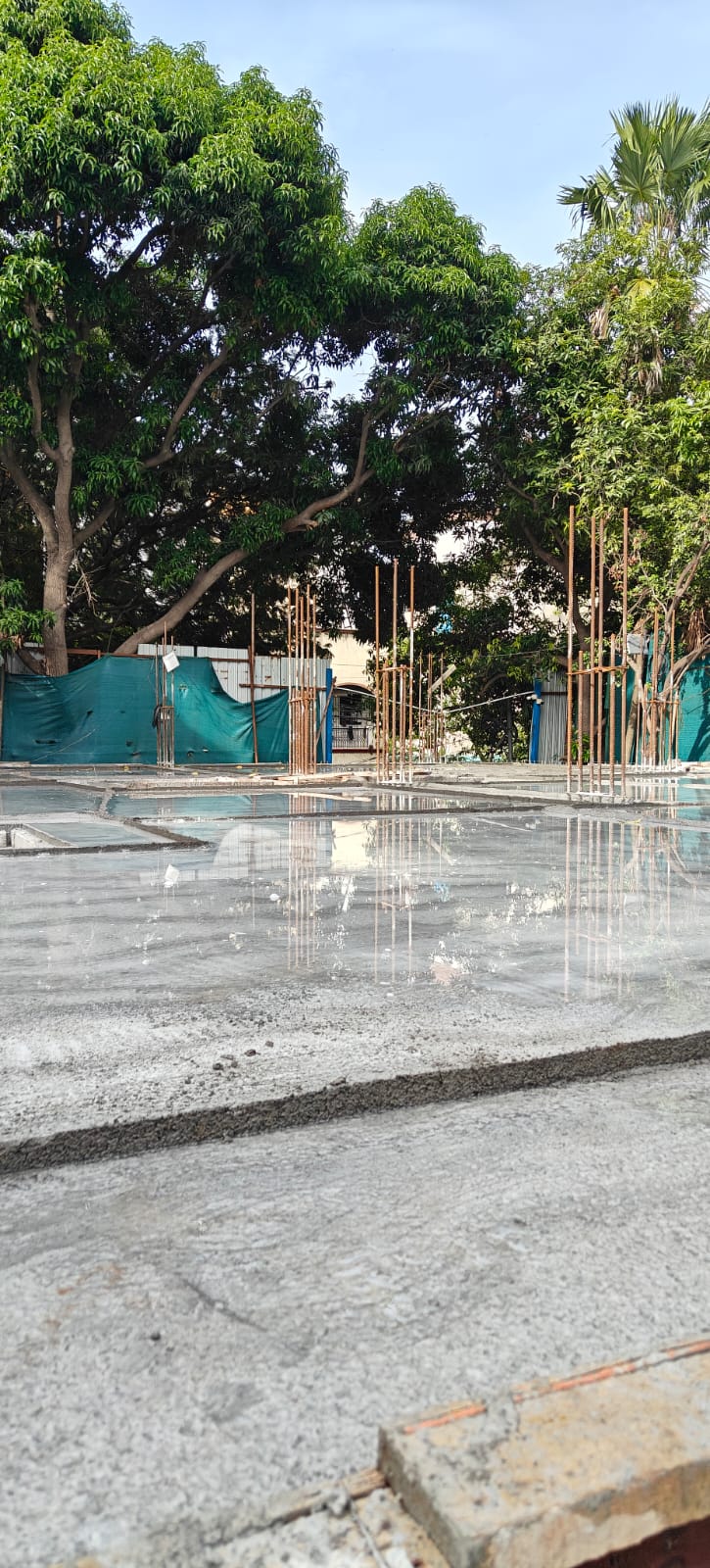

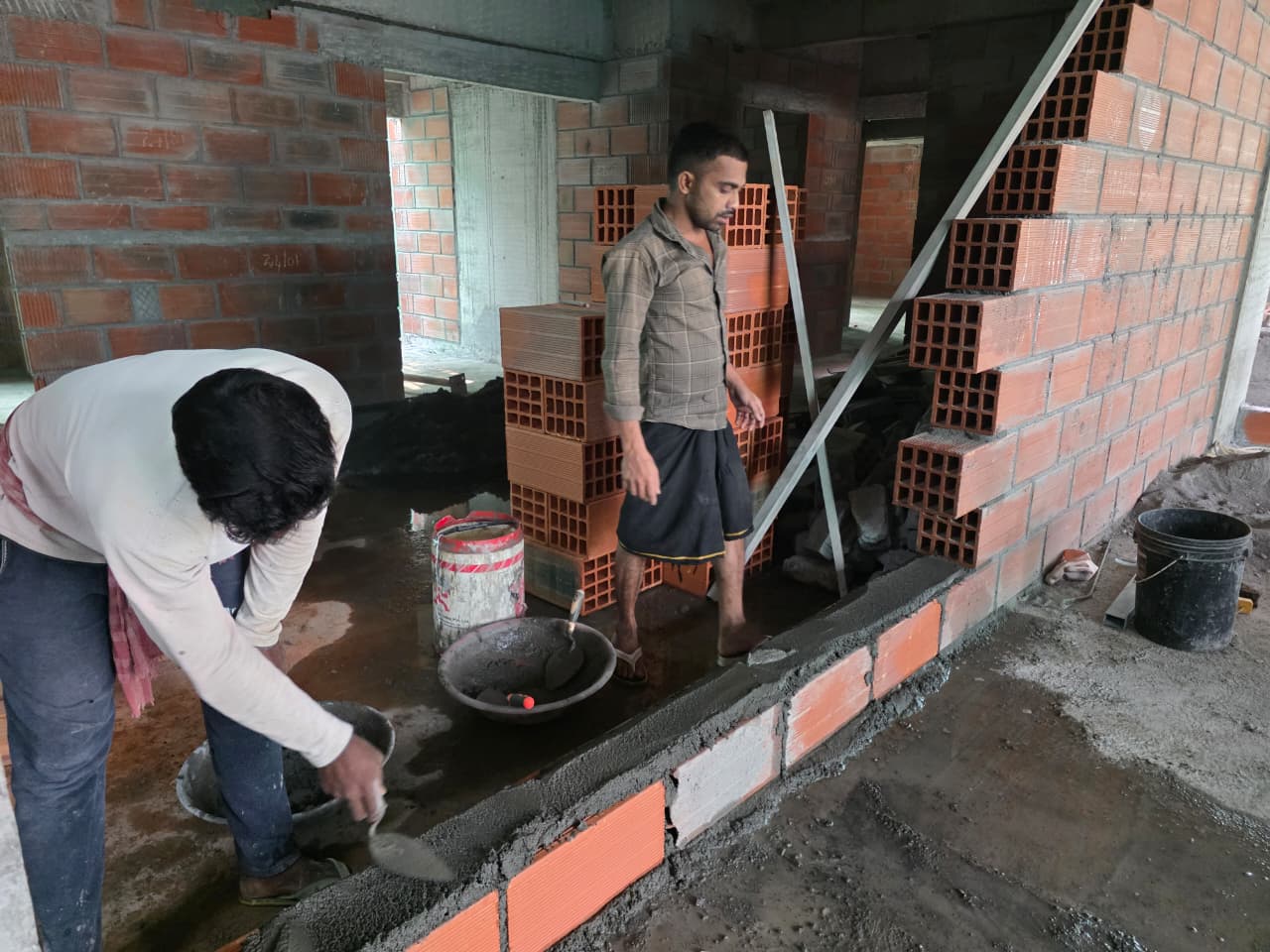

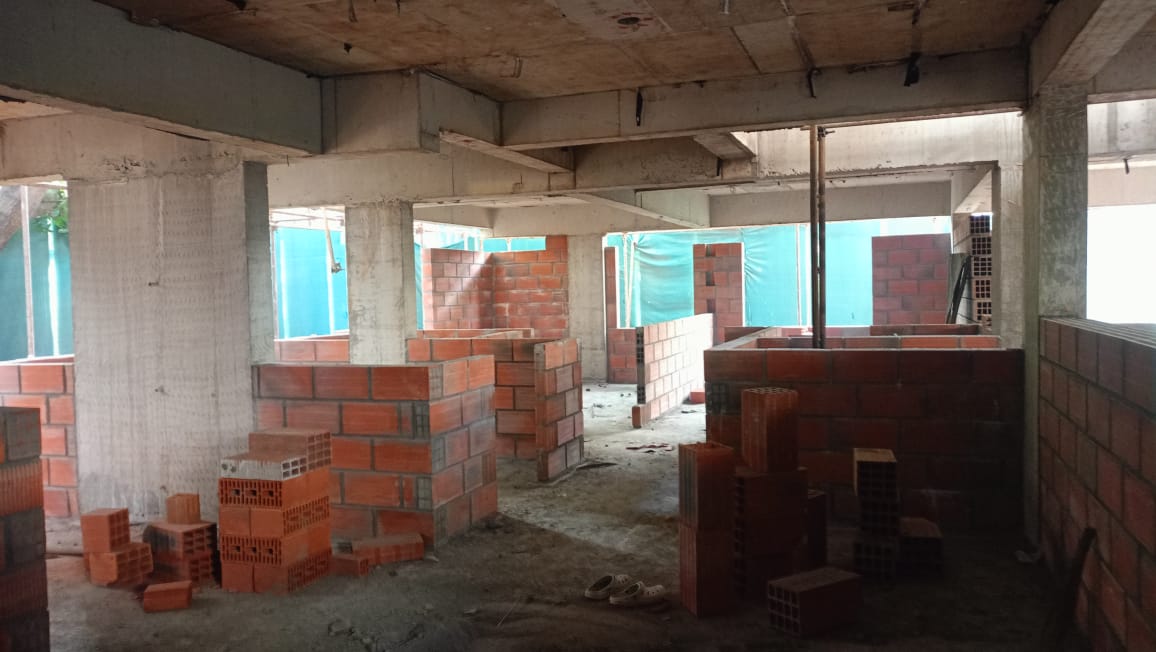

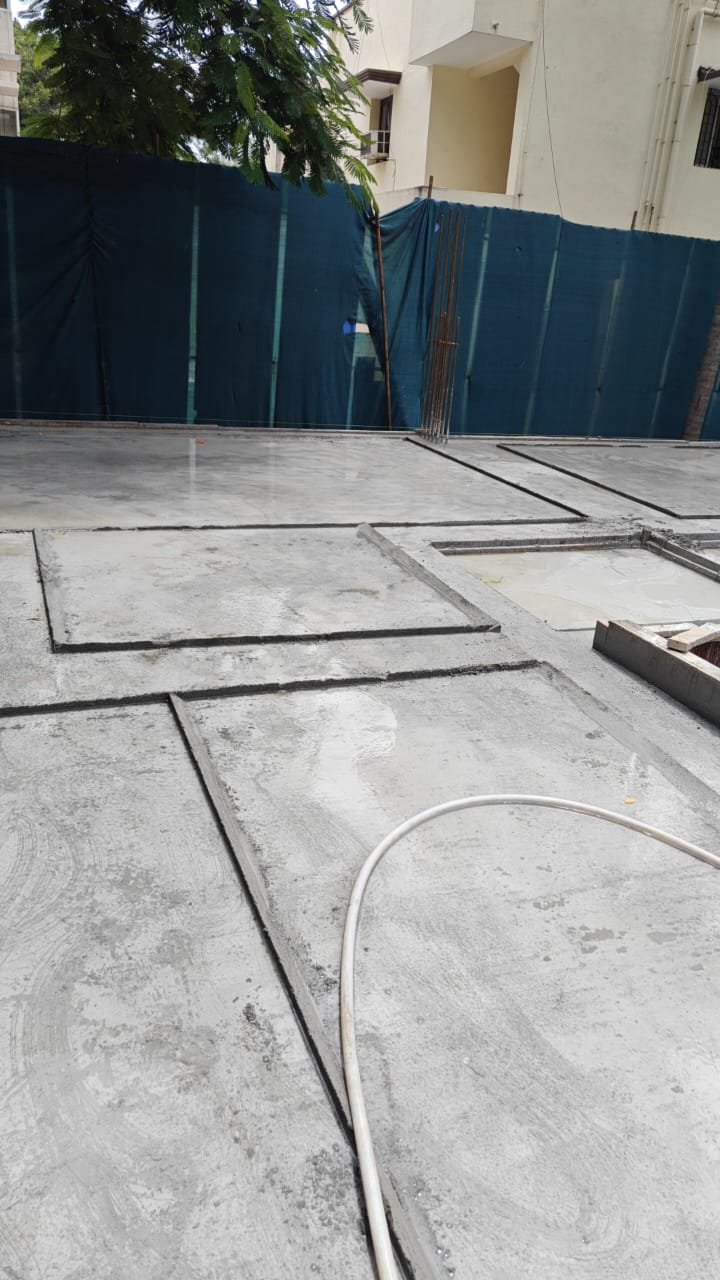

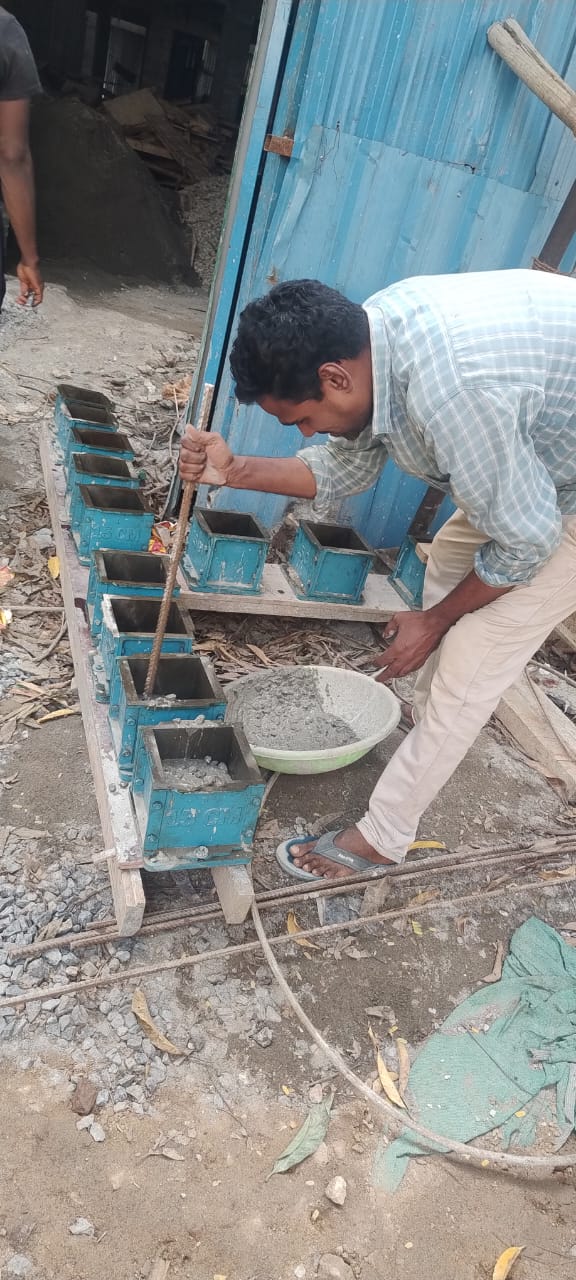

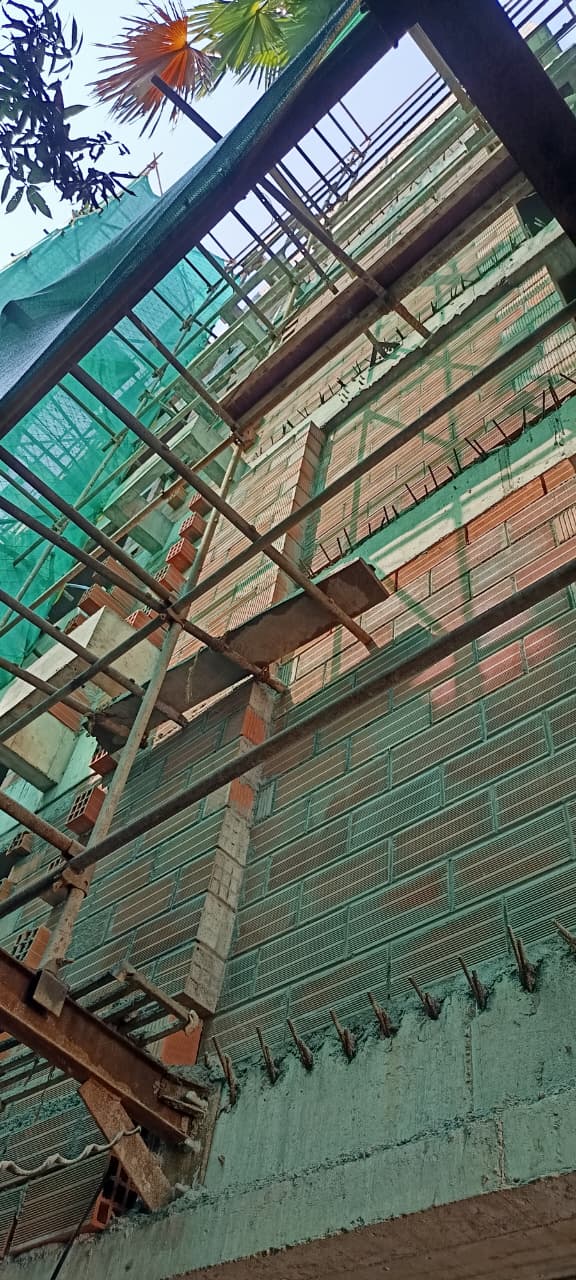

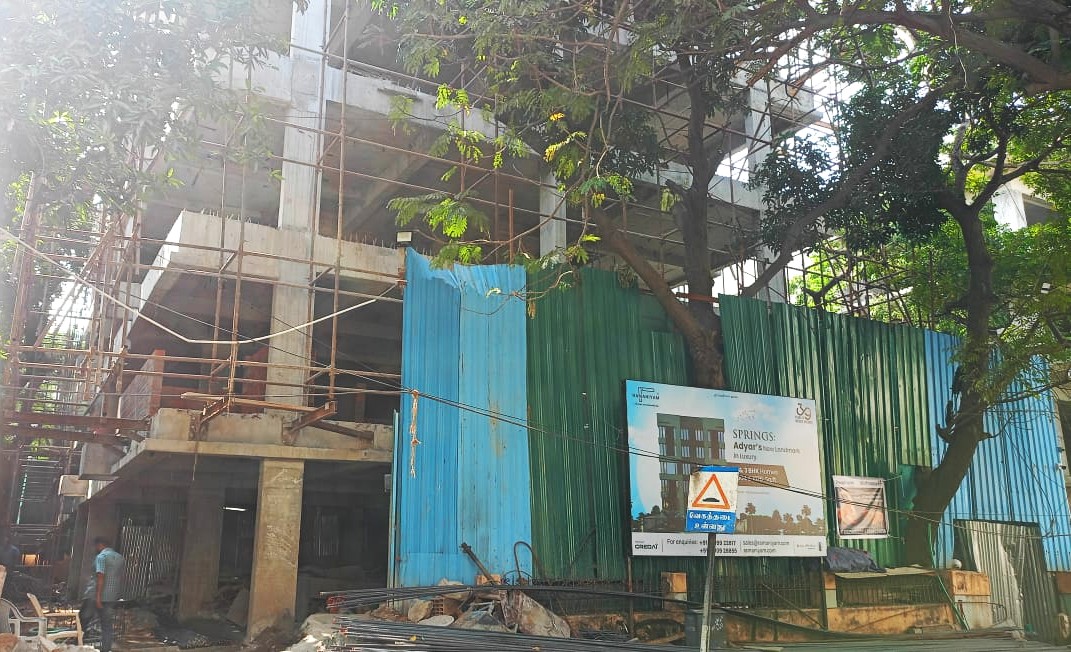

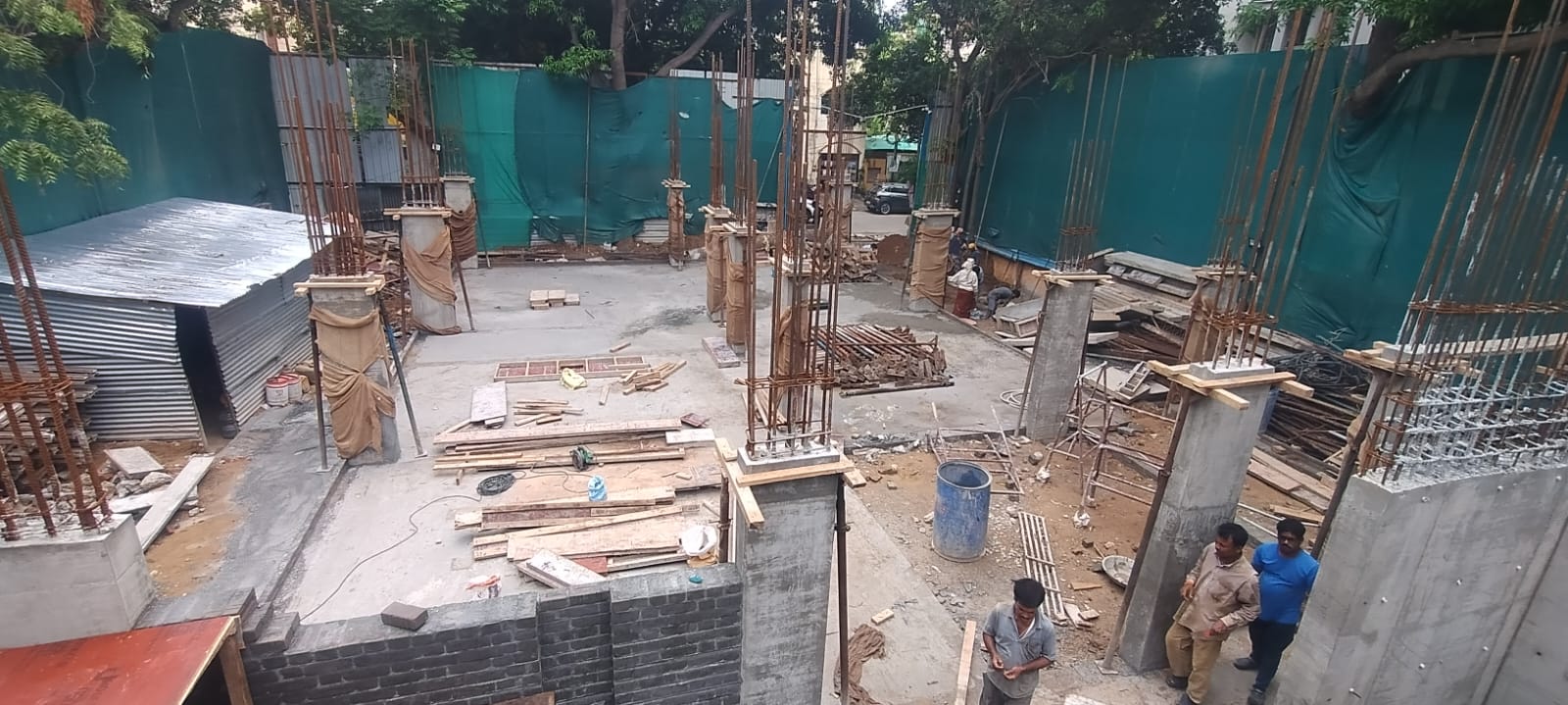

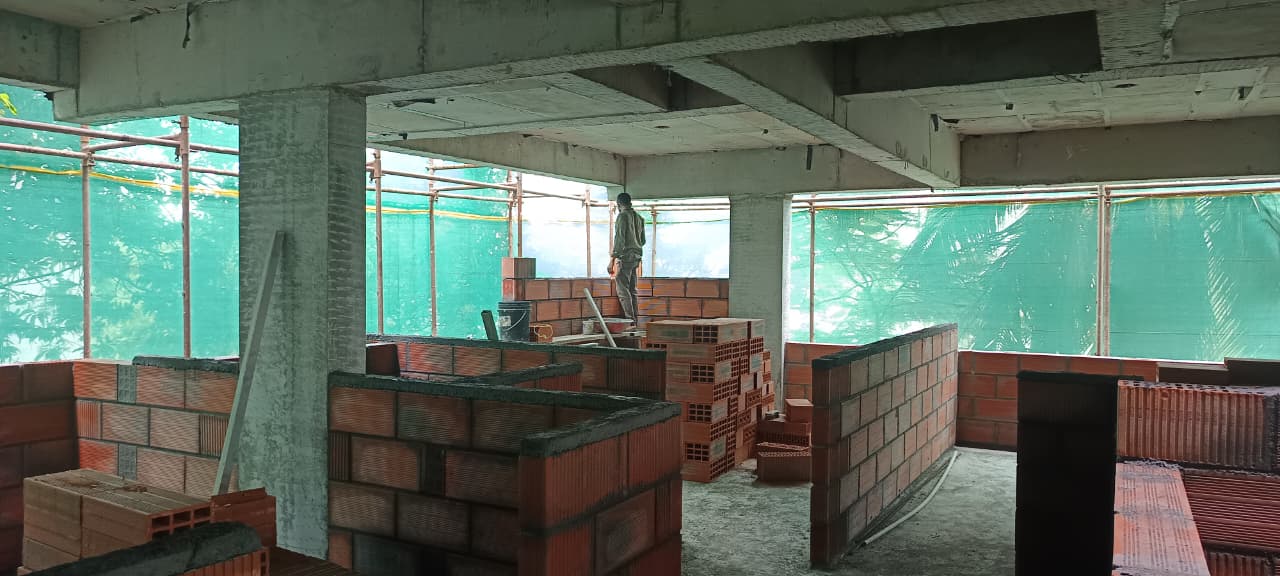

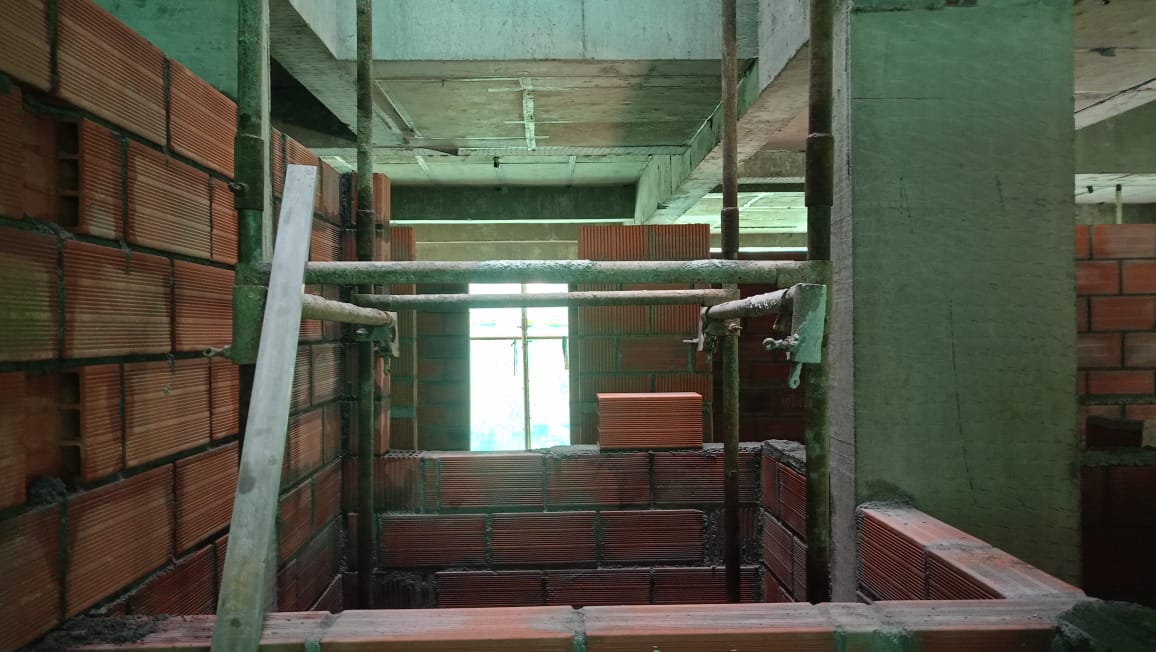

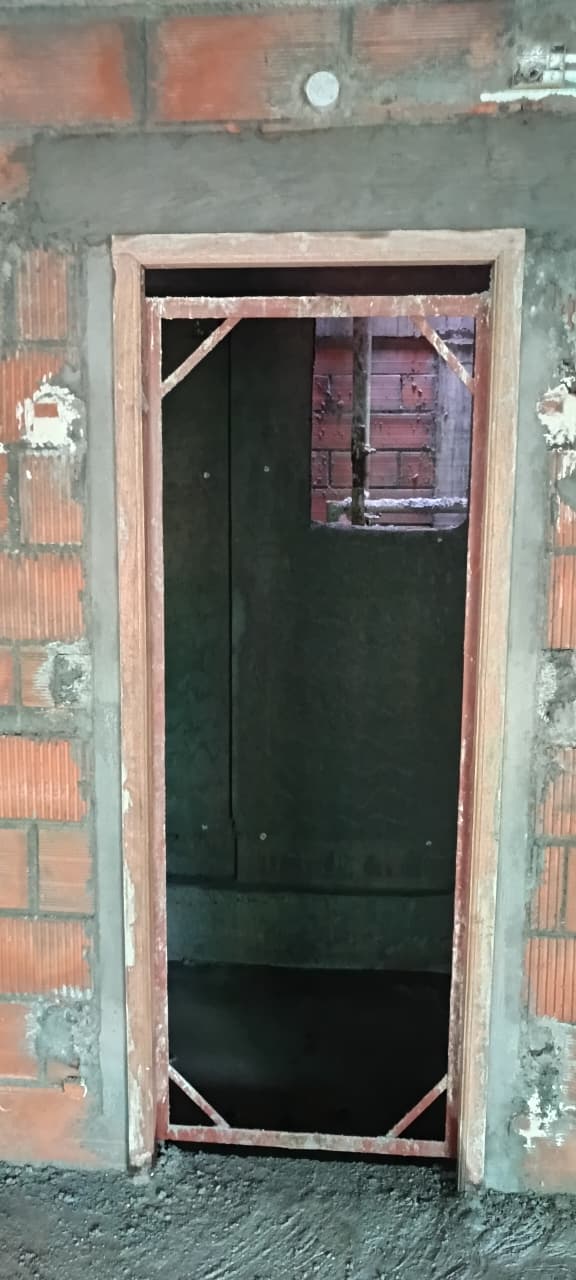

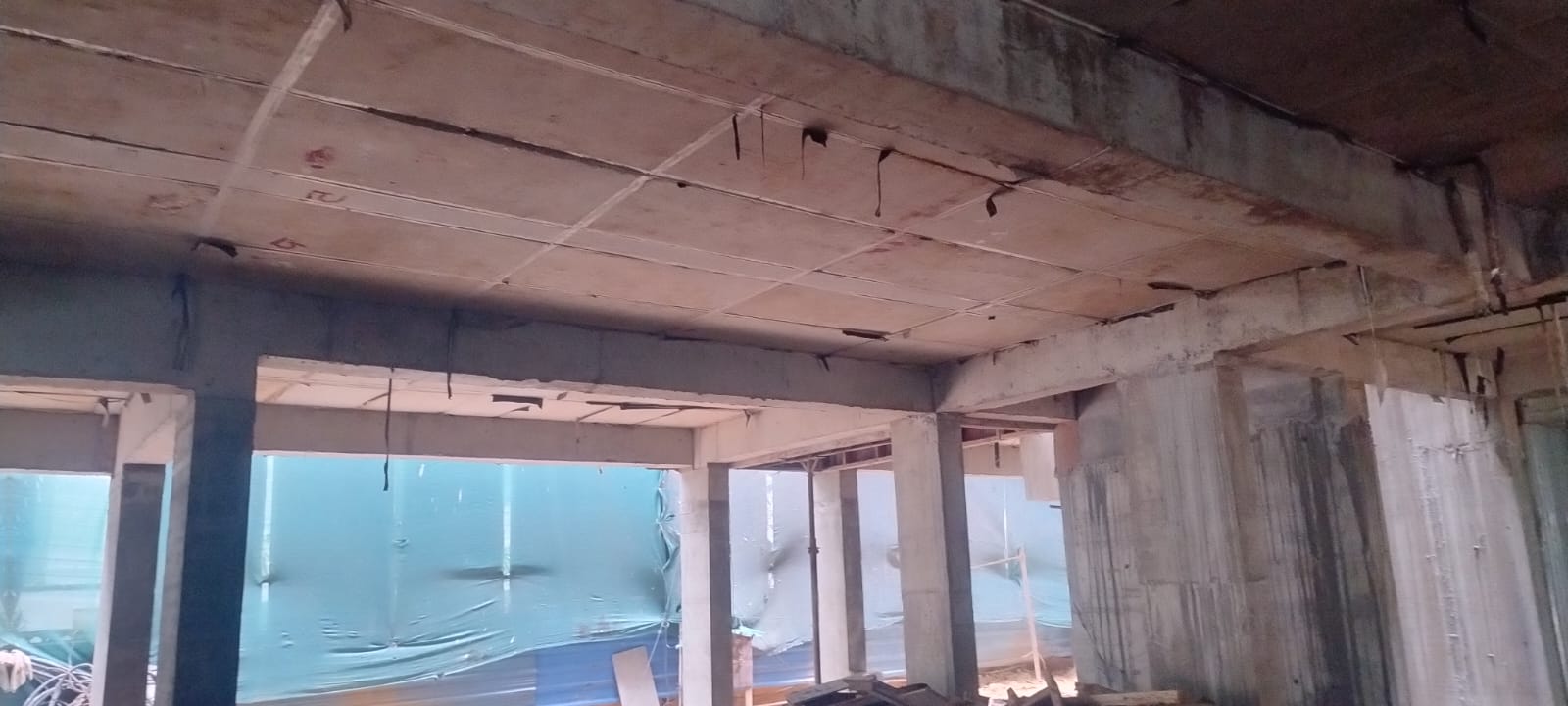

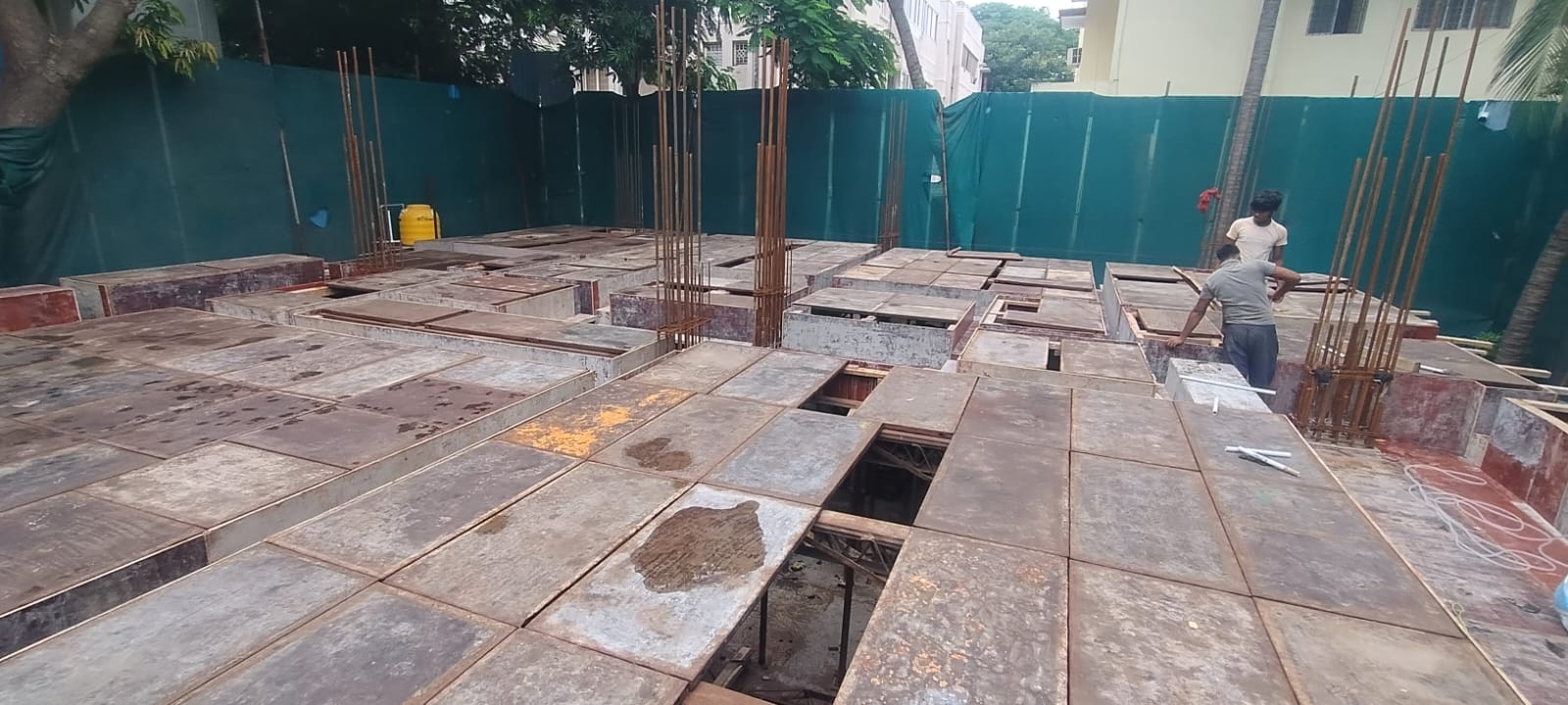

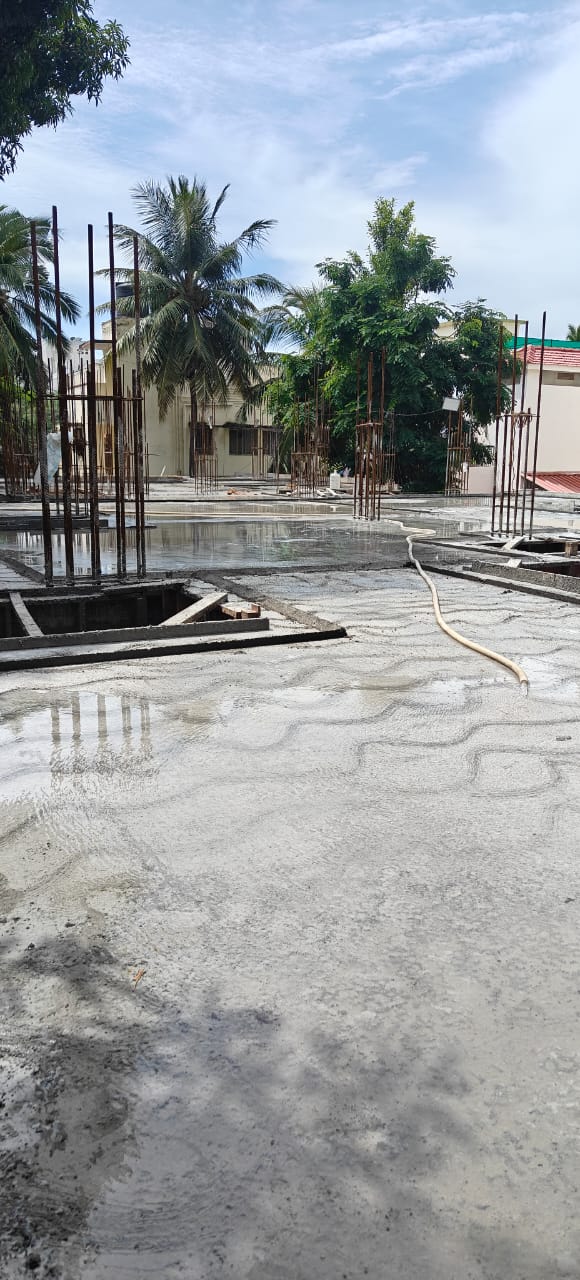

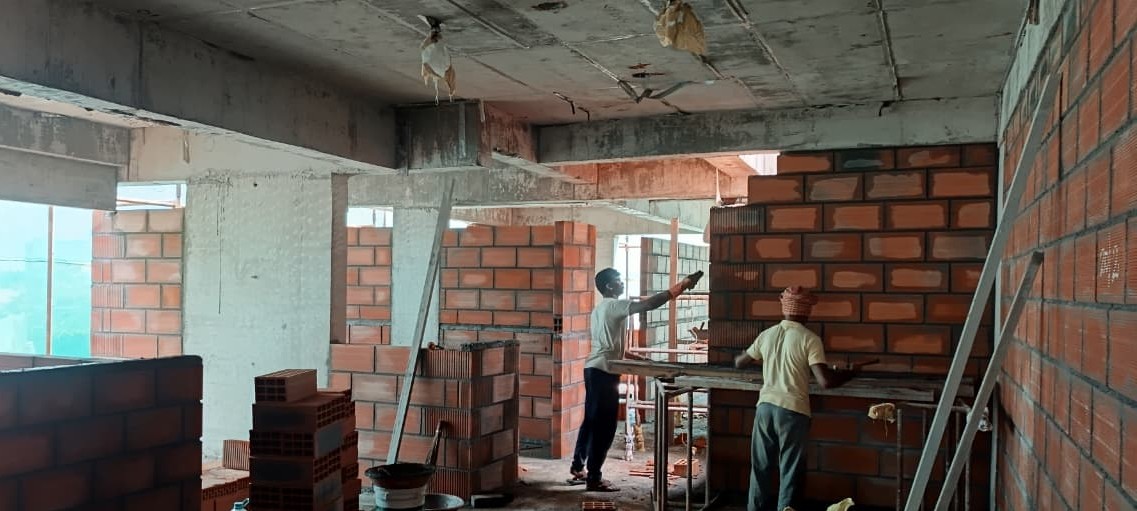

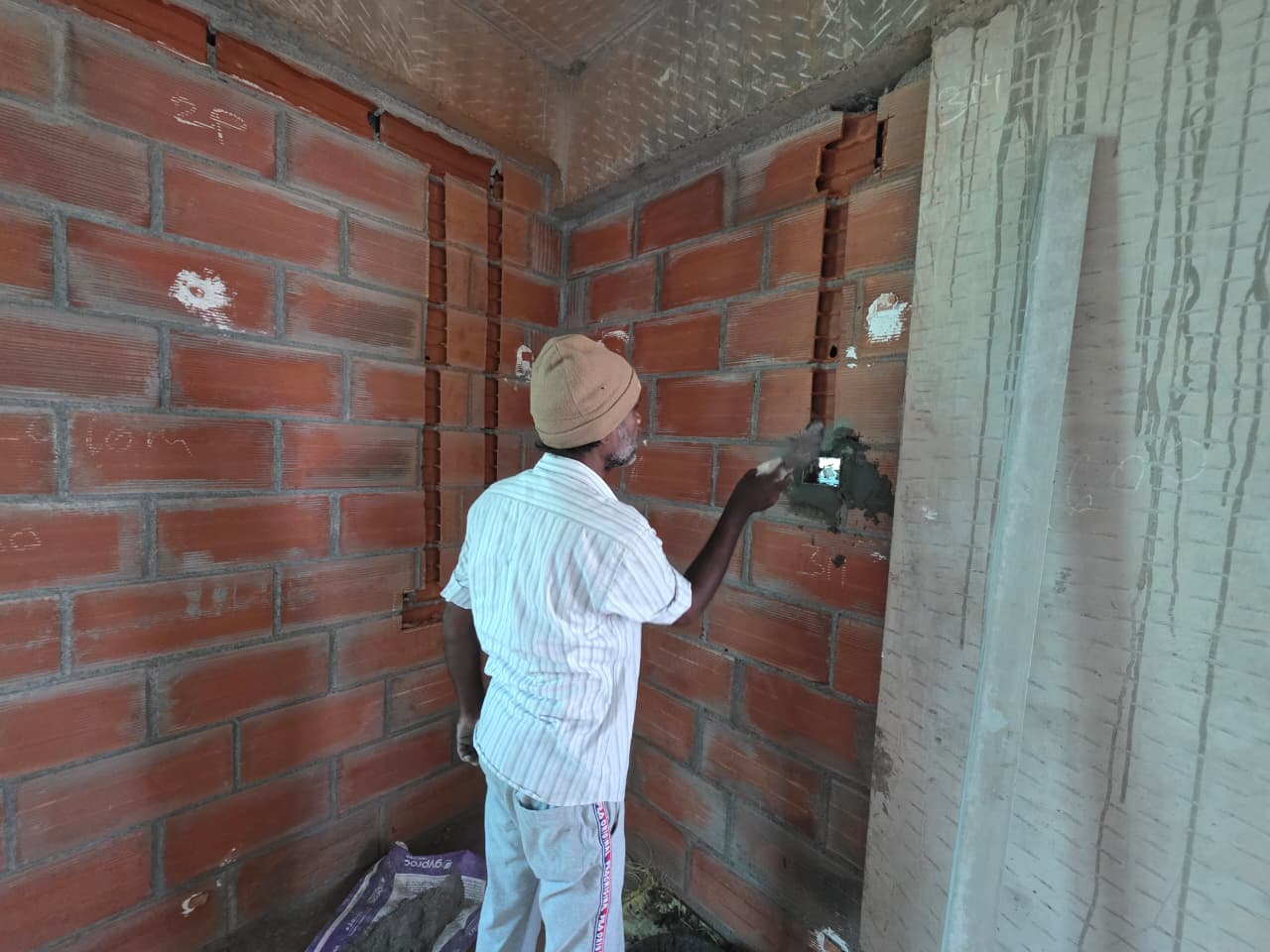

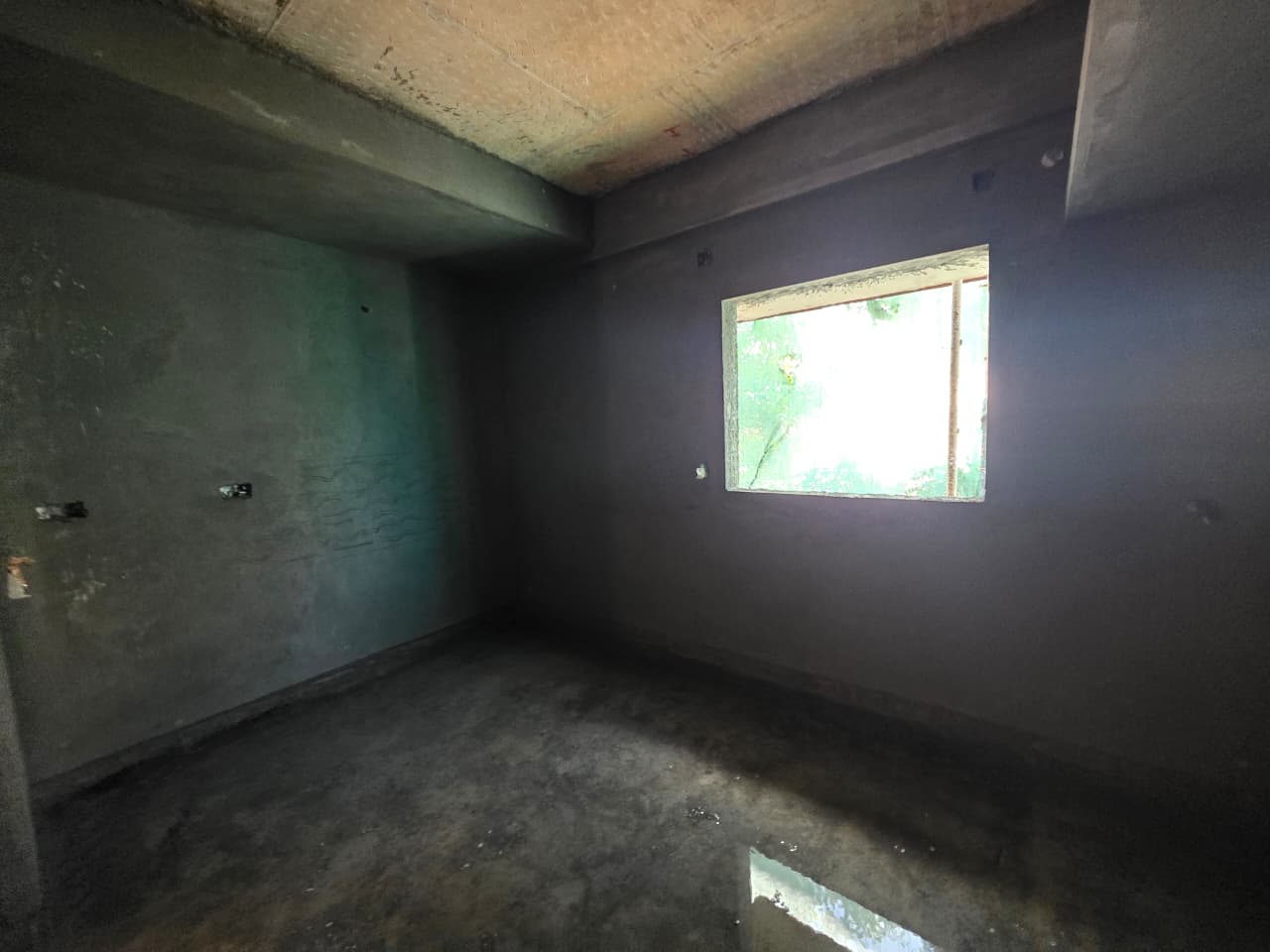

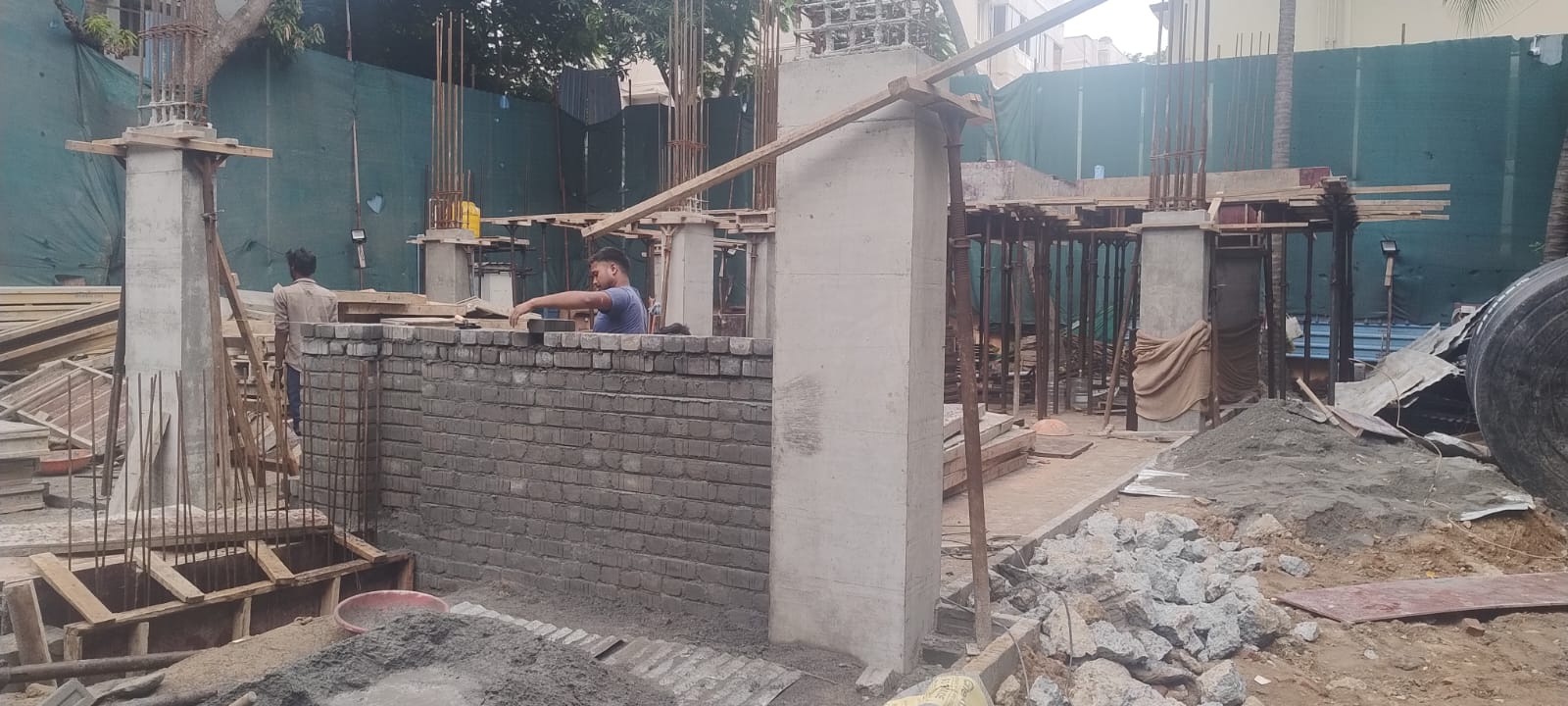

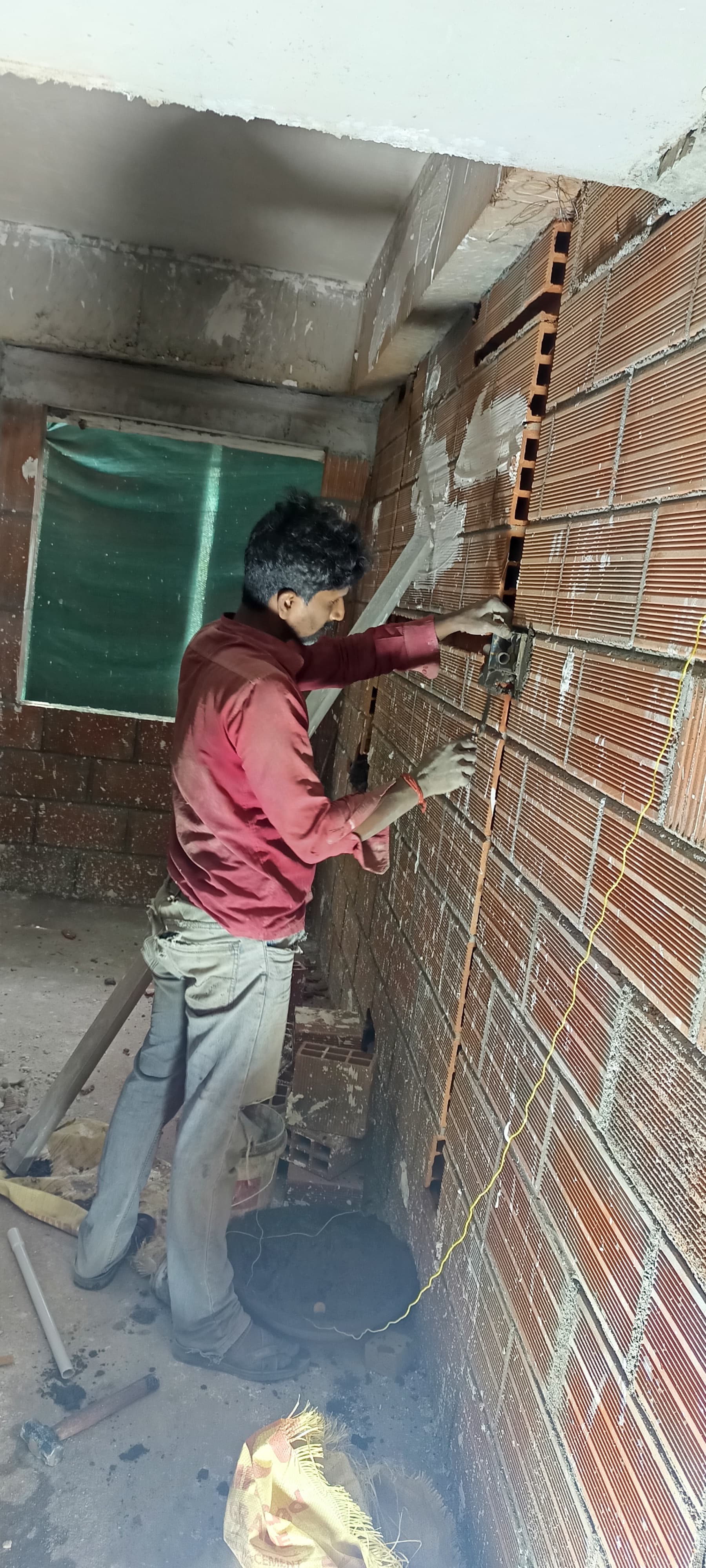

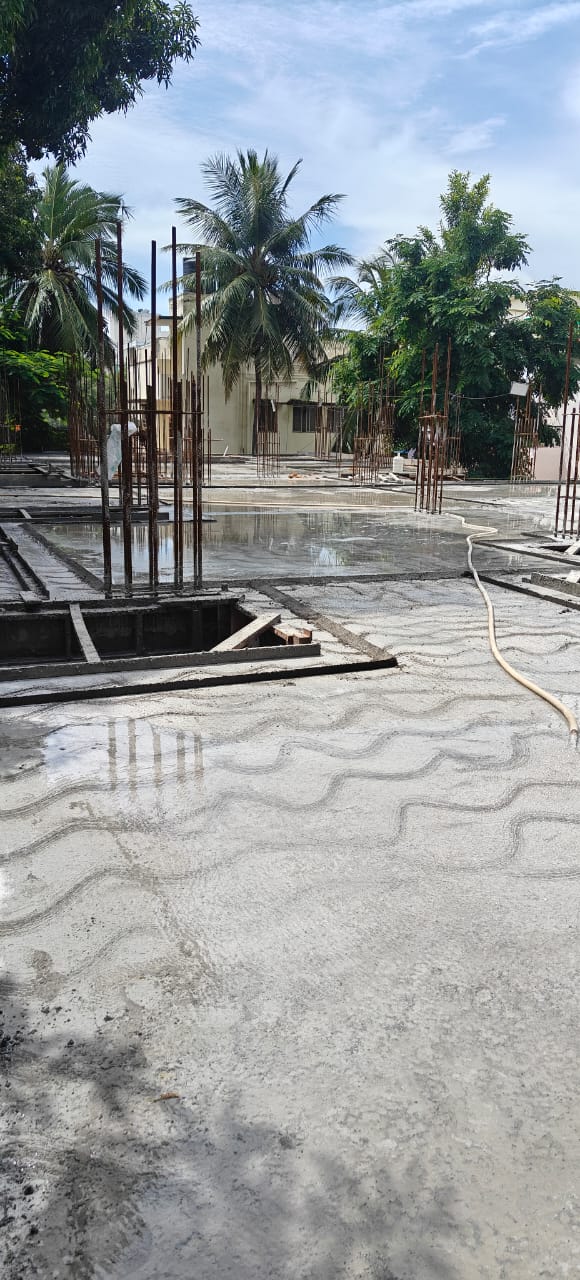

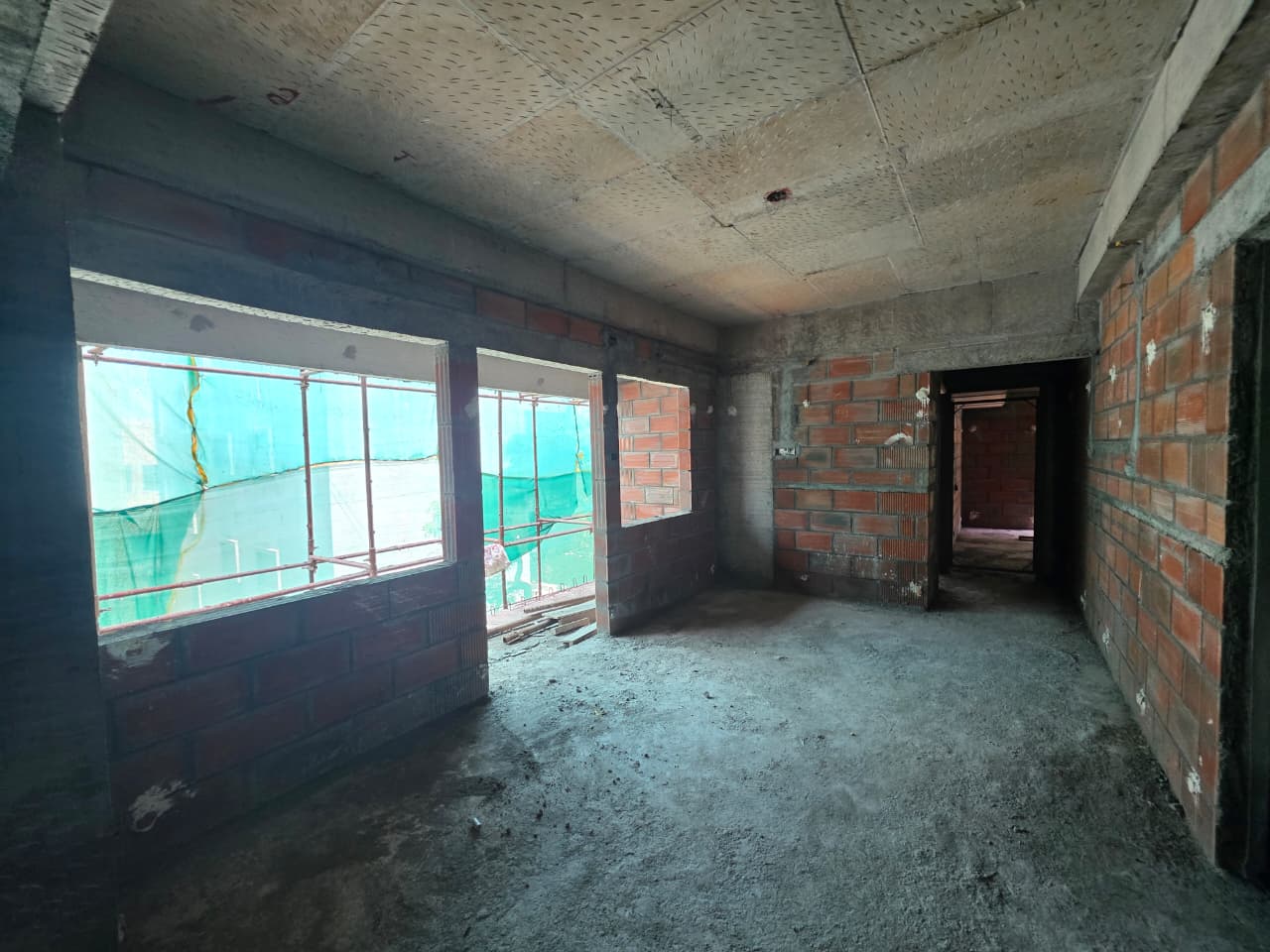

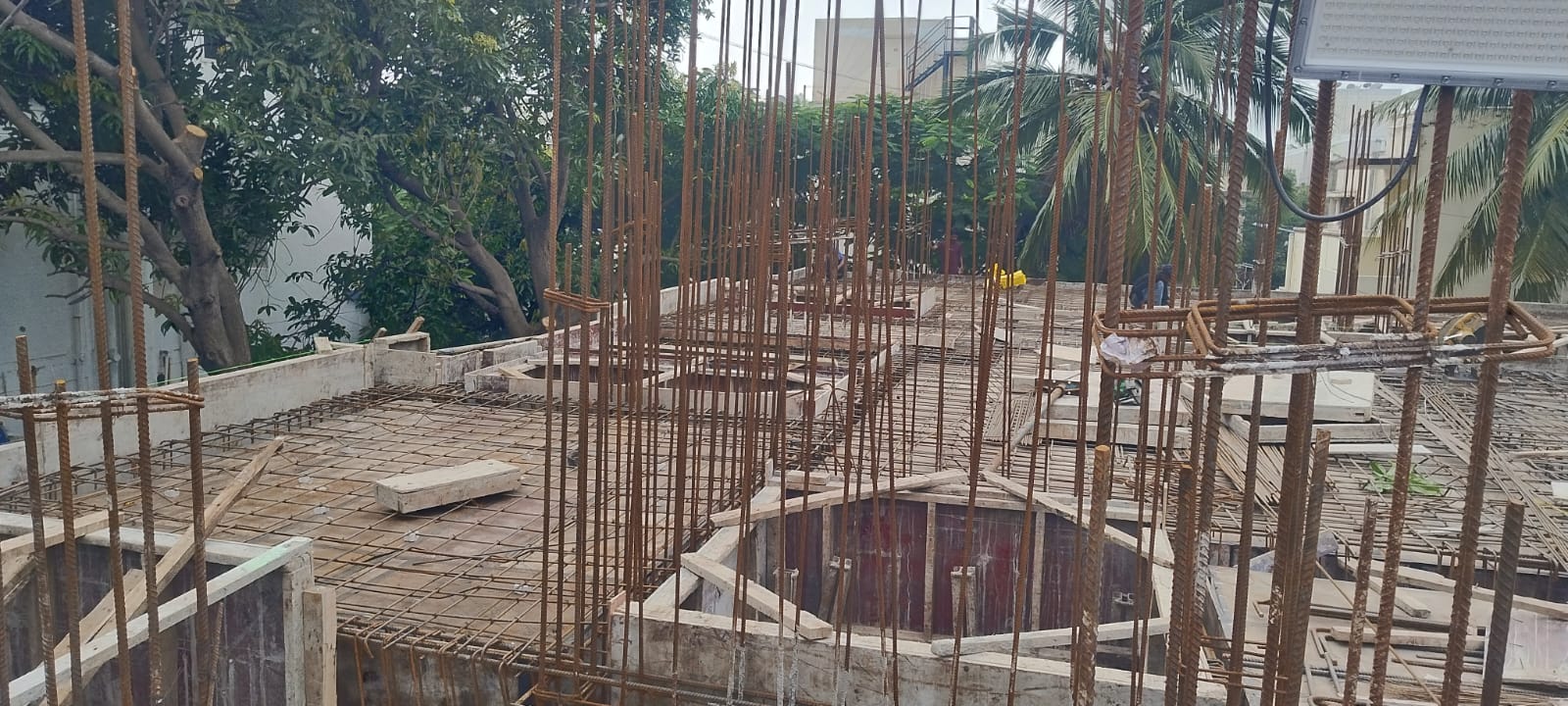

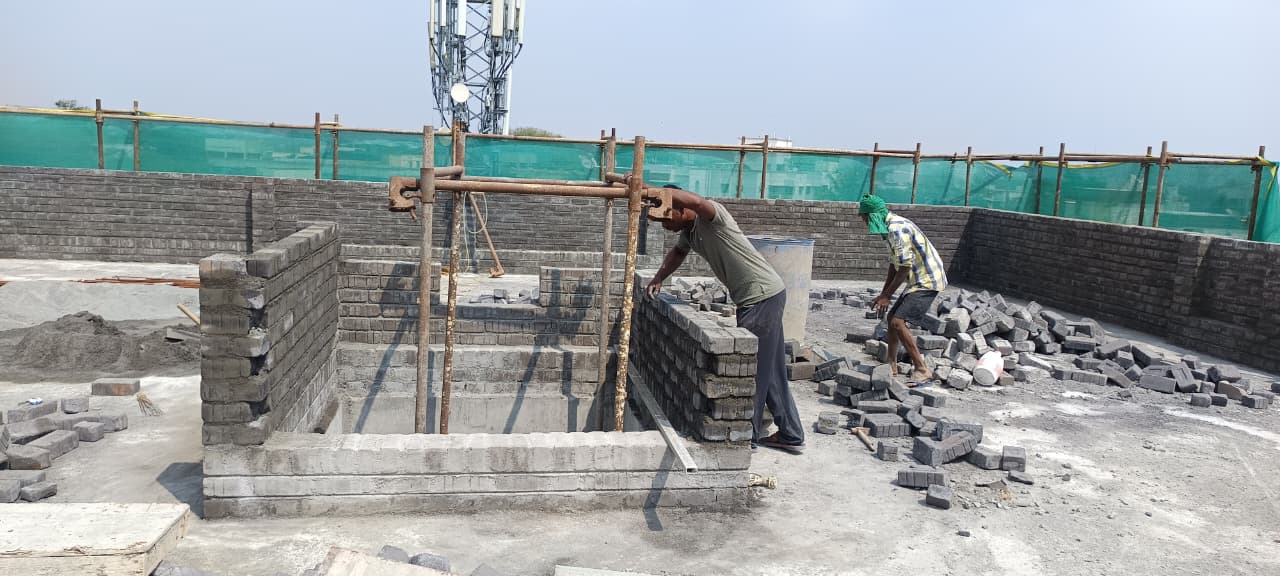

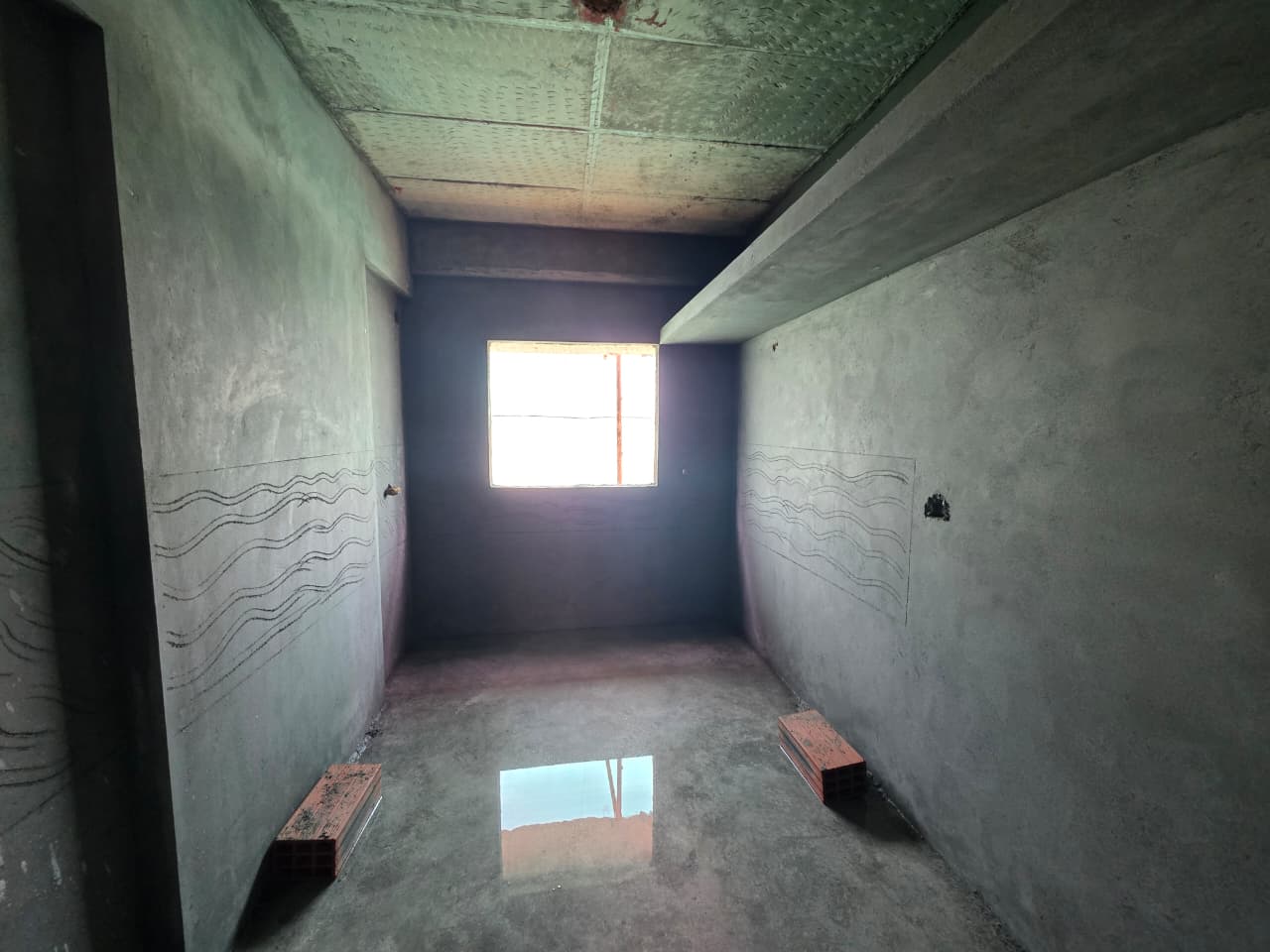

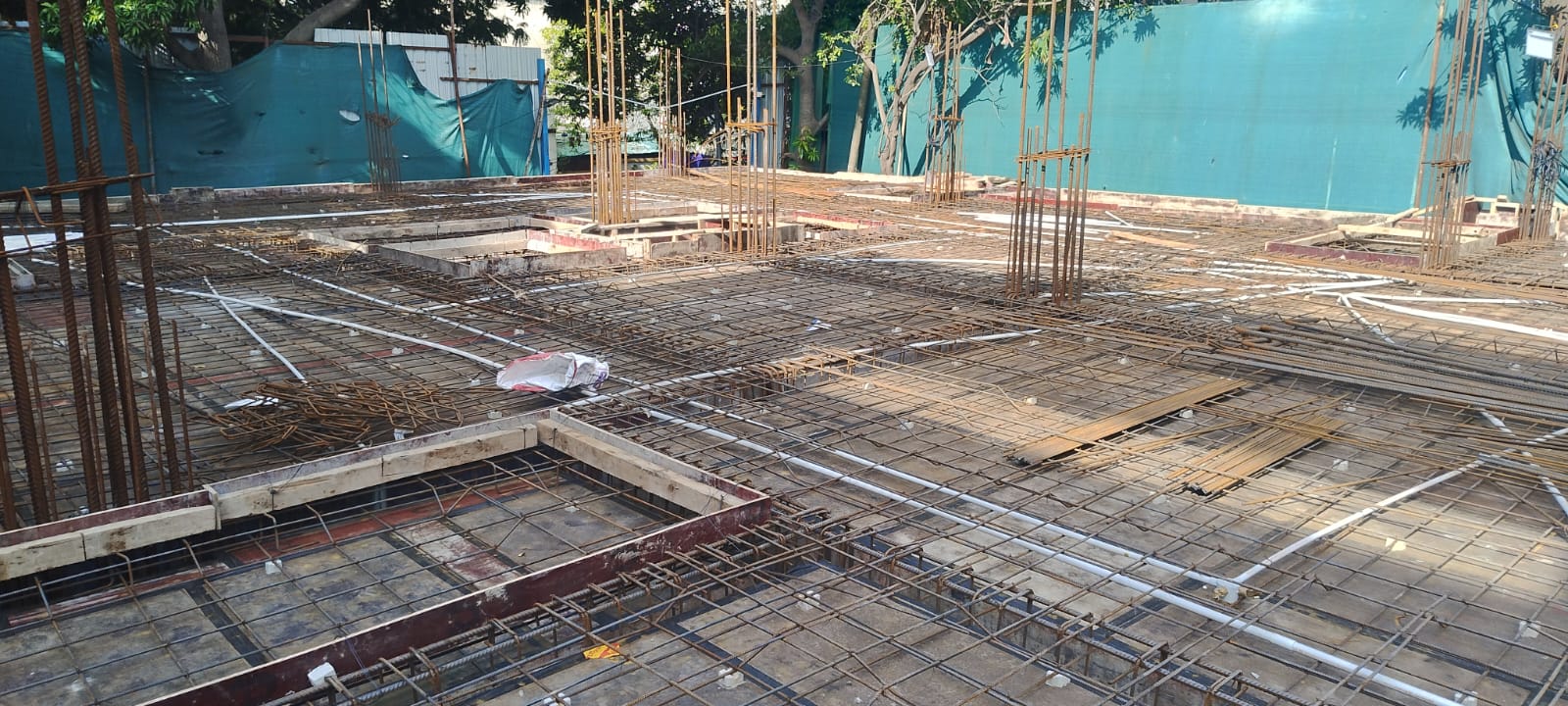

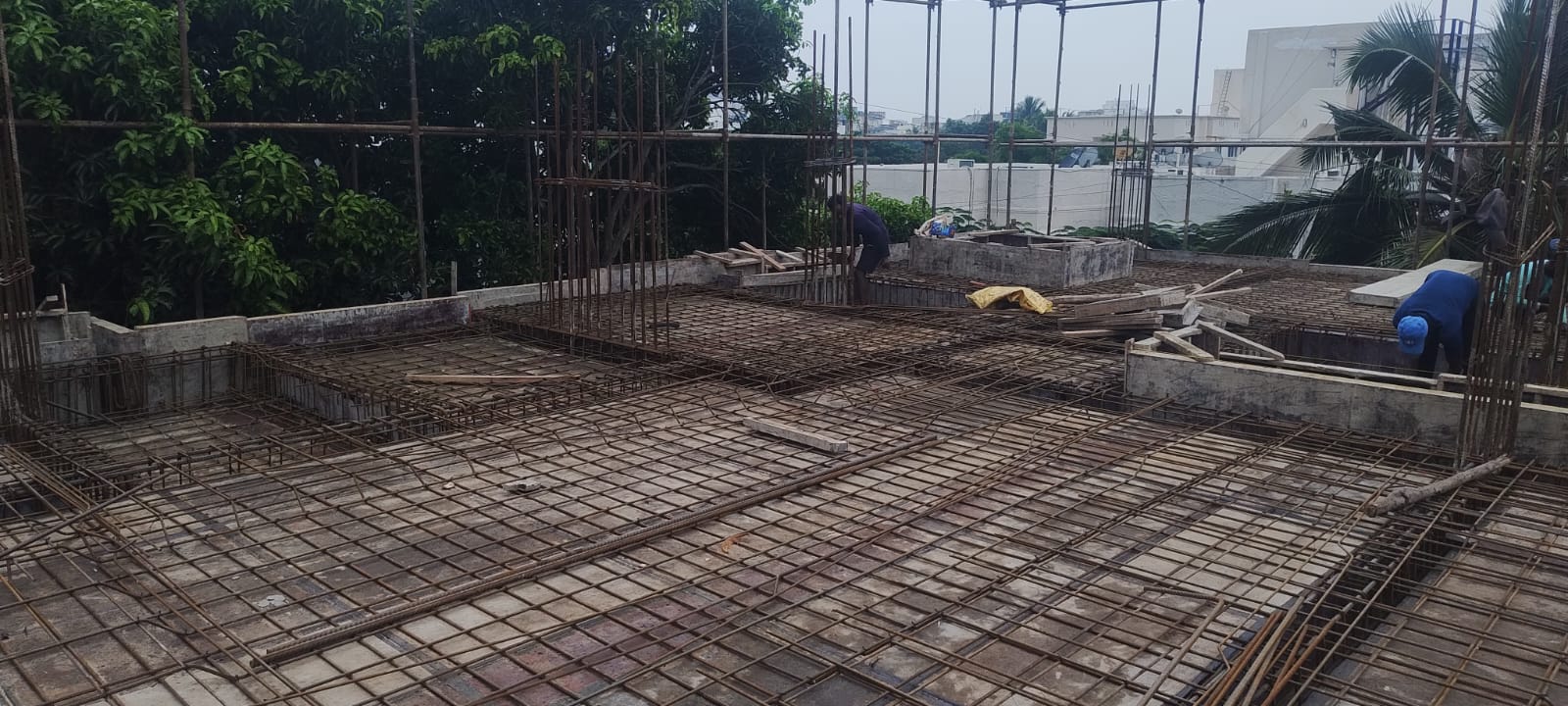

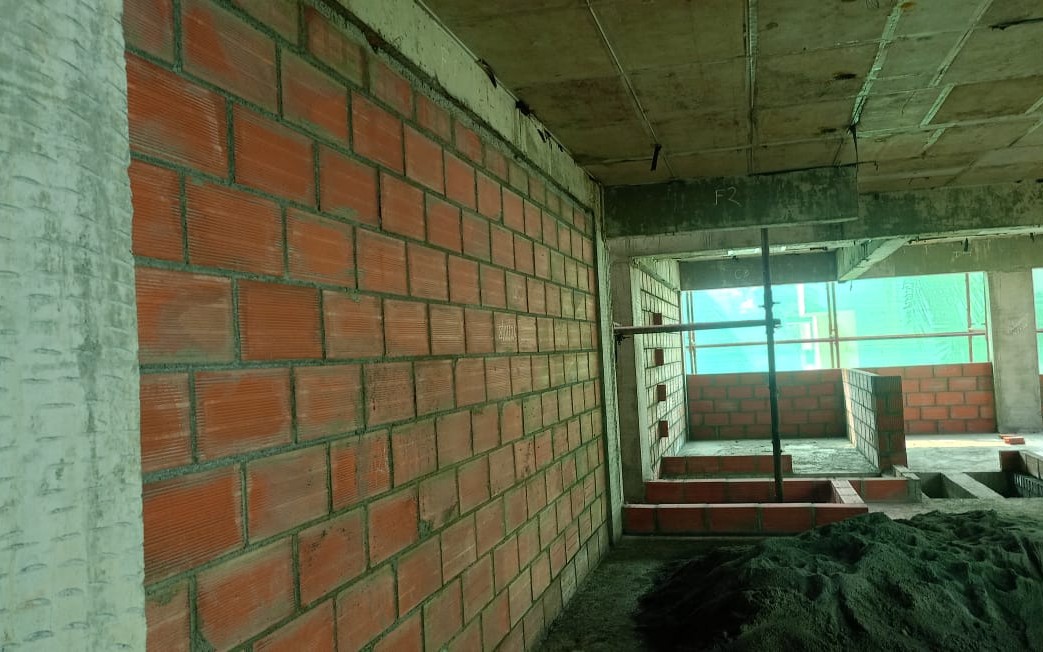

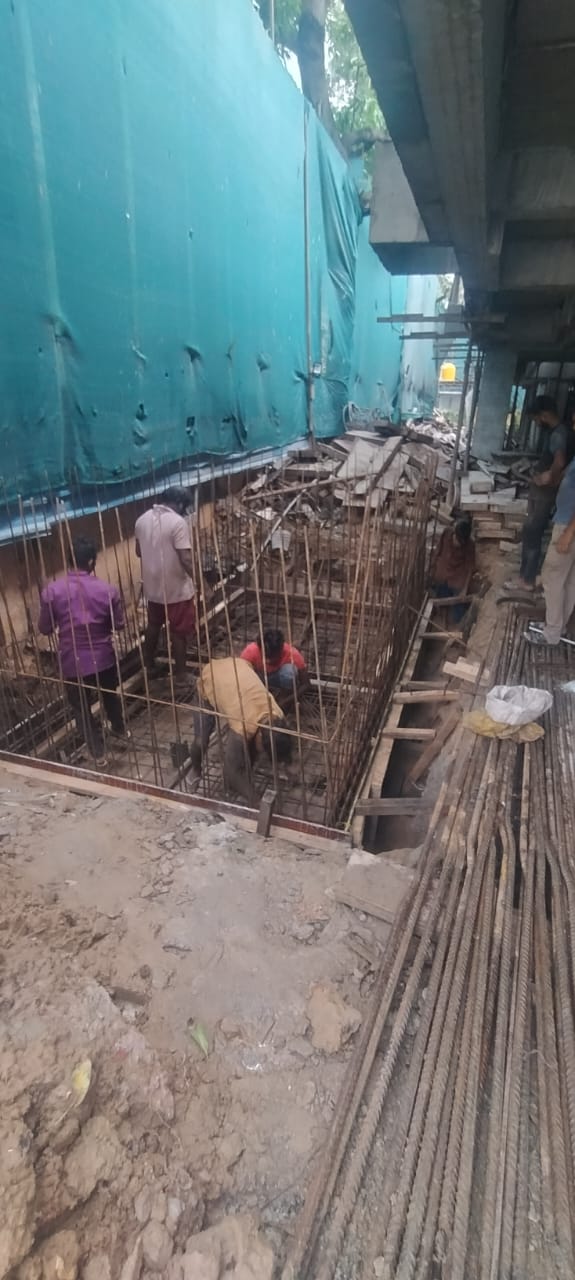

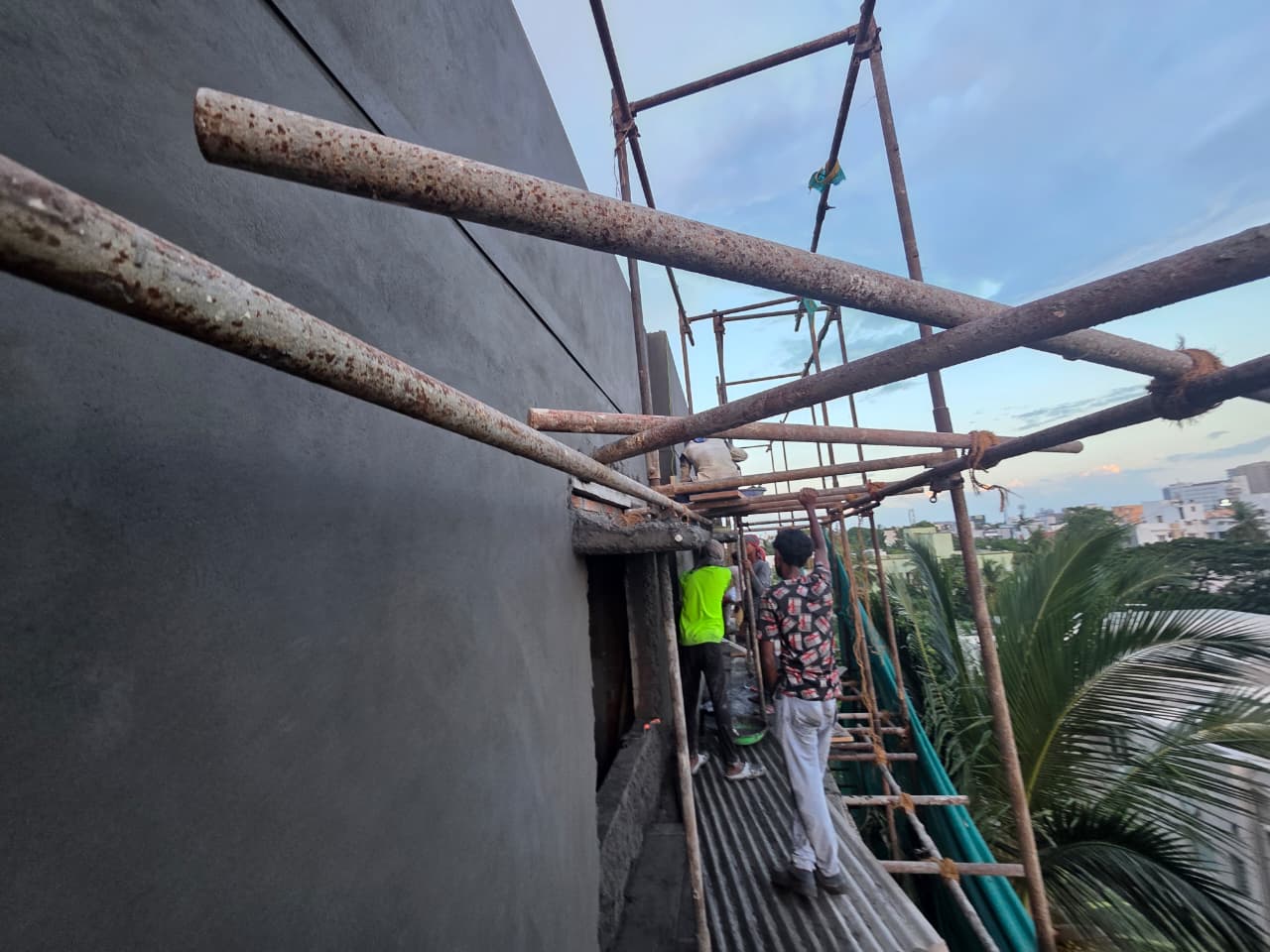

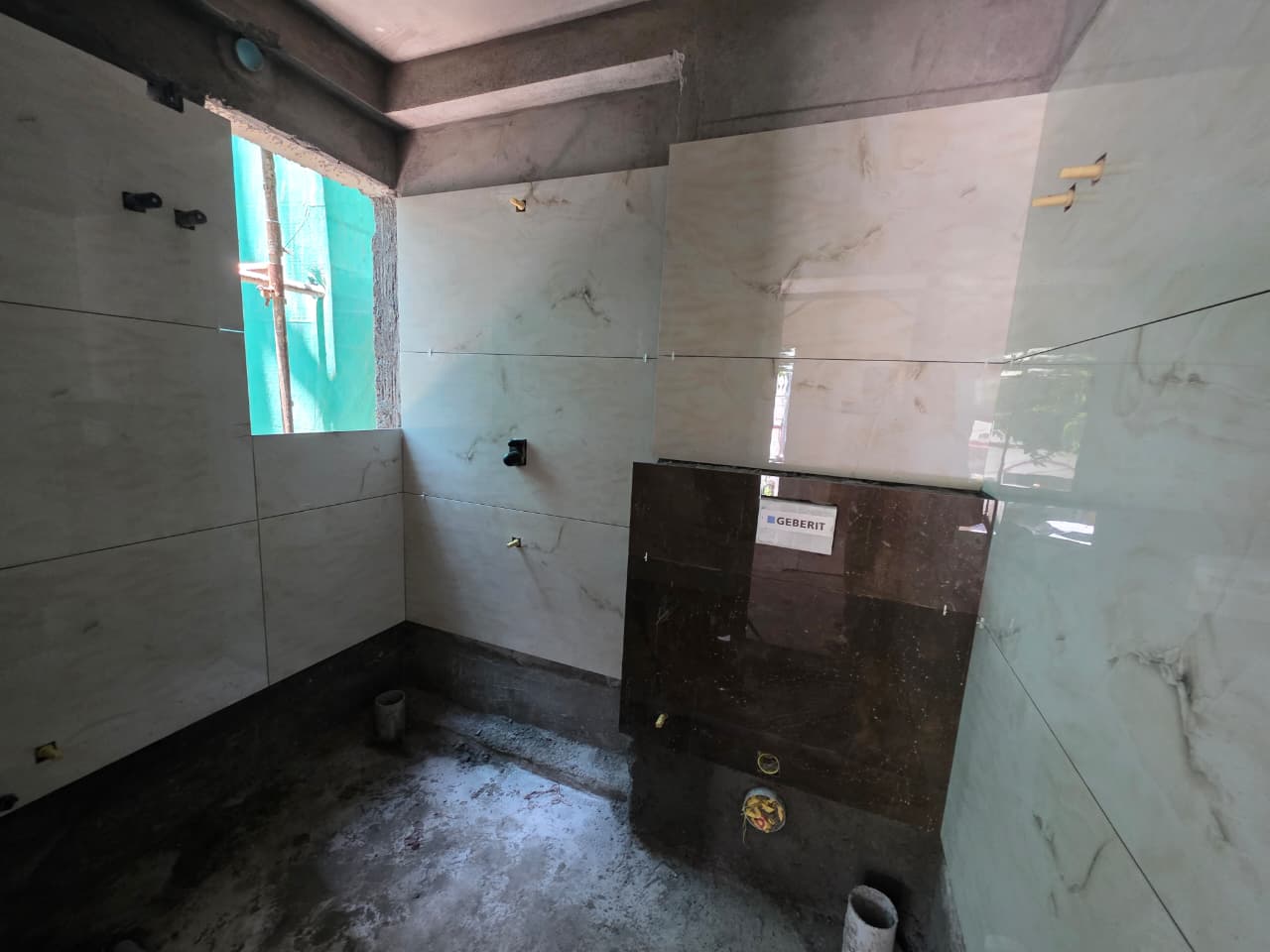

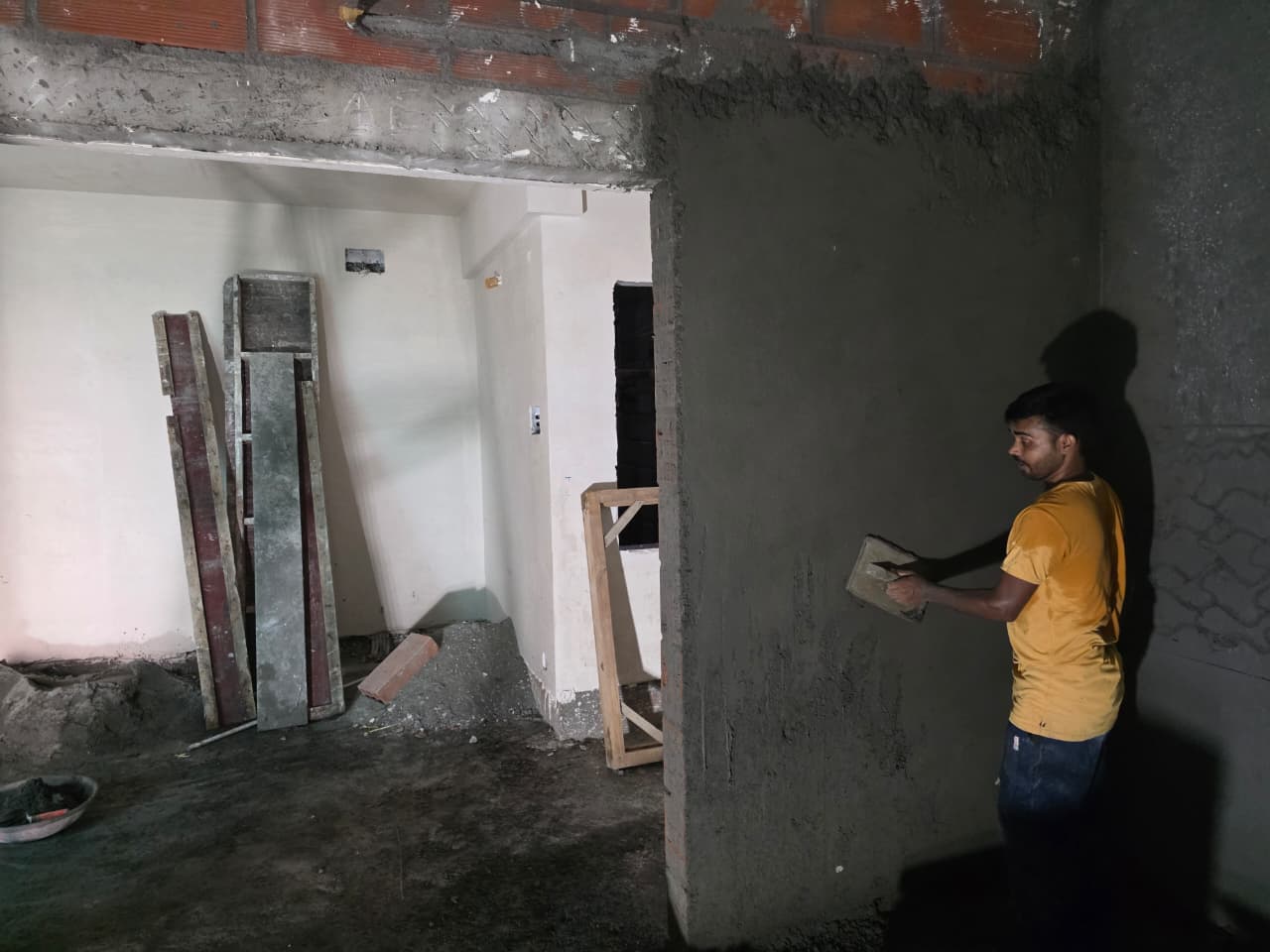

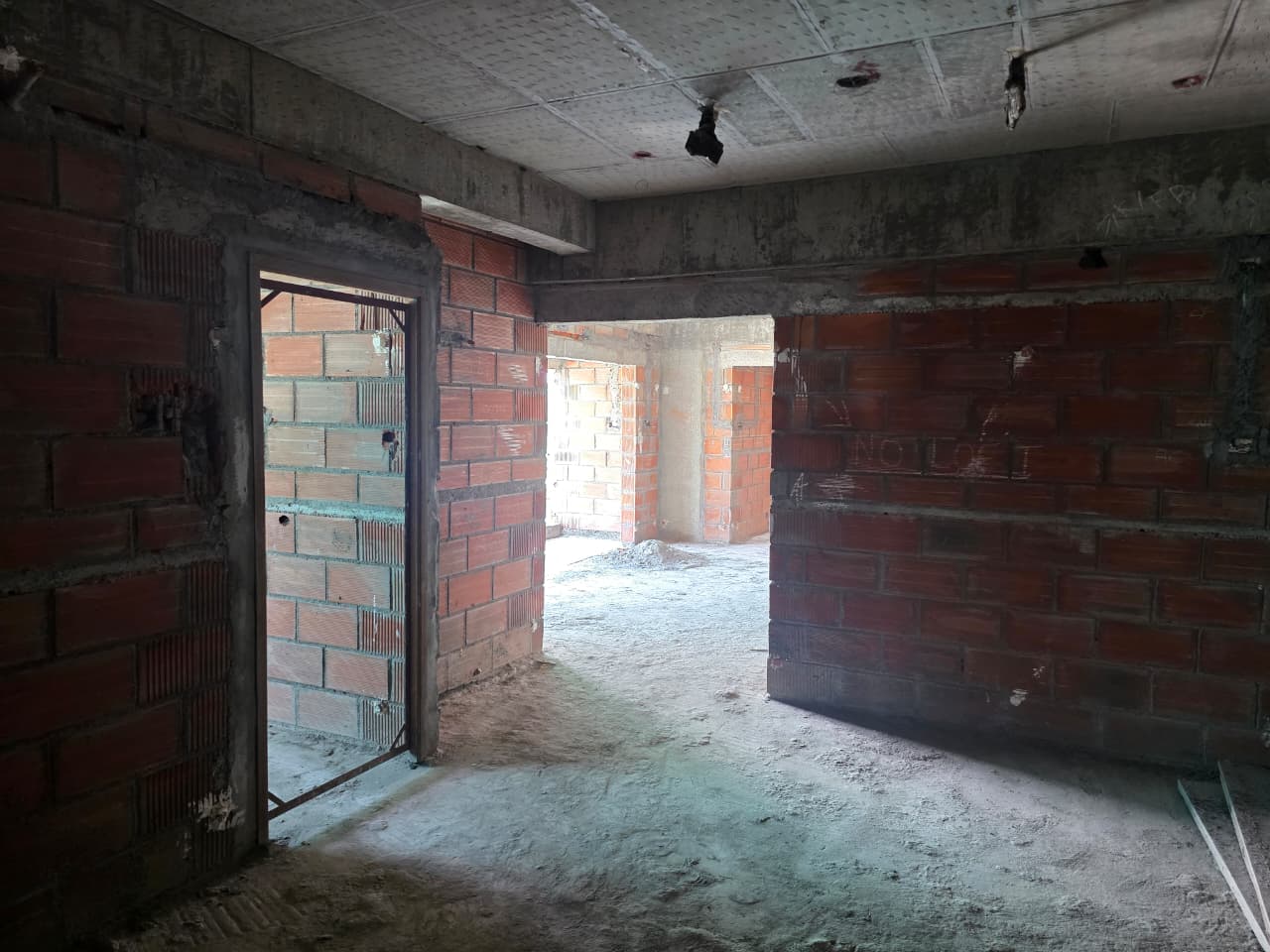

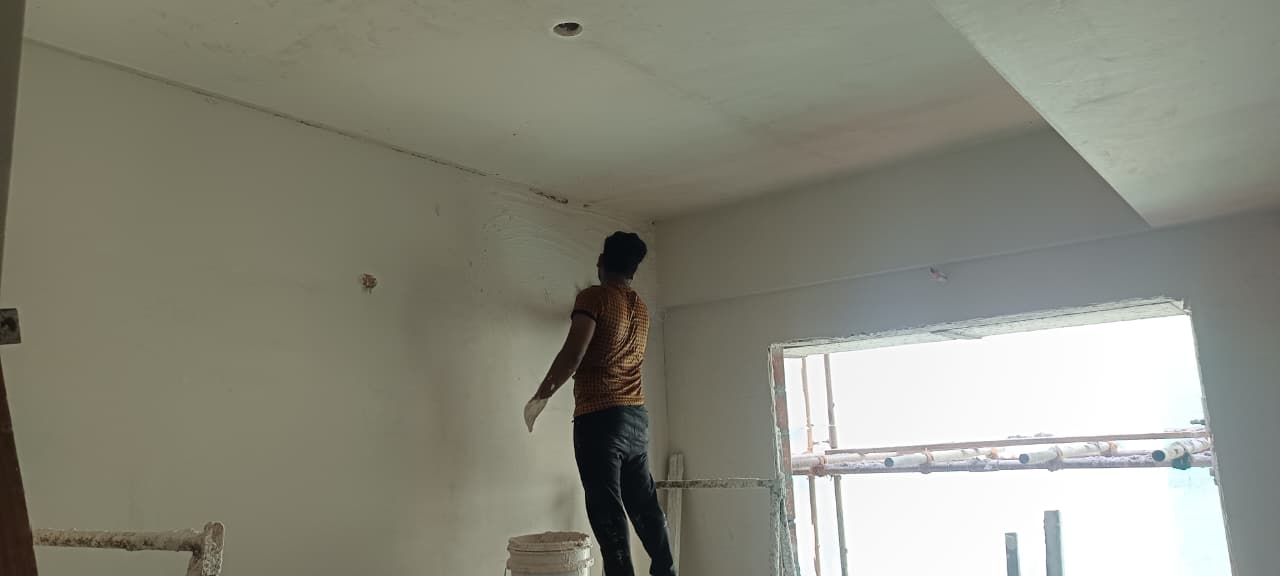

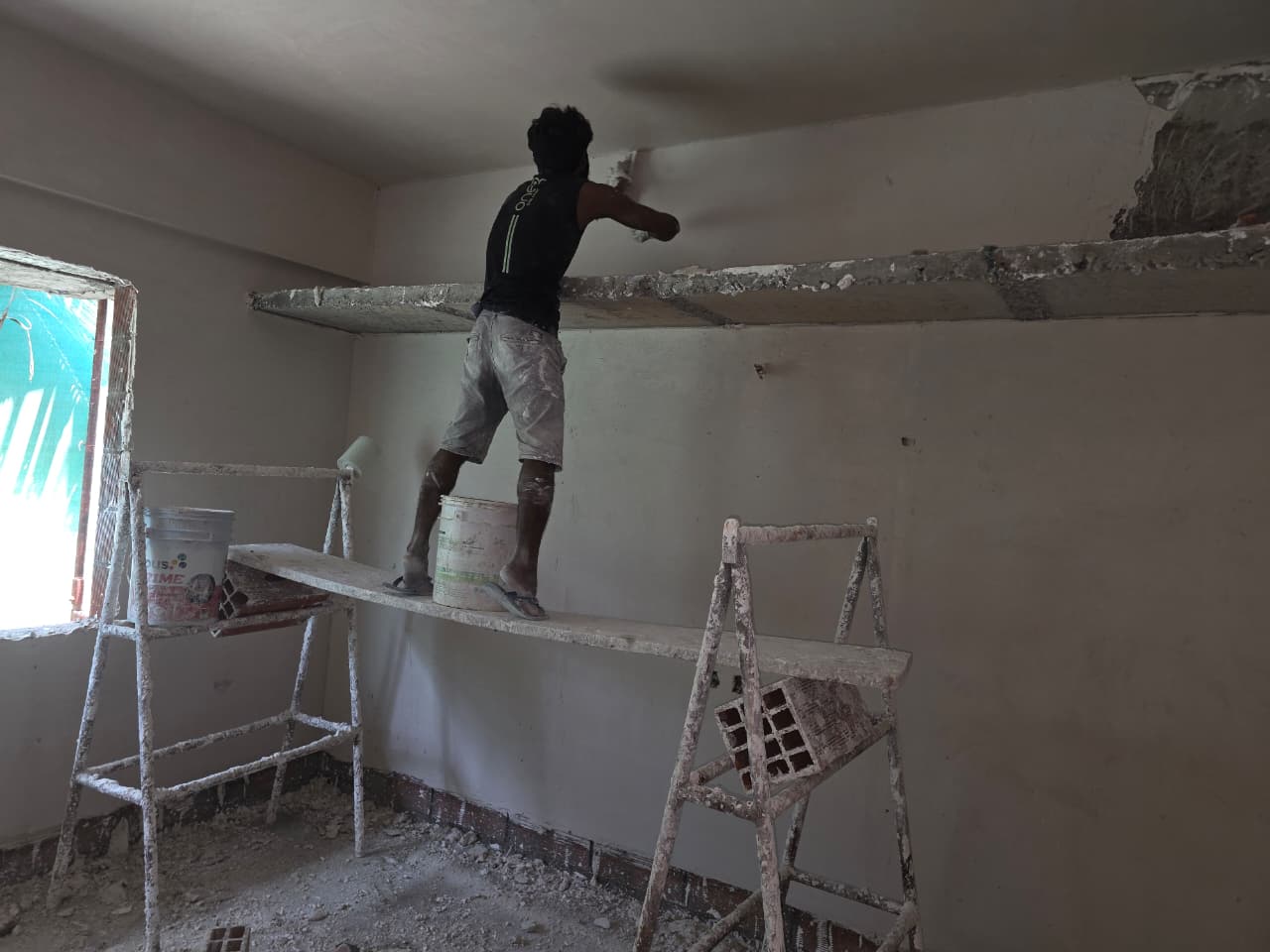

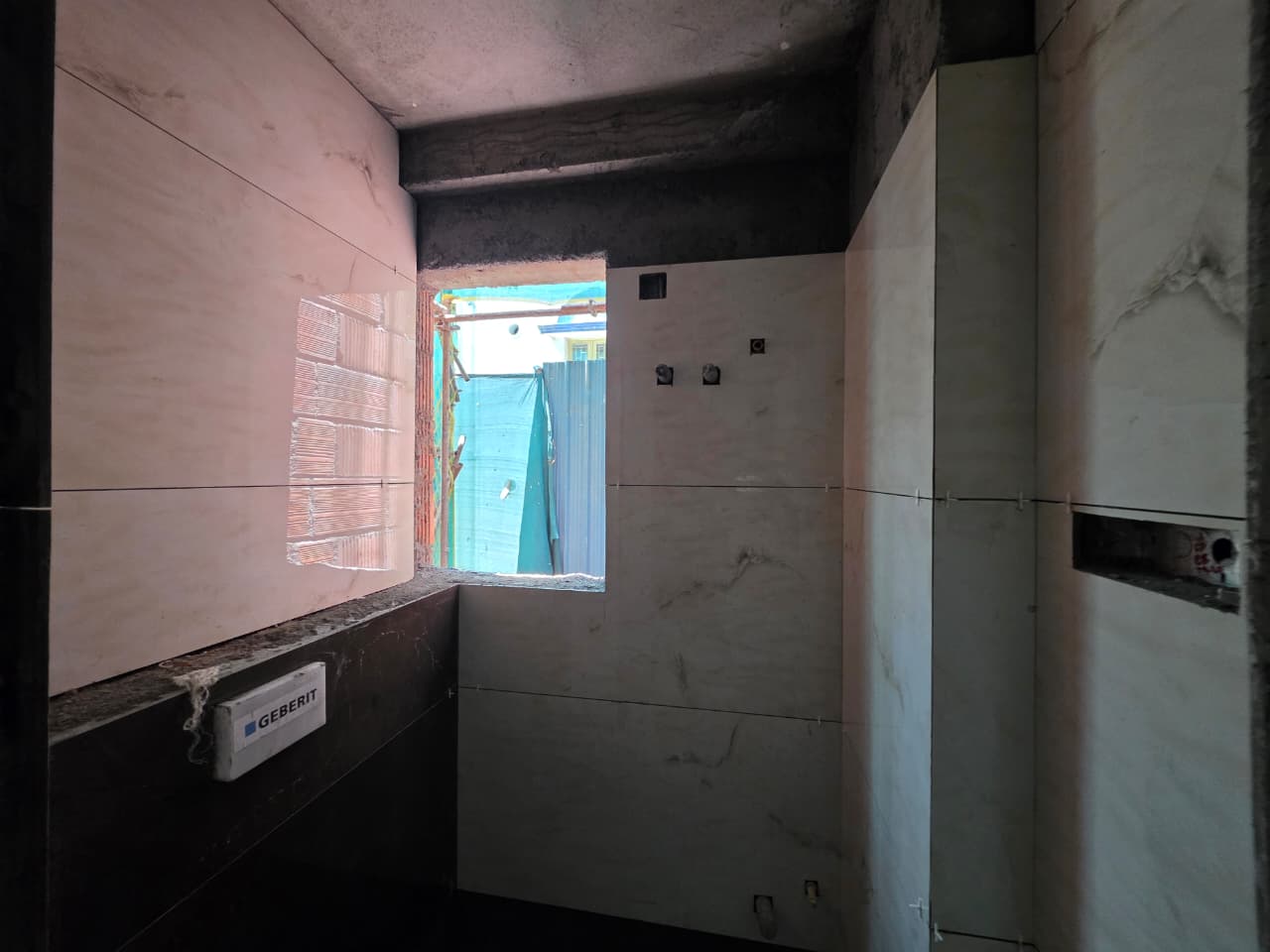

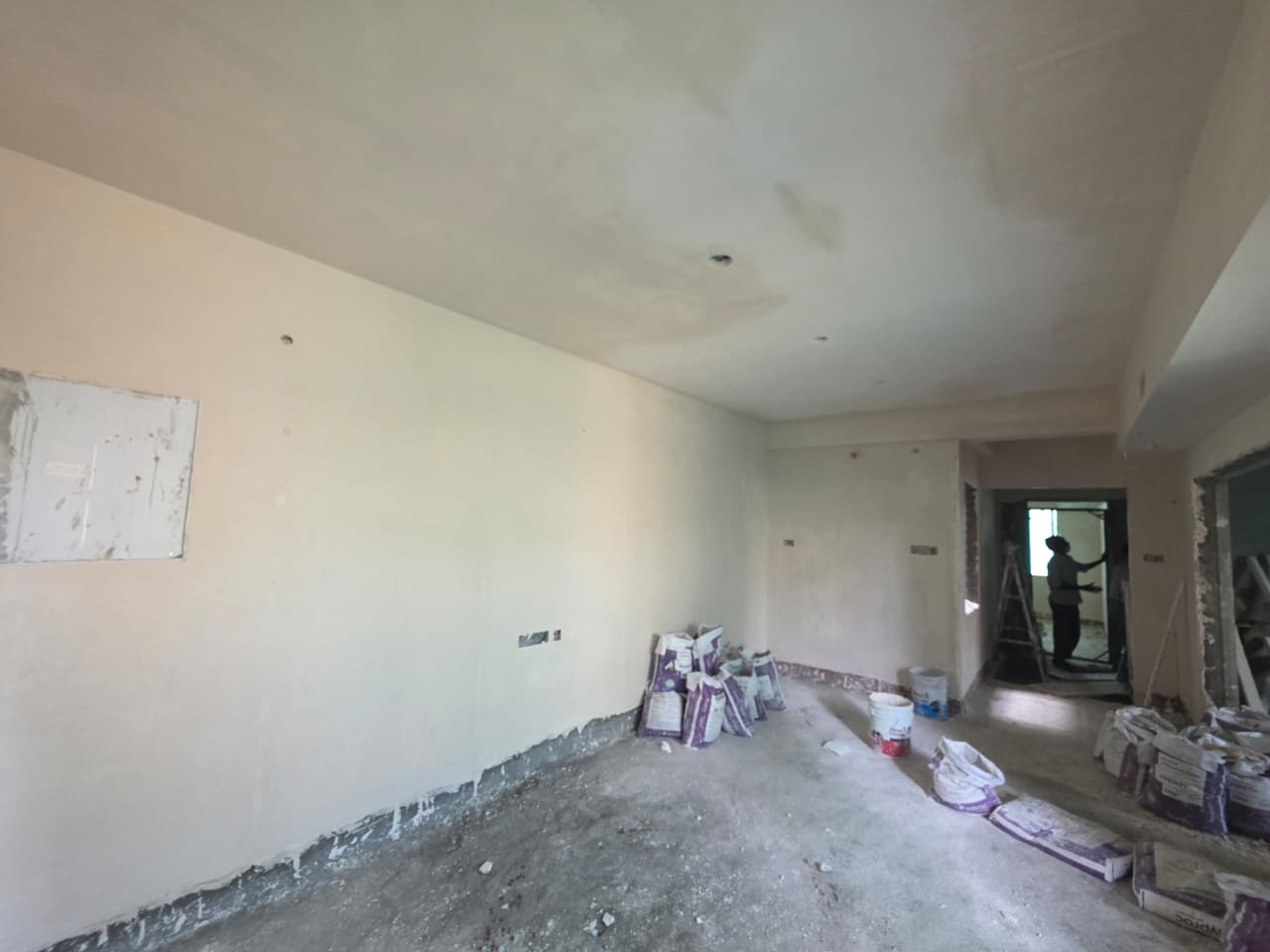

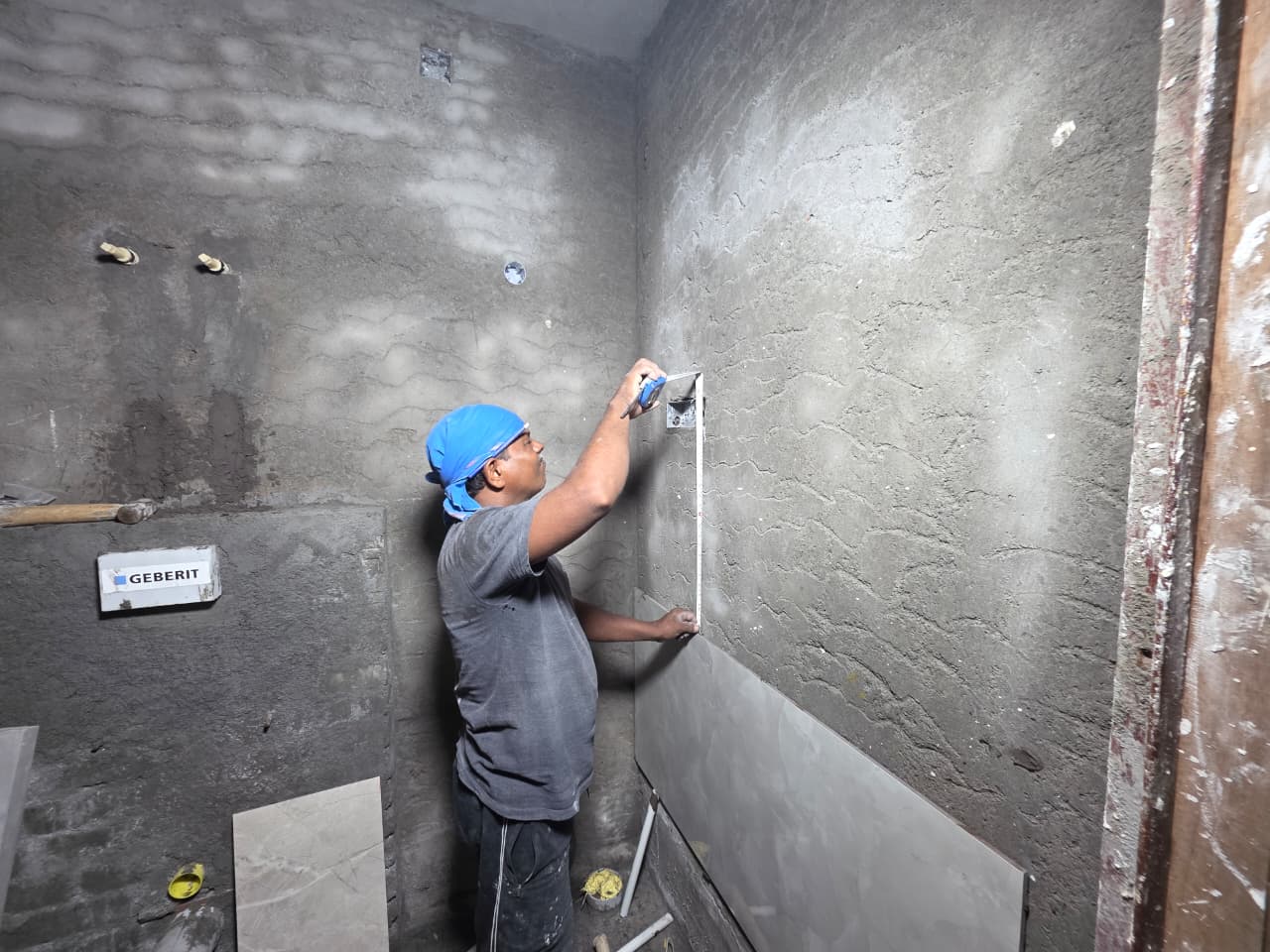

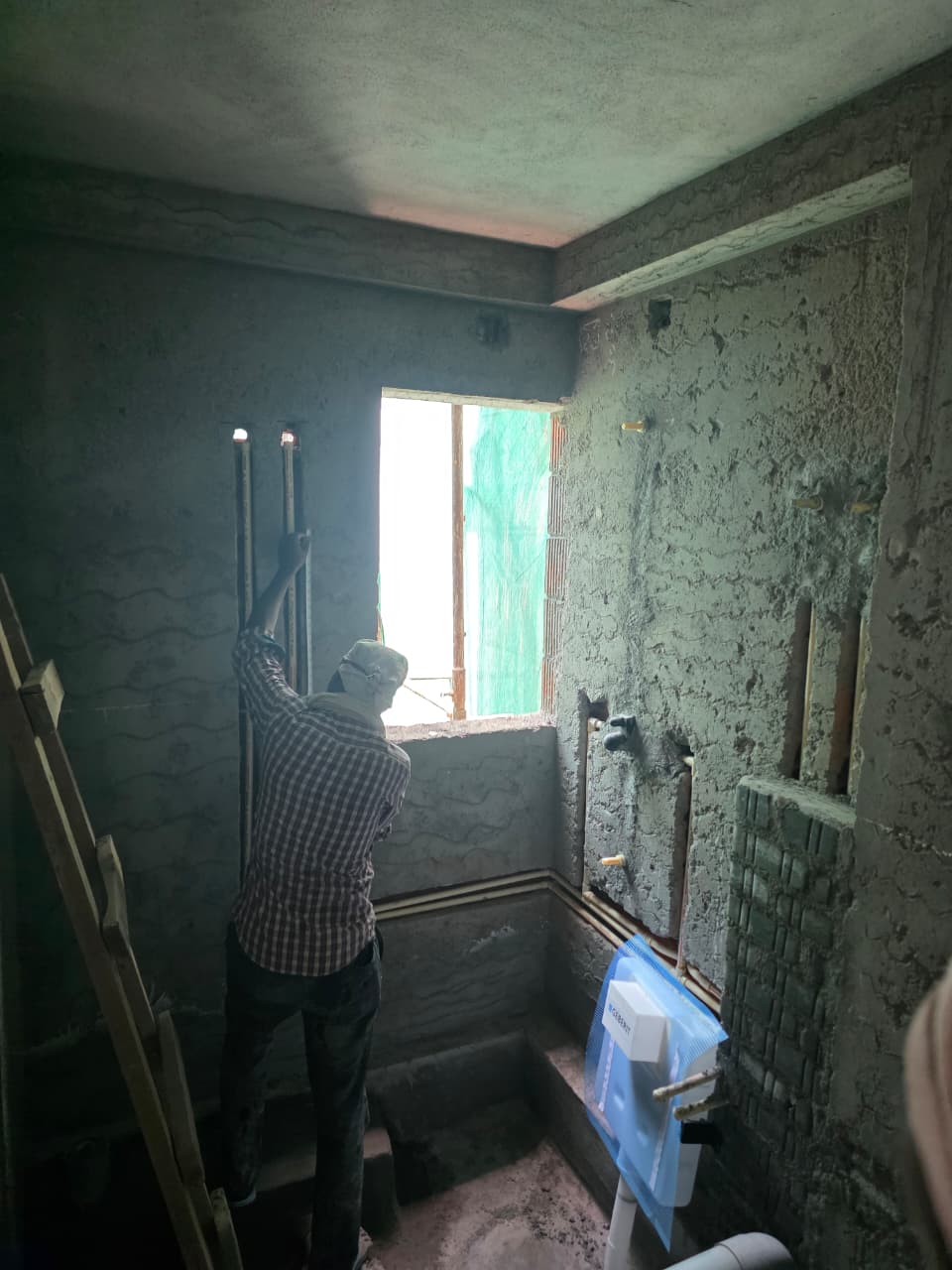

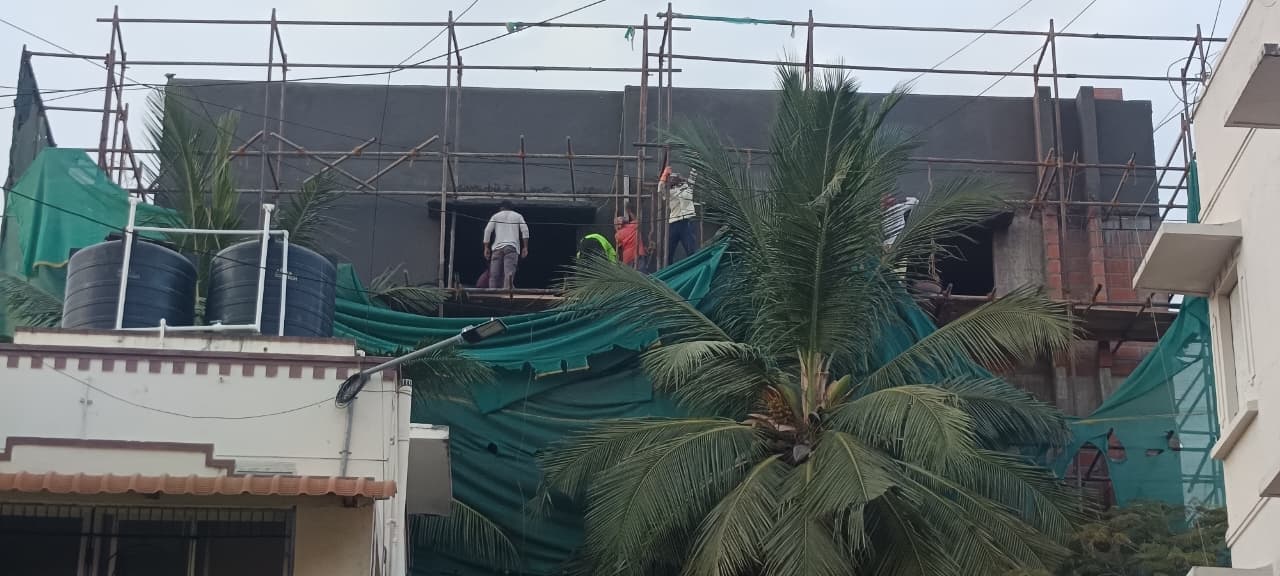

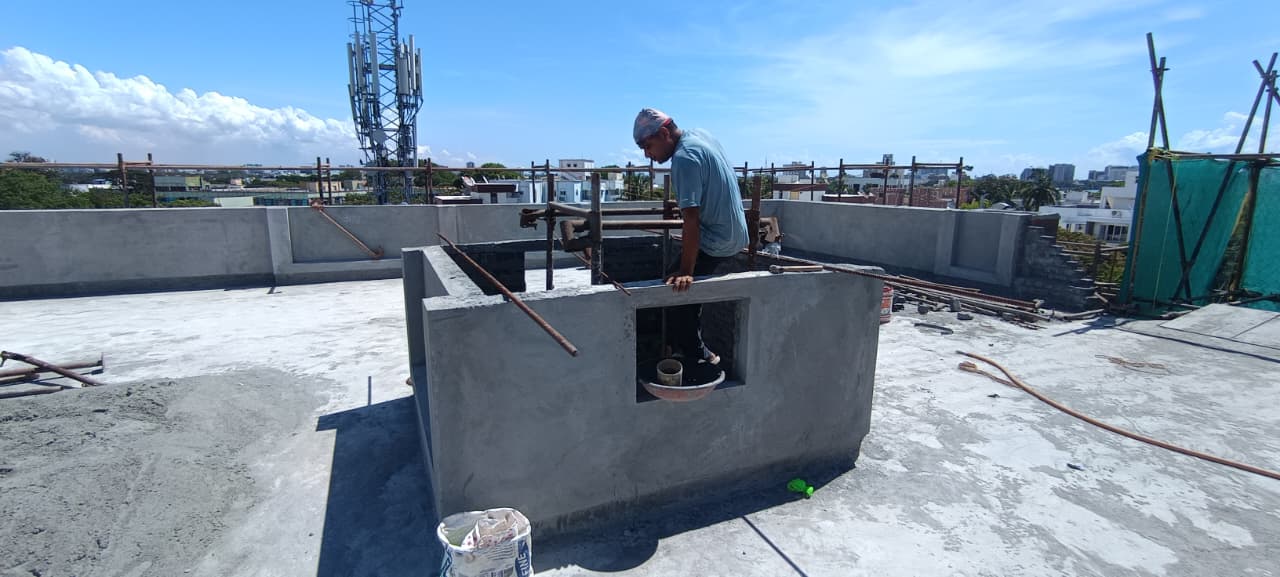

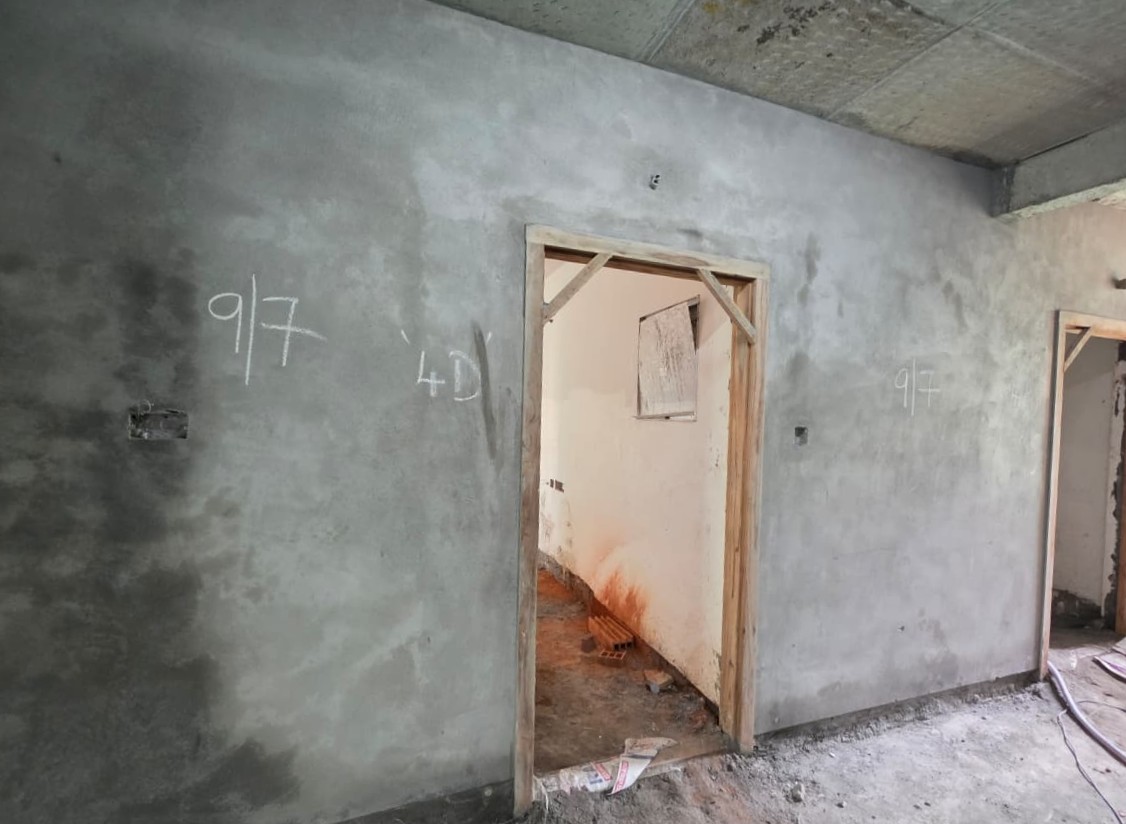

Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image

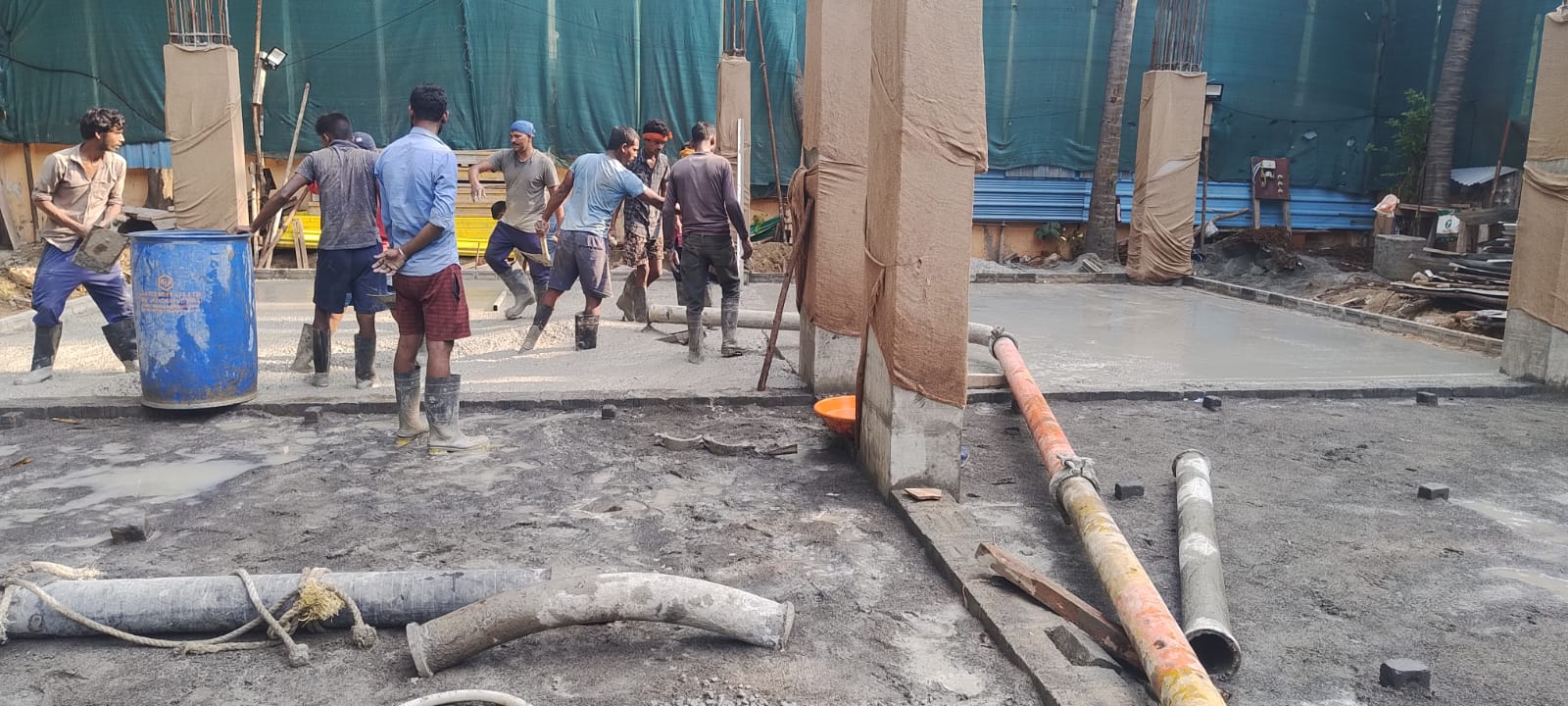

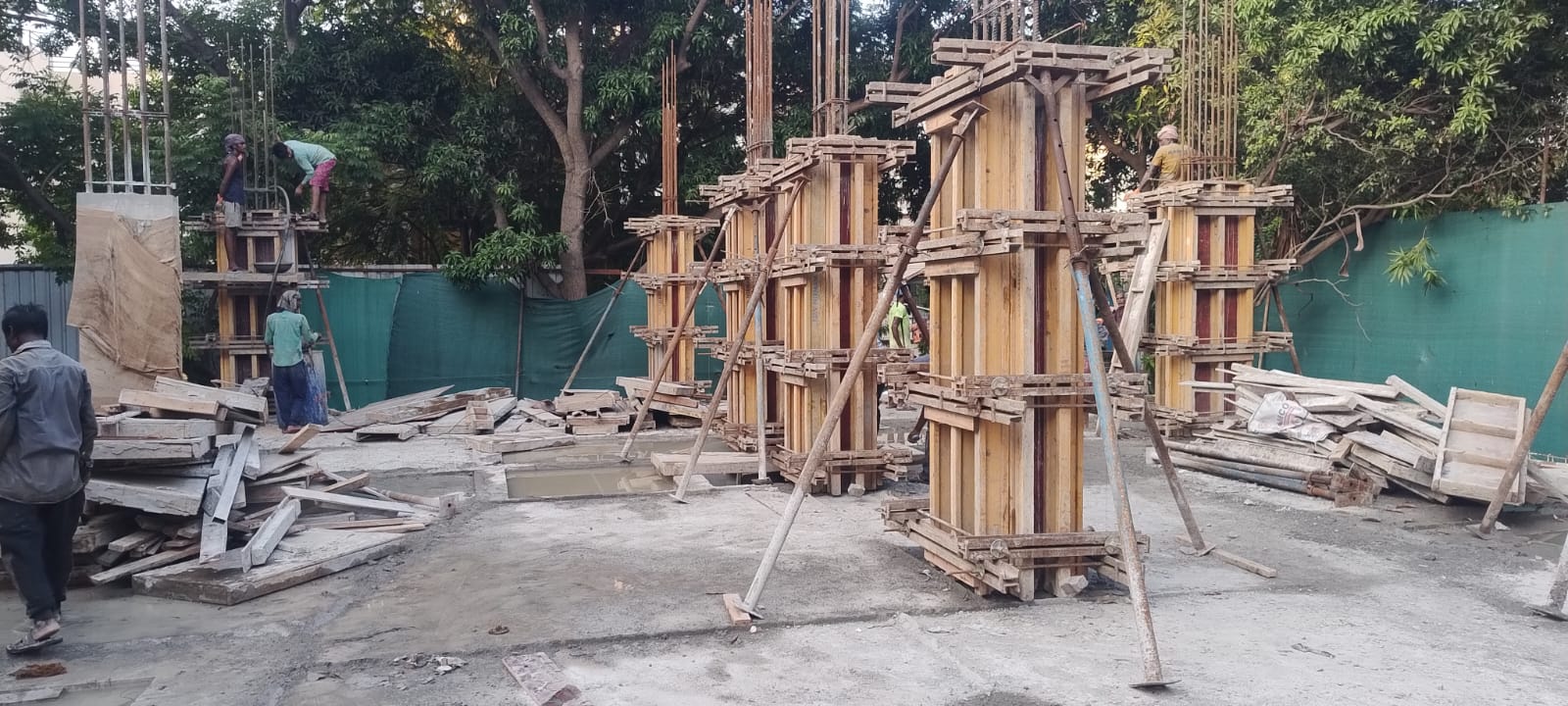

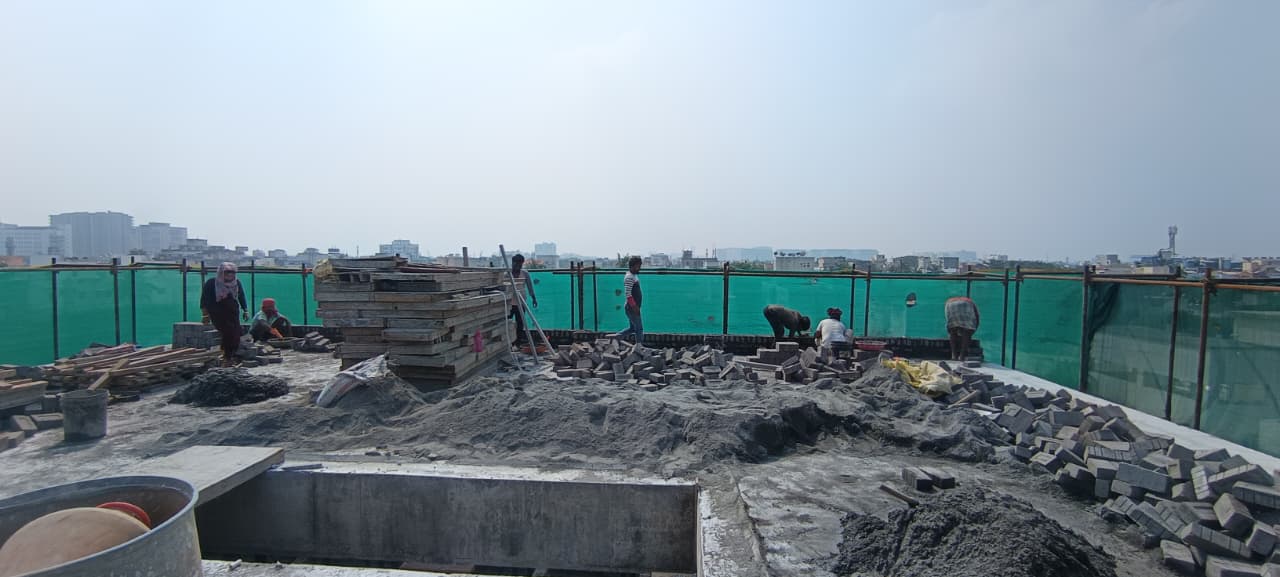

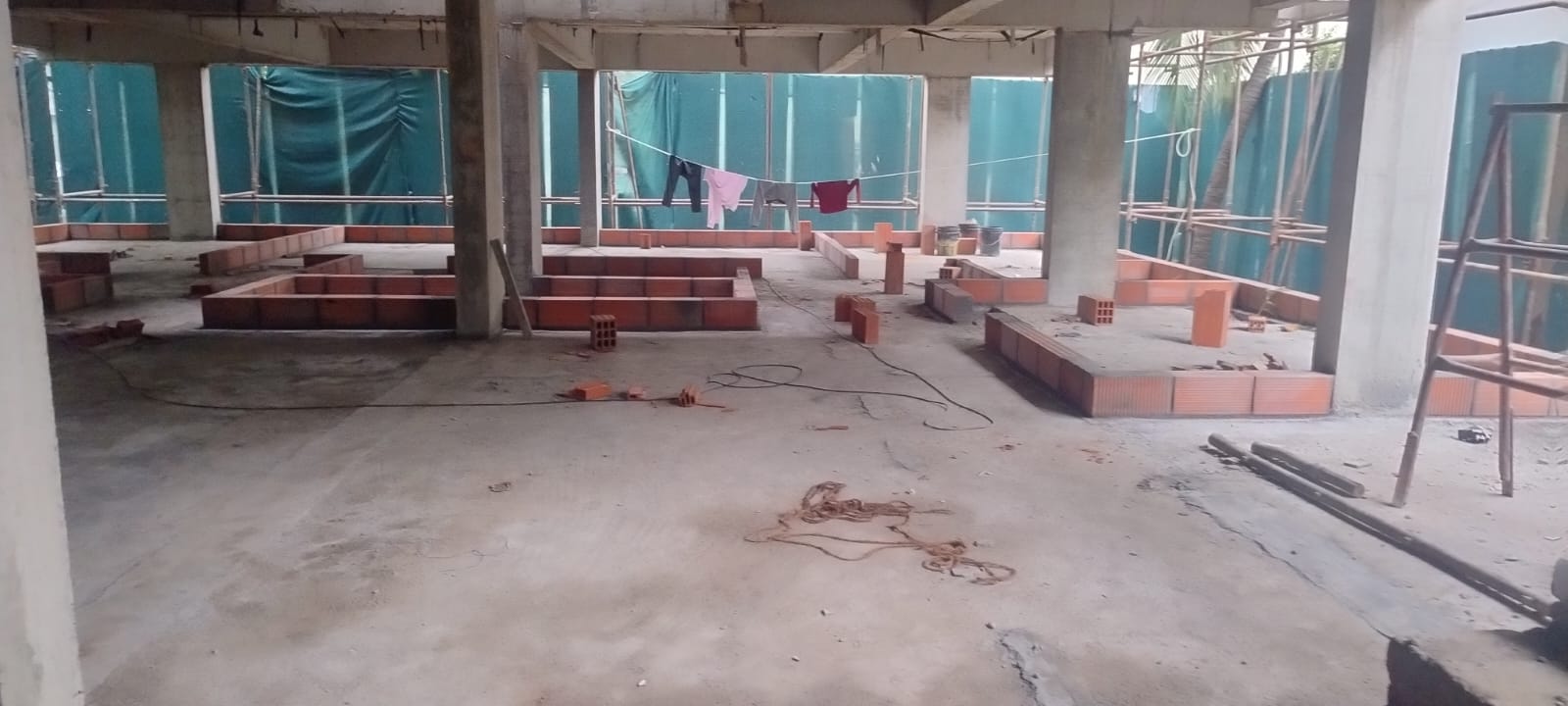

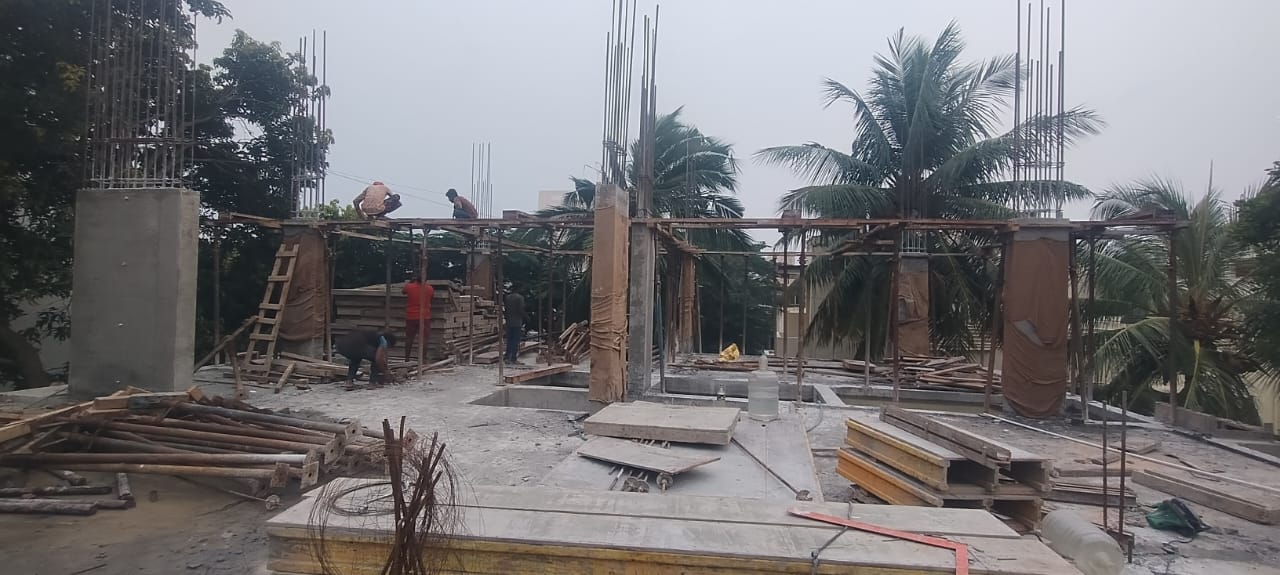

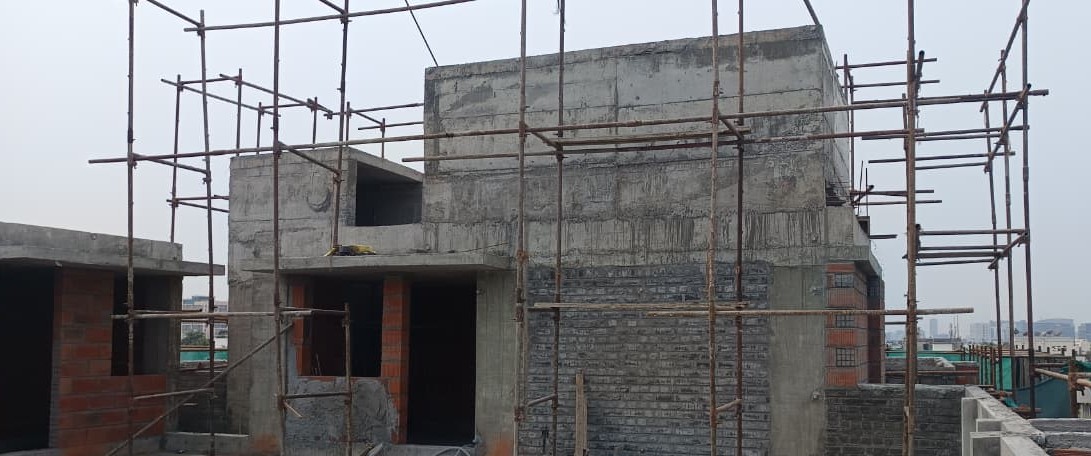

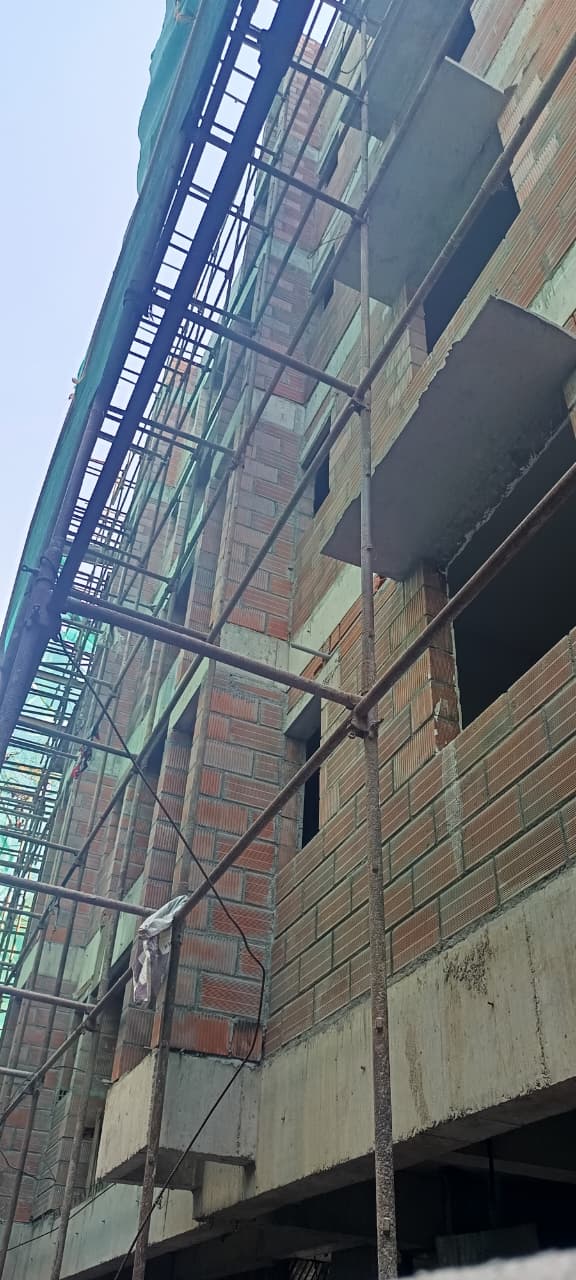

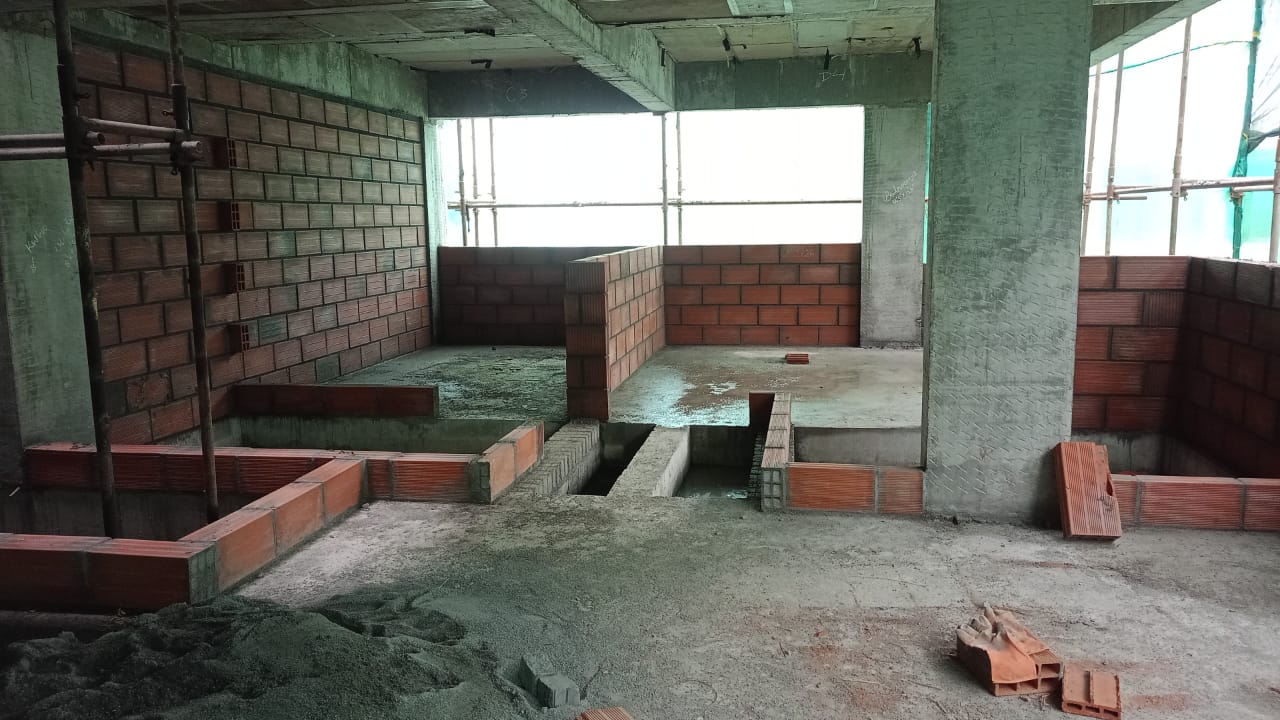

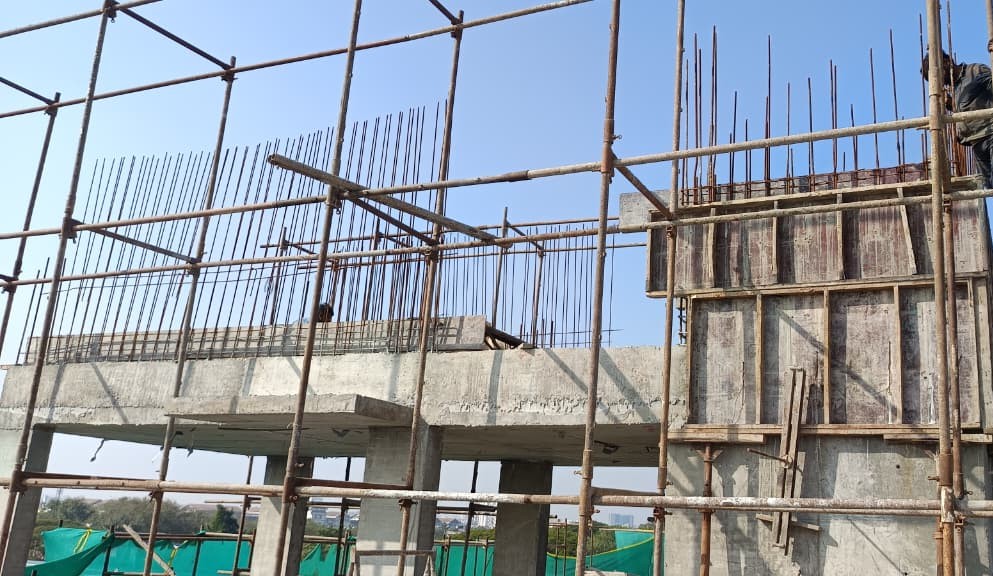

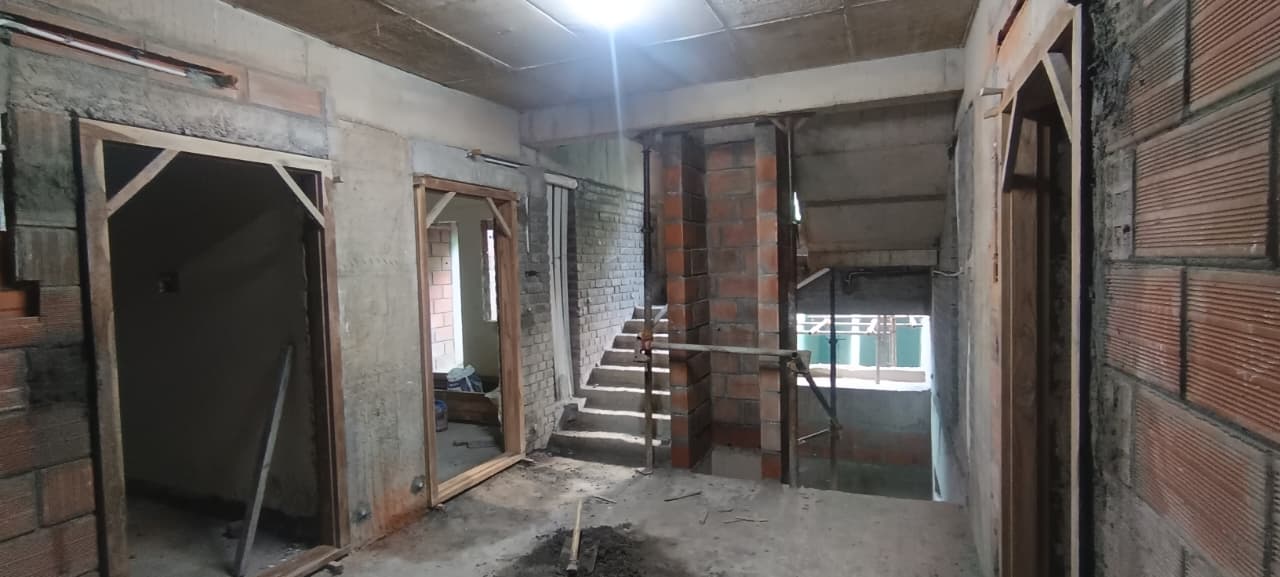

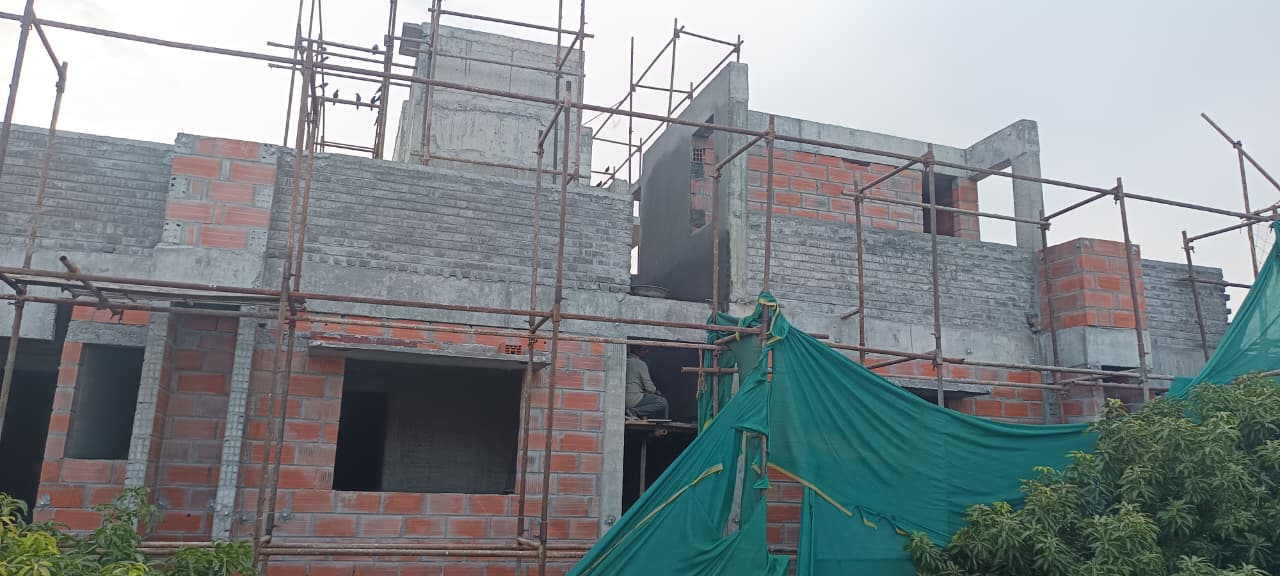

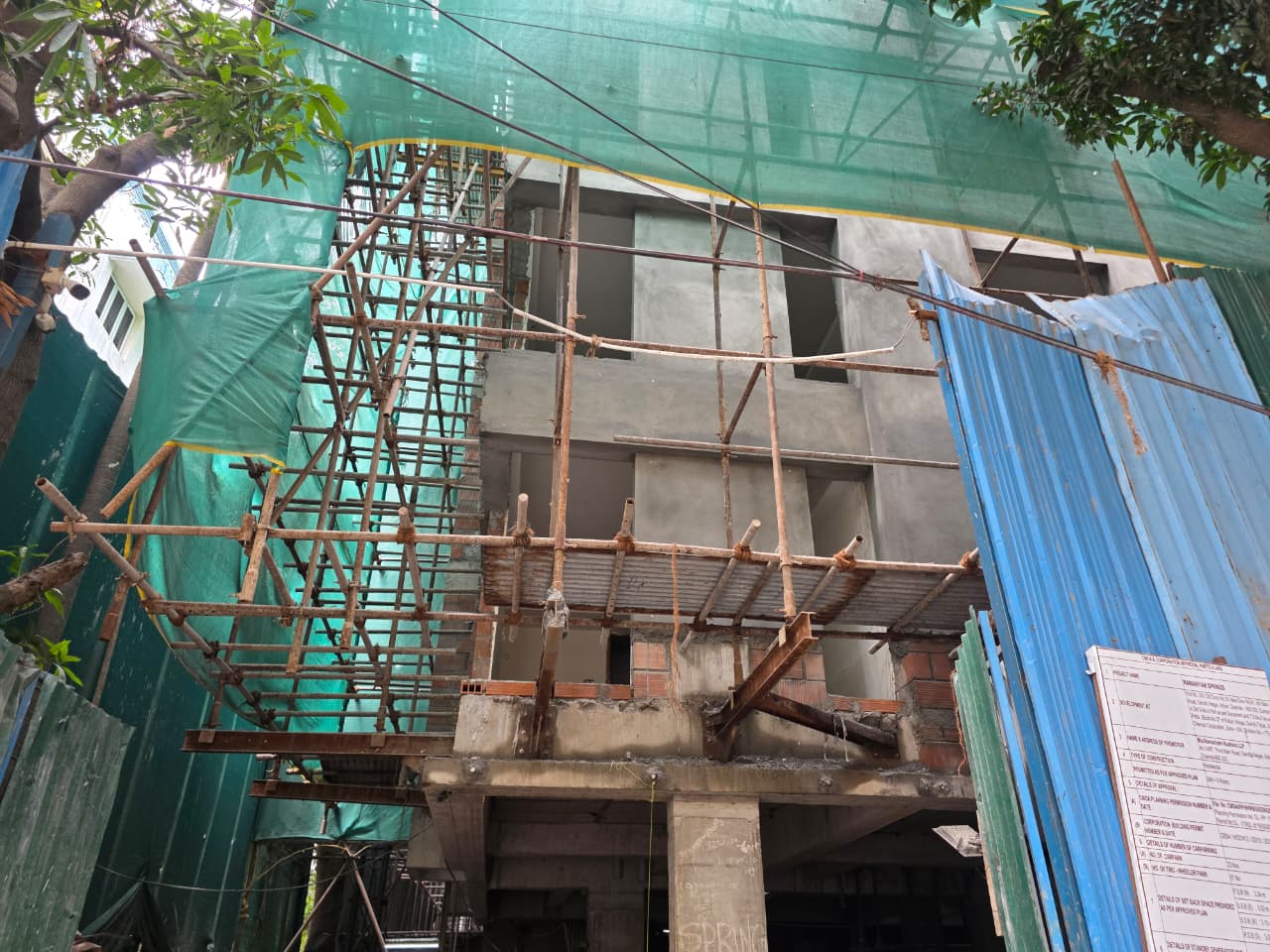

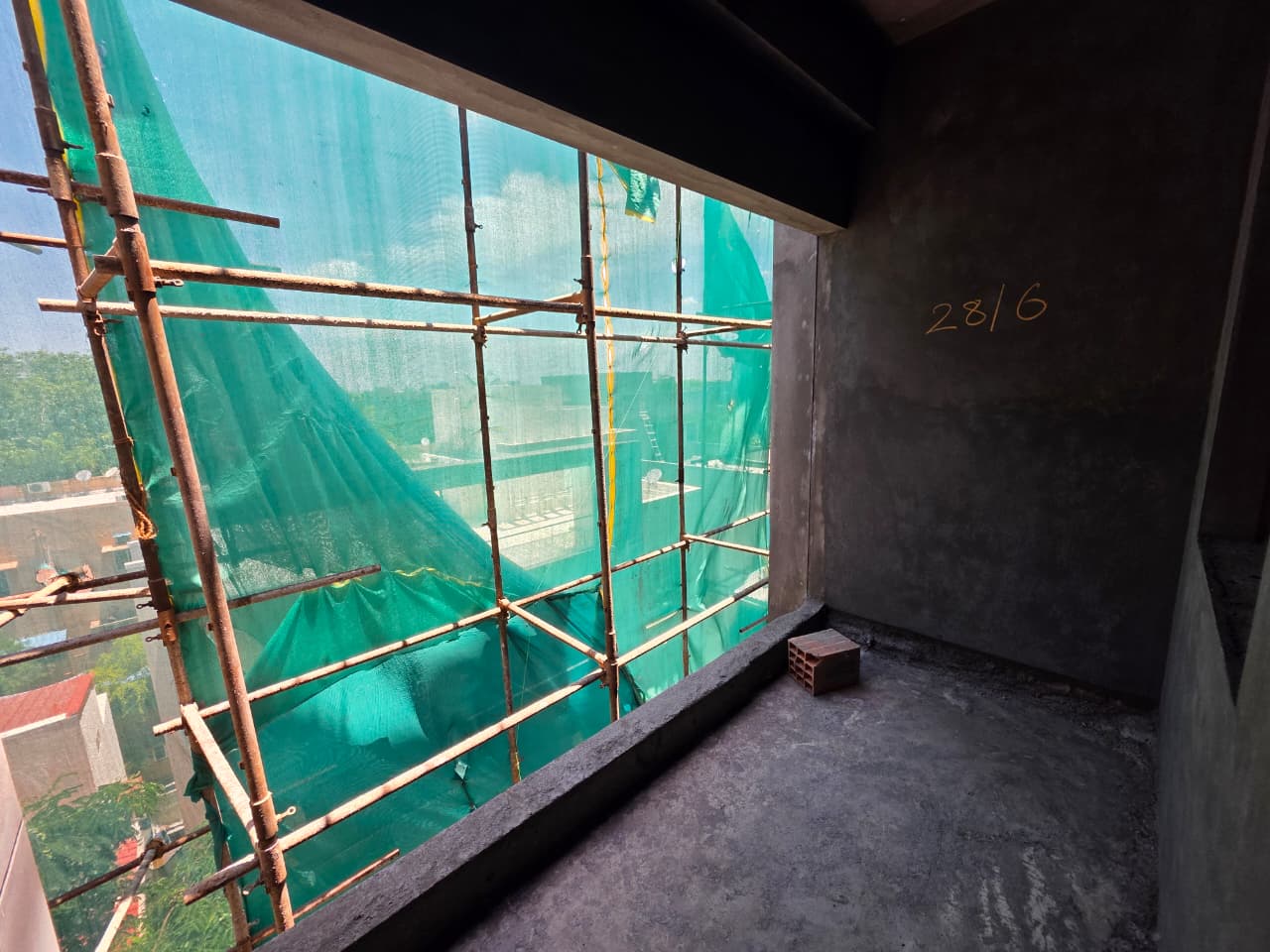

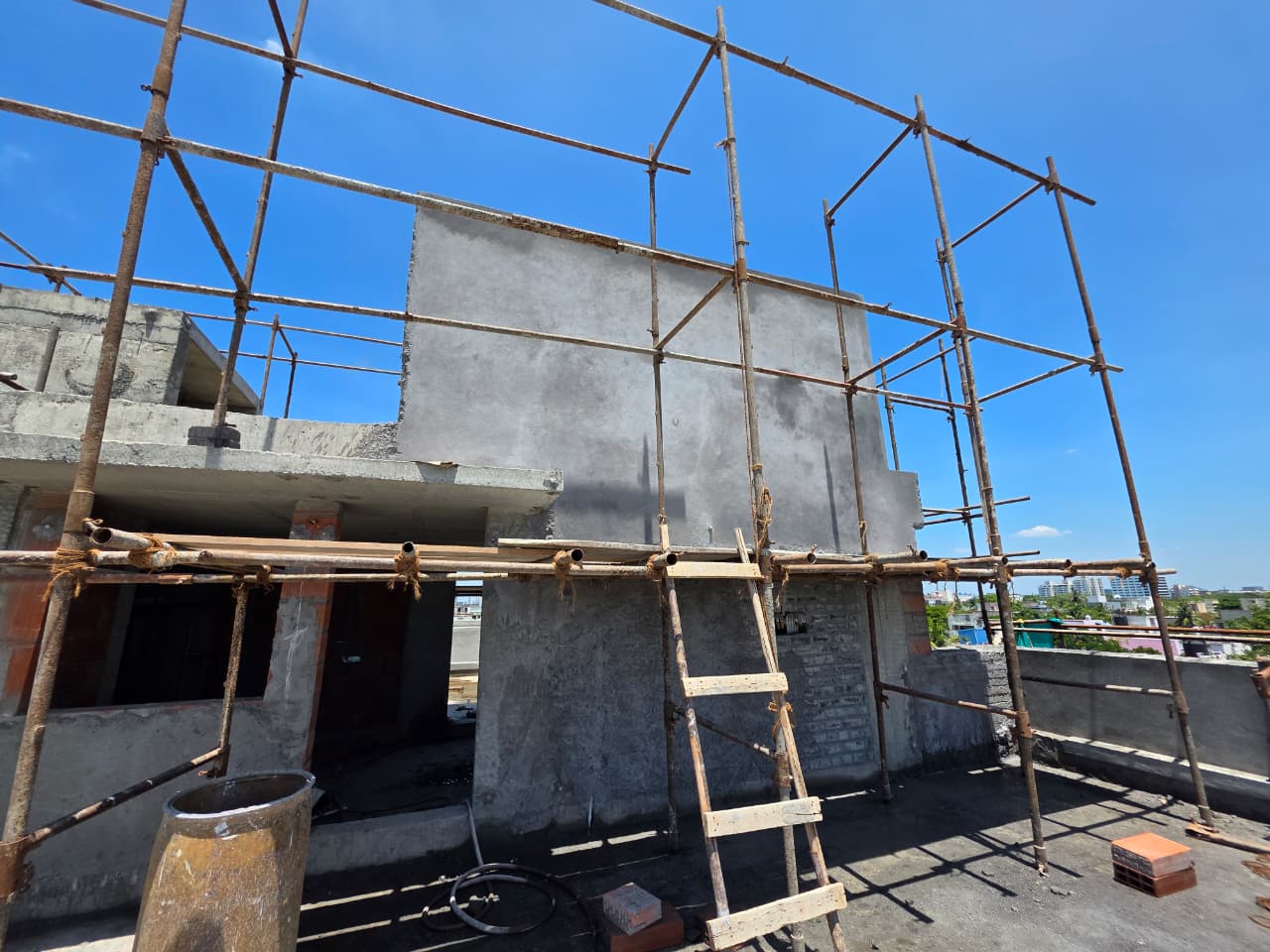

  • Up to 4th floor plastering work is in progress.

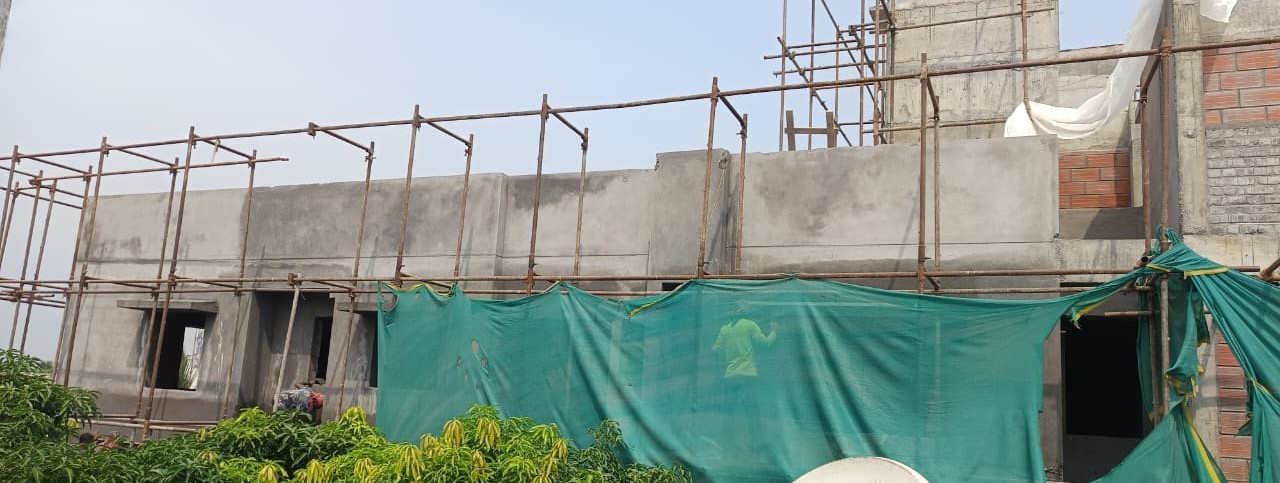

  • 5th floor plastering work is in progress.(40% completed)

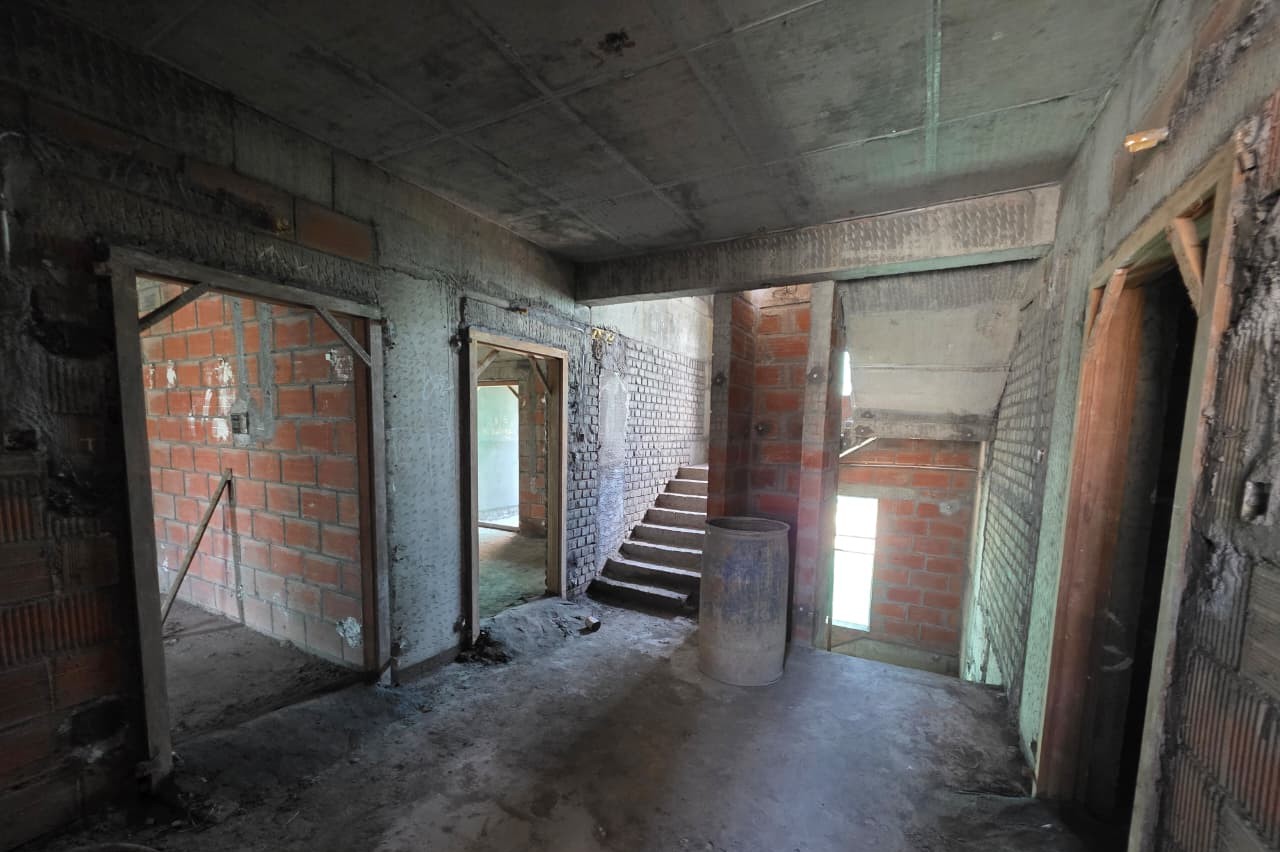

  • Inner putty work is in progress.(1st,2nd& 3rdfloor progress)

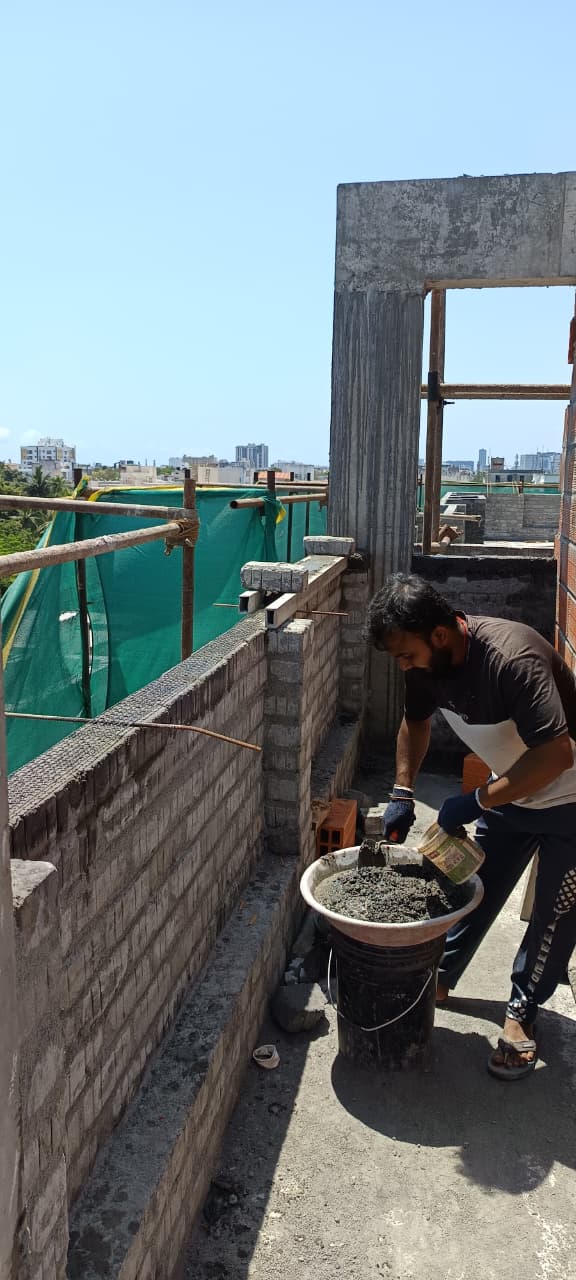

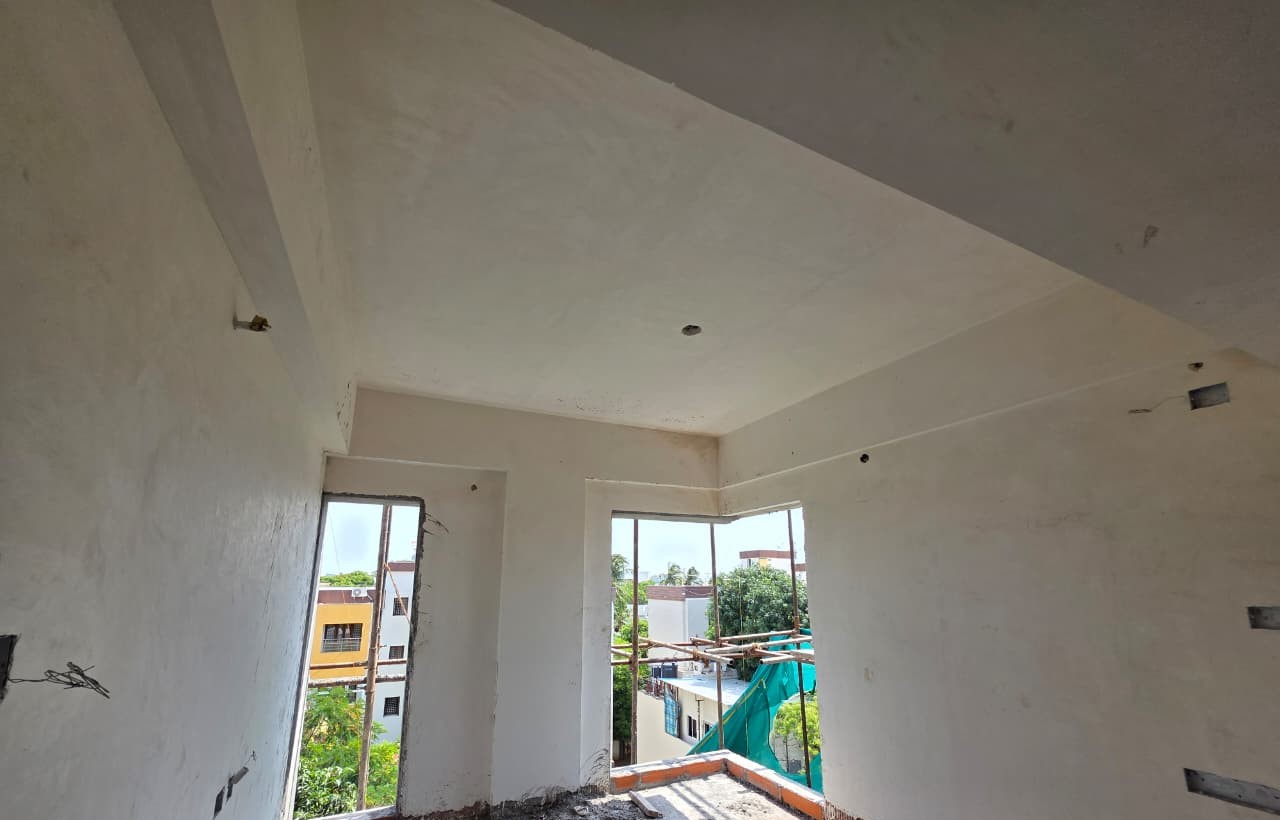

  • External plastering work is in progress.(50% completed)
  • Toilet plumbing work is in progress.(upto 3rd floor completed, 4th& 5thfloor progress)
  • Toilet wall tiles work is in progress. (1st& 2nd floor progress)

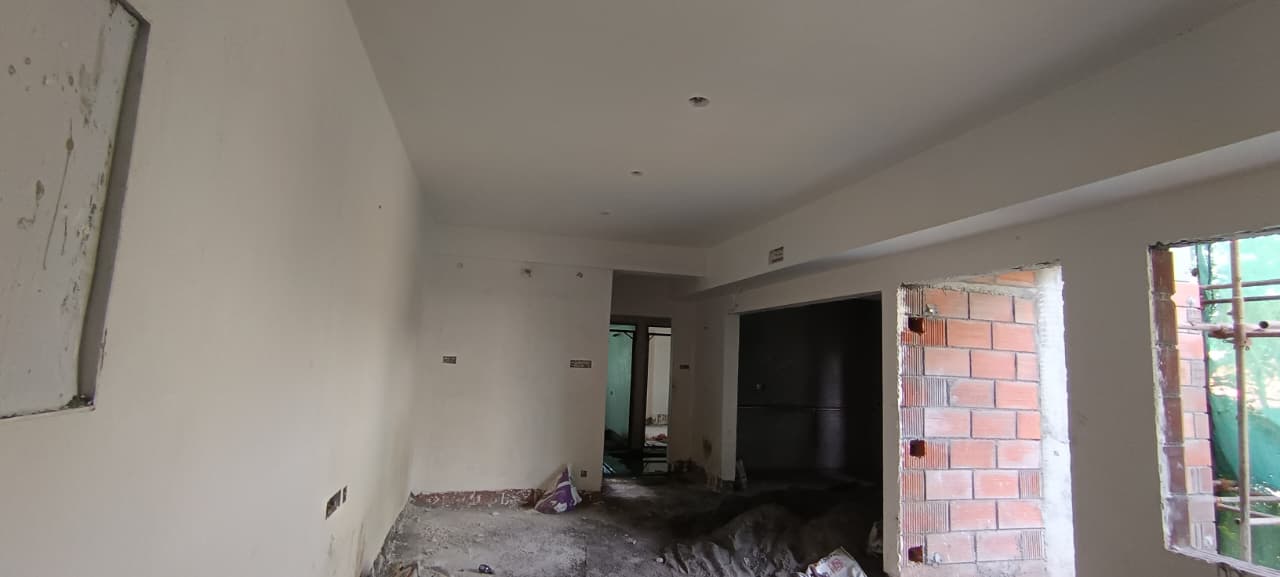

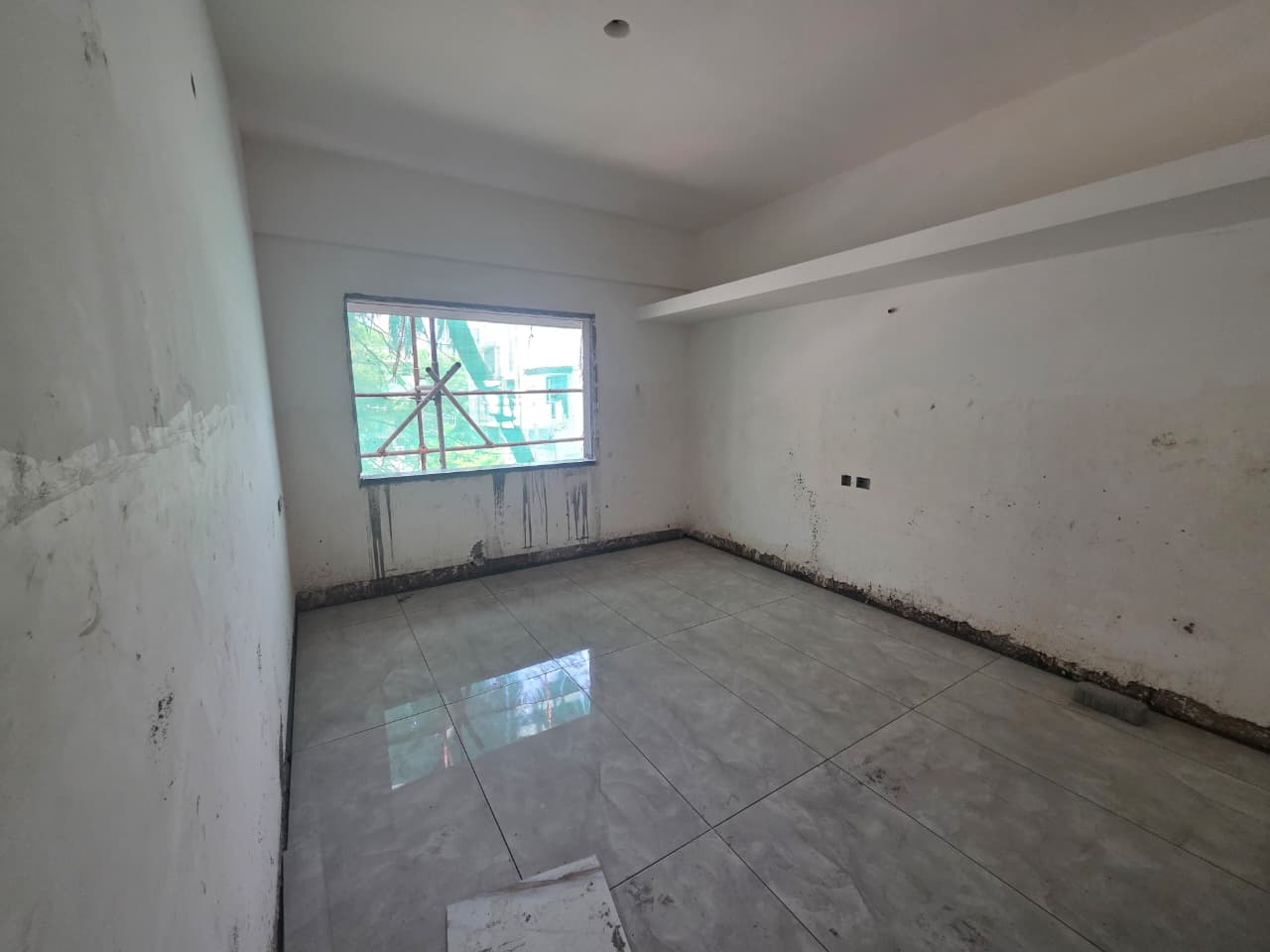

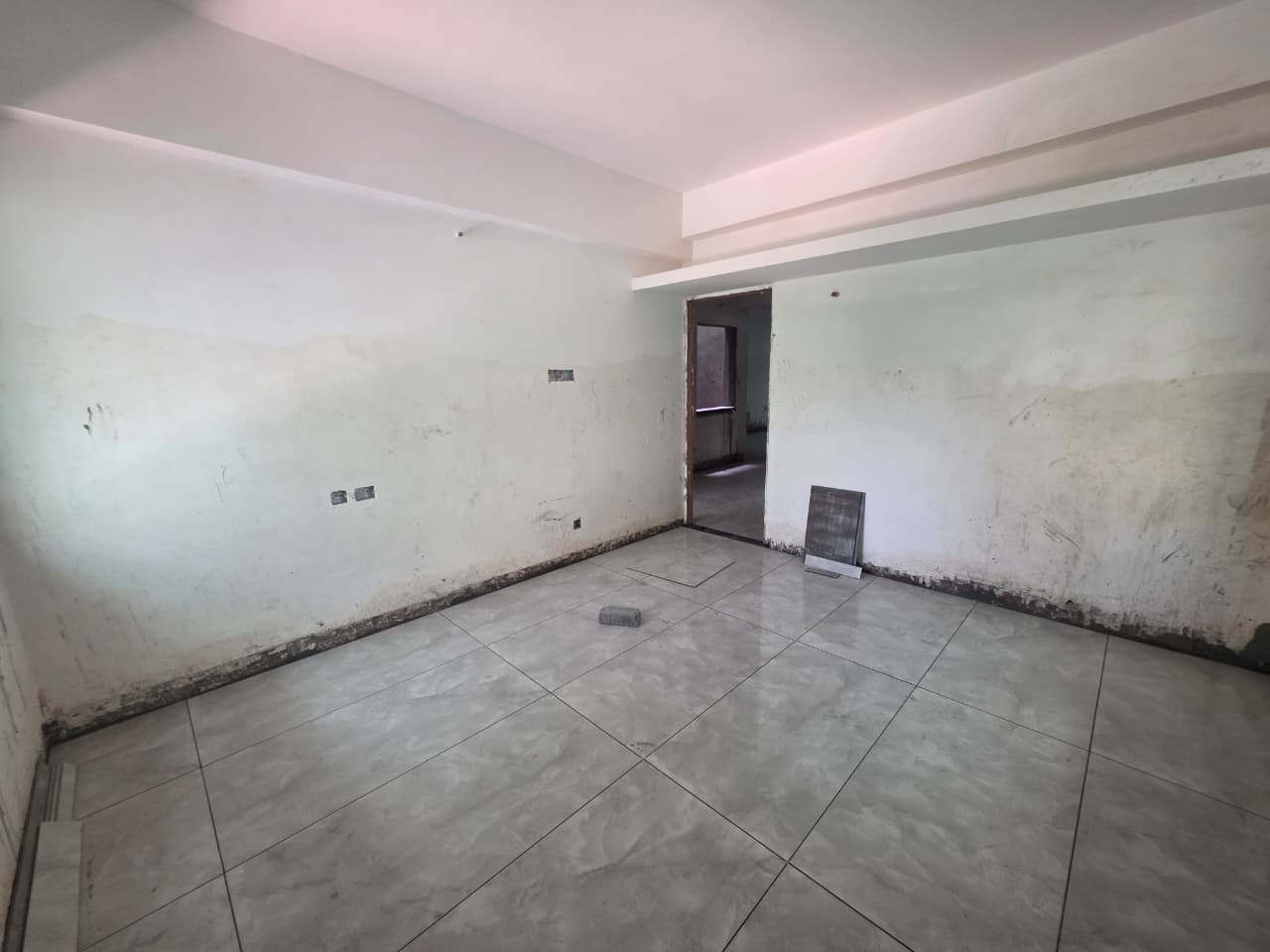

  • General main flooring work is in progress.(2nd floor progress)

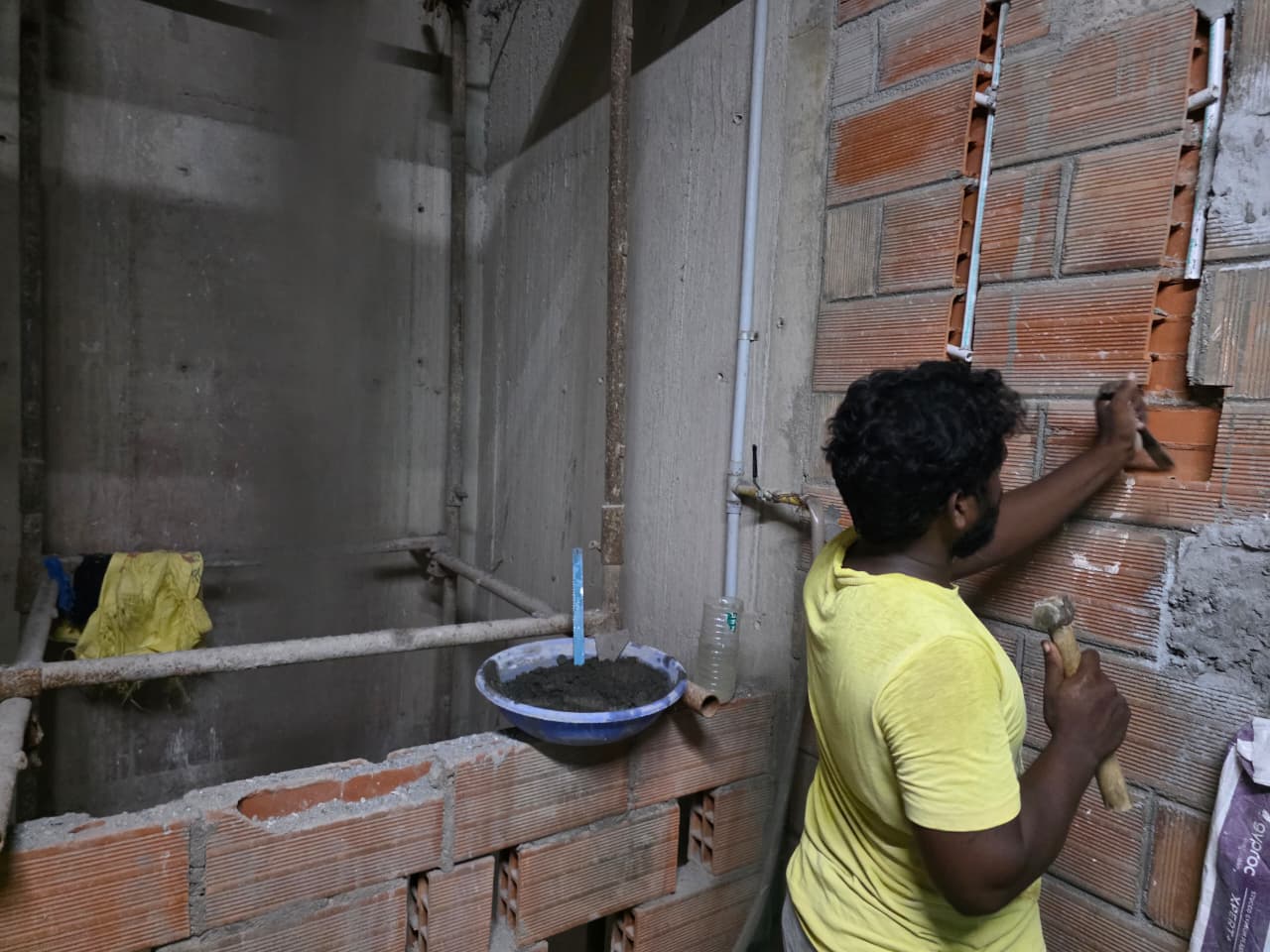

  • All floor jambs granite work is in progress.

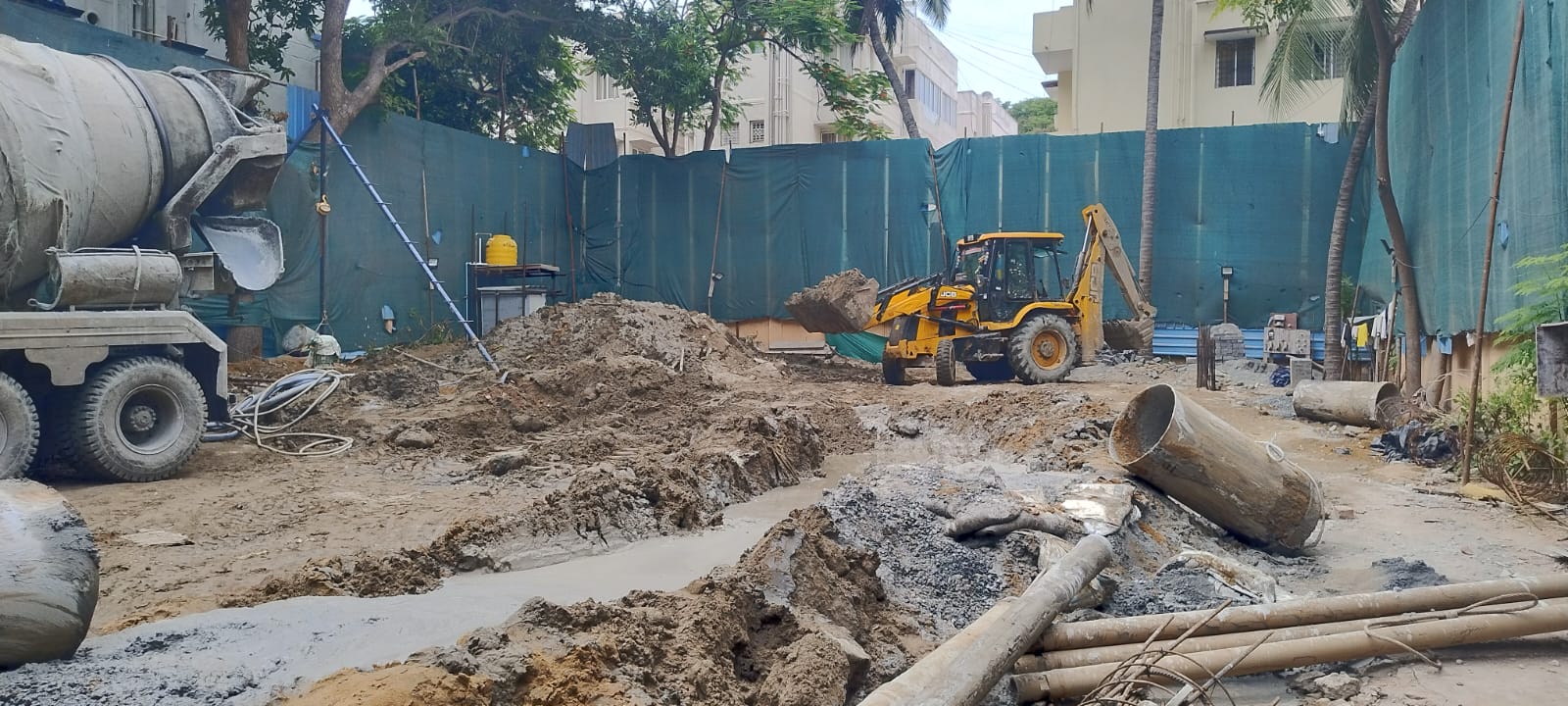

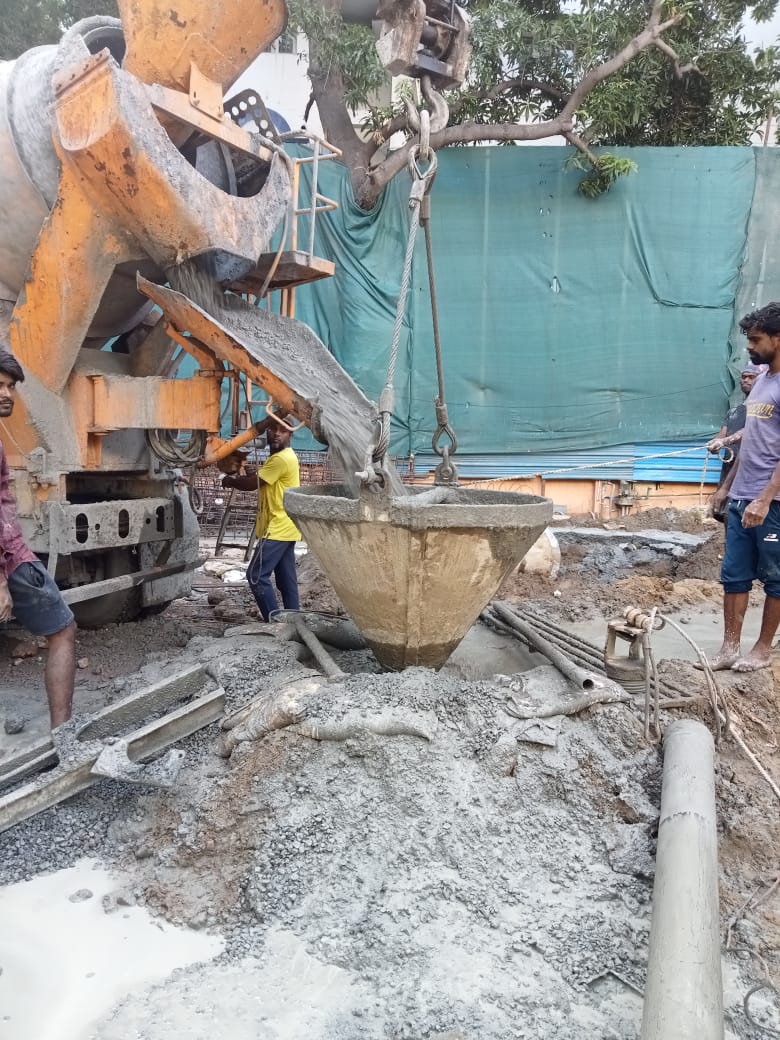

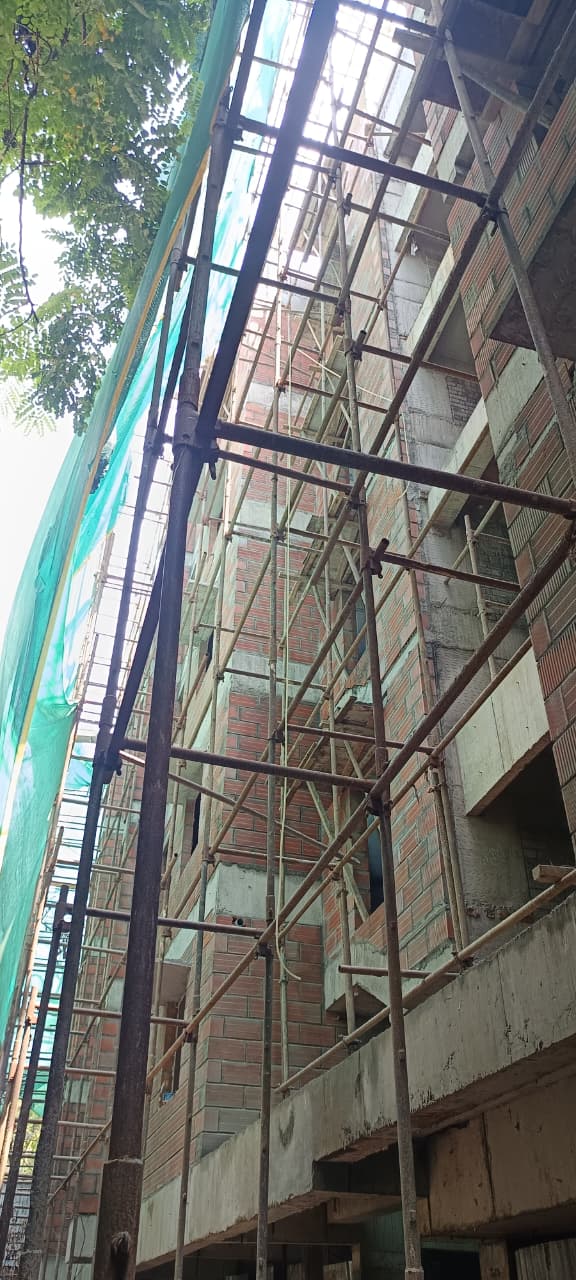

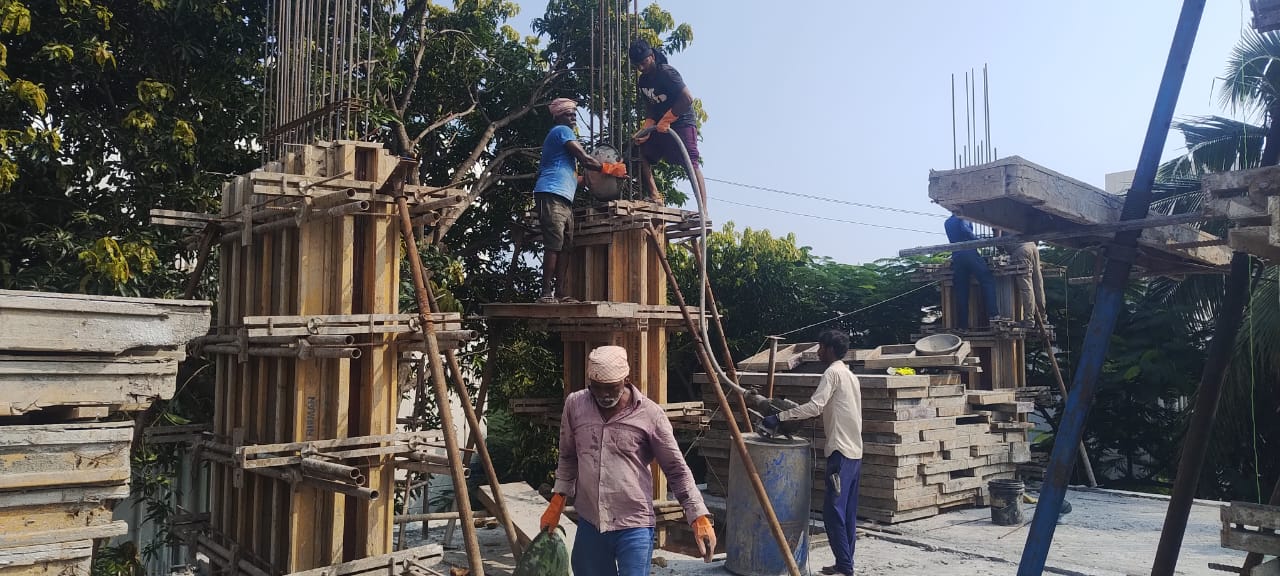

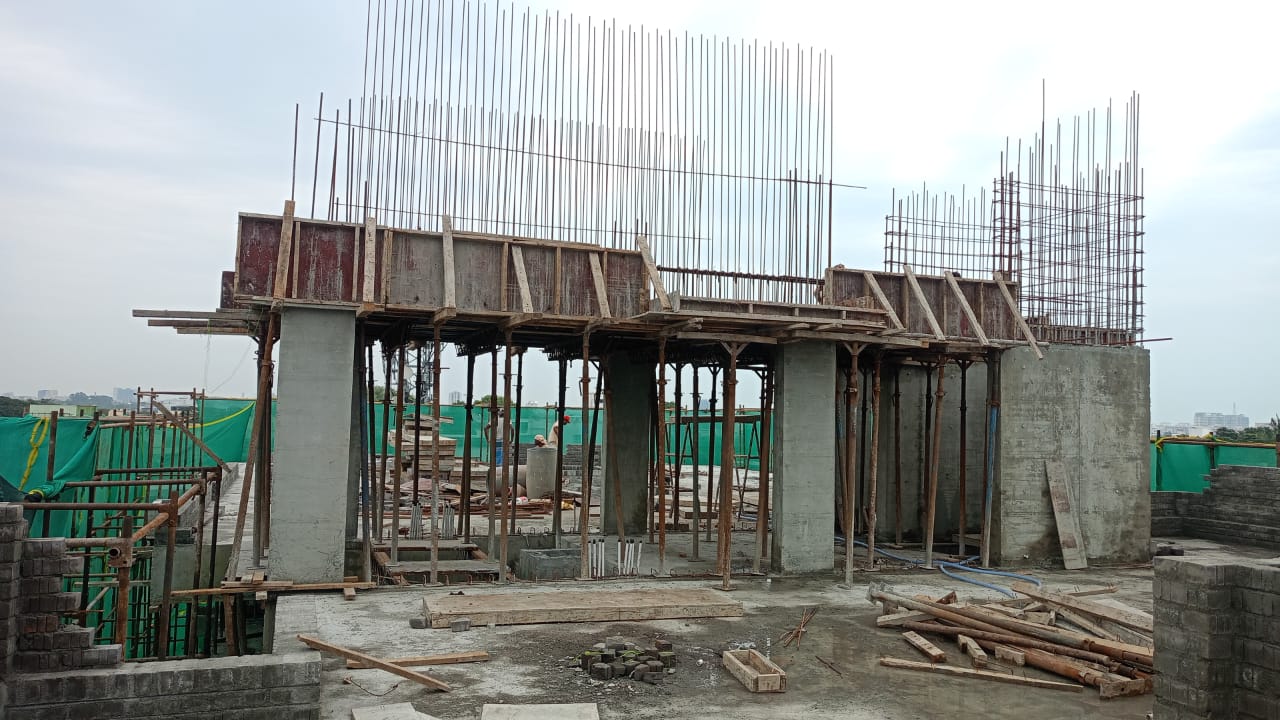

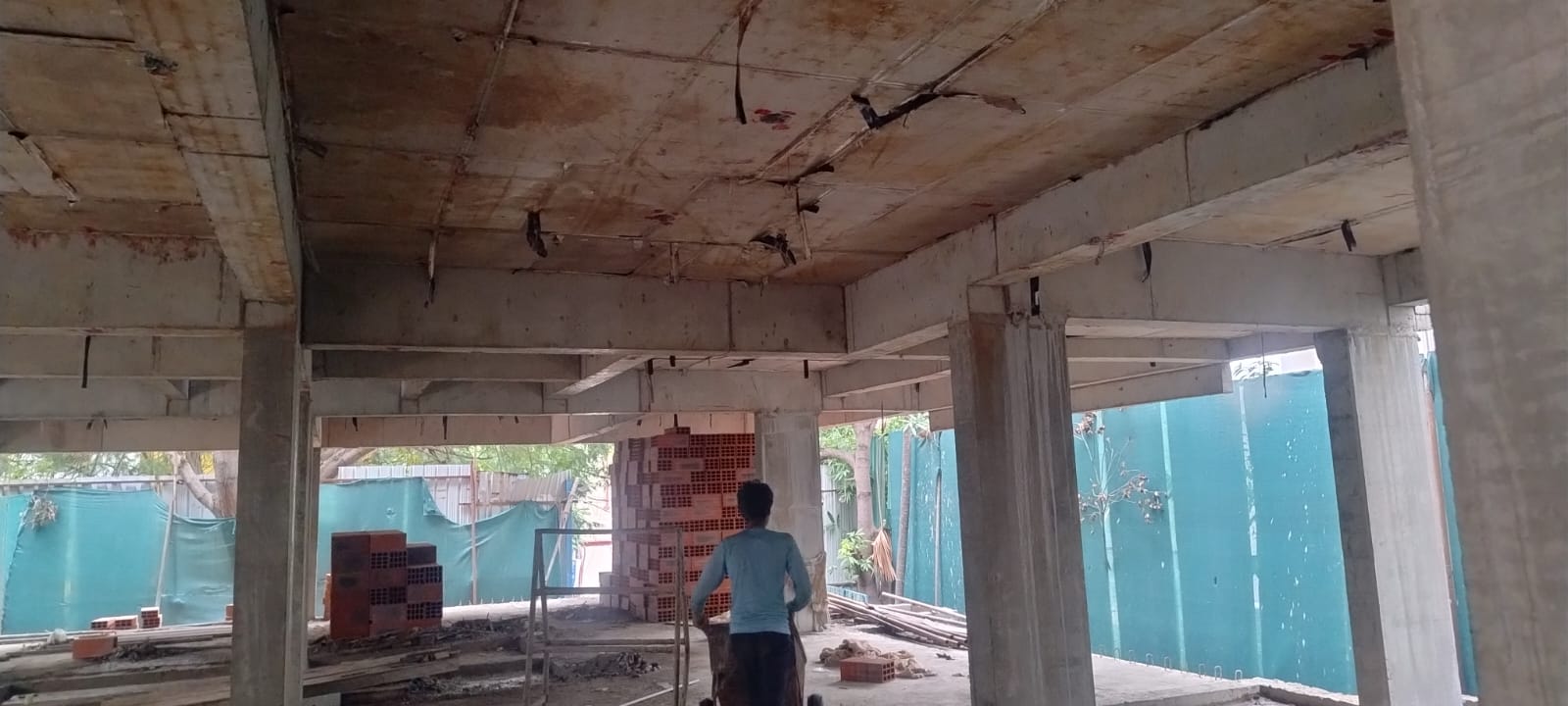

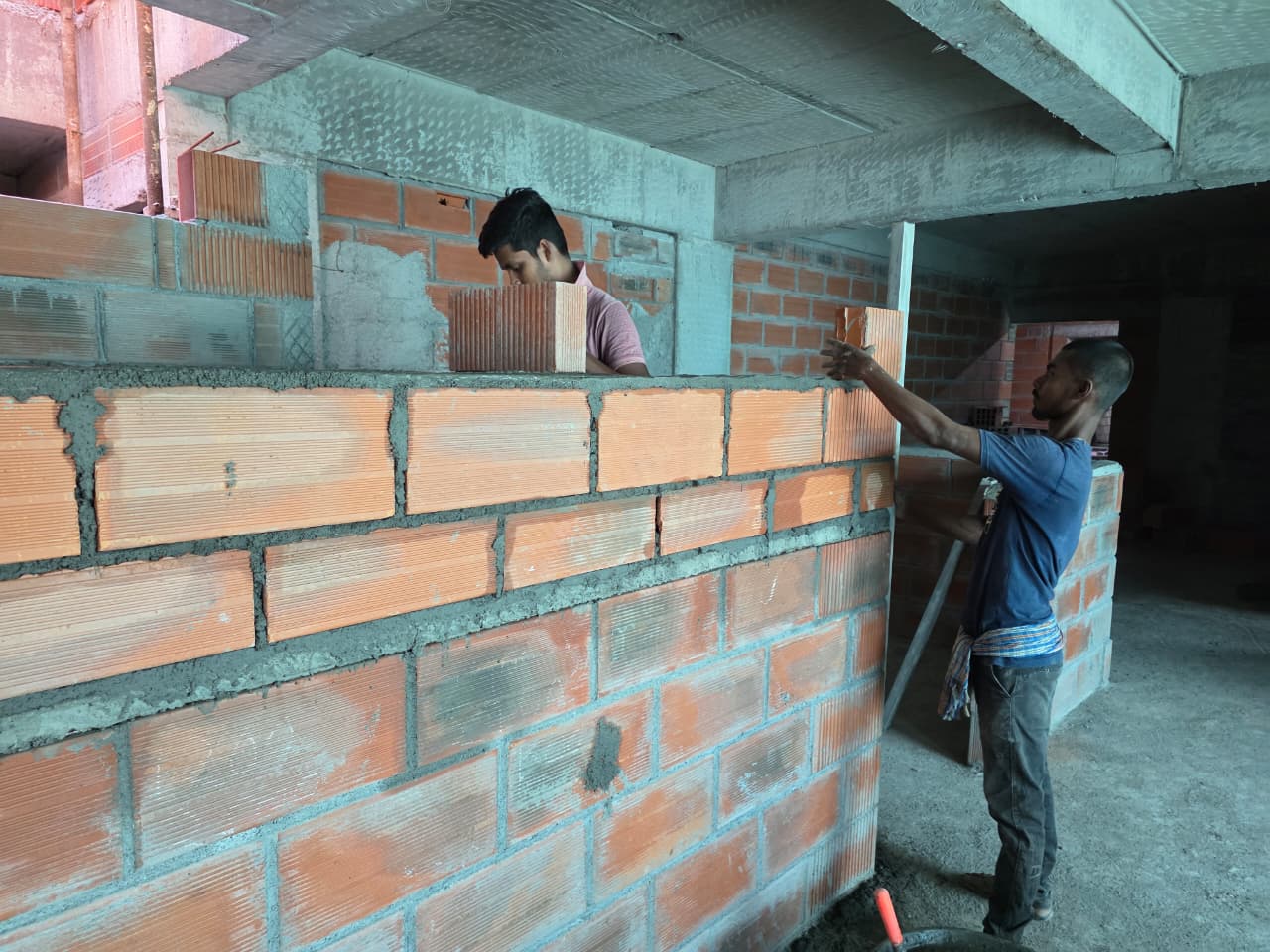

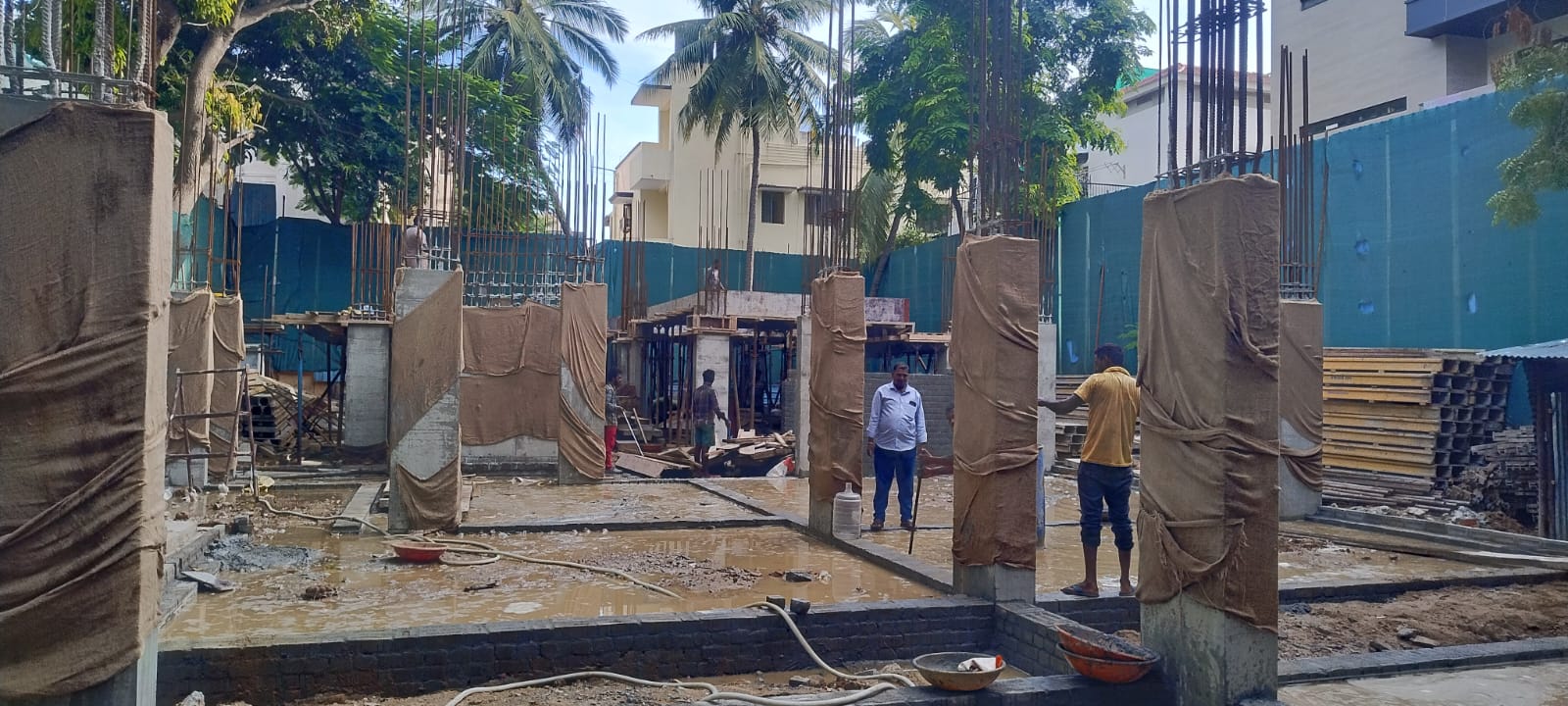

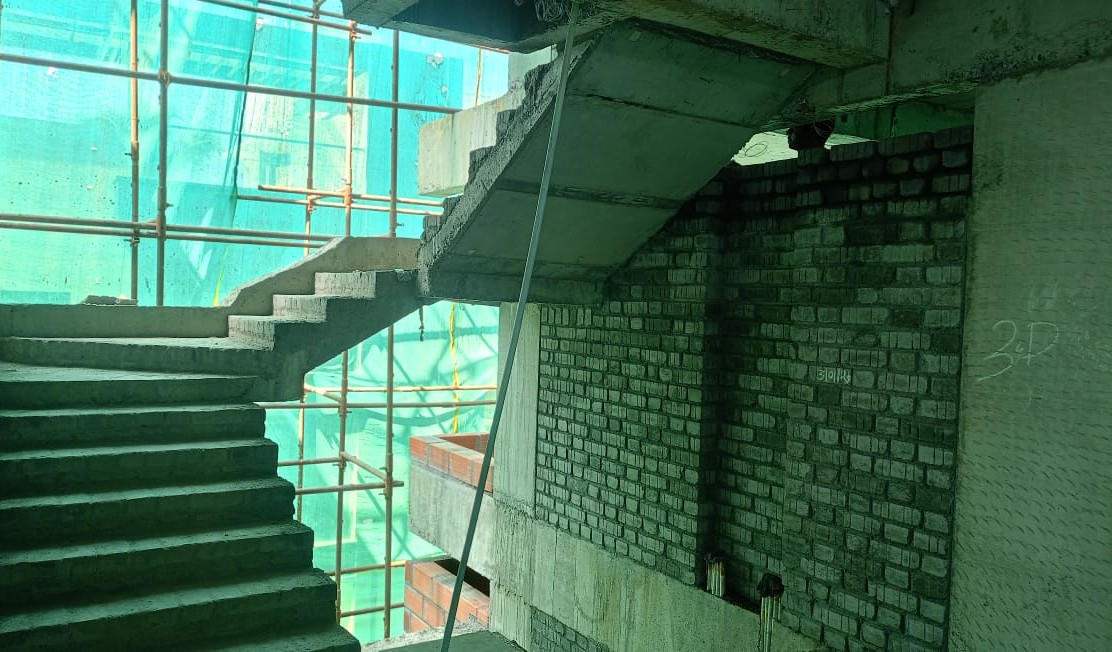

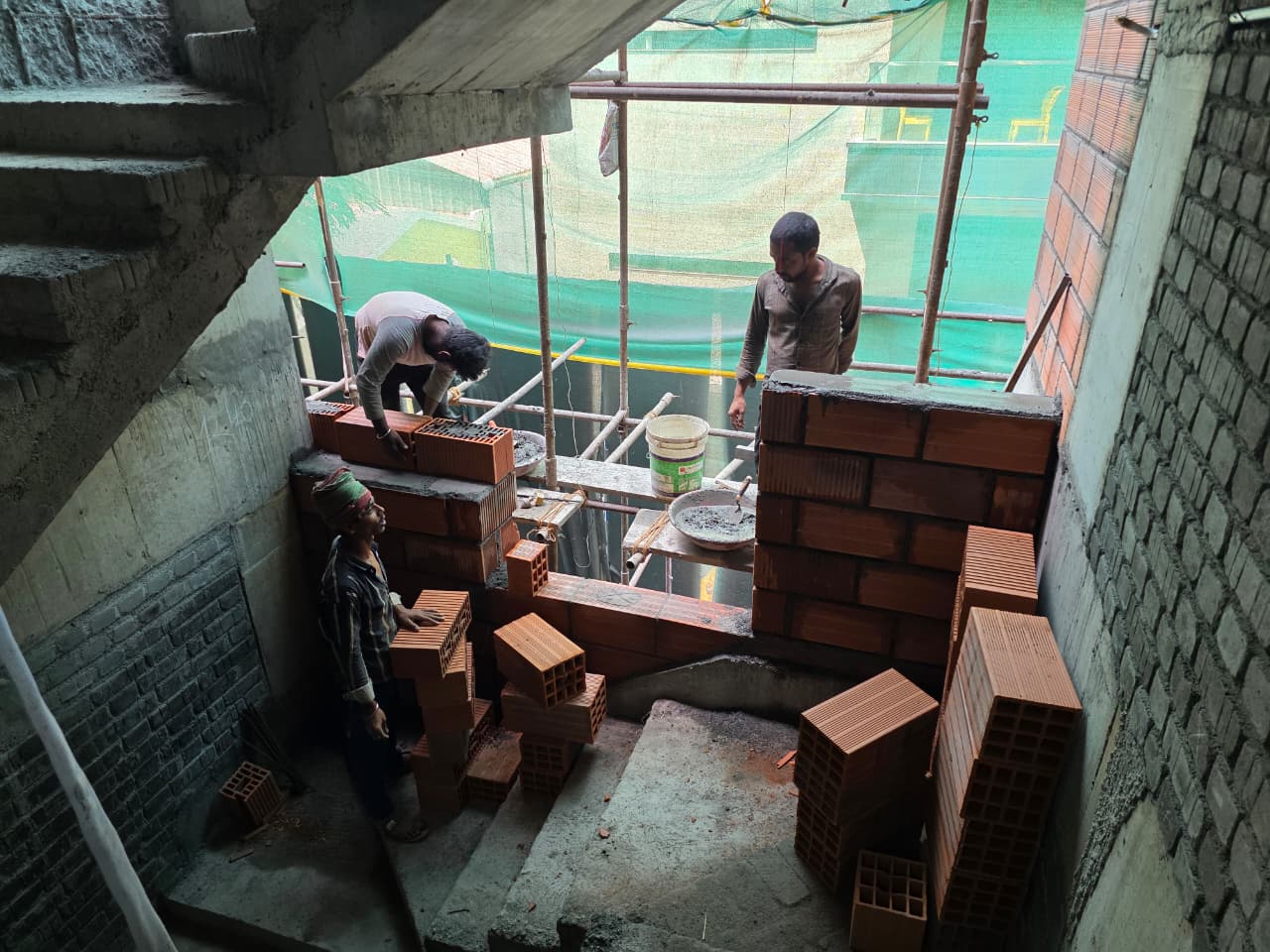

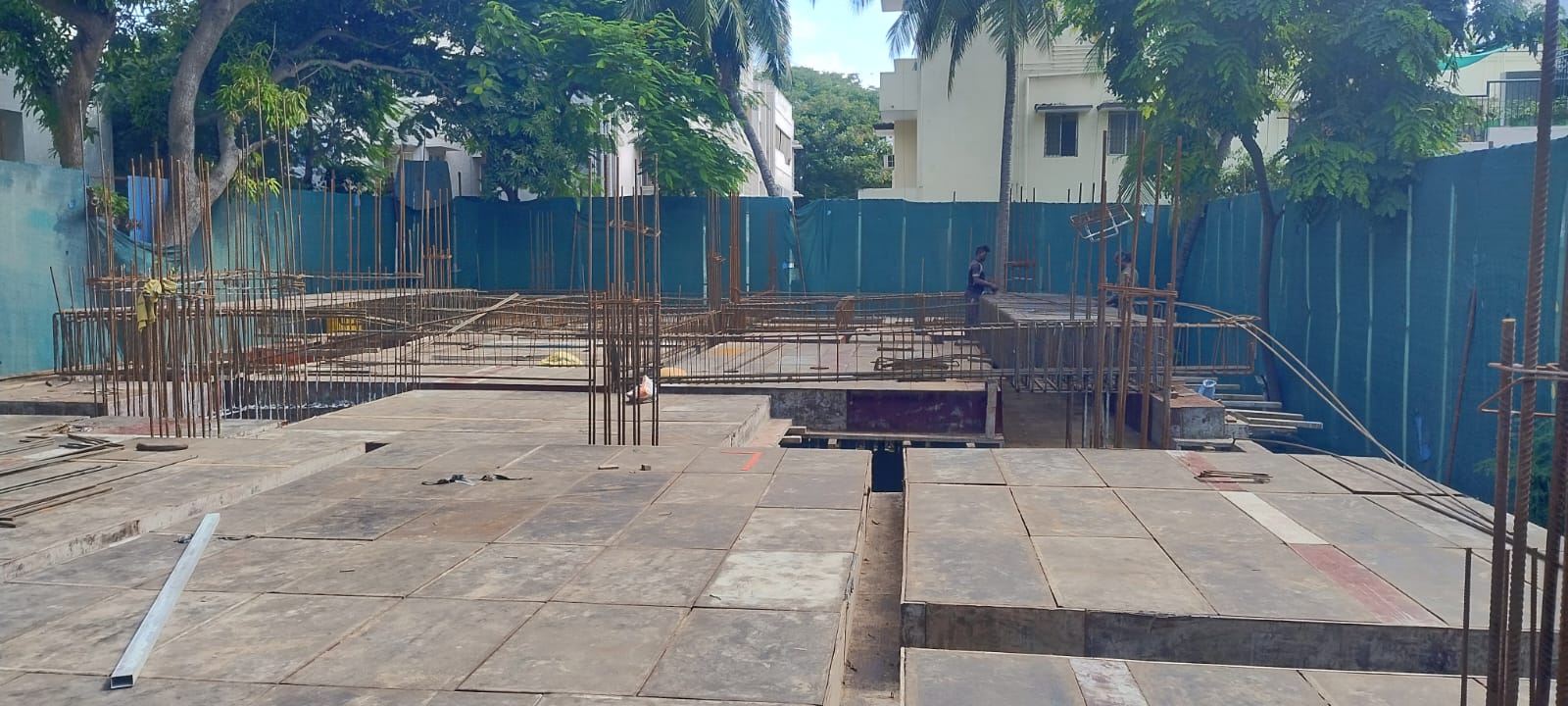

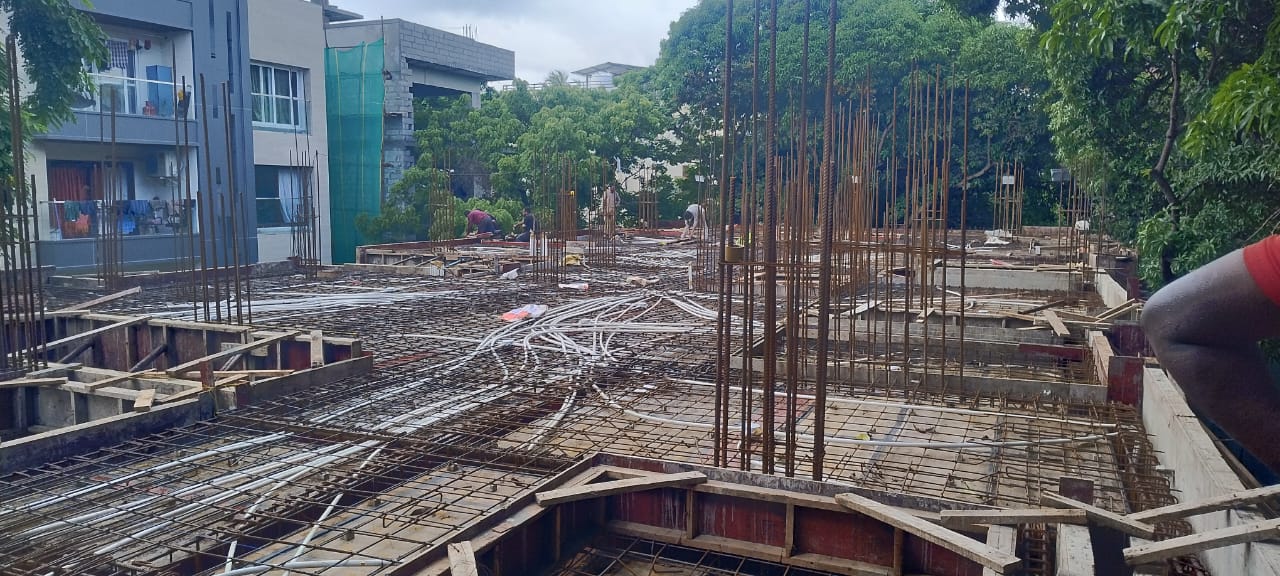

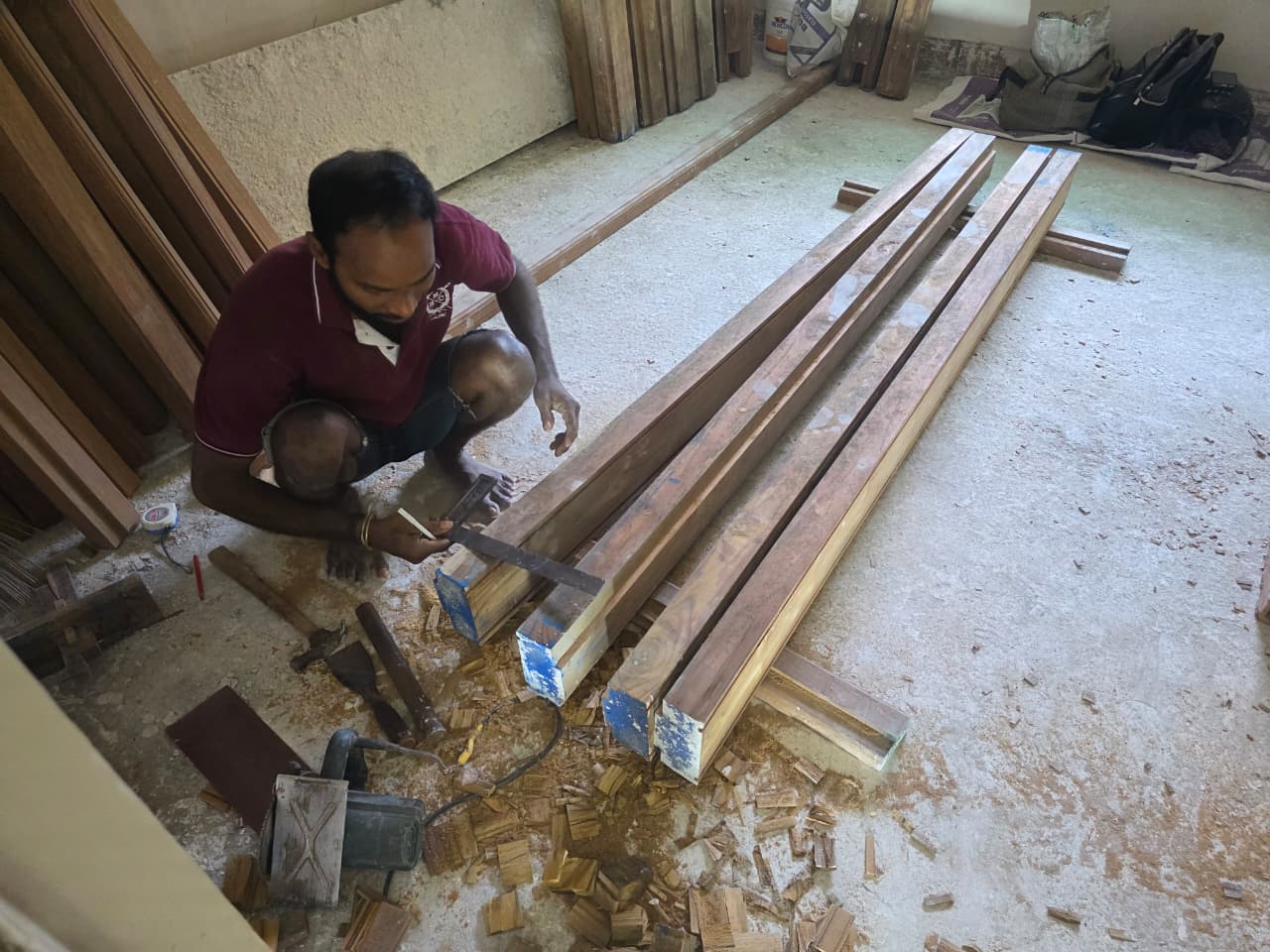

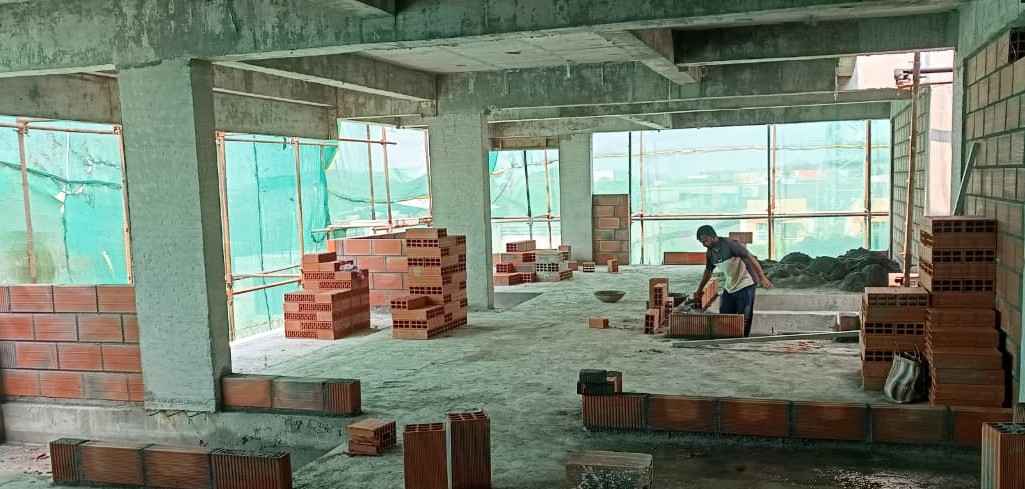

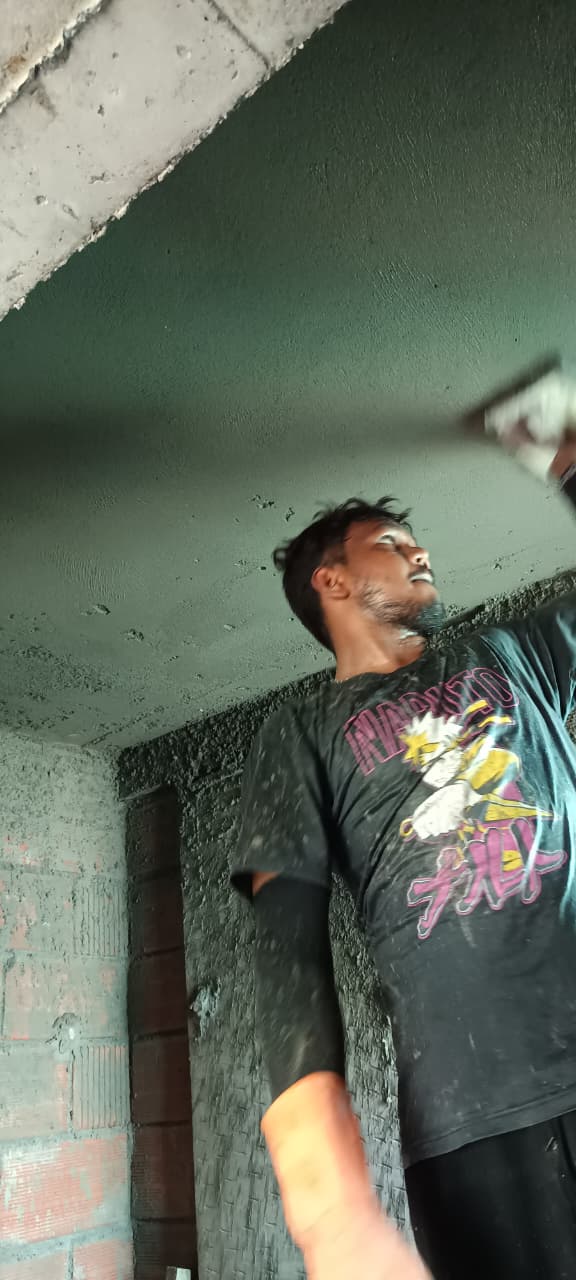

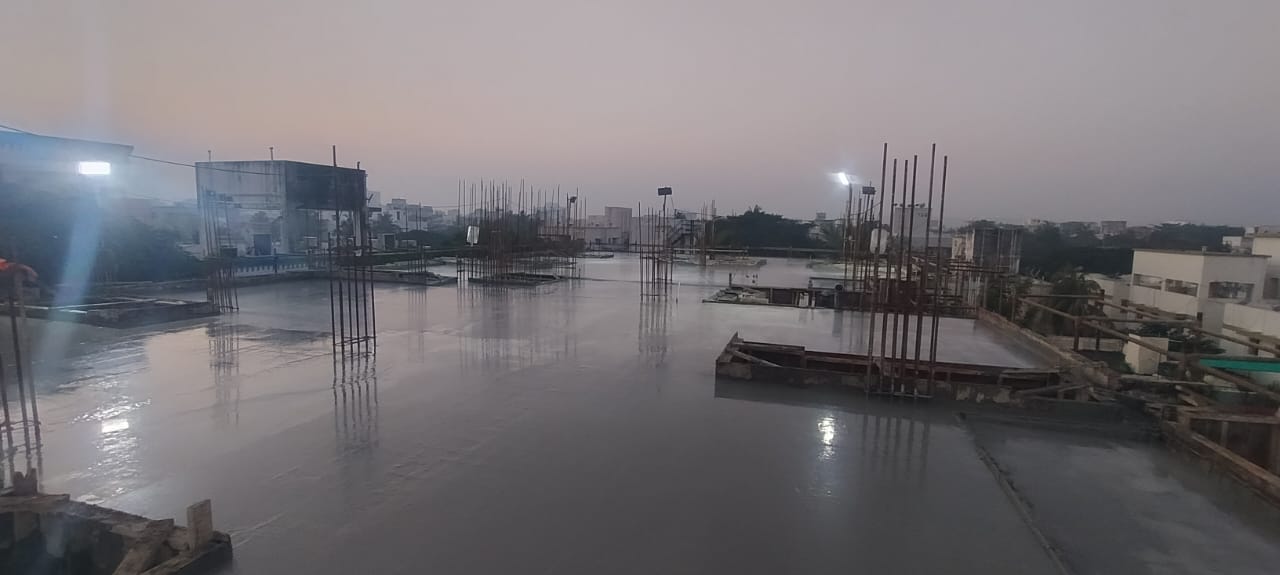

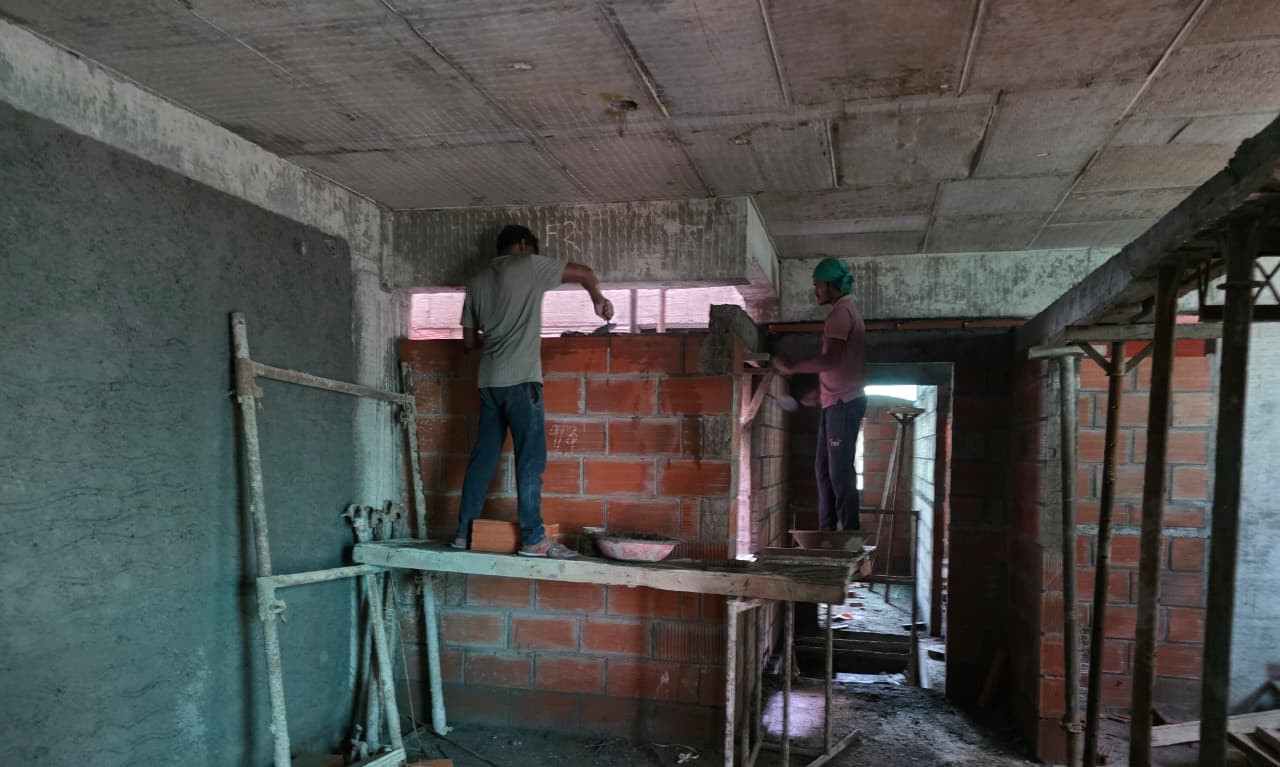

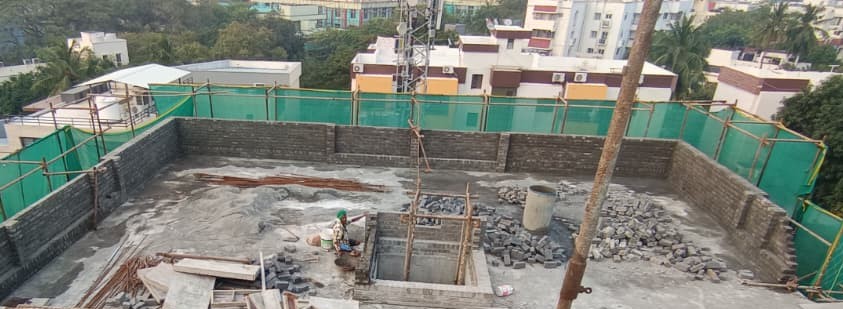

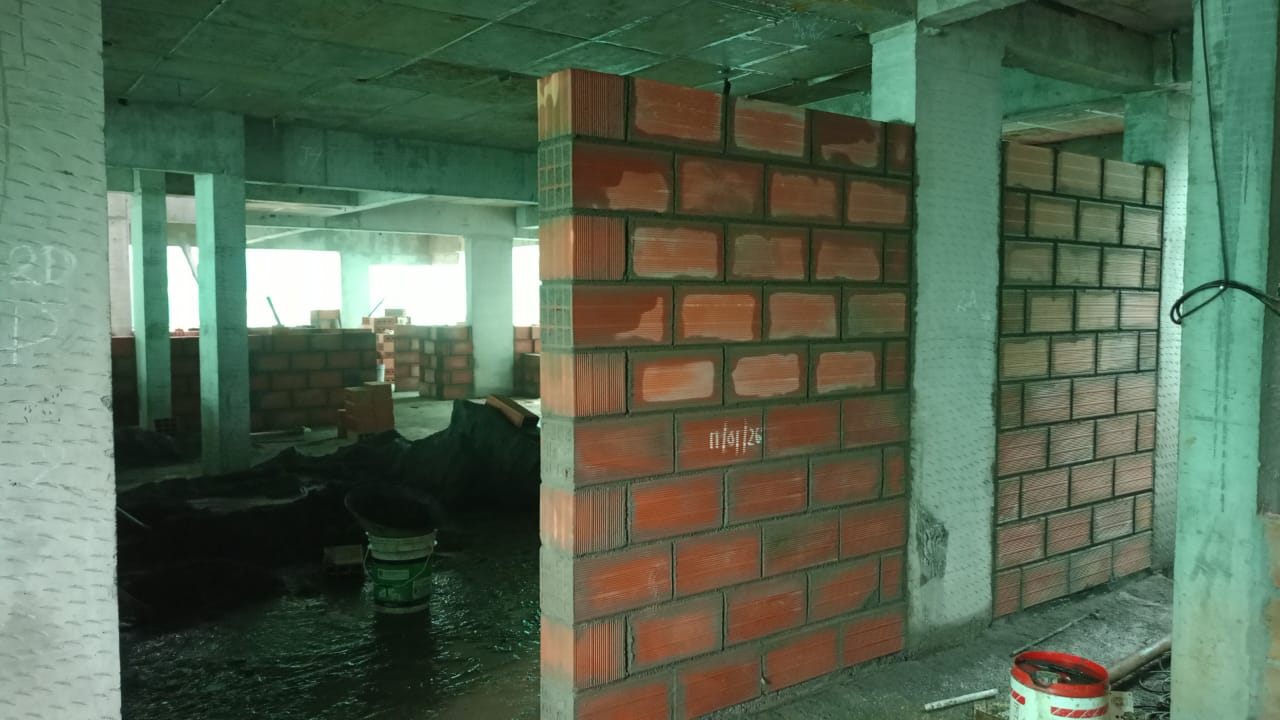

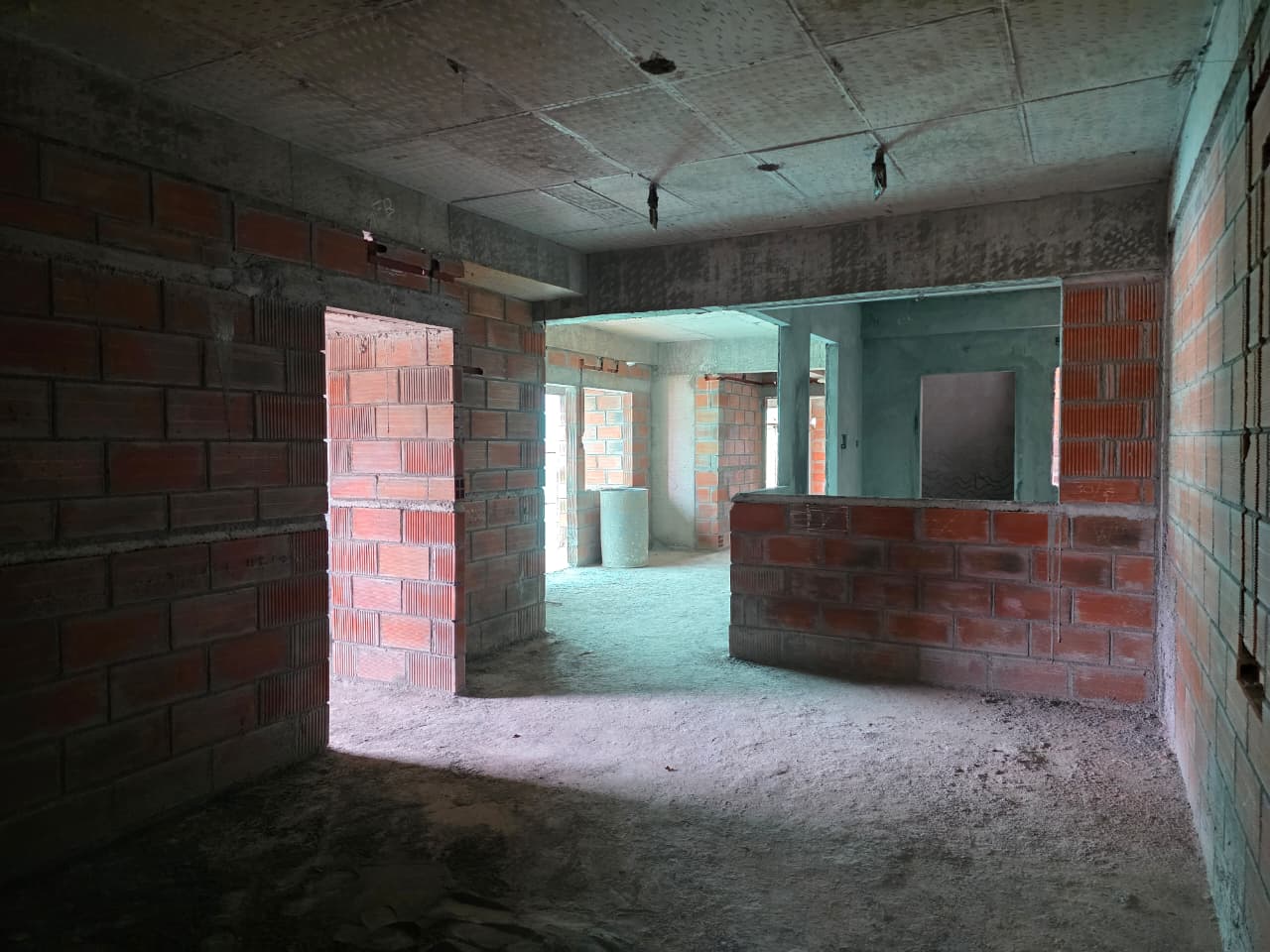

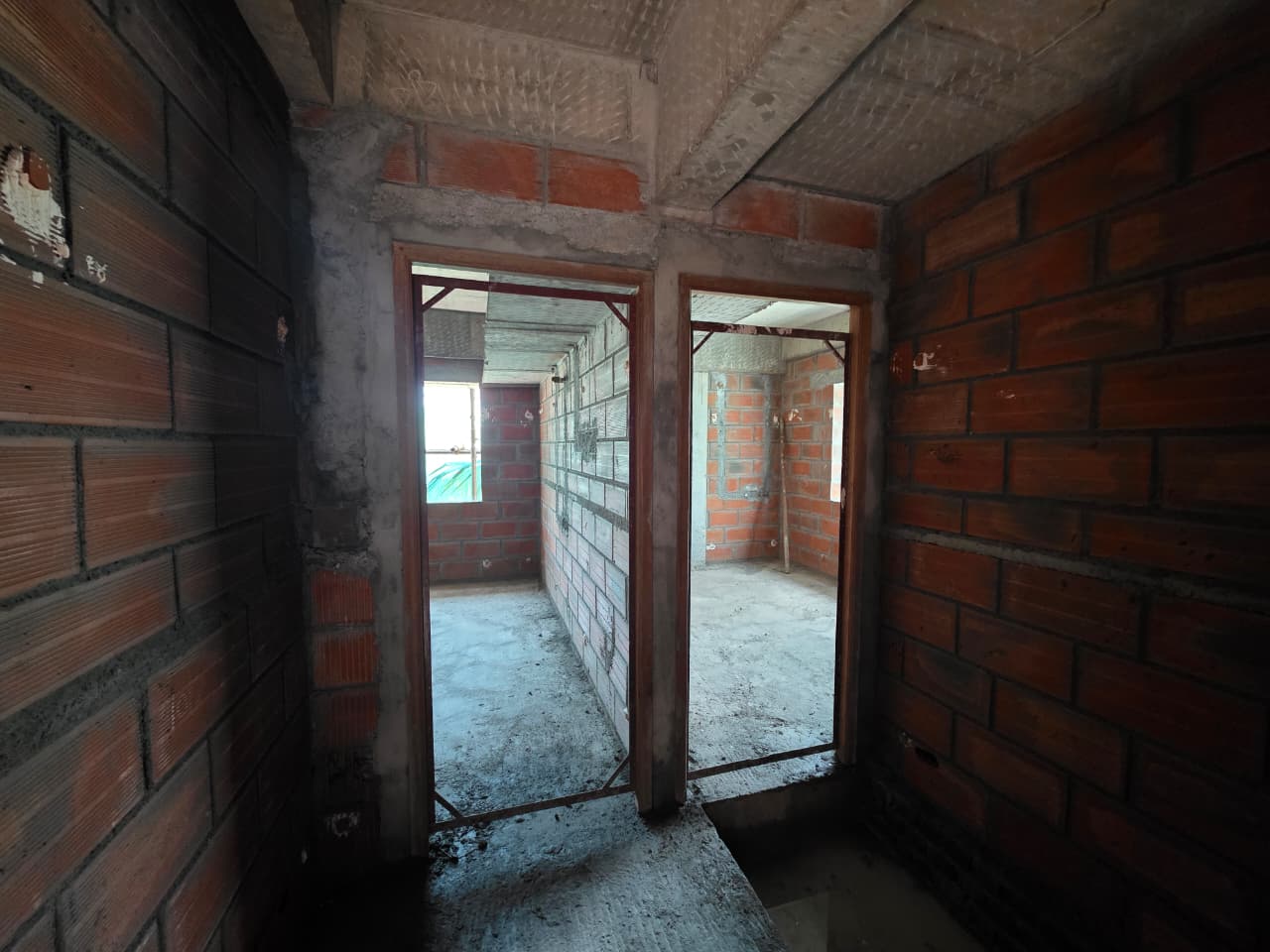

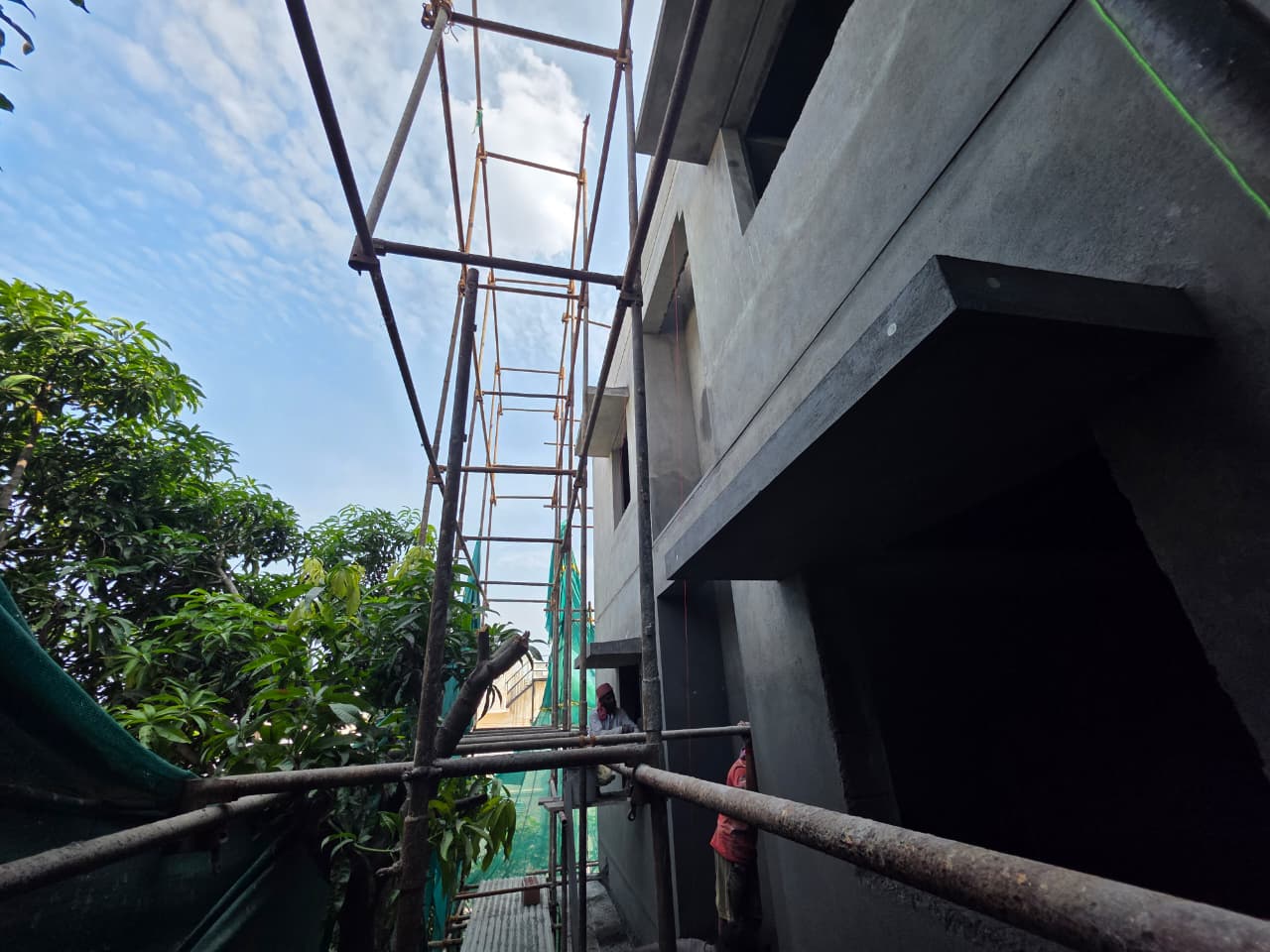

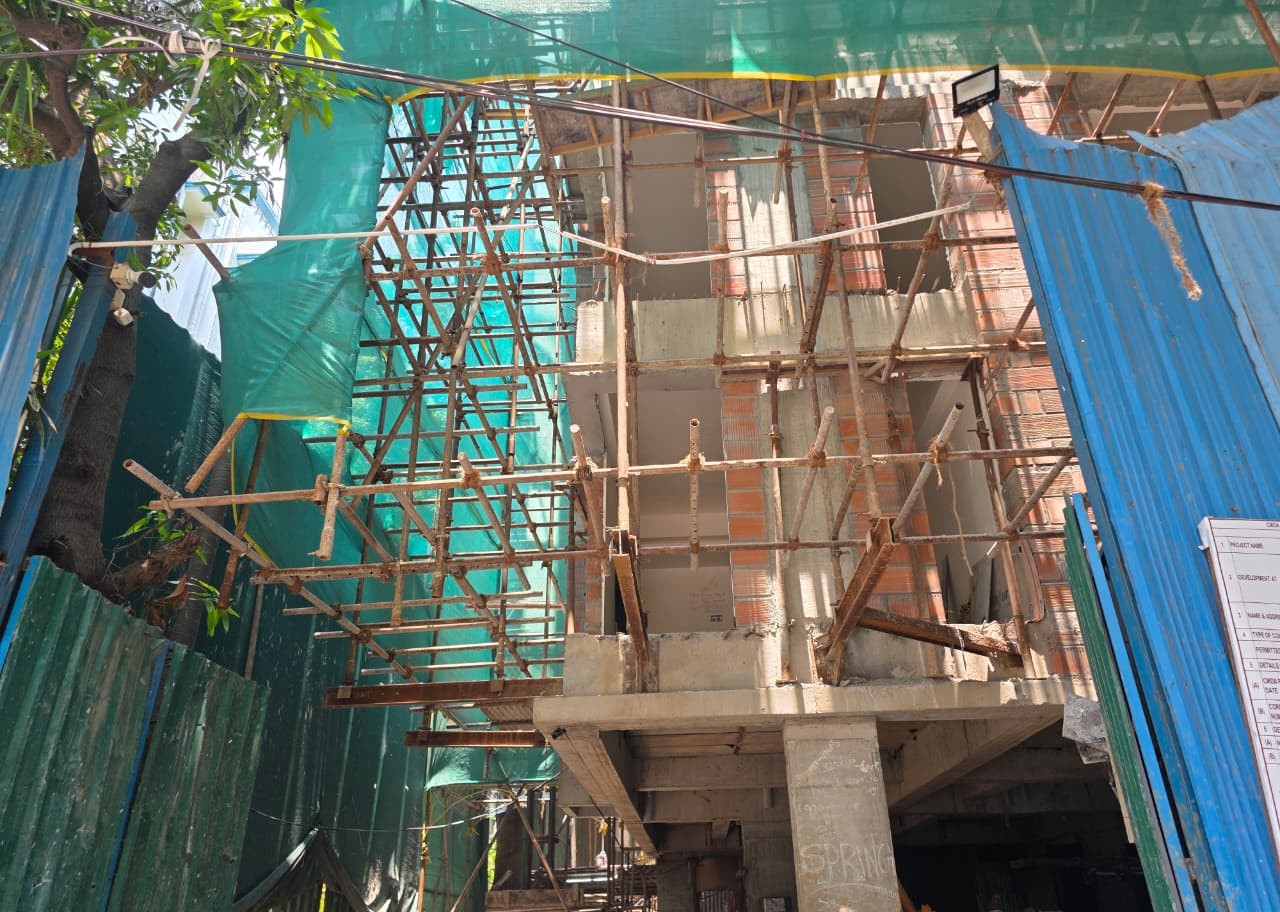

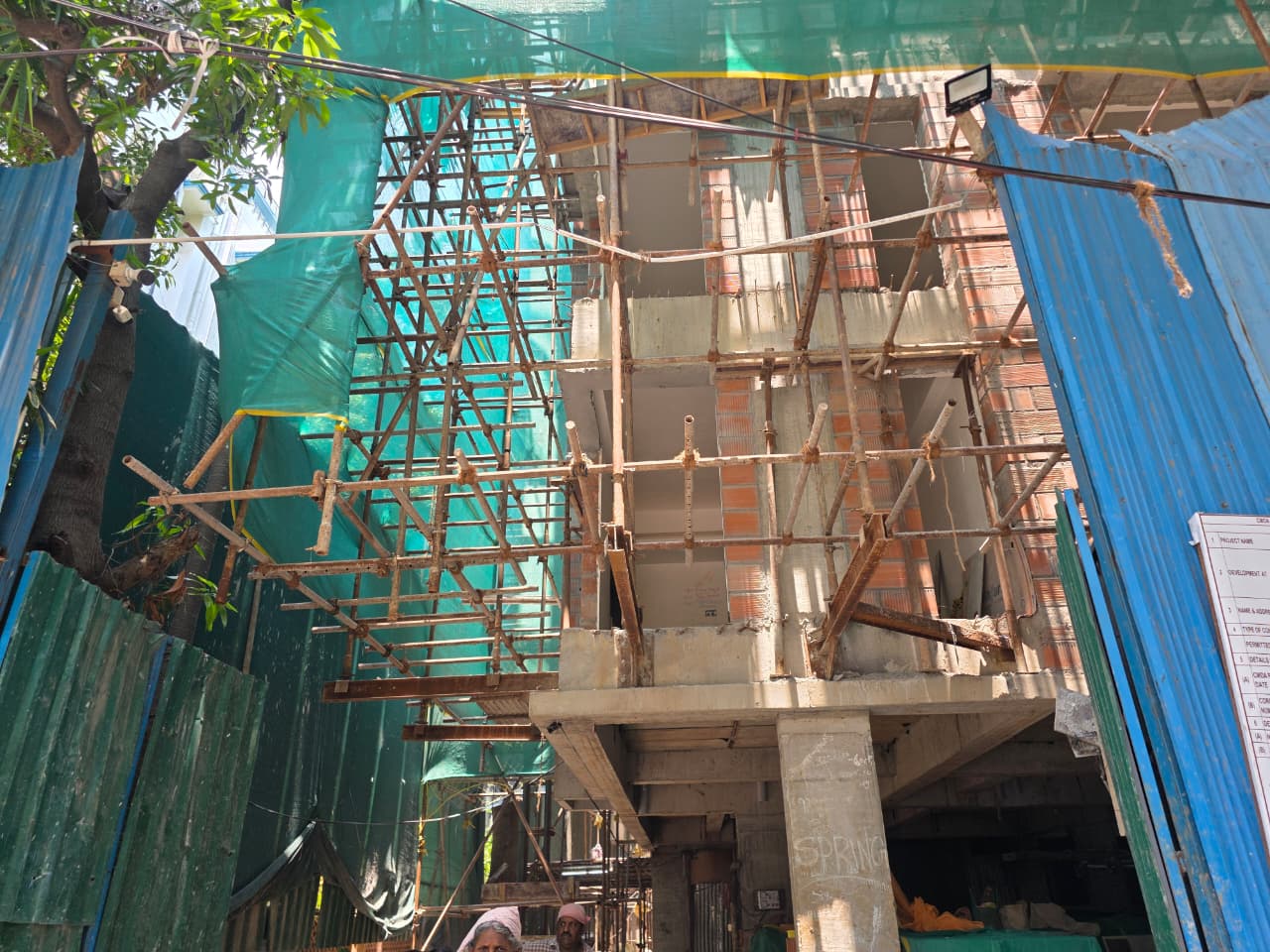

Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image

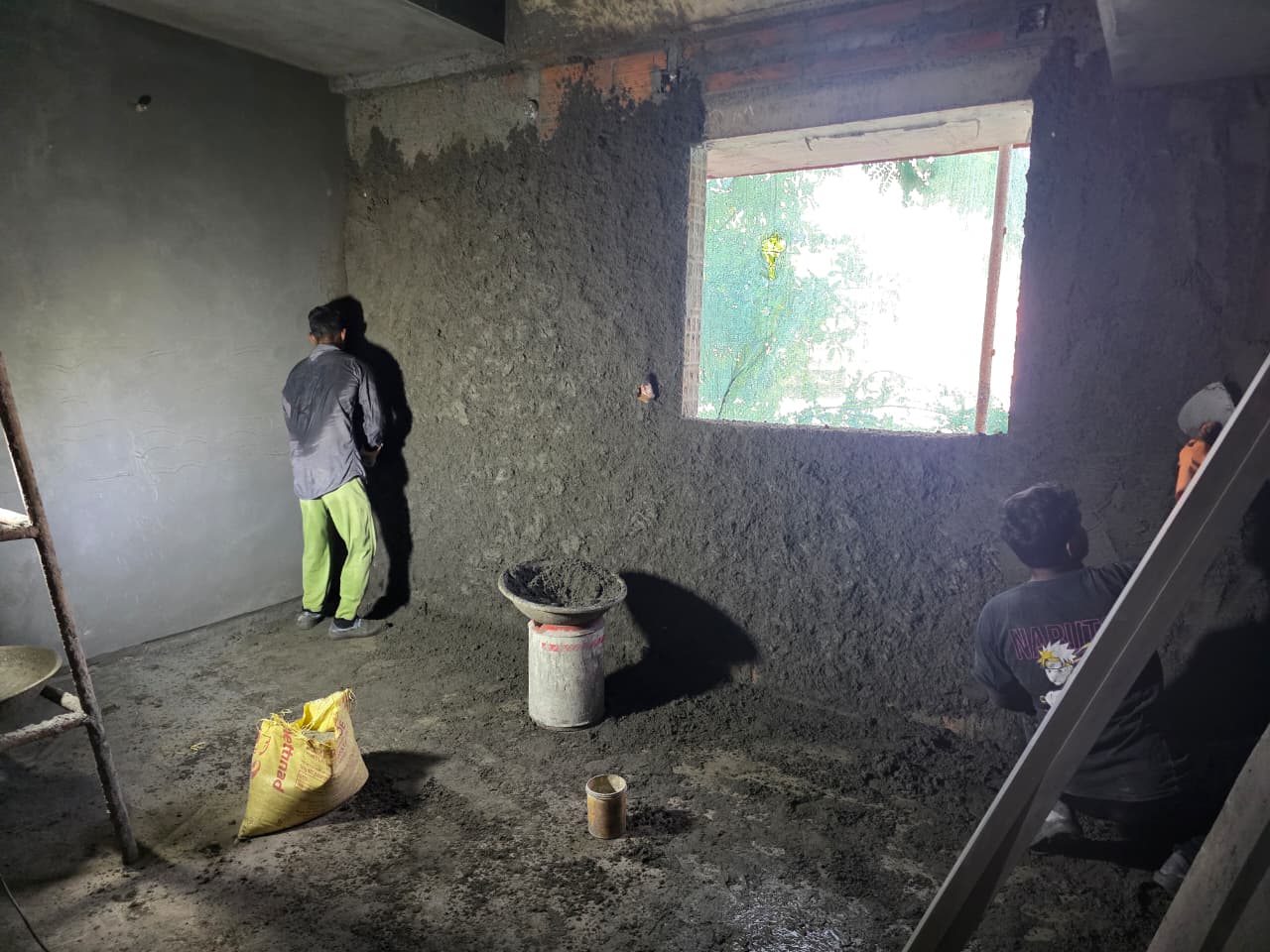

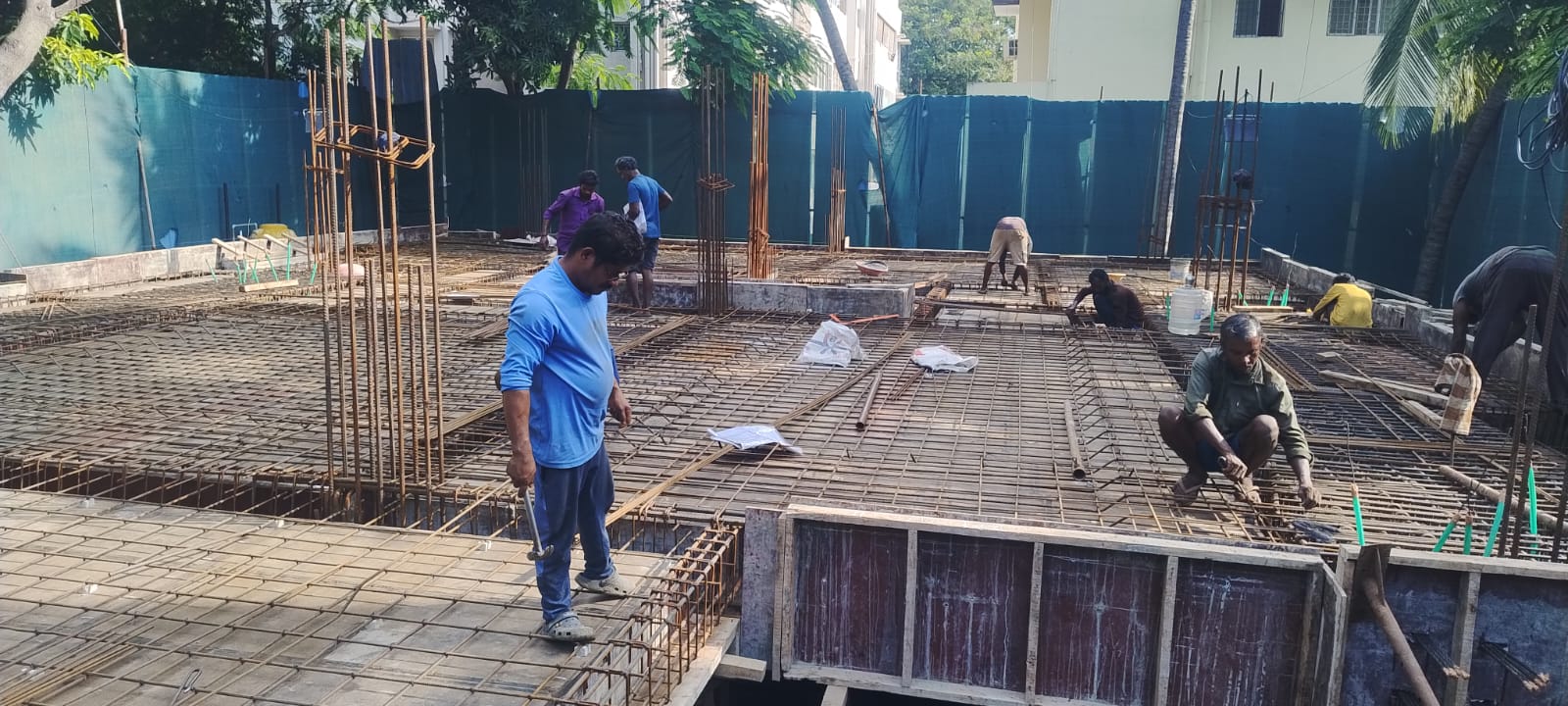

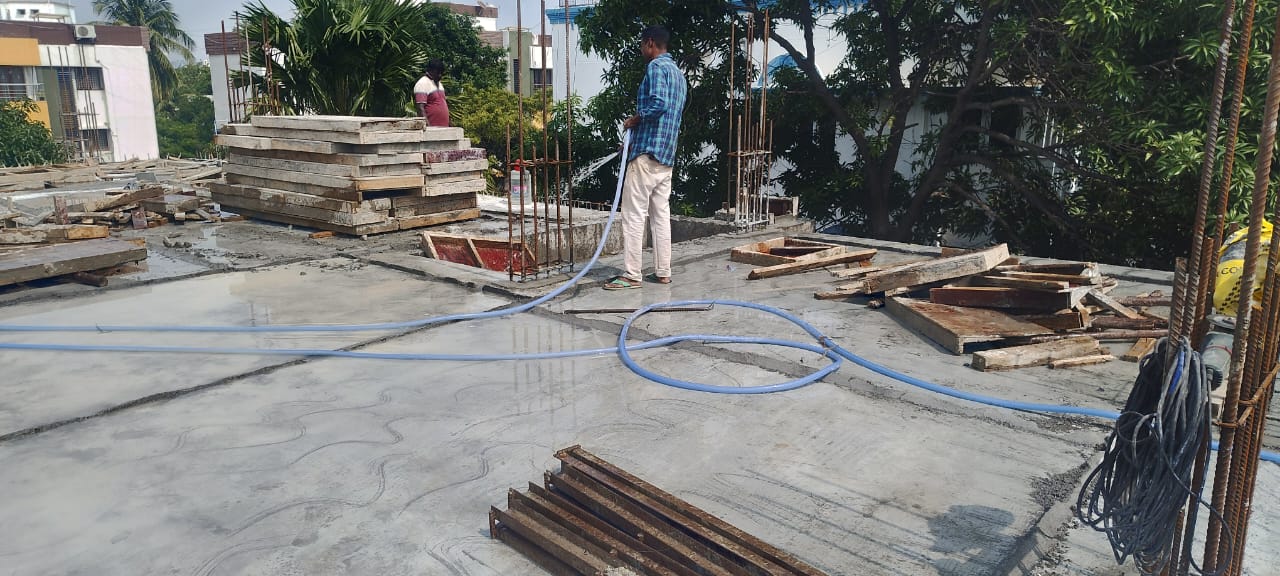

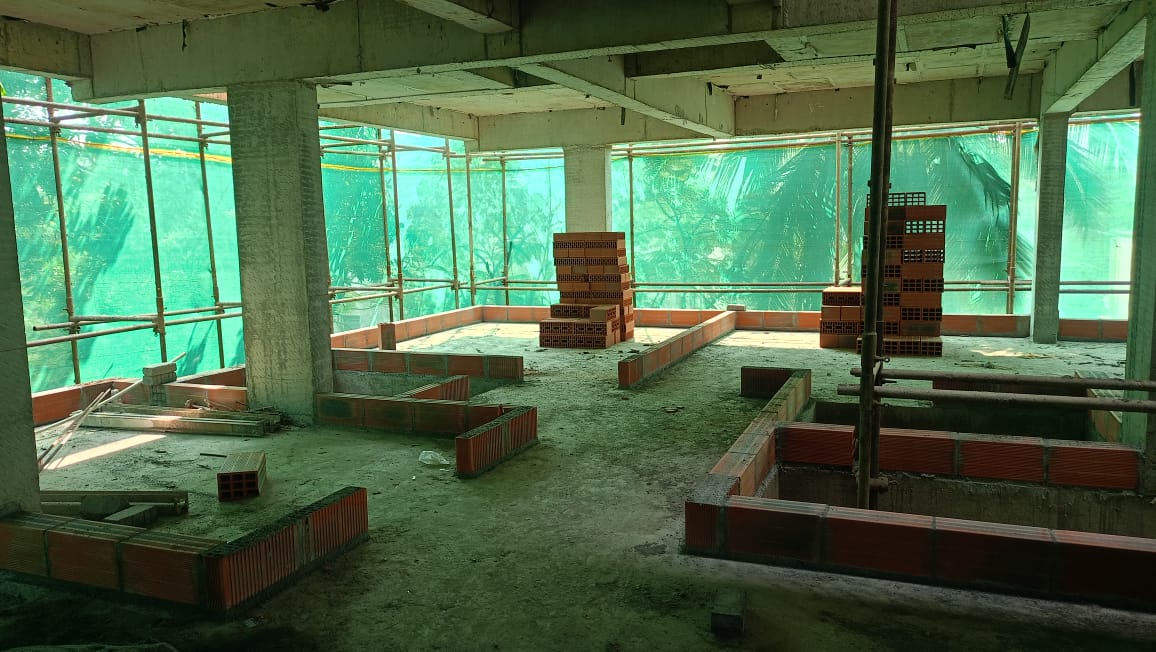

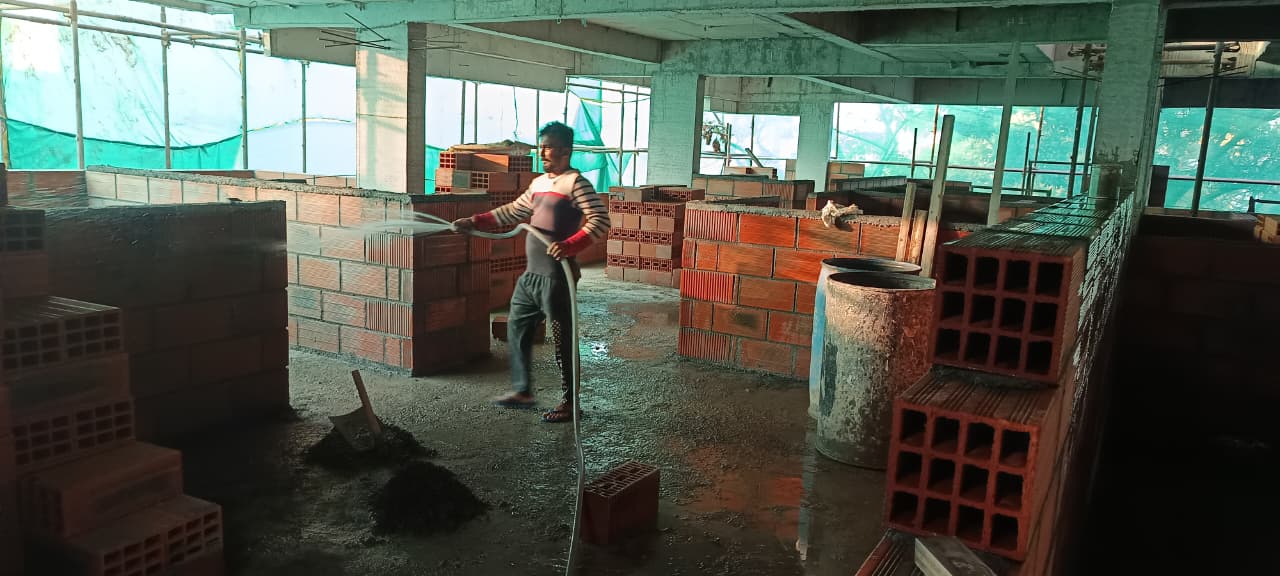

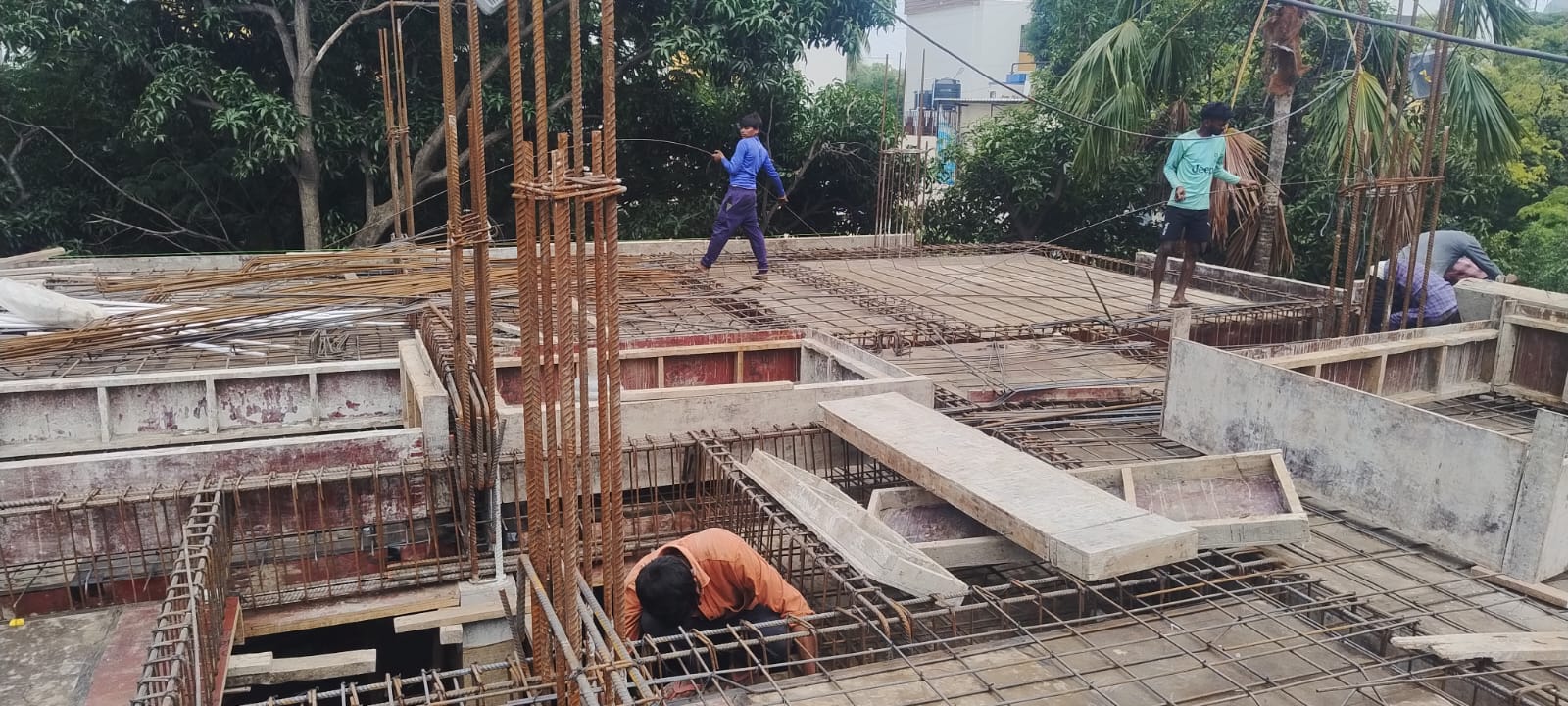

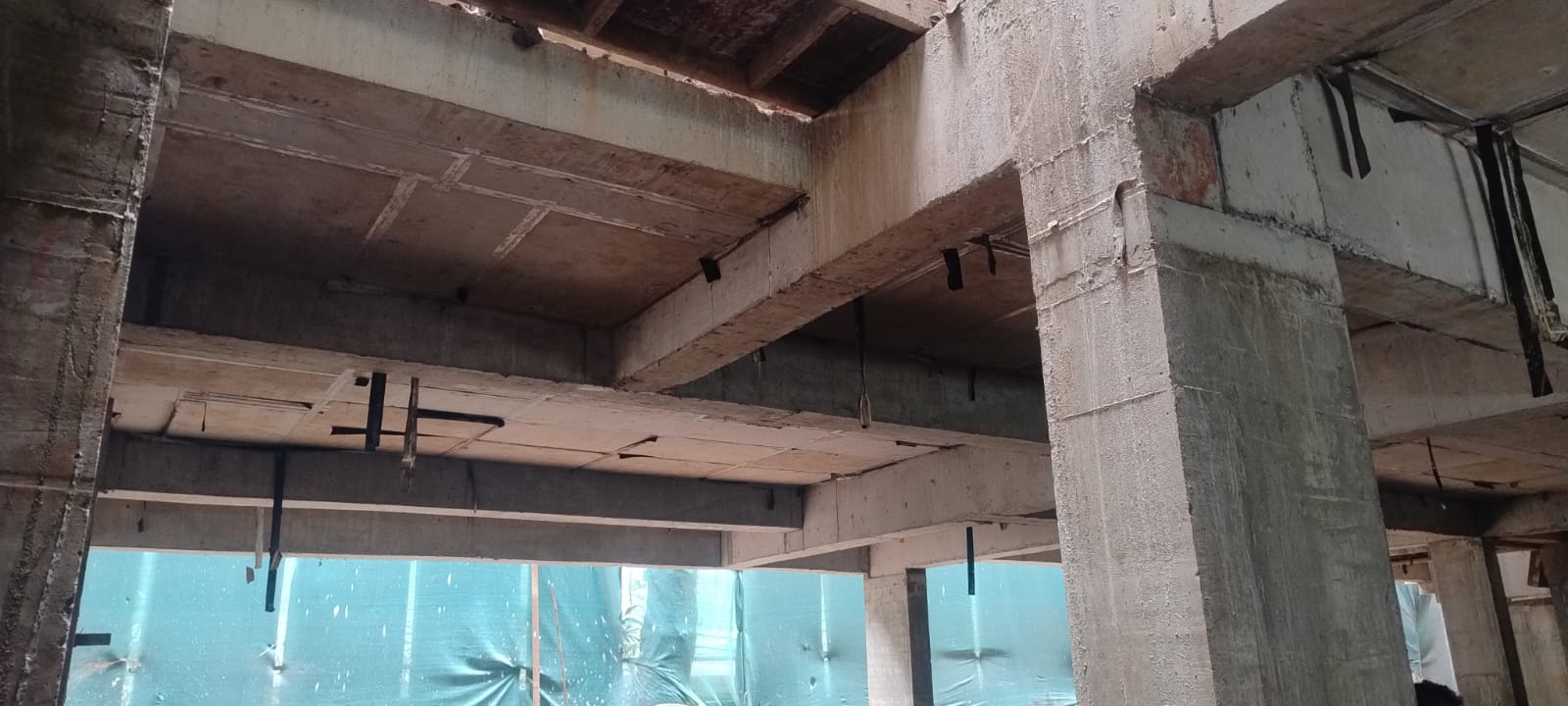

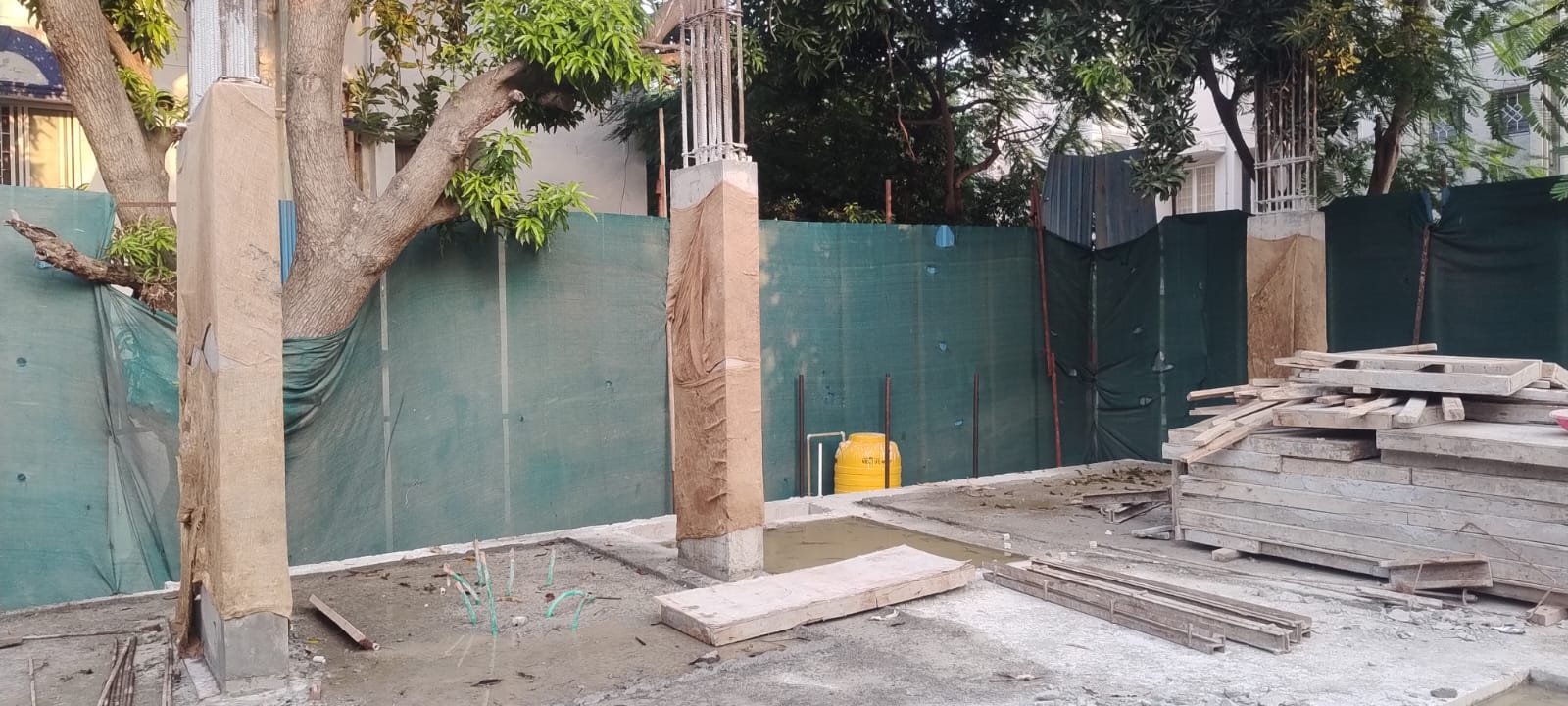

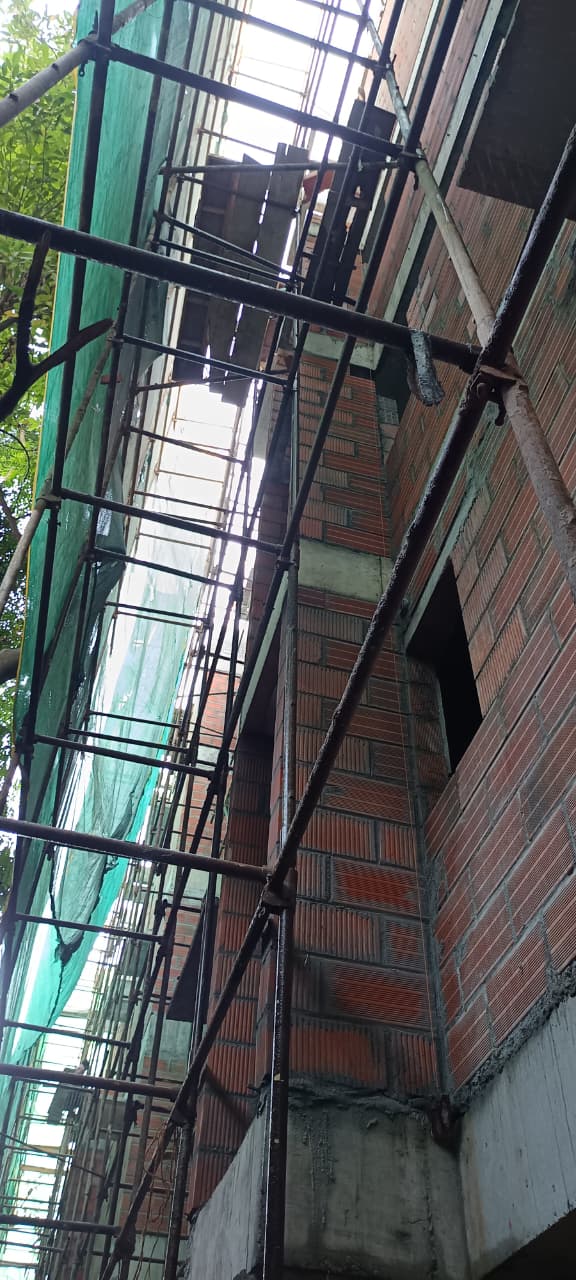

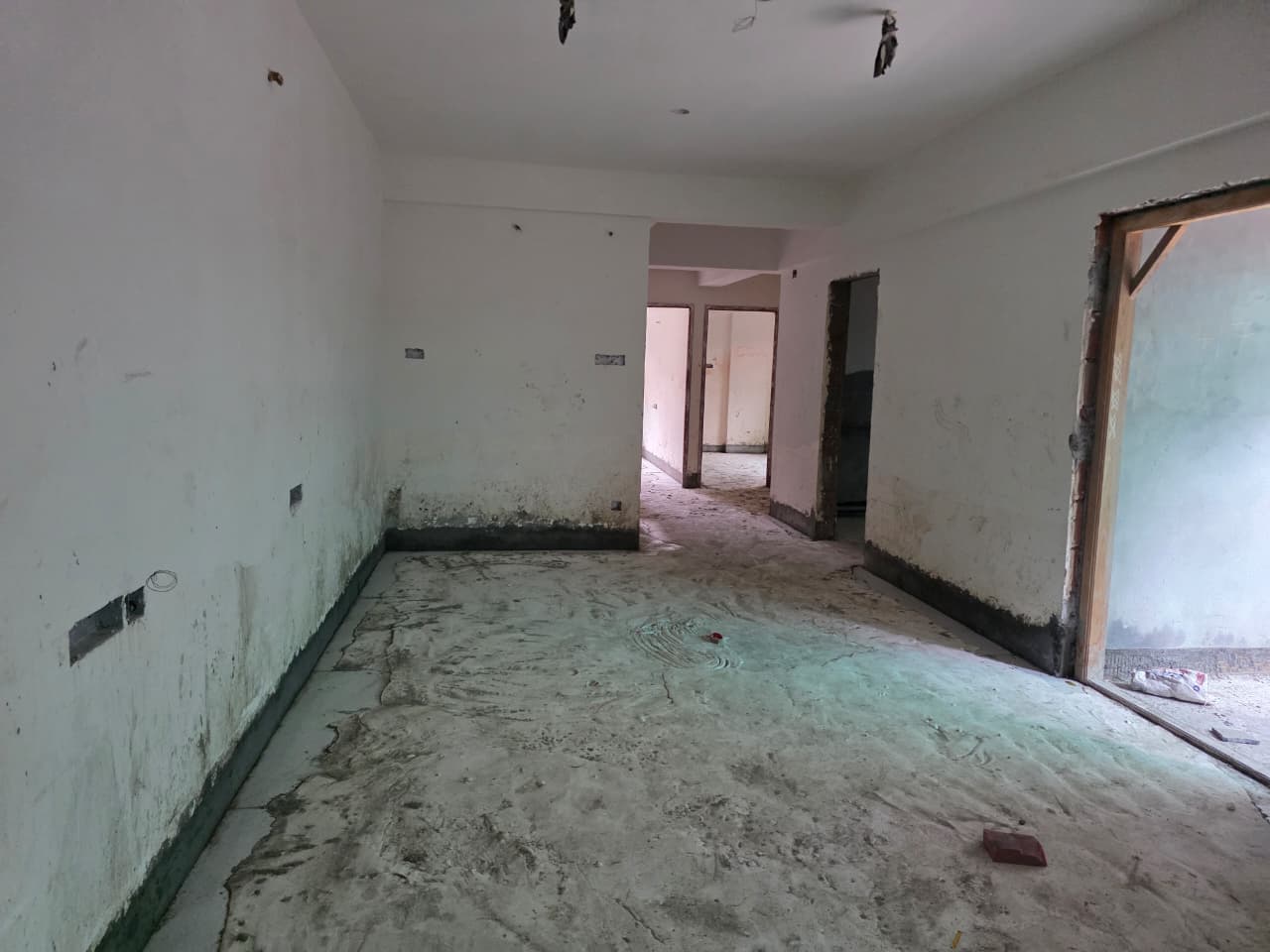

  • Up to 4th floor plastering work is in progress.
  • 5th floor plastering work is in progress.(60% completed)

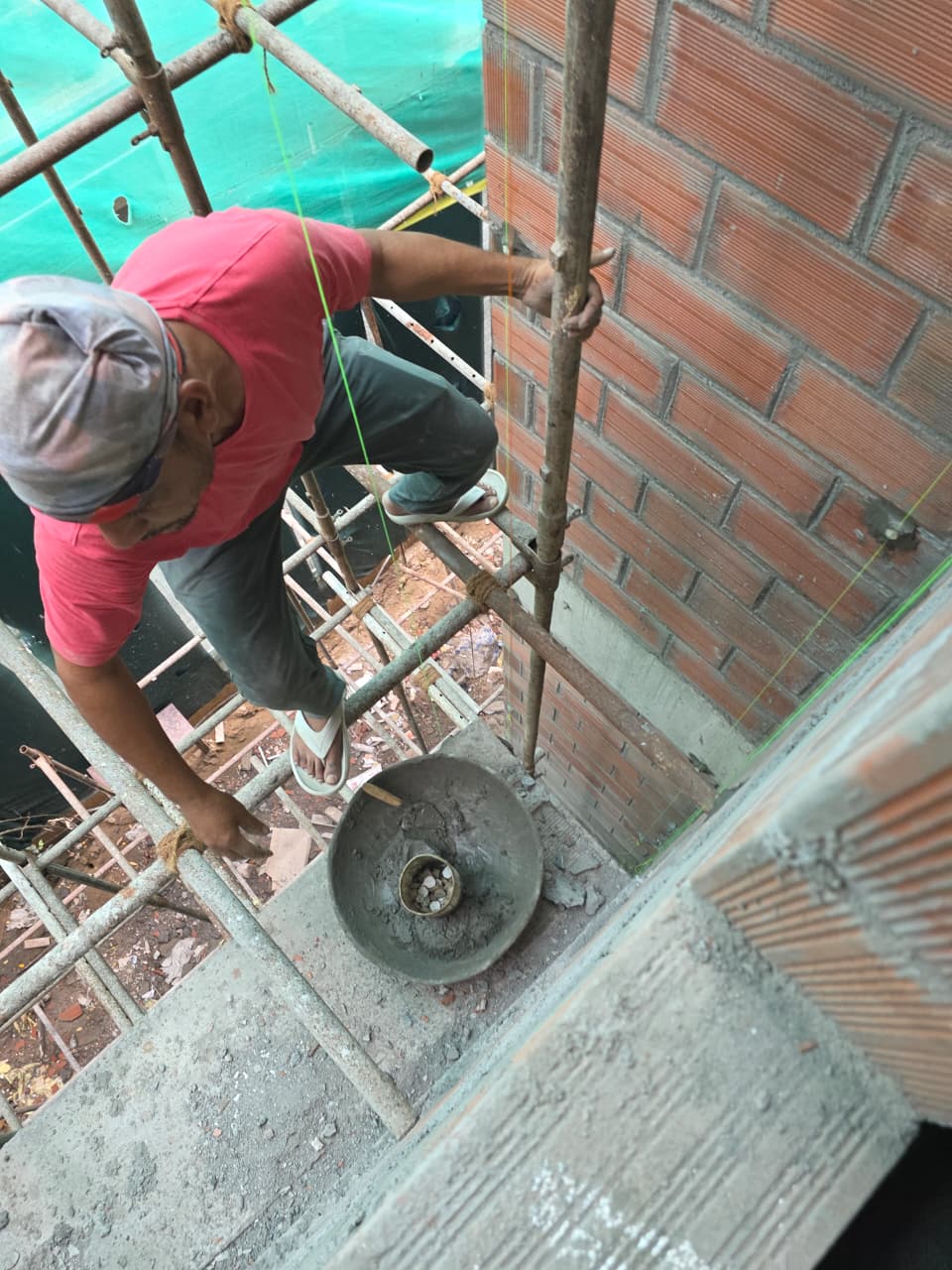

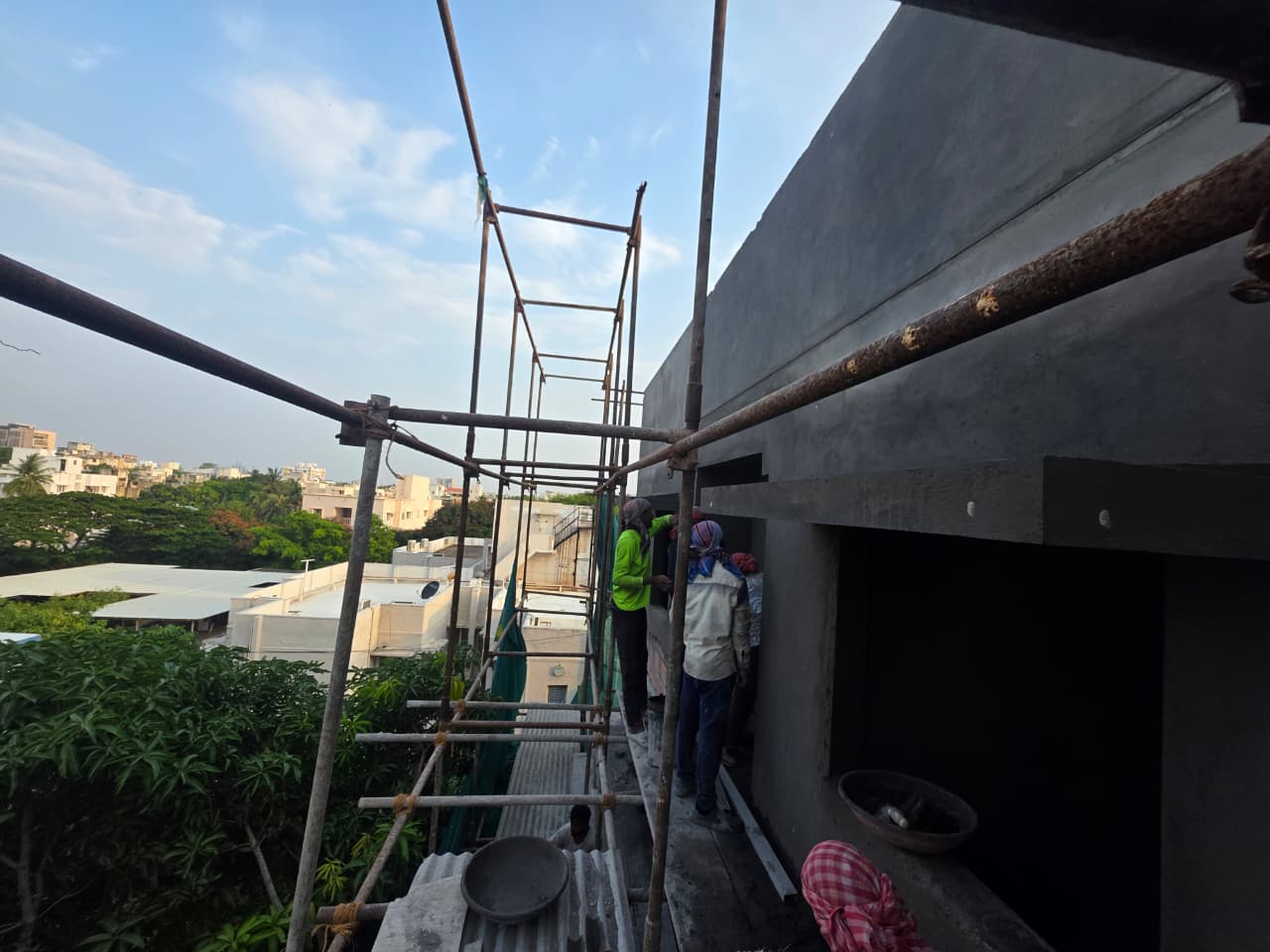

  • All floors staircase wall plastering work is in progress.(60% completed)
  • Inner putty work is in progress.(1st,2nd & 3rd floor progress)

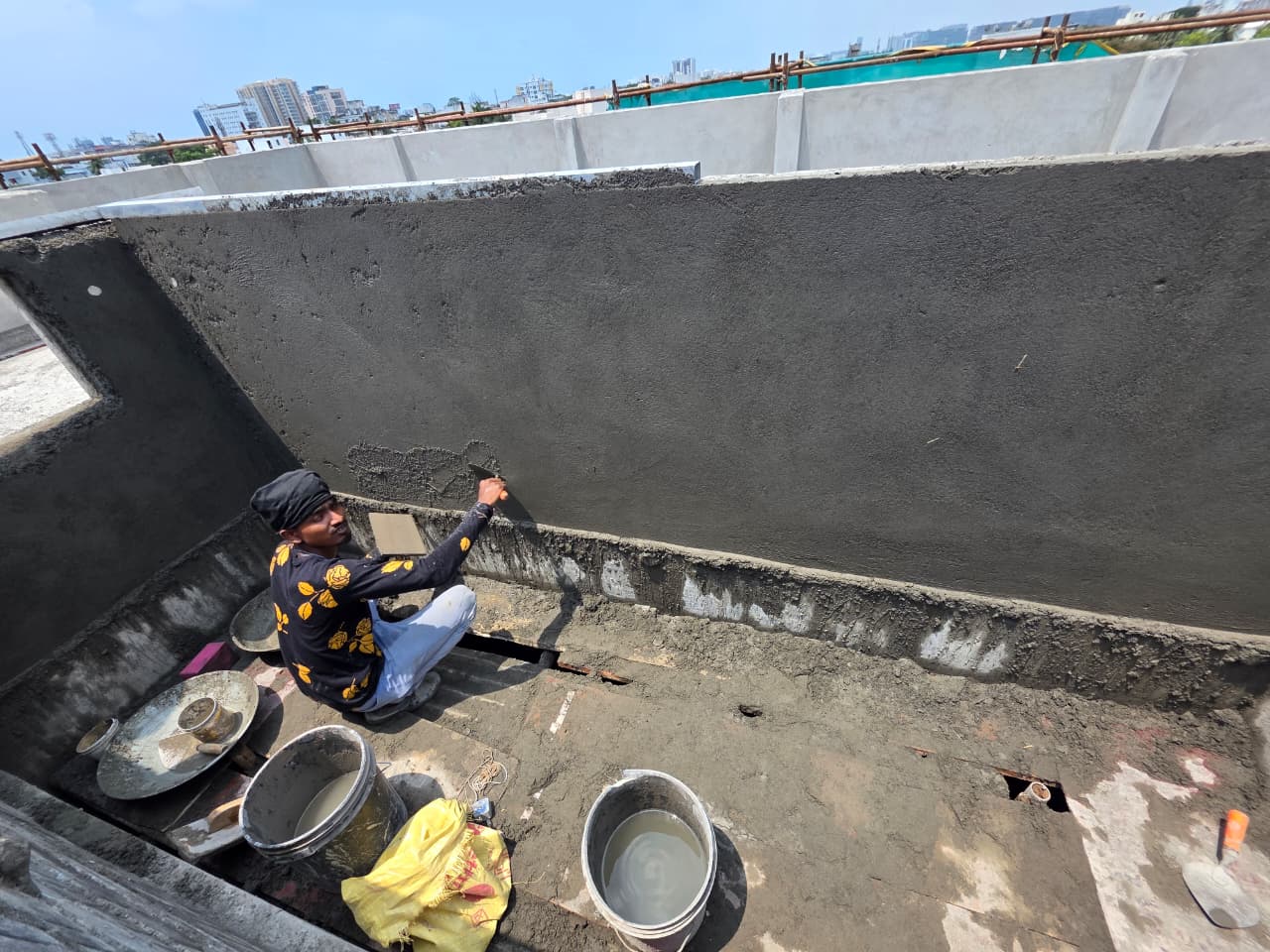

  • External plastering work is in progress.(60% completed)
  • Toilet plumbing work is in progress.(up to 3rd floor completed, 4th & 5thfloor progress)

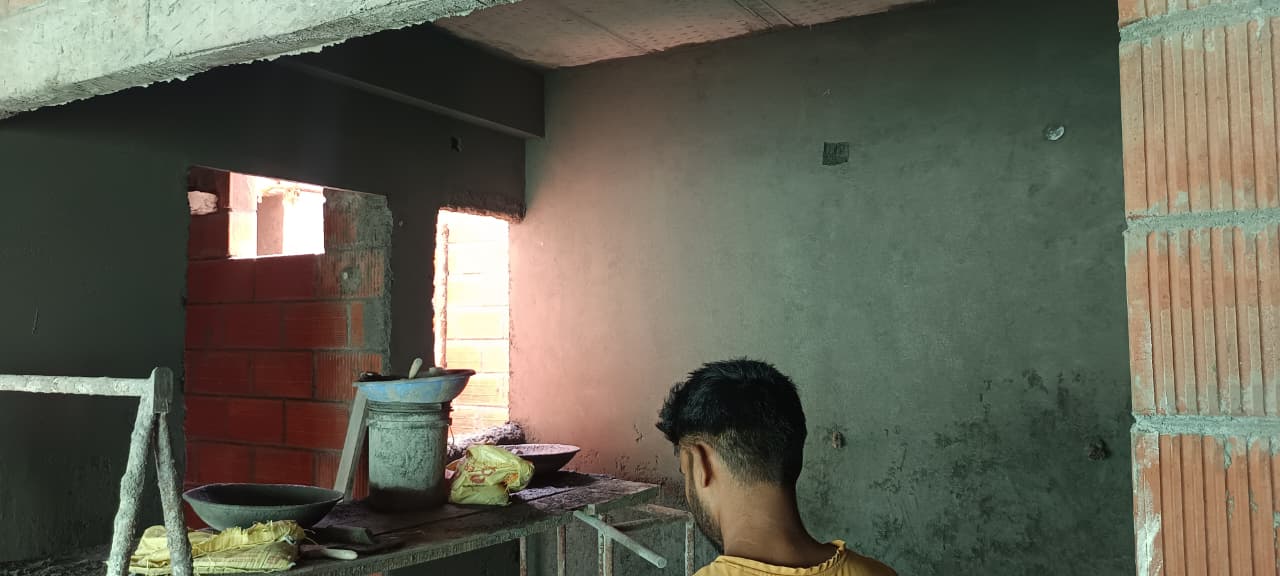

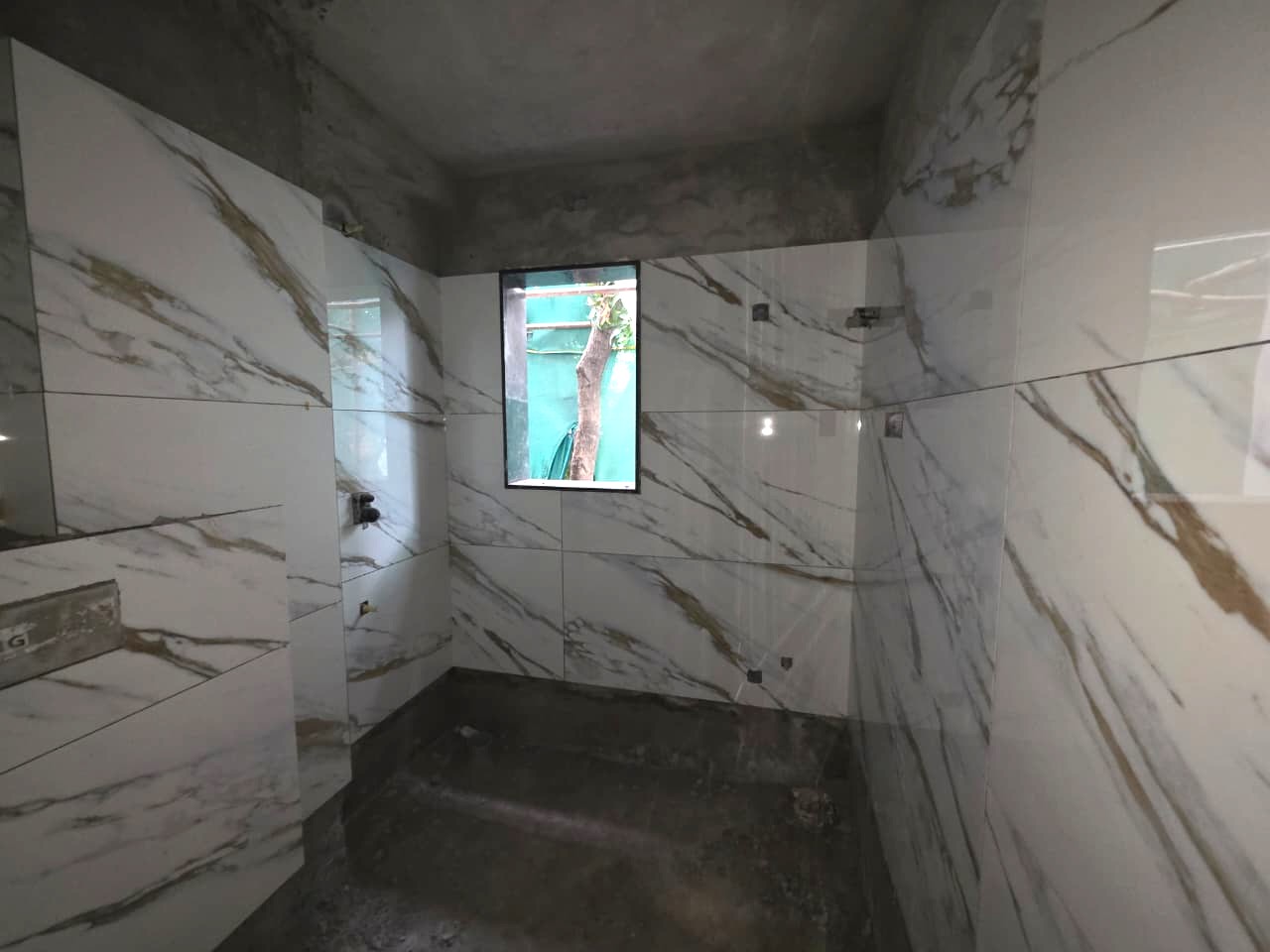

  • Toilet wall tiles work is in progress. (1st & 2nd completed,3rd floor progress)

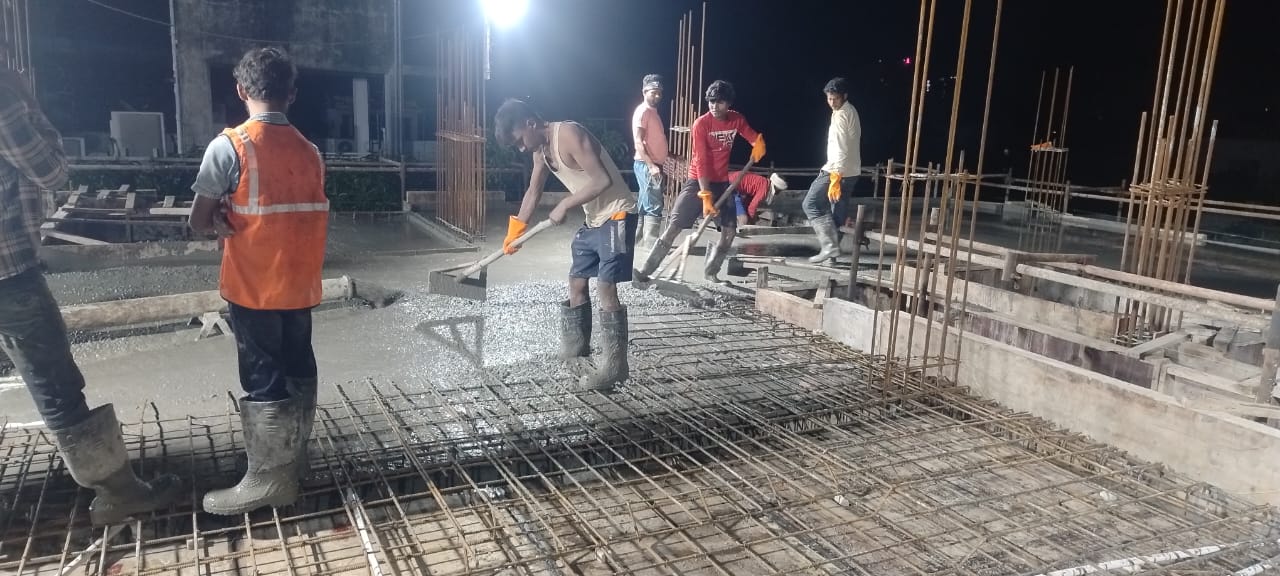

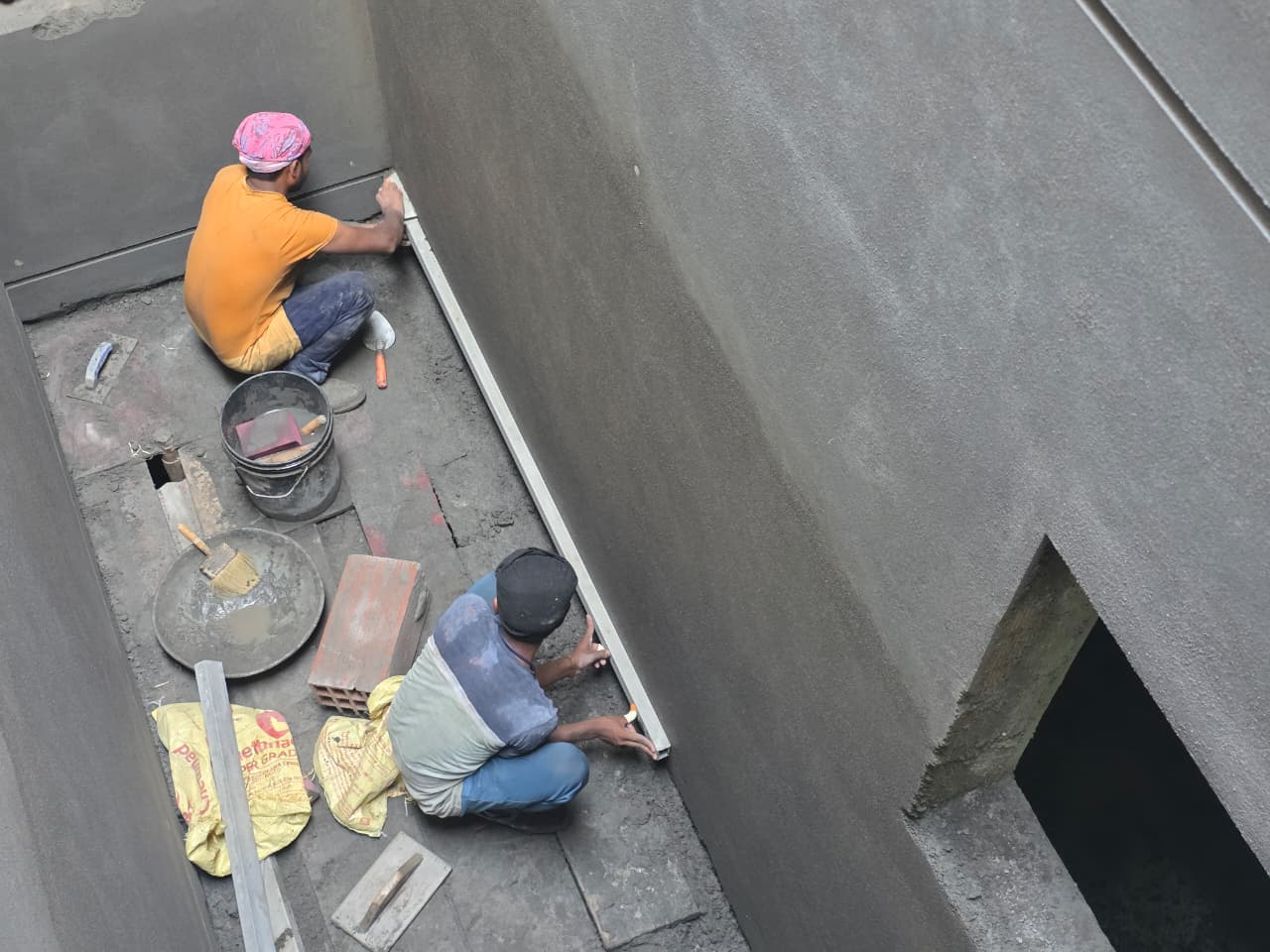

  • General main flooring work is in progress. (3/19) completed.
  • All floor jambs granite work is in progress.

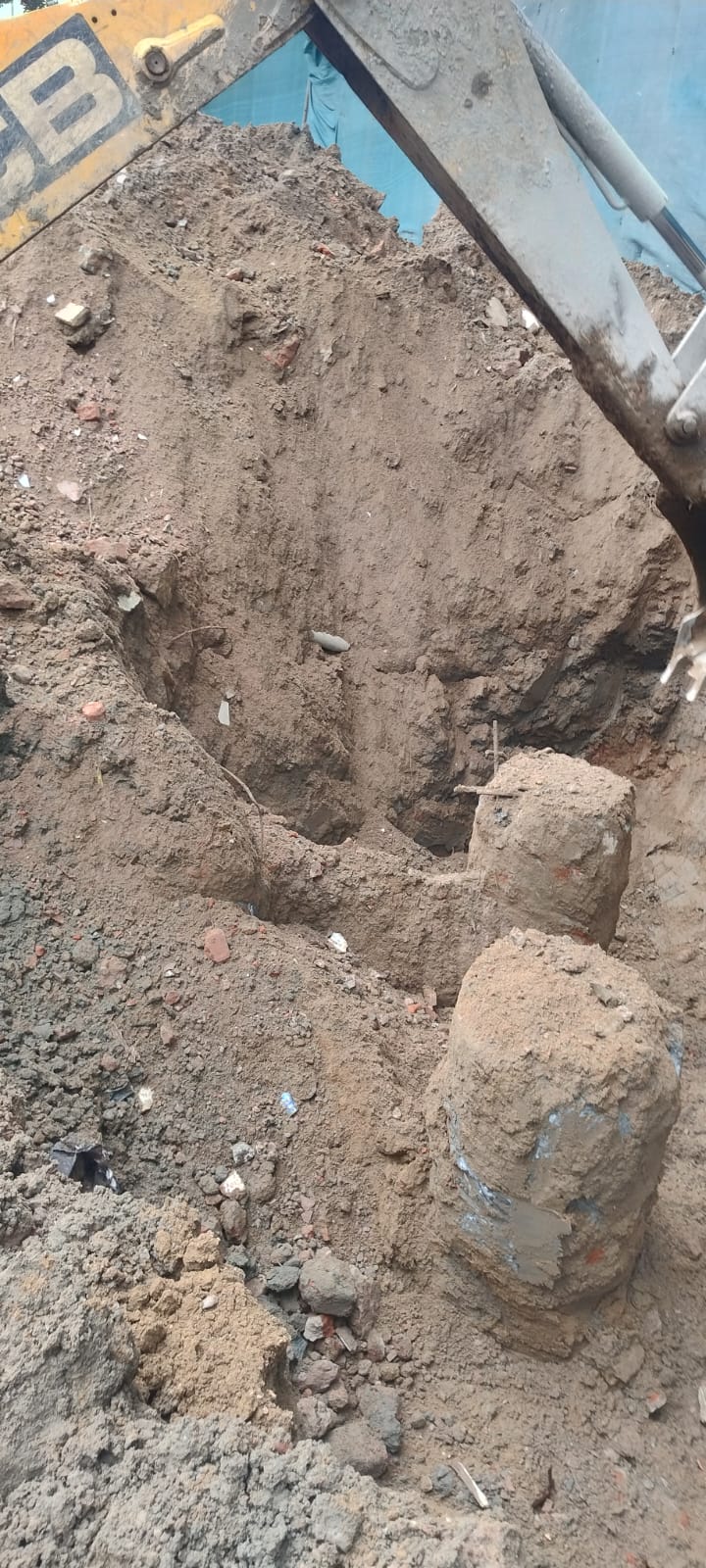

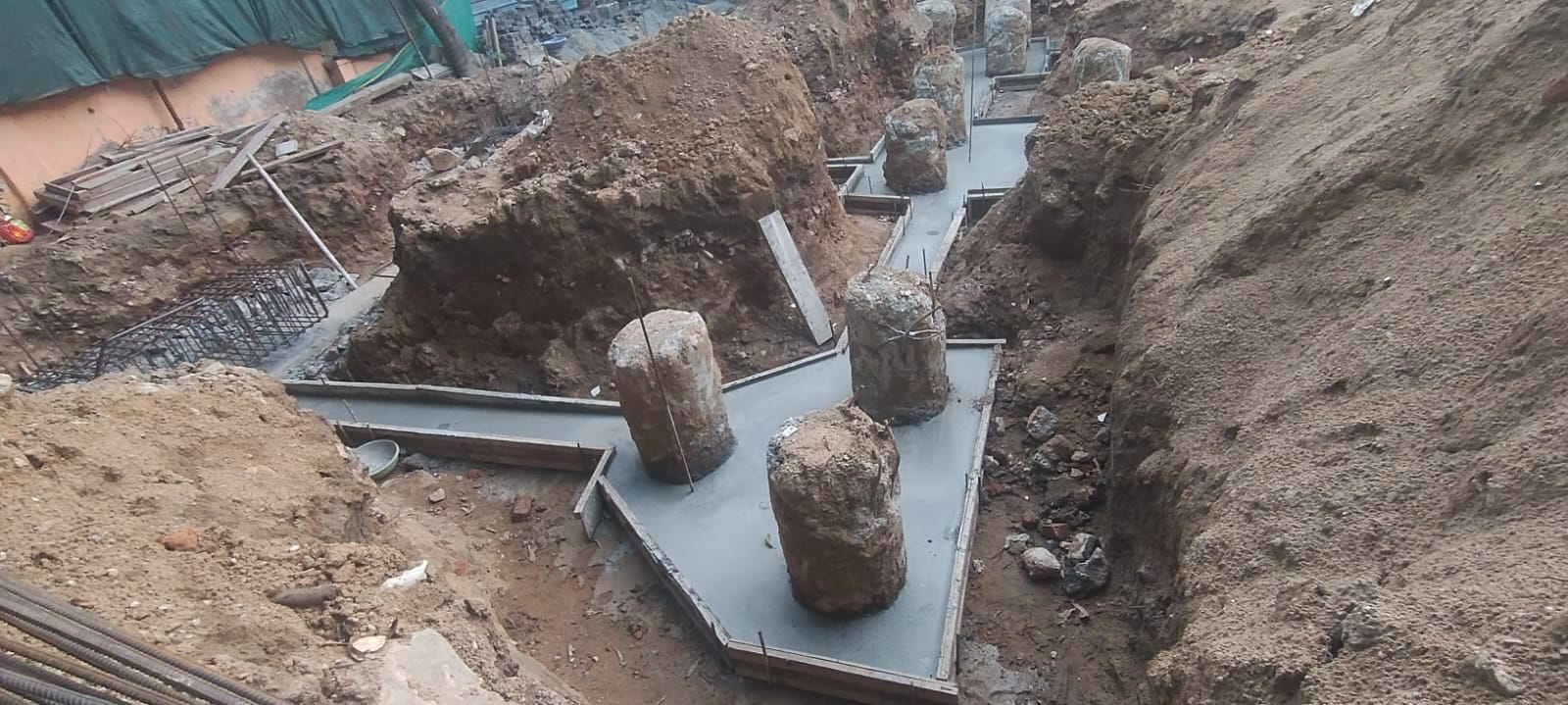

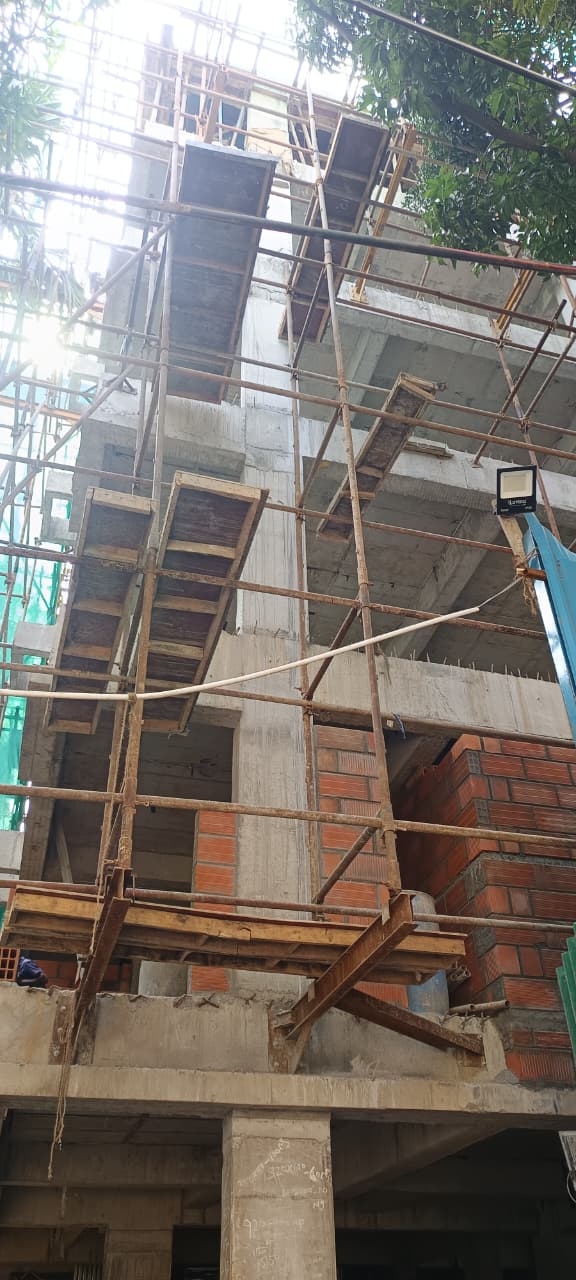

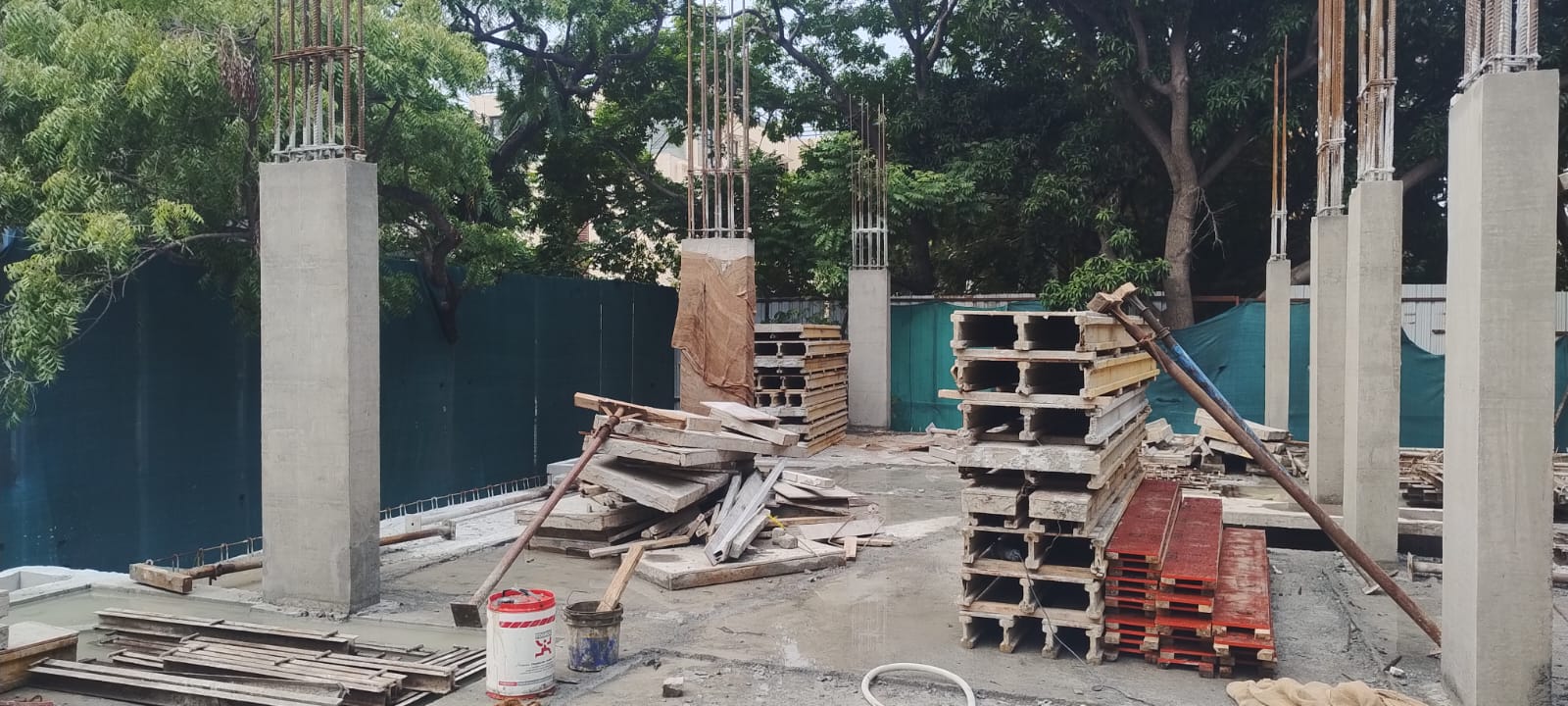

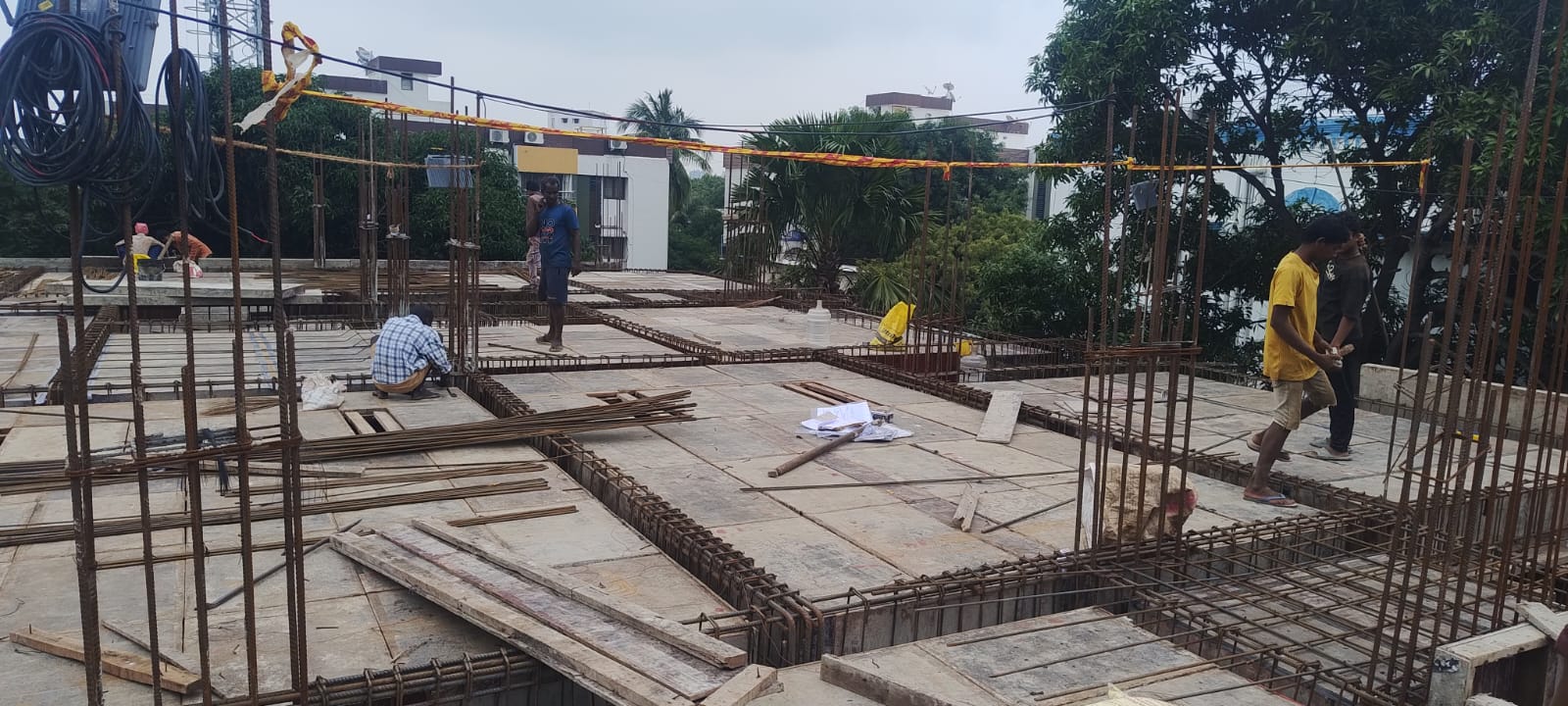

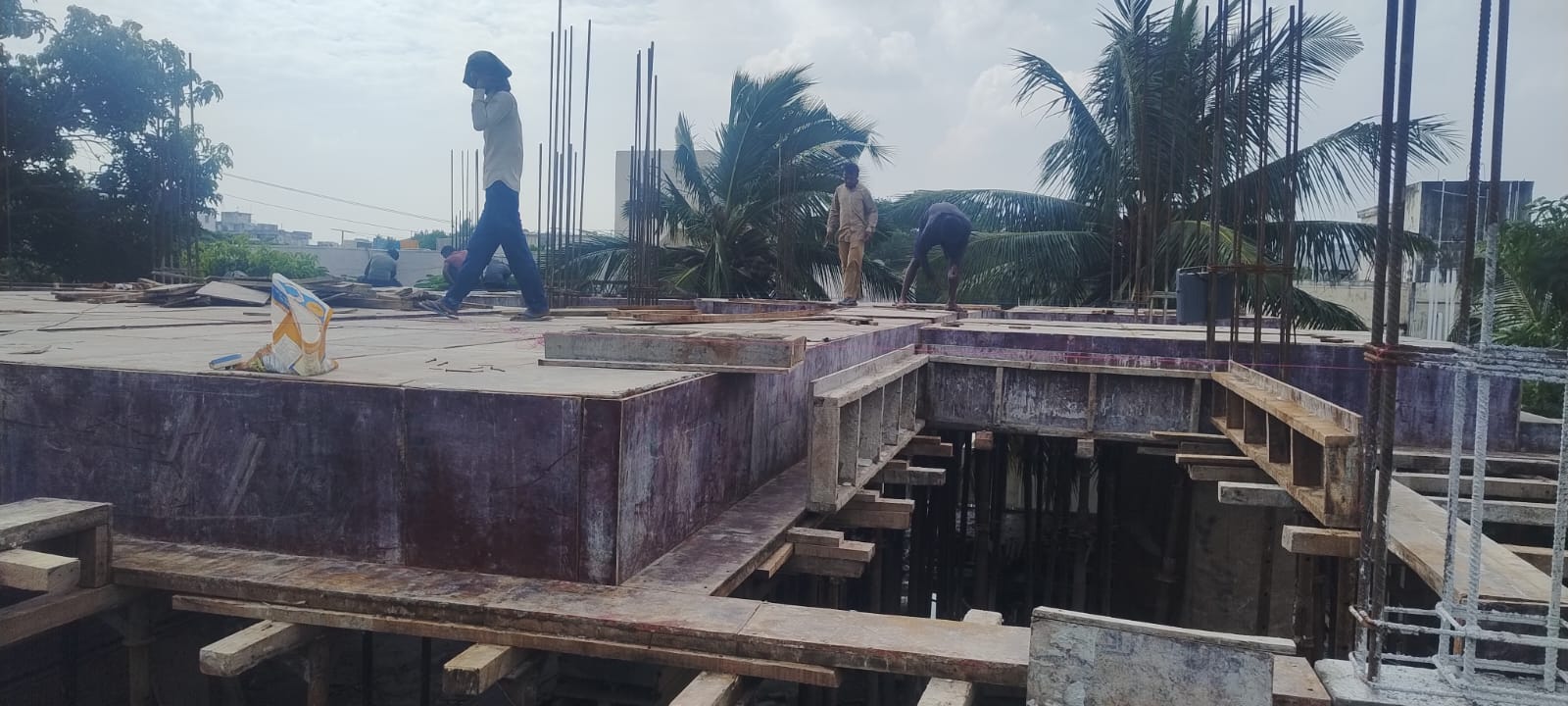

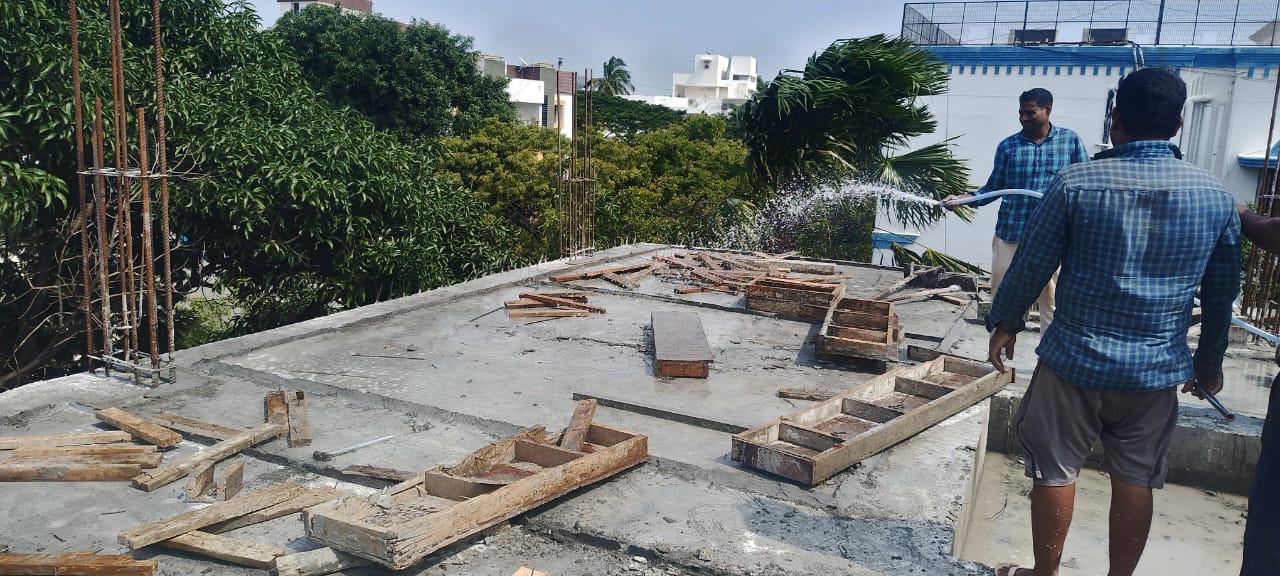

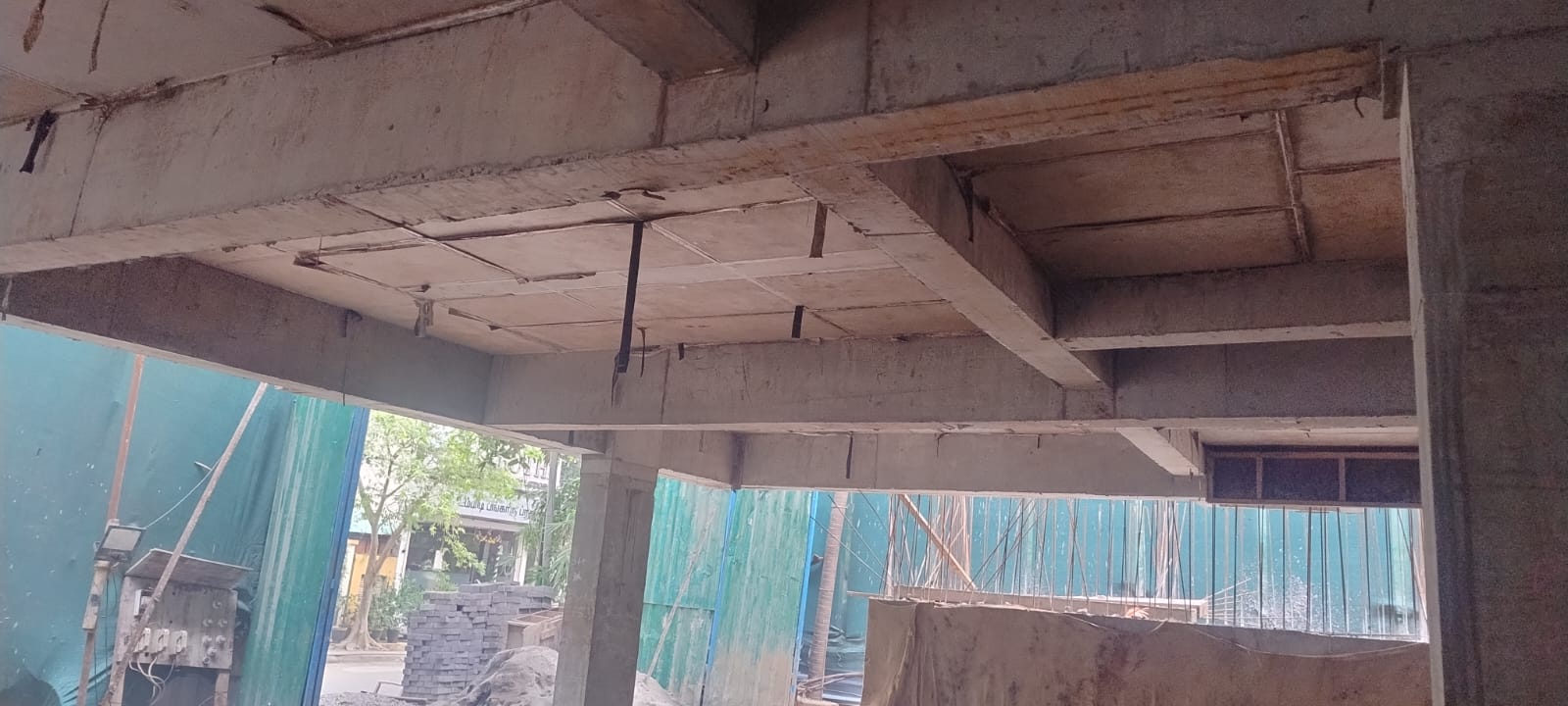

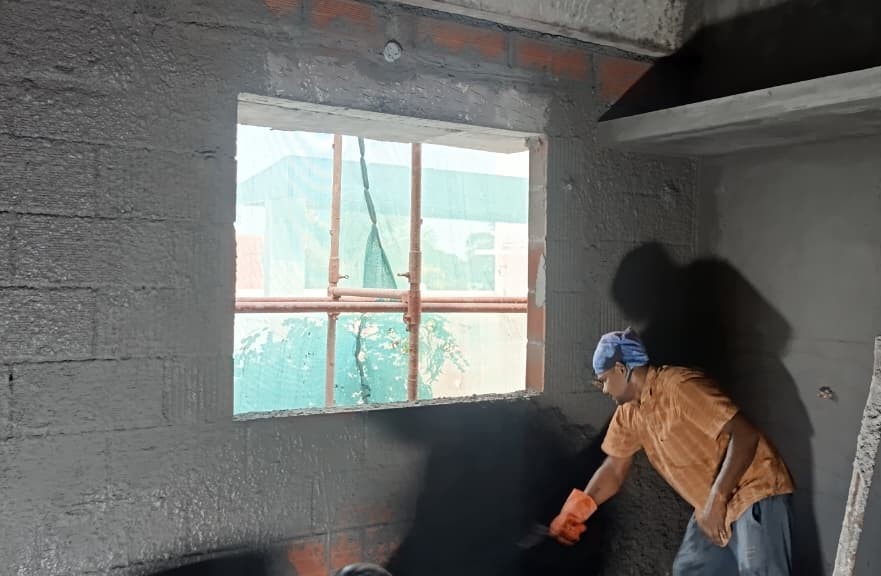

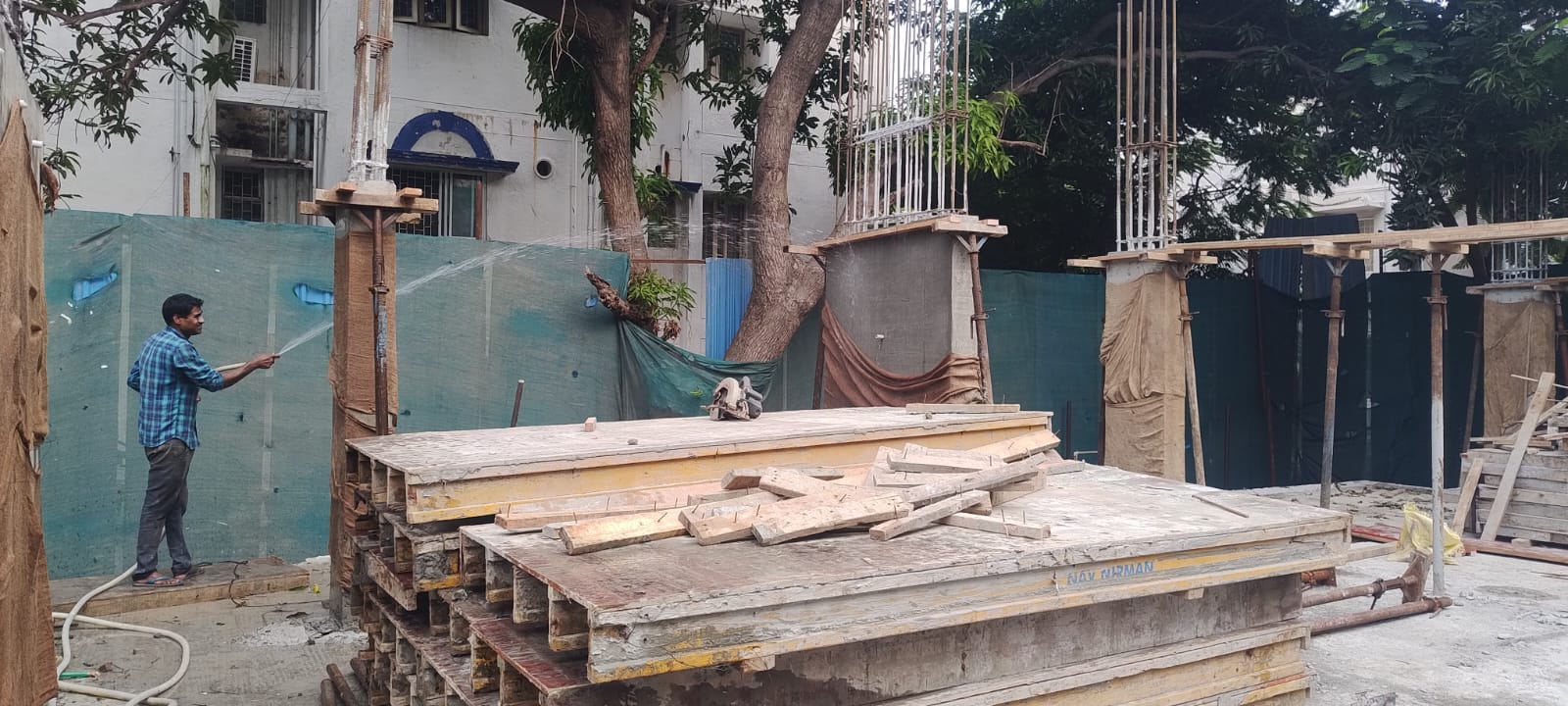

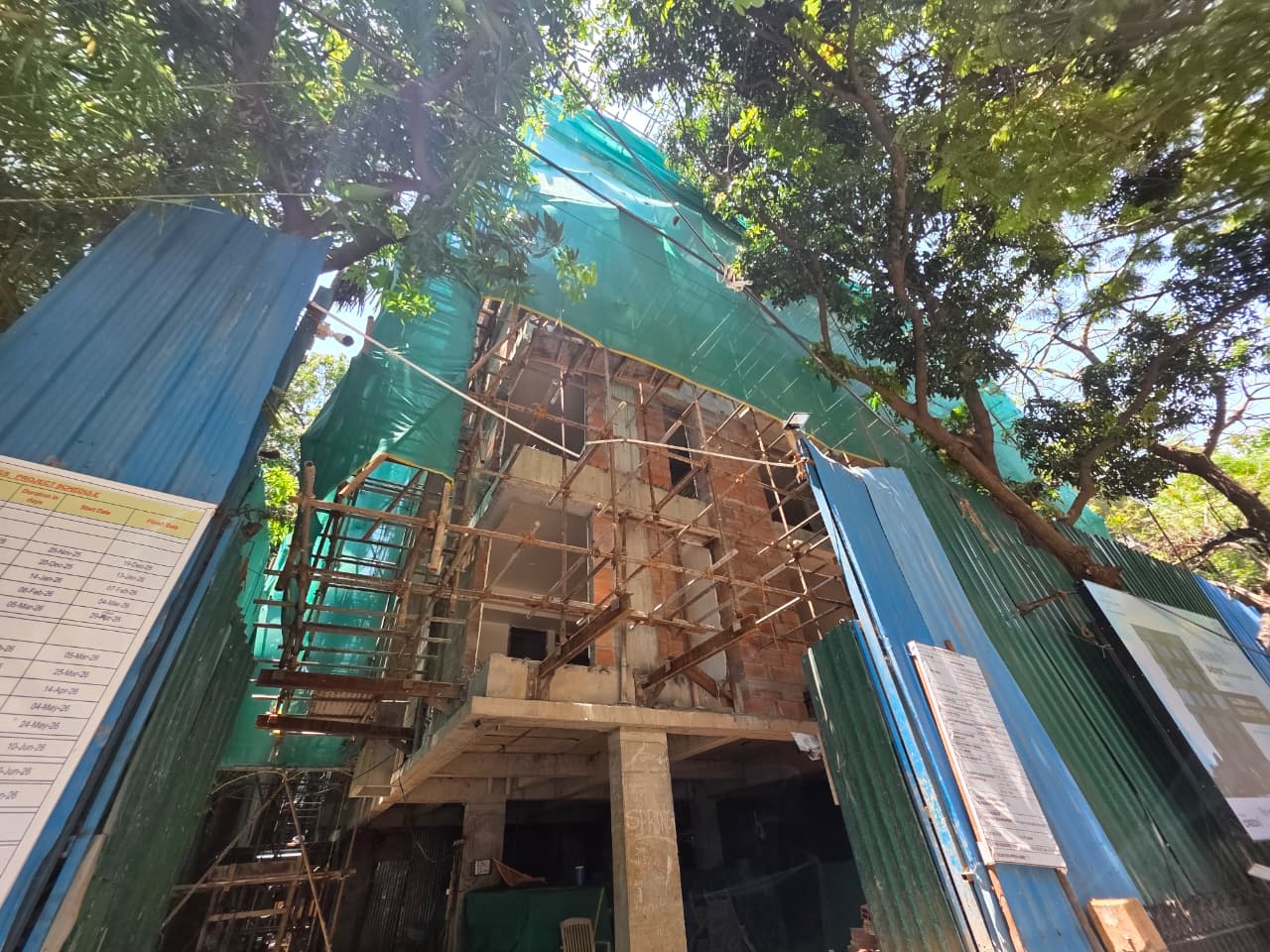

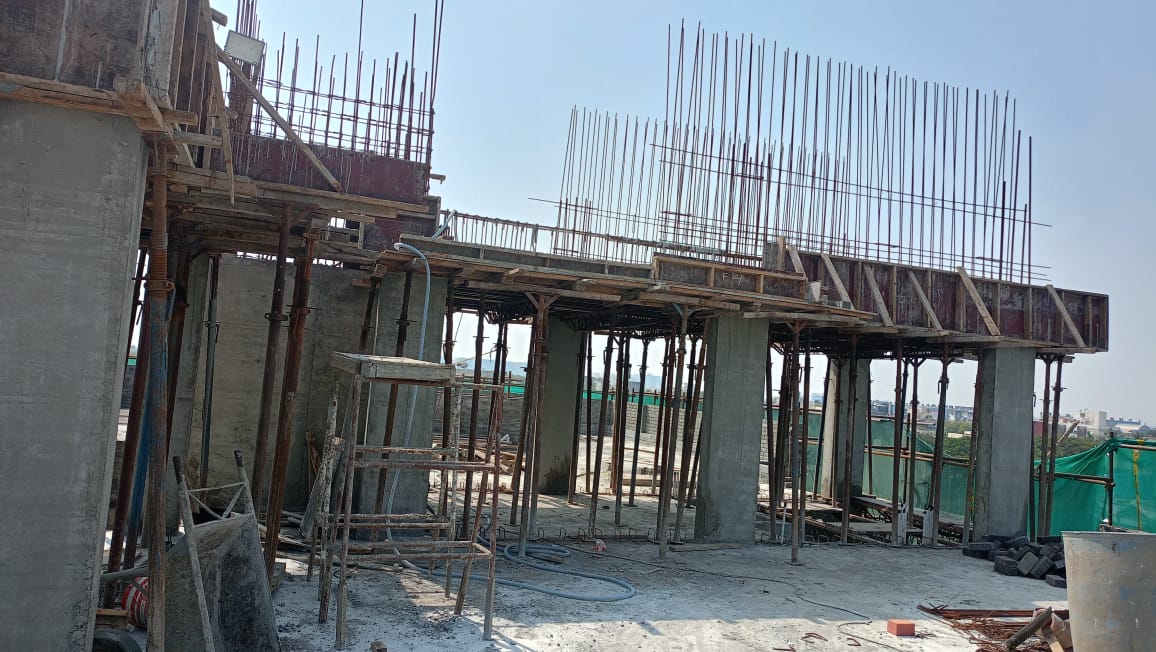

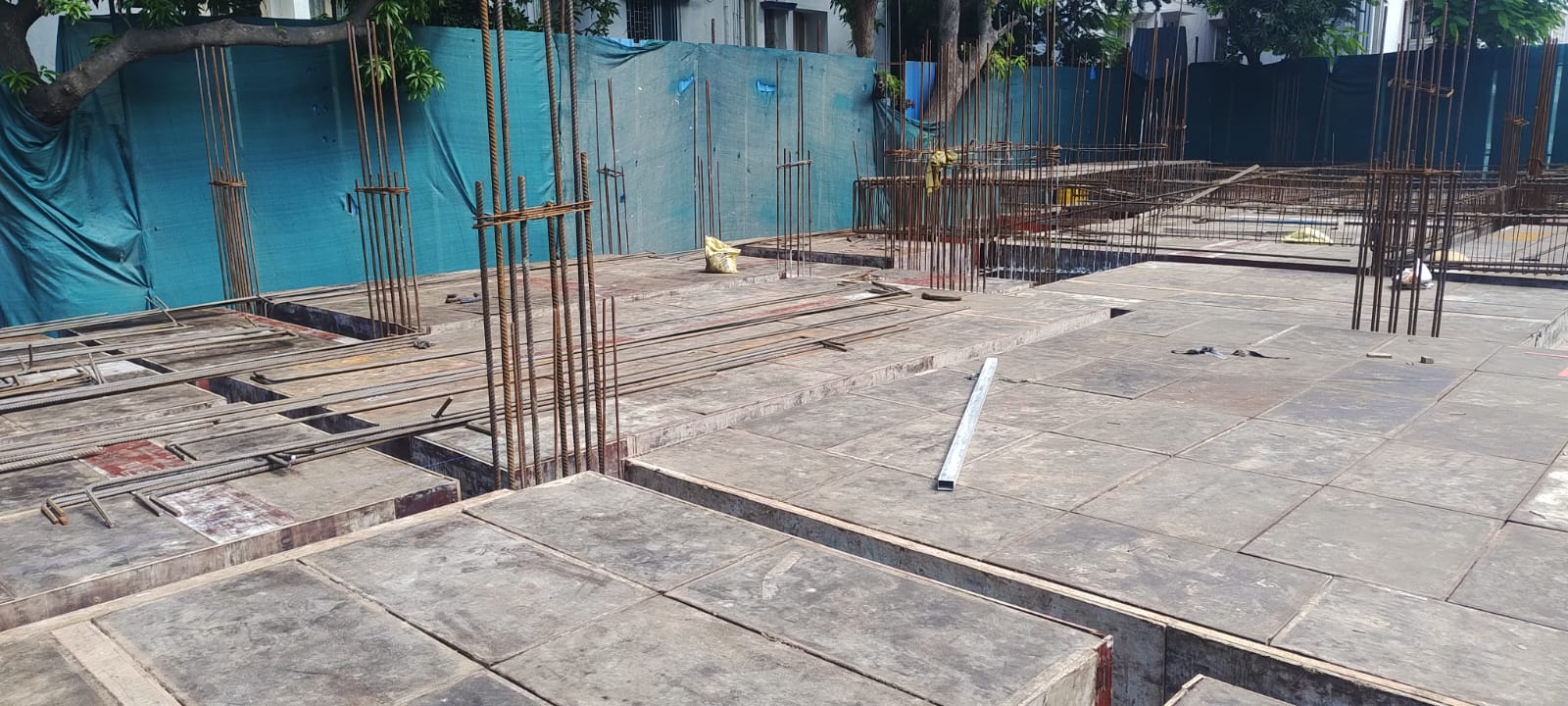

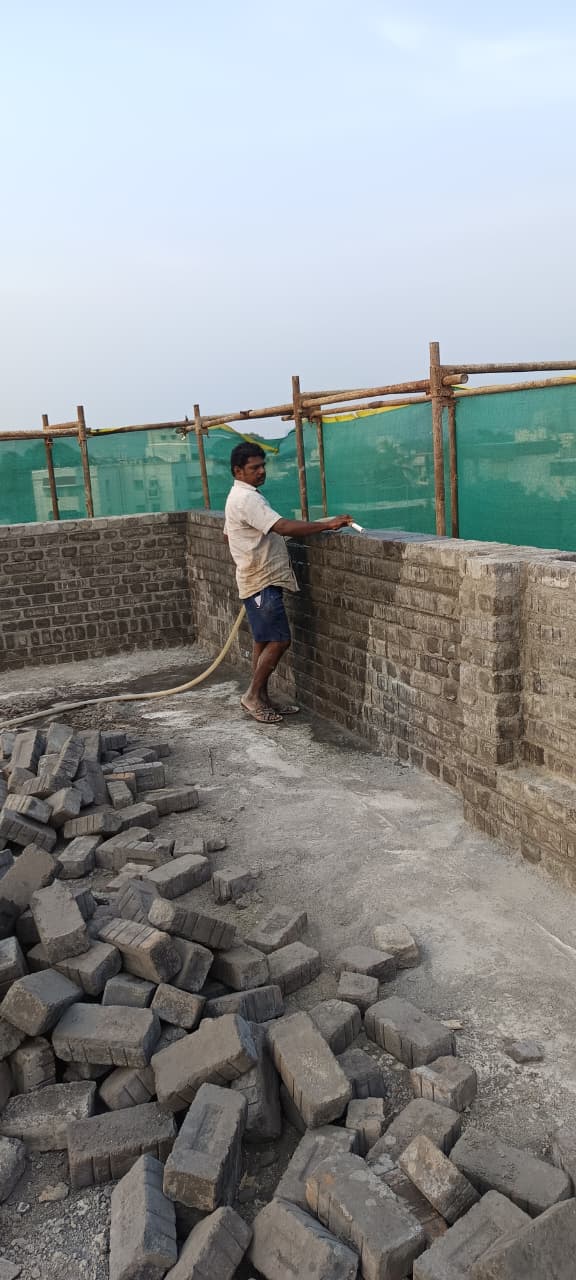

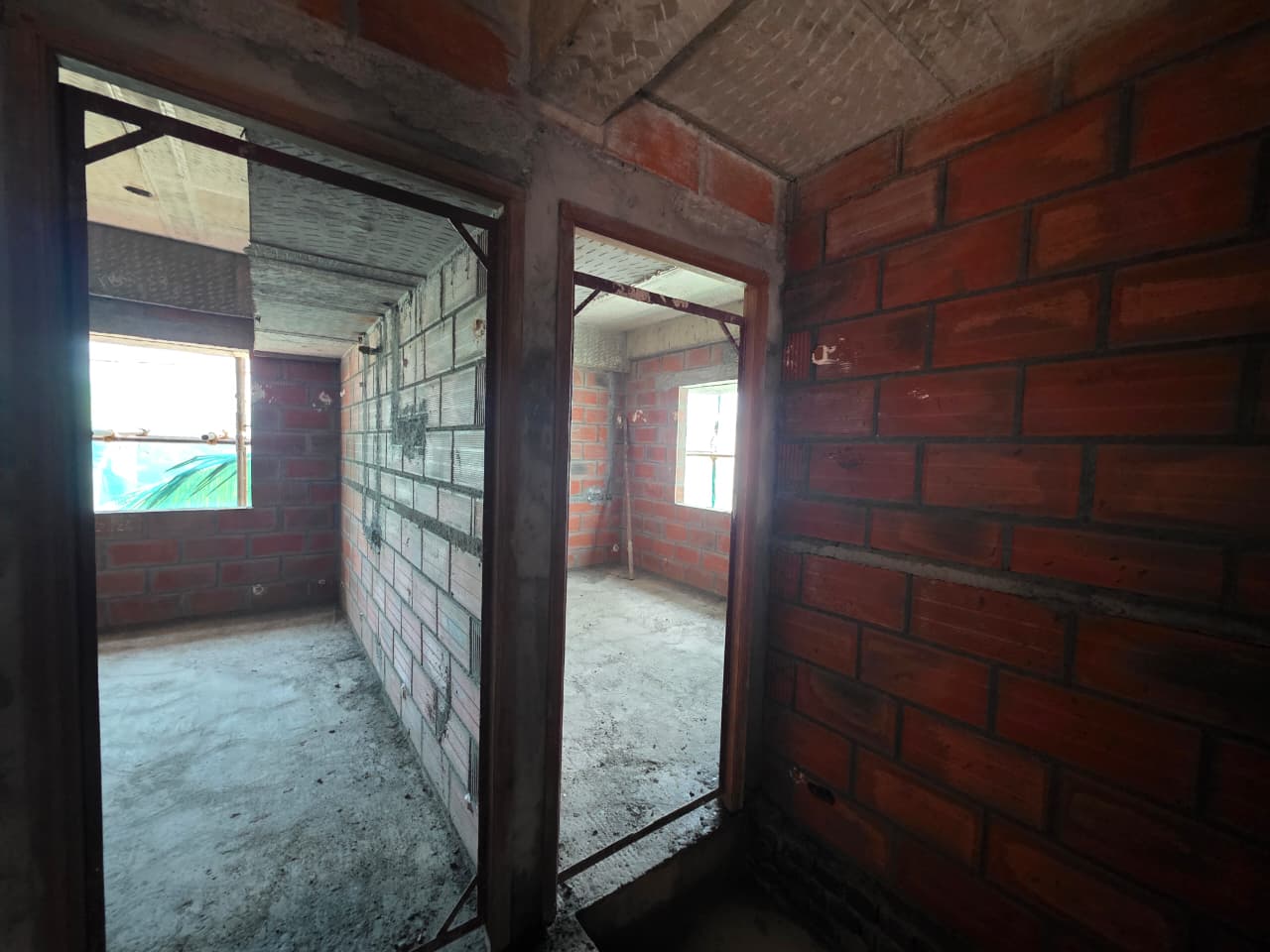

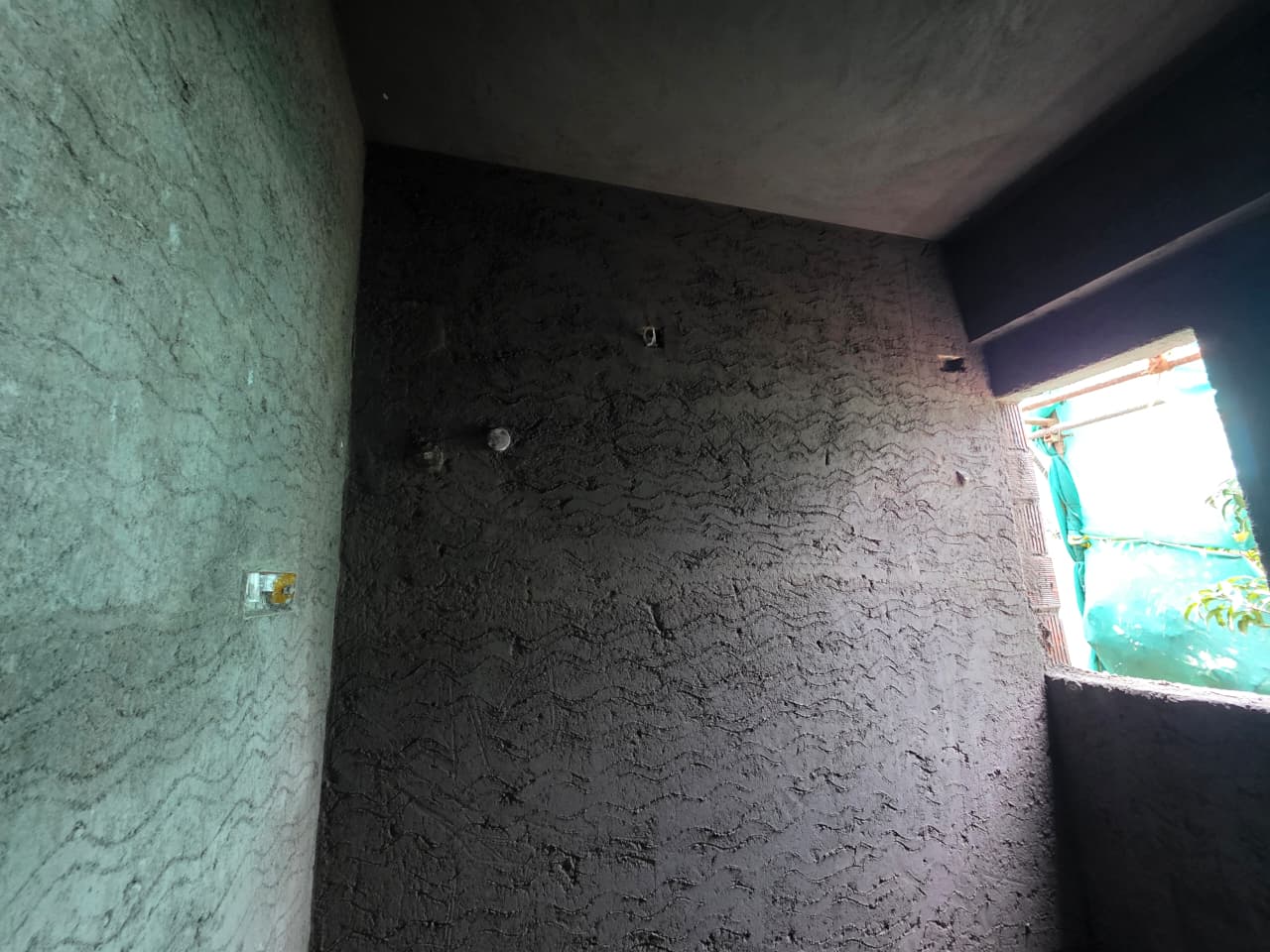

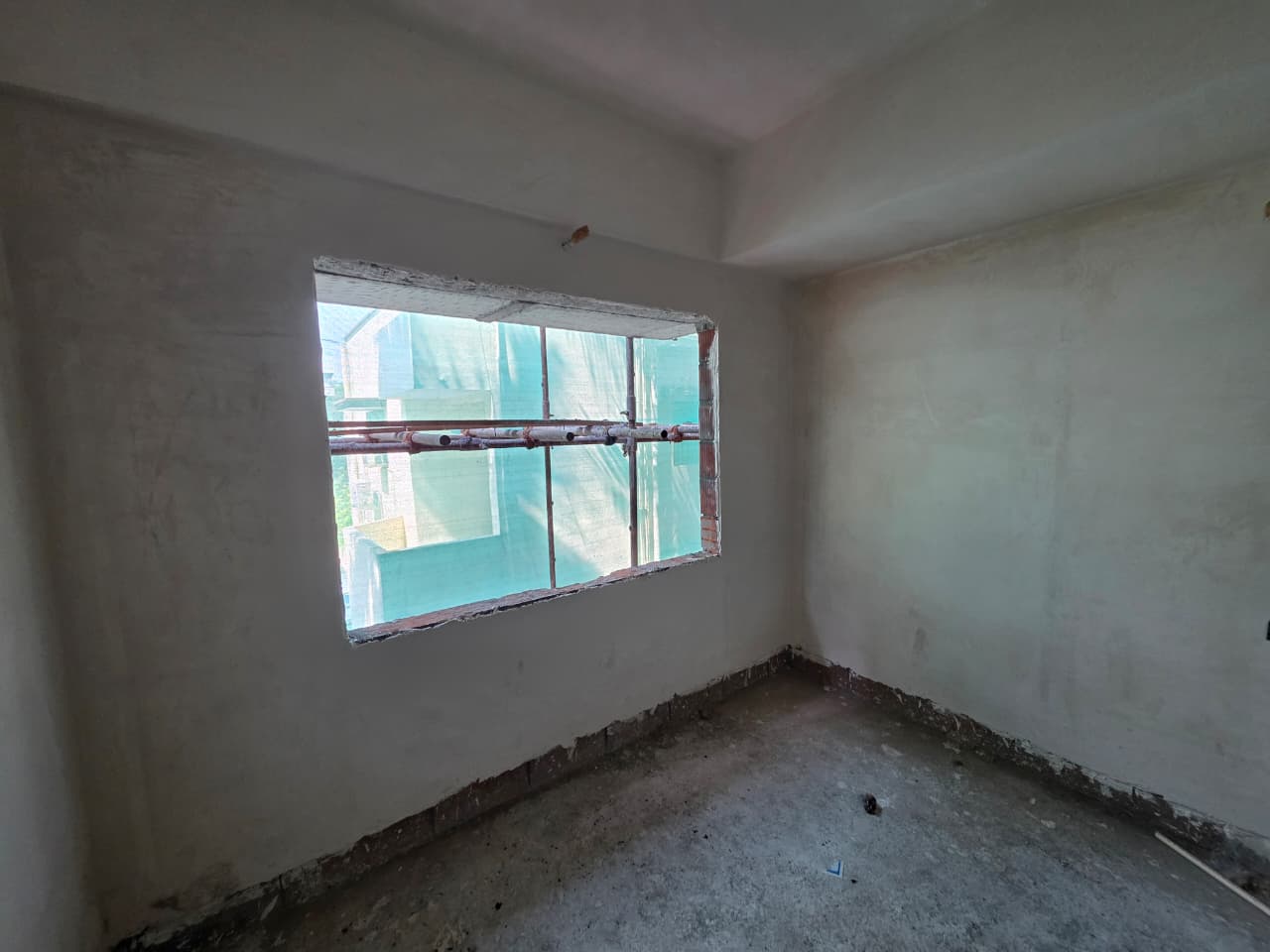

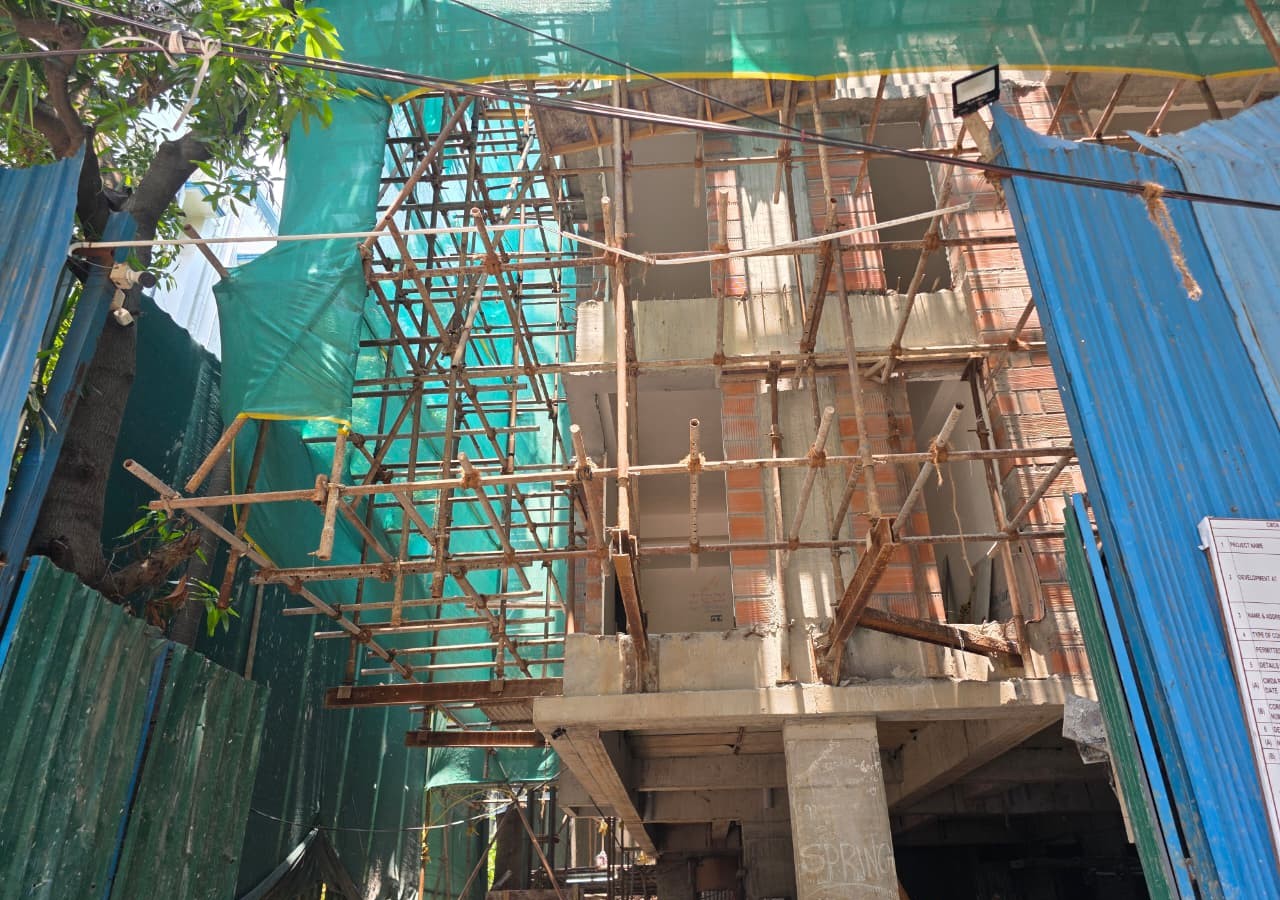

Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image

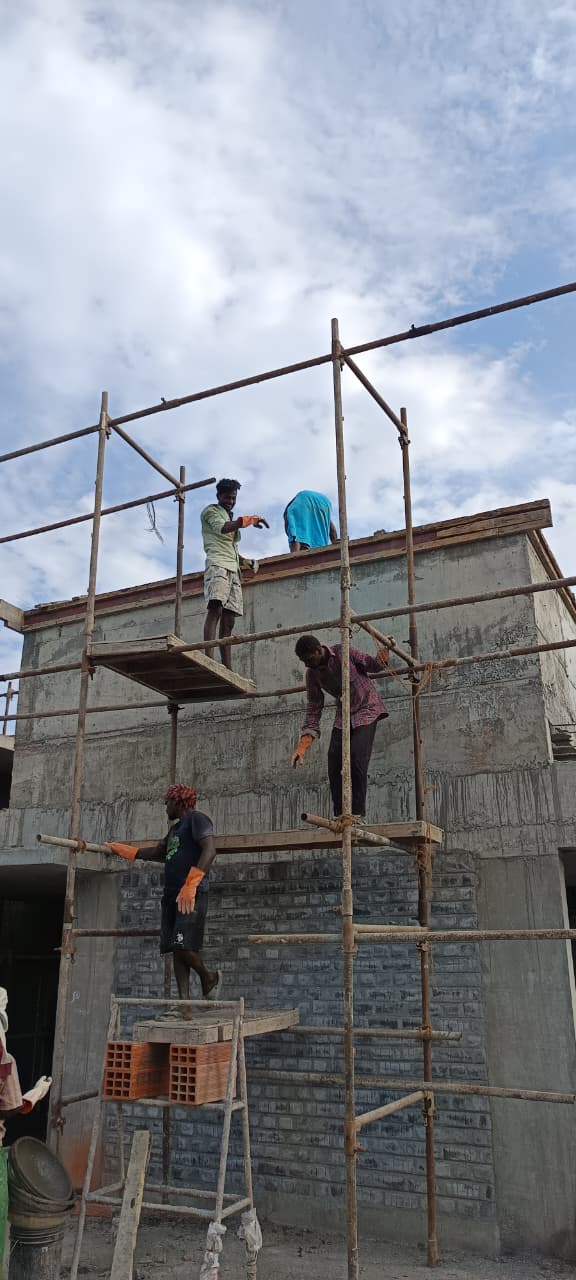

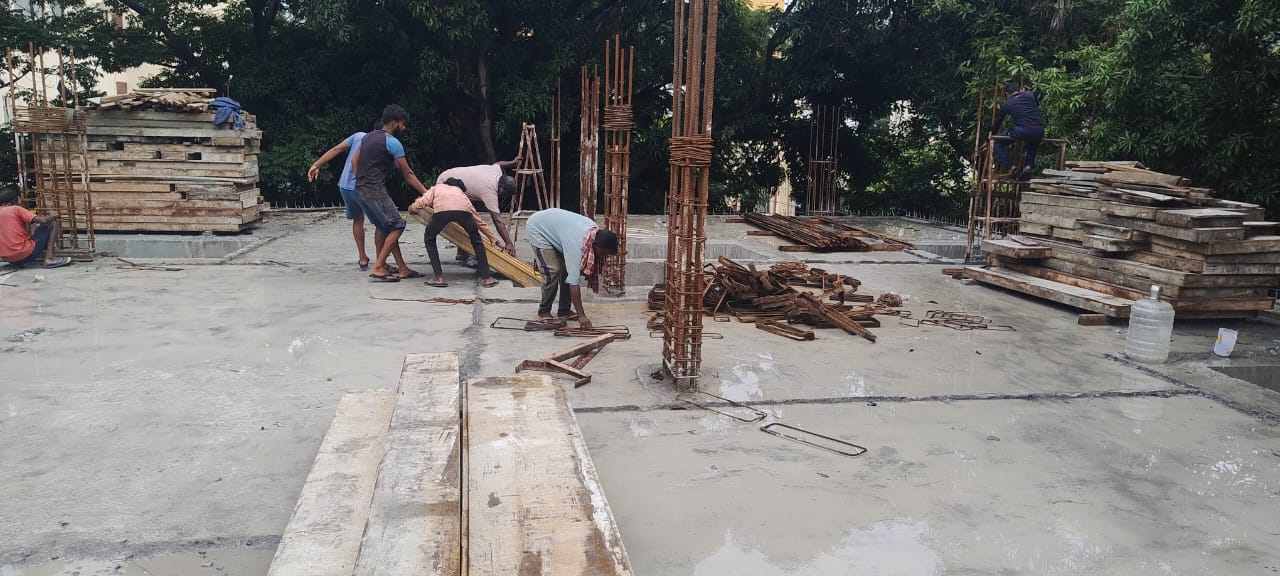

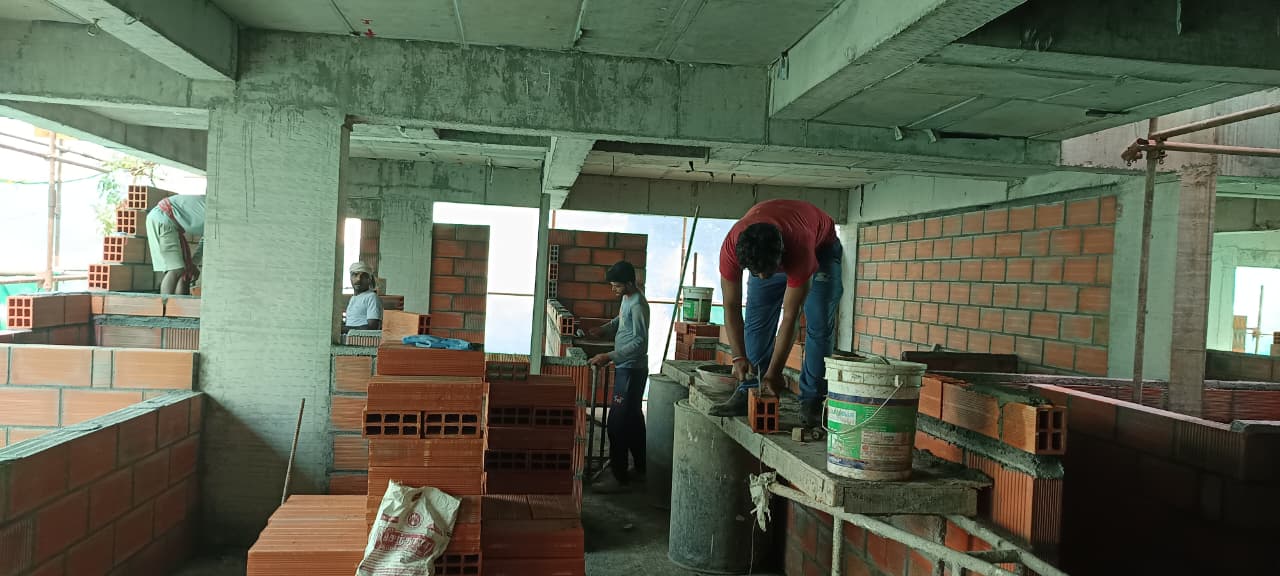

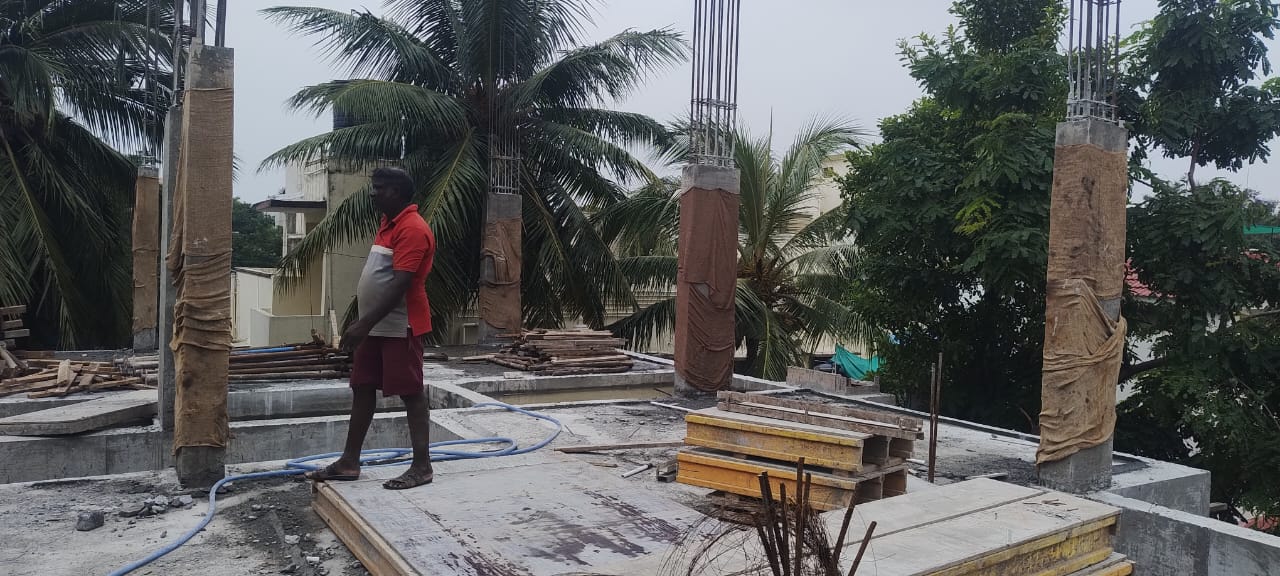

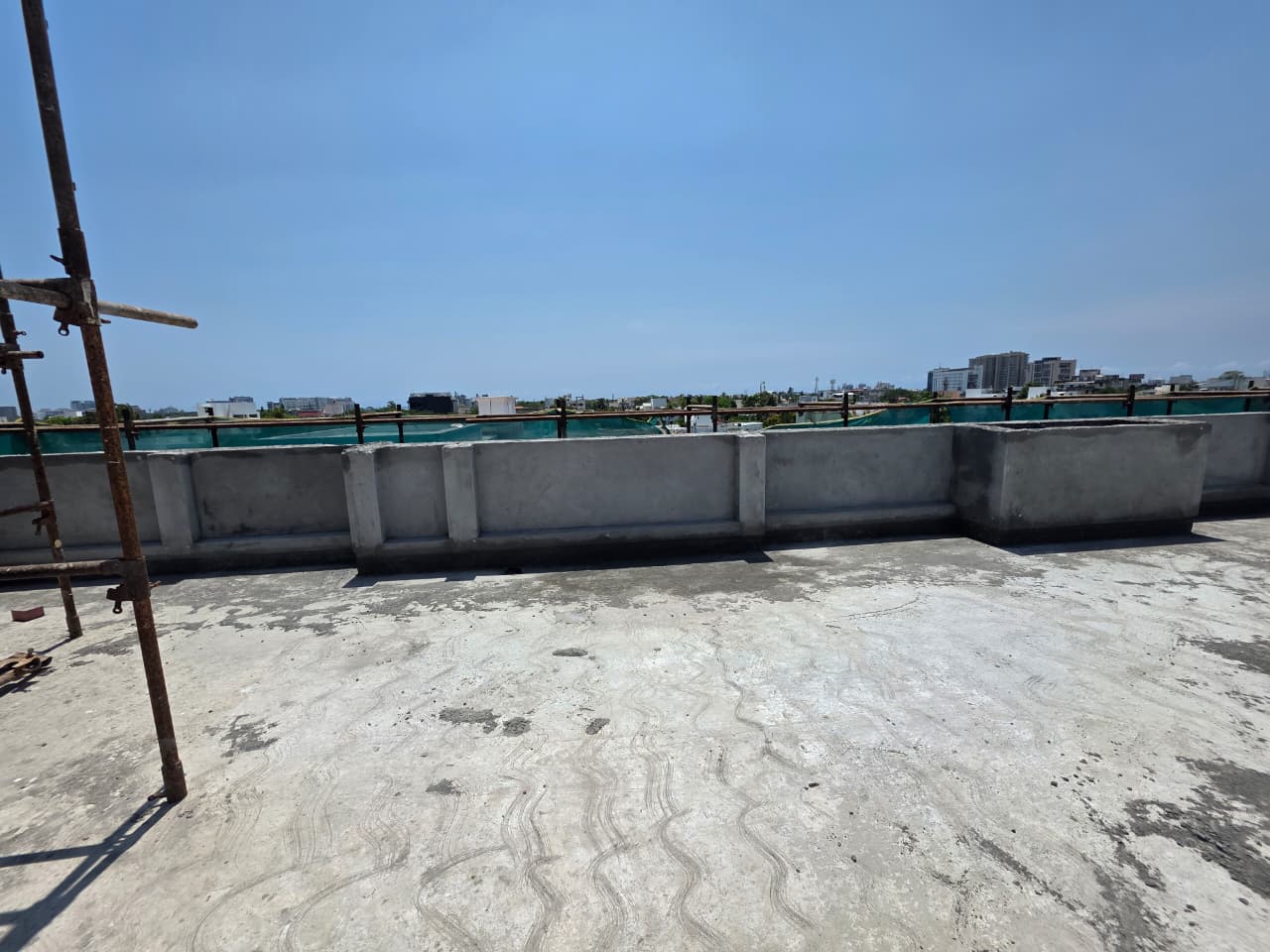

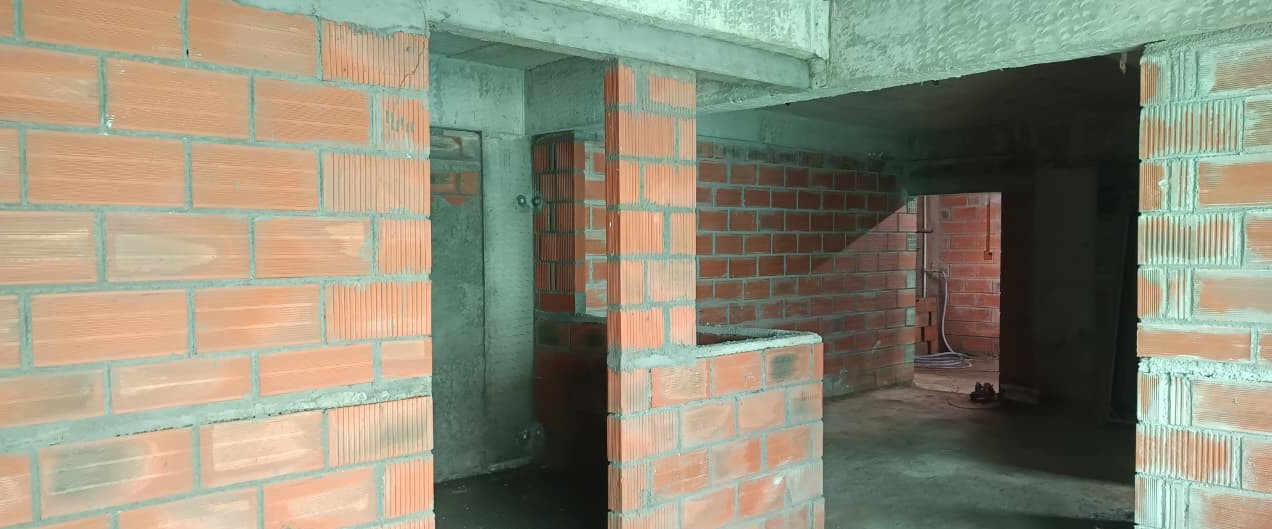

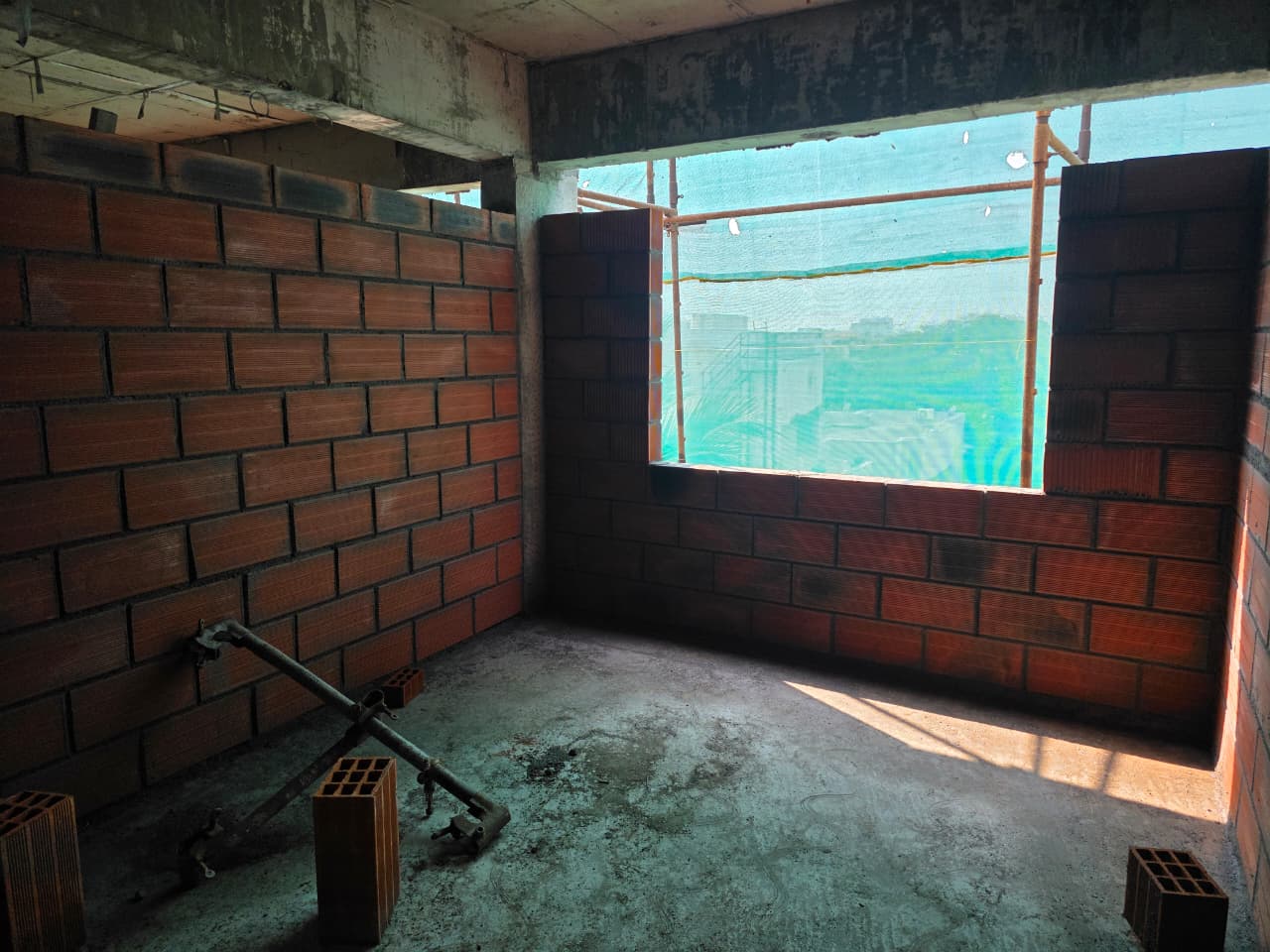

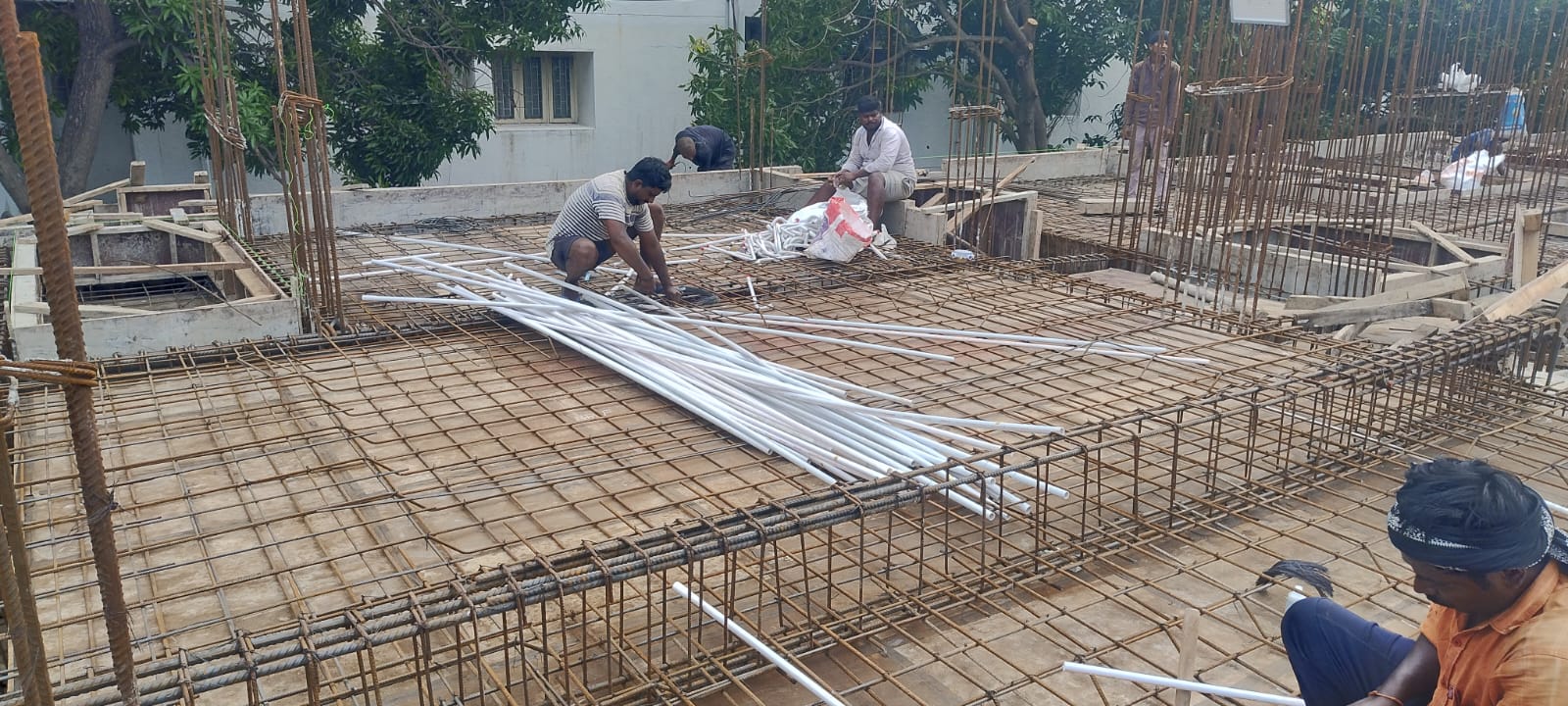

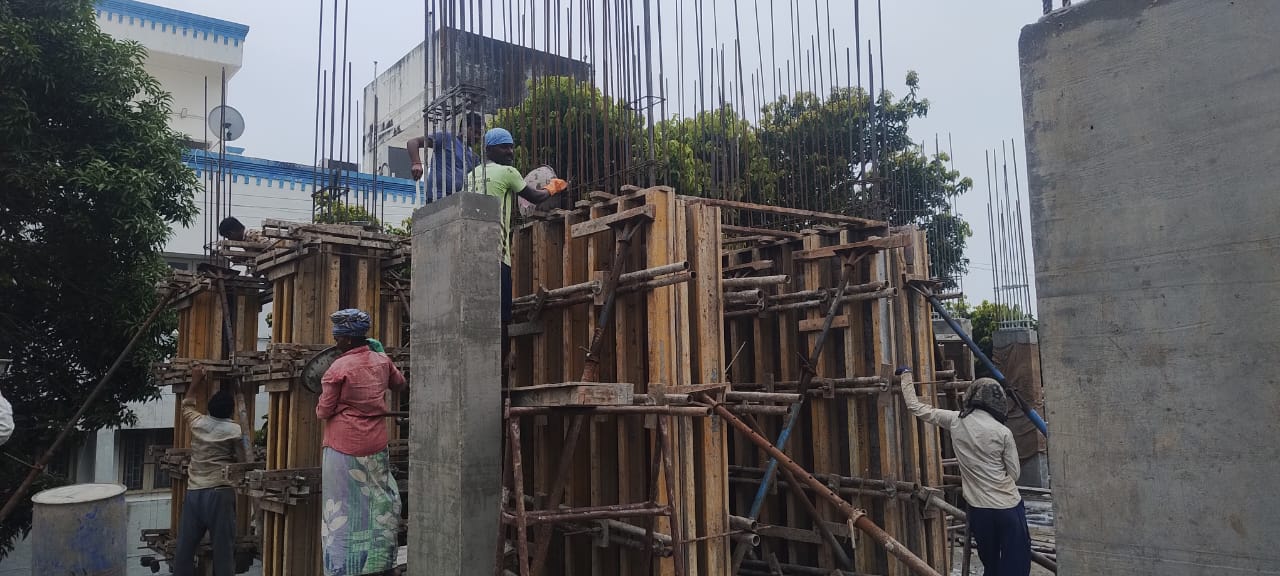

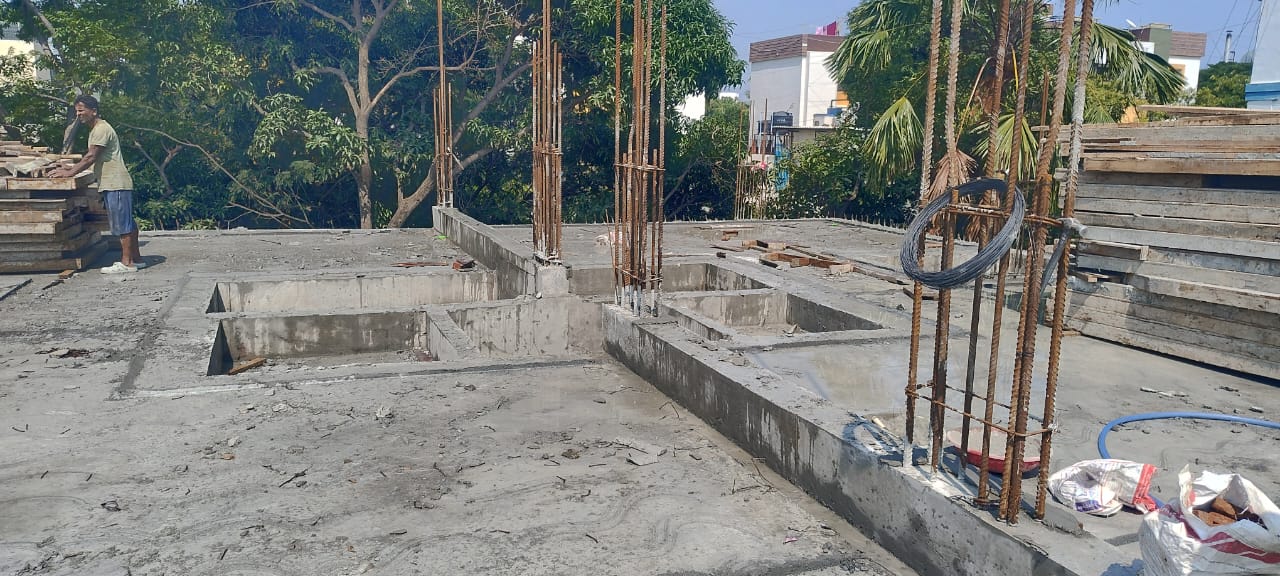

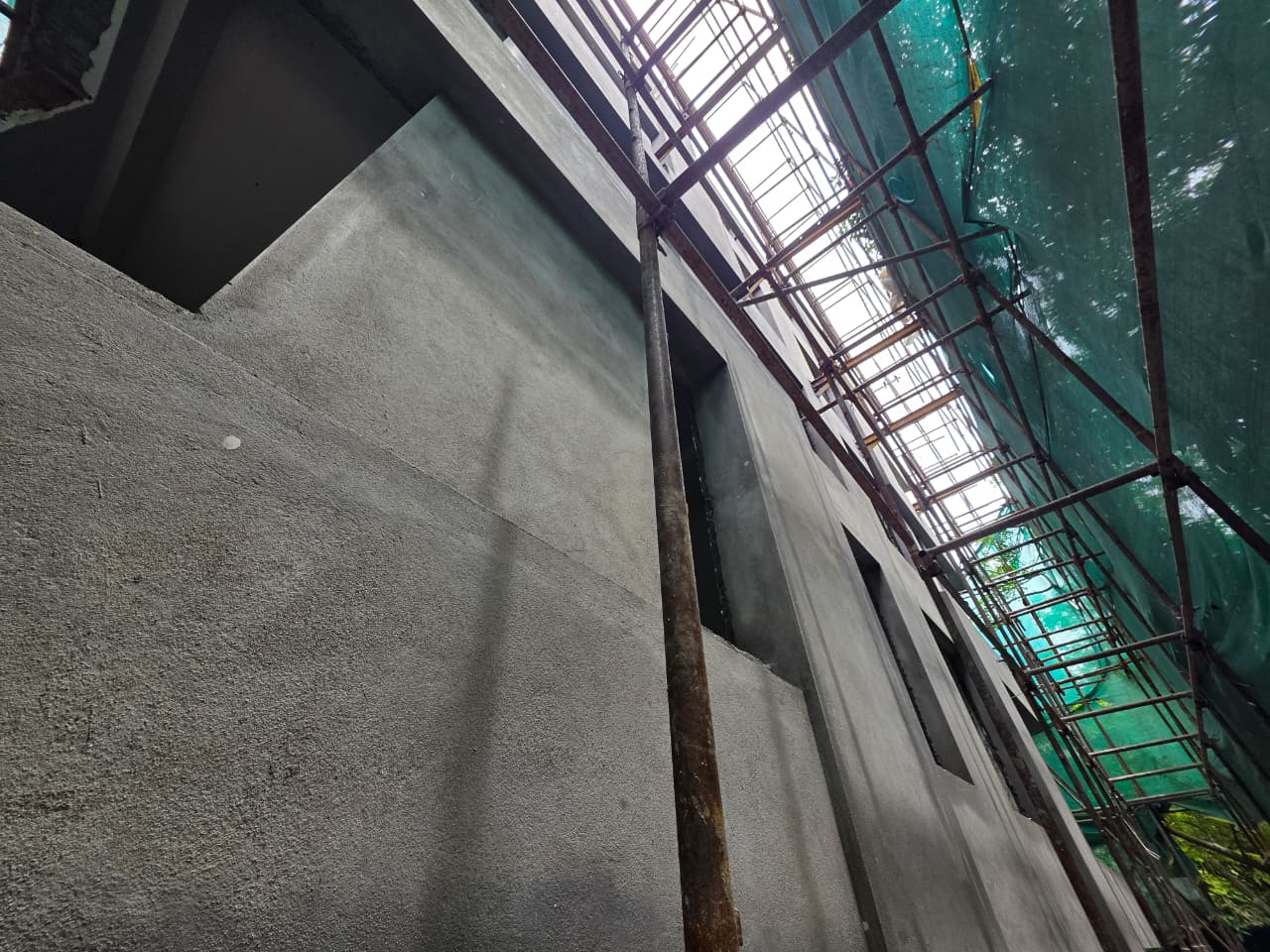

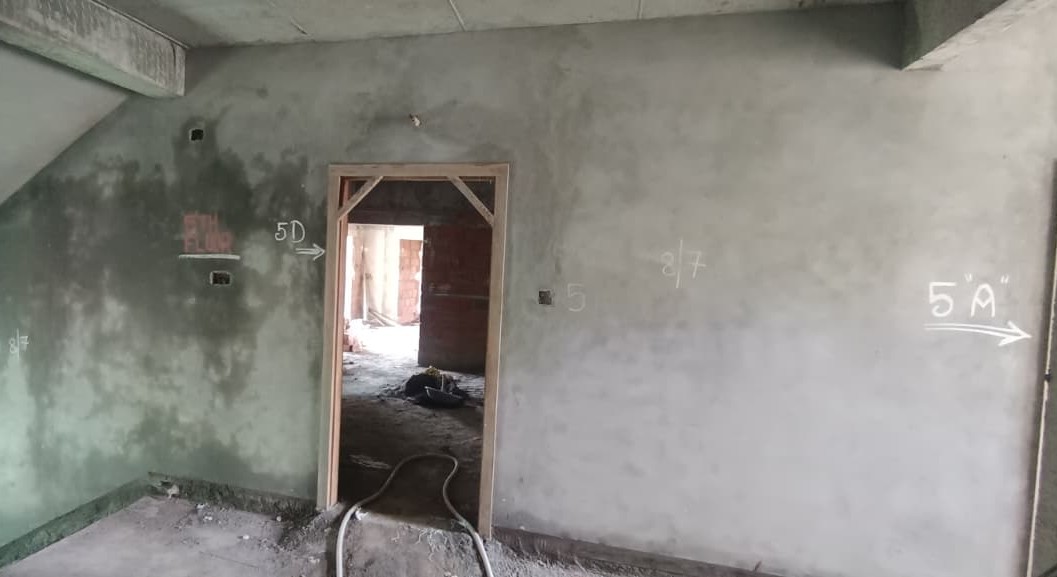

  • Up to 4th floor plastering work is in progress.
  • 5th floor plastering work is in progress.(80% completed)
  • All floors staircase wall plastering work is in progress.(80% completed)
  • Inner putty work is in progress.(1st,2nd,3rd& 4thfloor progress)
  • External plastering work is in progress.(80% completed)
  • Toilet plumbing work is in progress.(upto 3rd floor completed, 4th& 5thfloor progress)
  • Toilet wall tiles work is in progress. (1st& 2nd completed,3rd floor progress)
  • General main flooring work is in progress.(3/19) completed.

  • All floor jambs granite work is in progress.(40% completed)

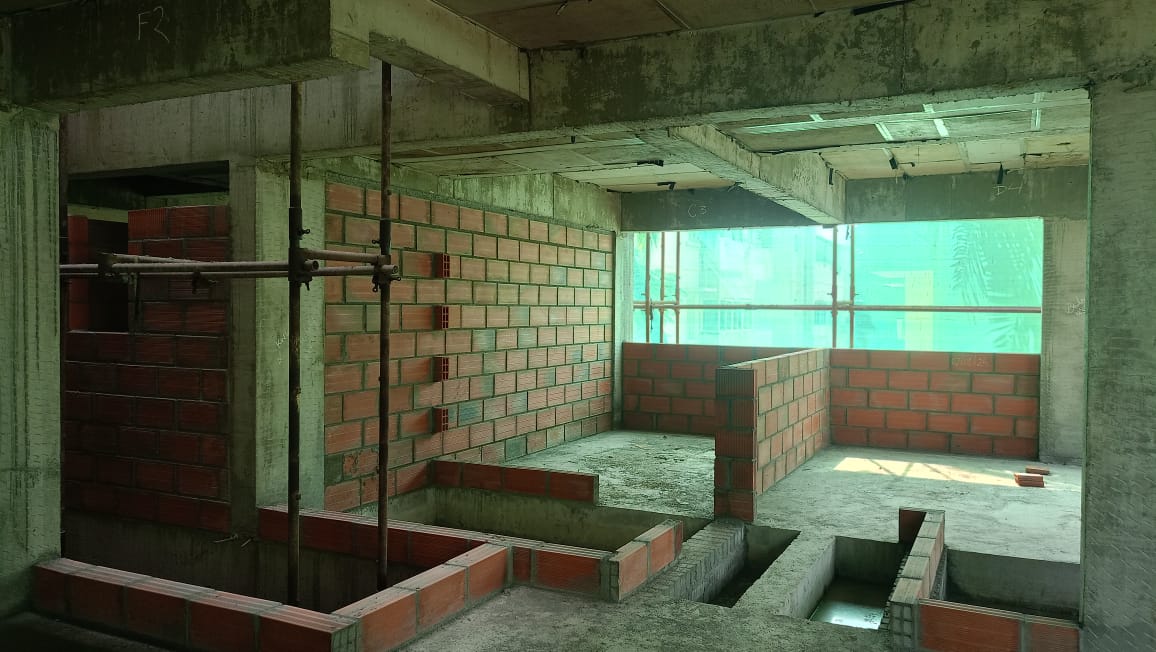

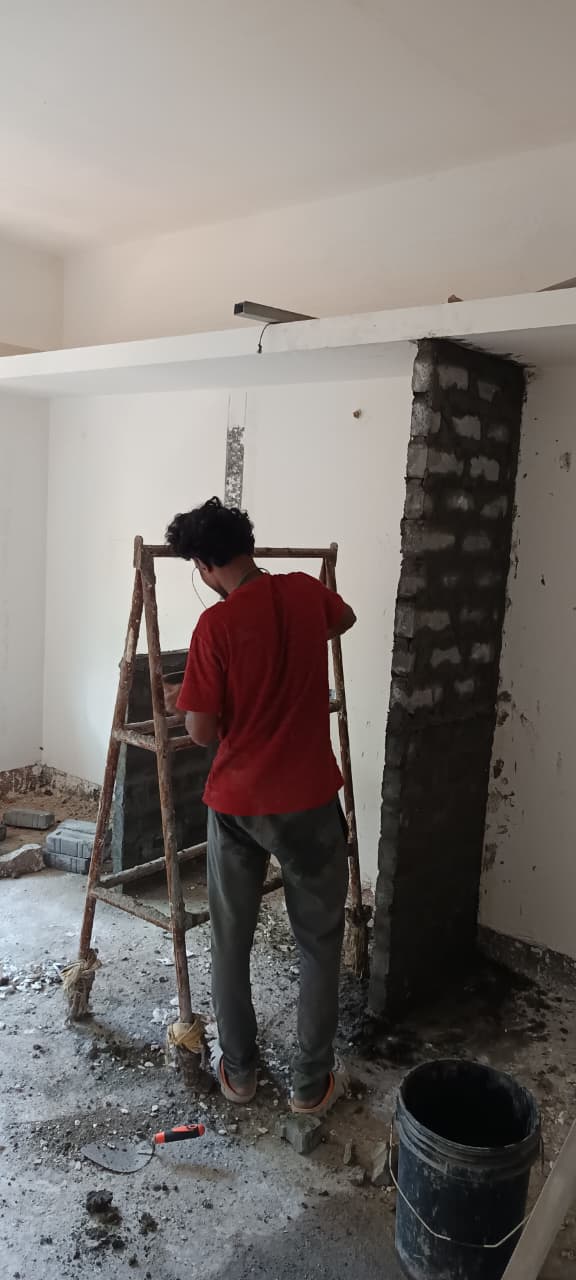

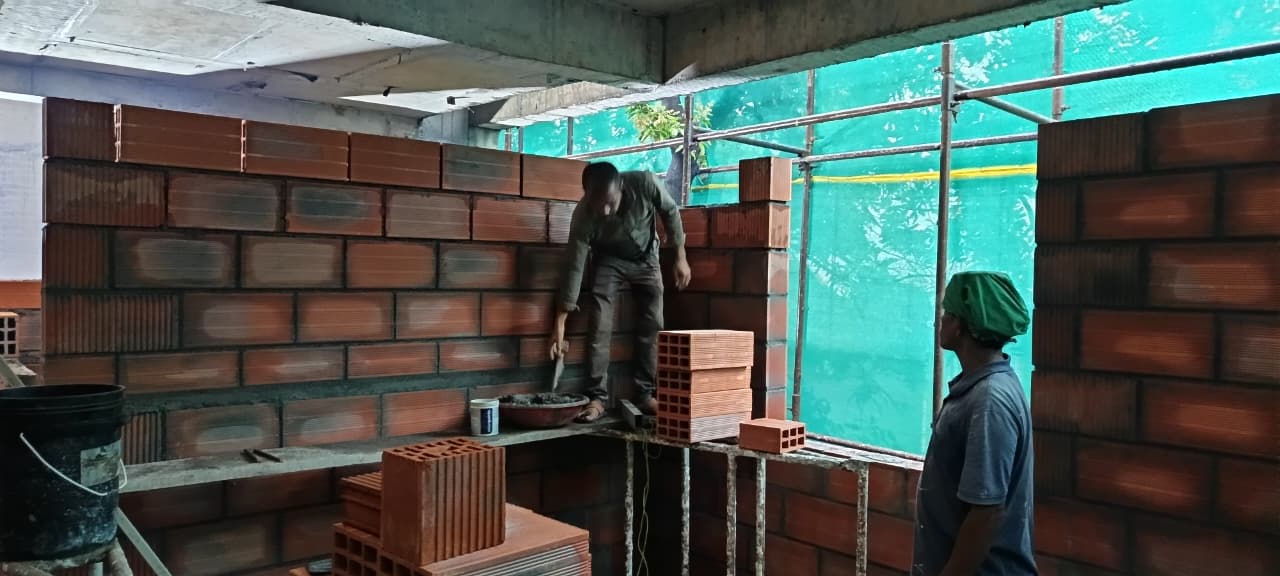

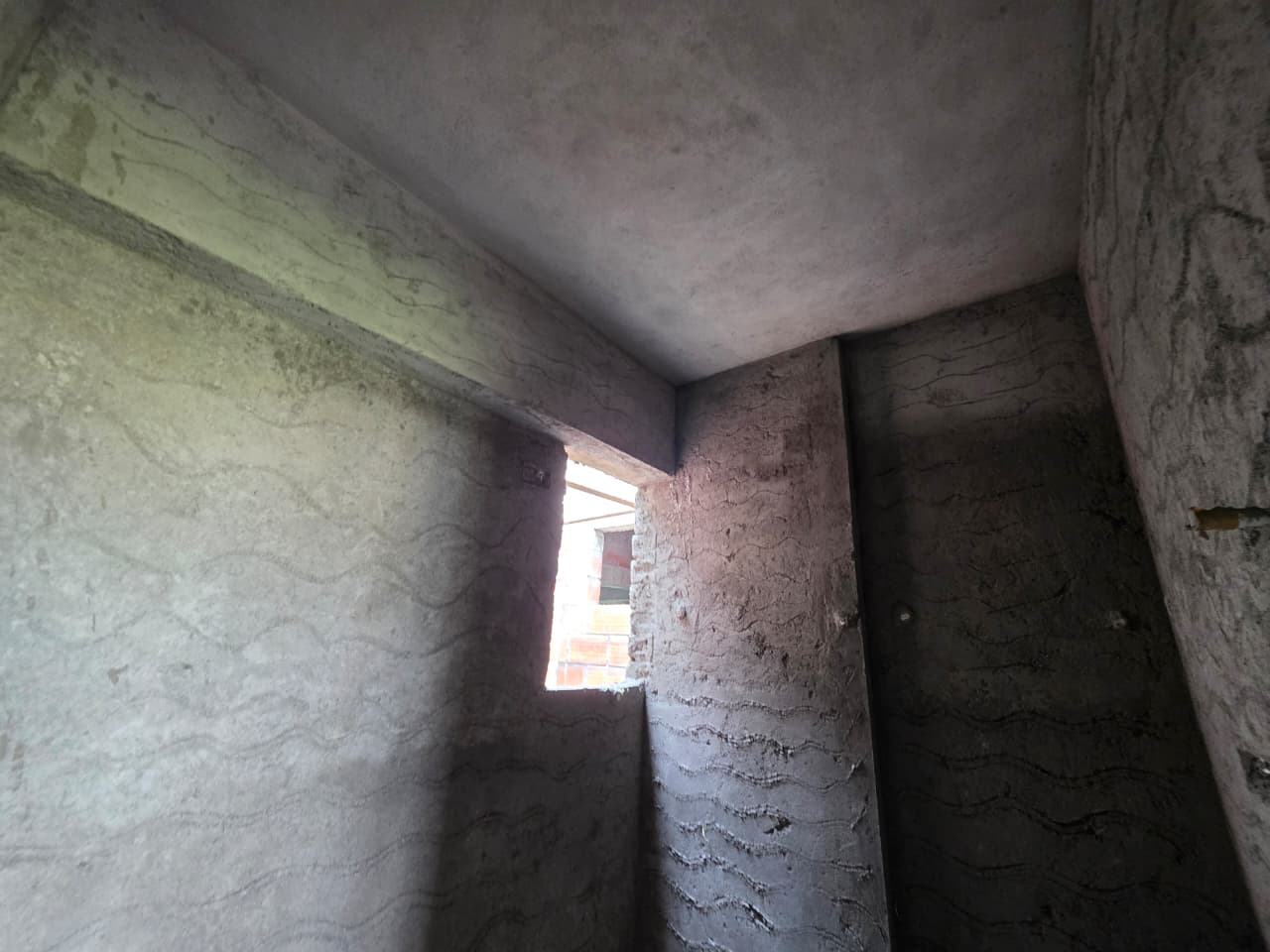

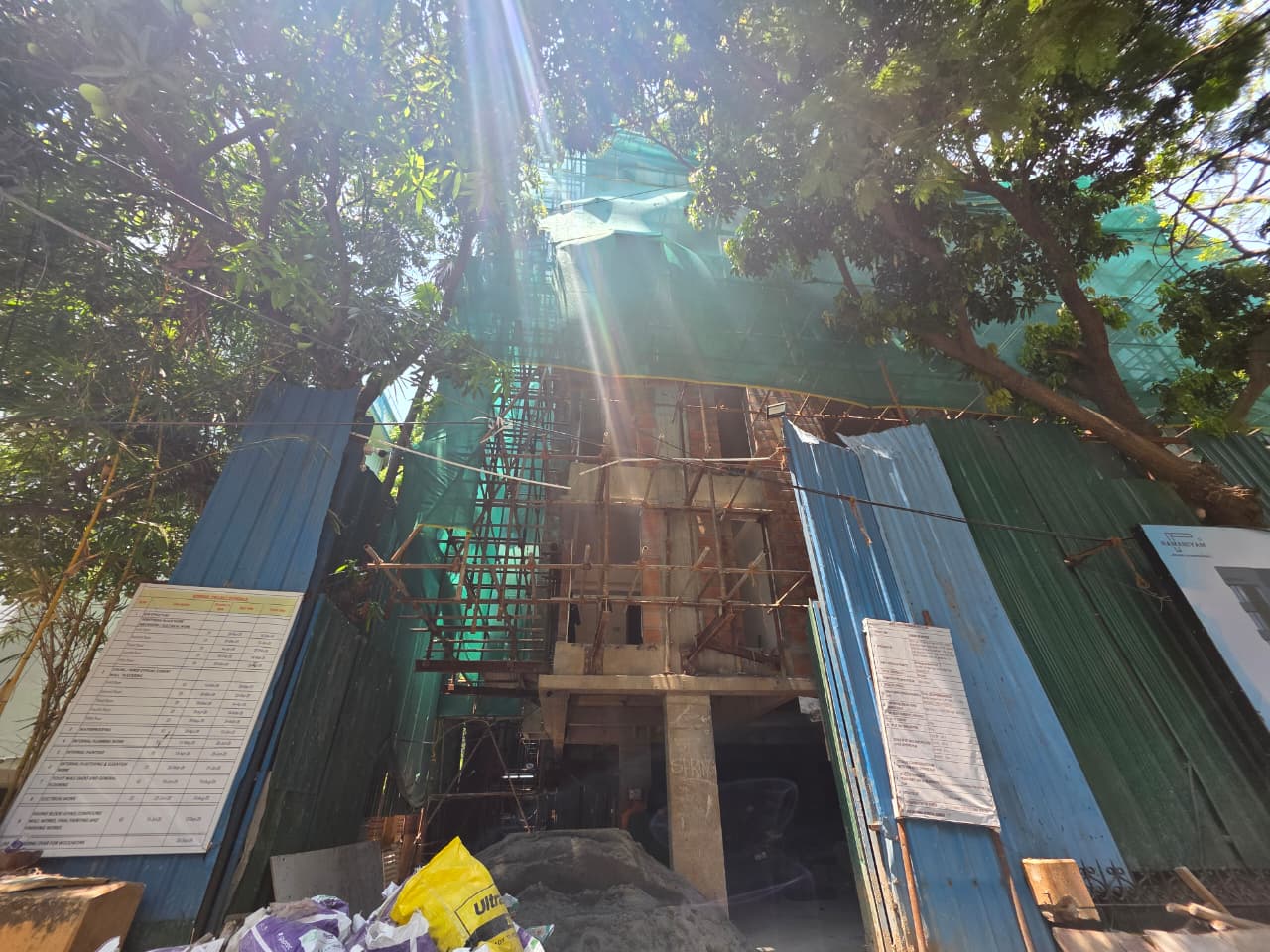

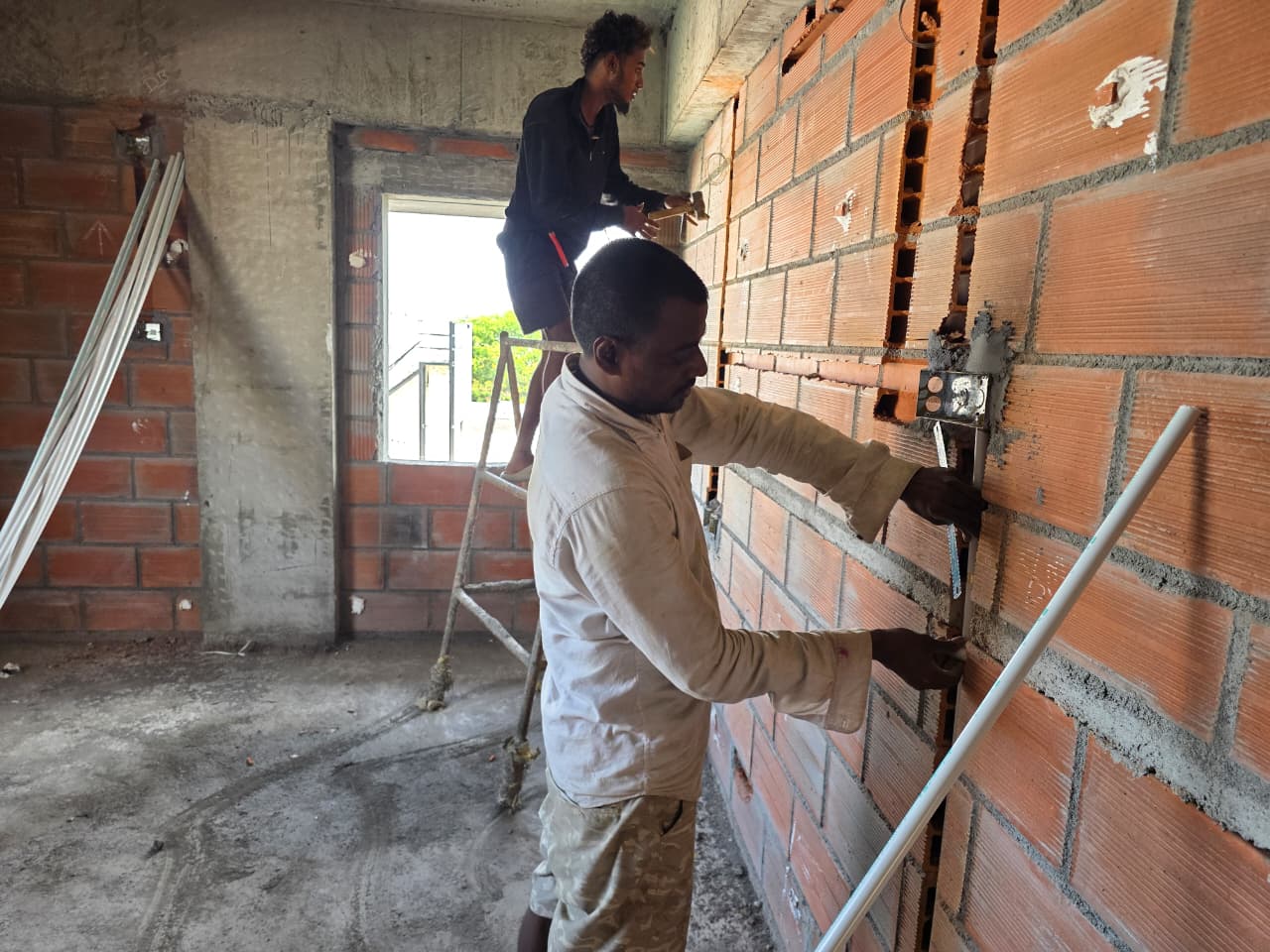

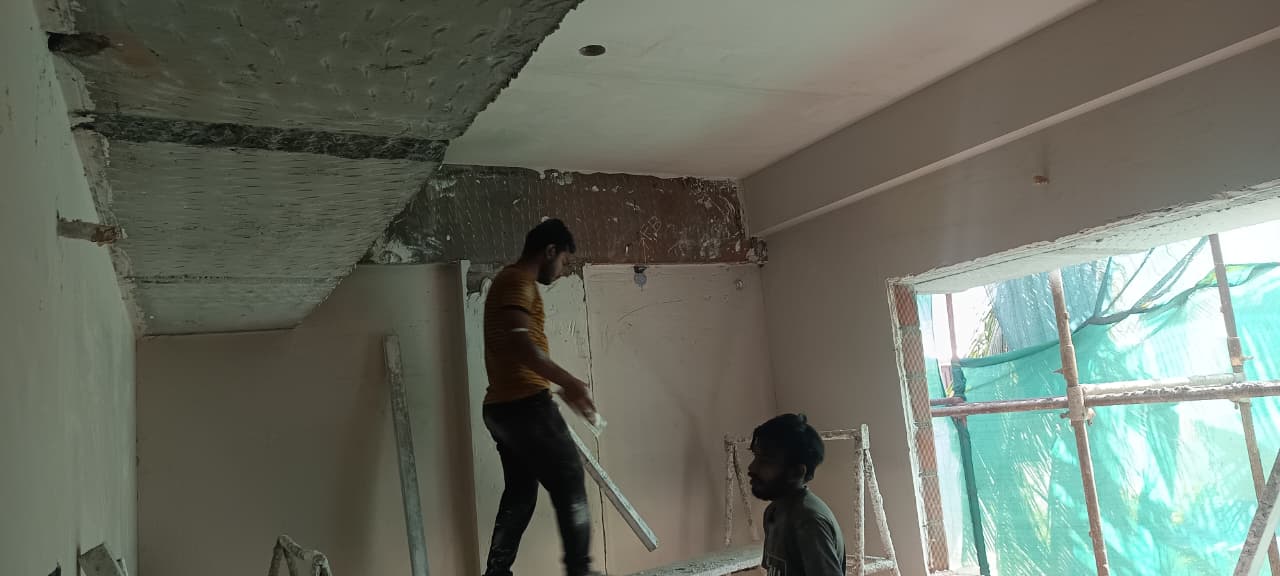

Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image Springs Progress Image

Property Location

Let your dreams be our

next Project!

Include your country code — all international formats are accepted (e.g. +91, +1, +44, +971).
