Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Ponkamal Enclave

T.Nagar

Download Brochure

Ramaniya - Files

Enquire Now

Amenities

Generator Backup Generator Backup
CCTV CCTV
Lobby Lobby
Rain Water Harvesting Rain Water Harvesting

Master Layout Plan

Ponkamal Enclave - Floor Plan
Ponkamal Enclave - Floor Plan
Ponkamal Enclave - Floor Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
2A 2 3BHK + 3T 1722 North Available

Approvals

Planning Permit No:

OL-PP/NHRB/0181/2025,OL-01807

Date of Permit:

2025-05-19

Building Permission No:

CEBA / WDCN09 / 00227 / 2025

Date of Permit:

2025-05-20

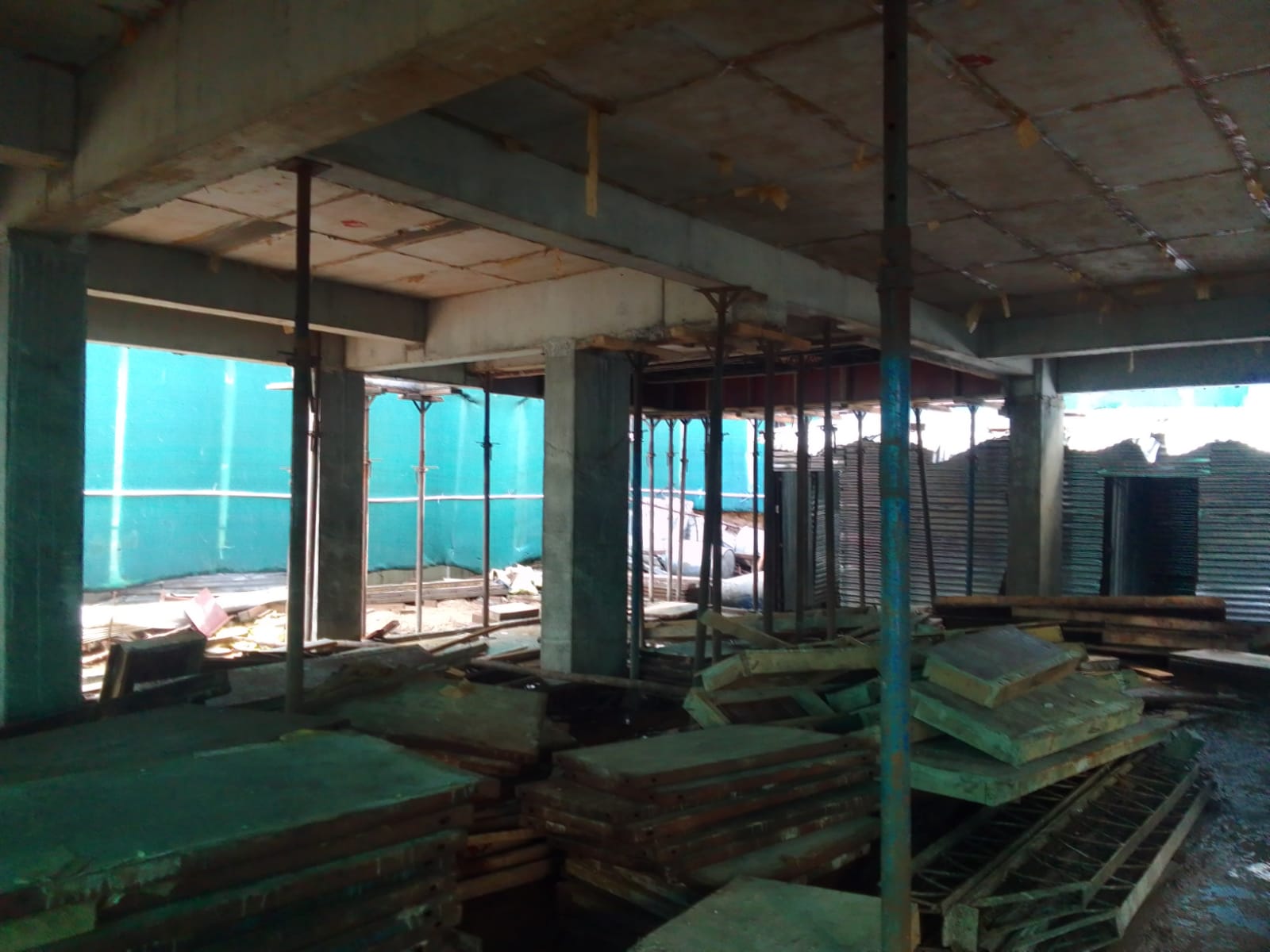

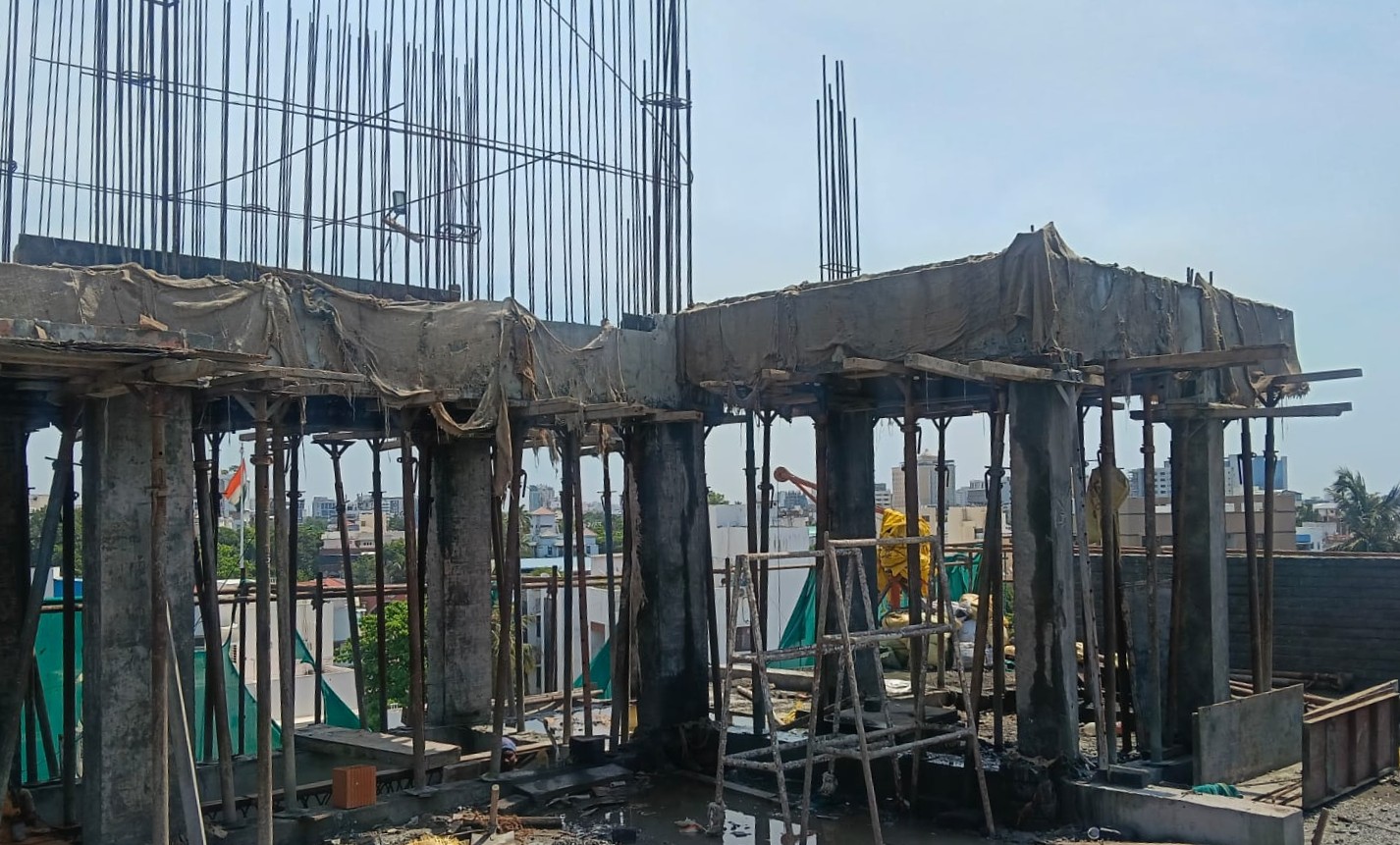

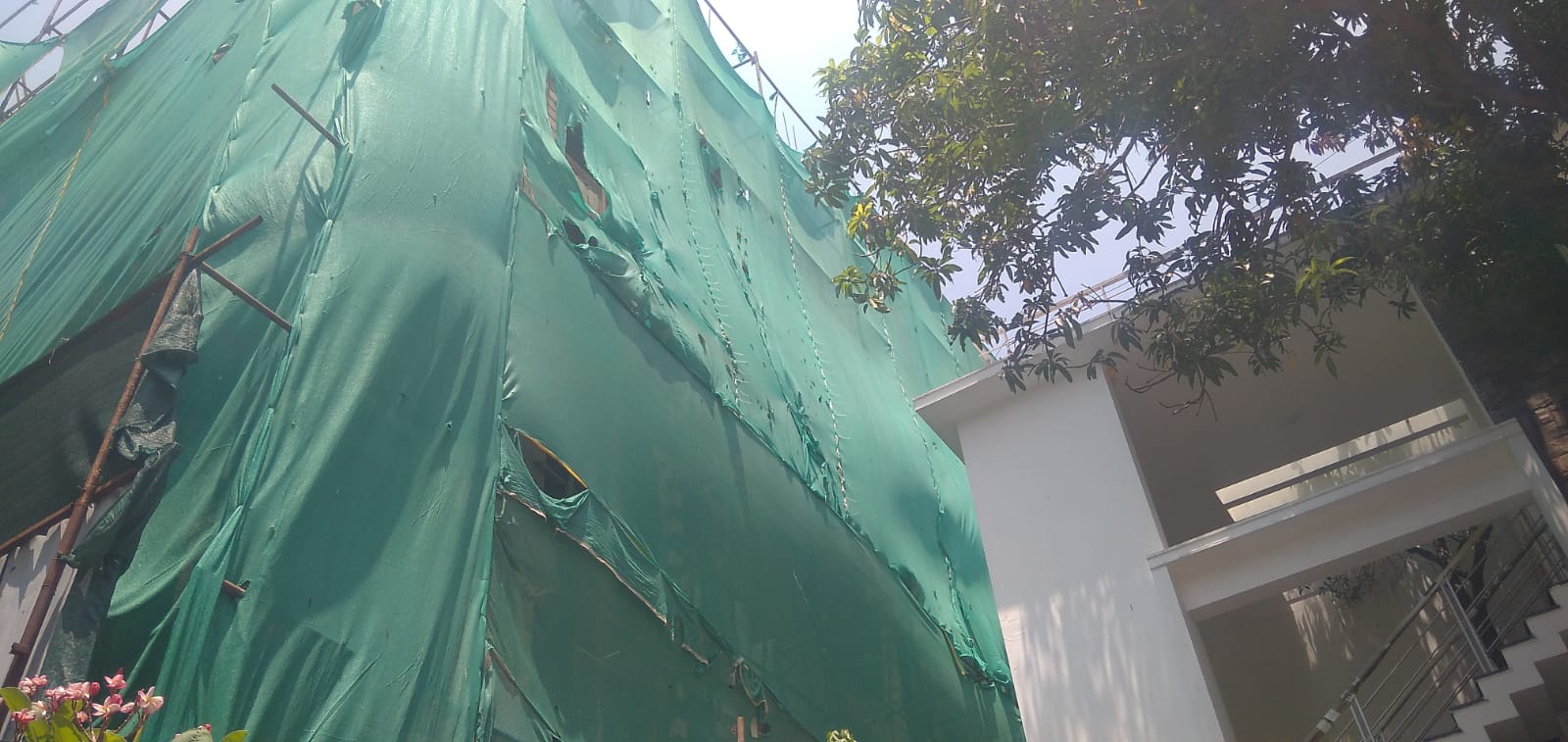

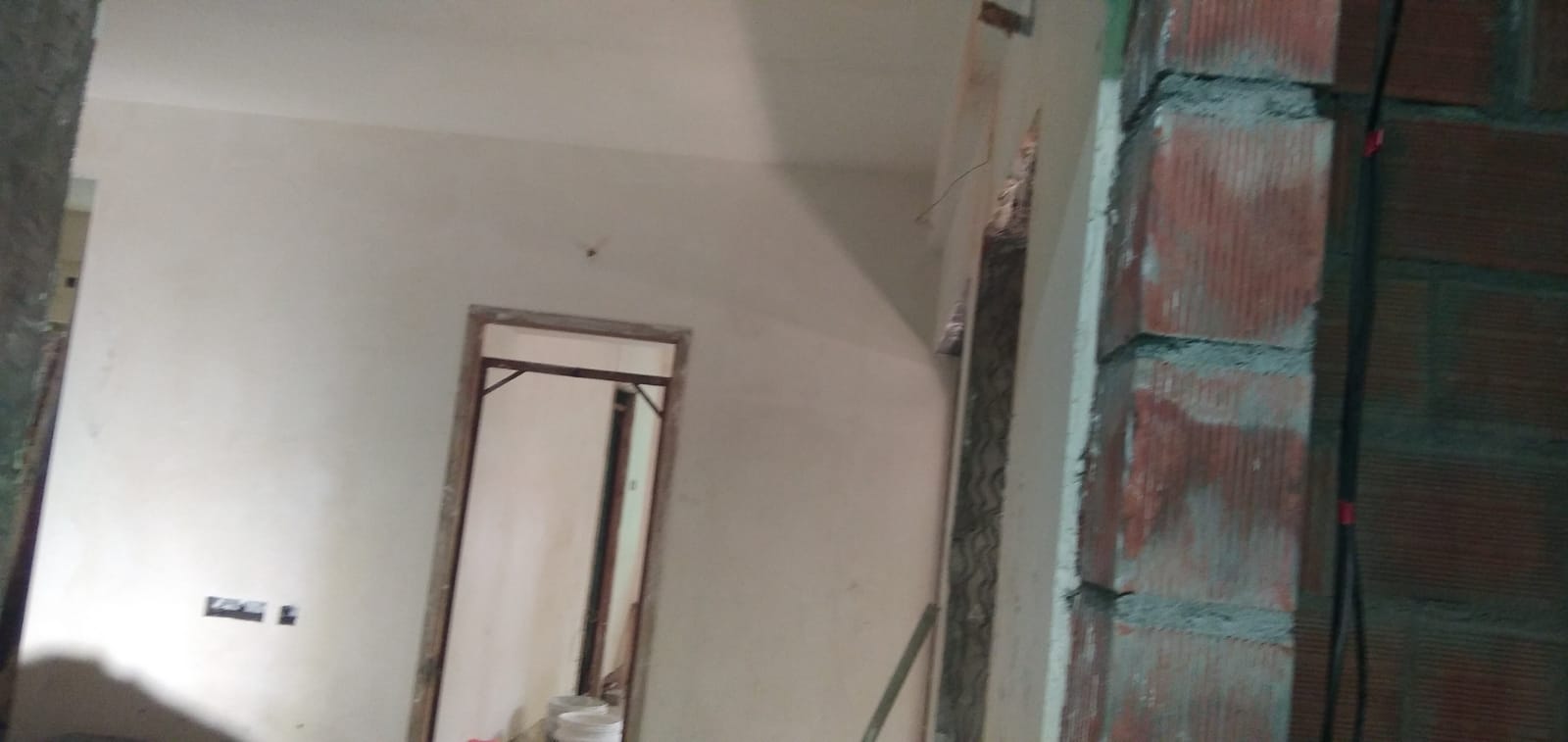

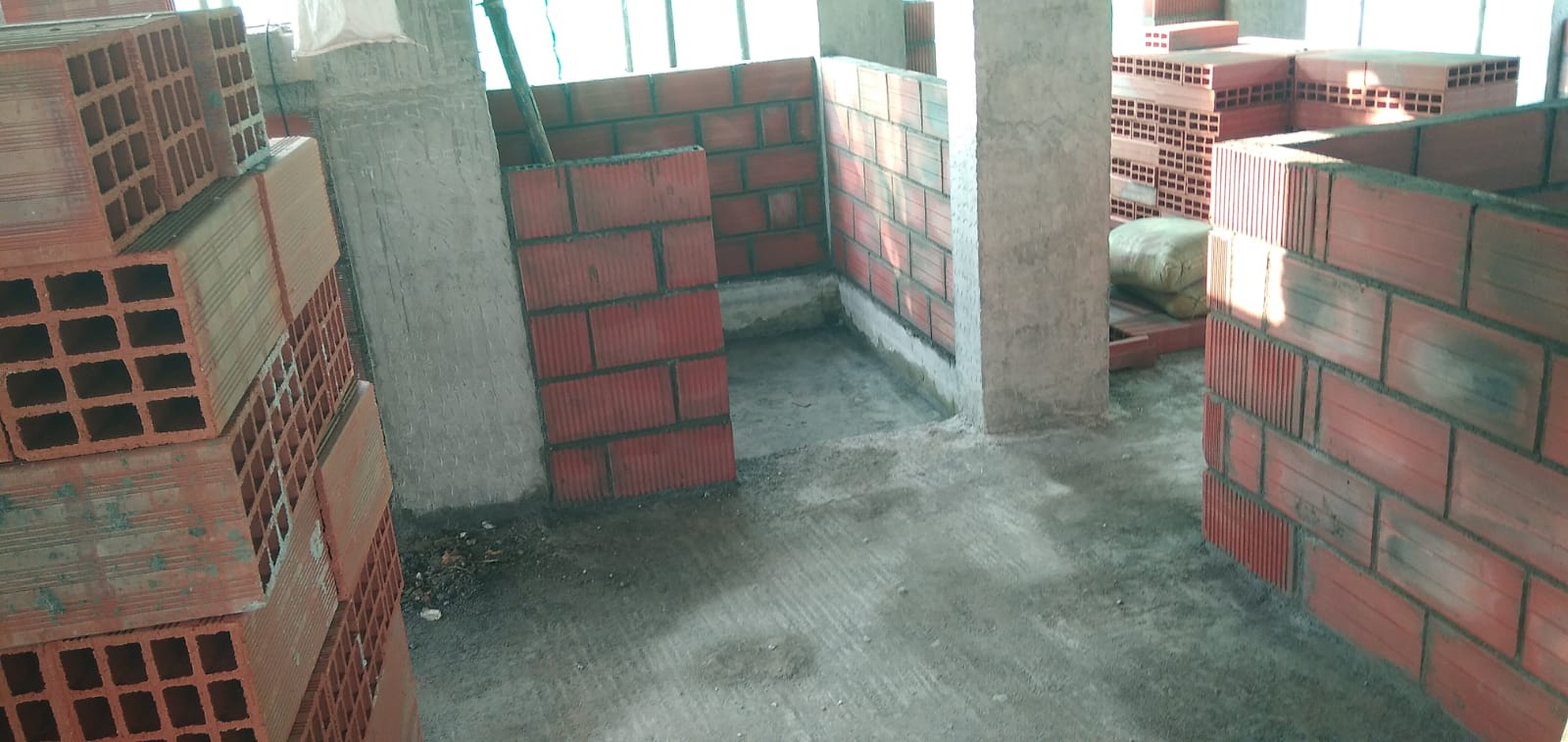

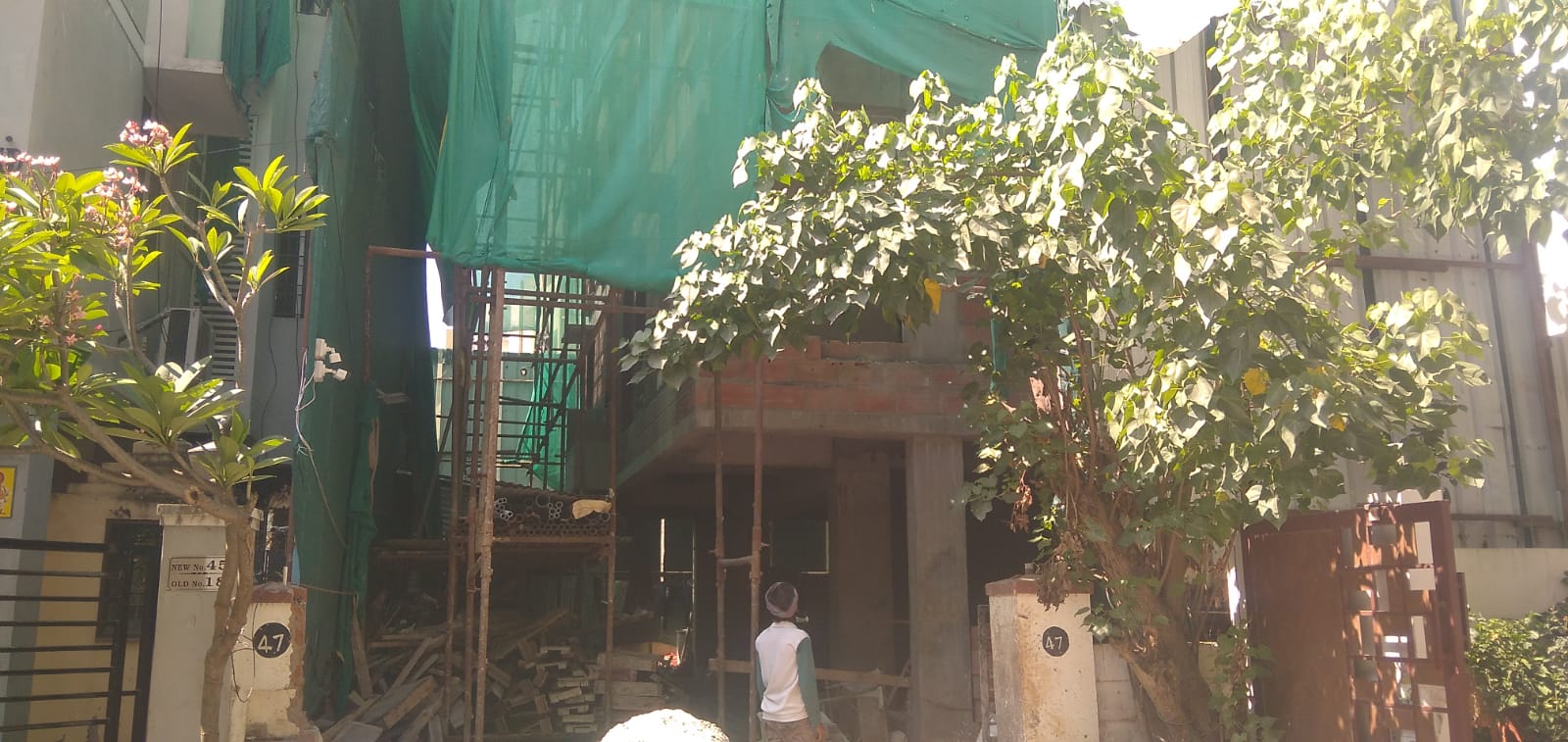

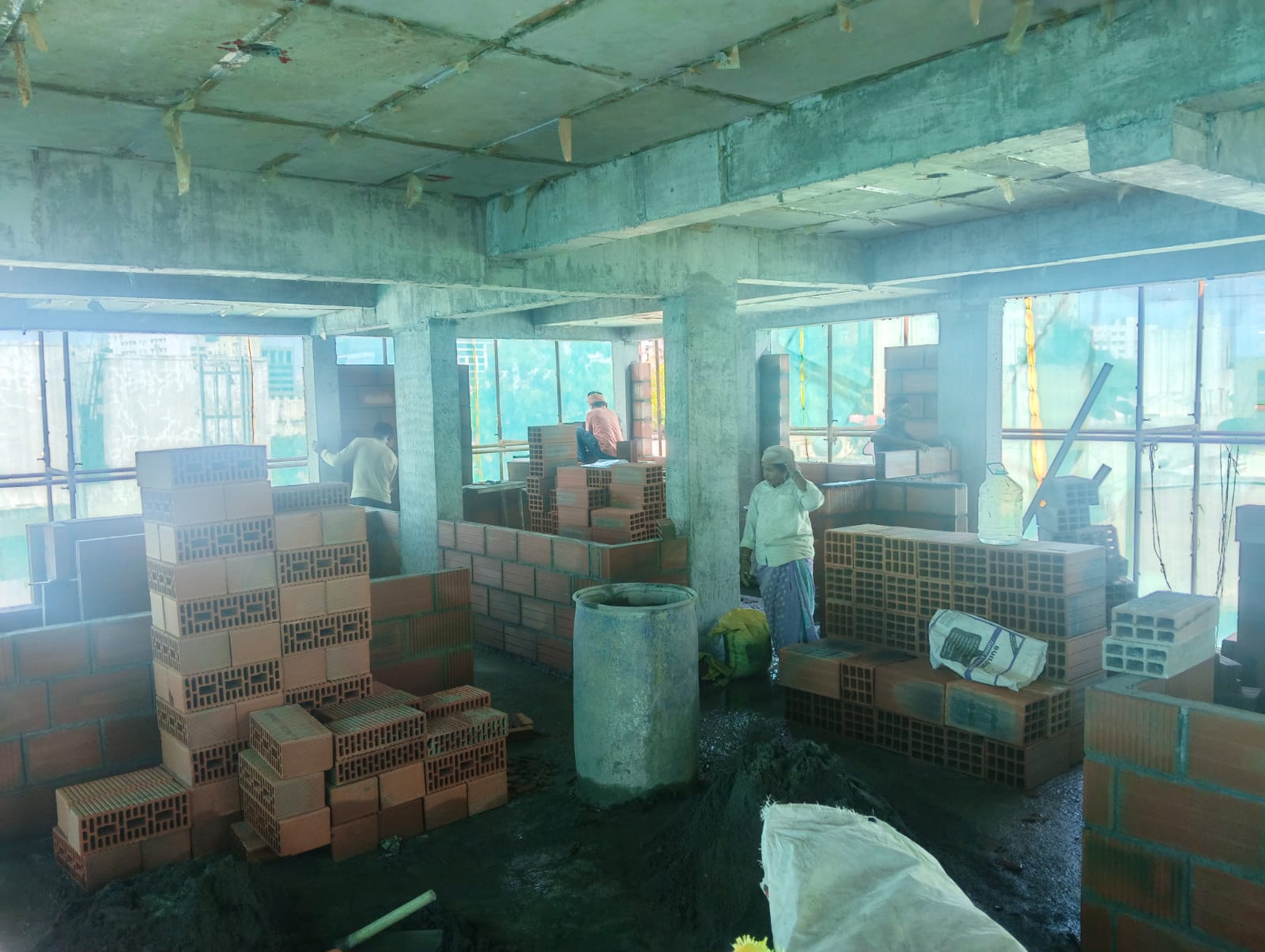

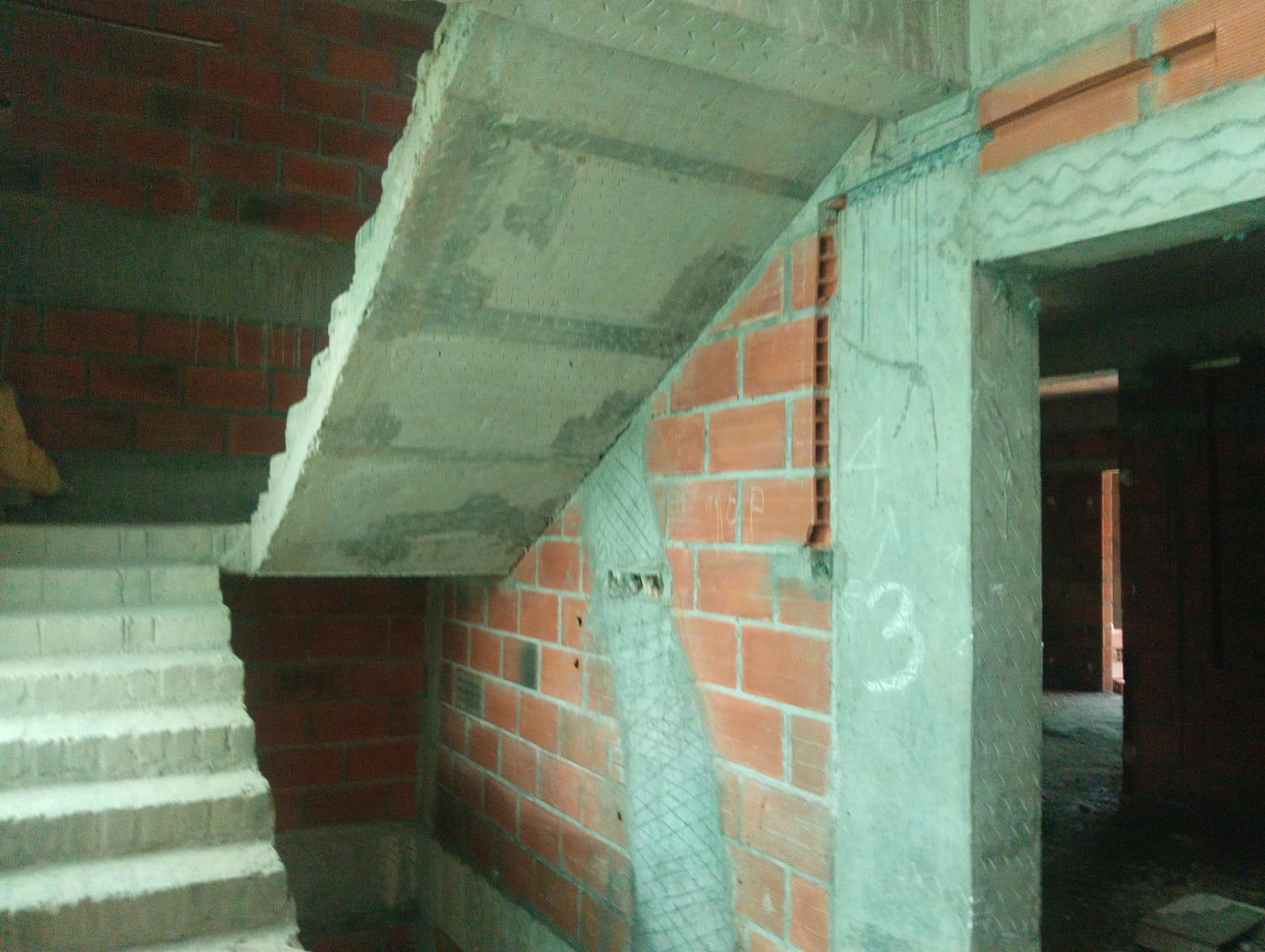

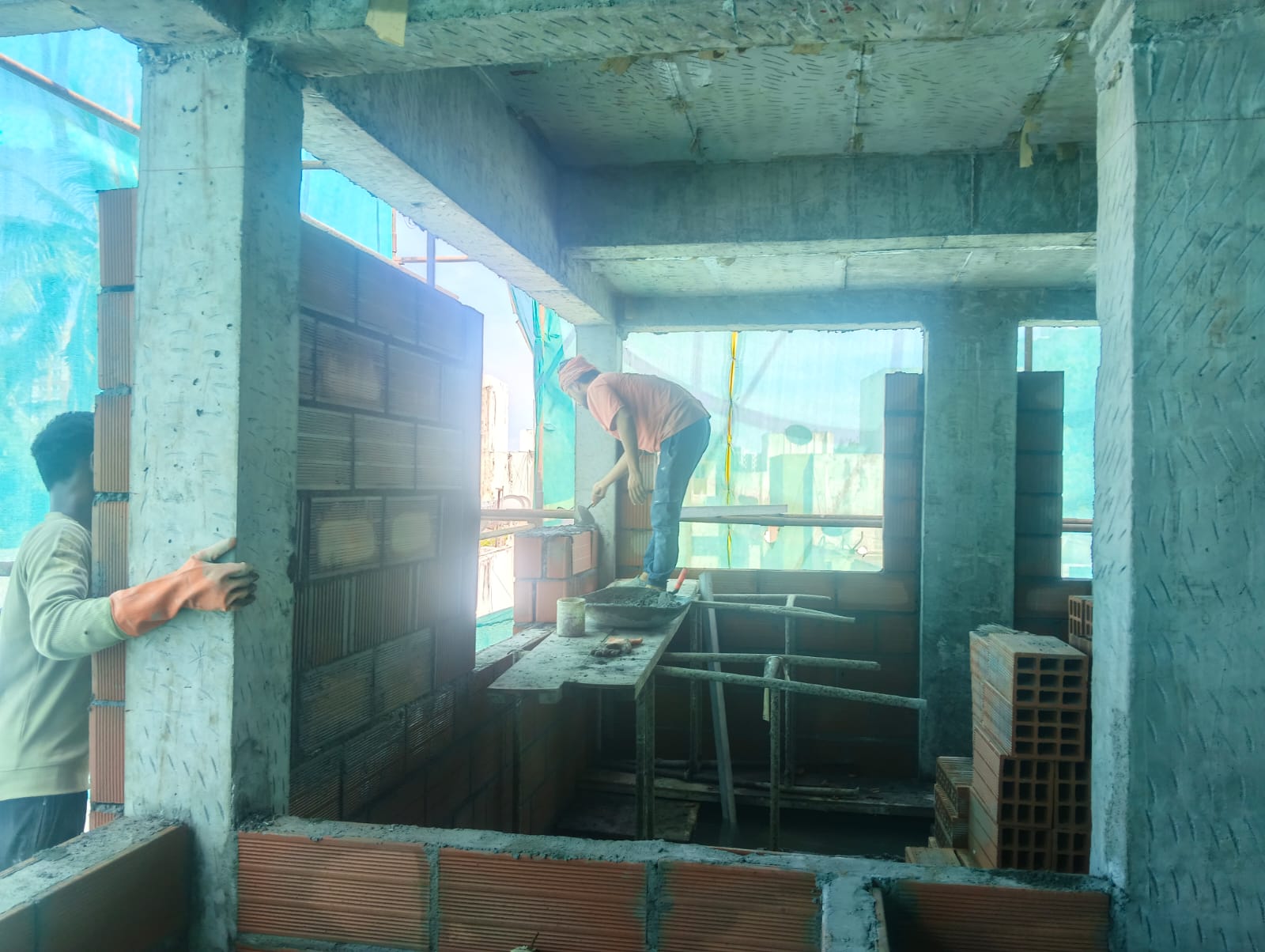

Project Update Images

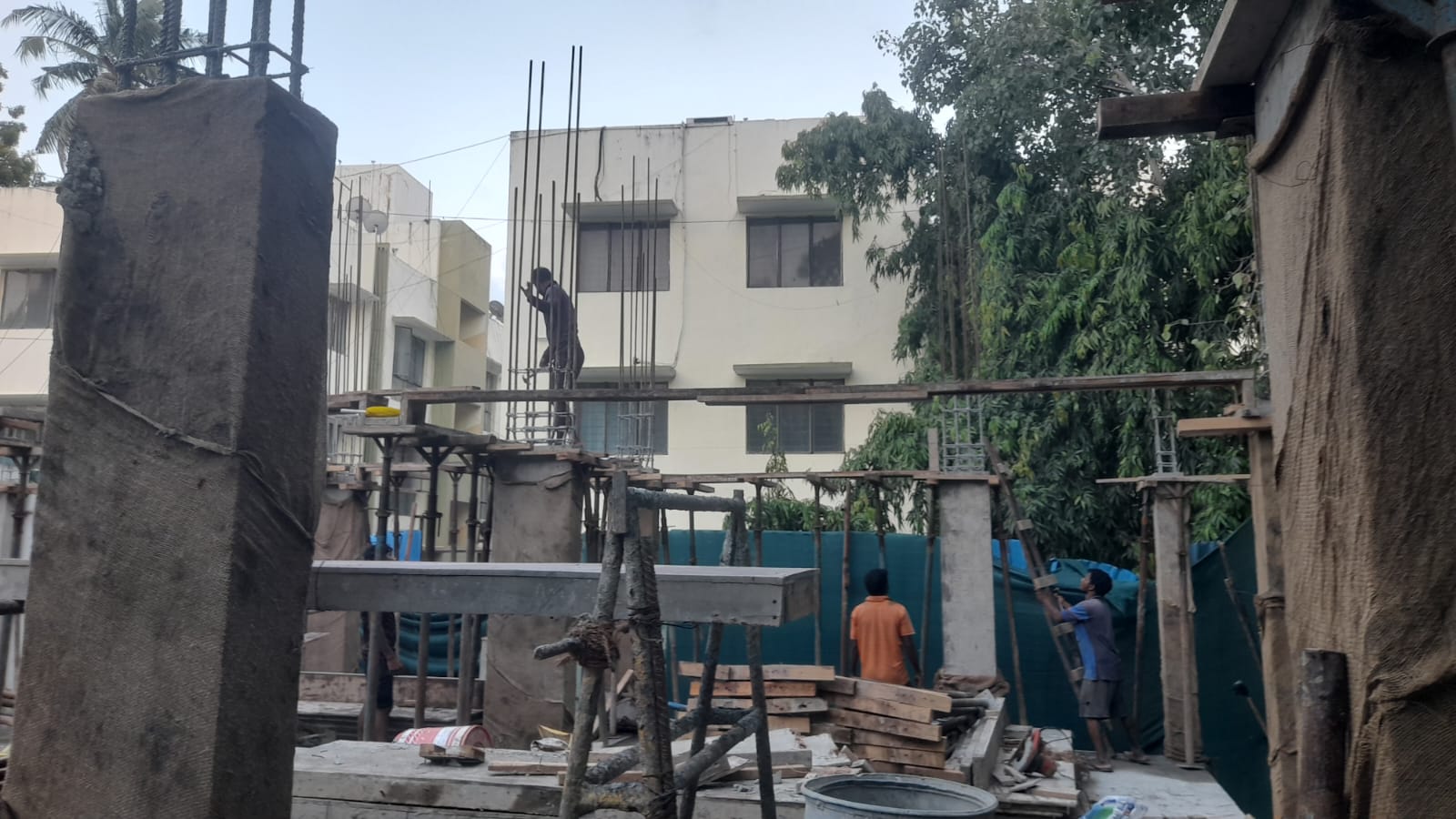

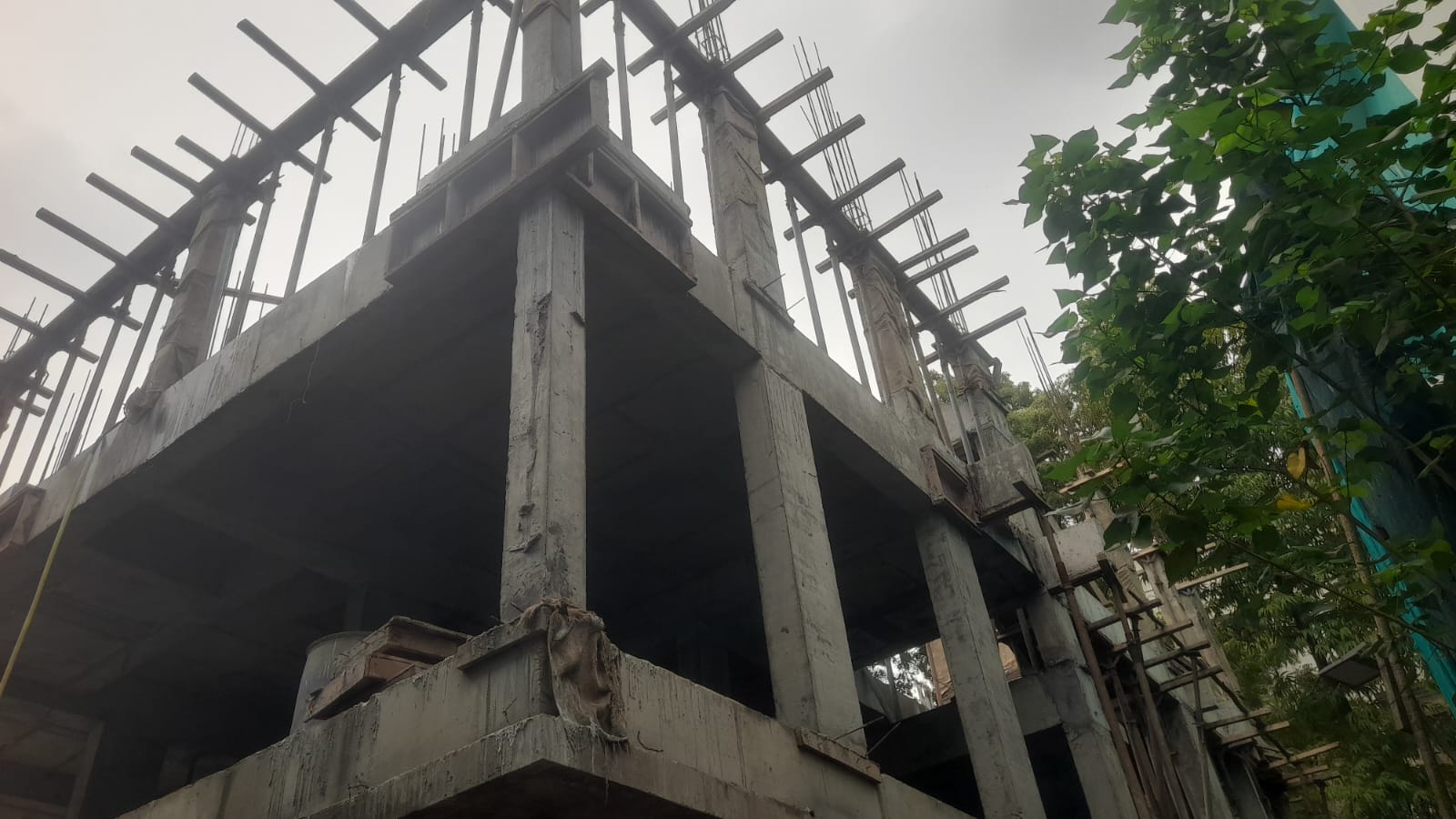

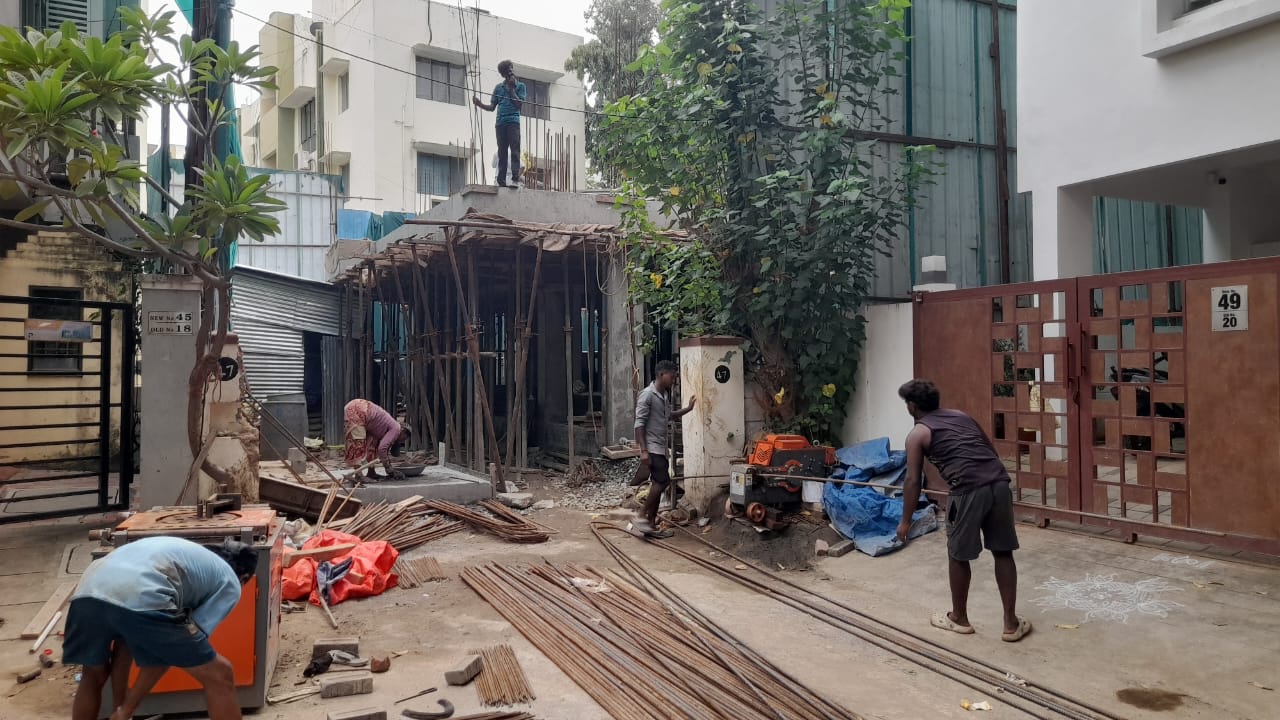

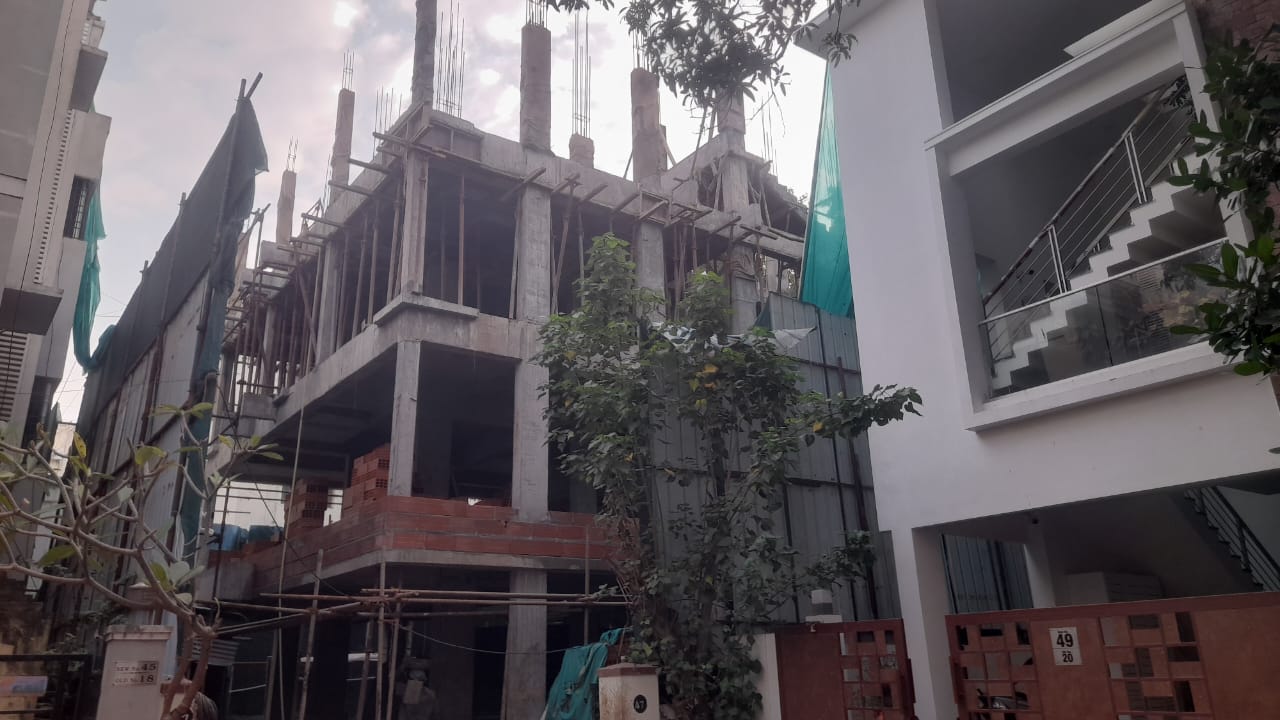

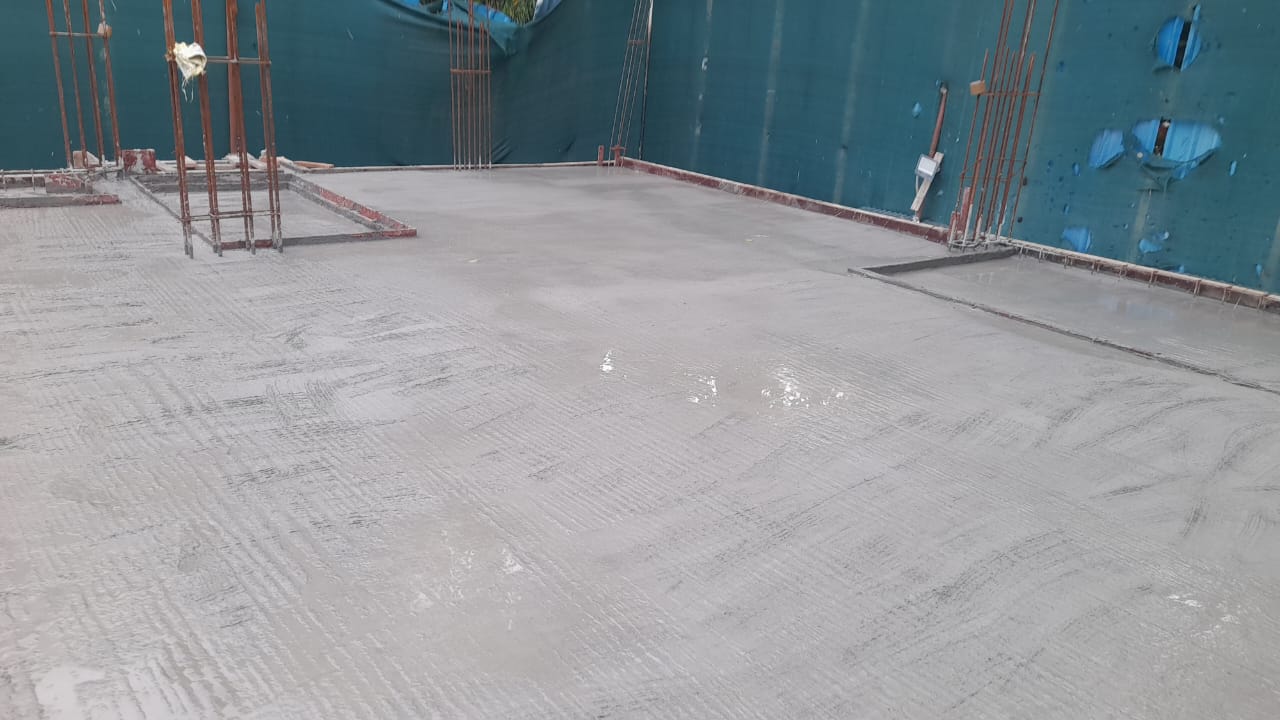

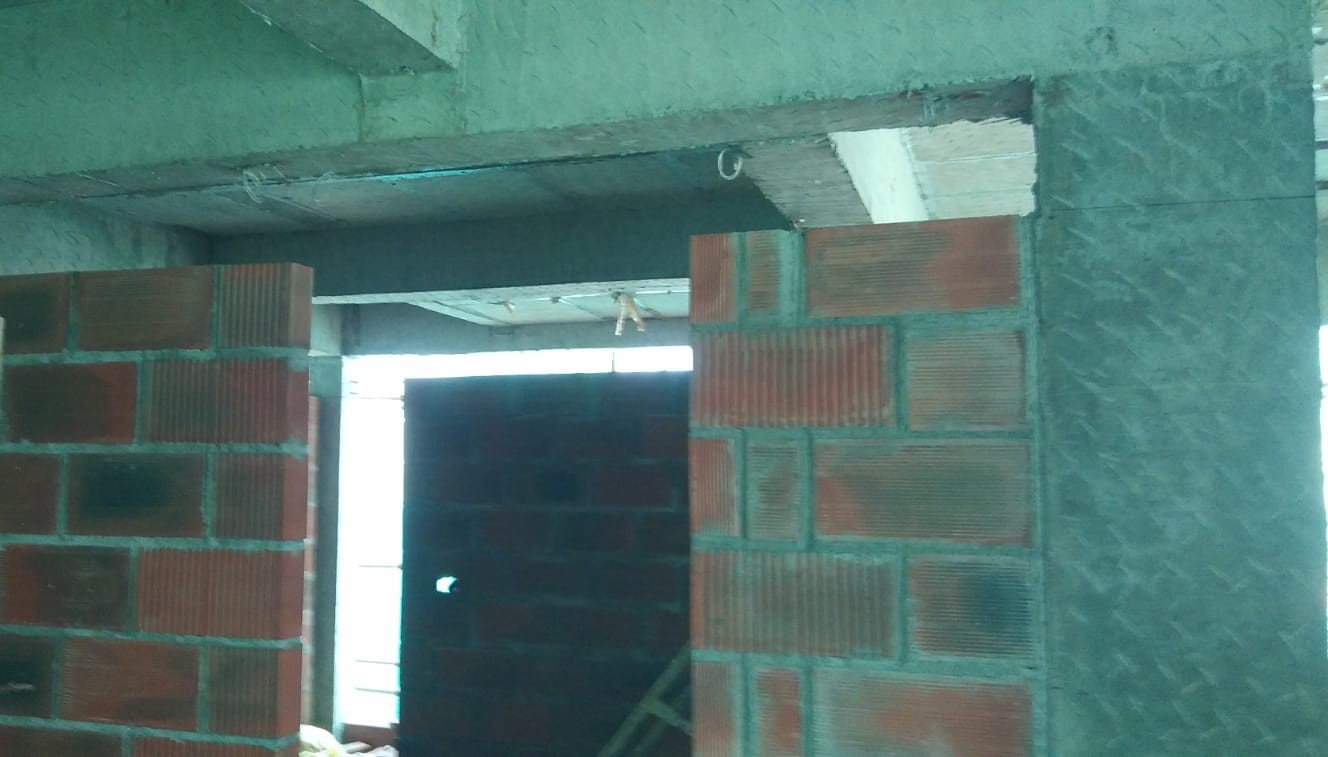

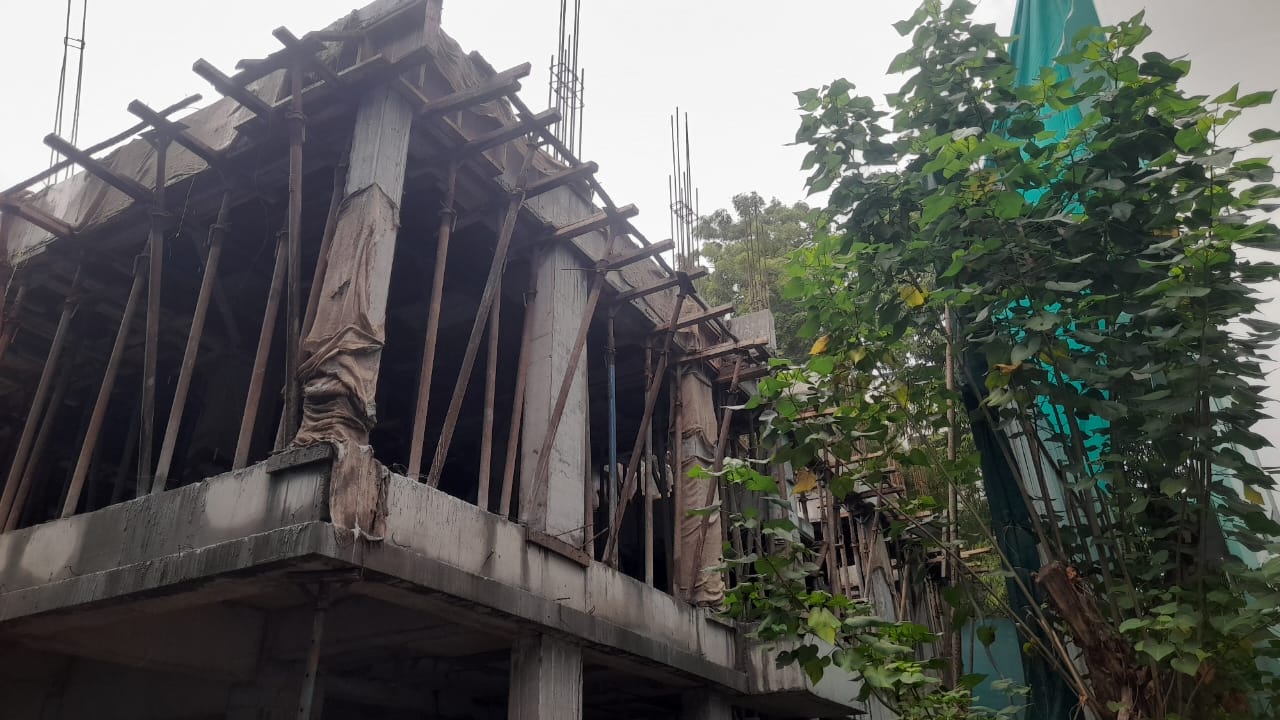

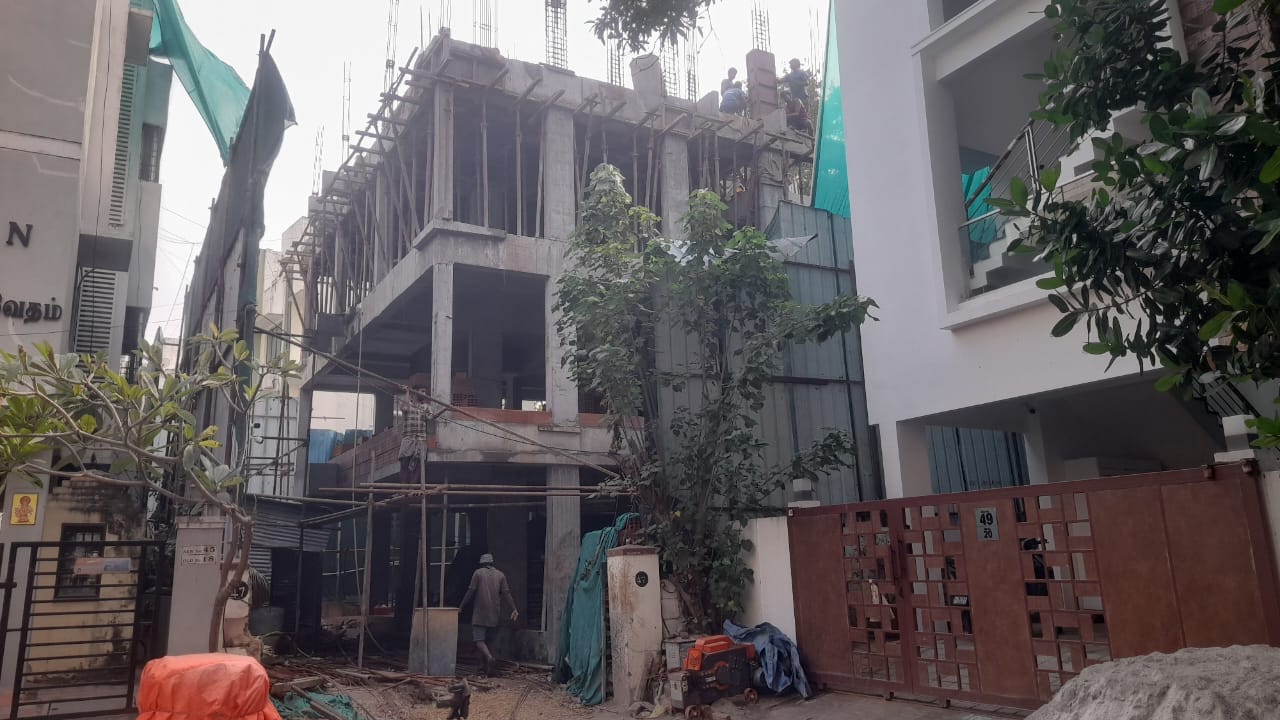

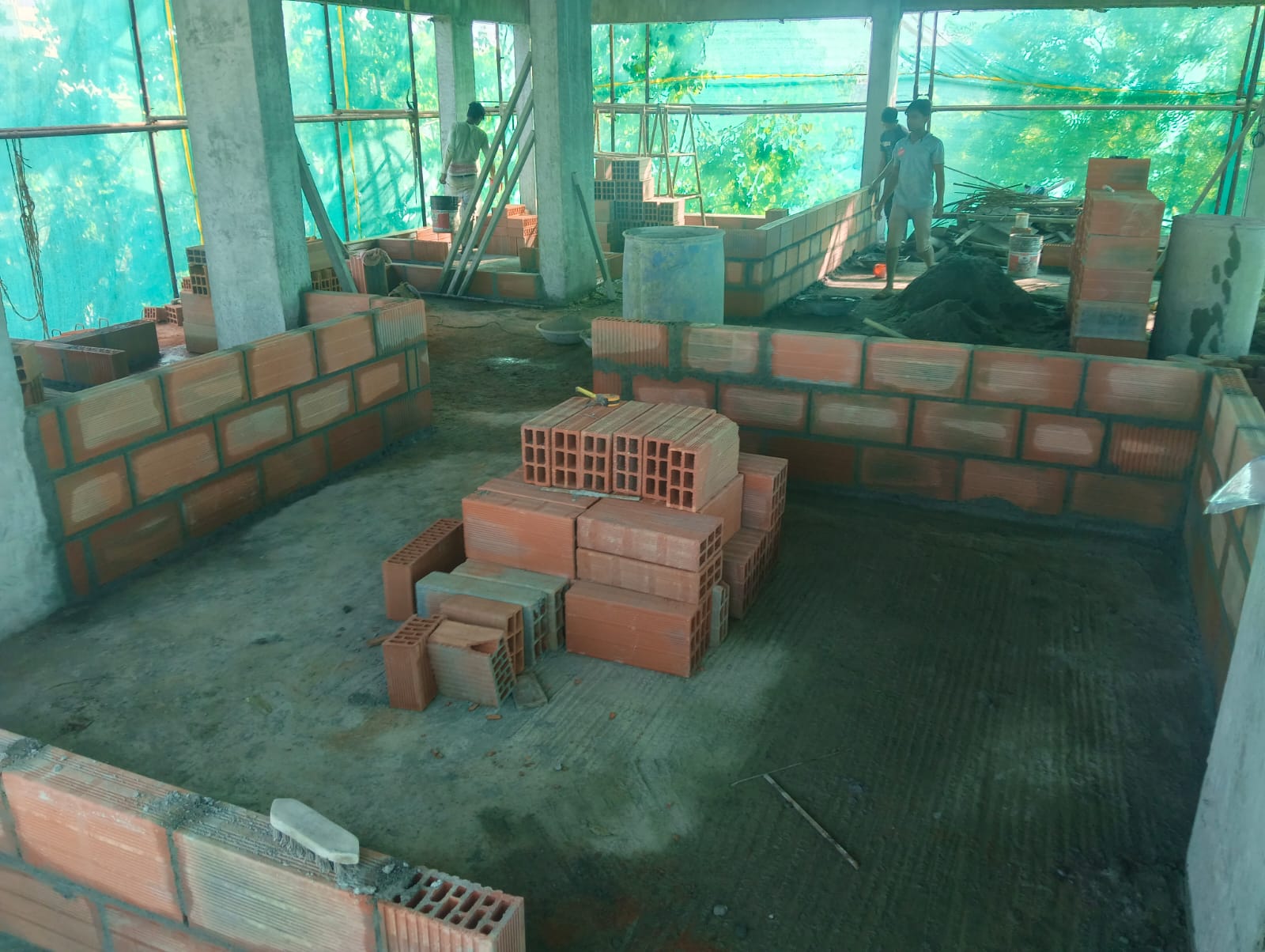

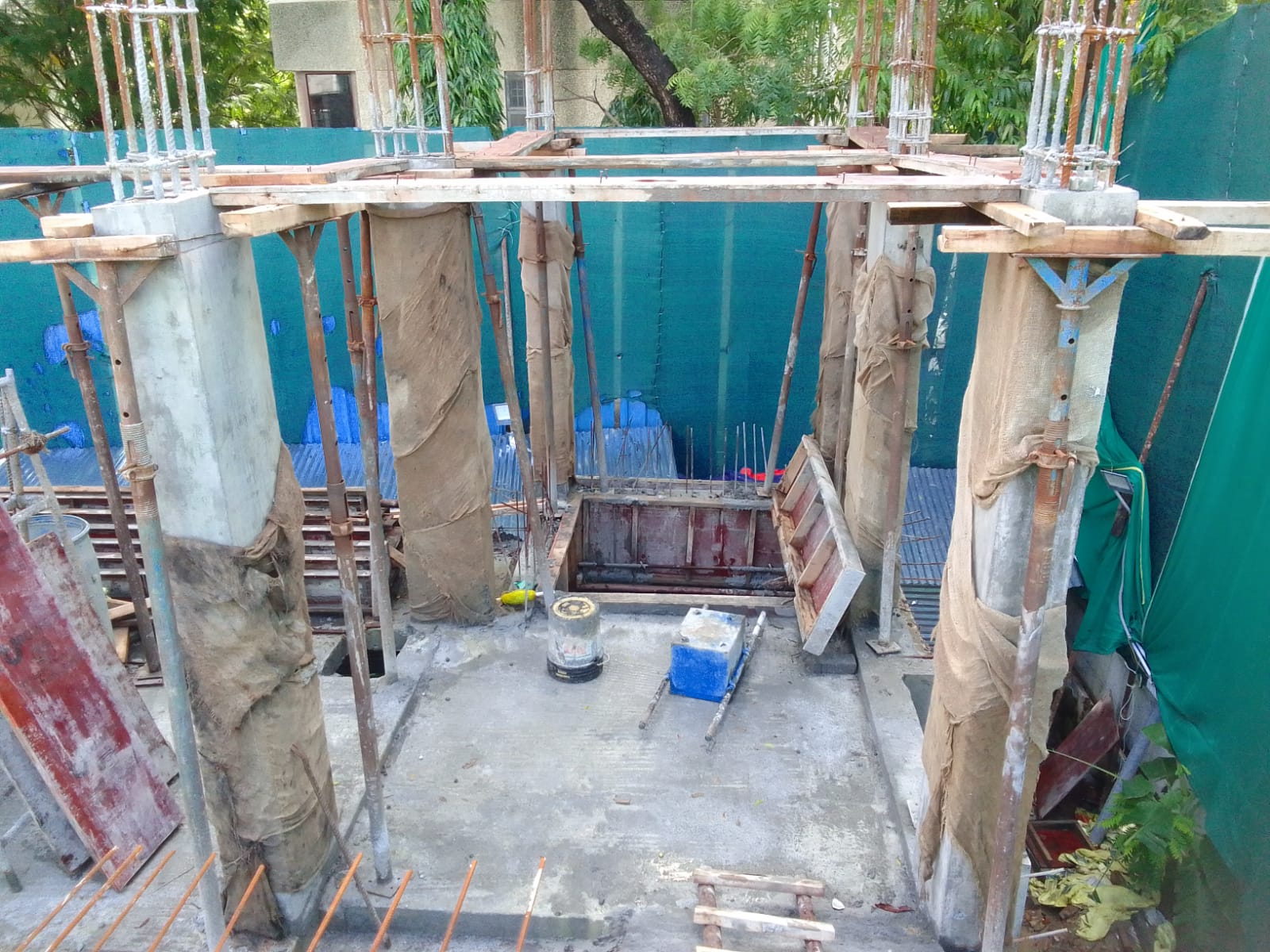

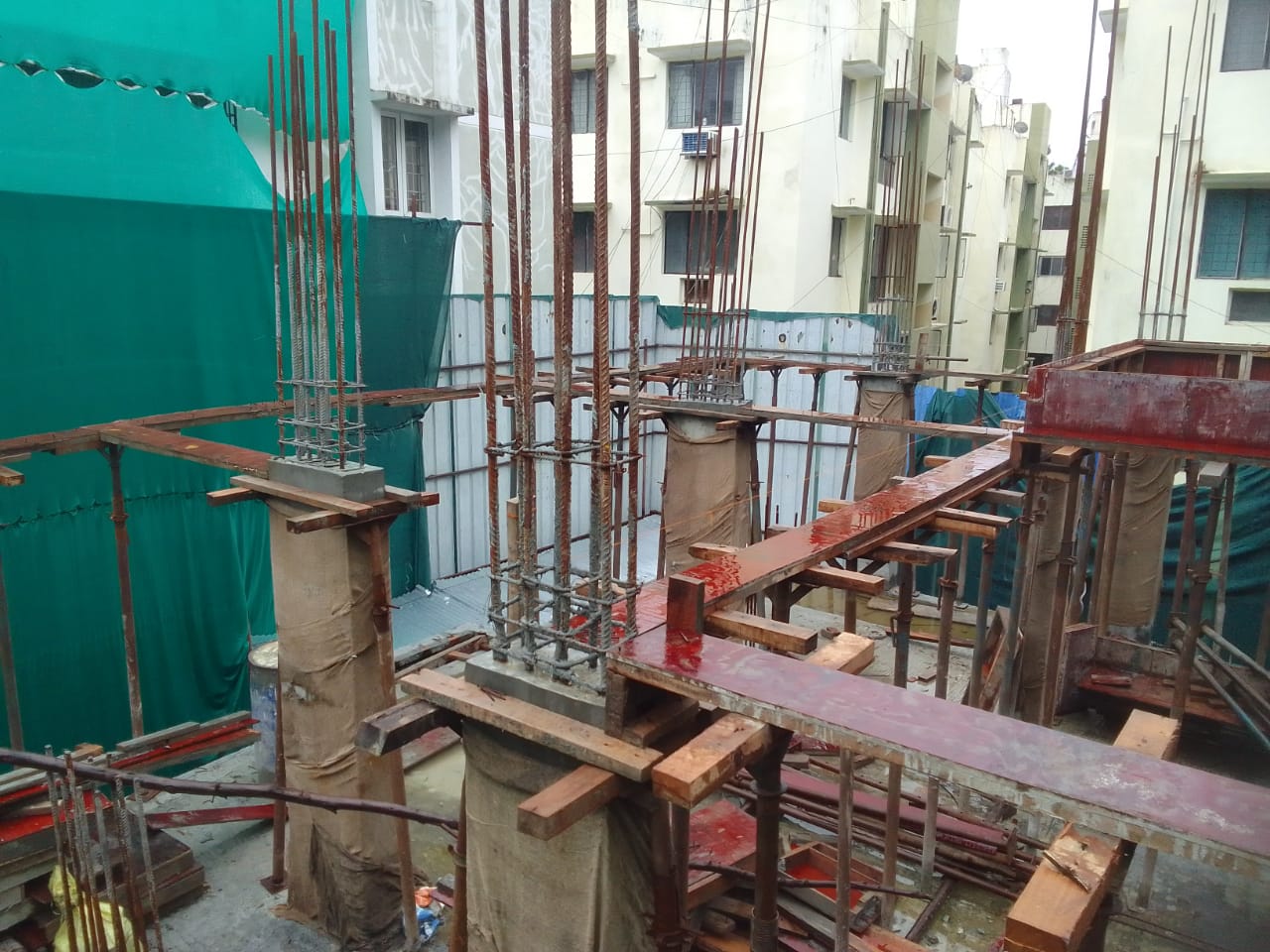

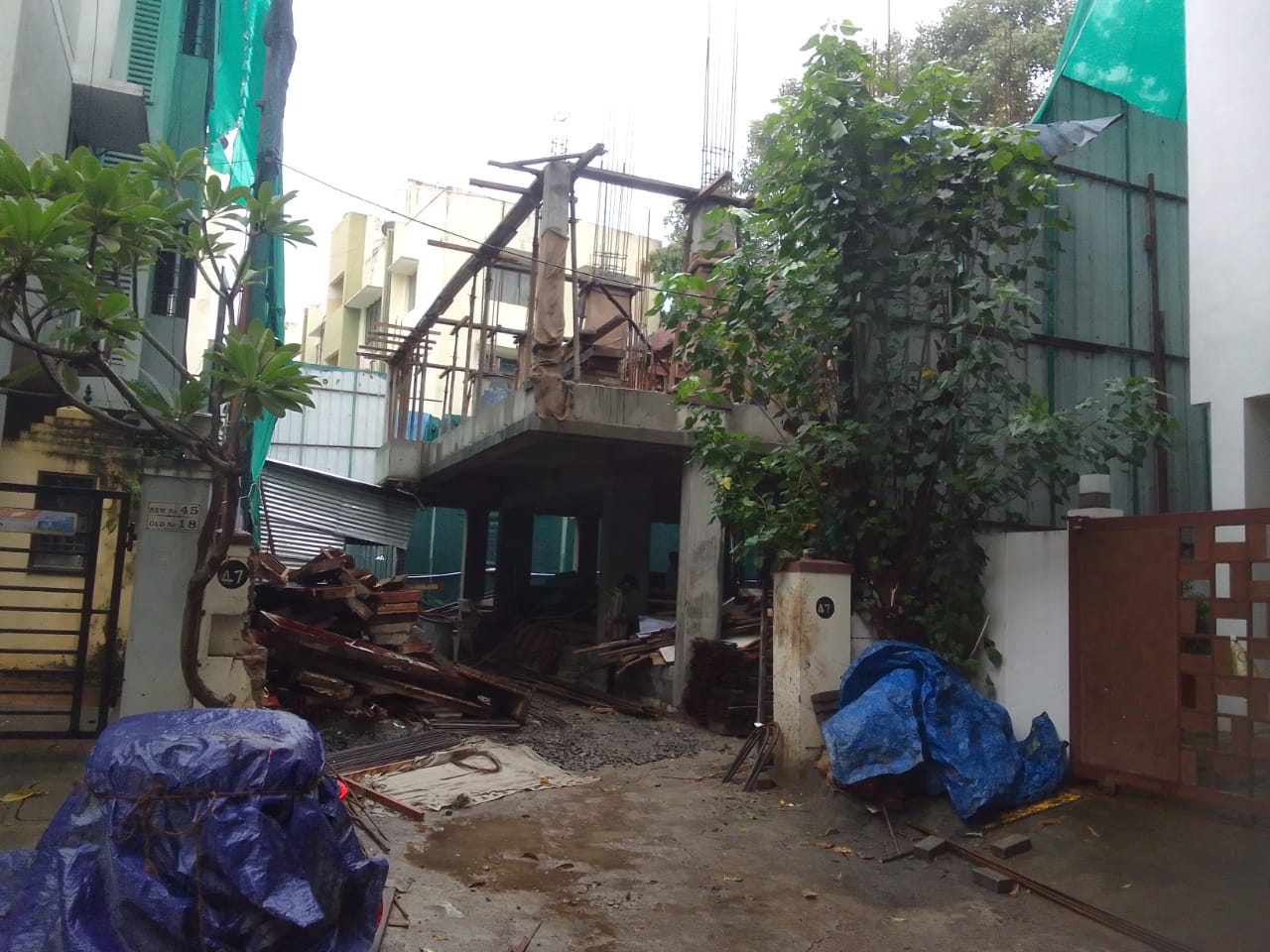

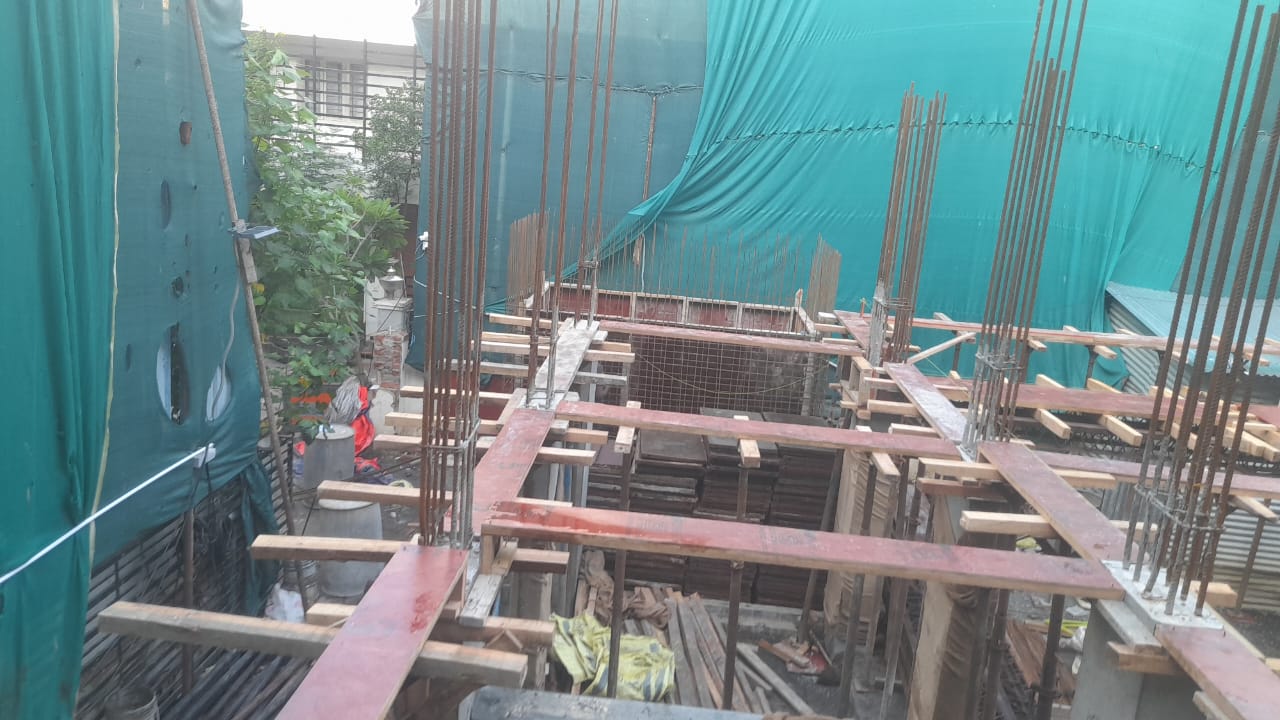

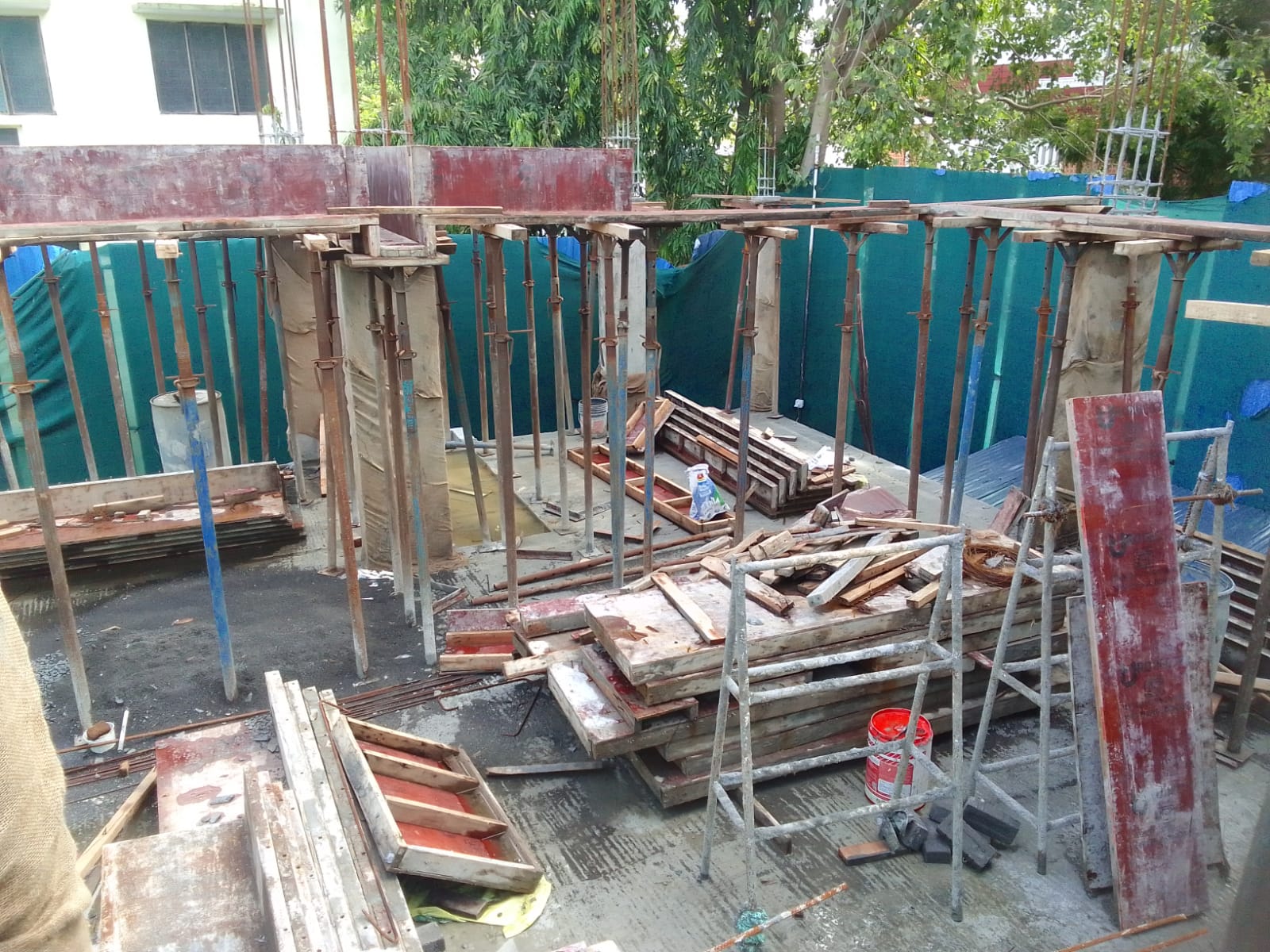

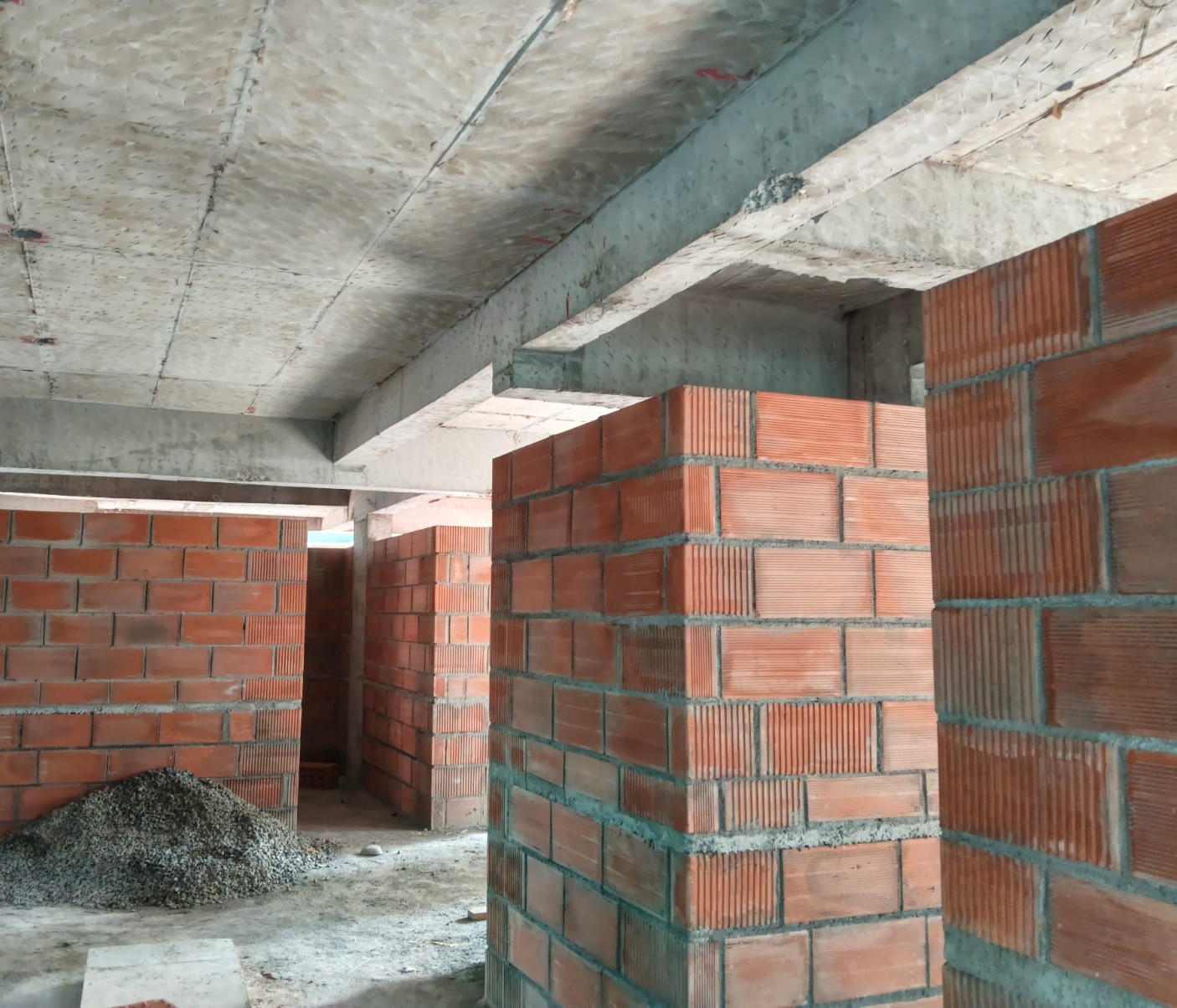

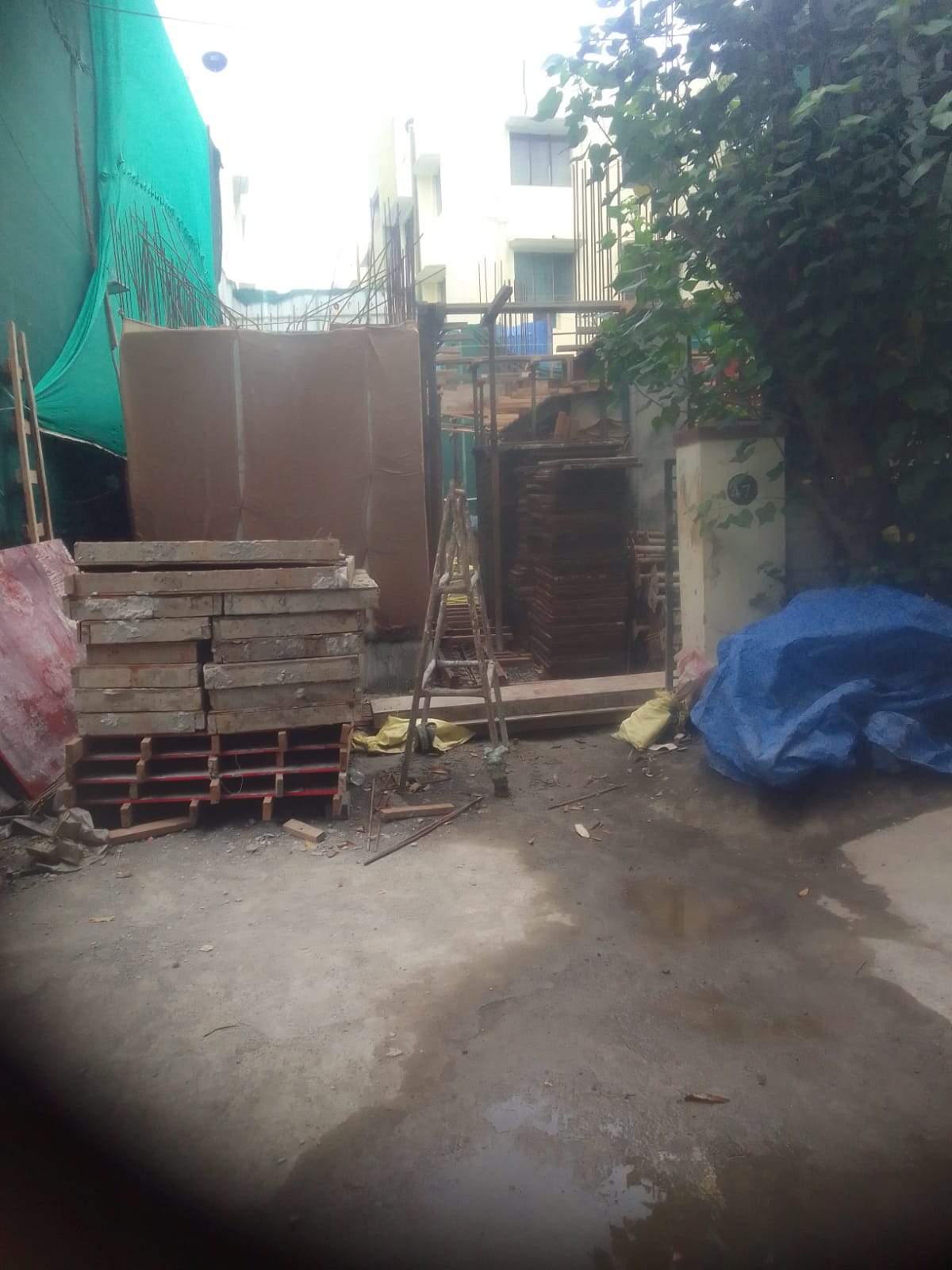

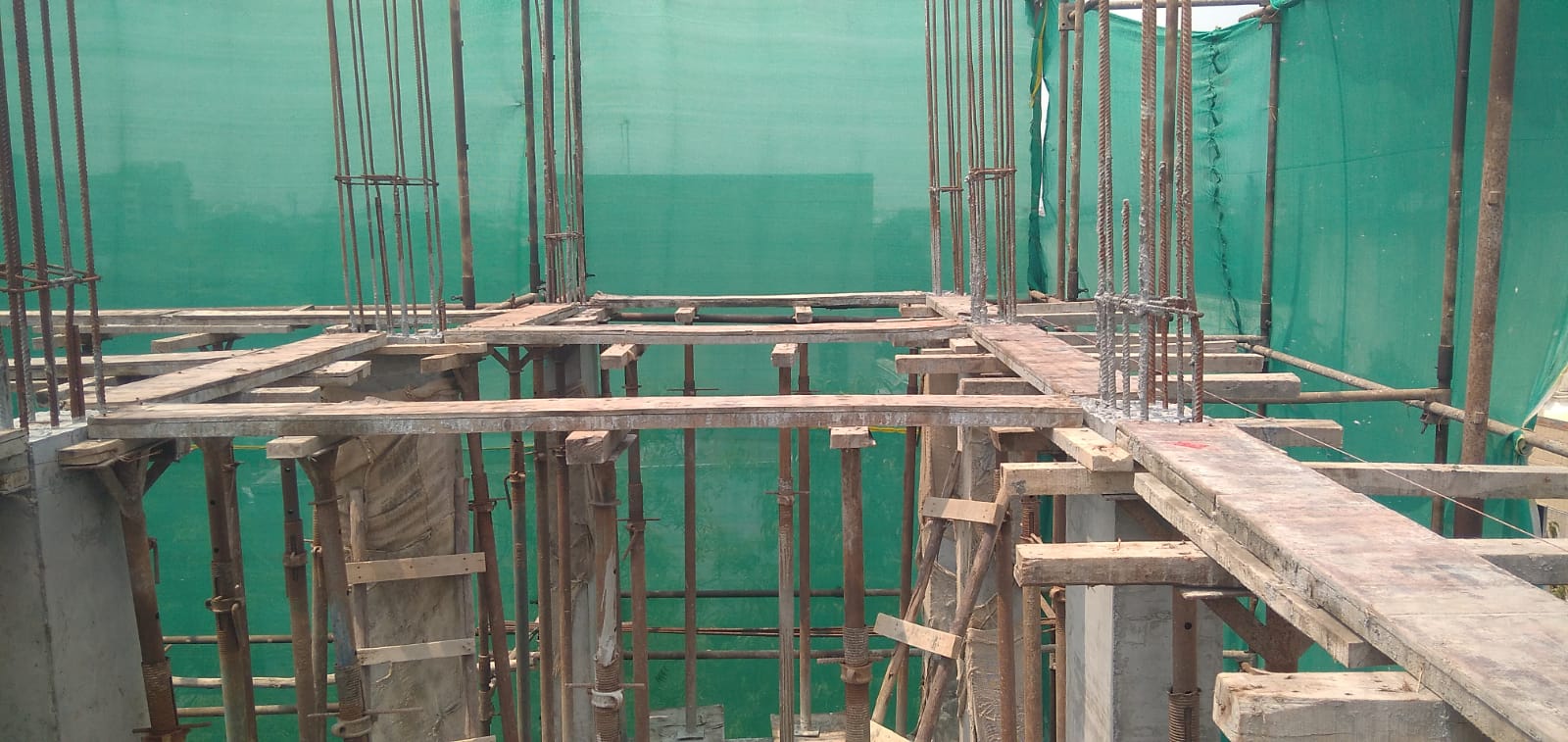

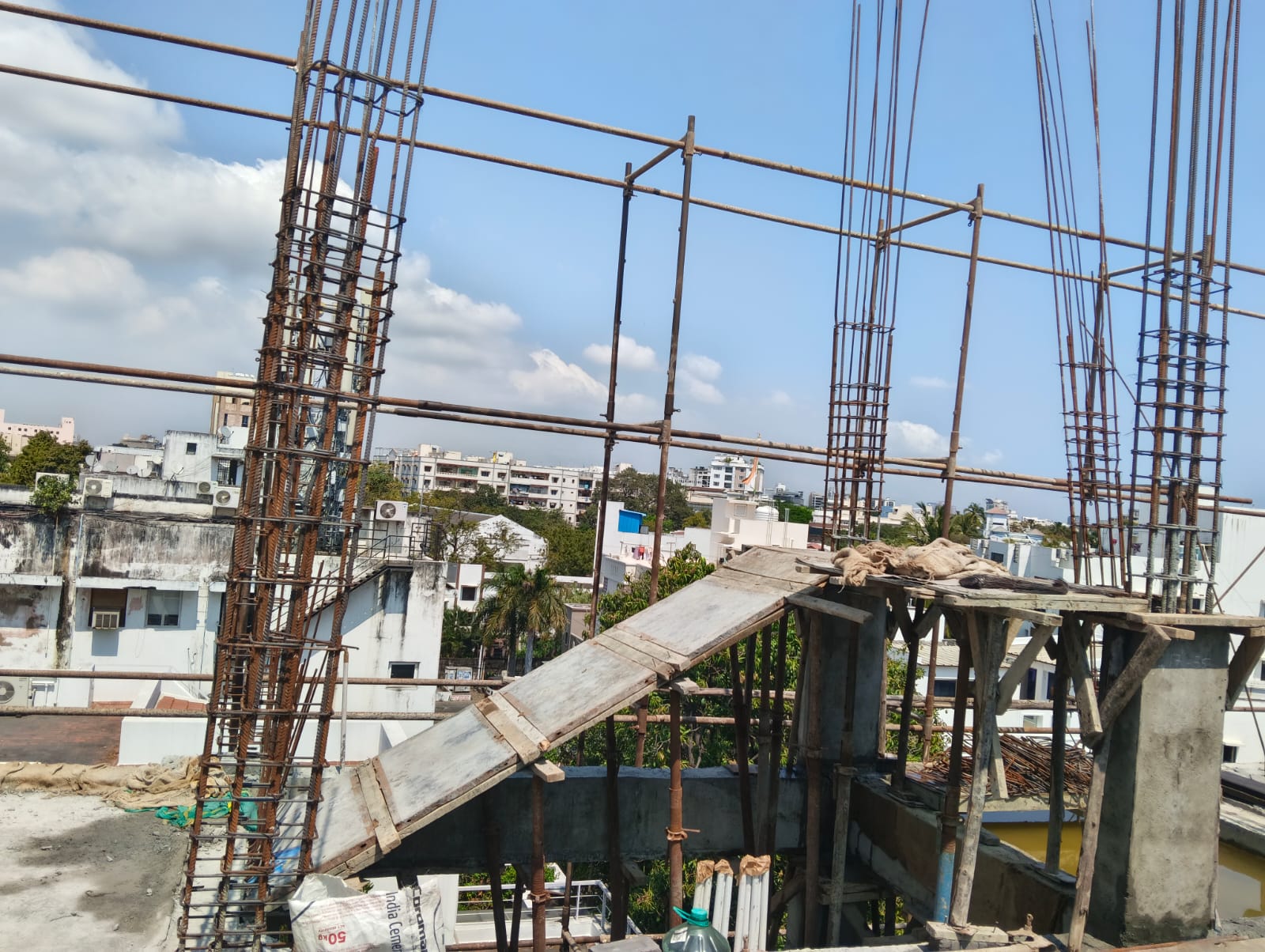

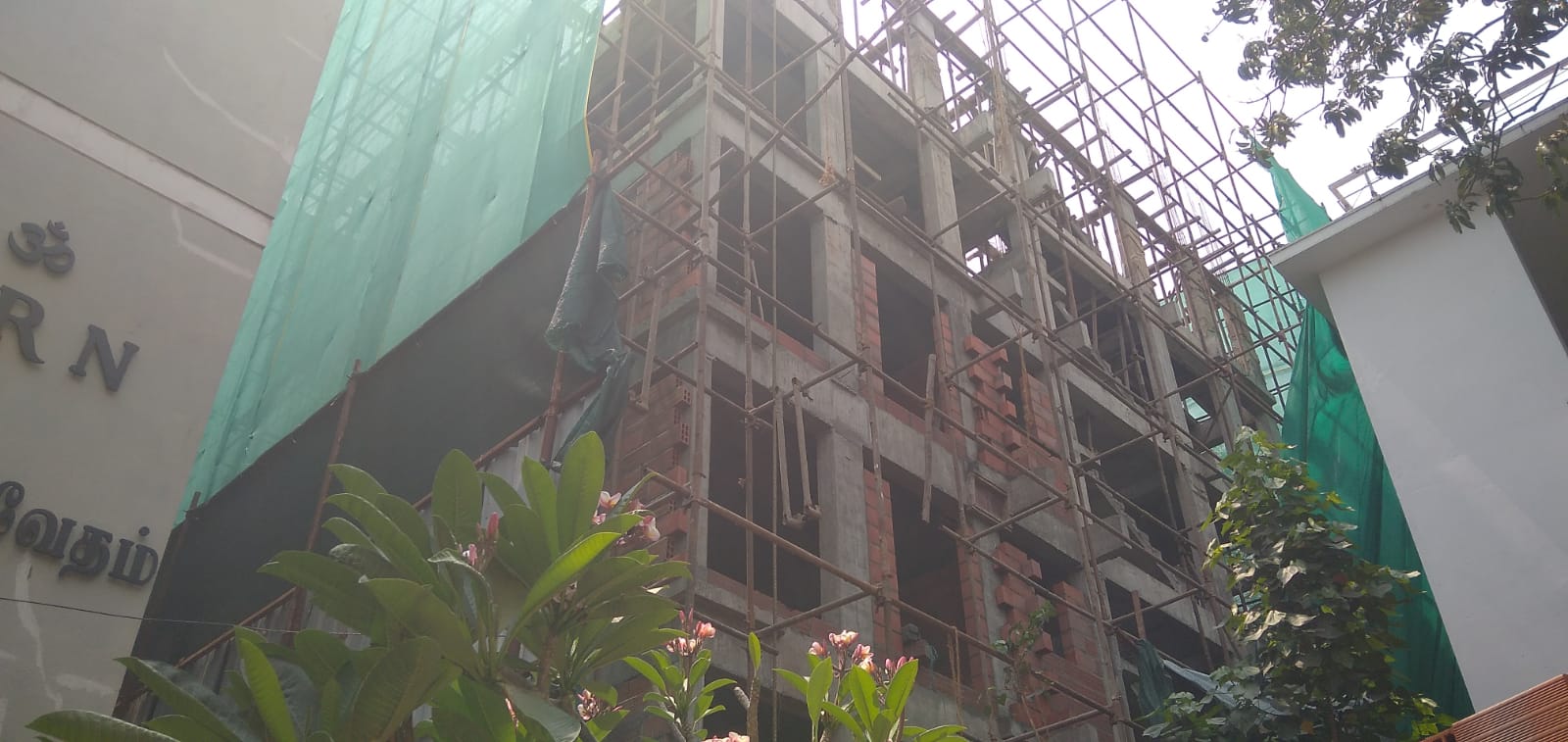

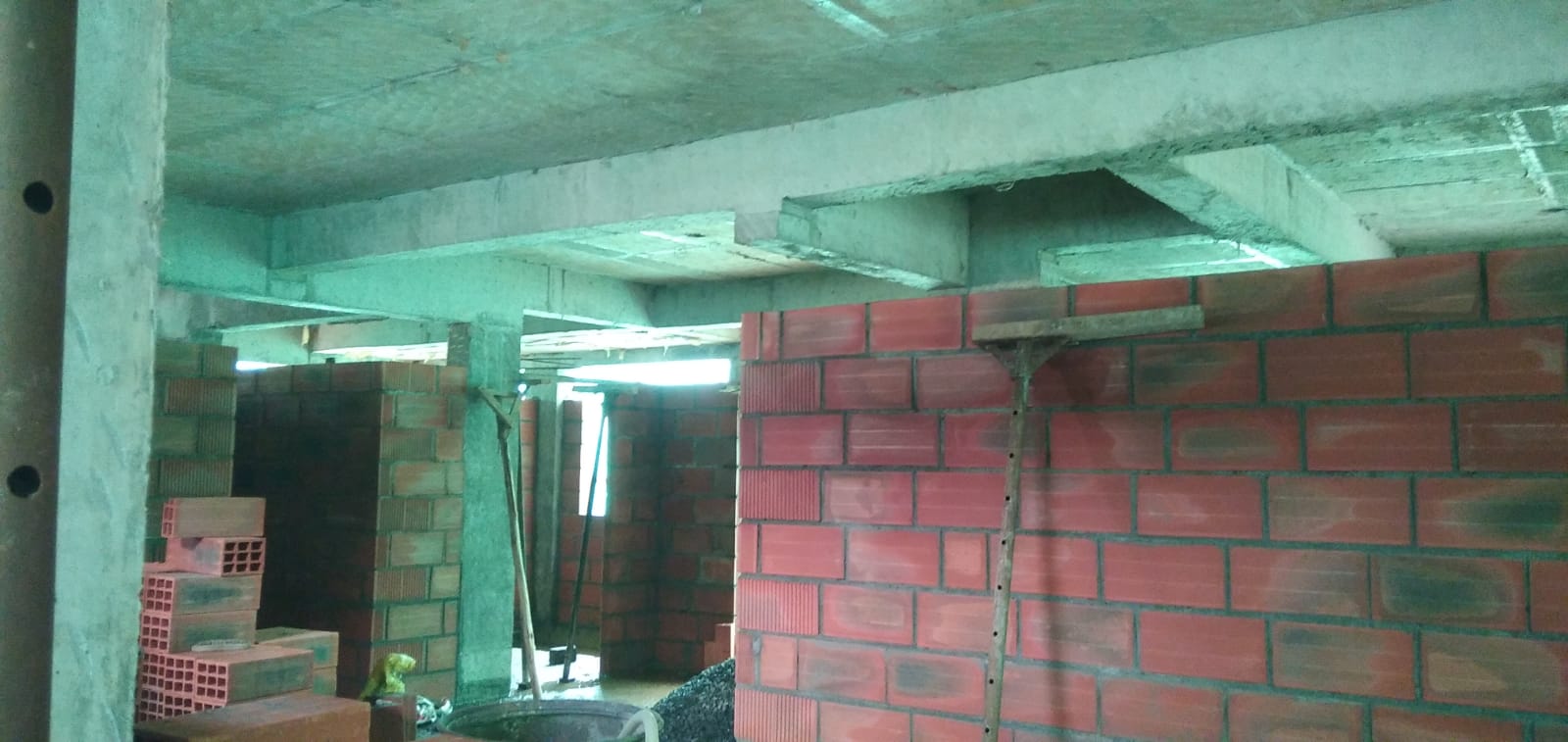

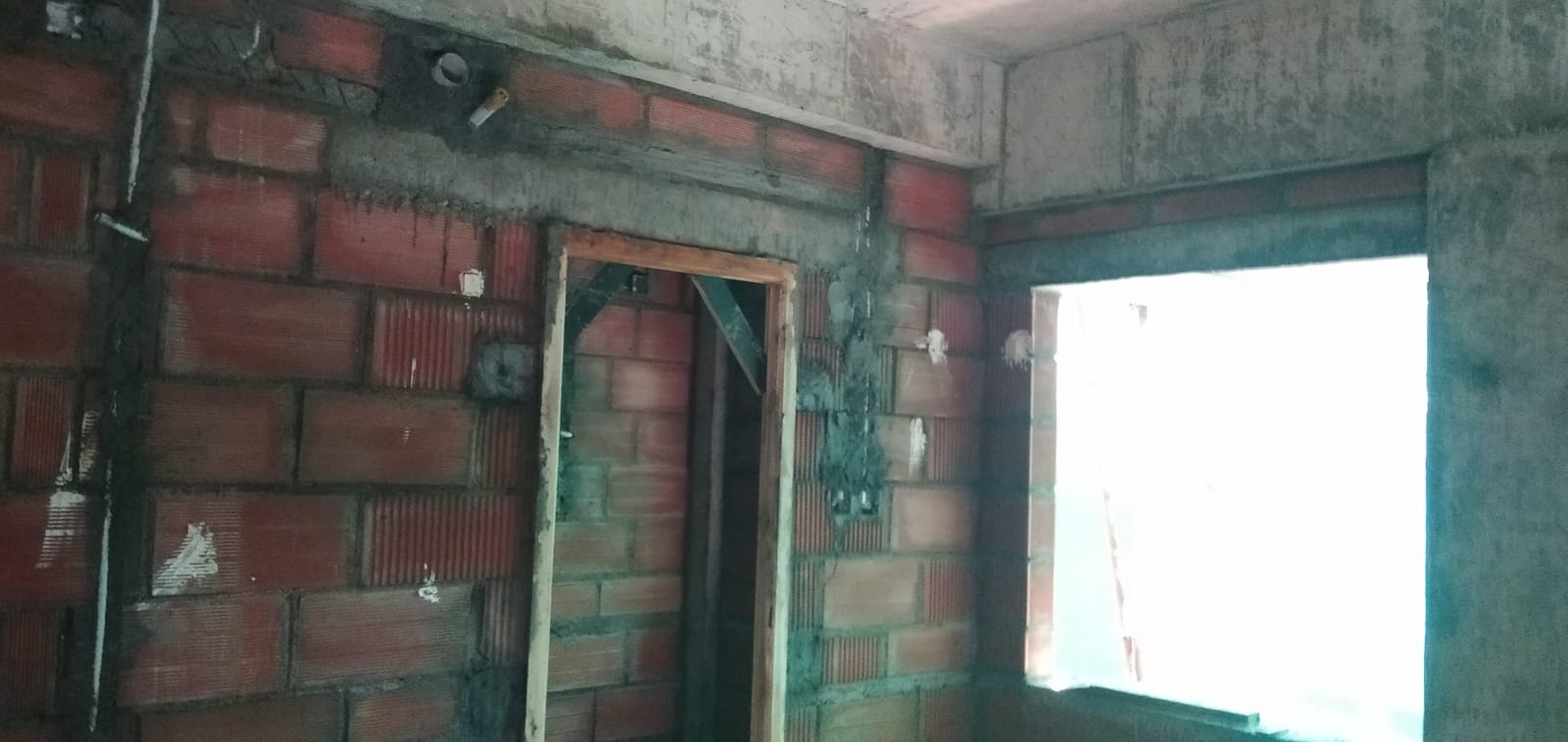

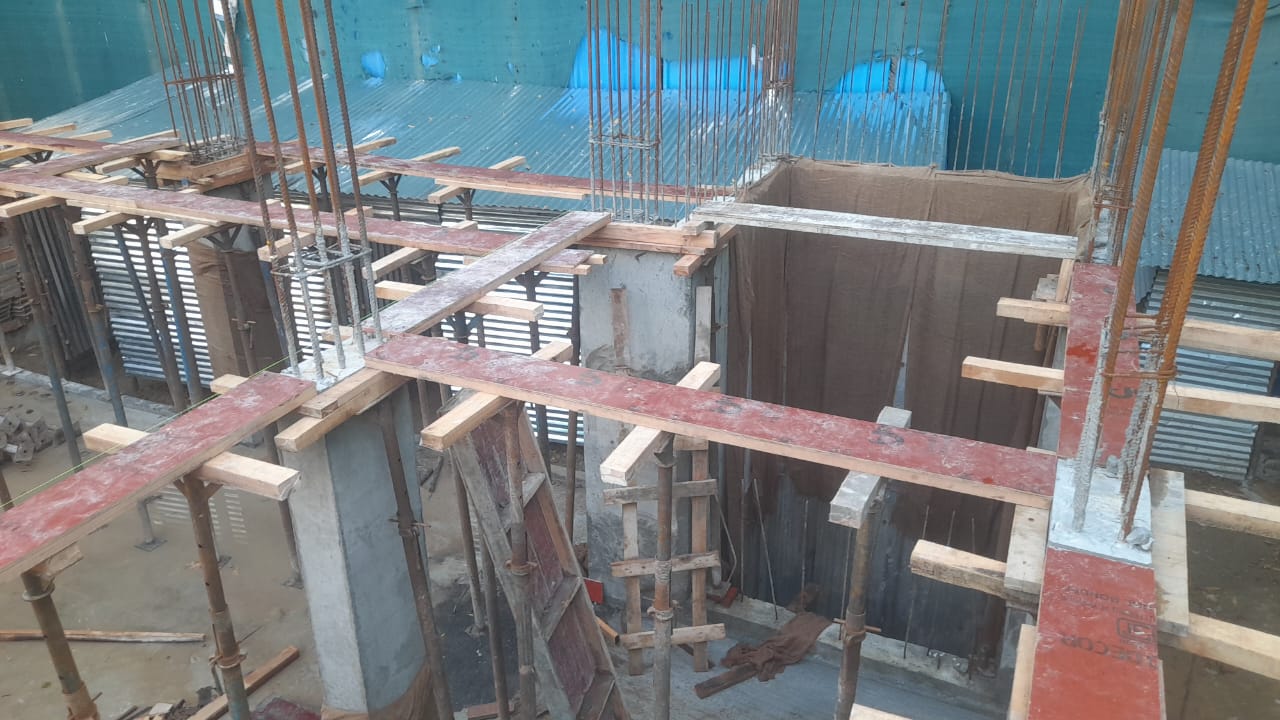

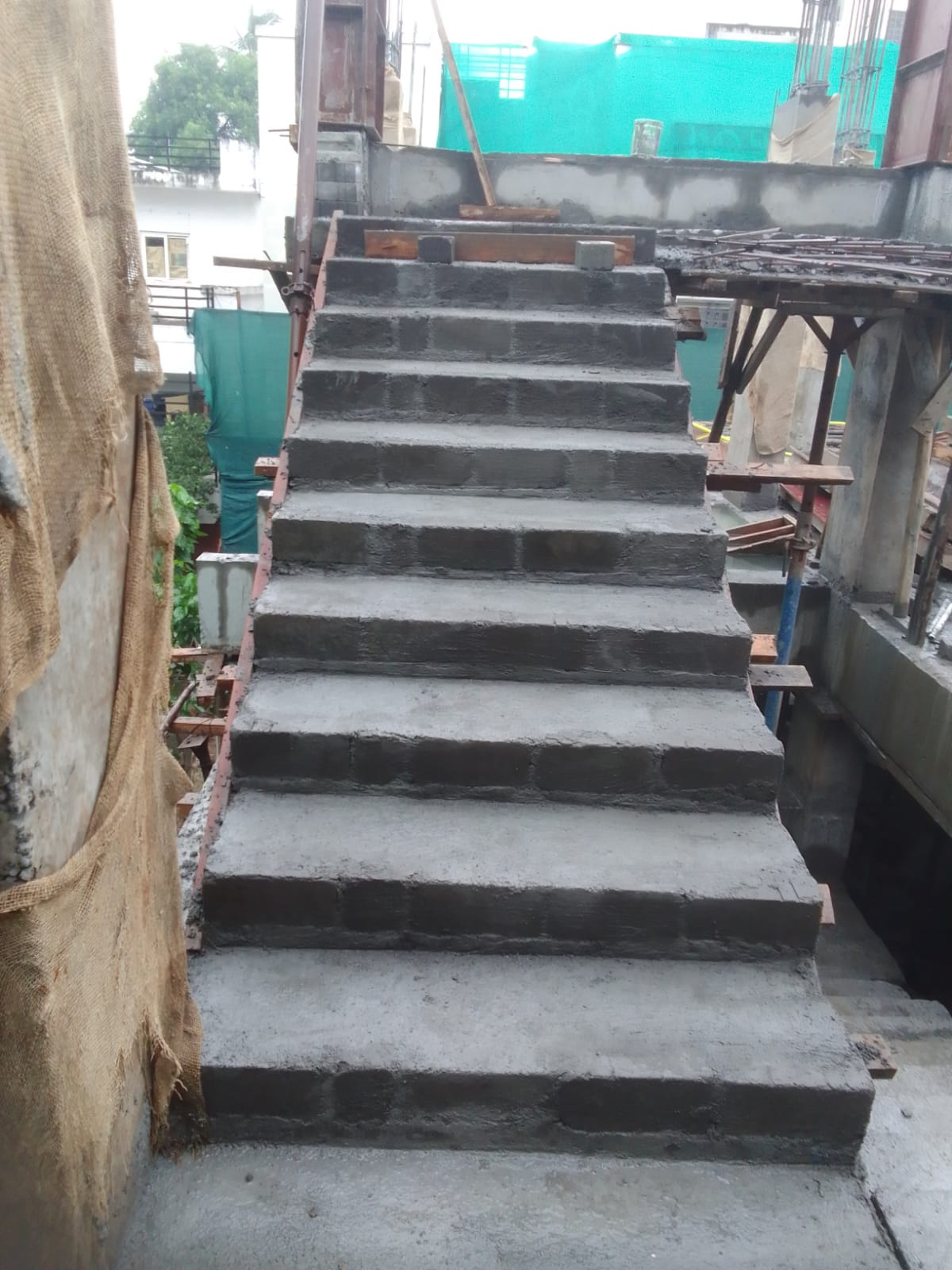

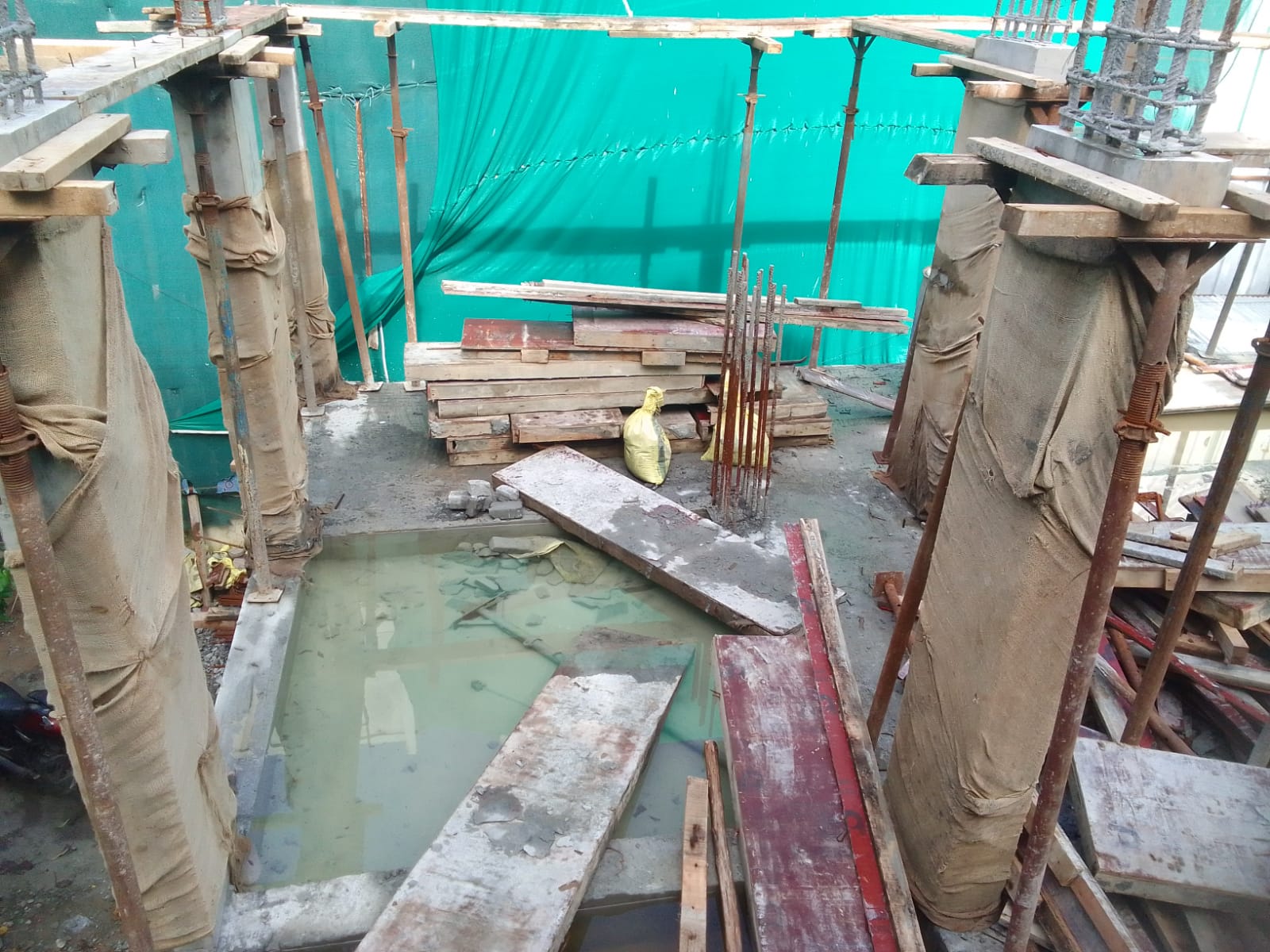

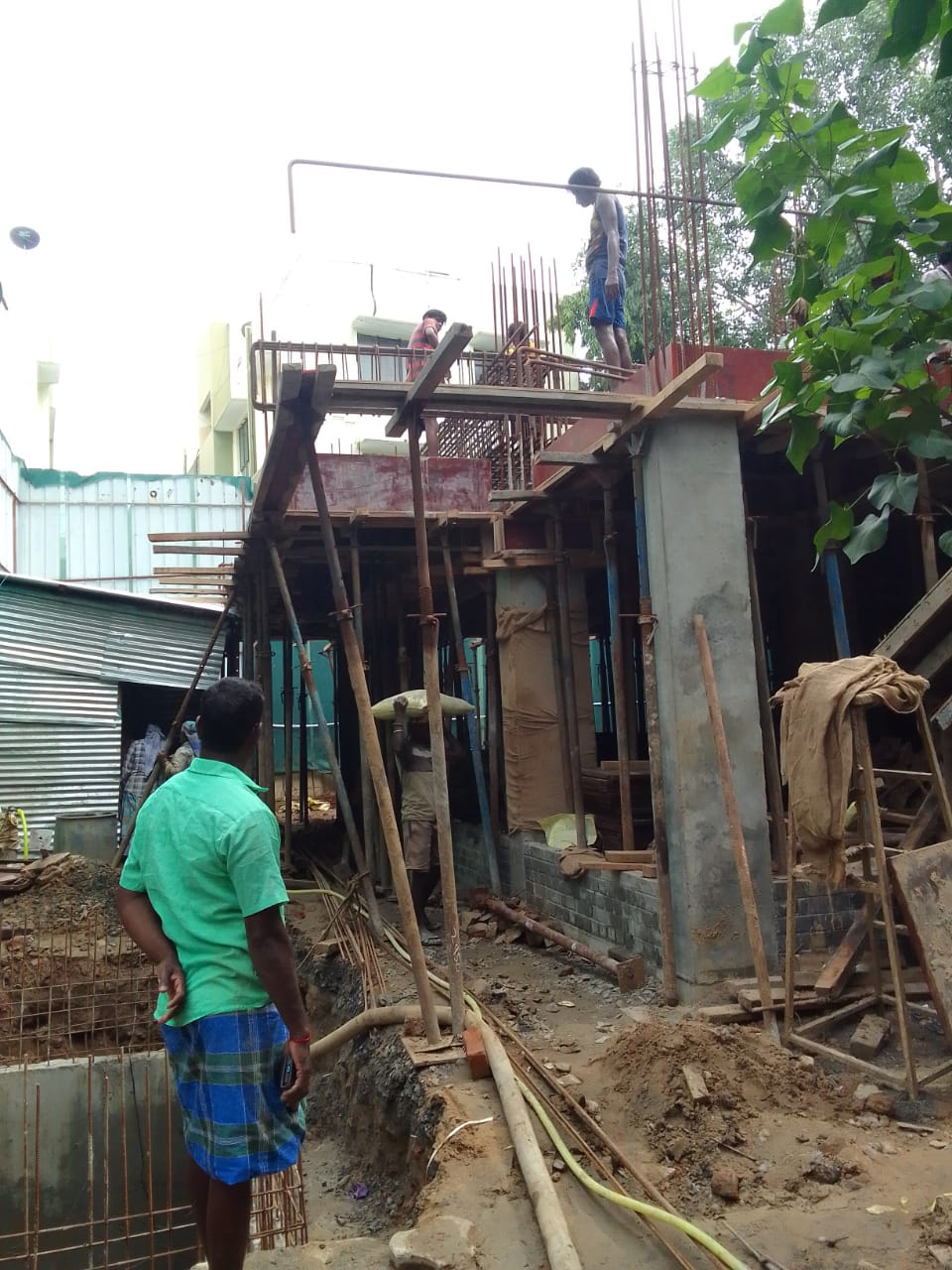

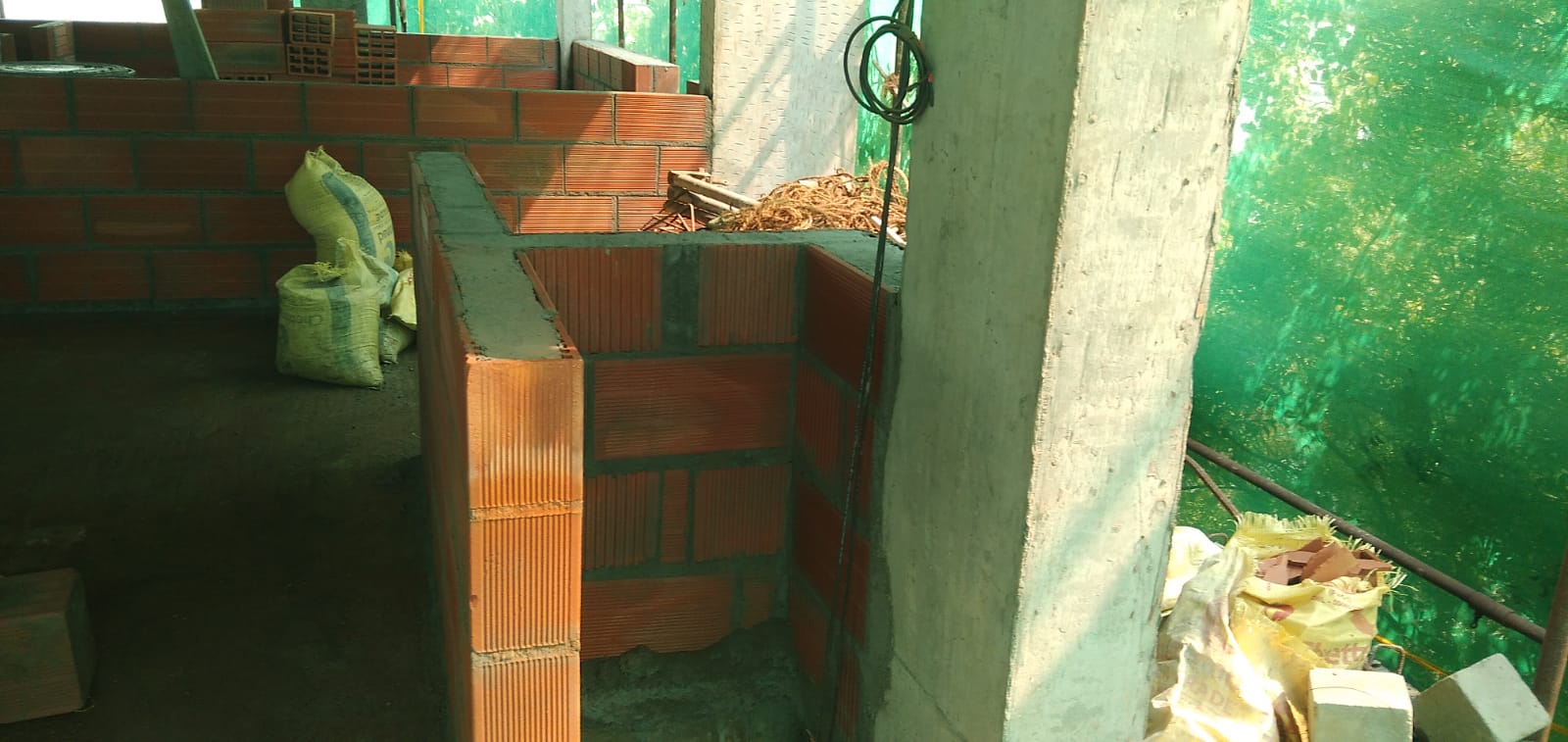

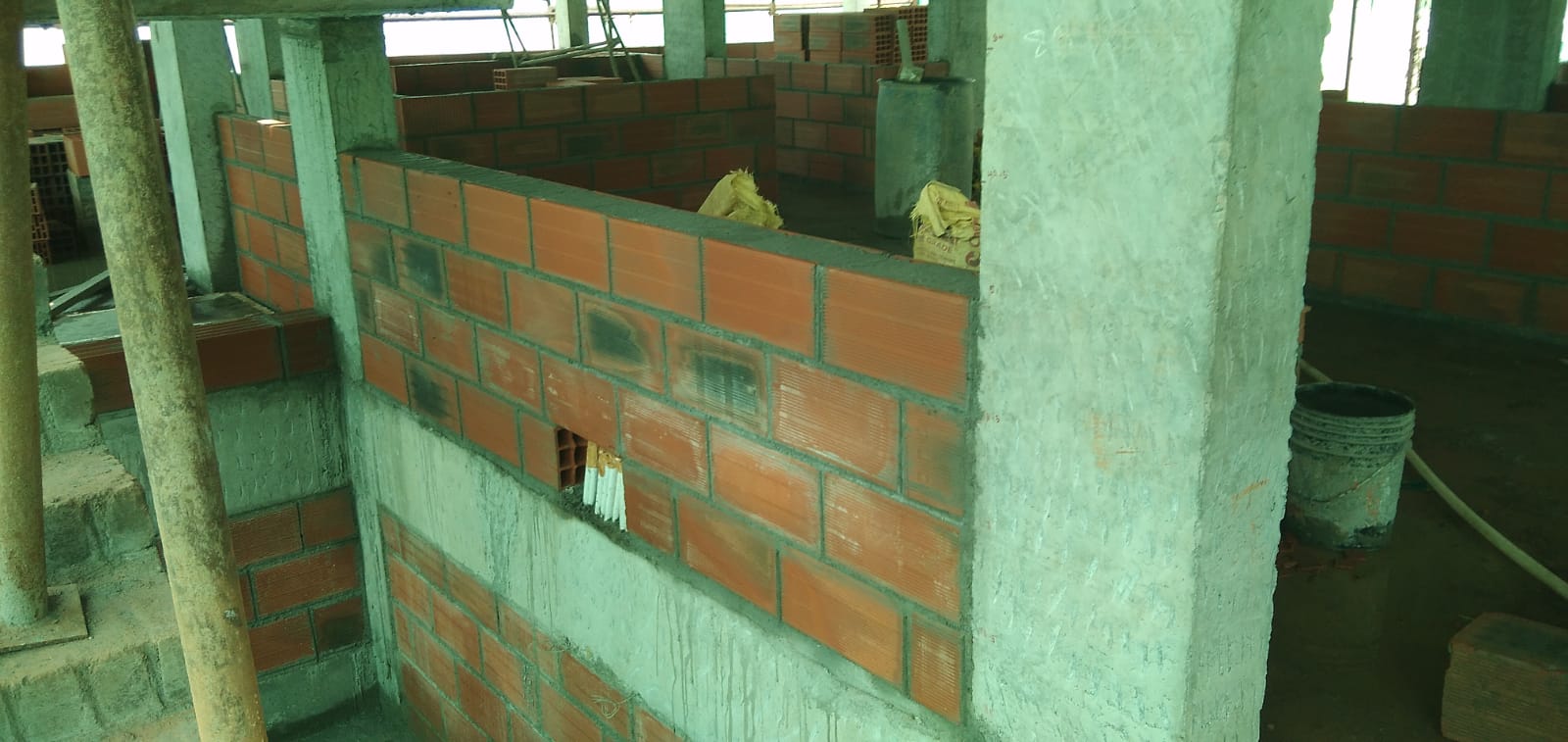

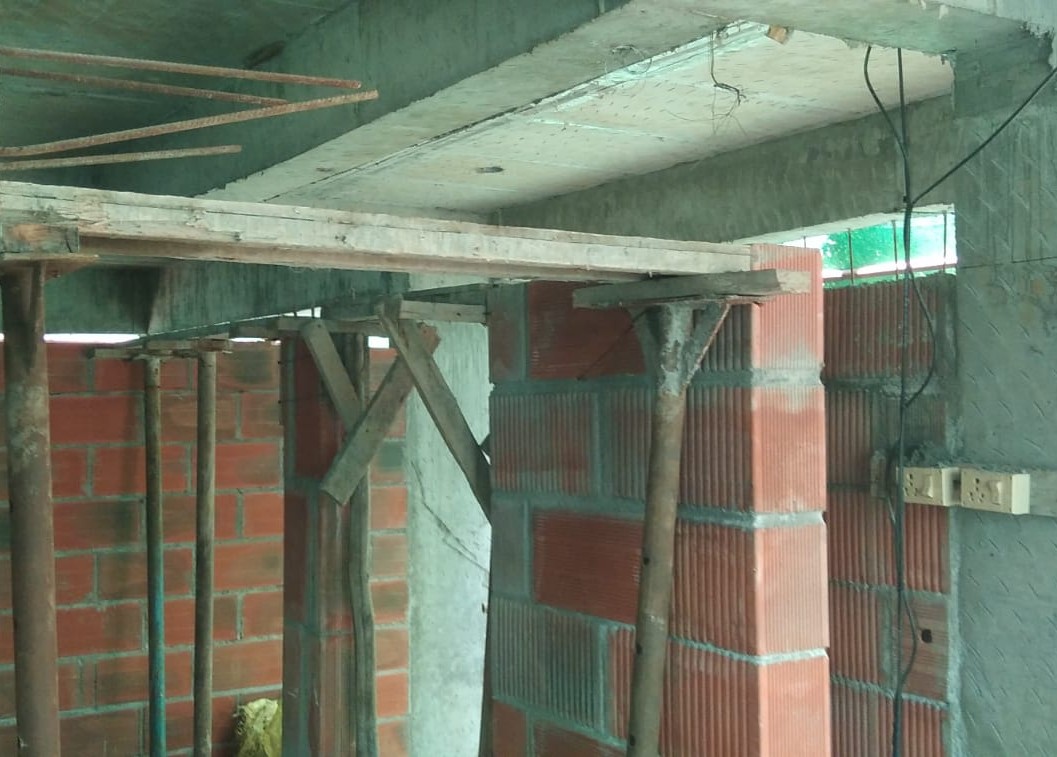

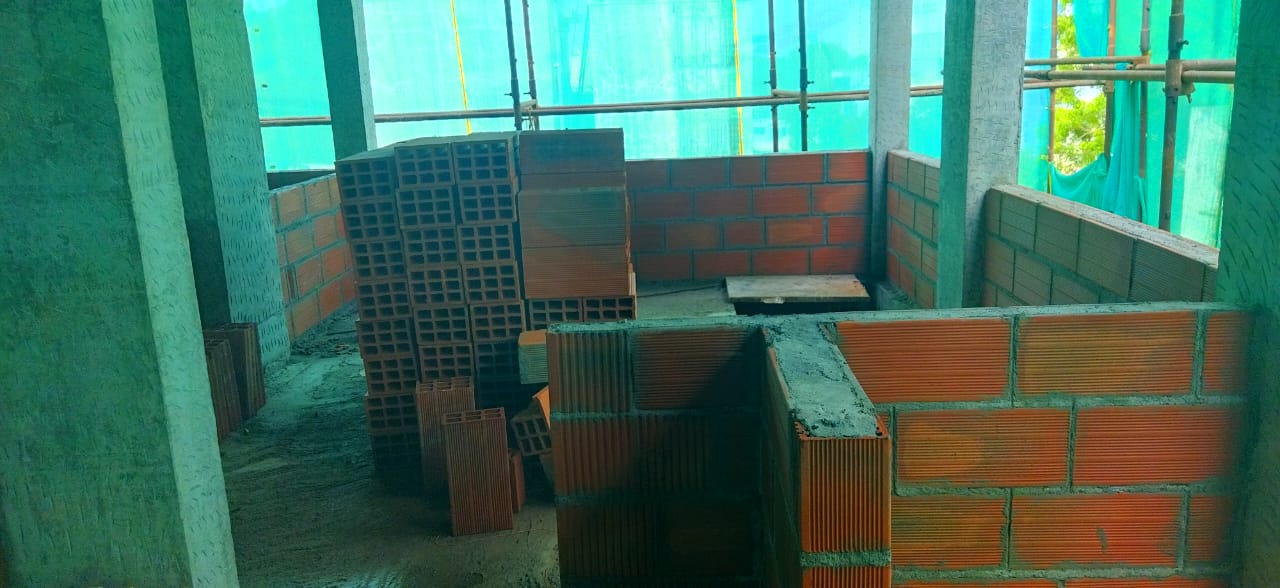

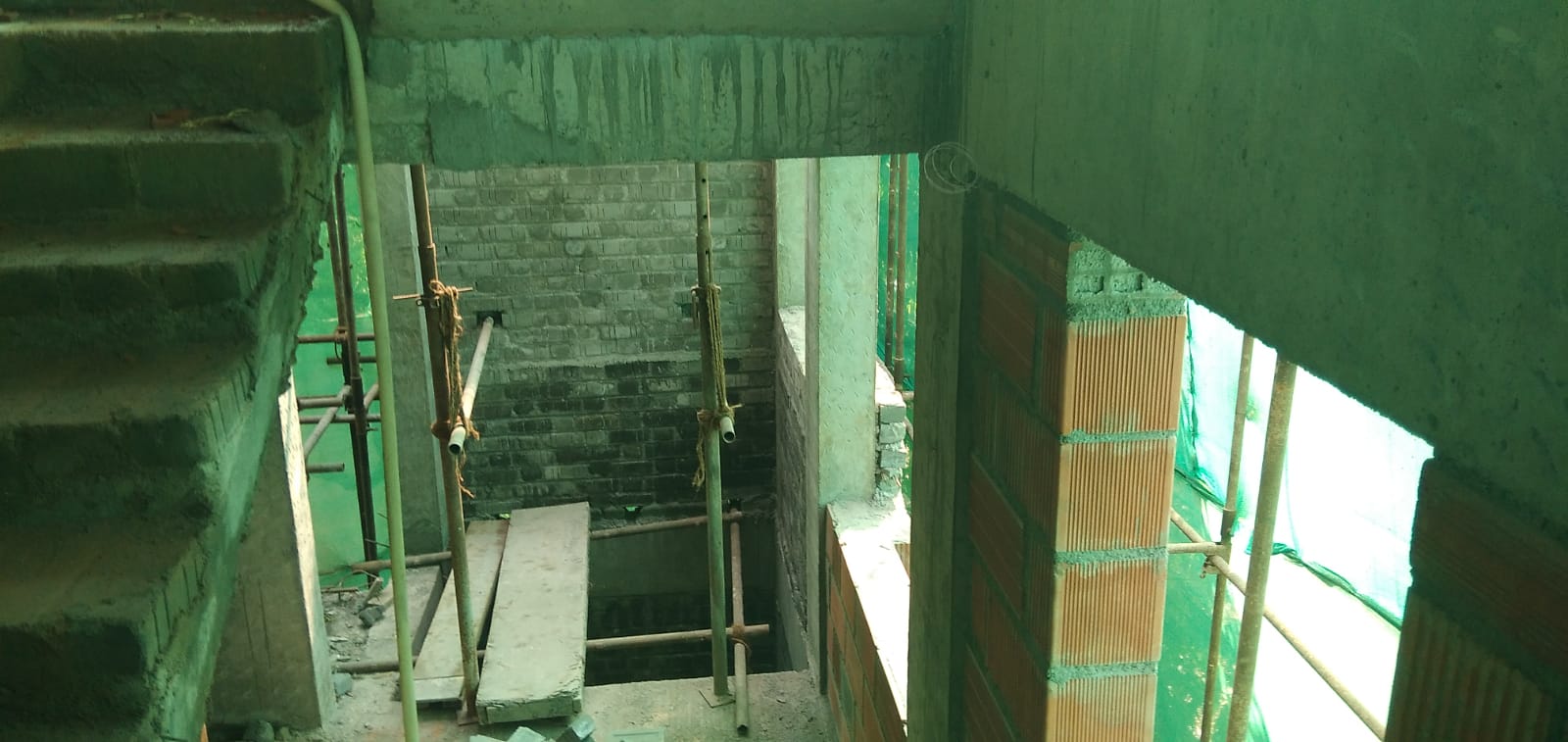

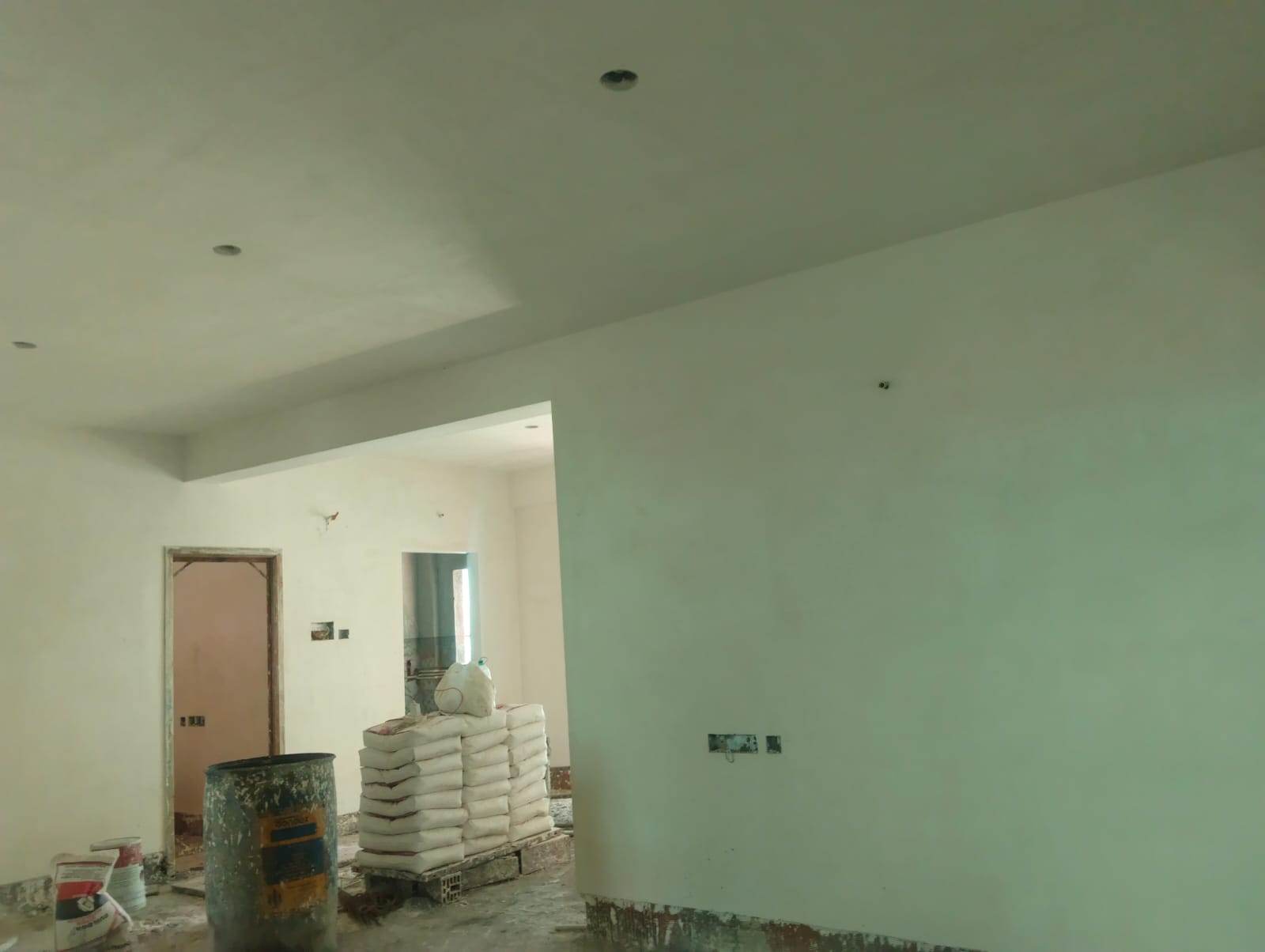

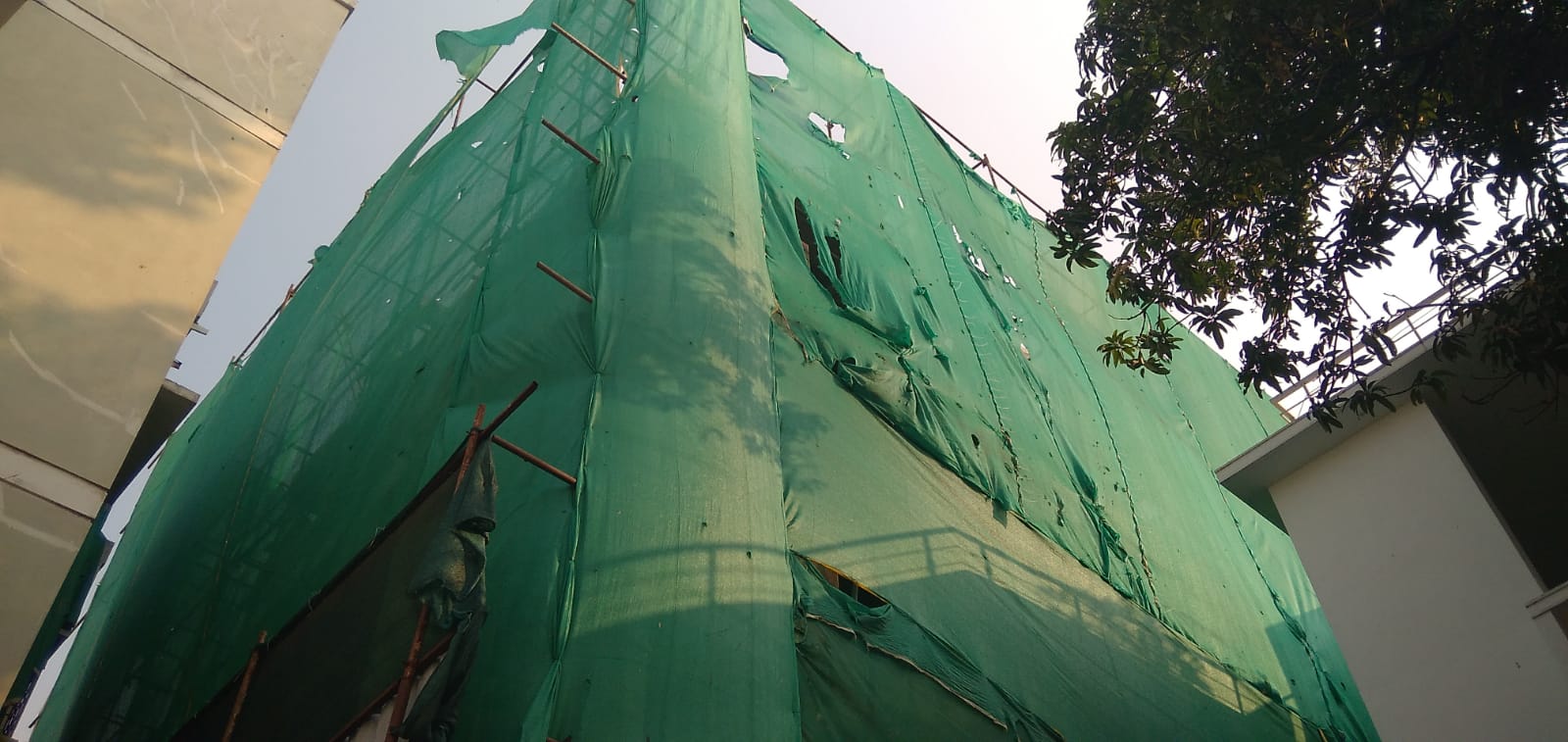

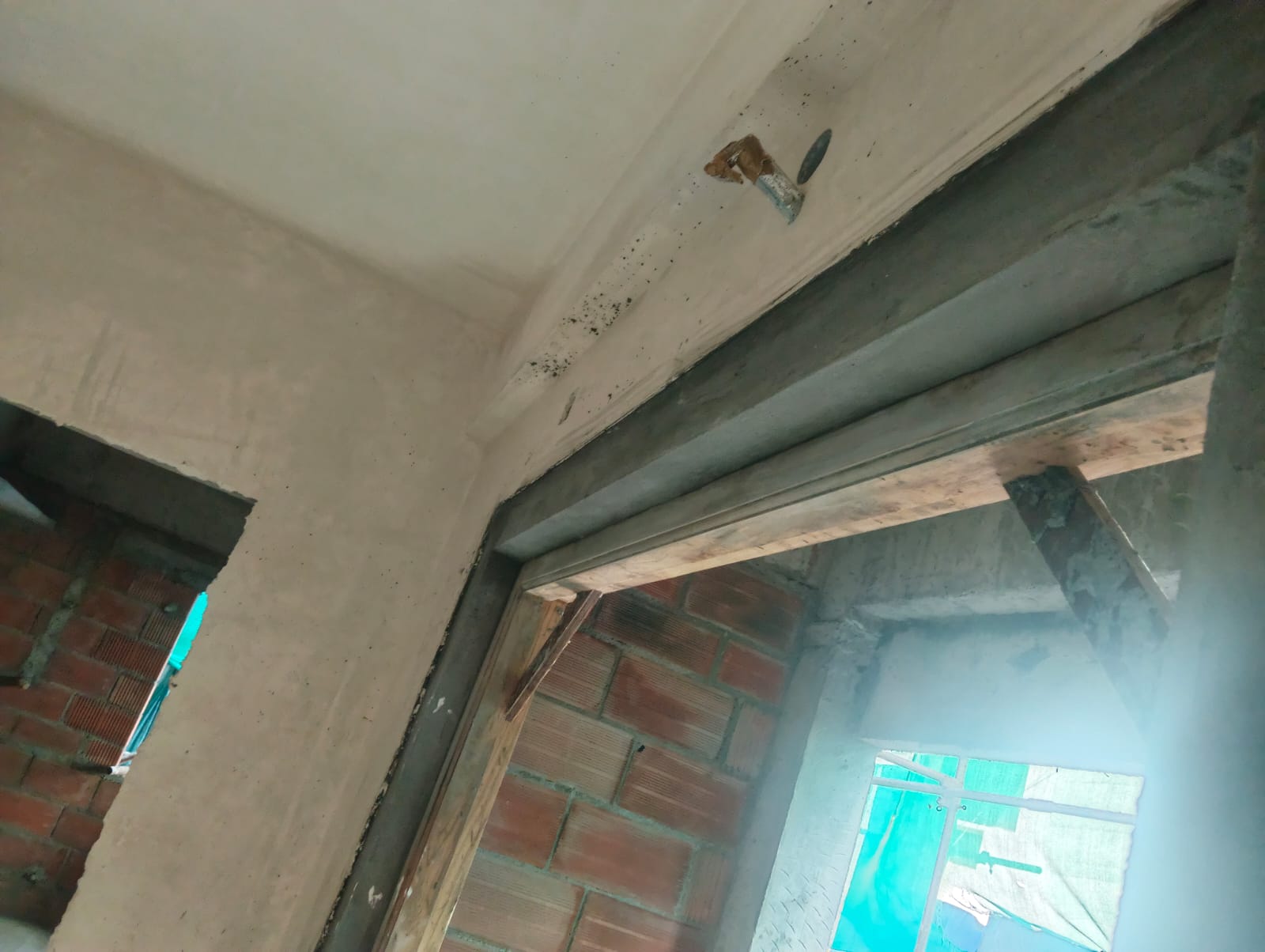

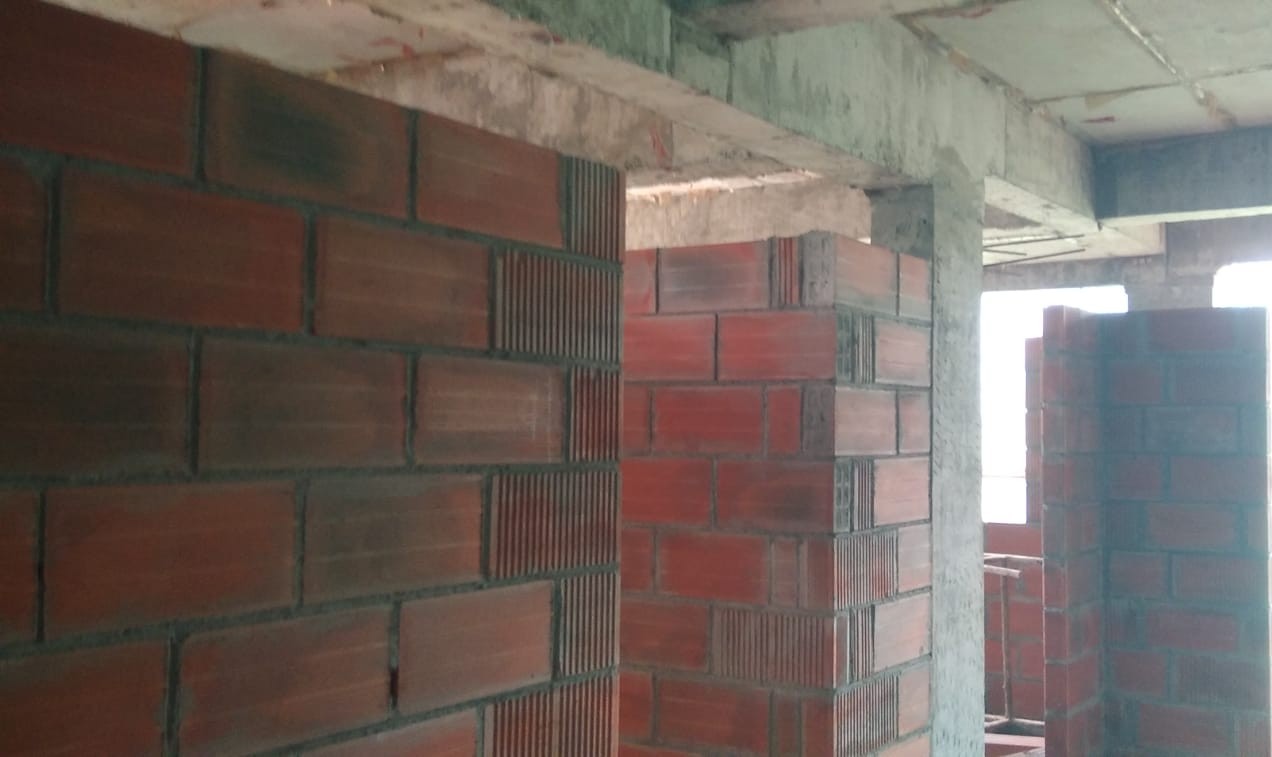

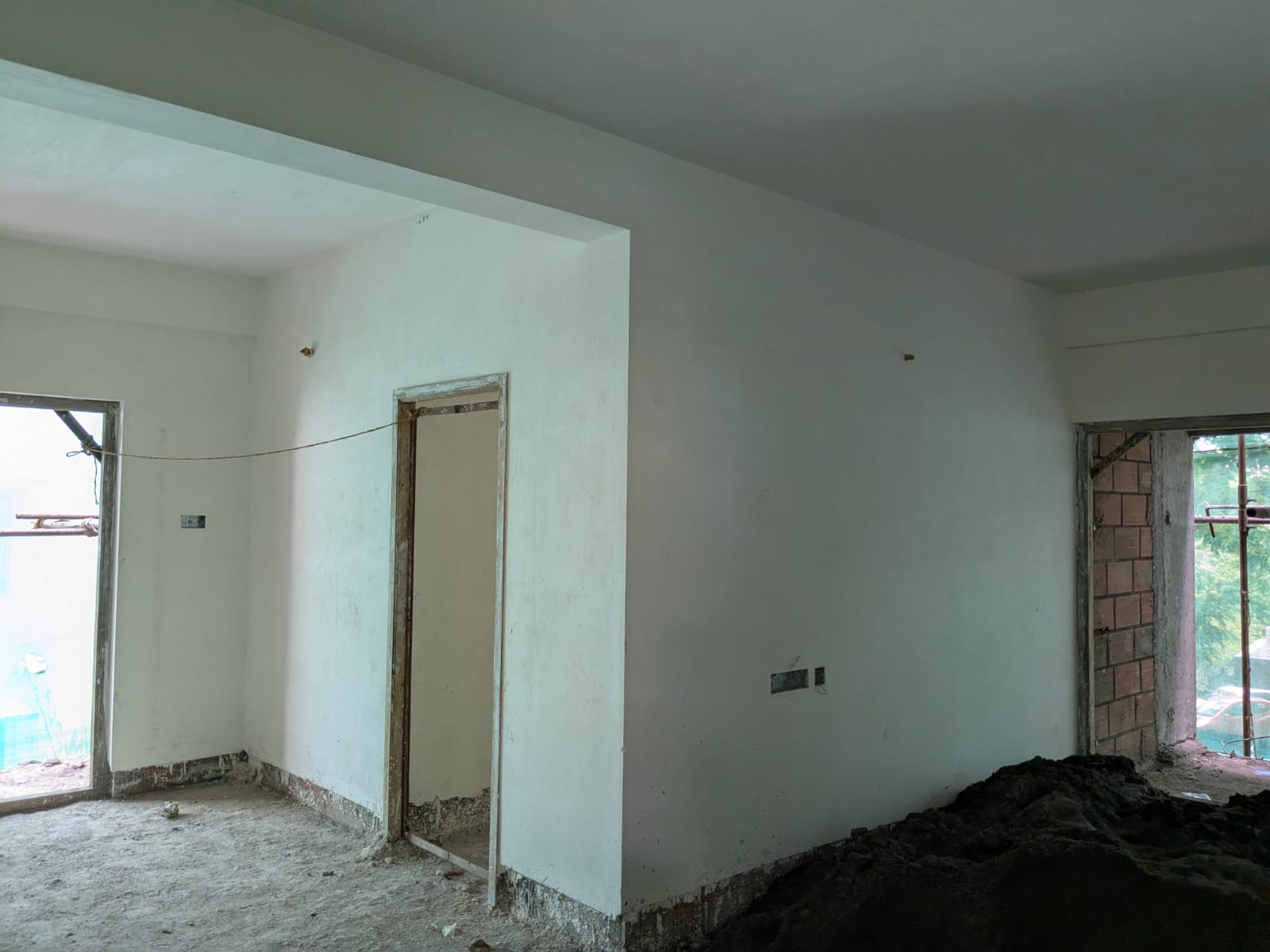

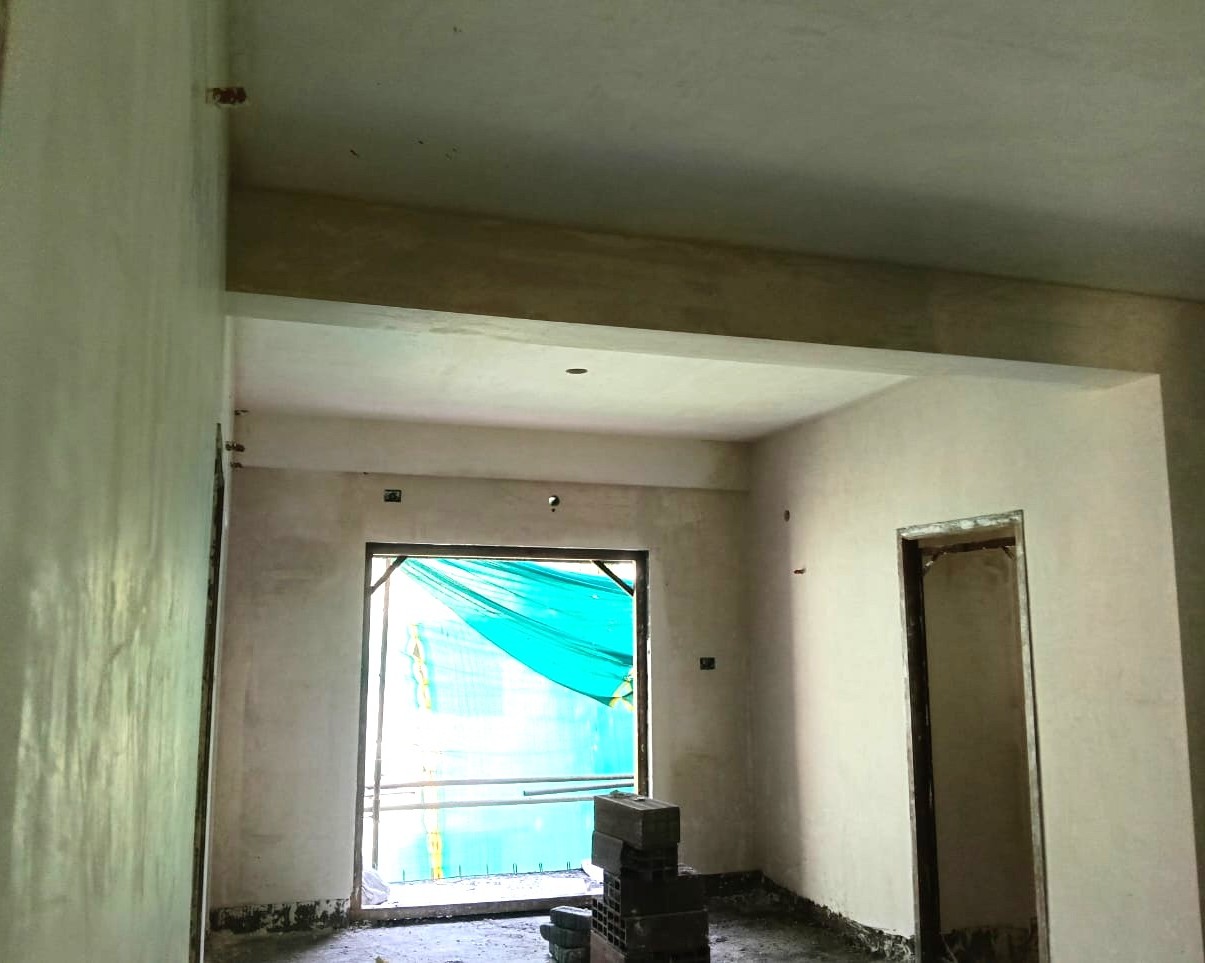

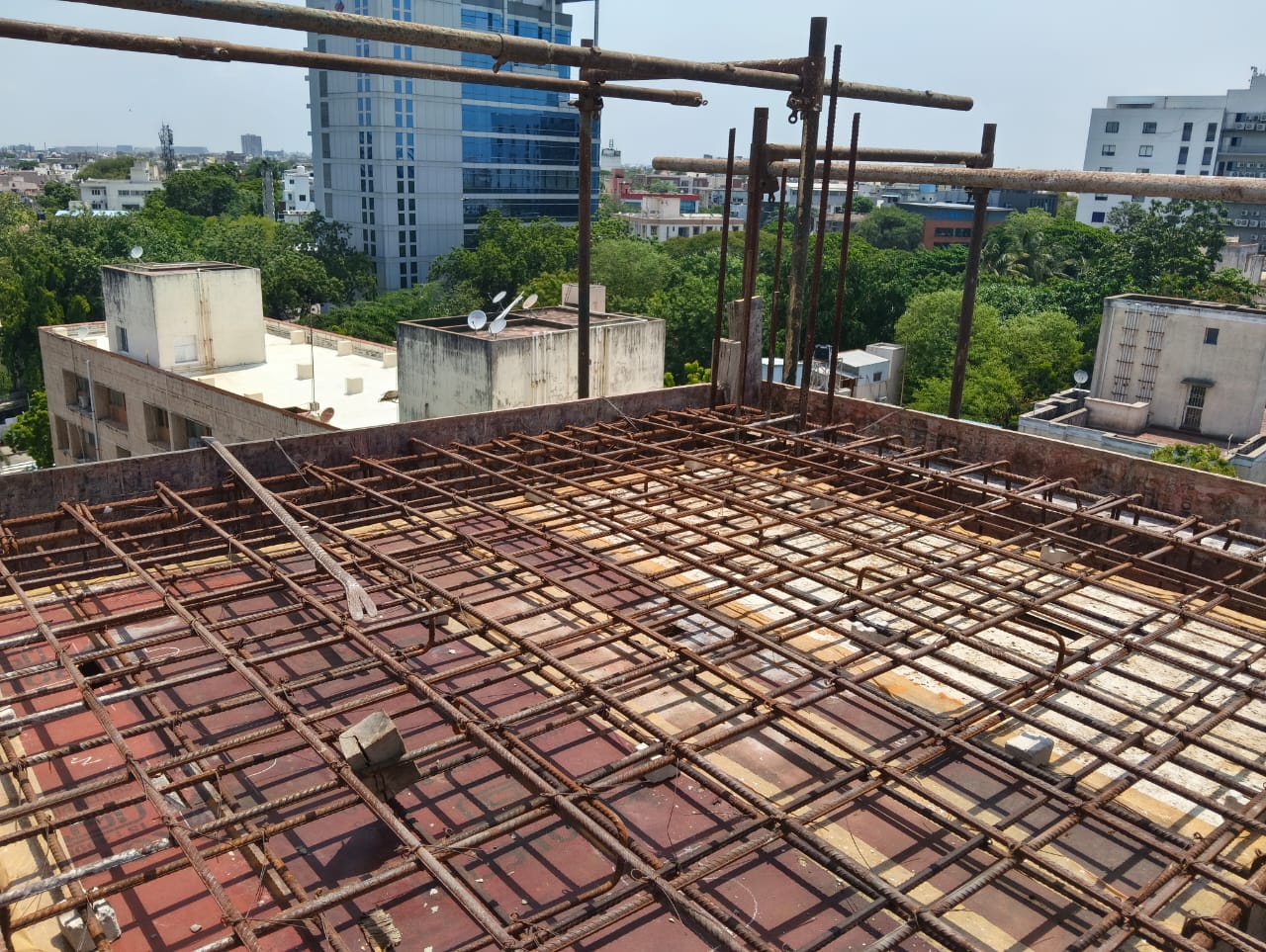

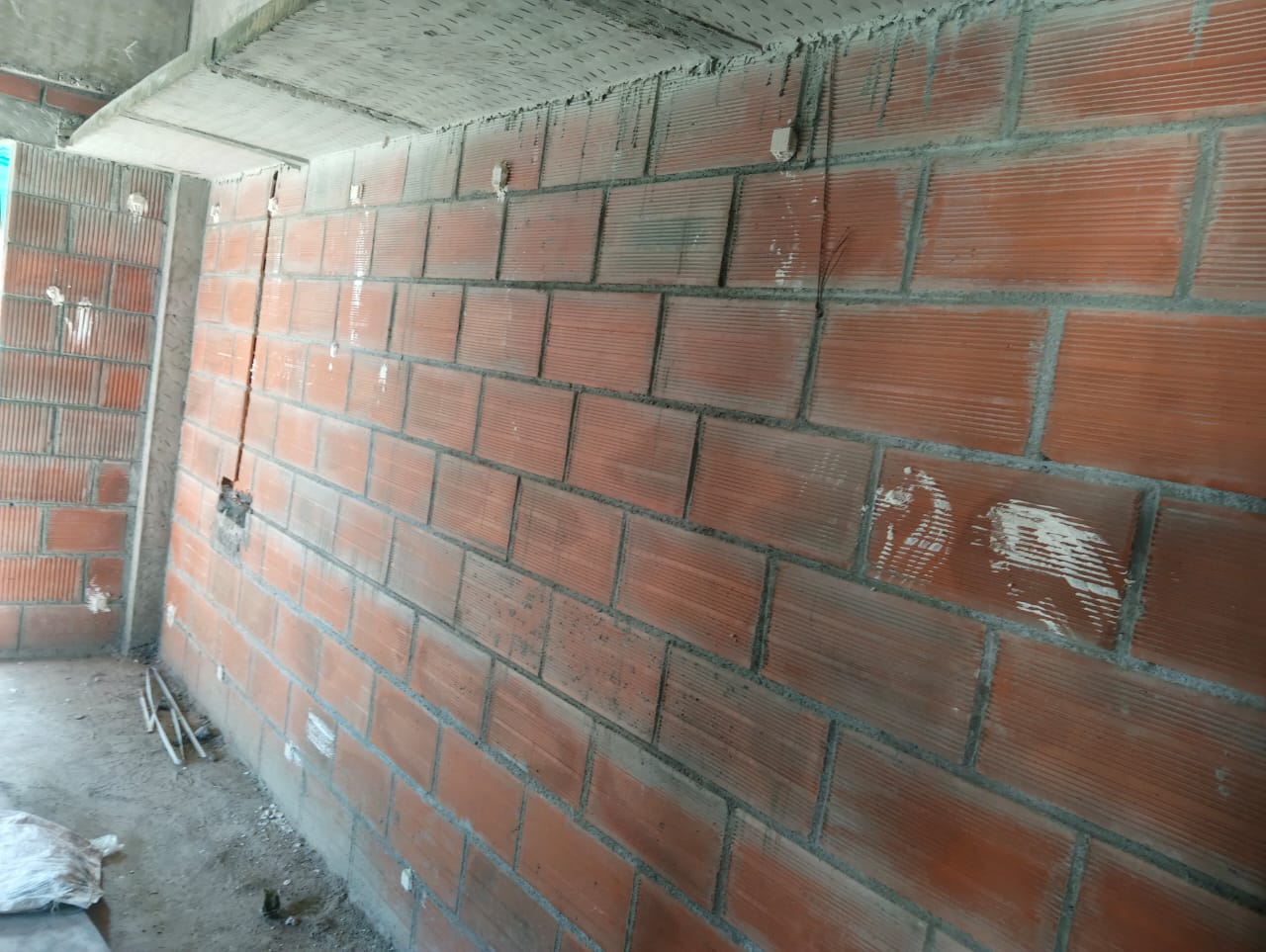

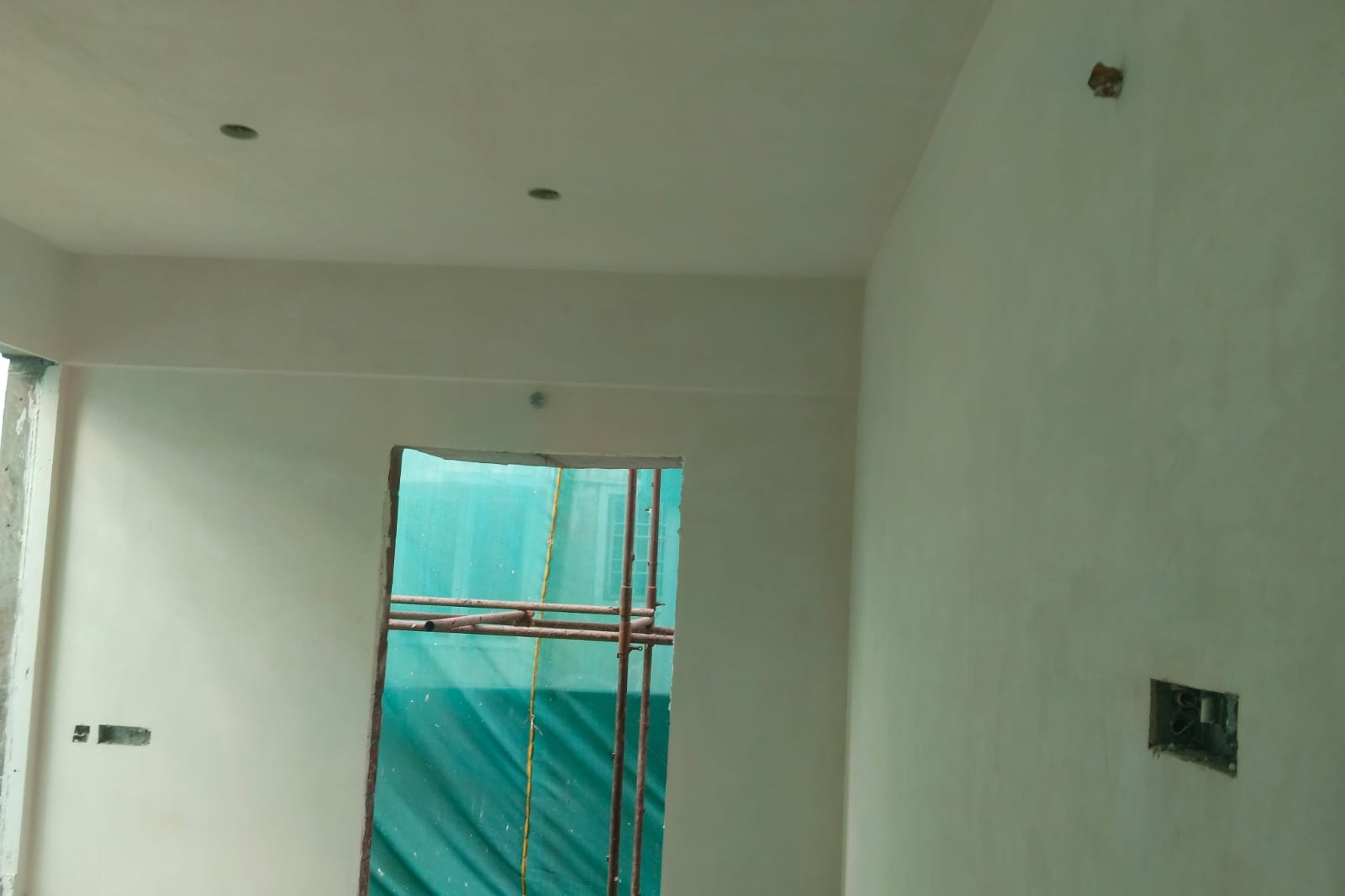

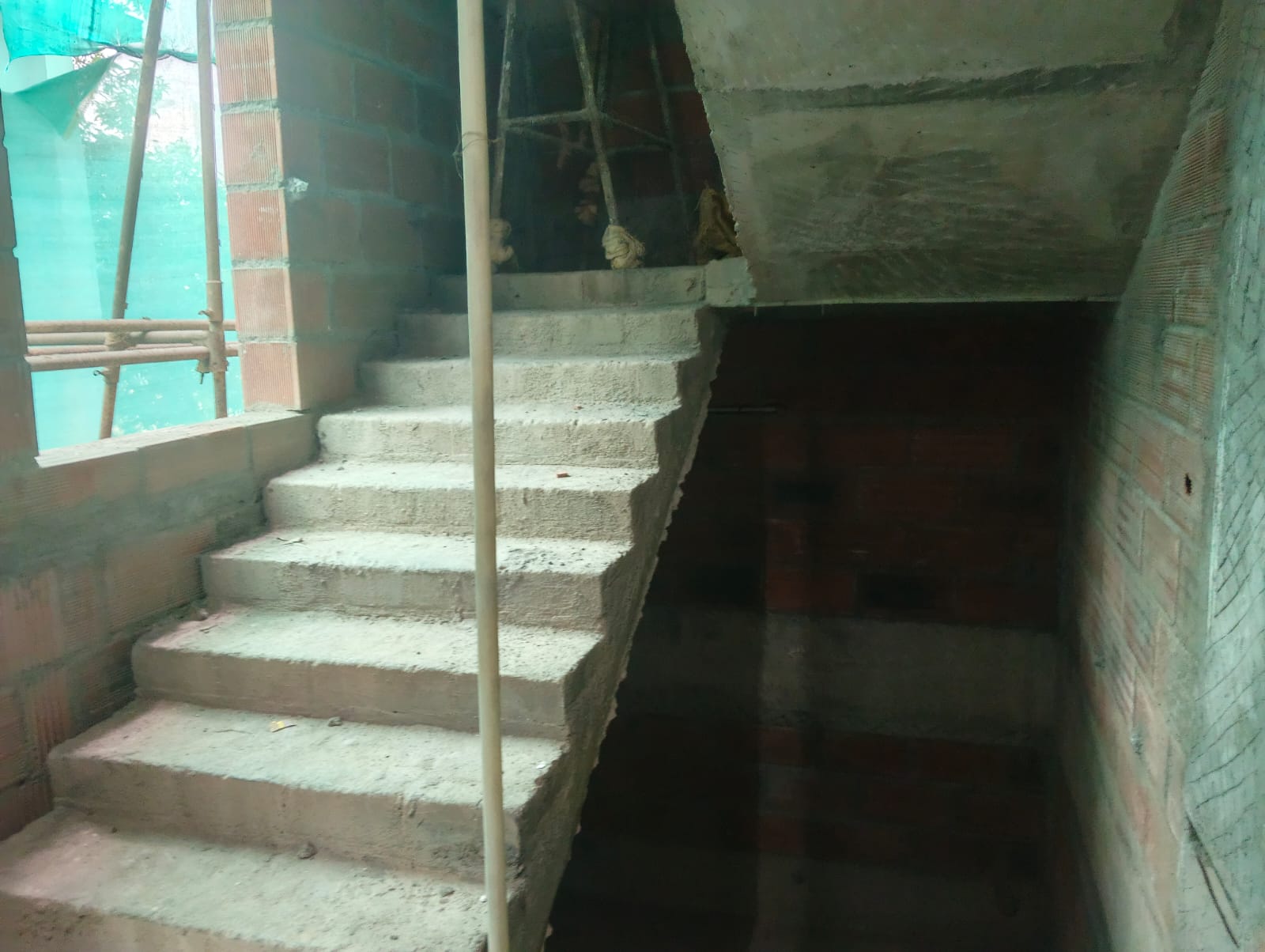

  • 2nd Floor plastering work is completed.
  • 3rd Floor plastering work is in progress.(electrical wall chasing work completed)

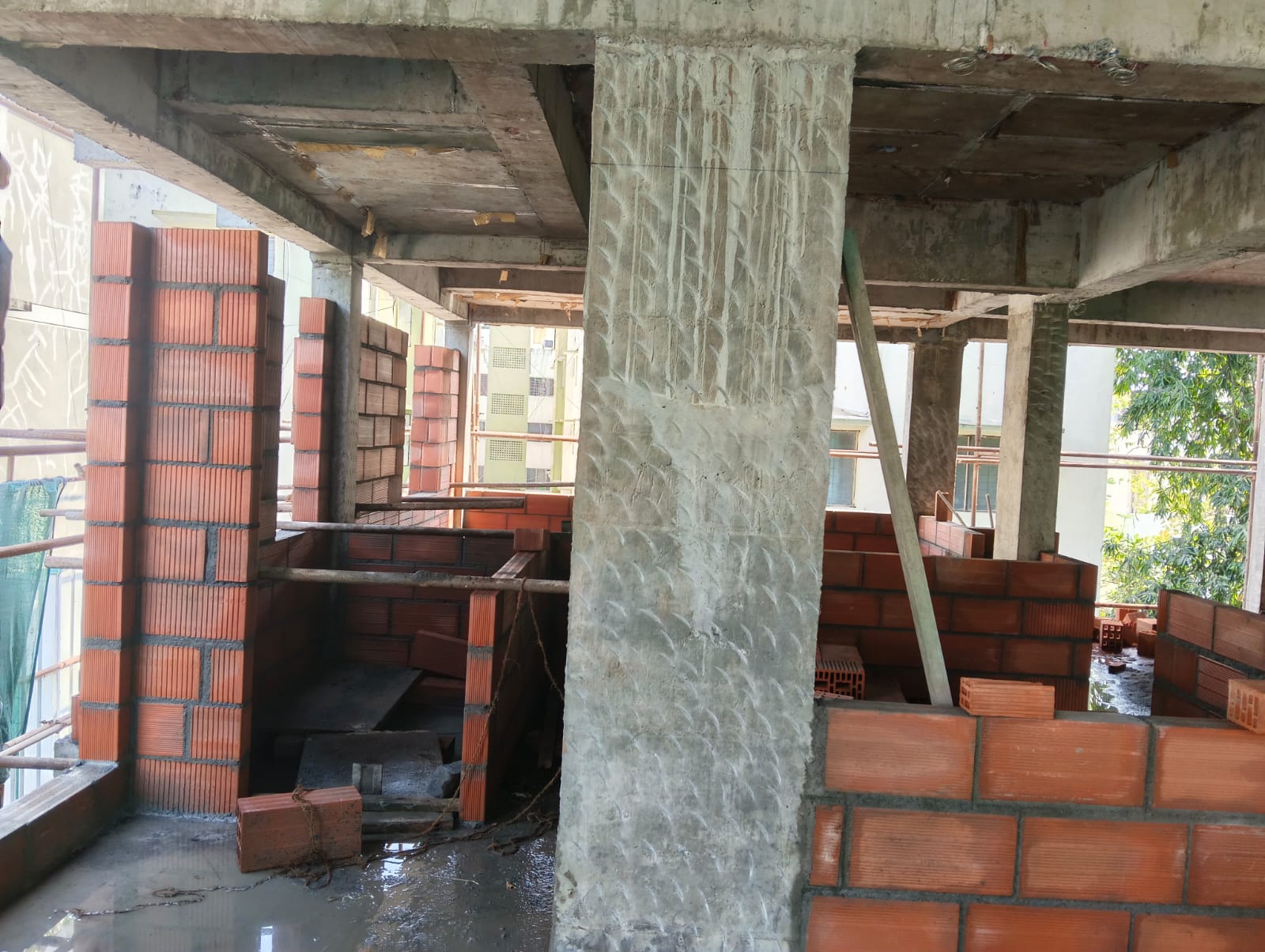

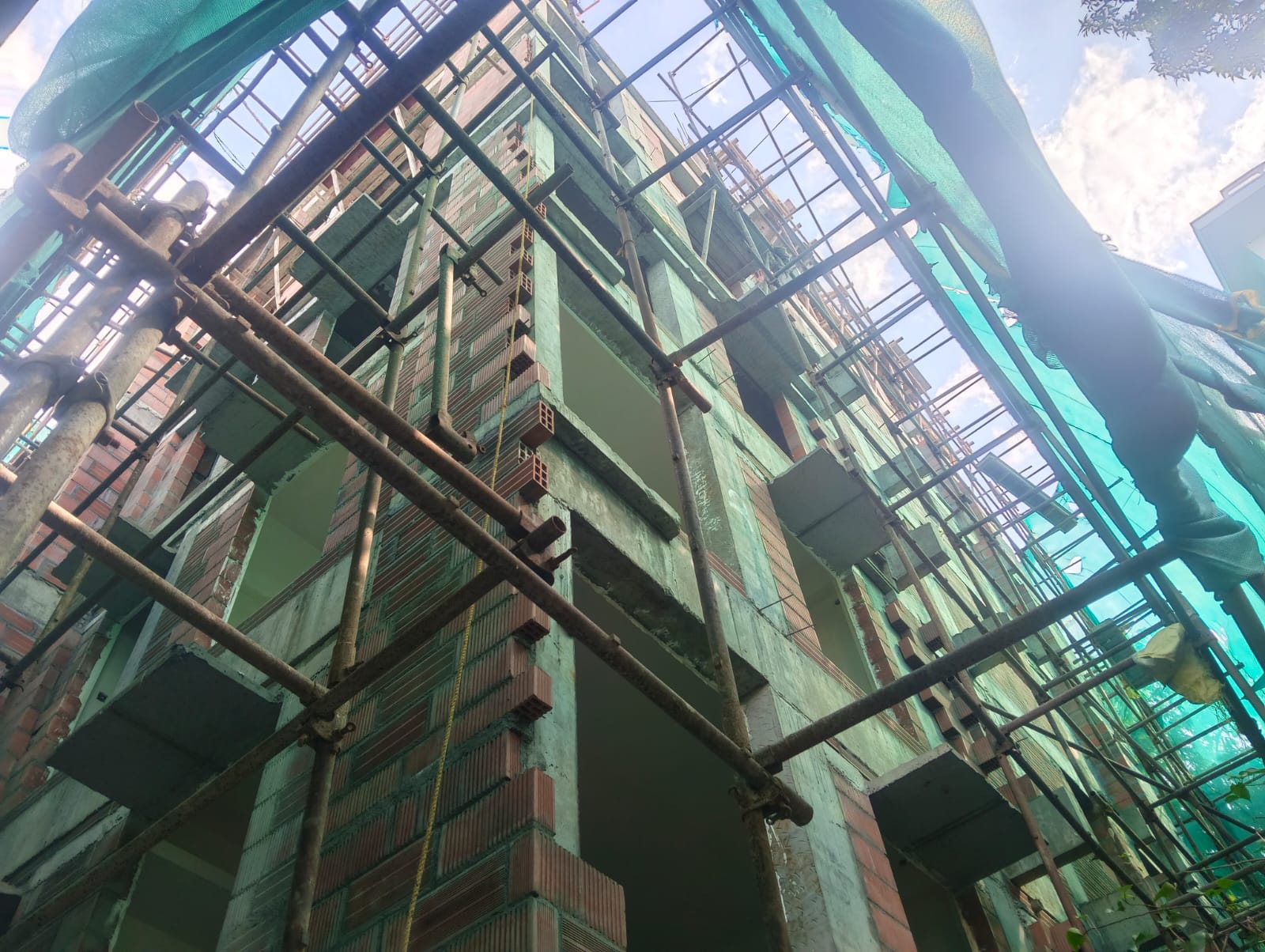

  • 4th Floor block work is in progress.(70% completed)
  • 5th Floor block work is in progress. (70% completed)

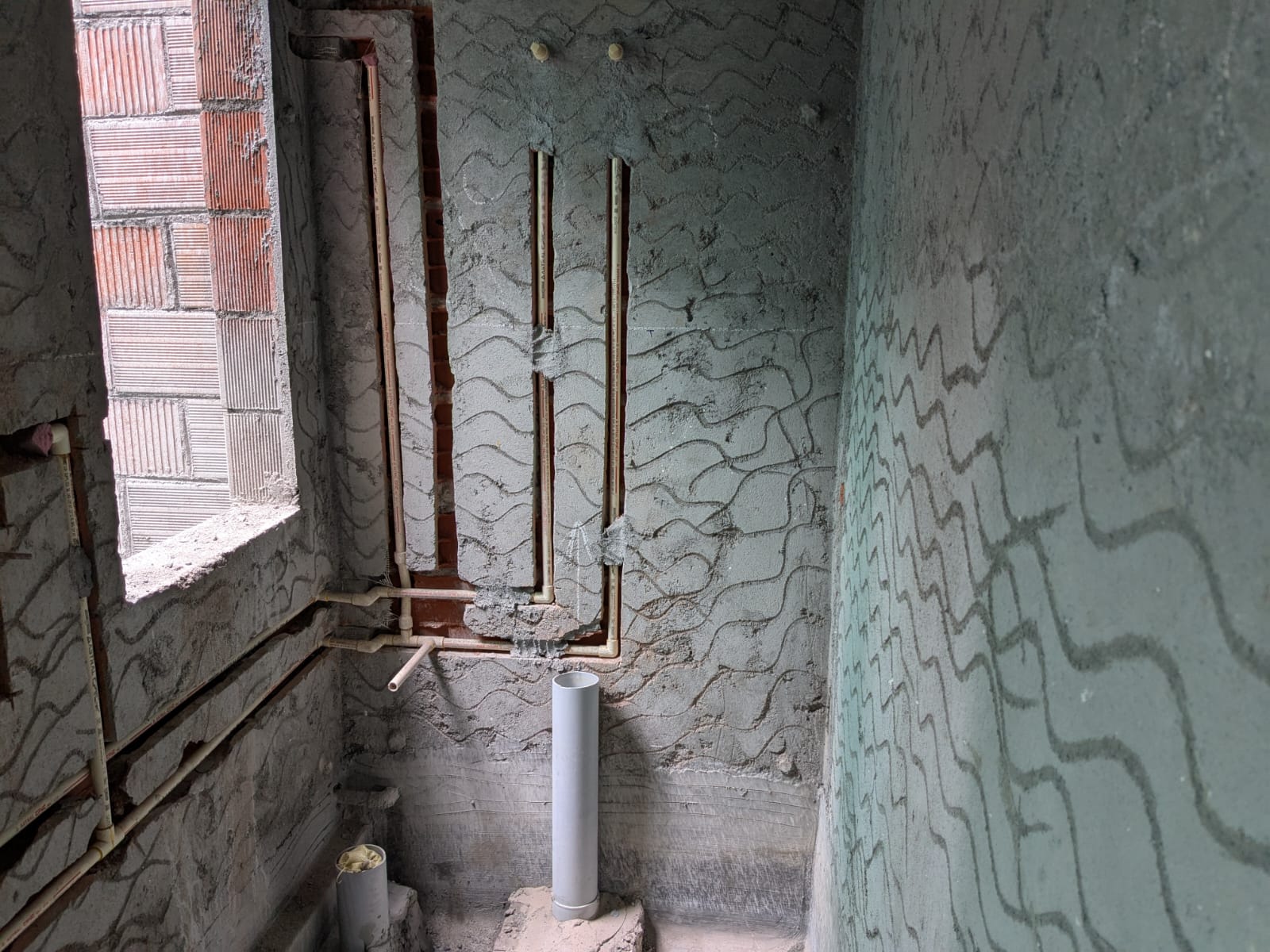

  • Toilet plumbing work is in progress.(1st & 2nd floor progress).

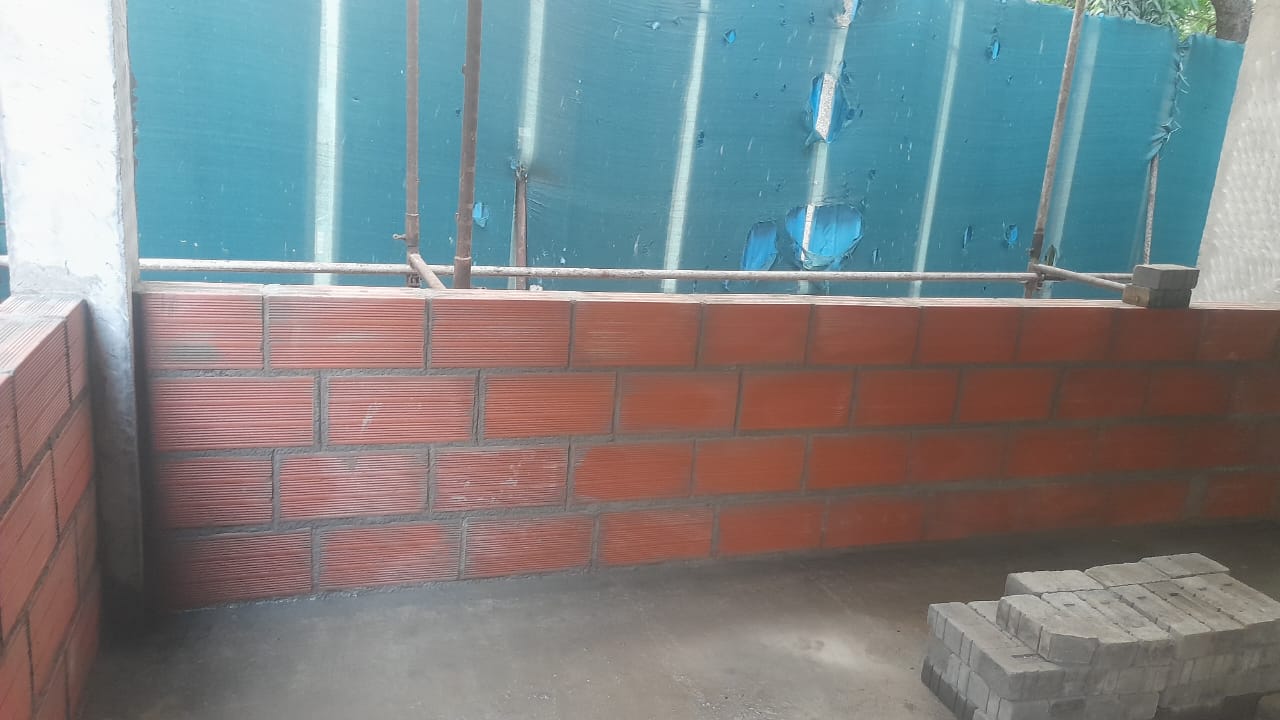

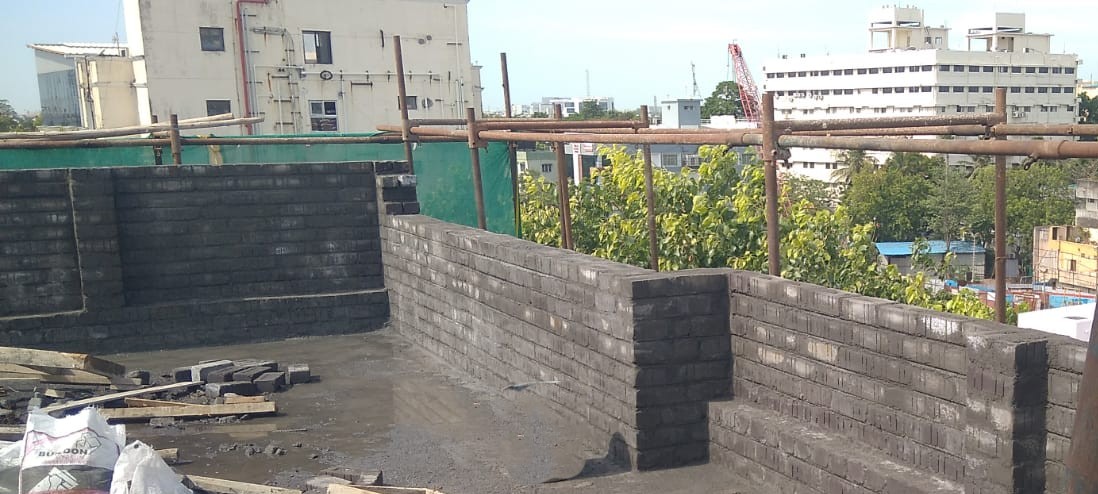

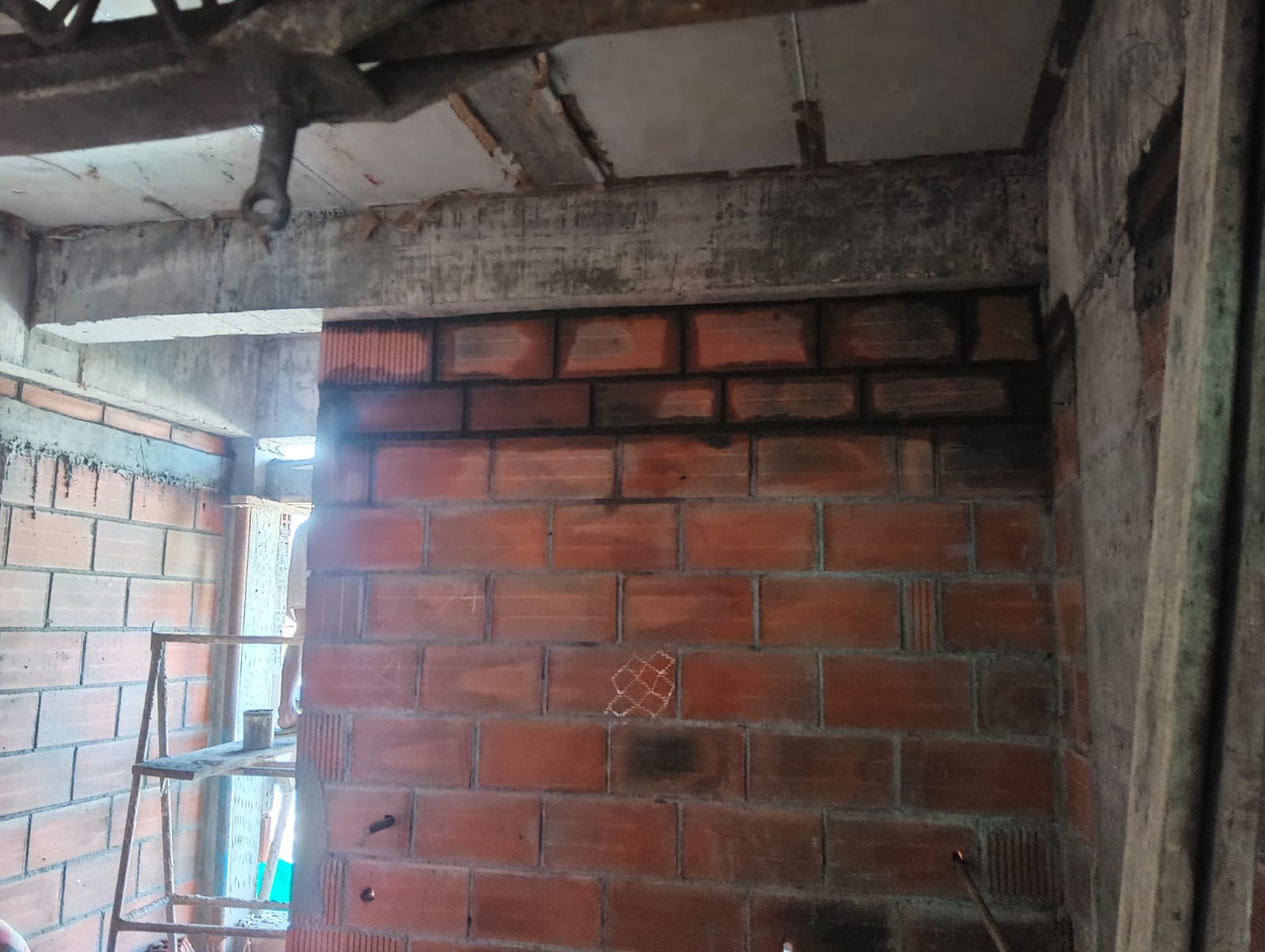

  • Terrace parapet wall brick work is completed.

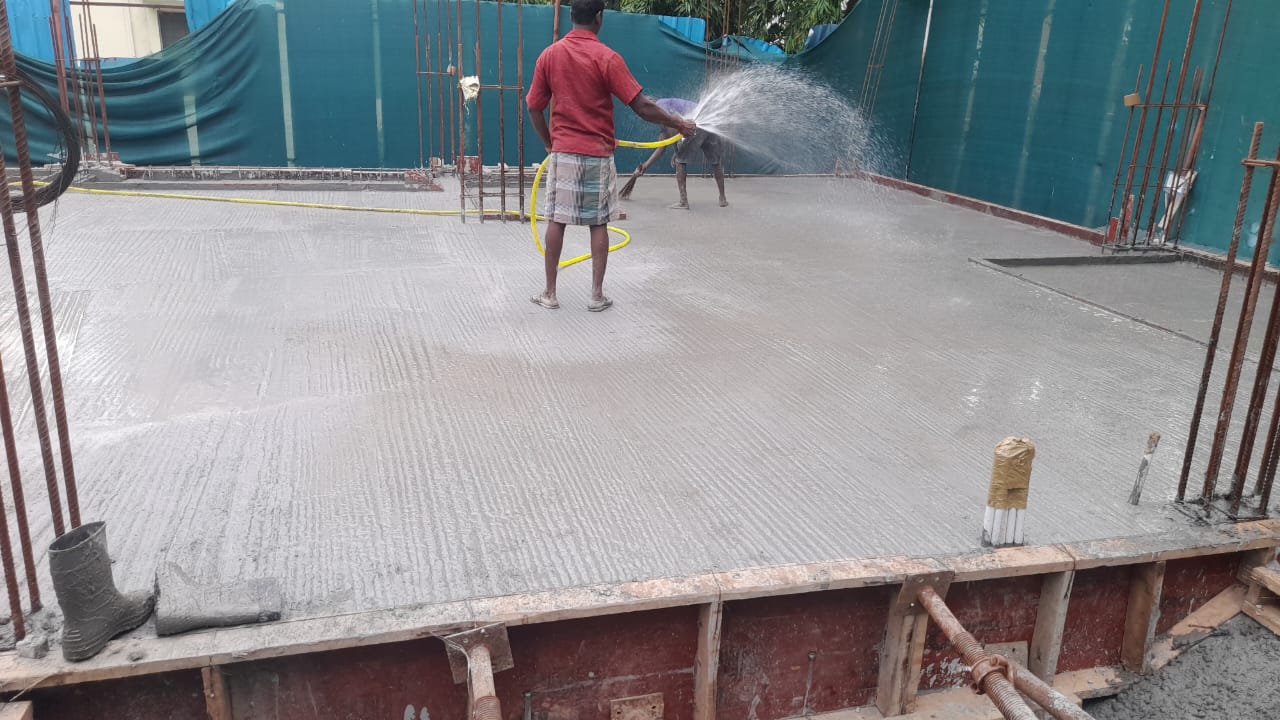

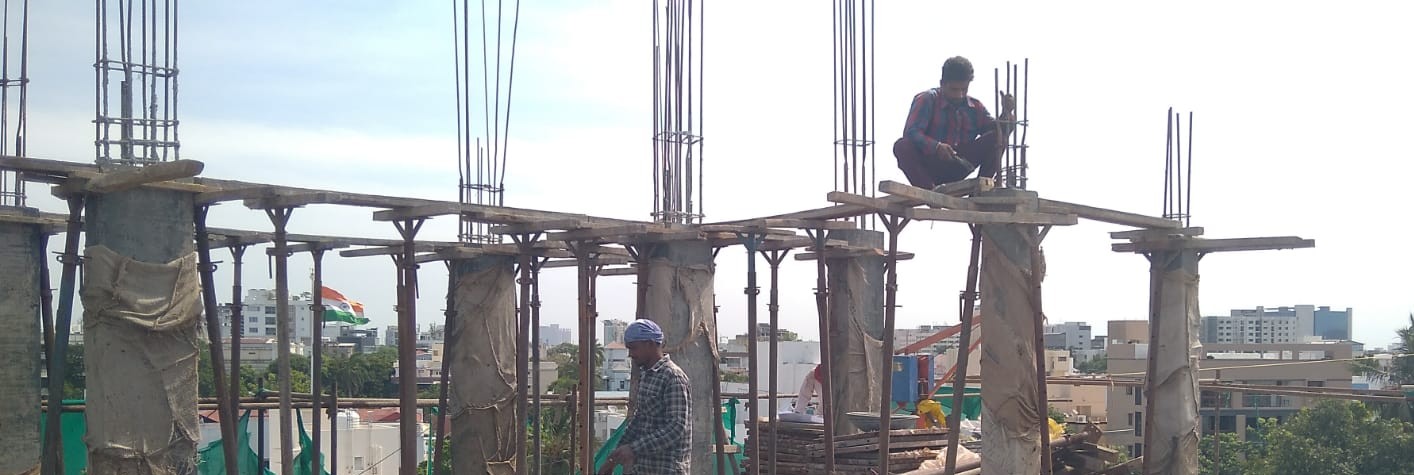

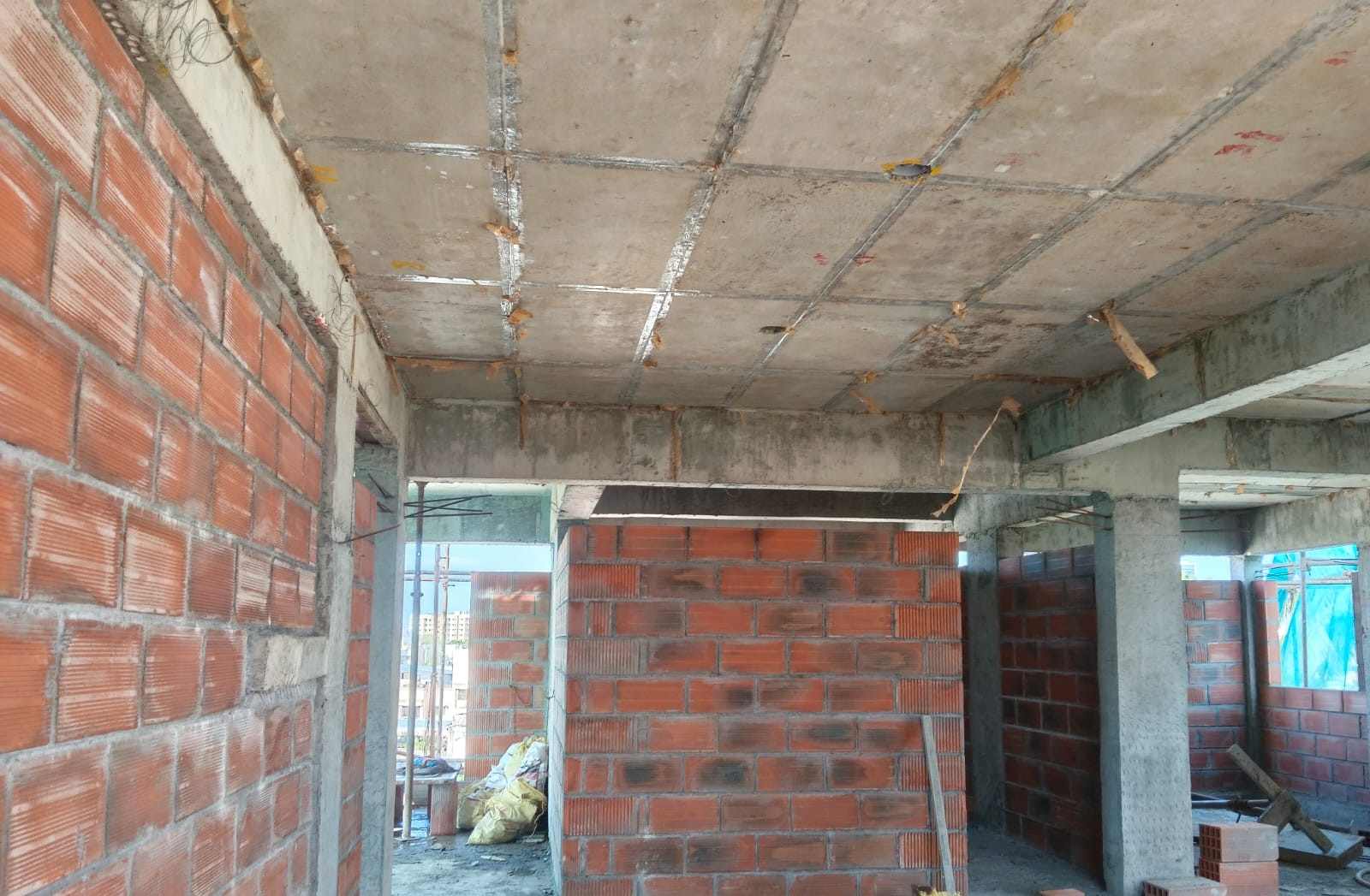

  • Head room column concrete work is completed.

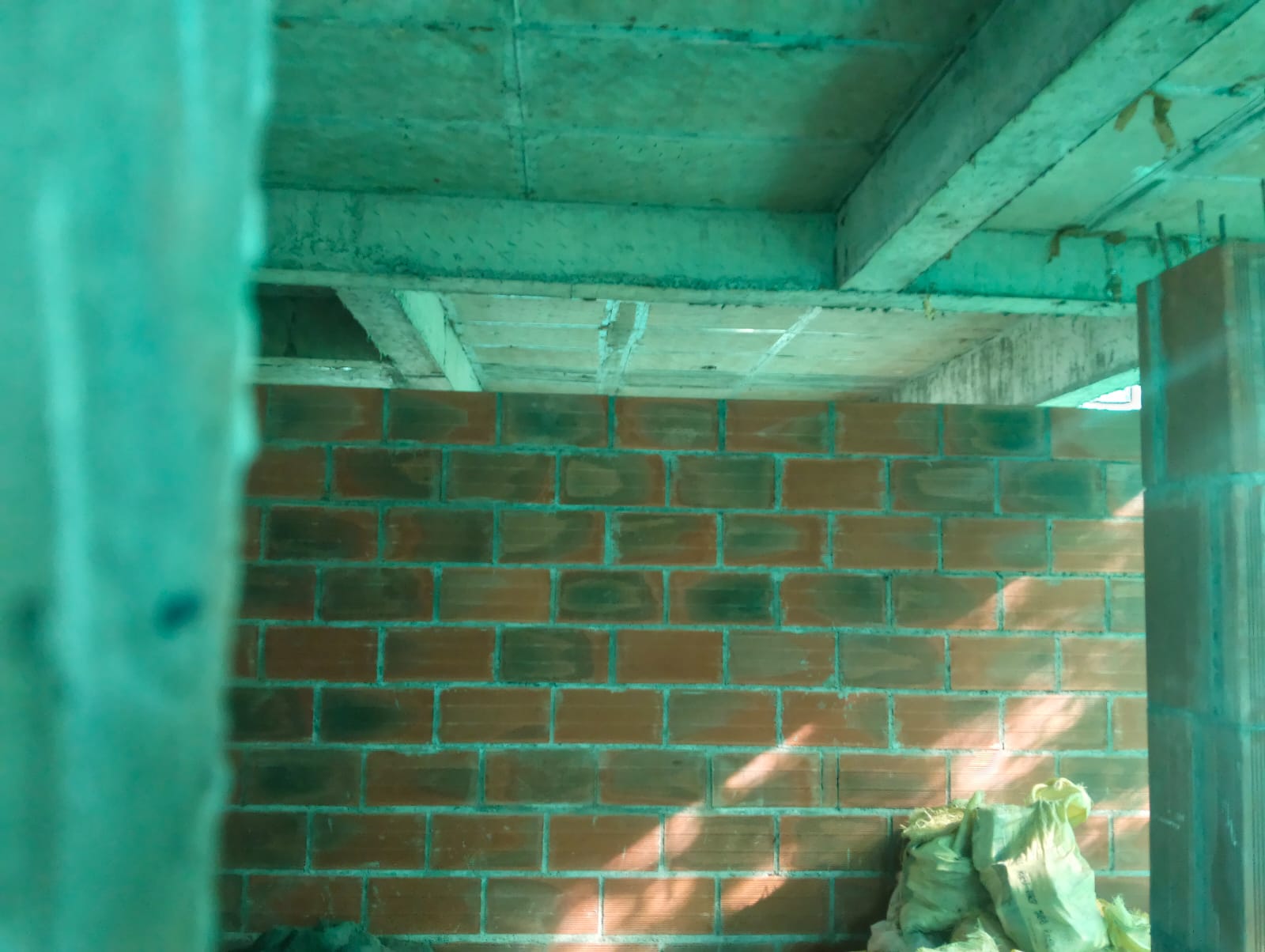

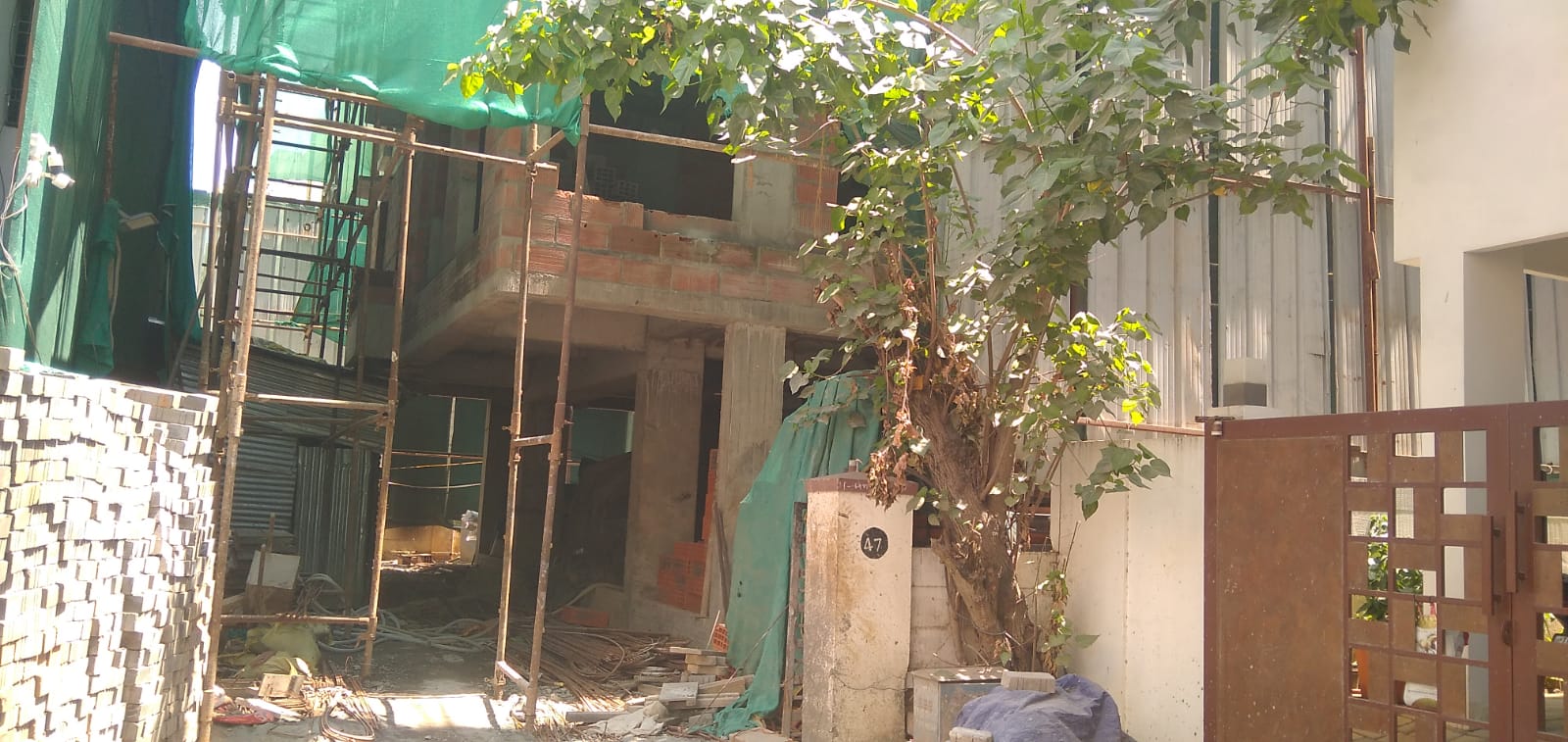

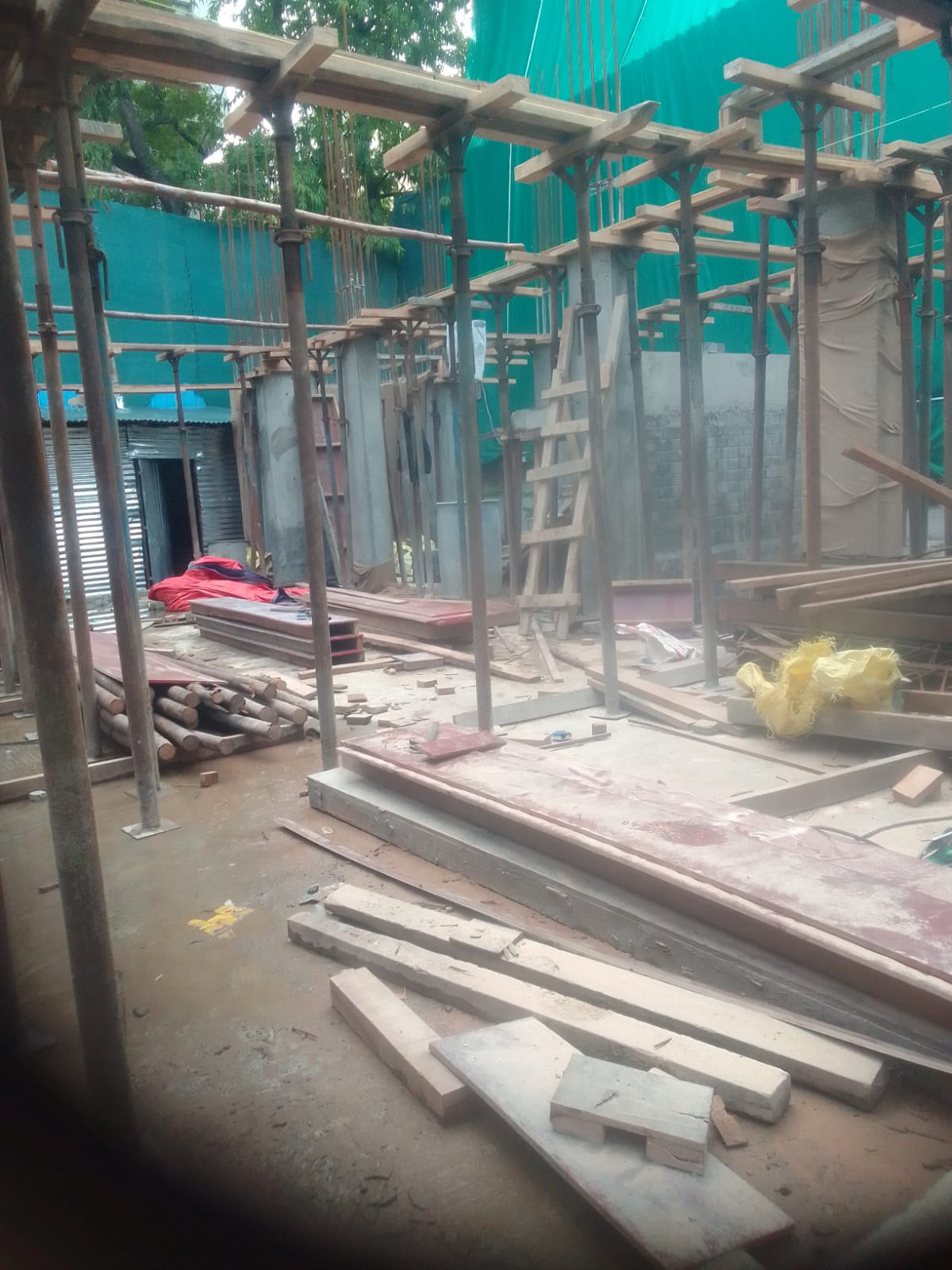

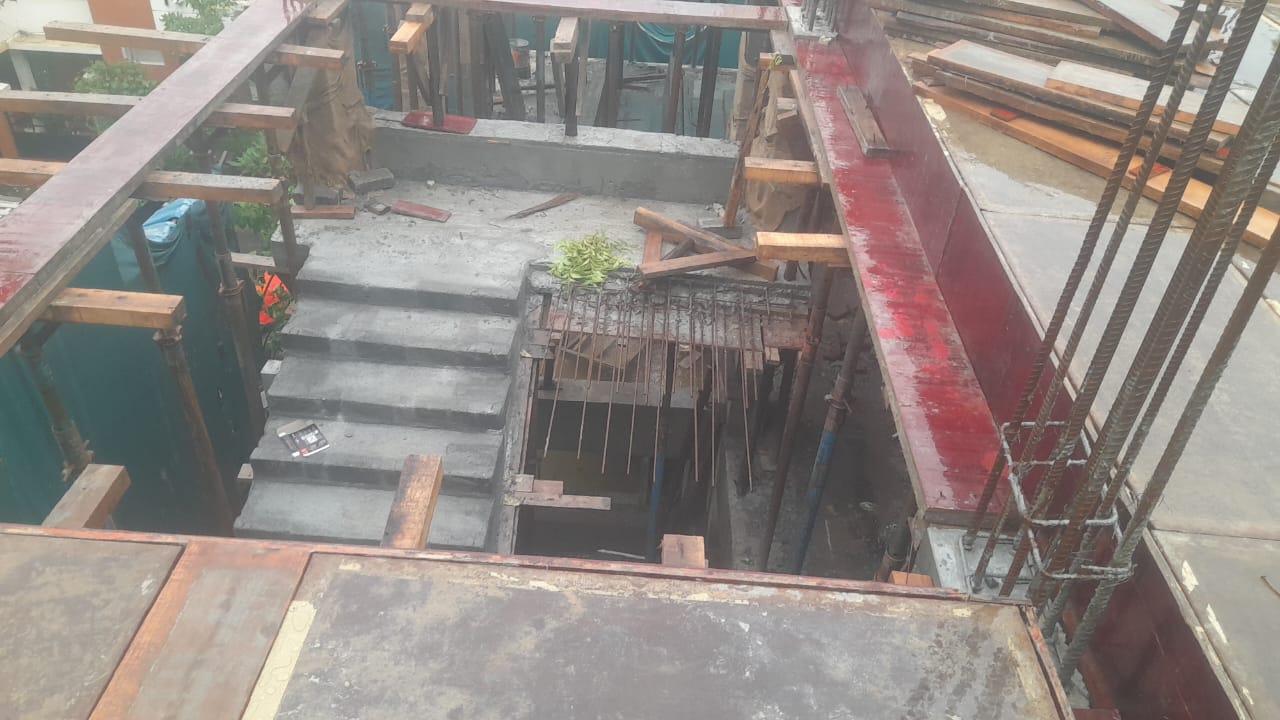

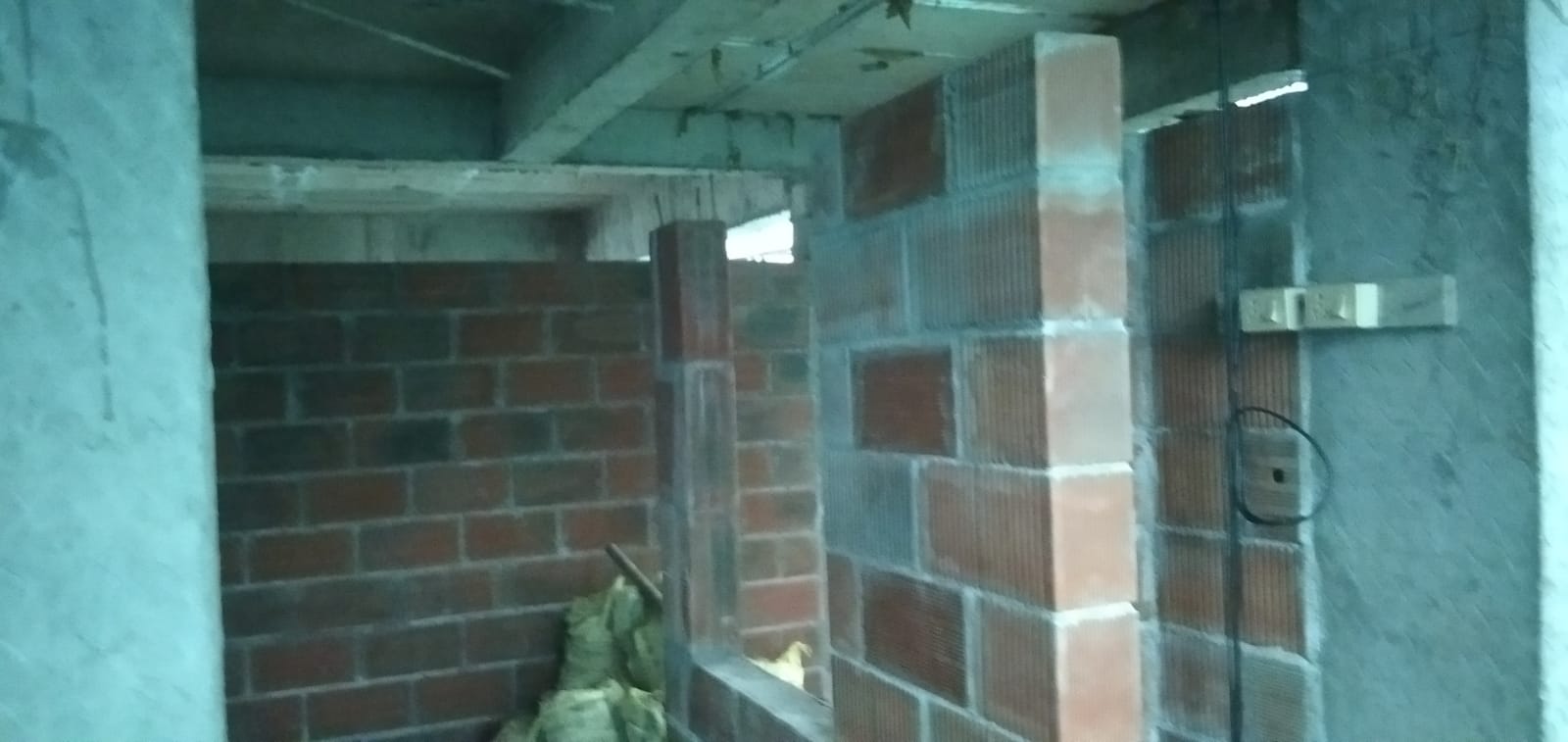

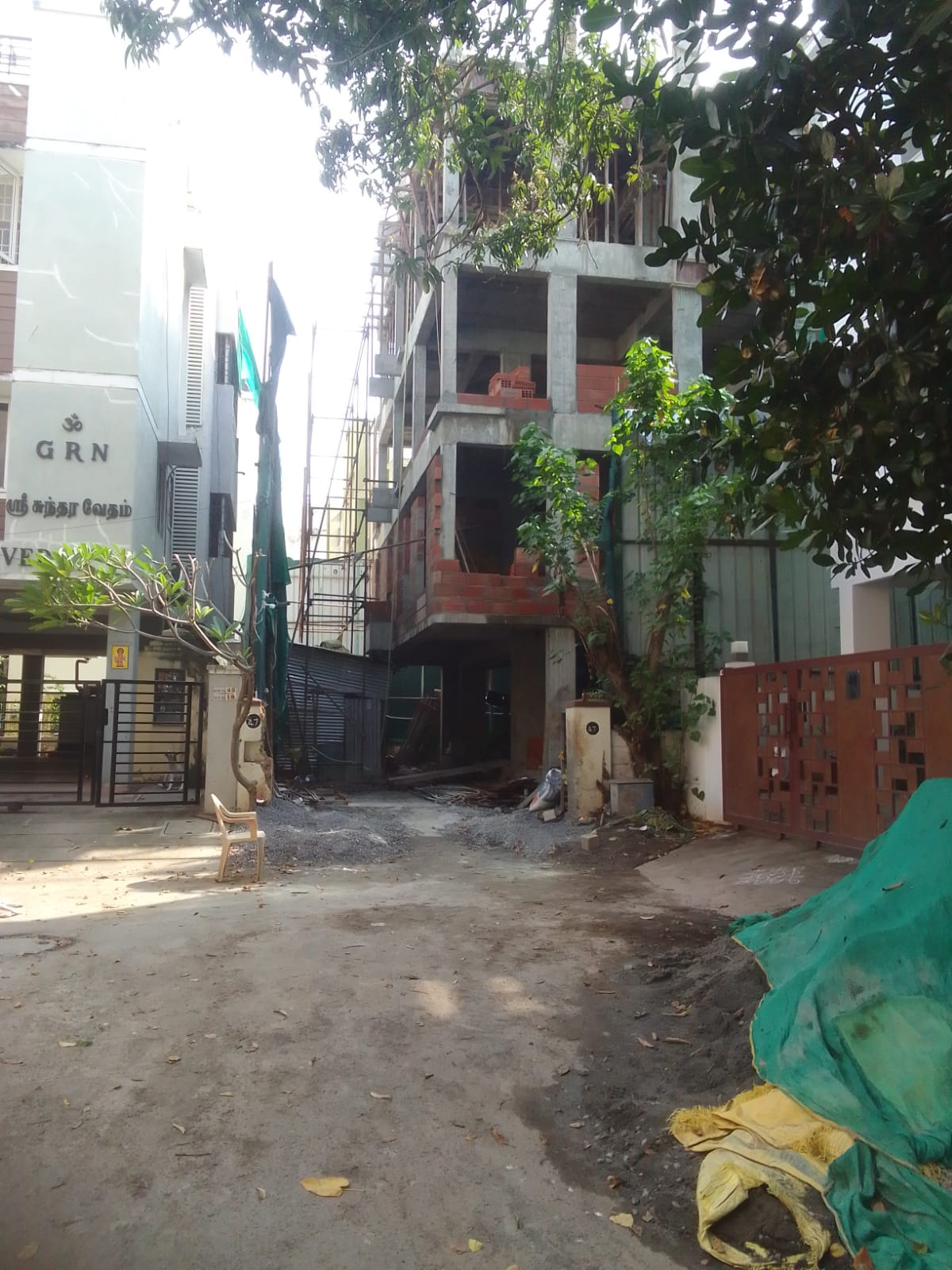

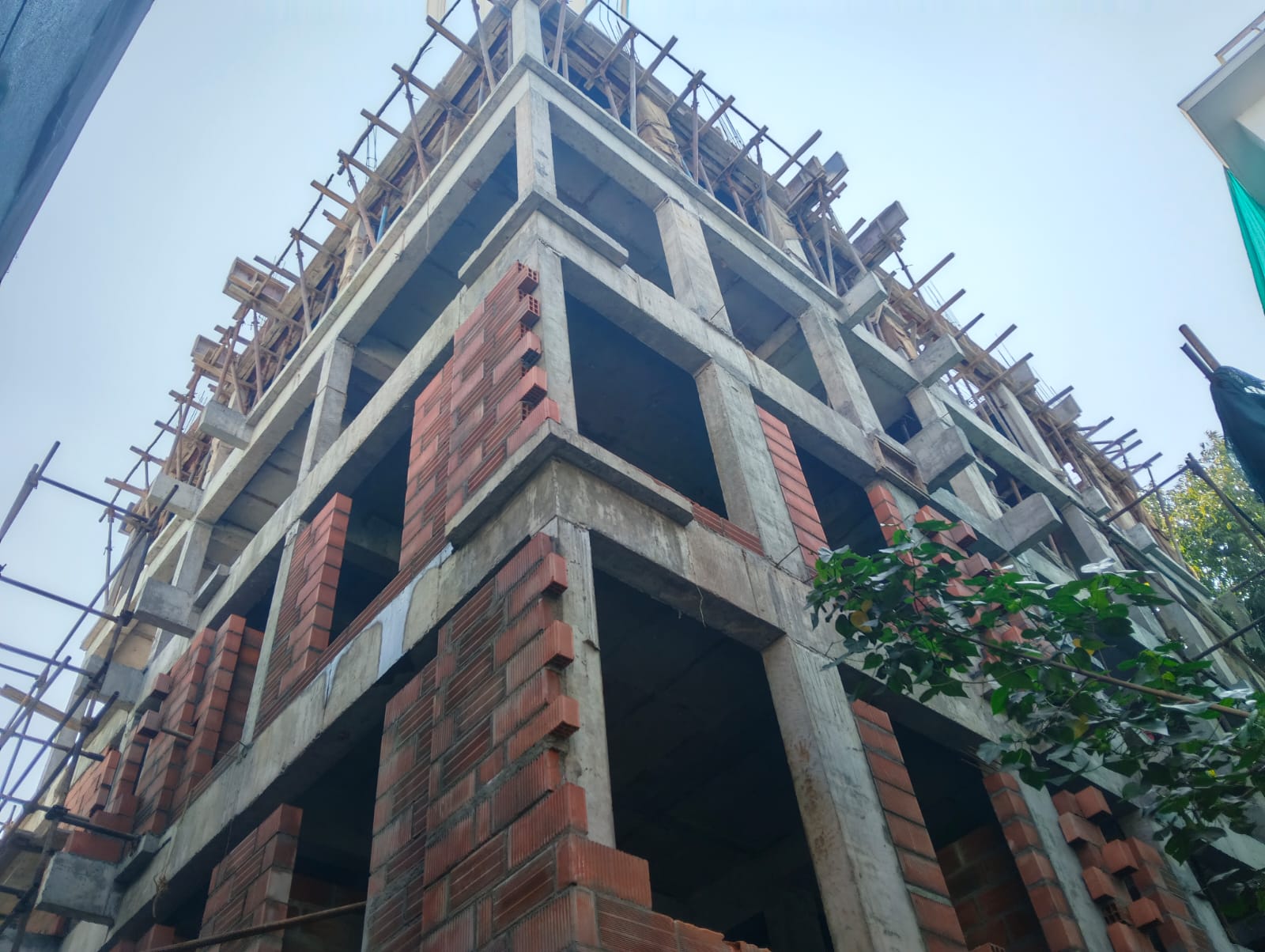

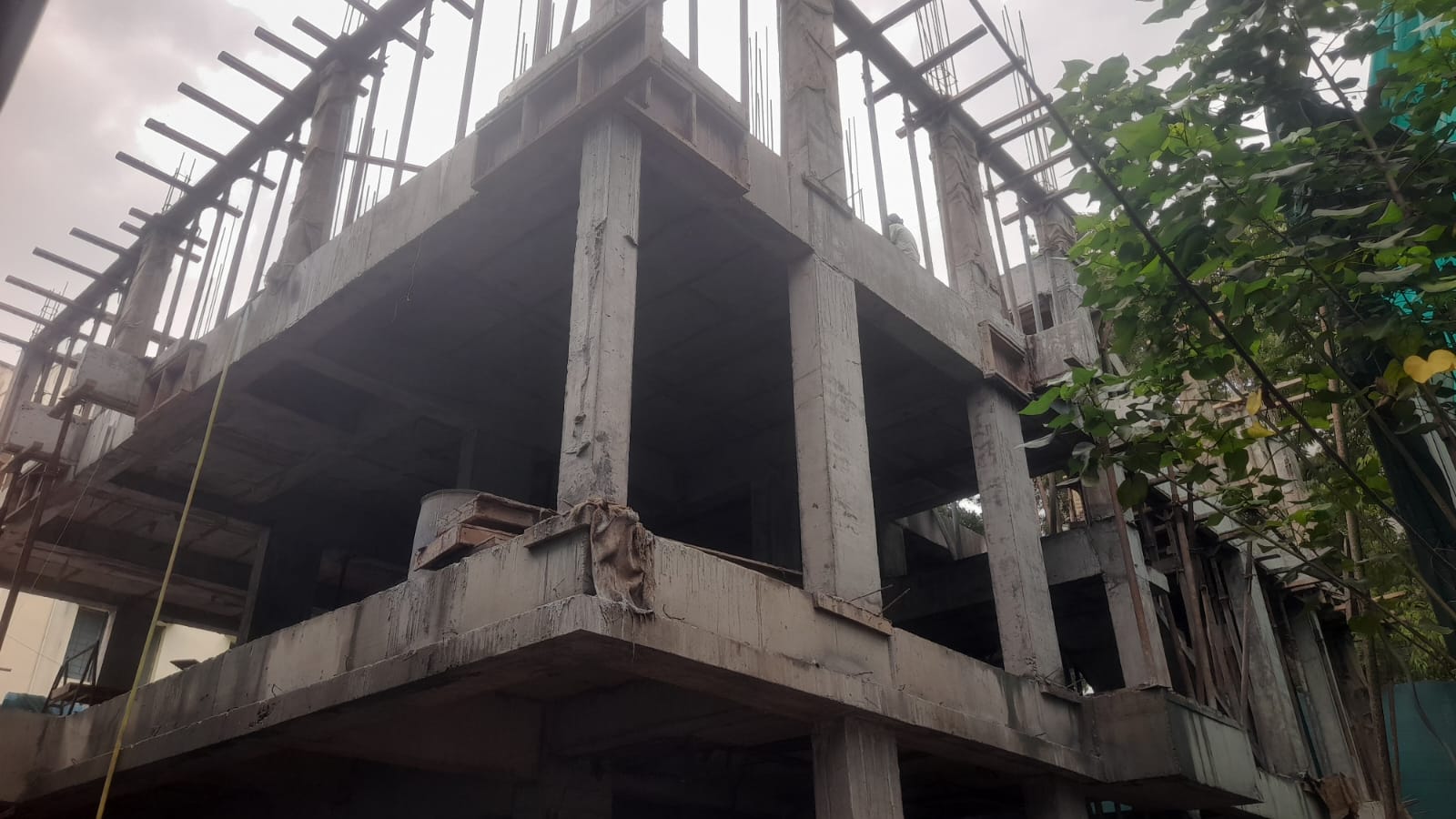

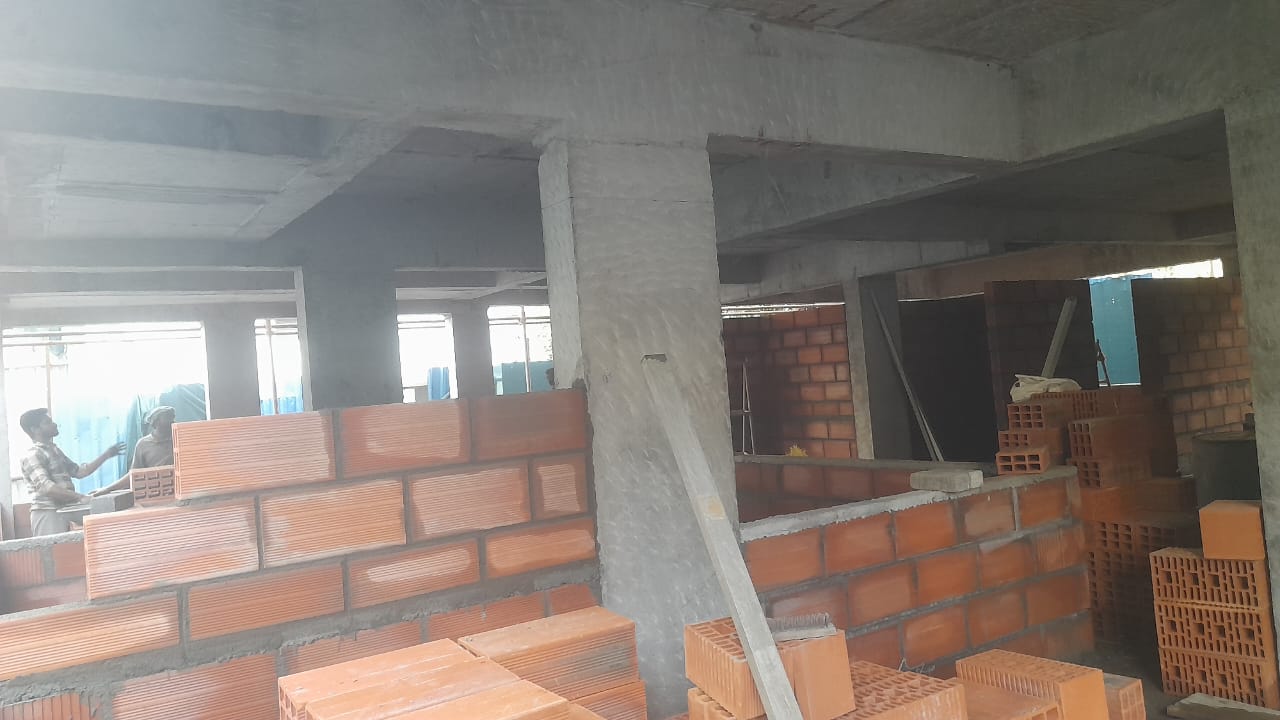

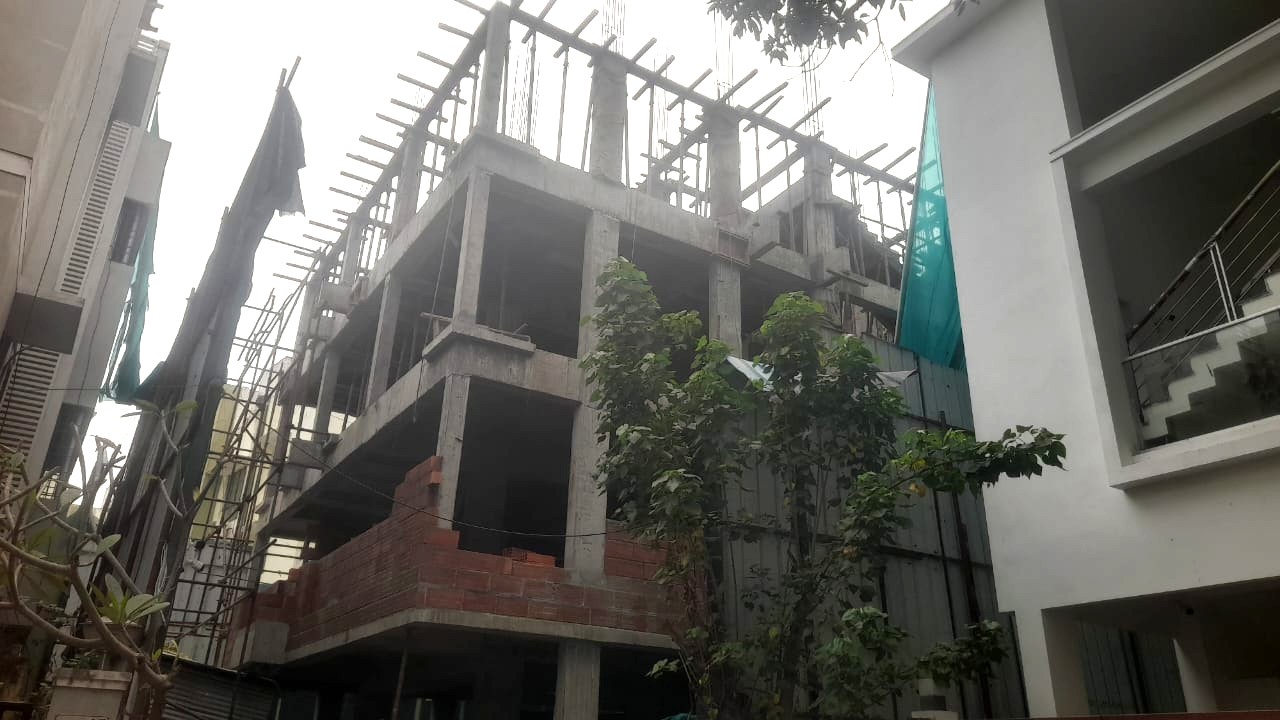

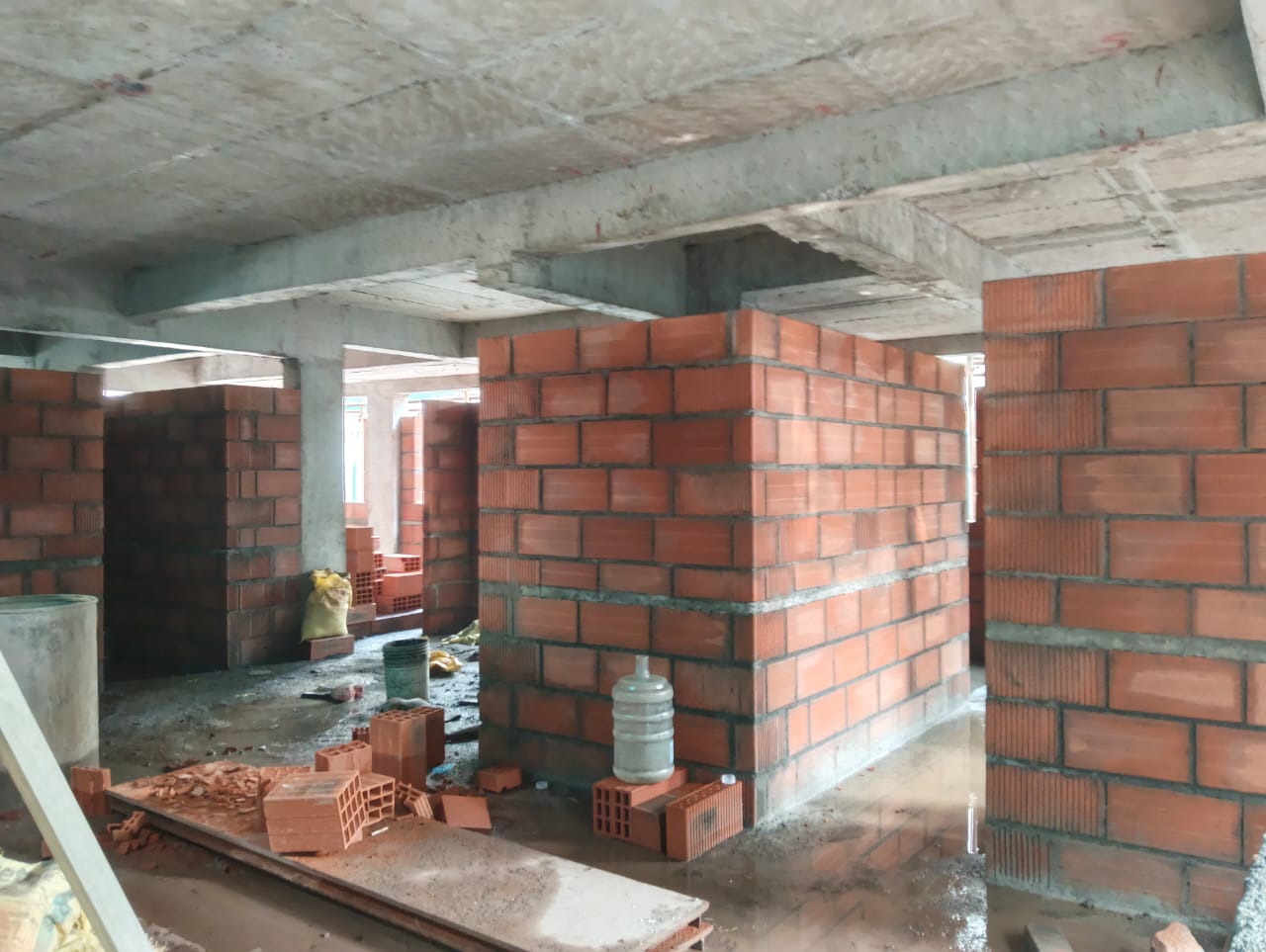

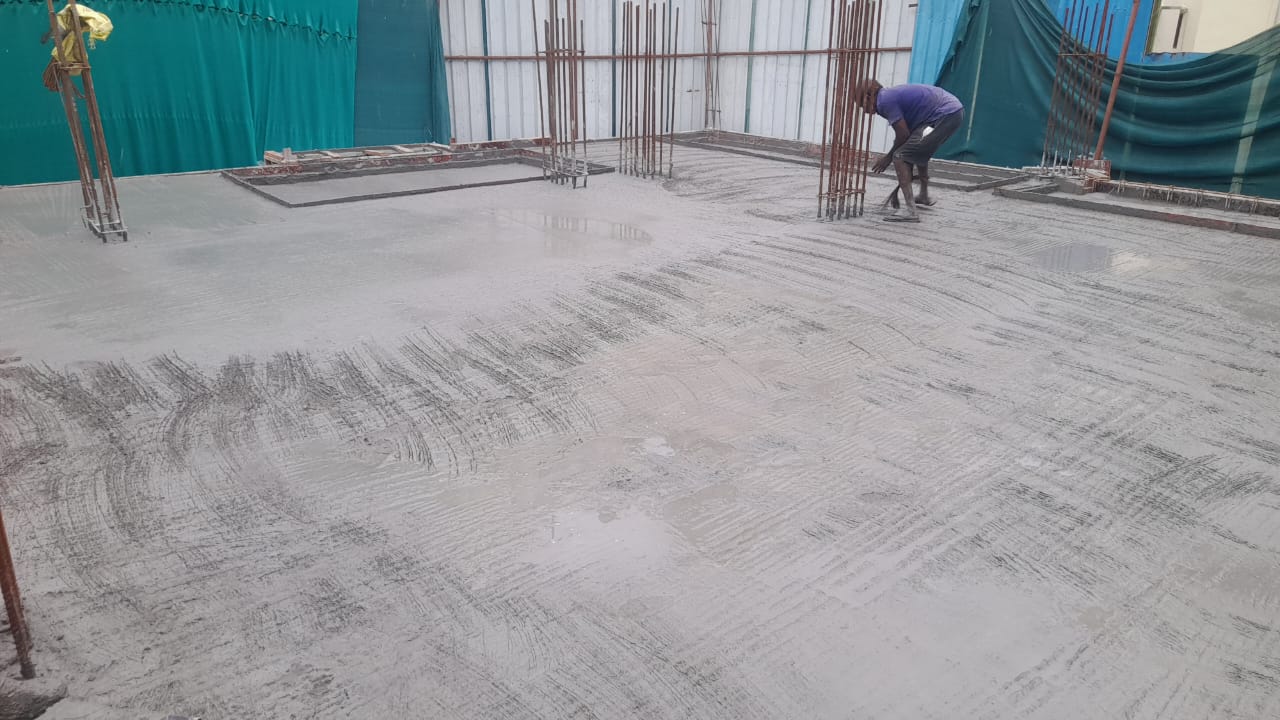

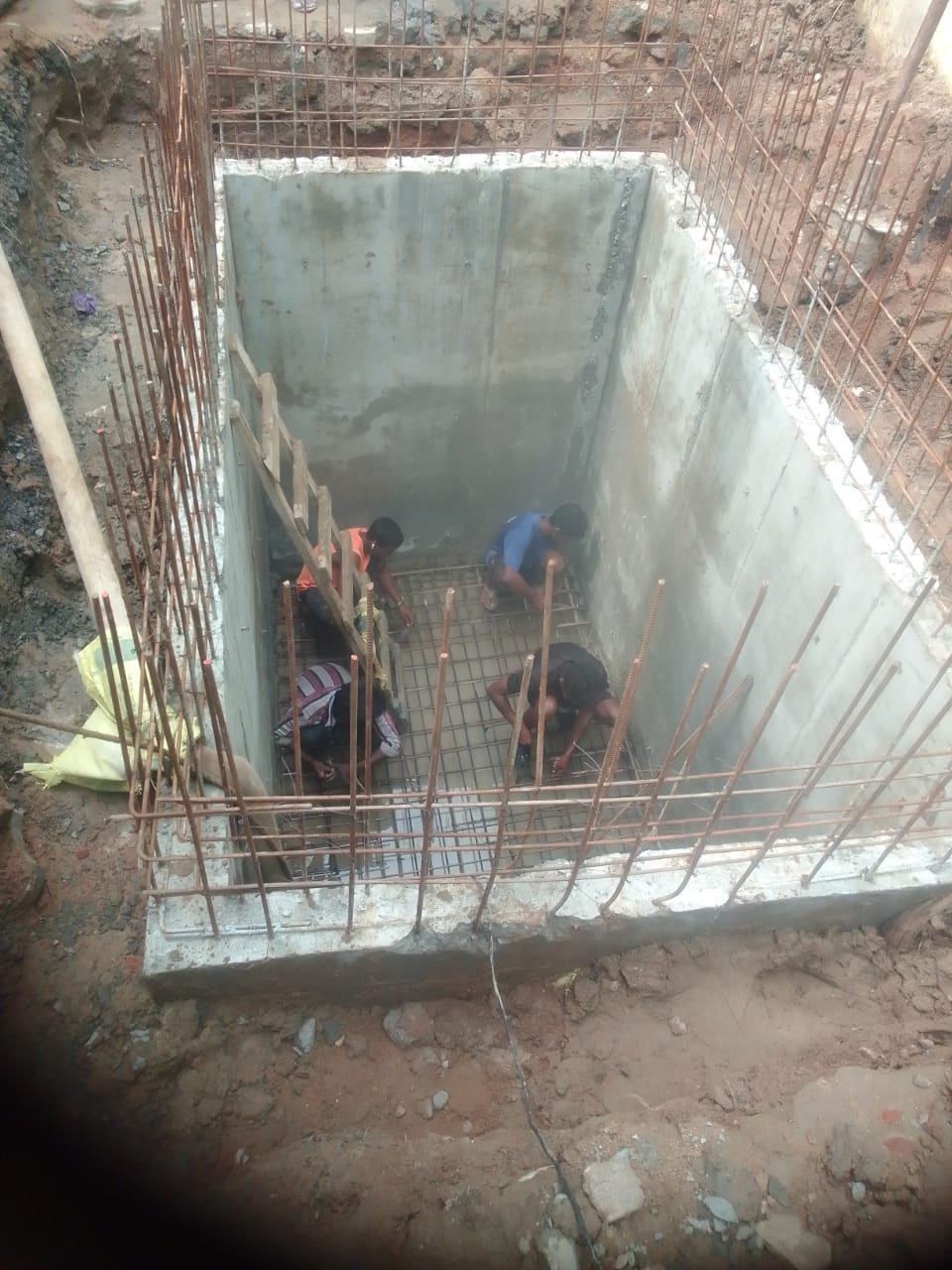

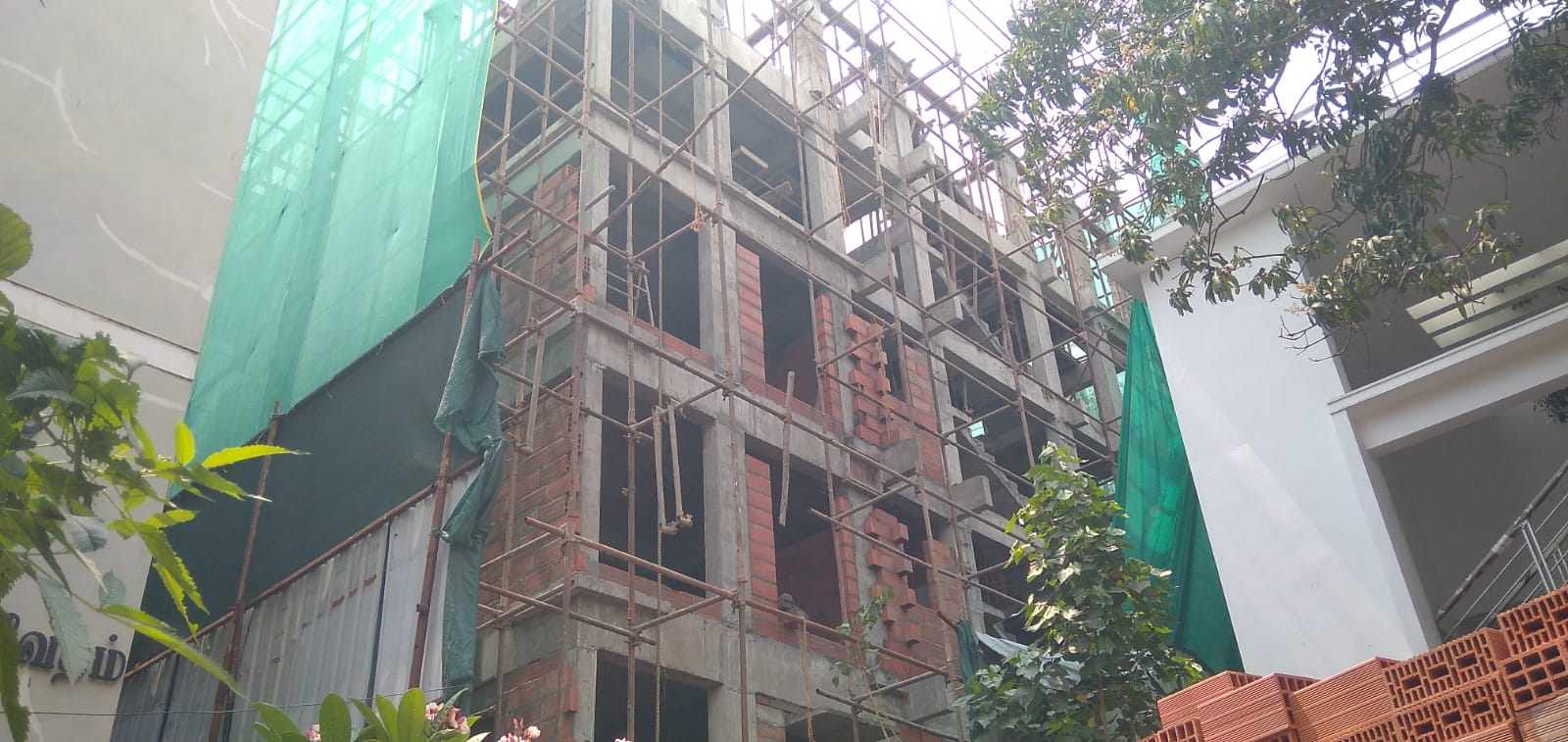

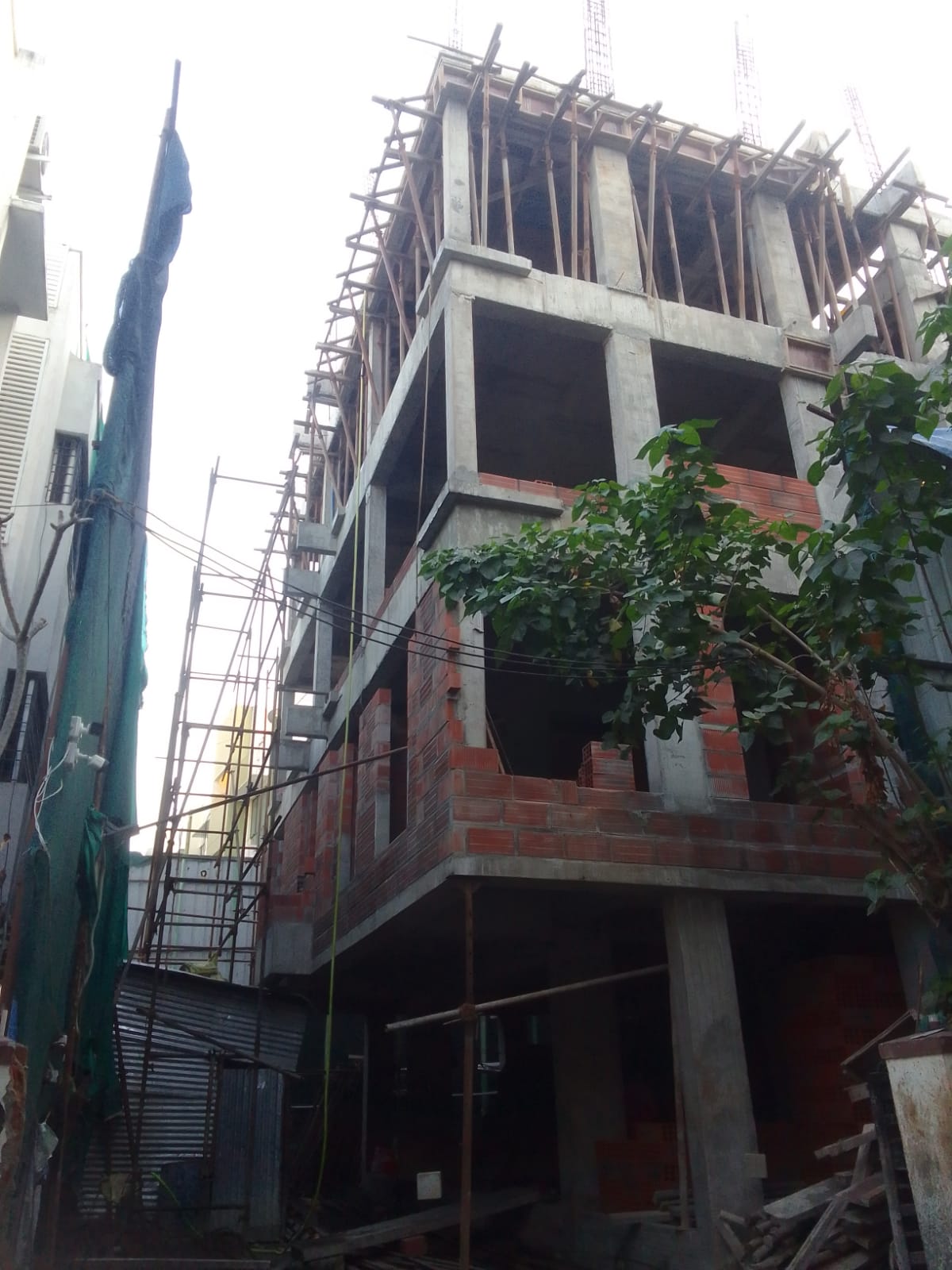

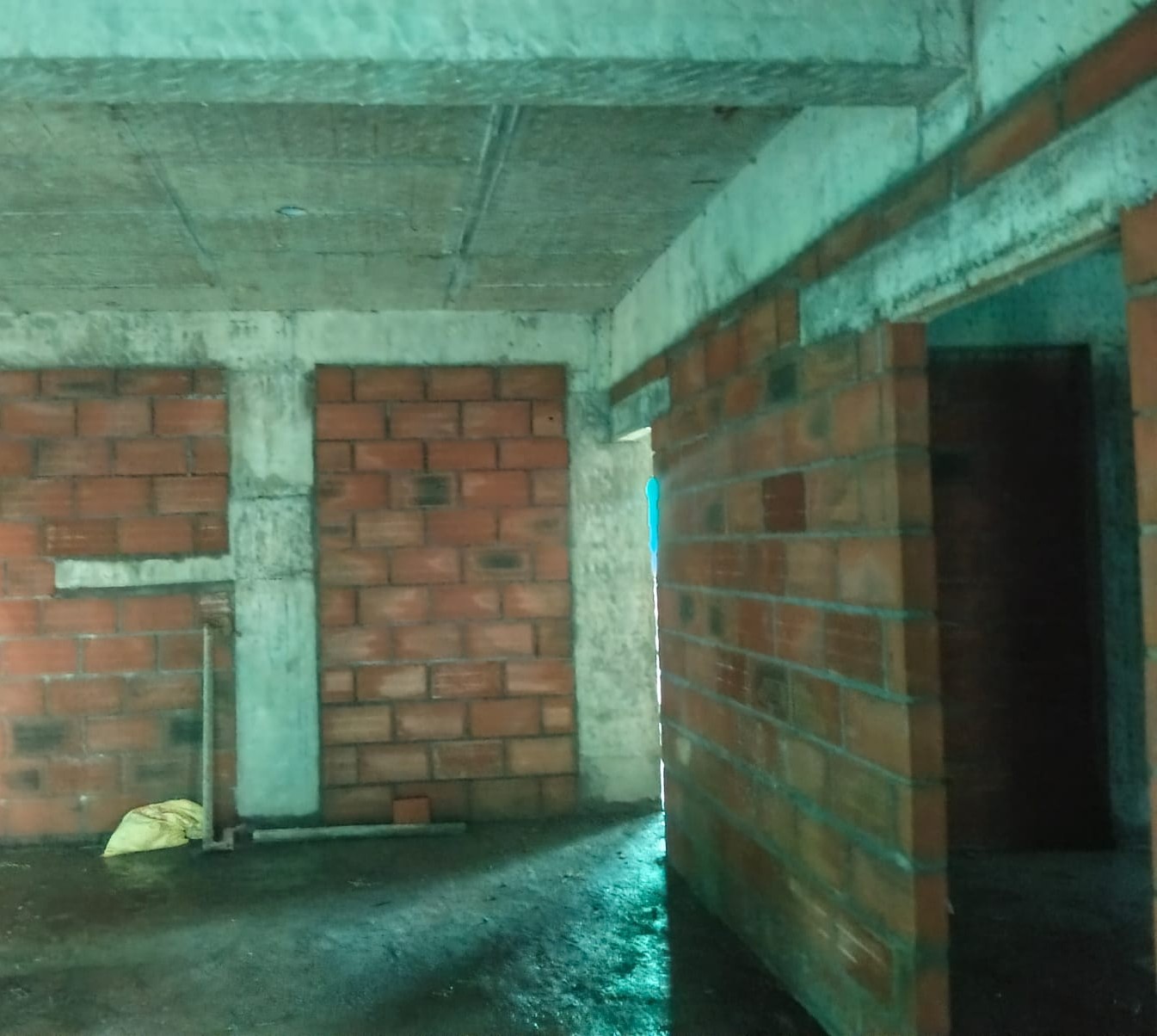

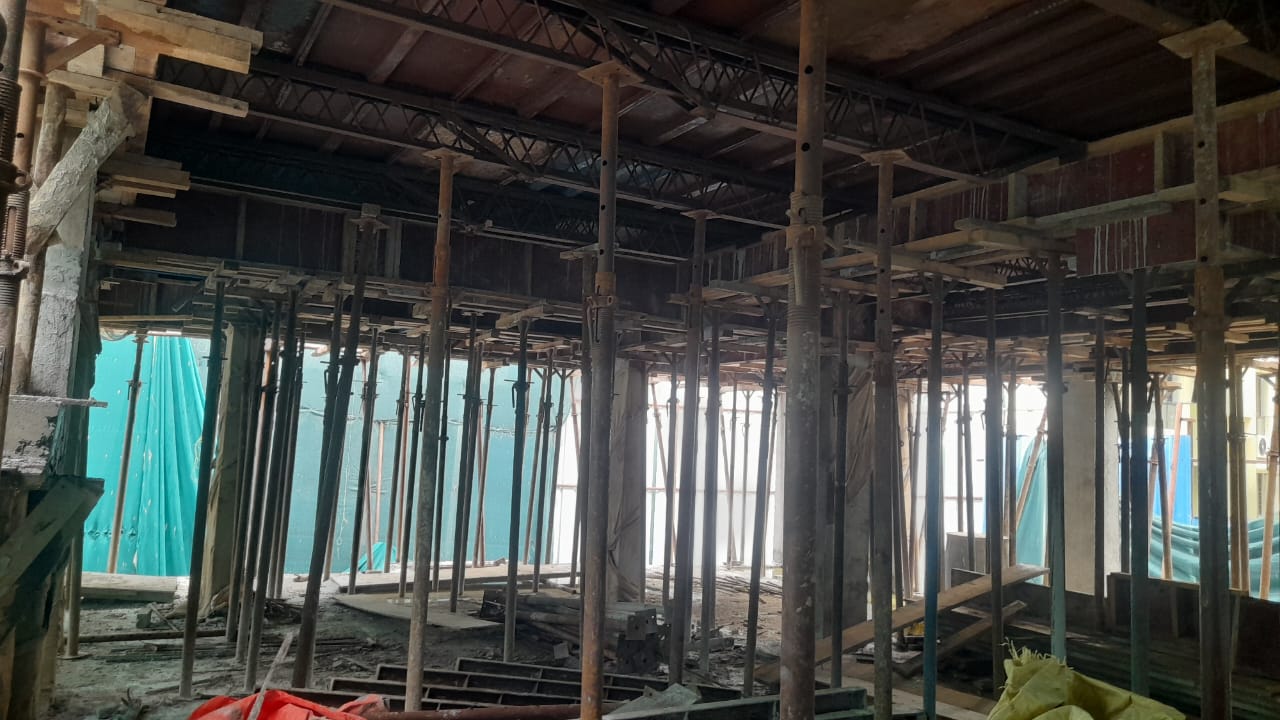

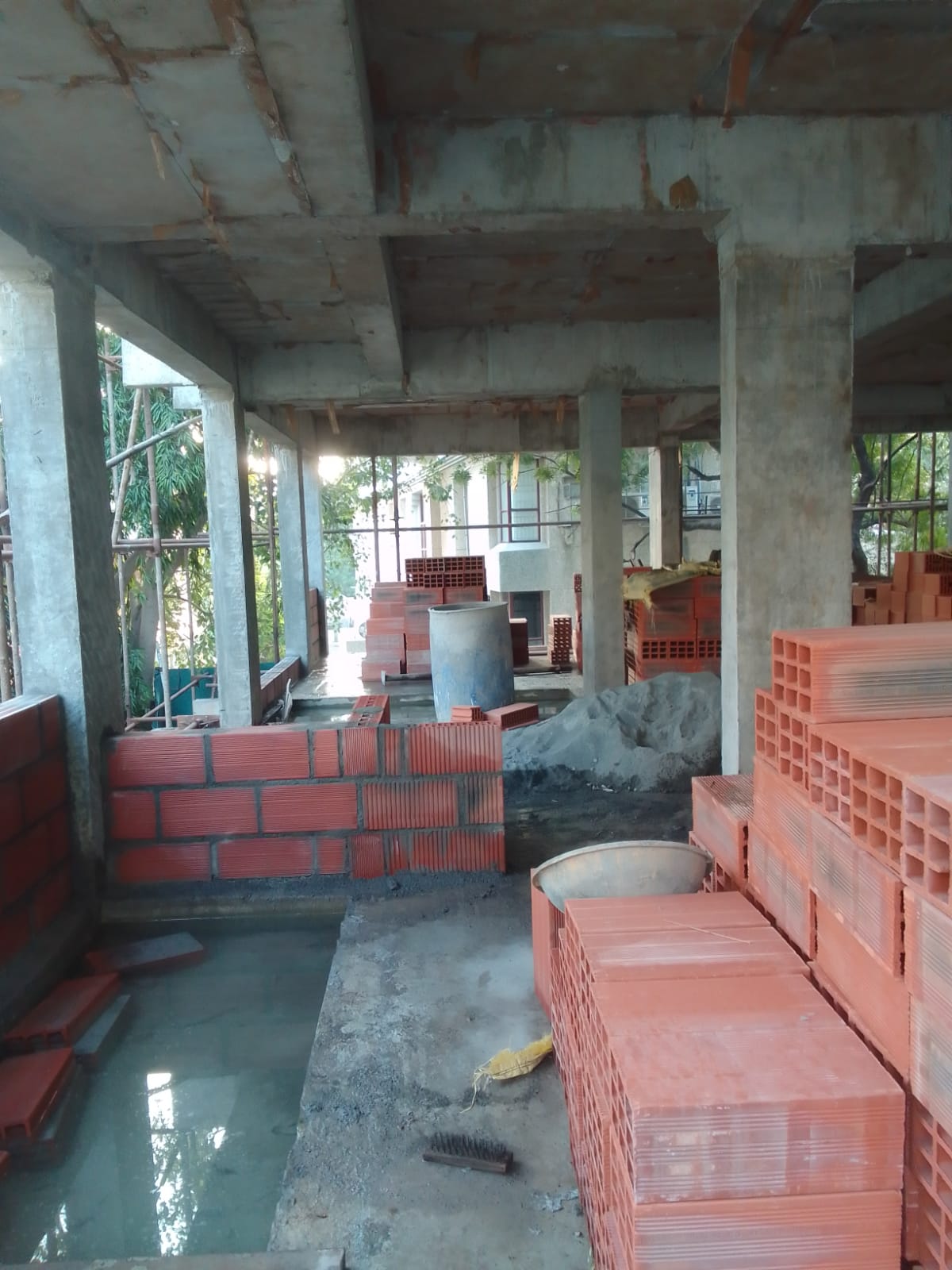

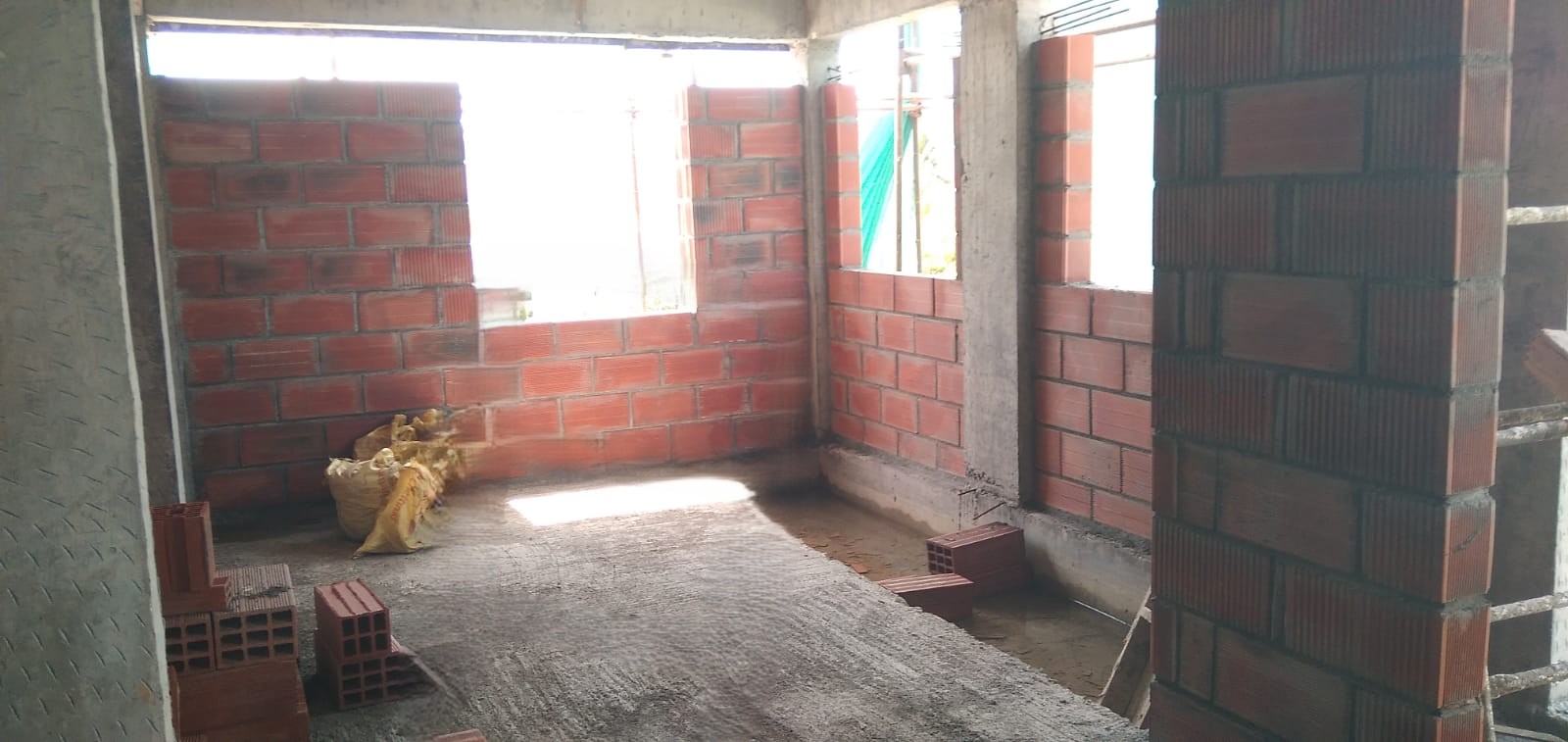

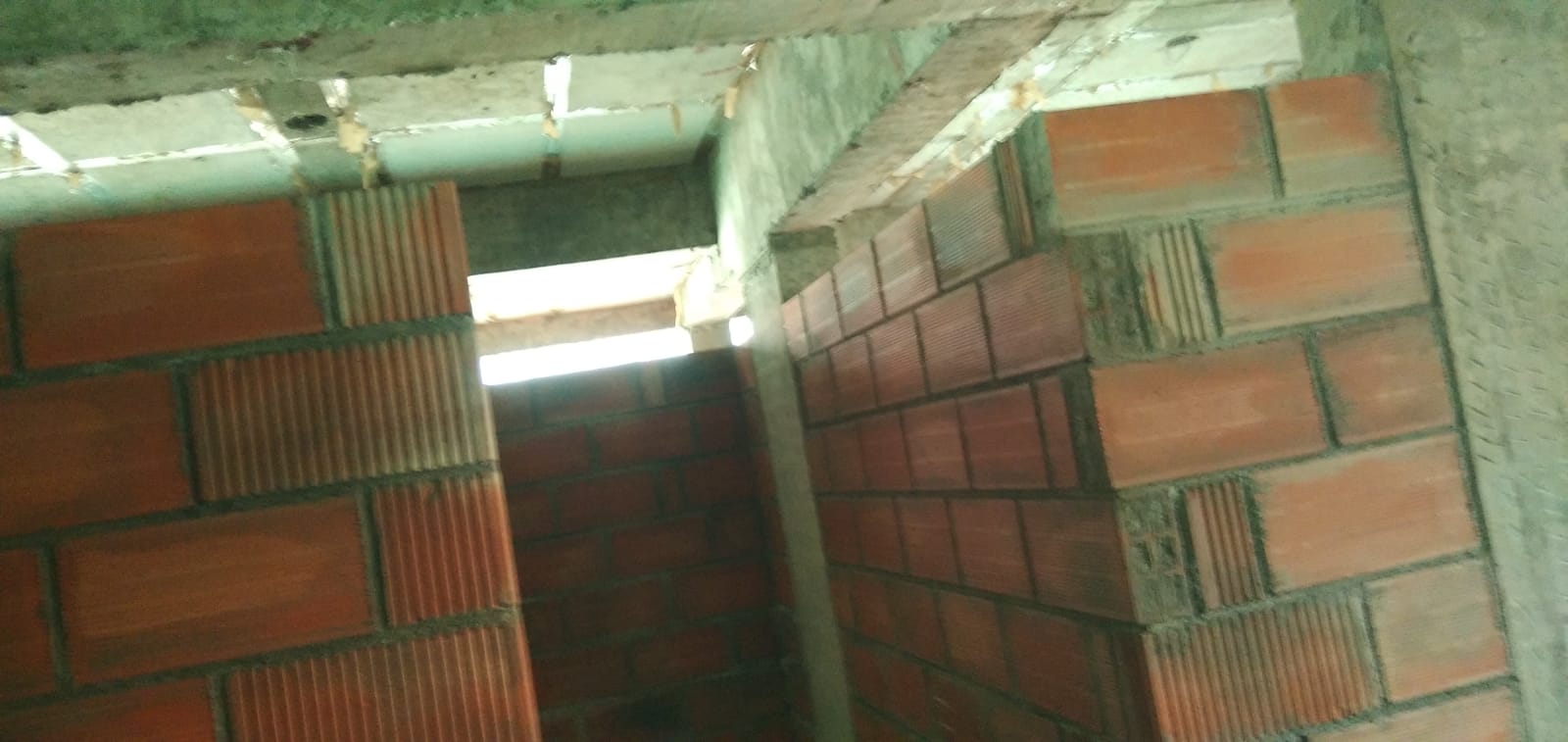

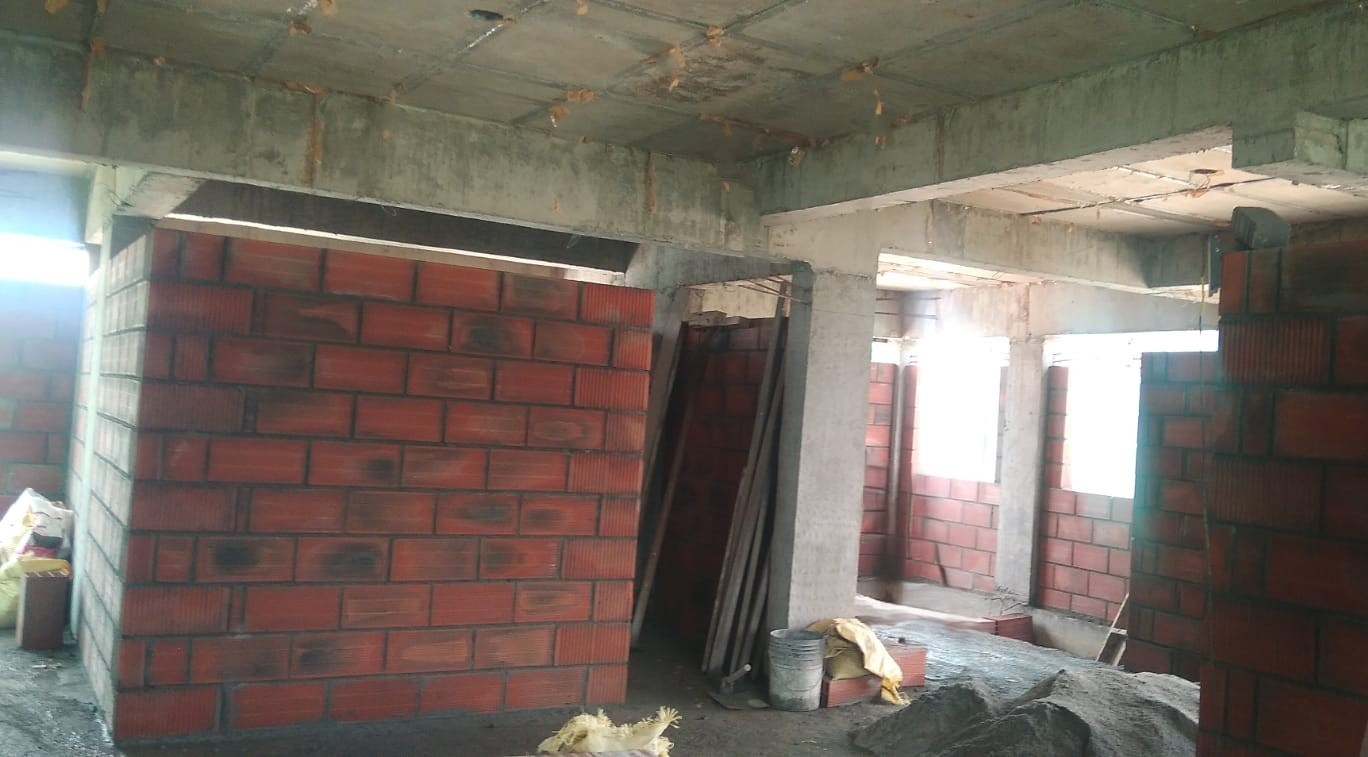

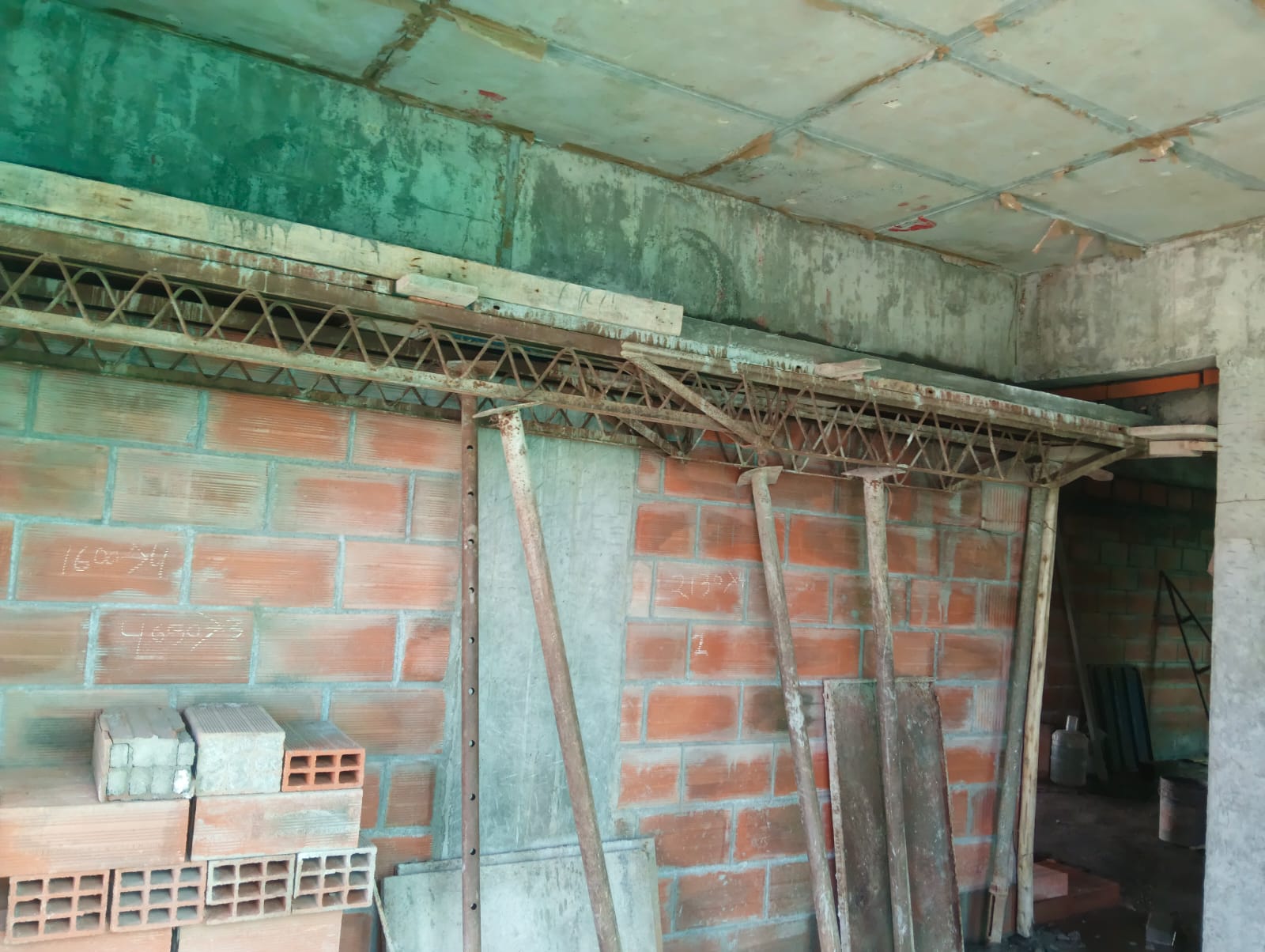

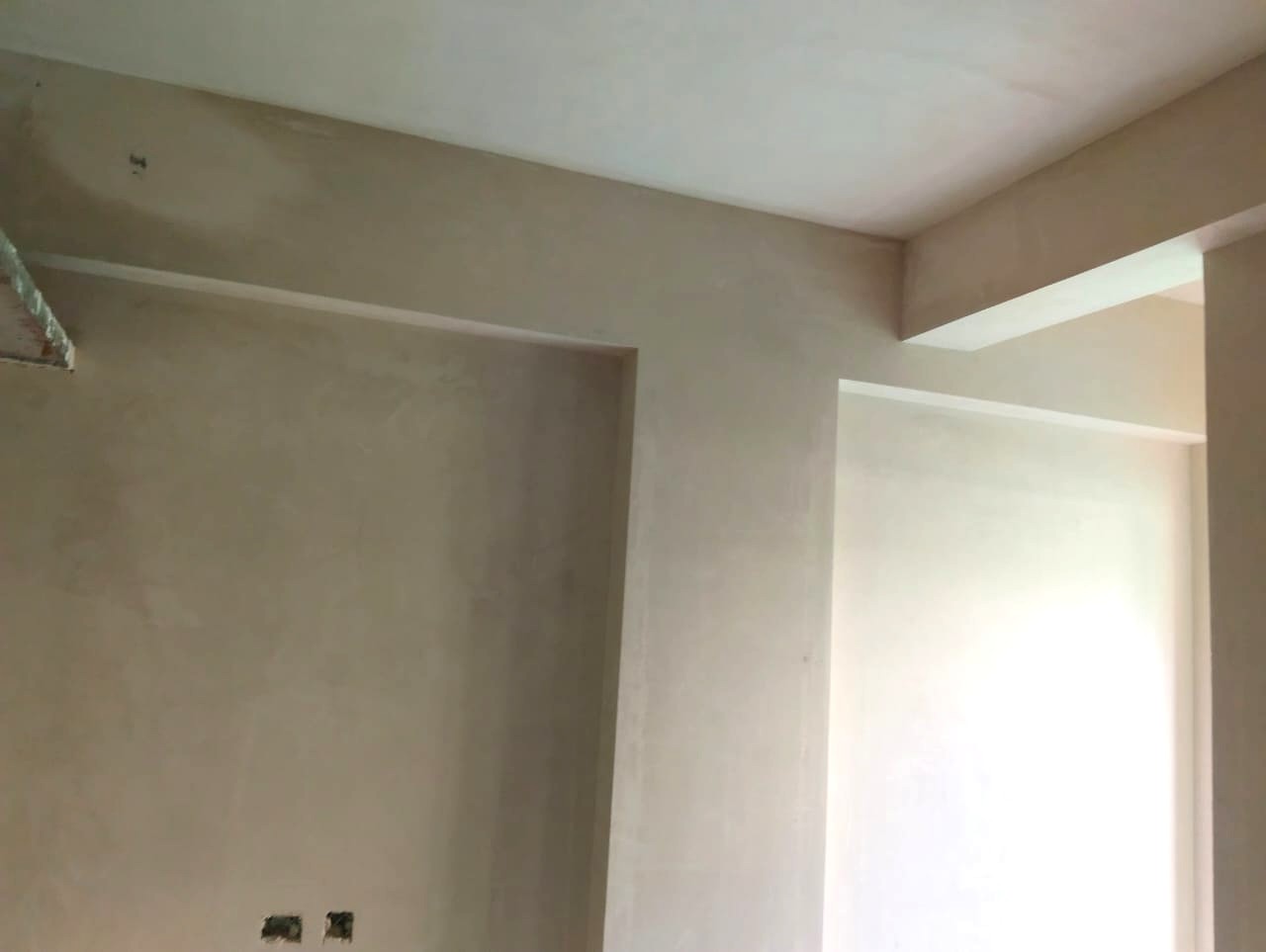

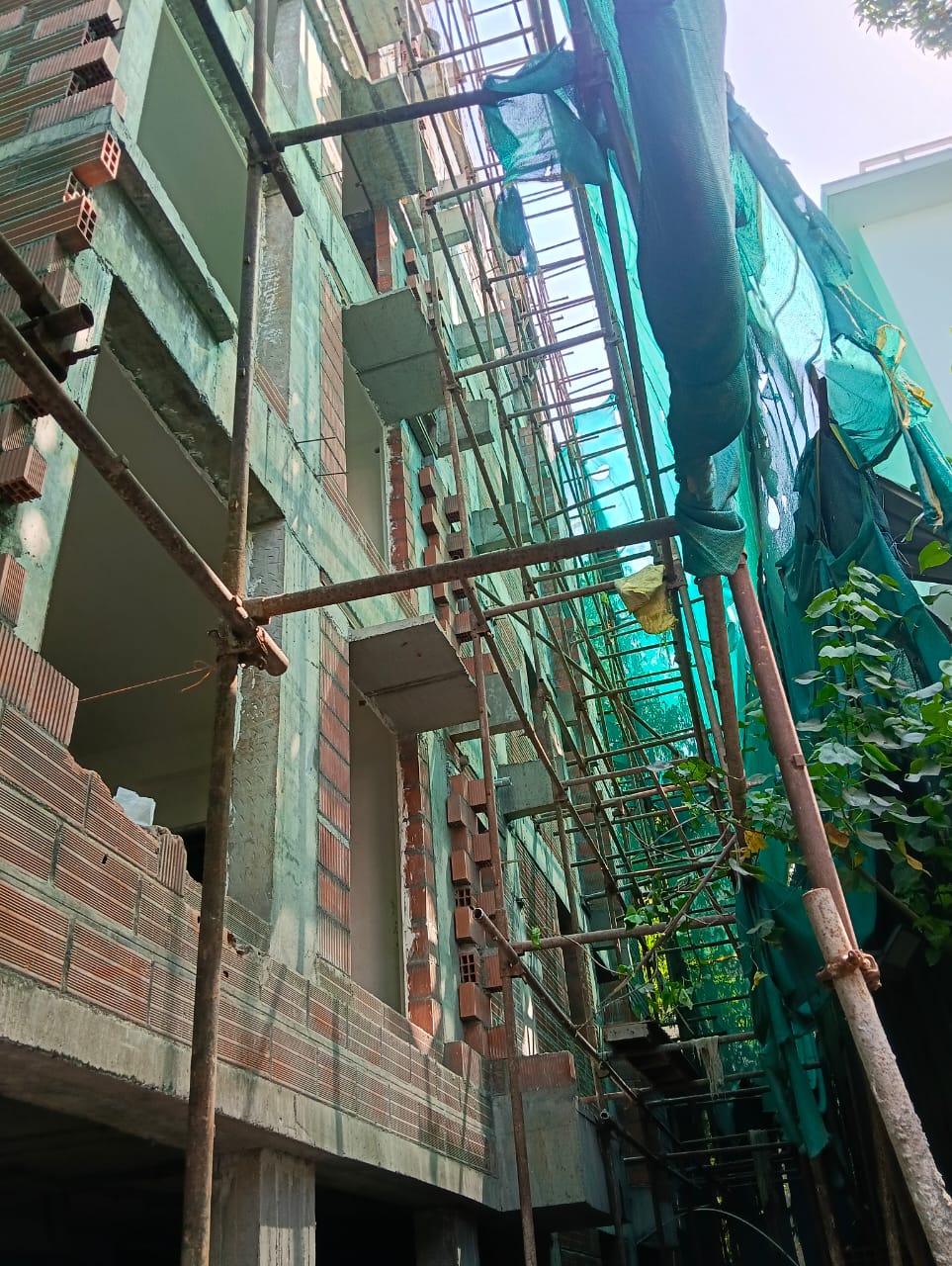

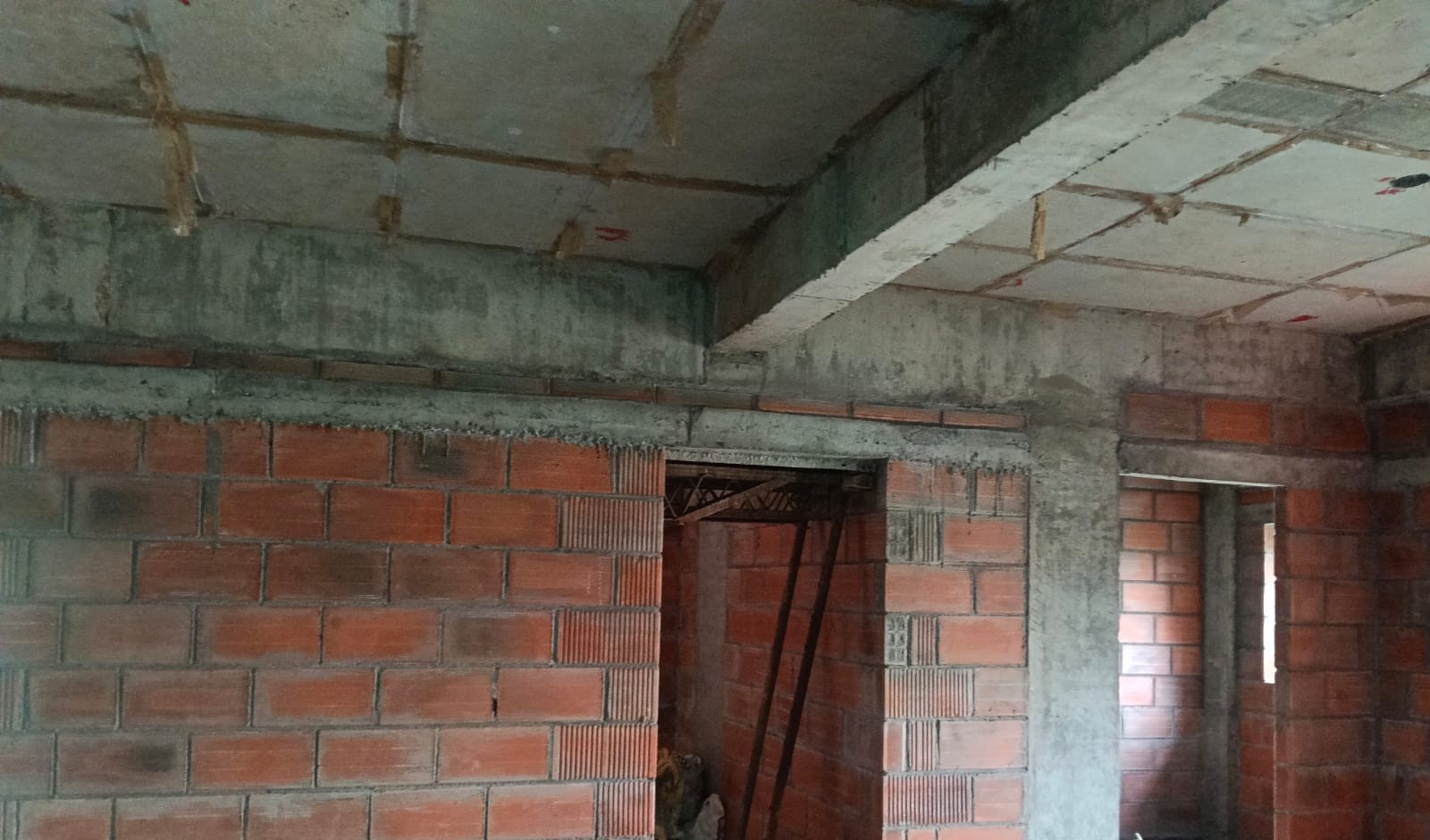

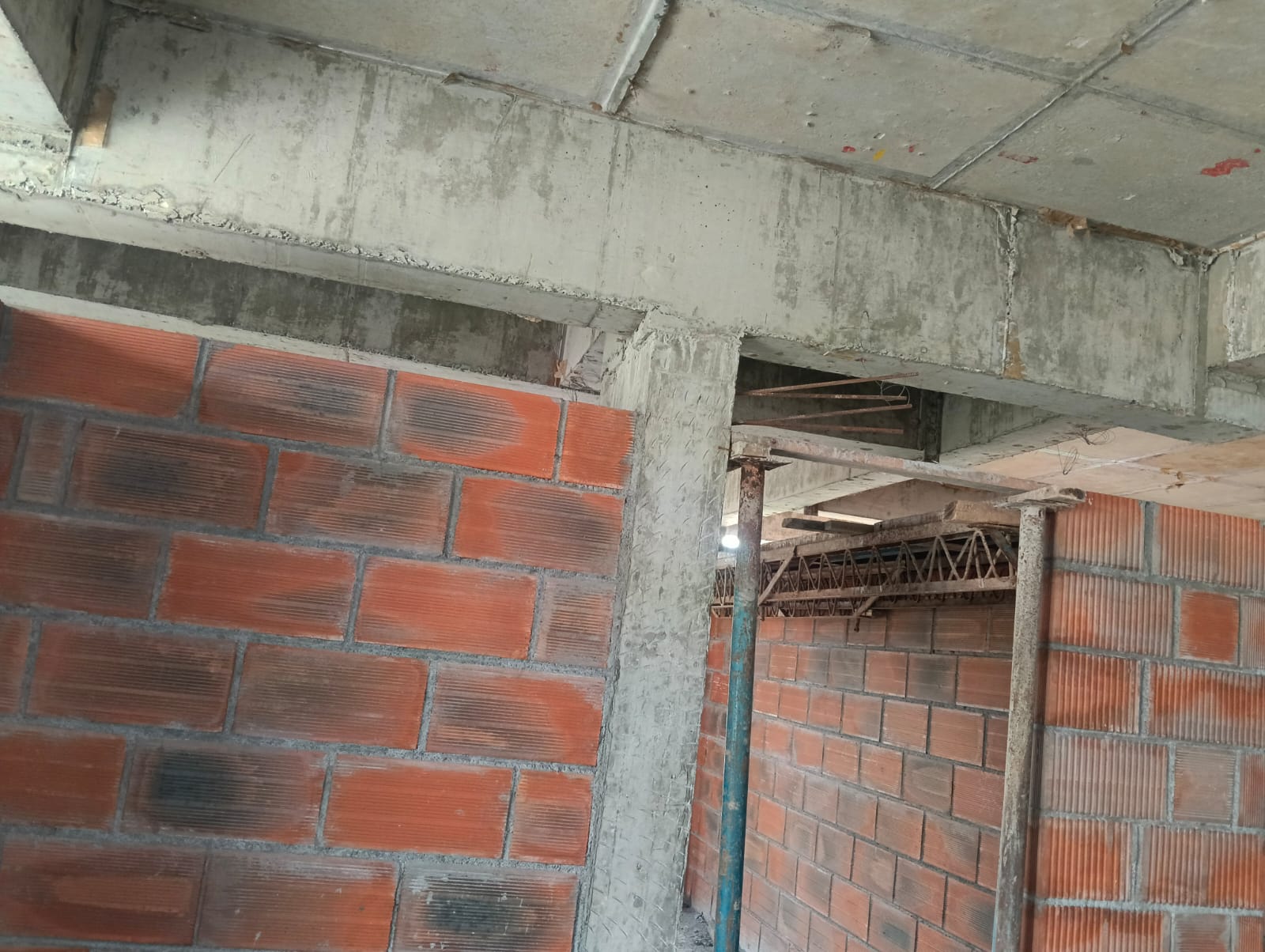

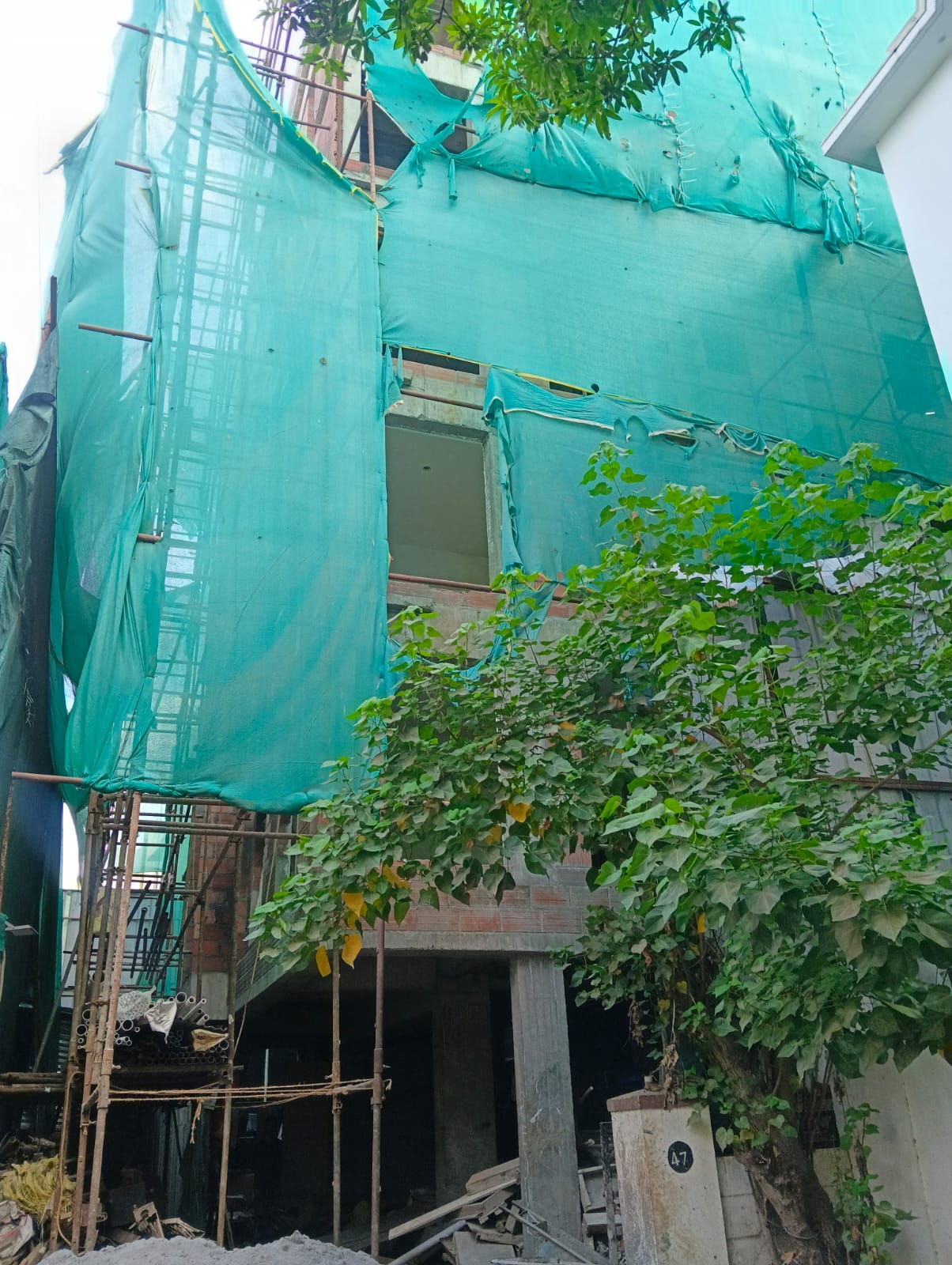

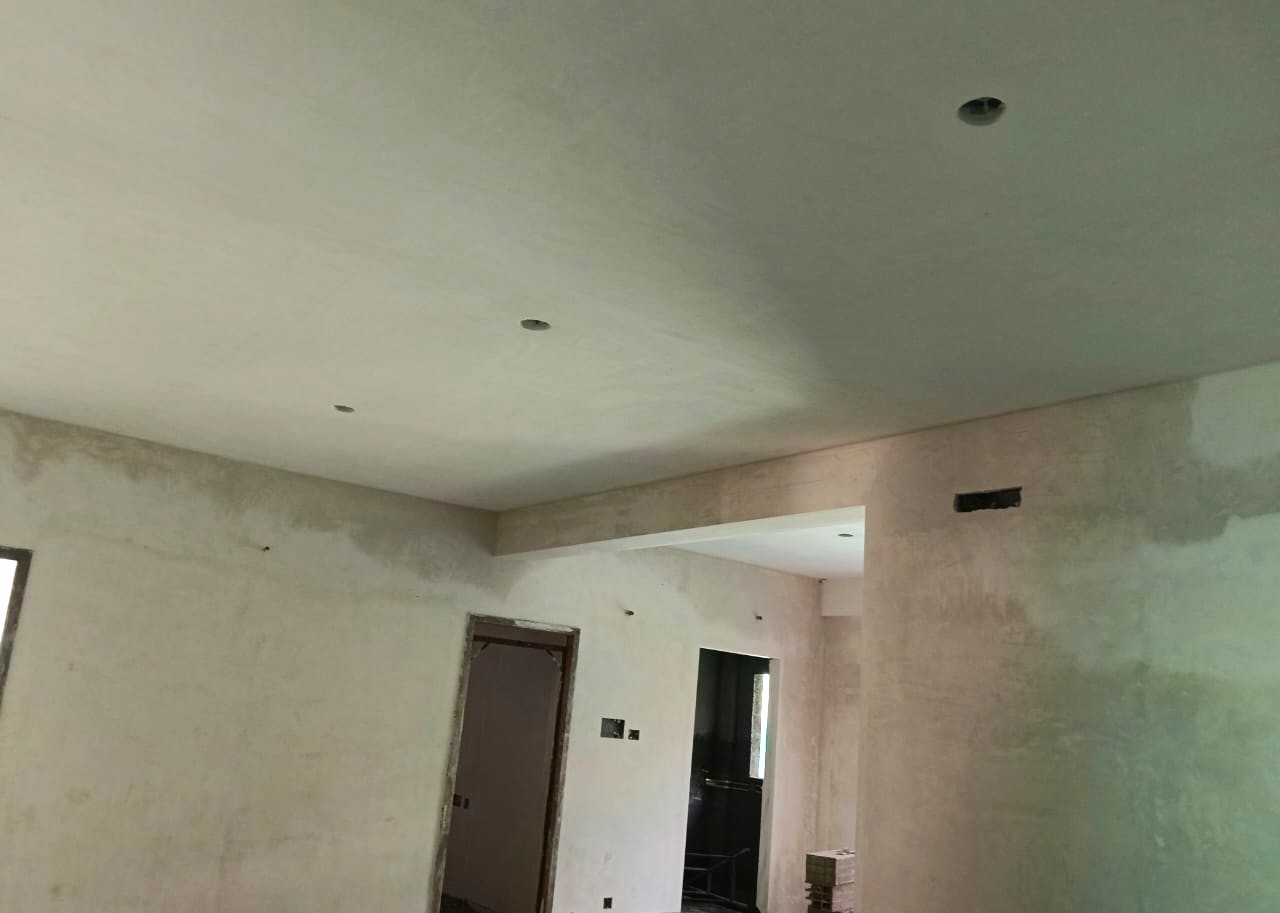

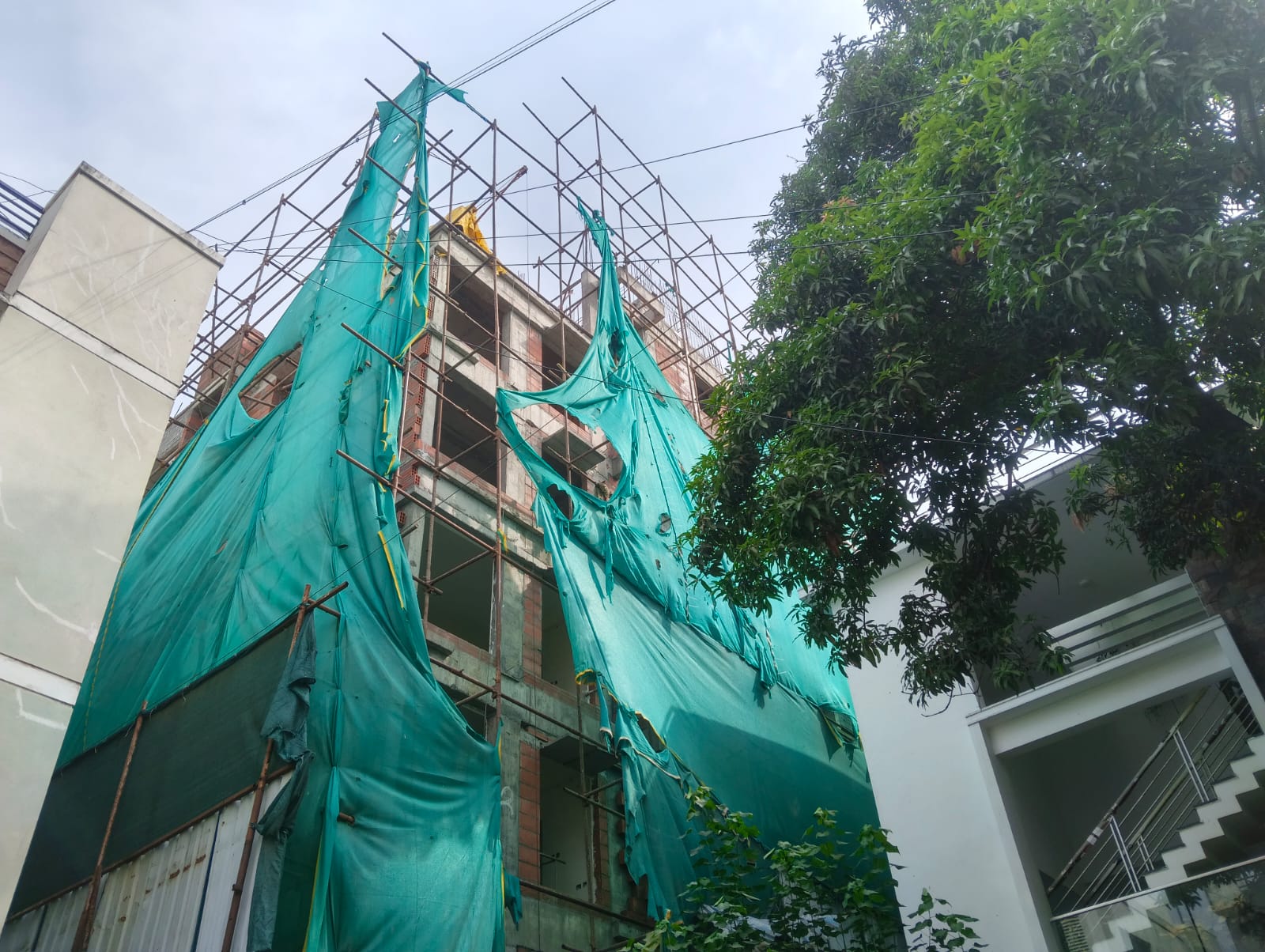

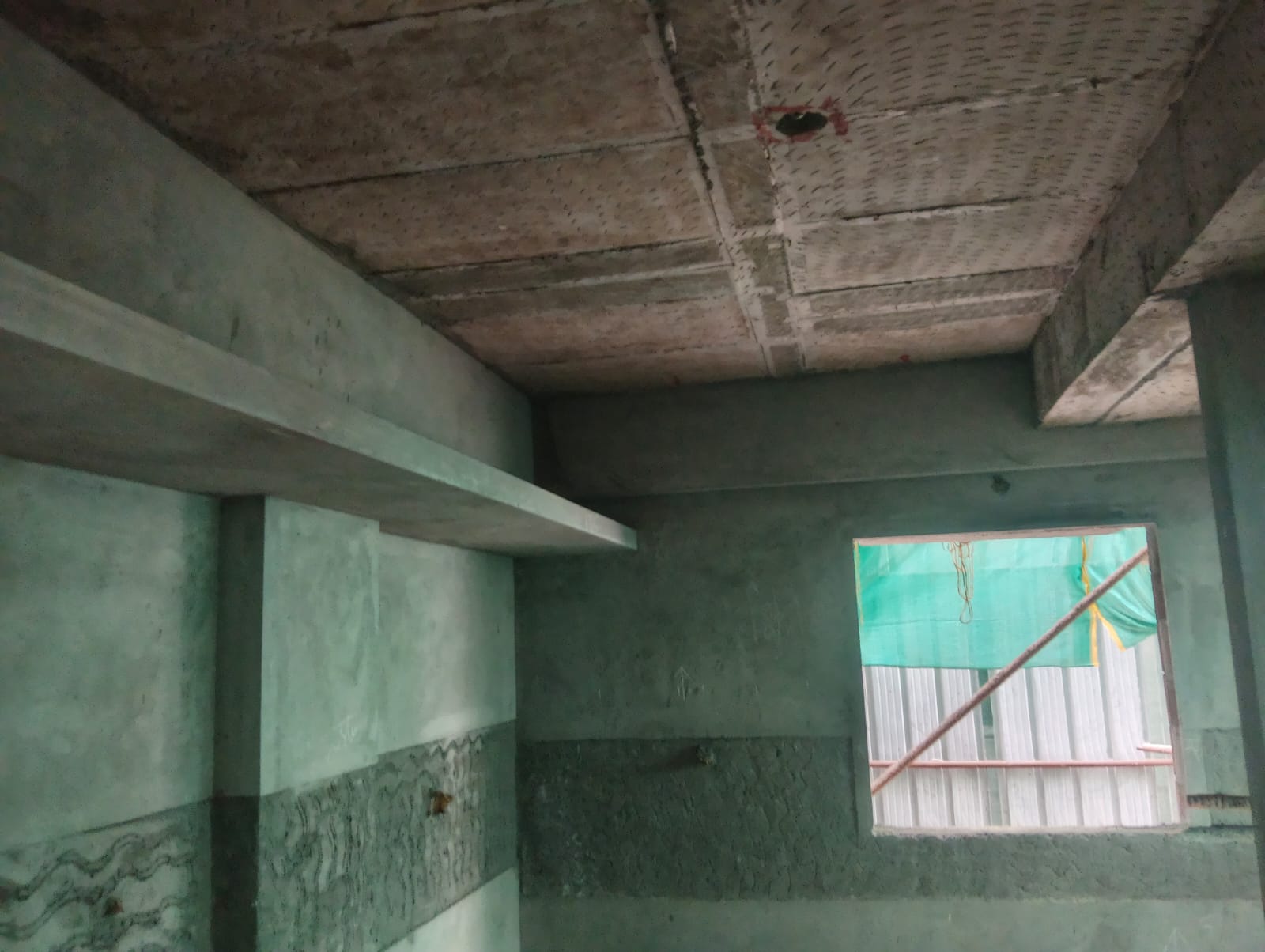

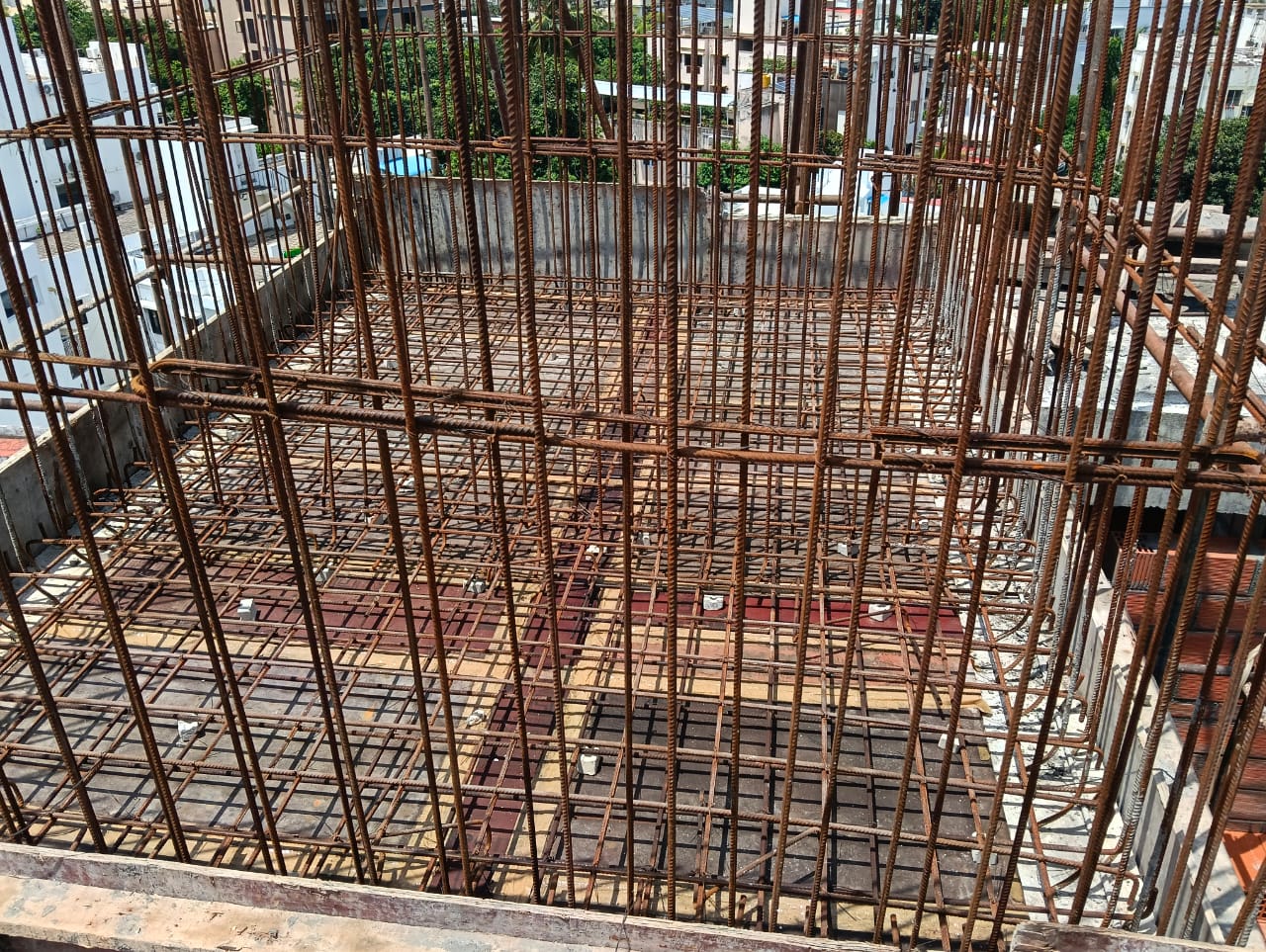

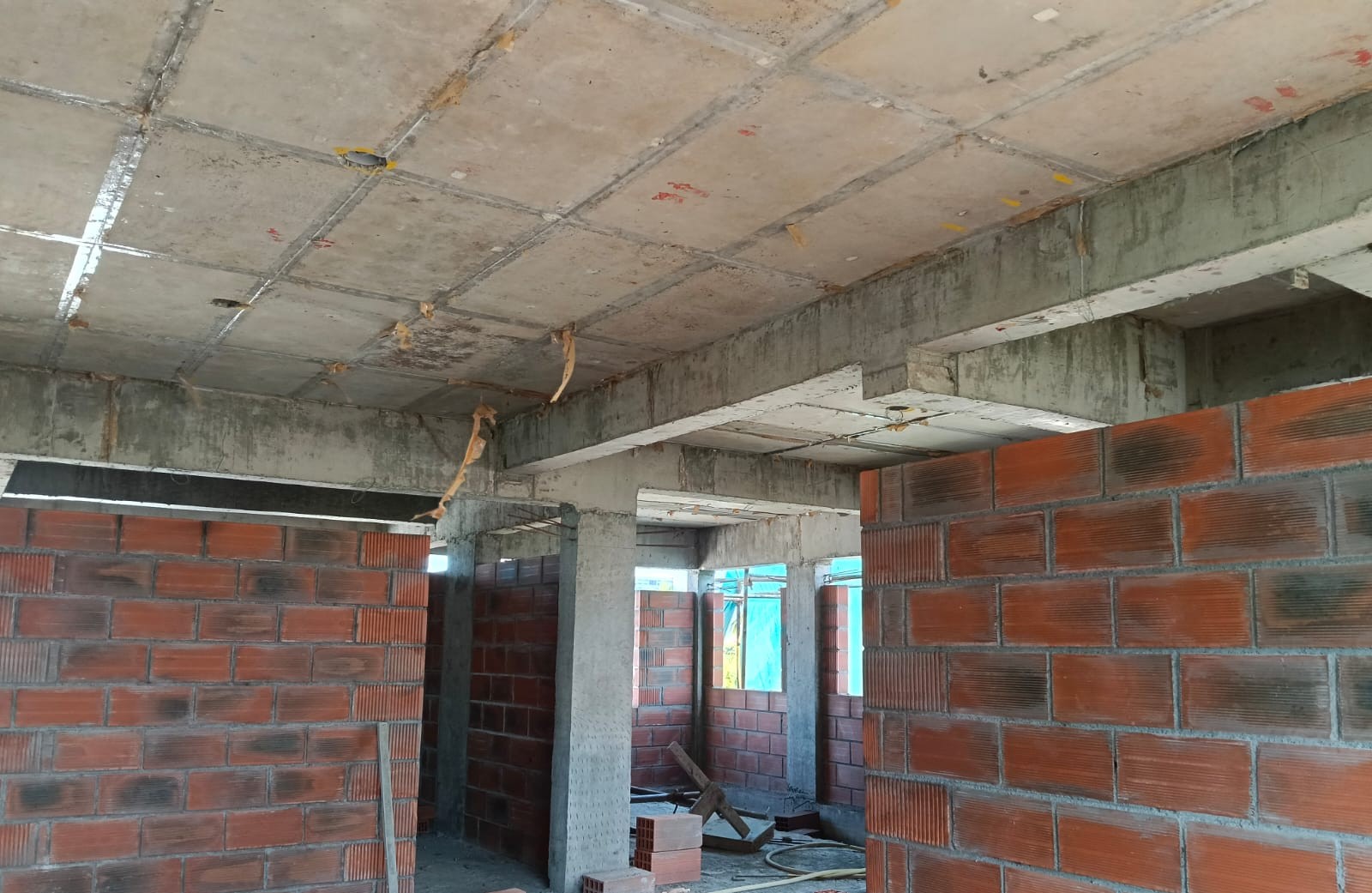

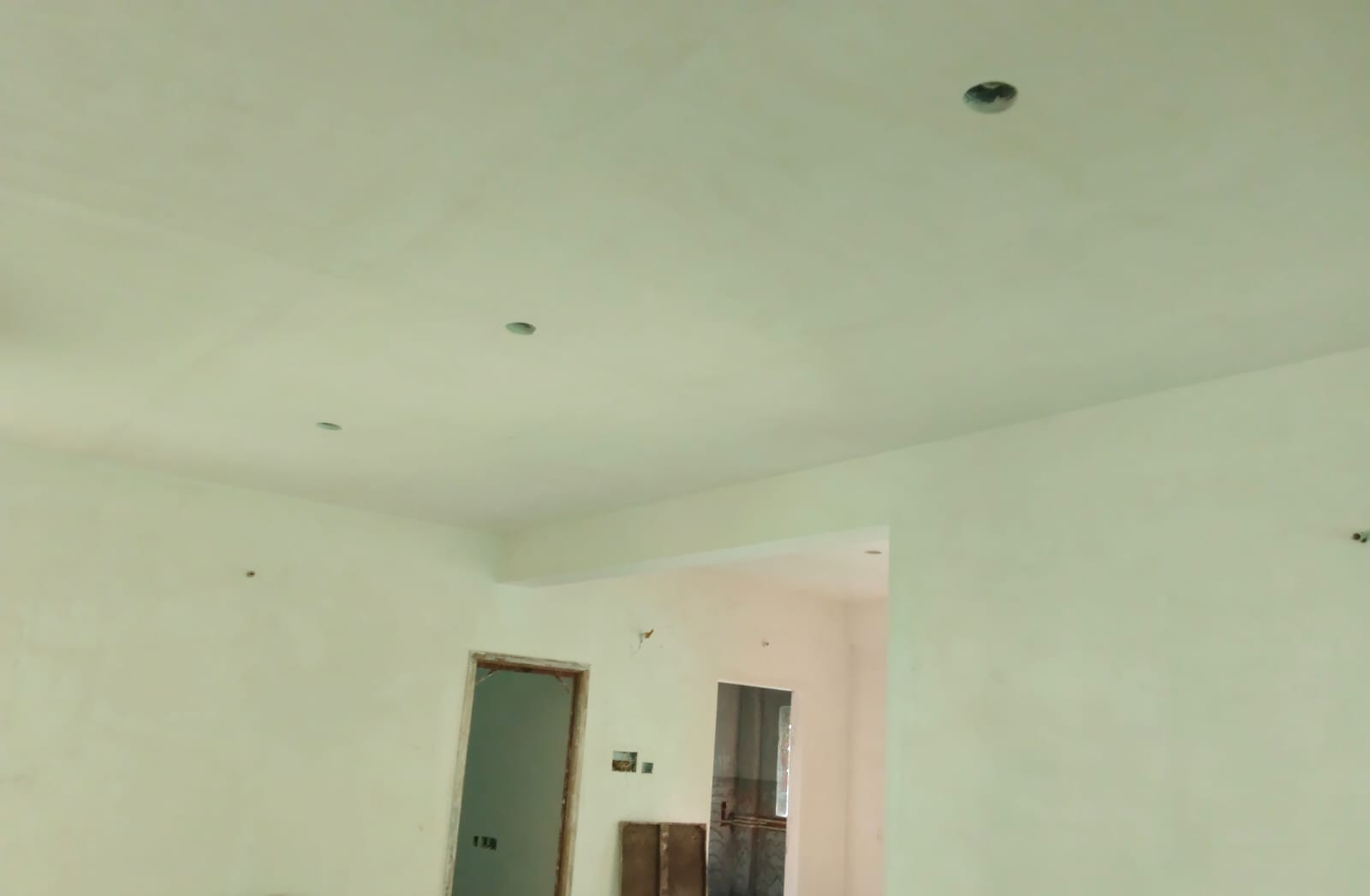

Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image

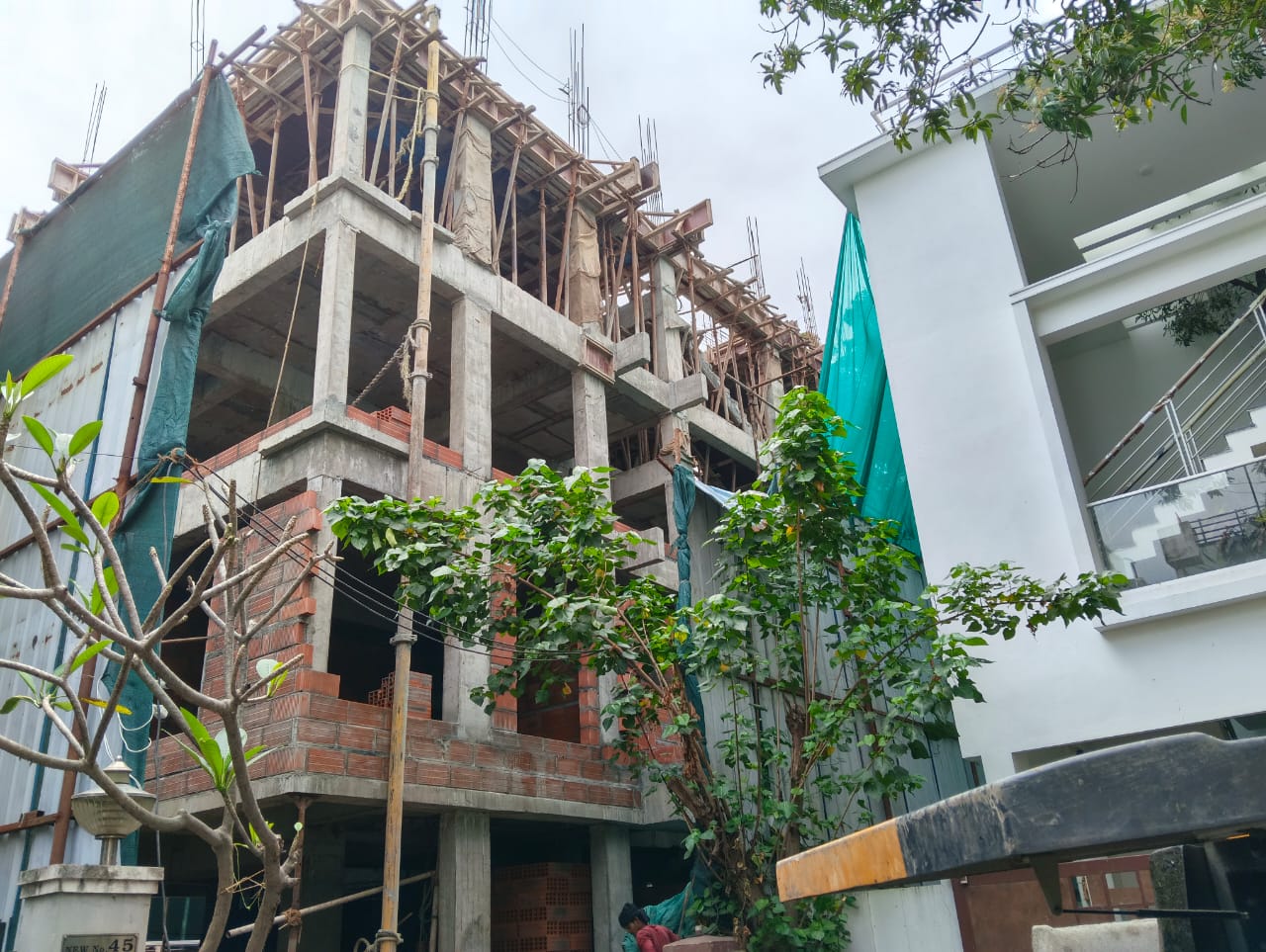

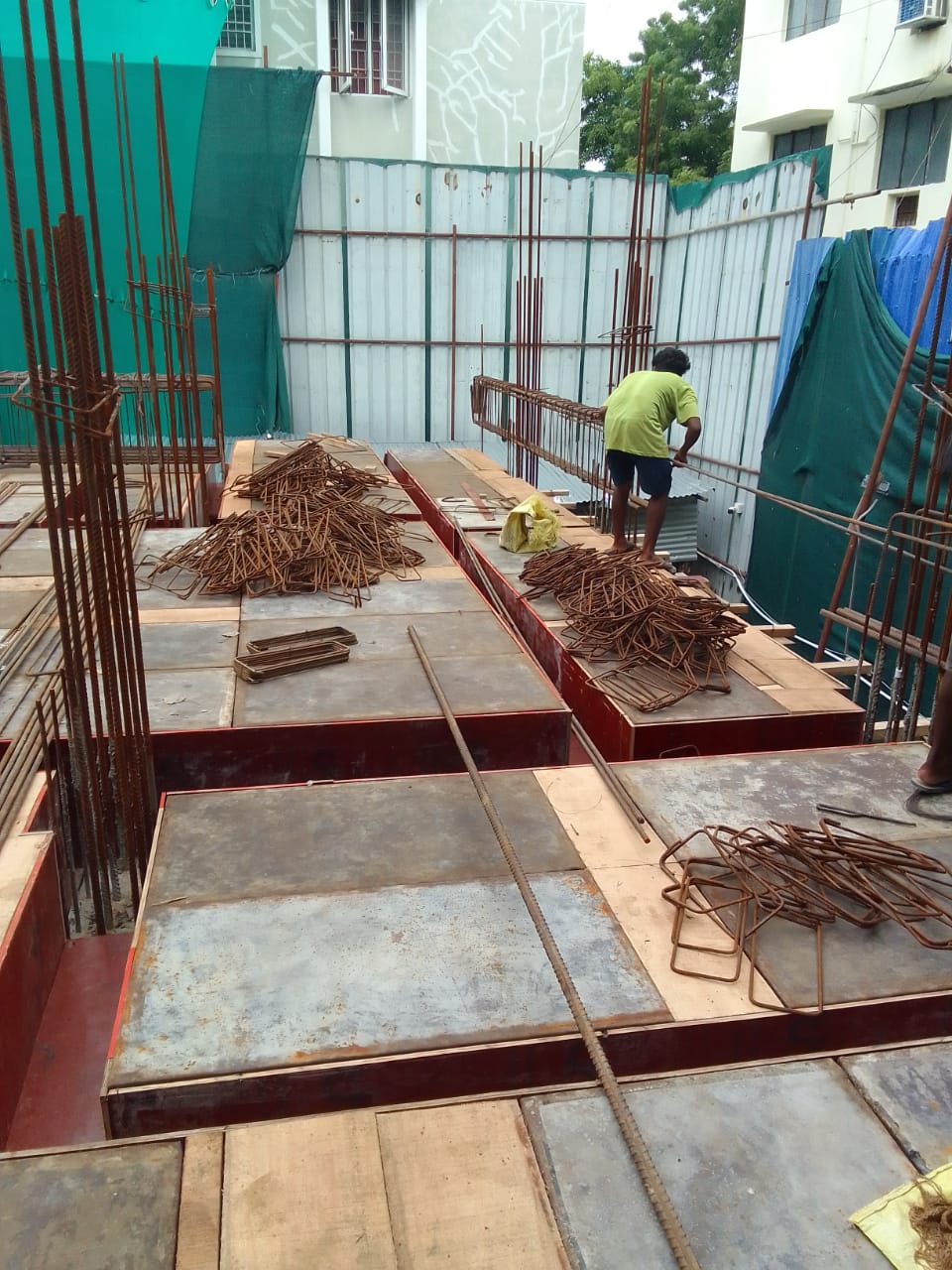

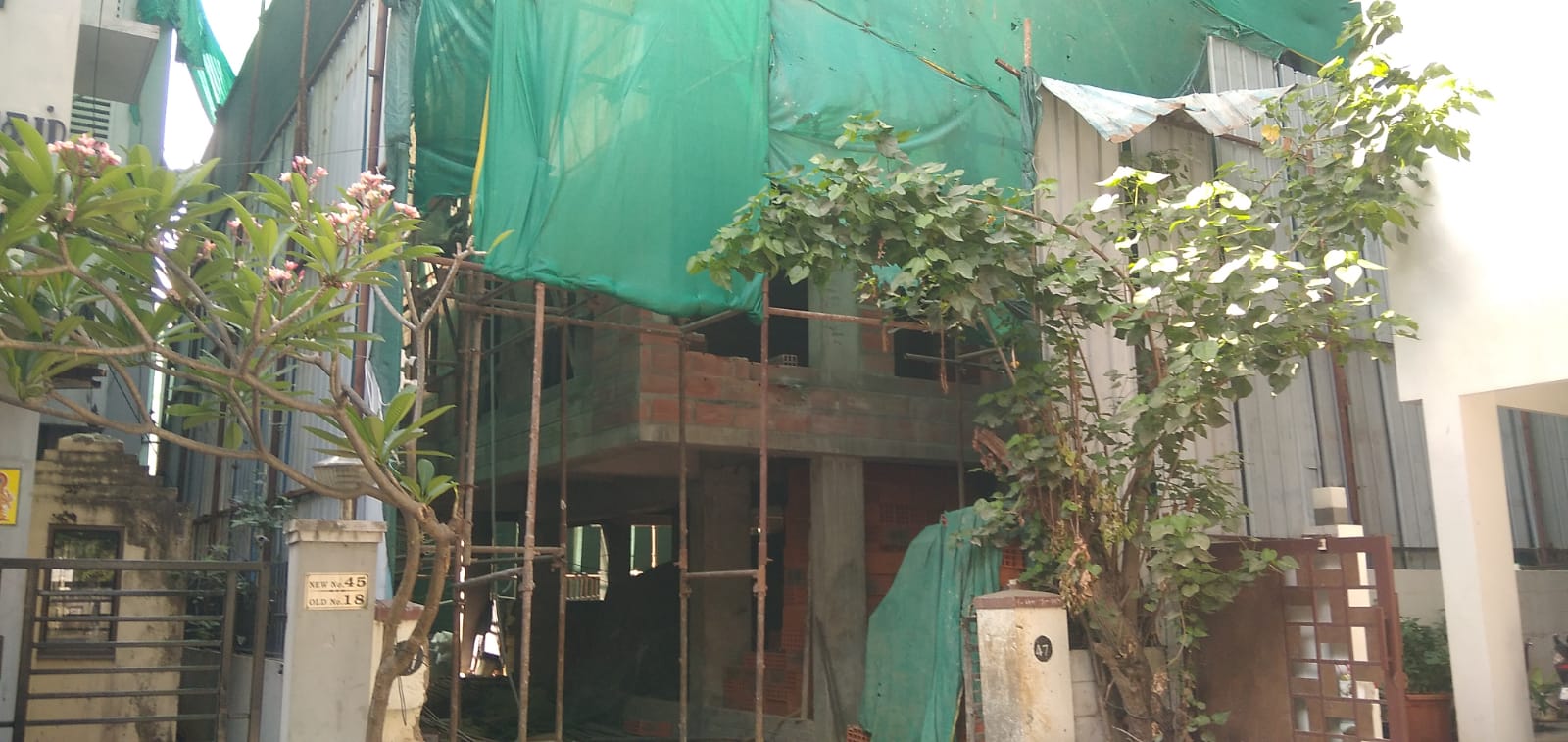

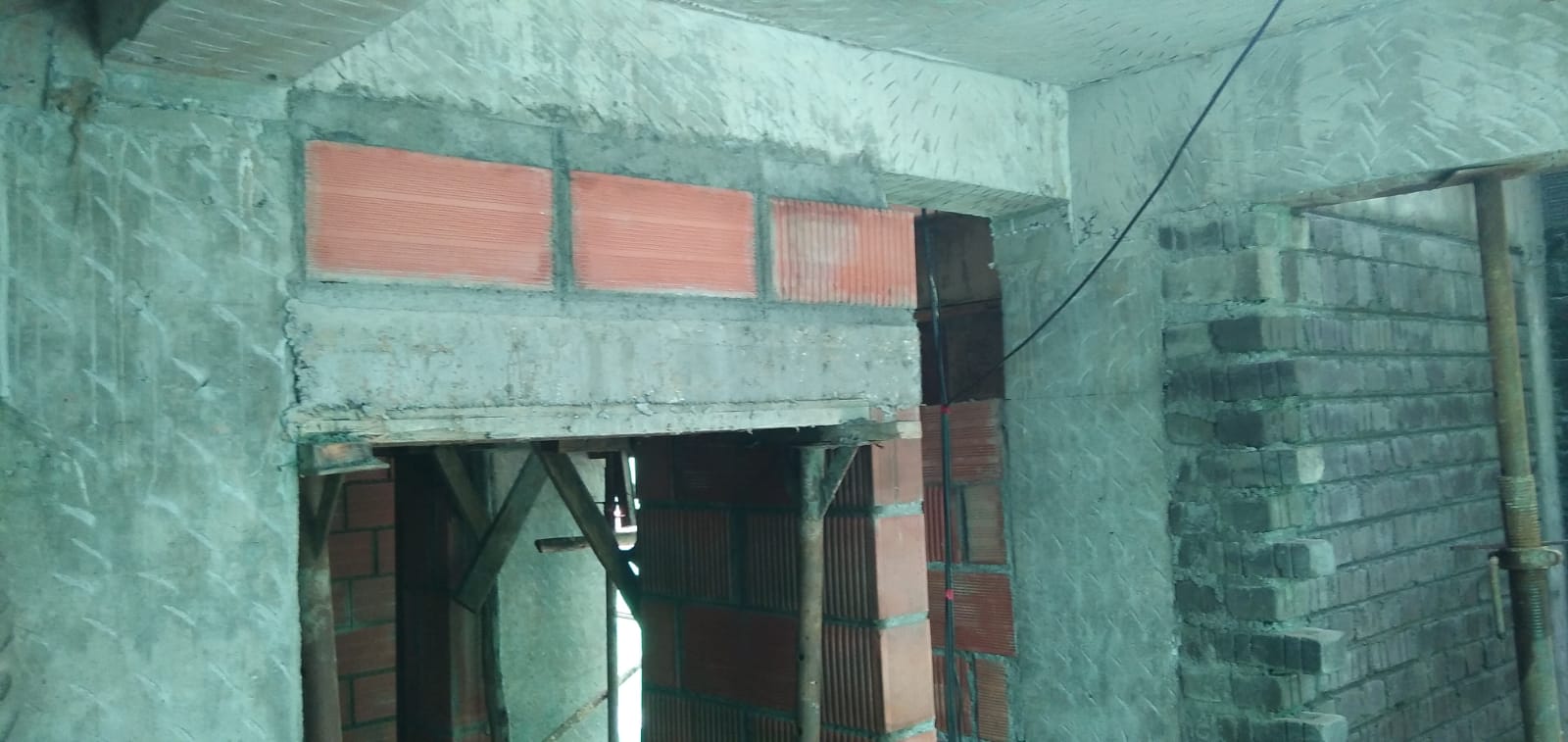

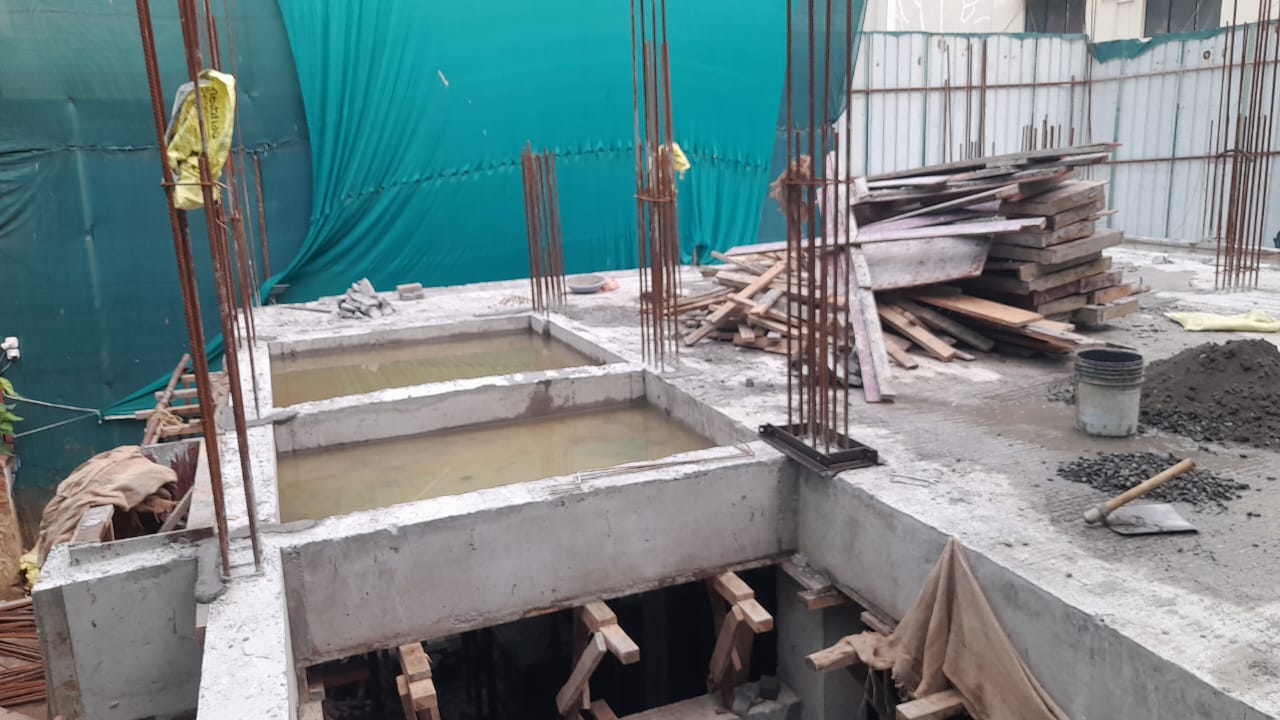

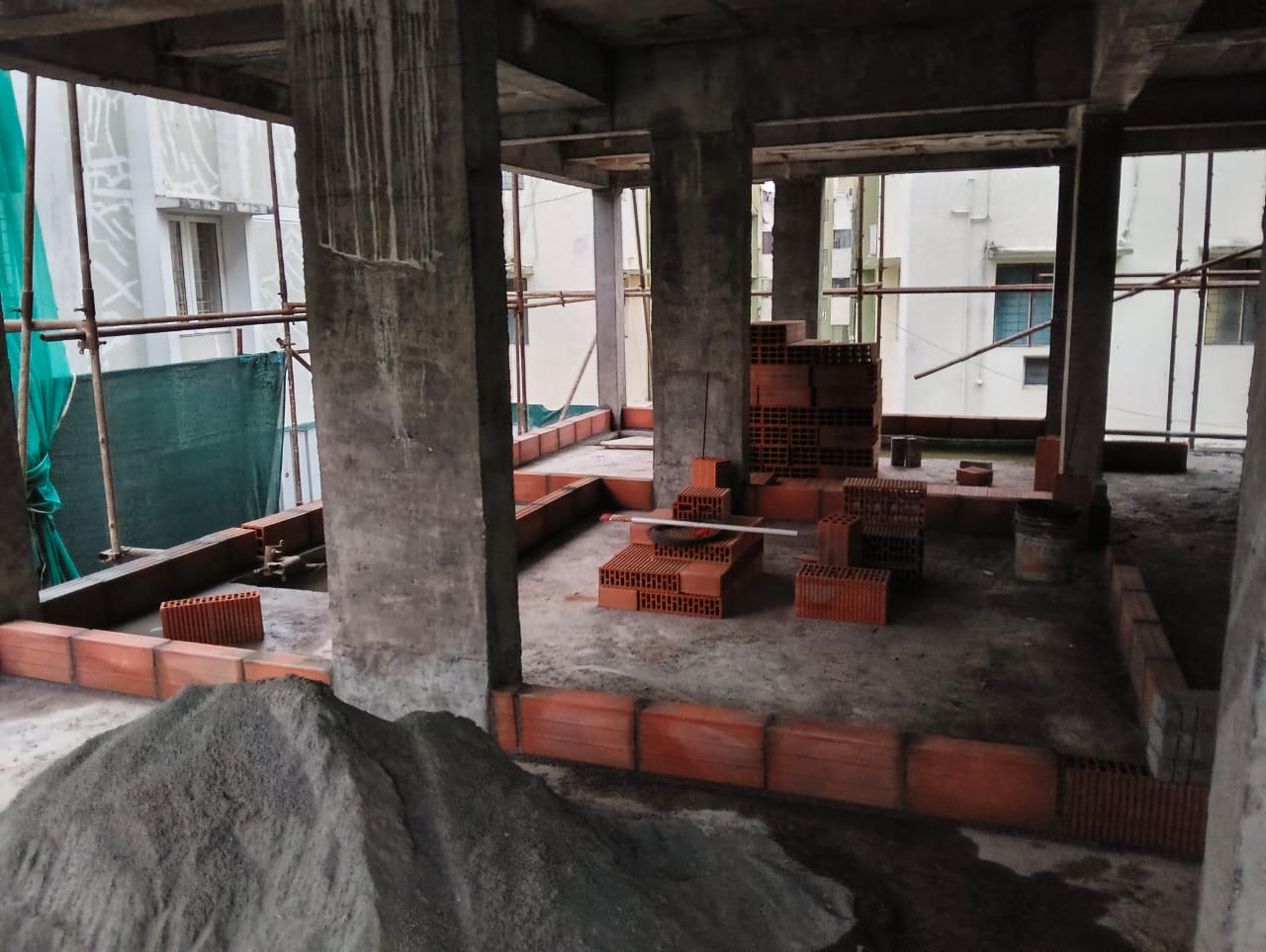

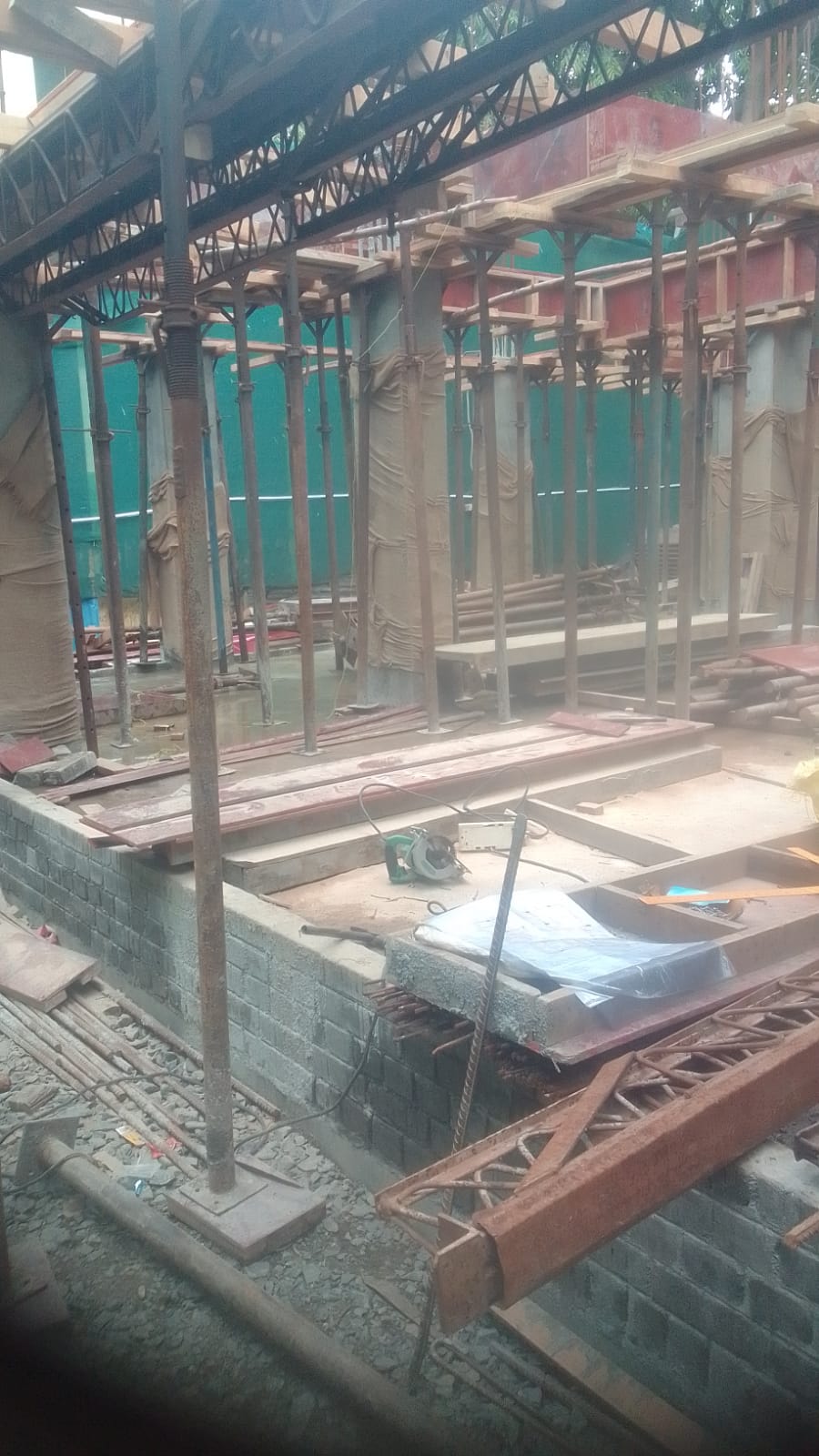

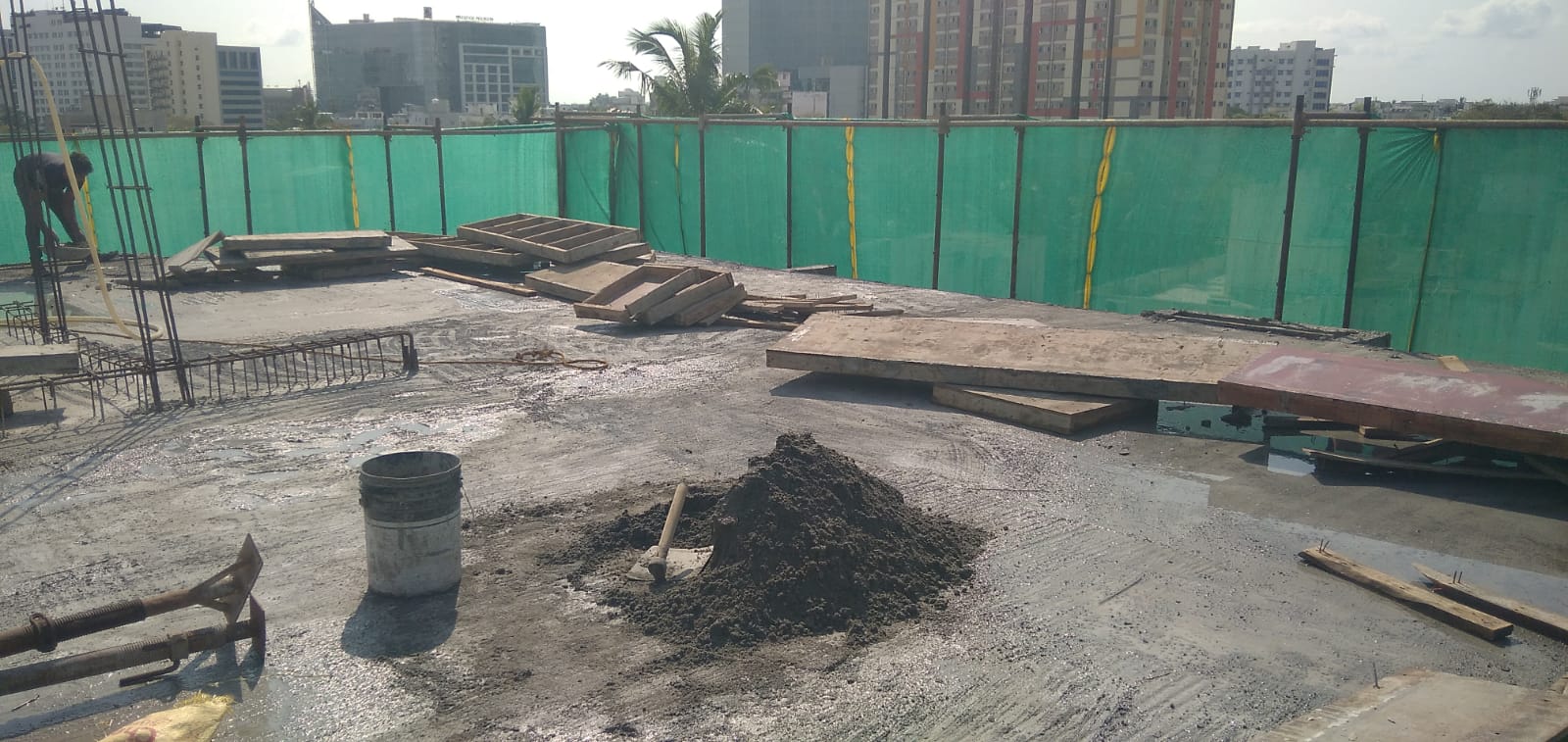

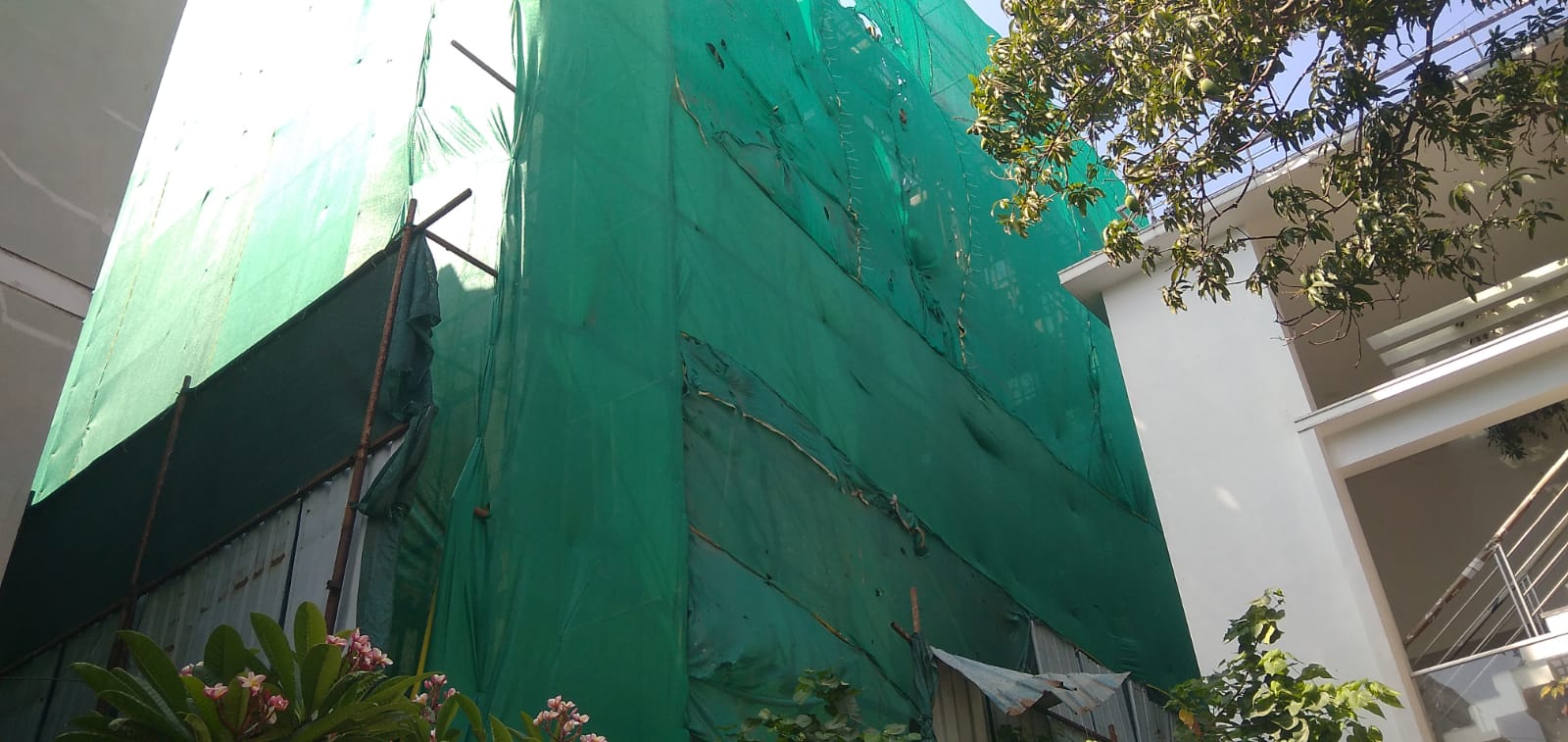

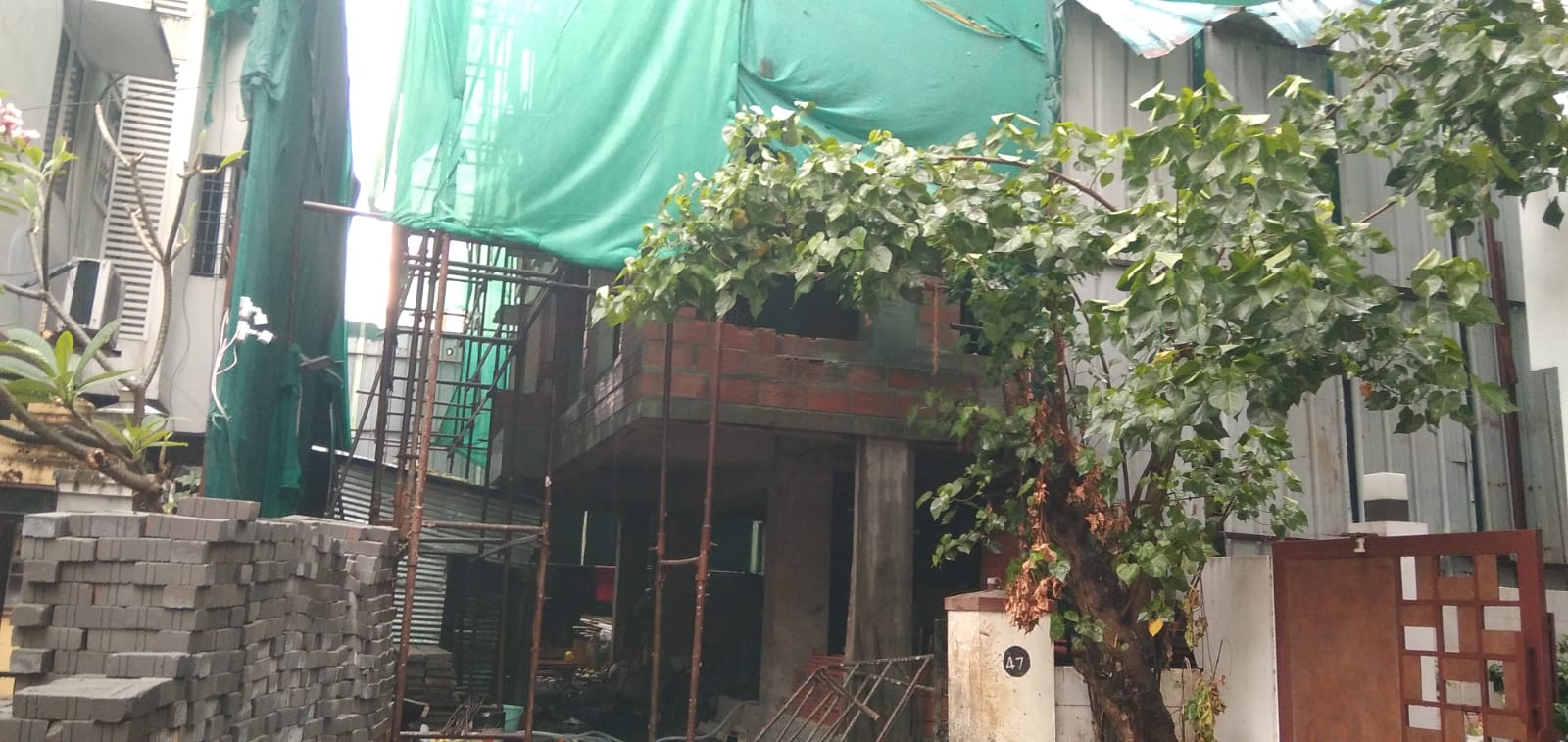

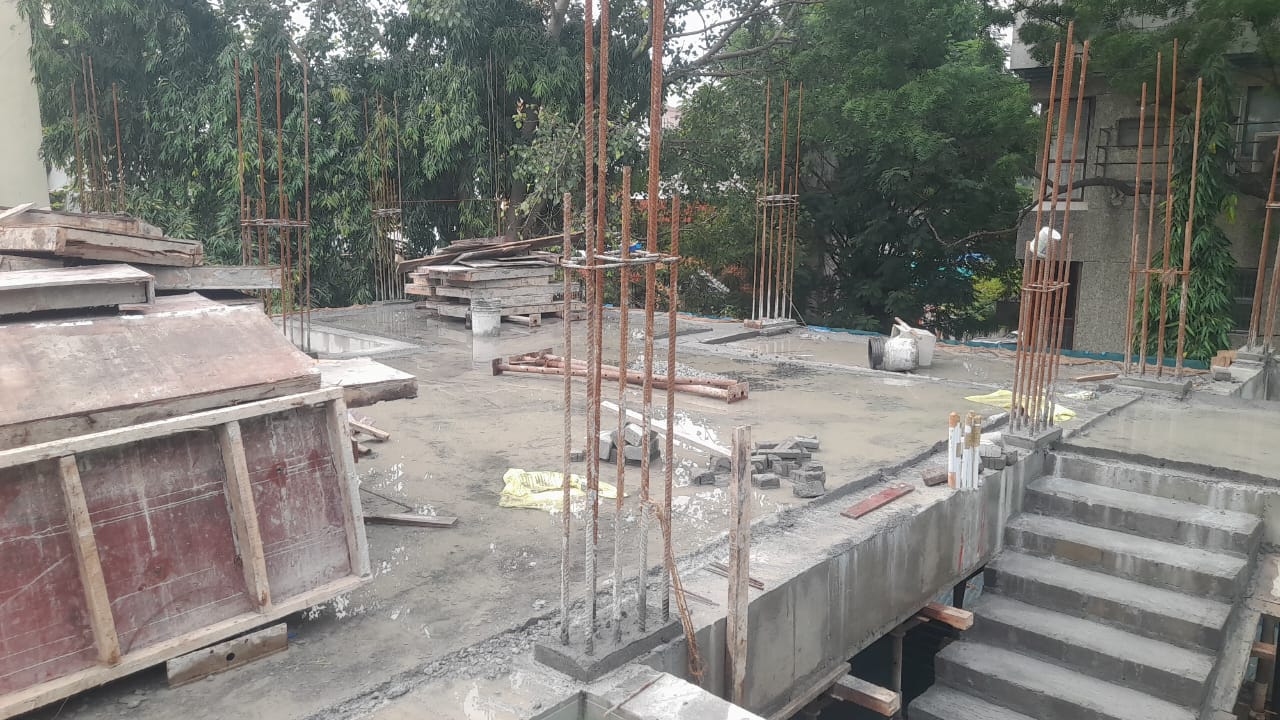

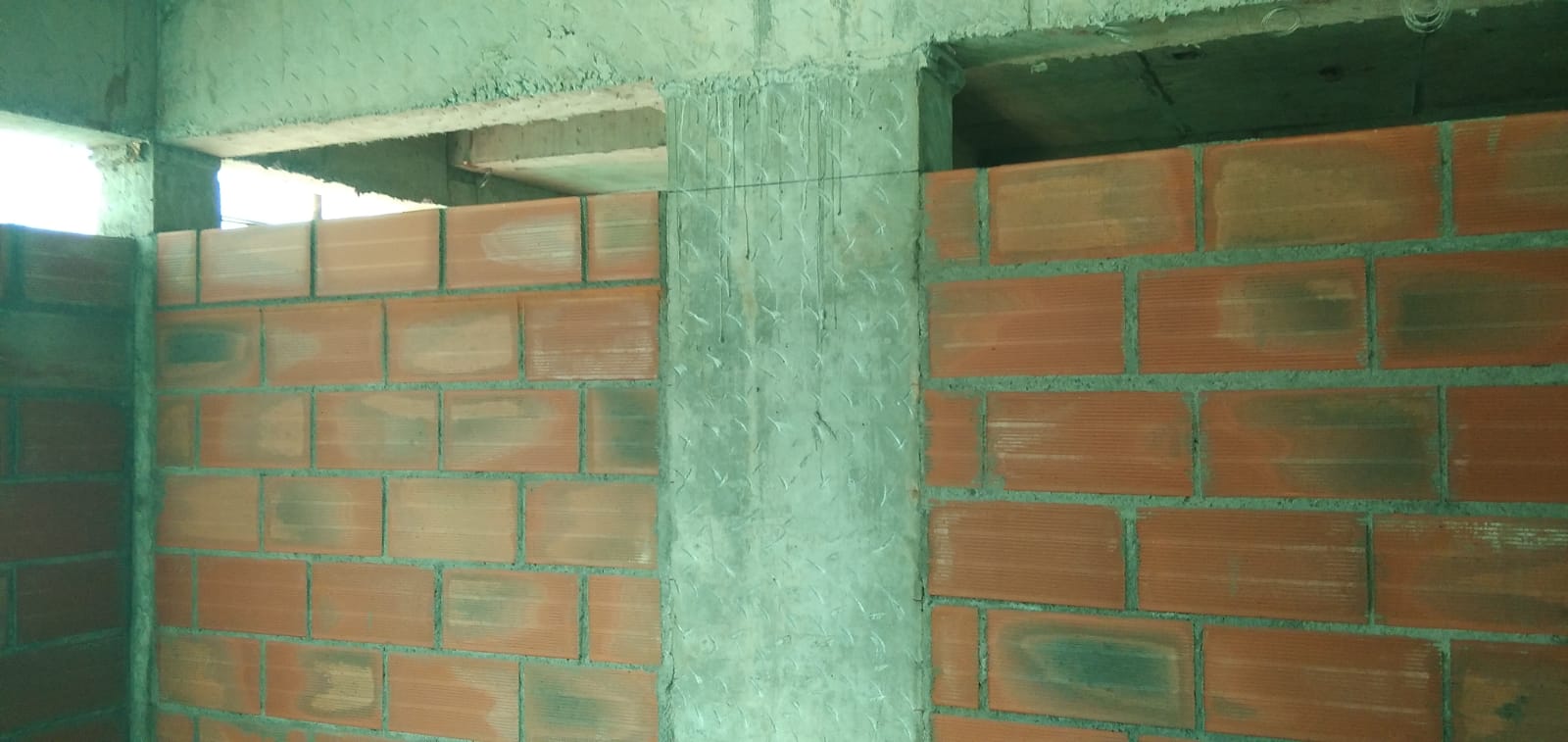

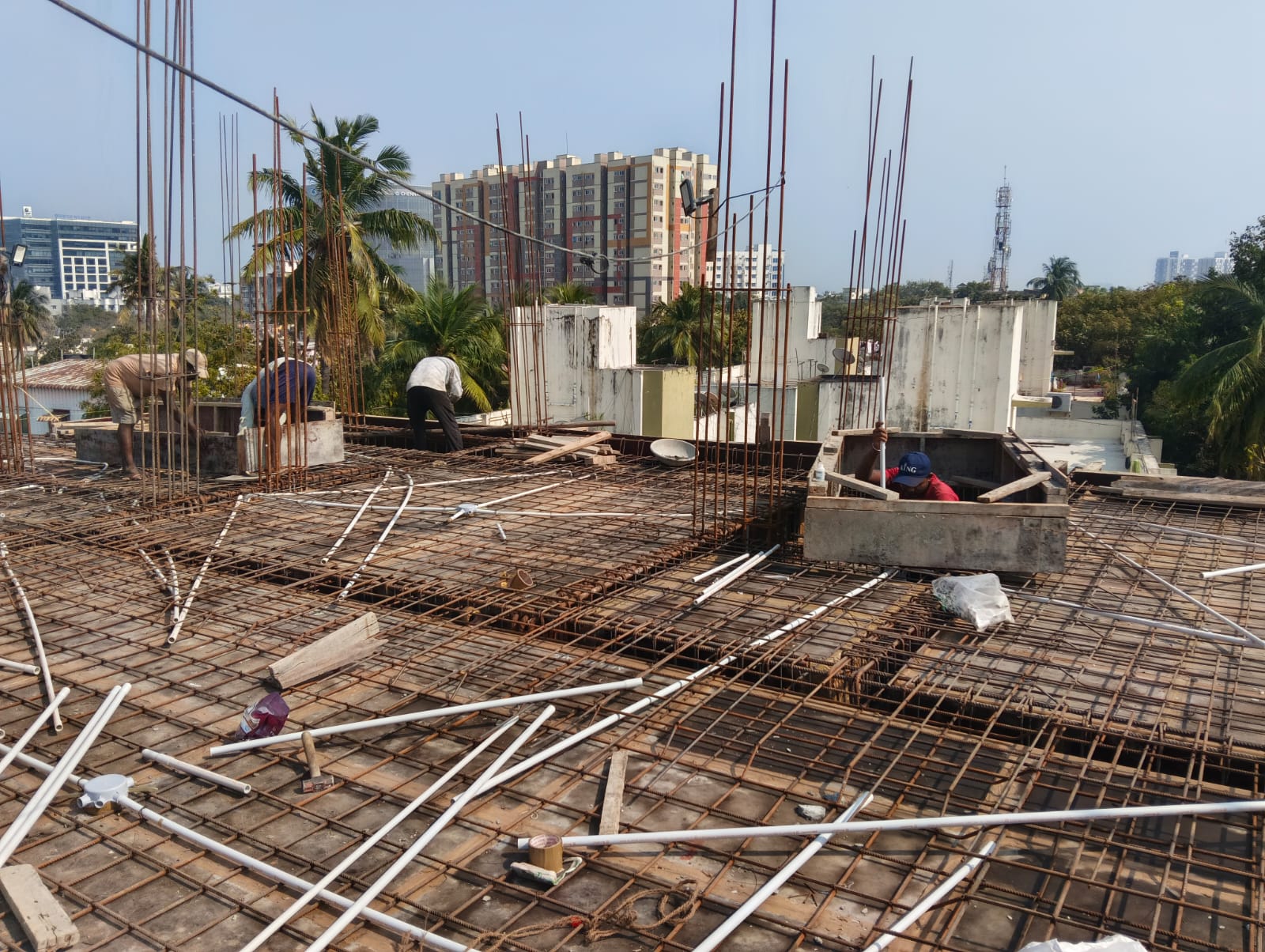

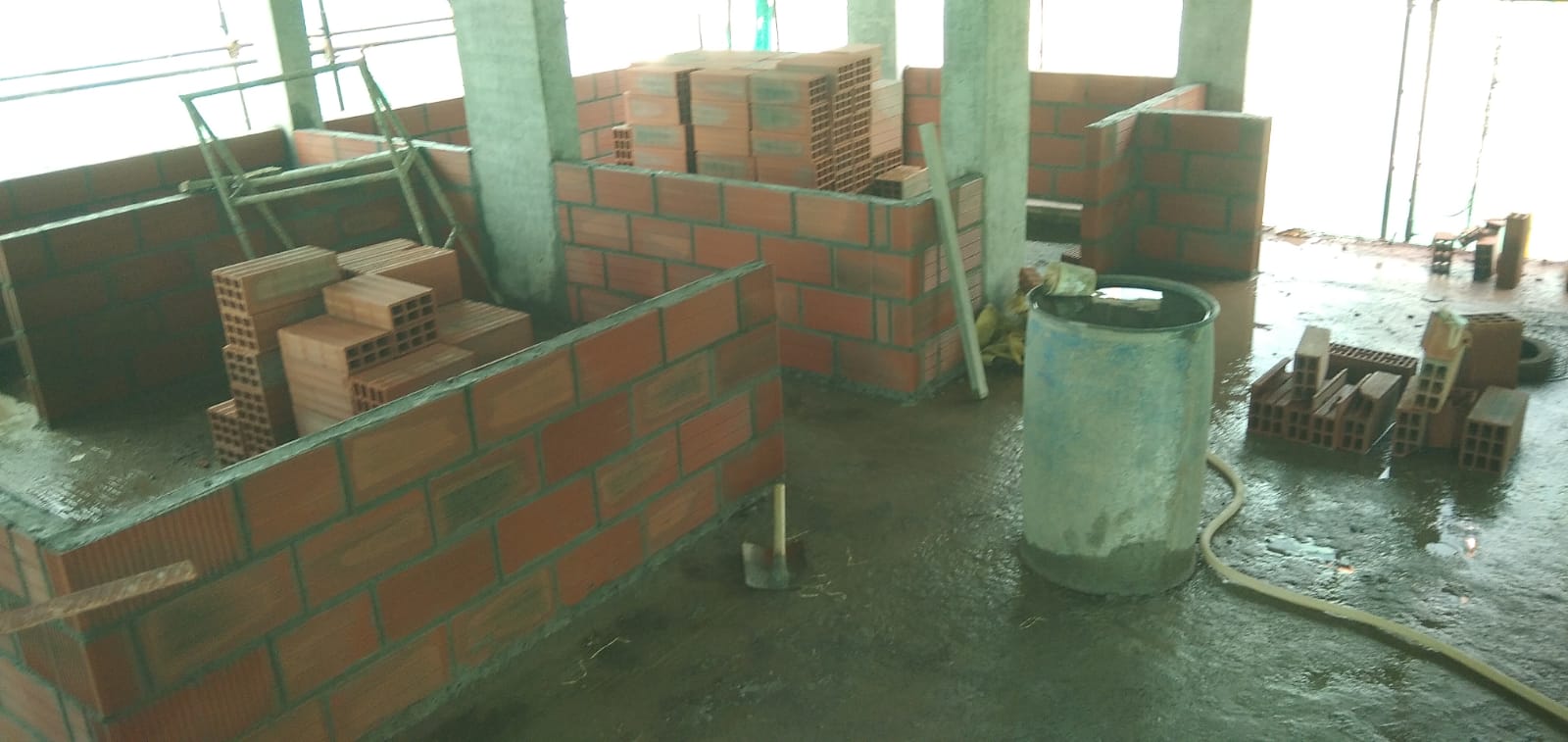

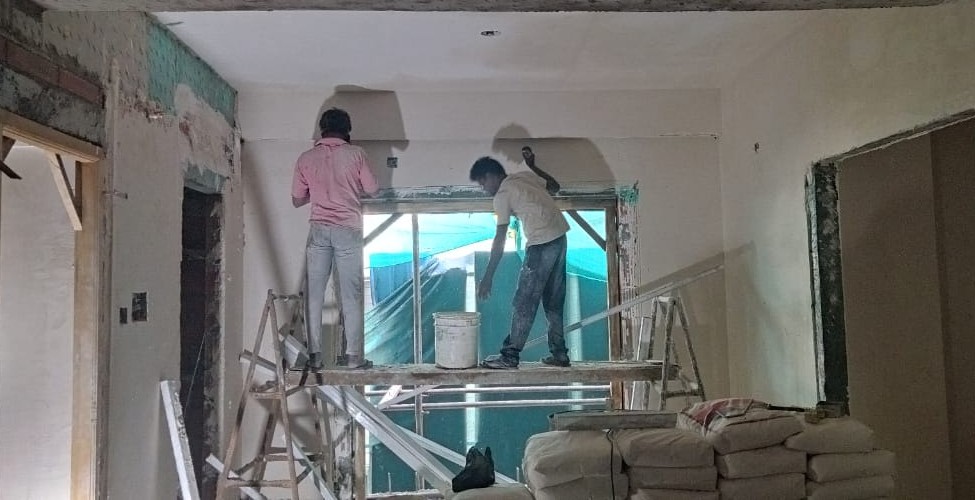

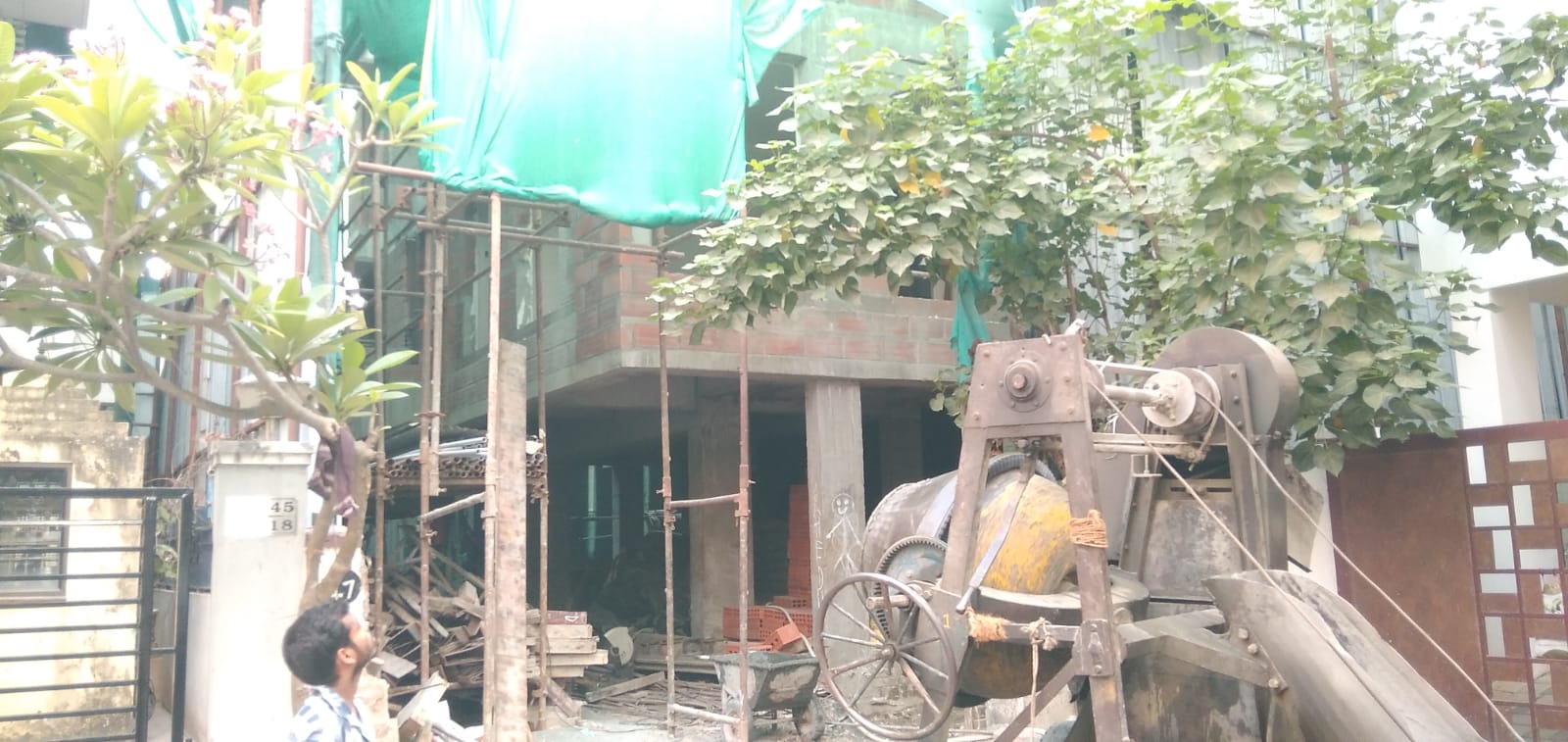

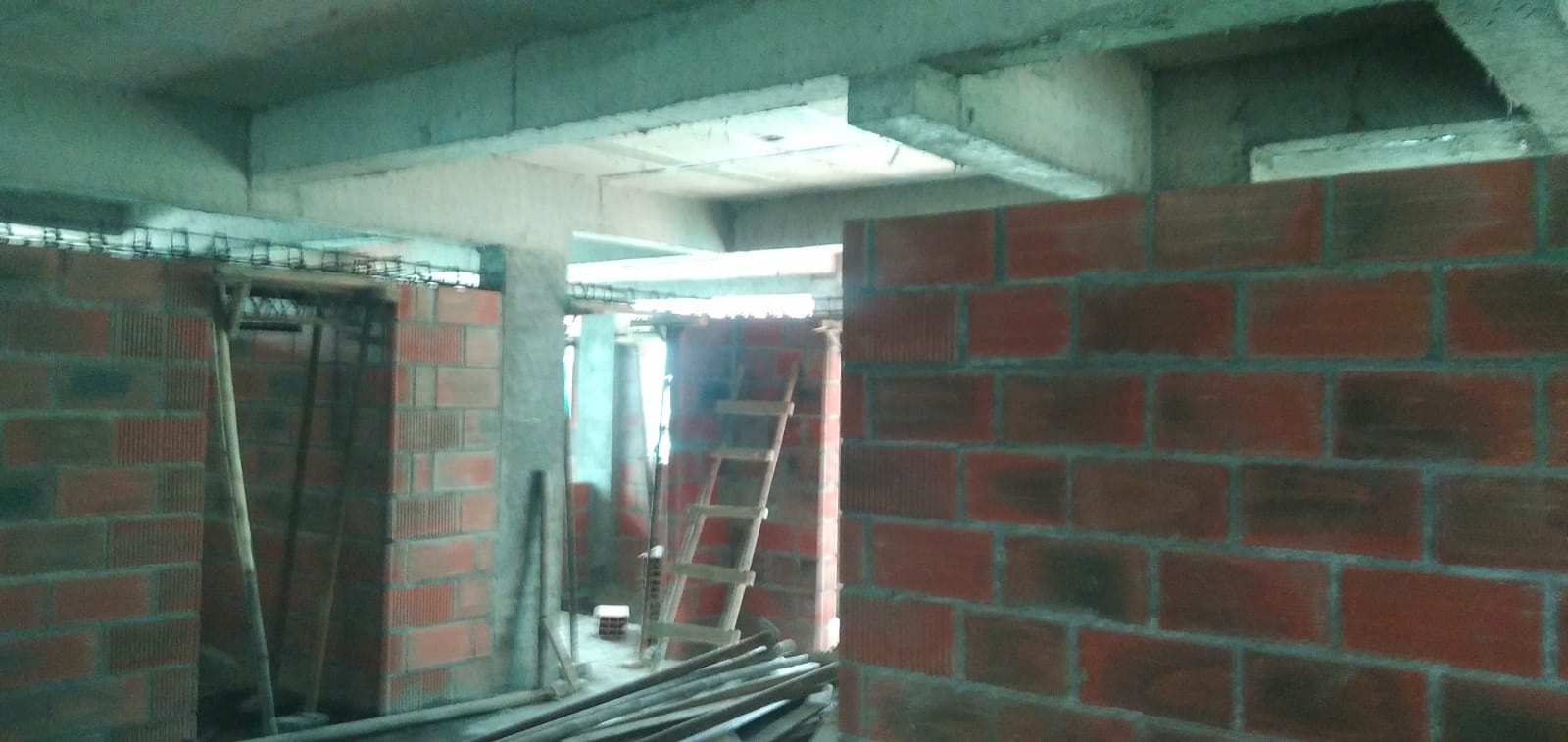

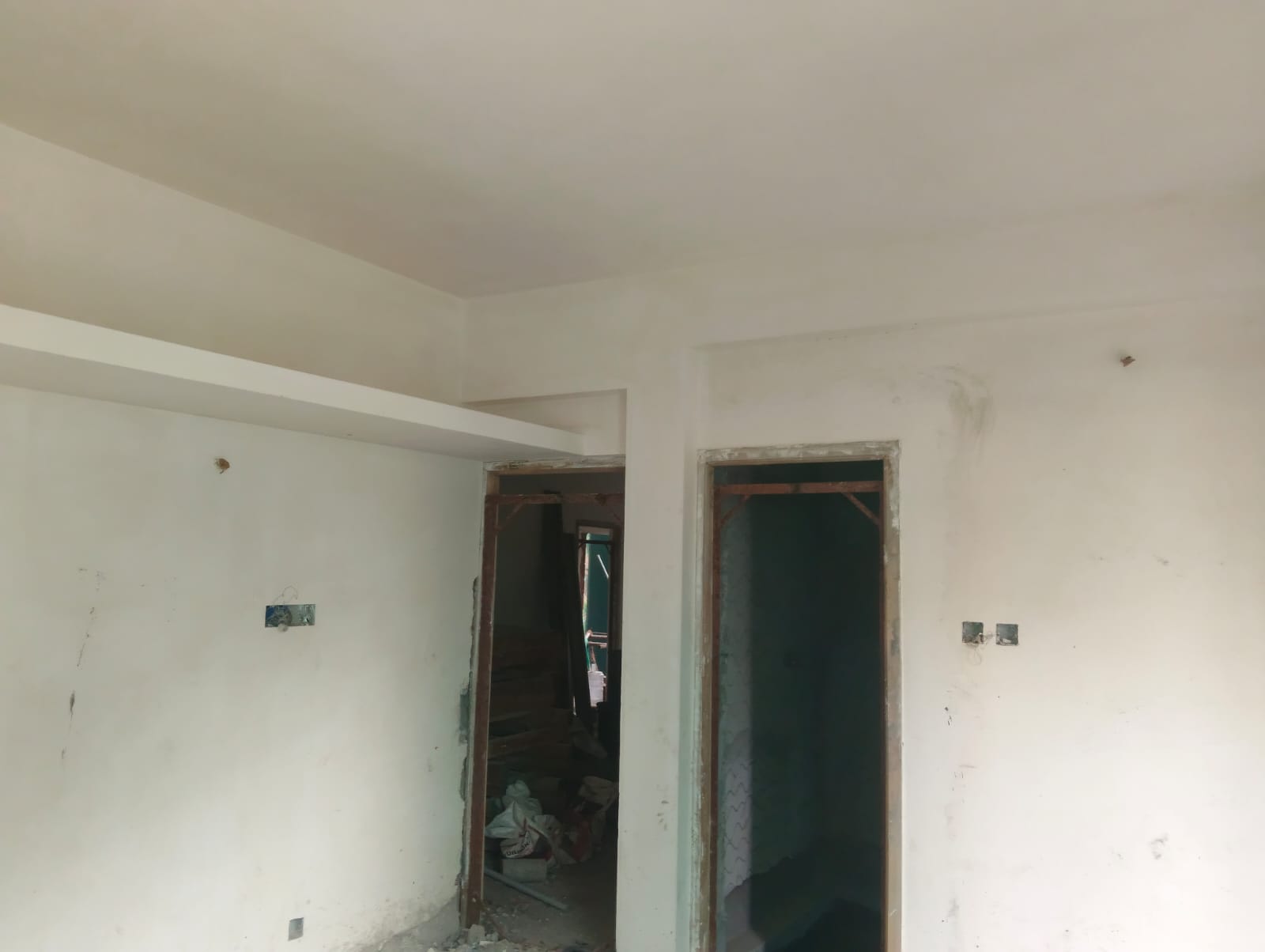

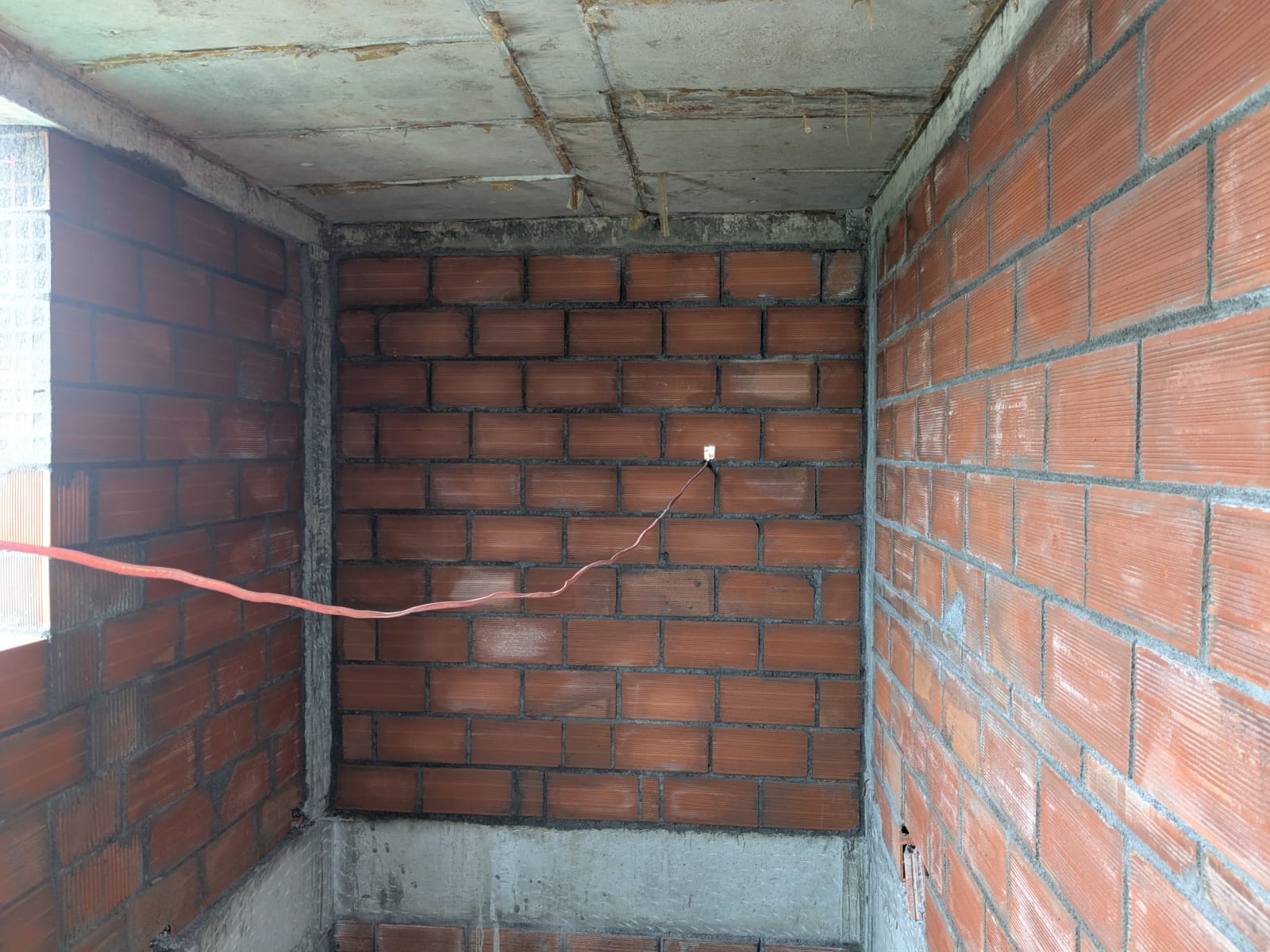

  • Up to 2nd Floor plastering work is completed.

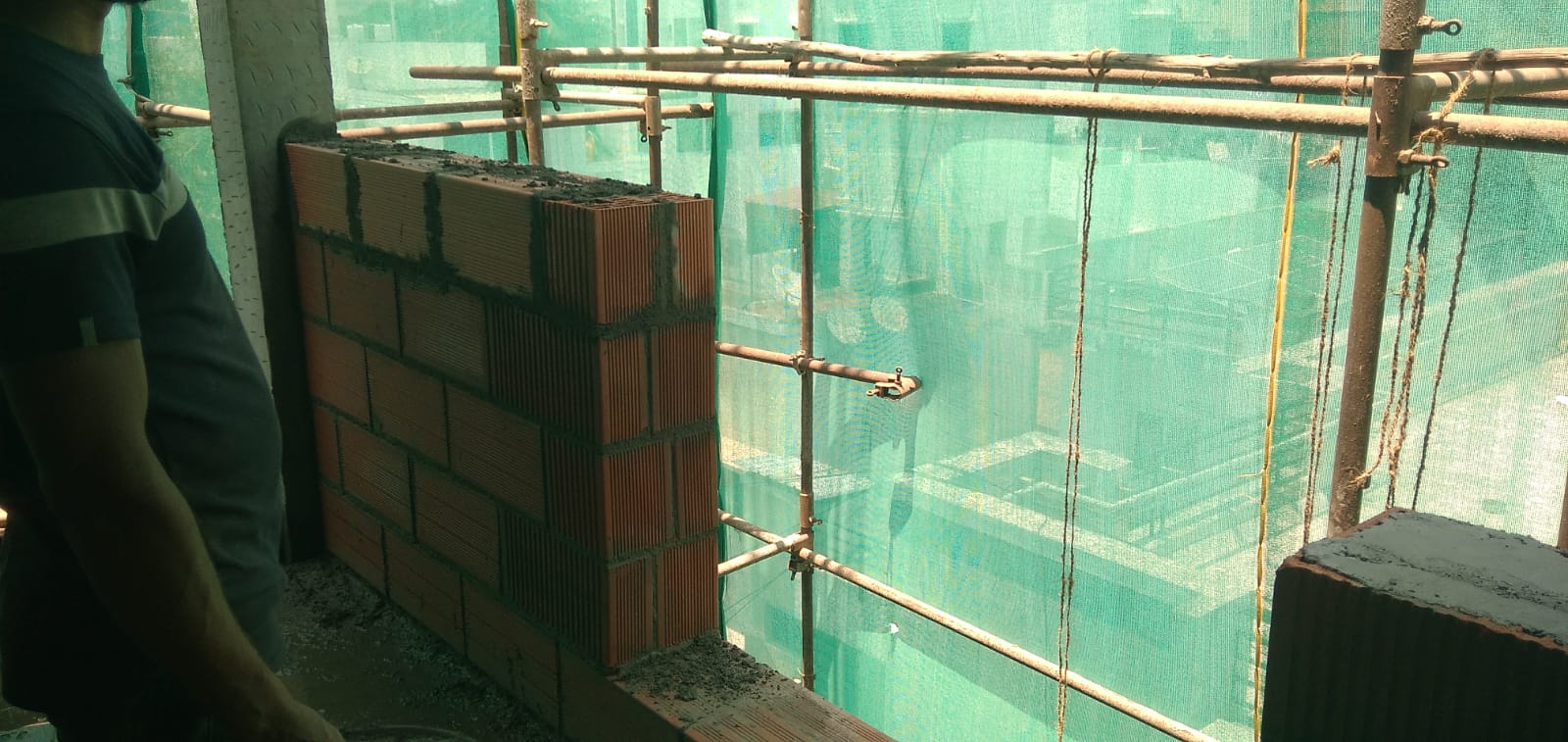

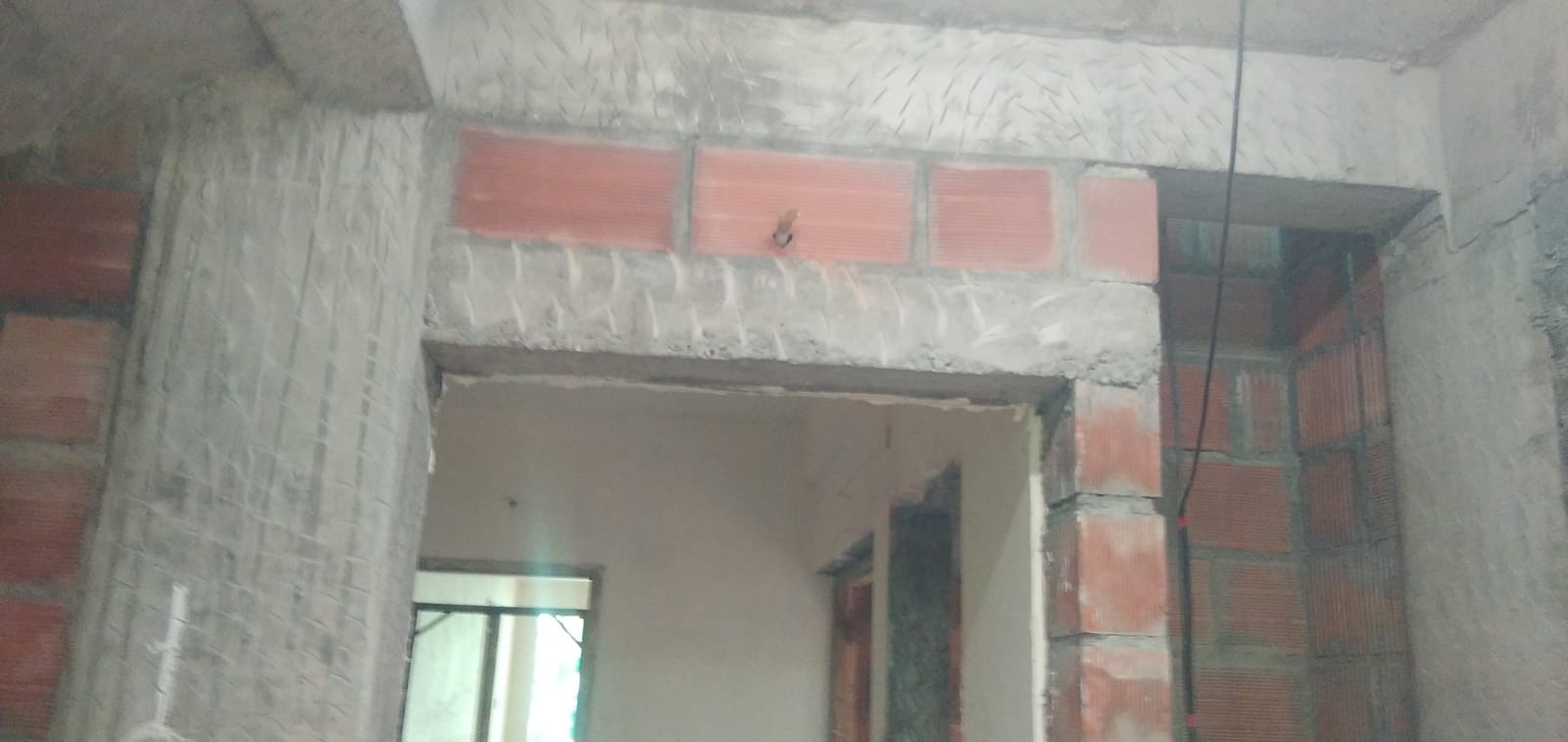

  • 3rd Floor plastering work is in progress.(30% completed)

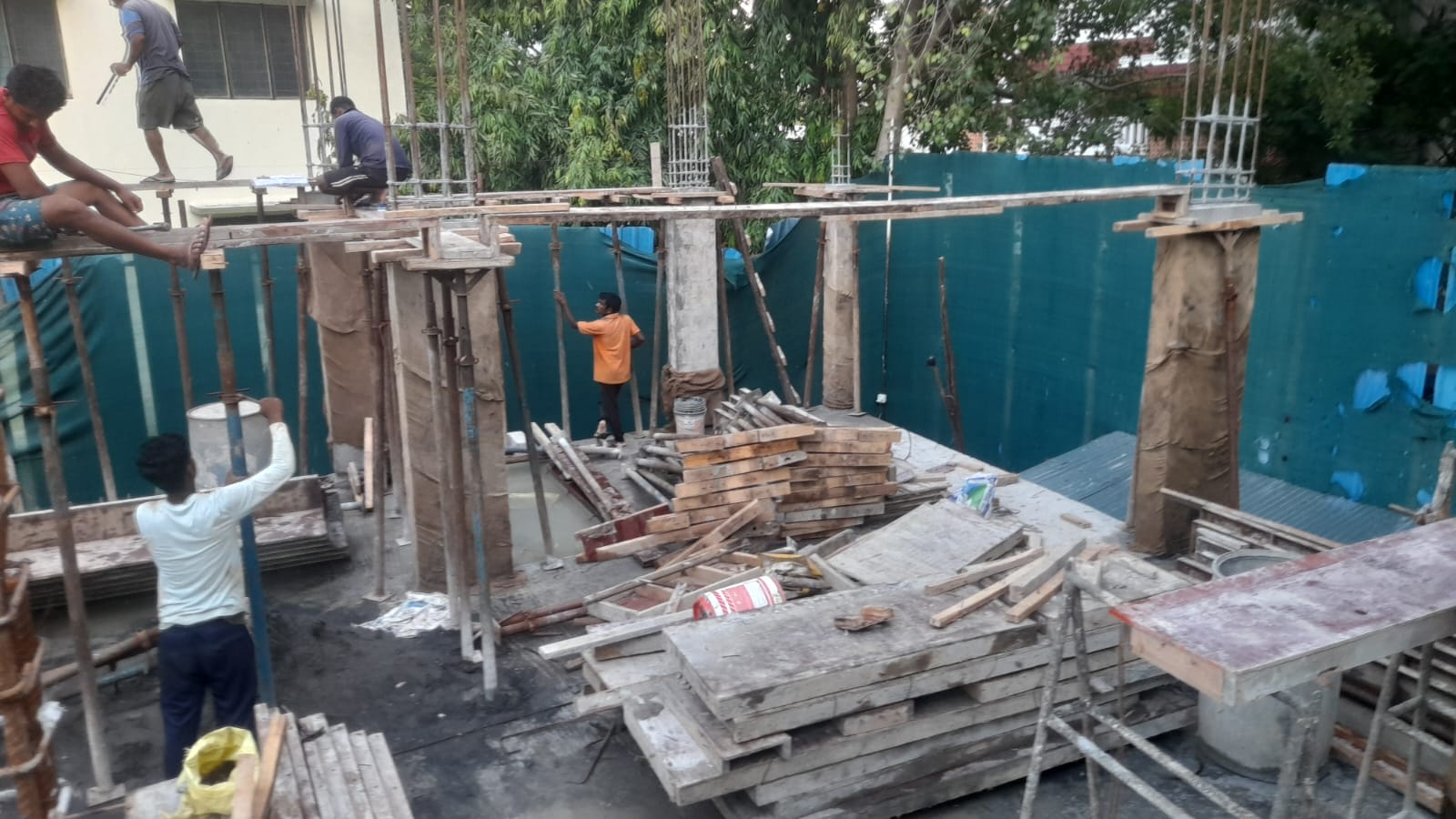

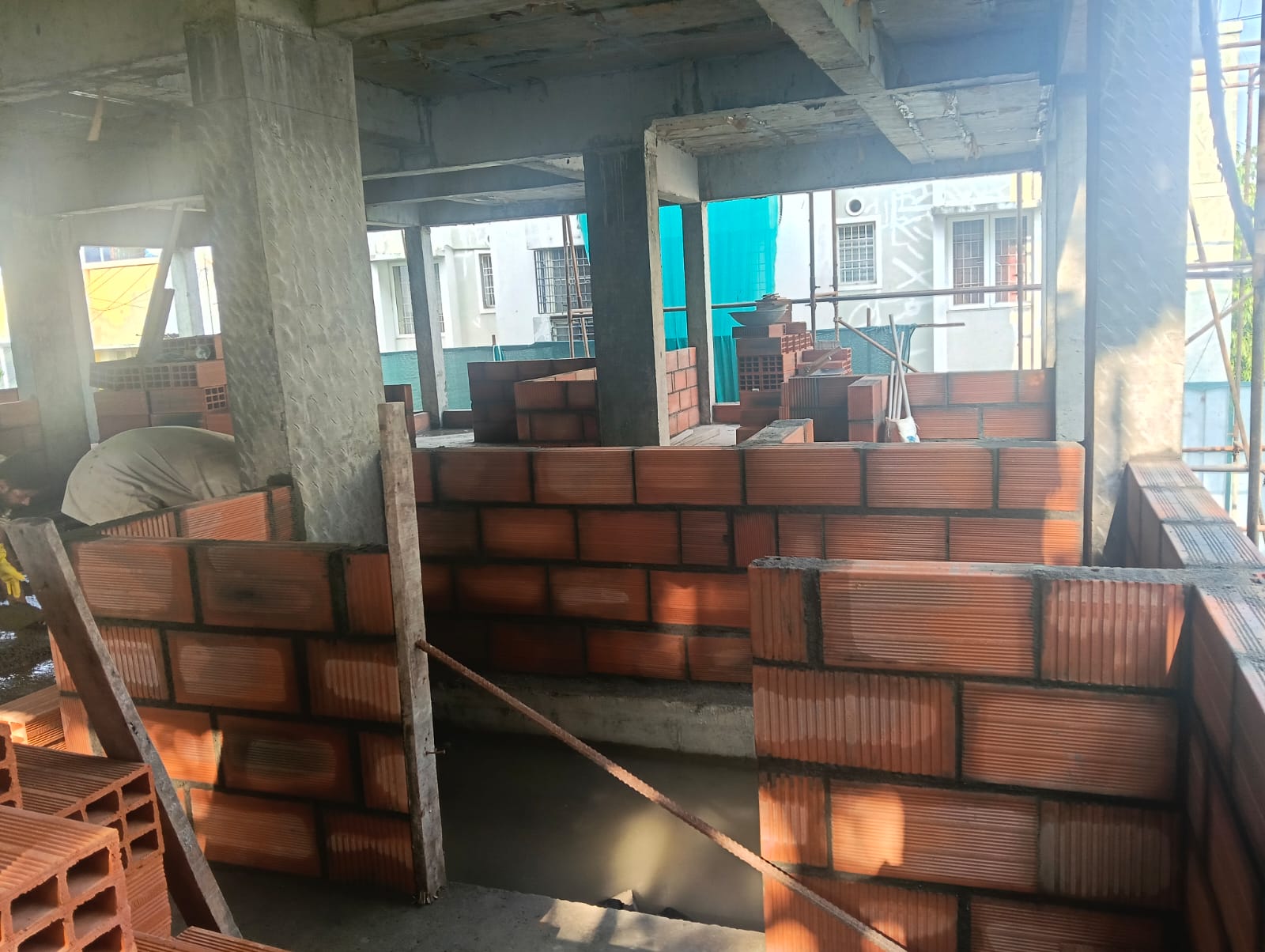

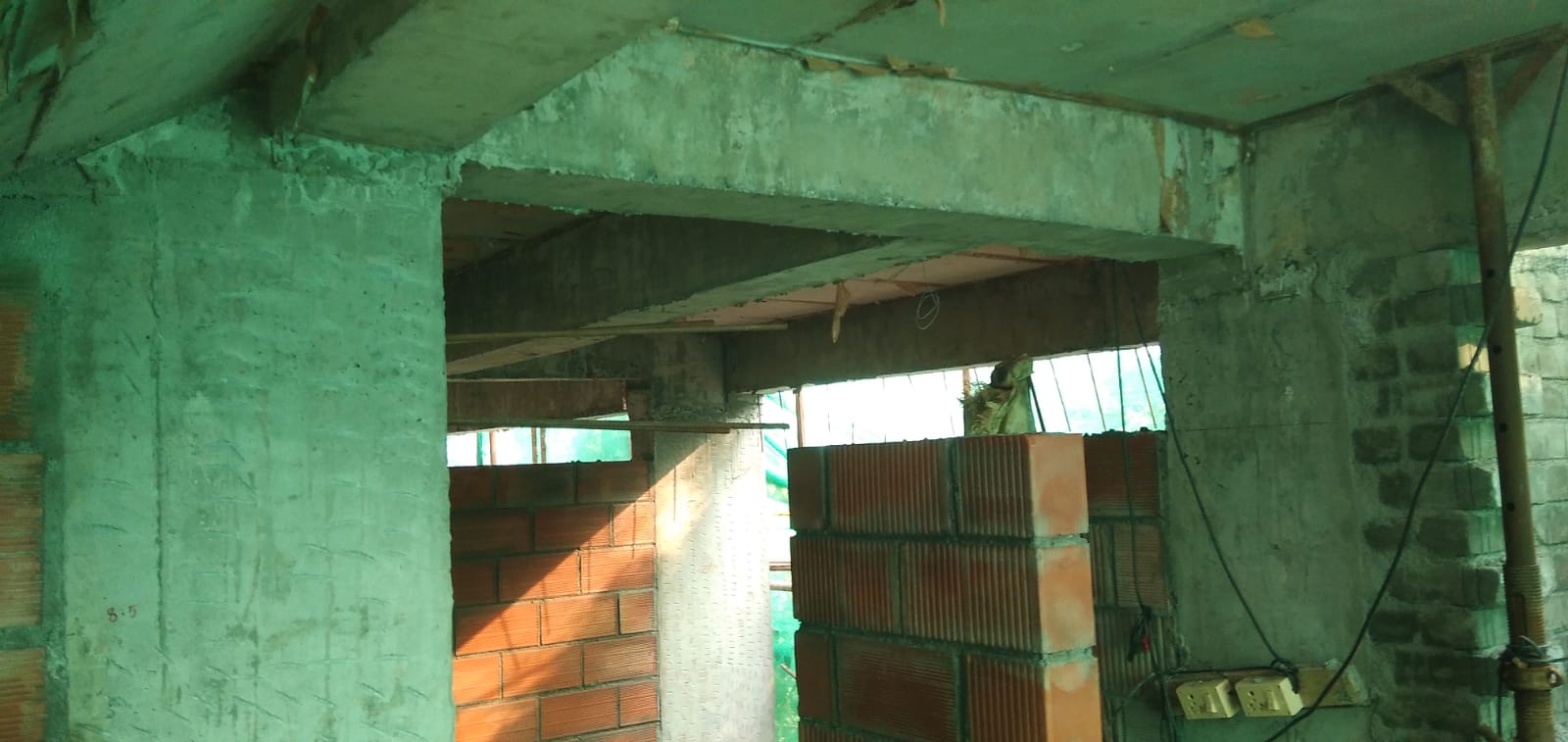

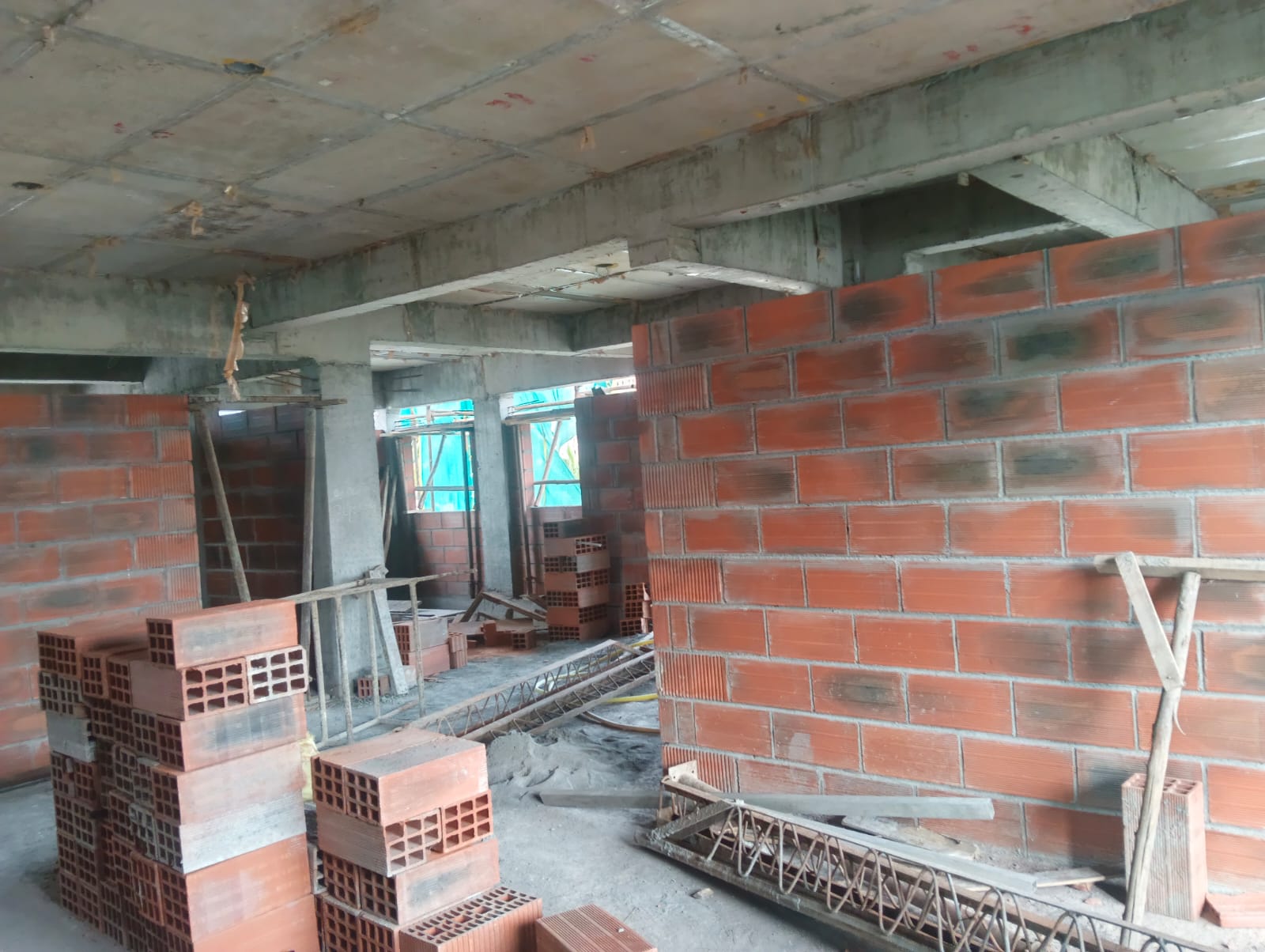

  • 4th Floor block work is completed.
  • 5th Floor block work is in progress. (70% completed)
  • Toilet plumbing work is in progress.(1st& 2nd floor progress).

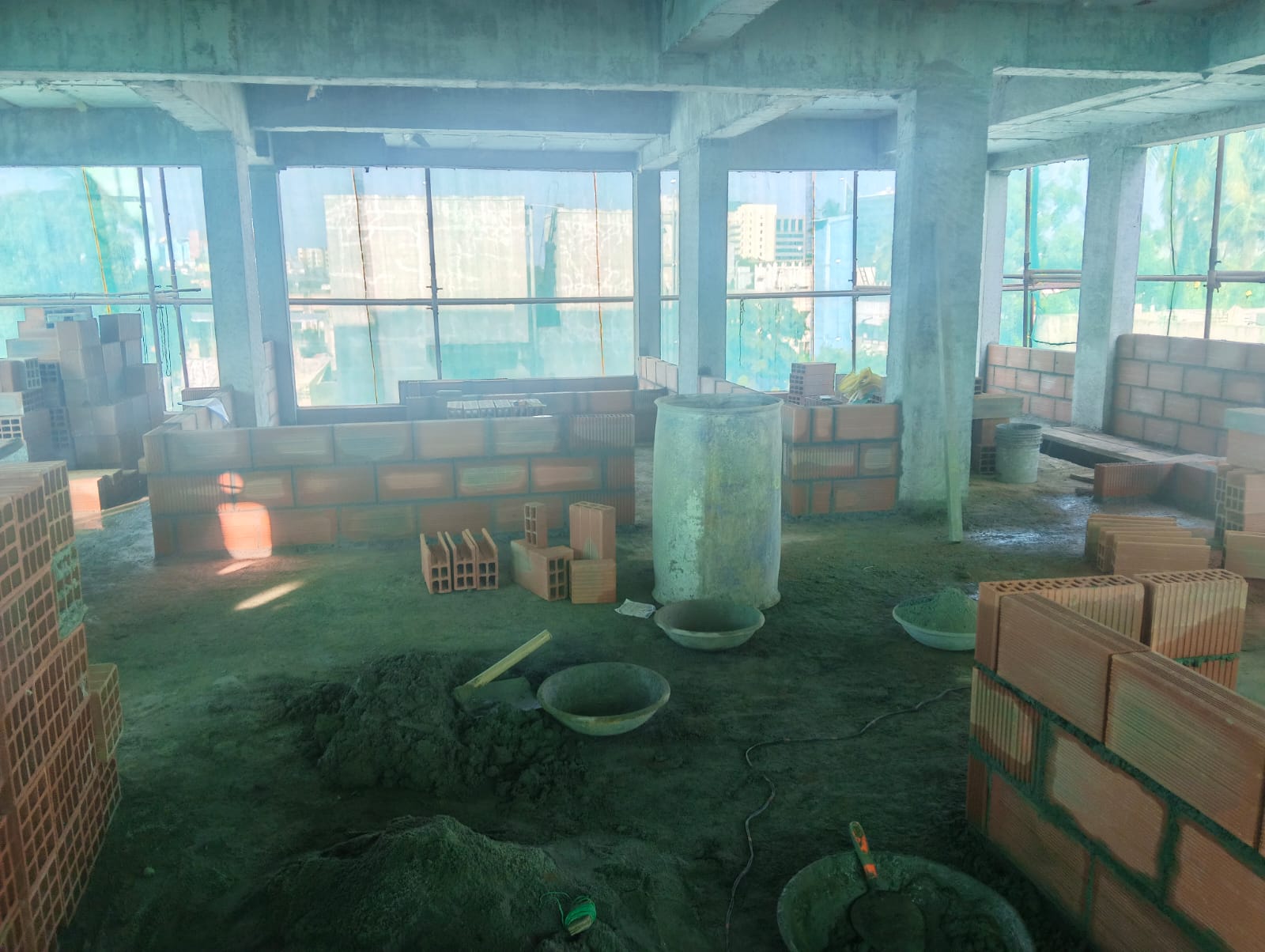

  • Duct brick work is in progress.

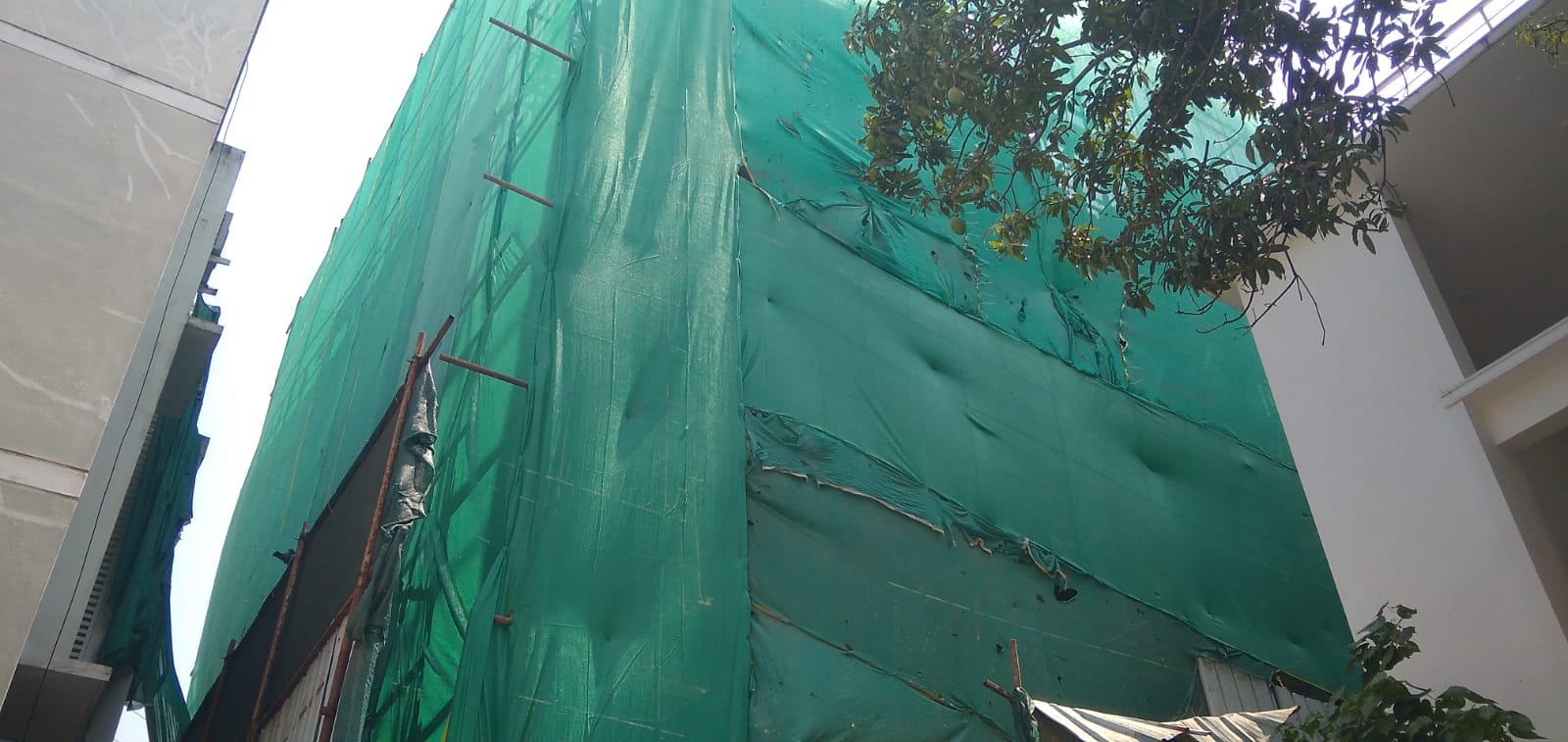

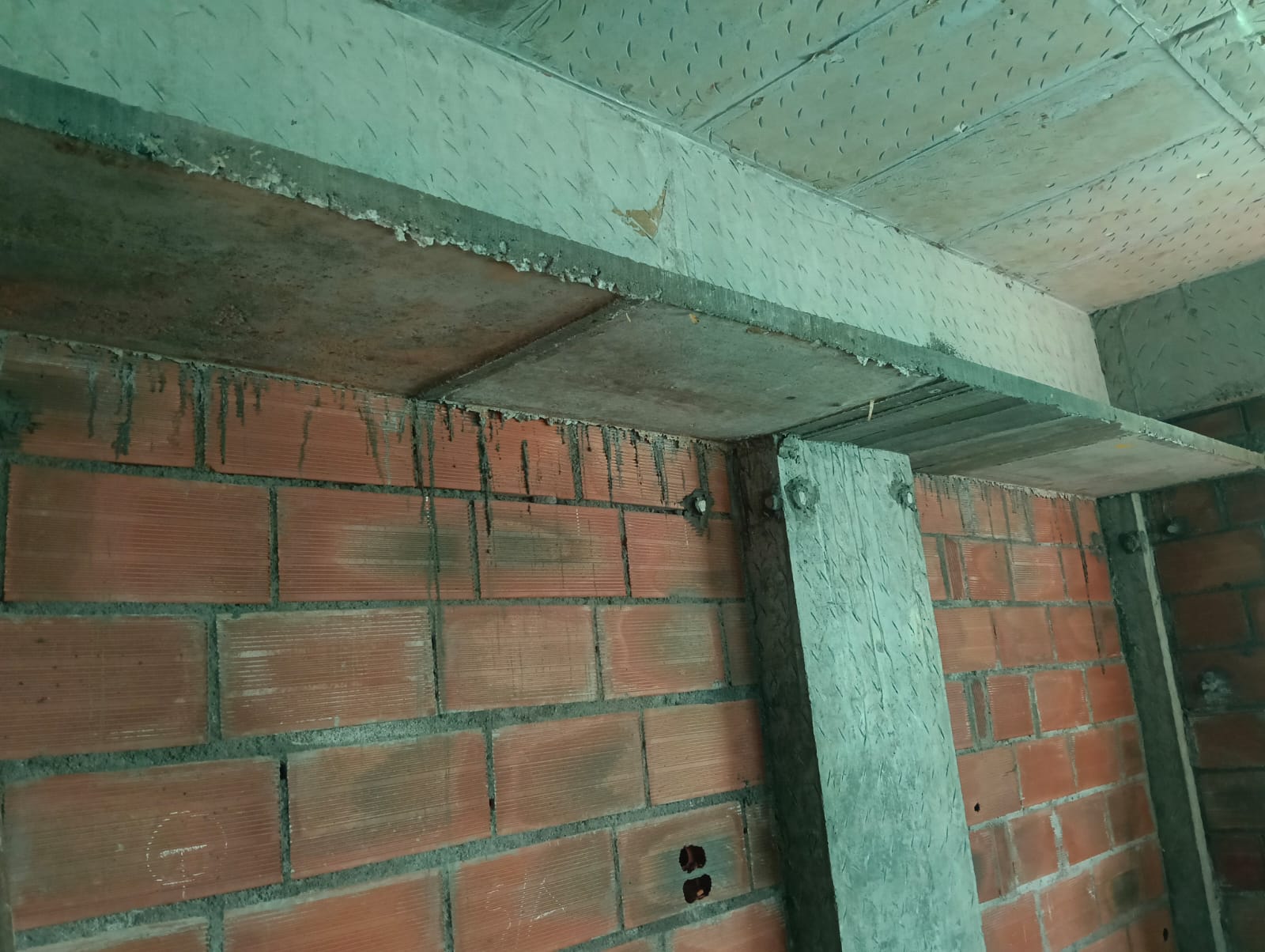

  • Terrace parapet wall brick work is completed.

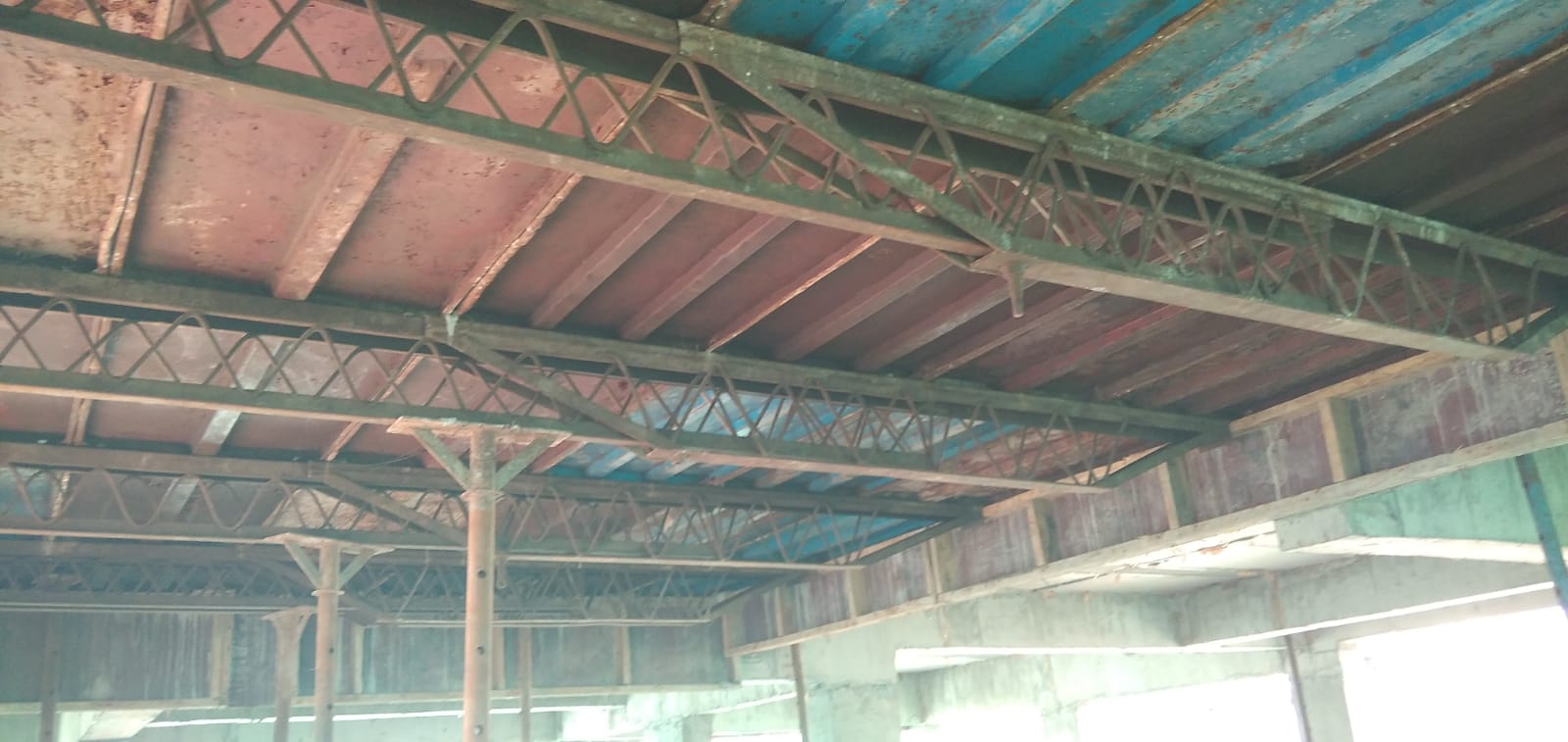

  • Head room column concrete work is completed.

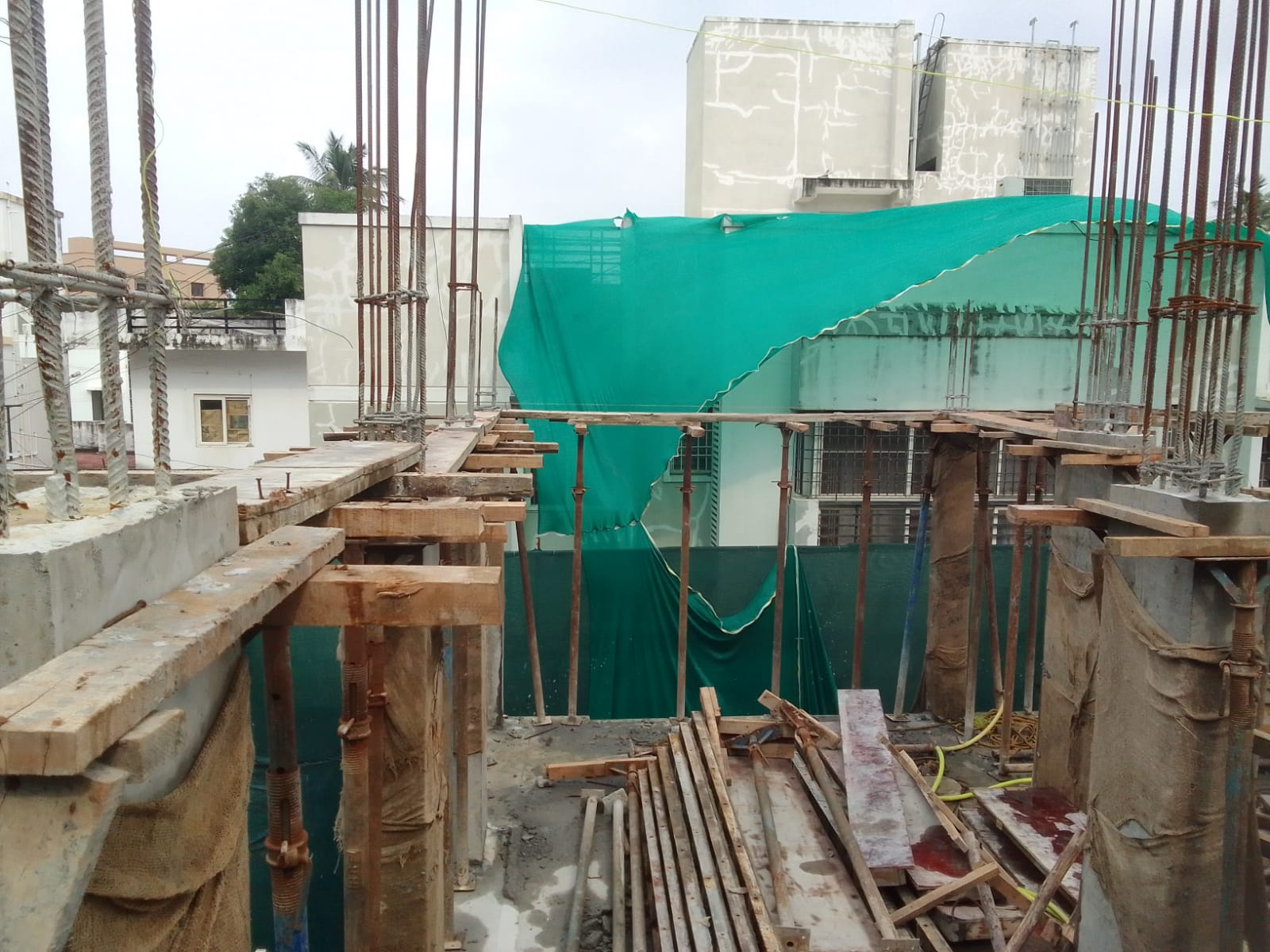

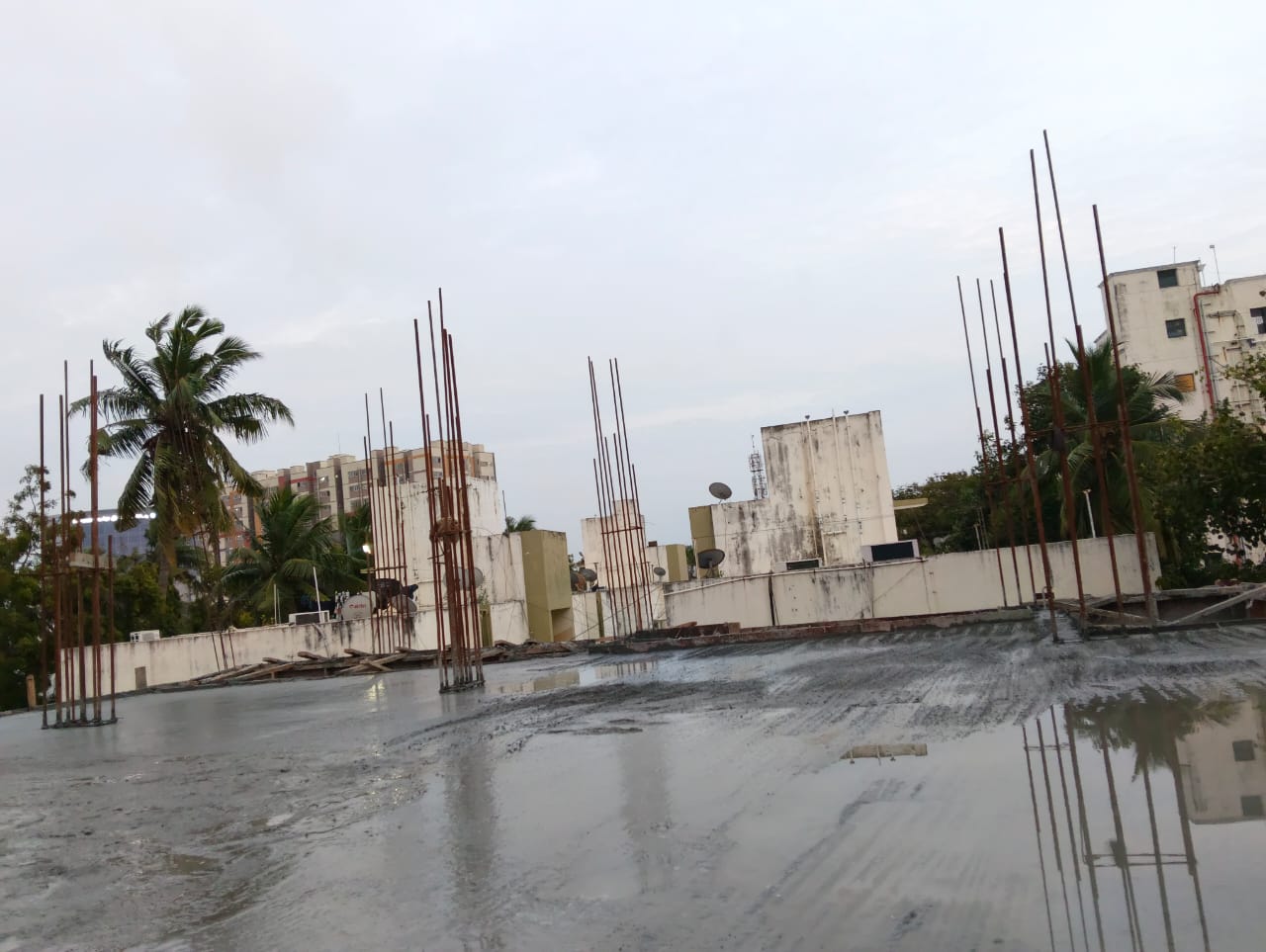

  • OHT base slab shuttering and bar bending work is in progress.

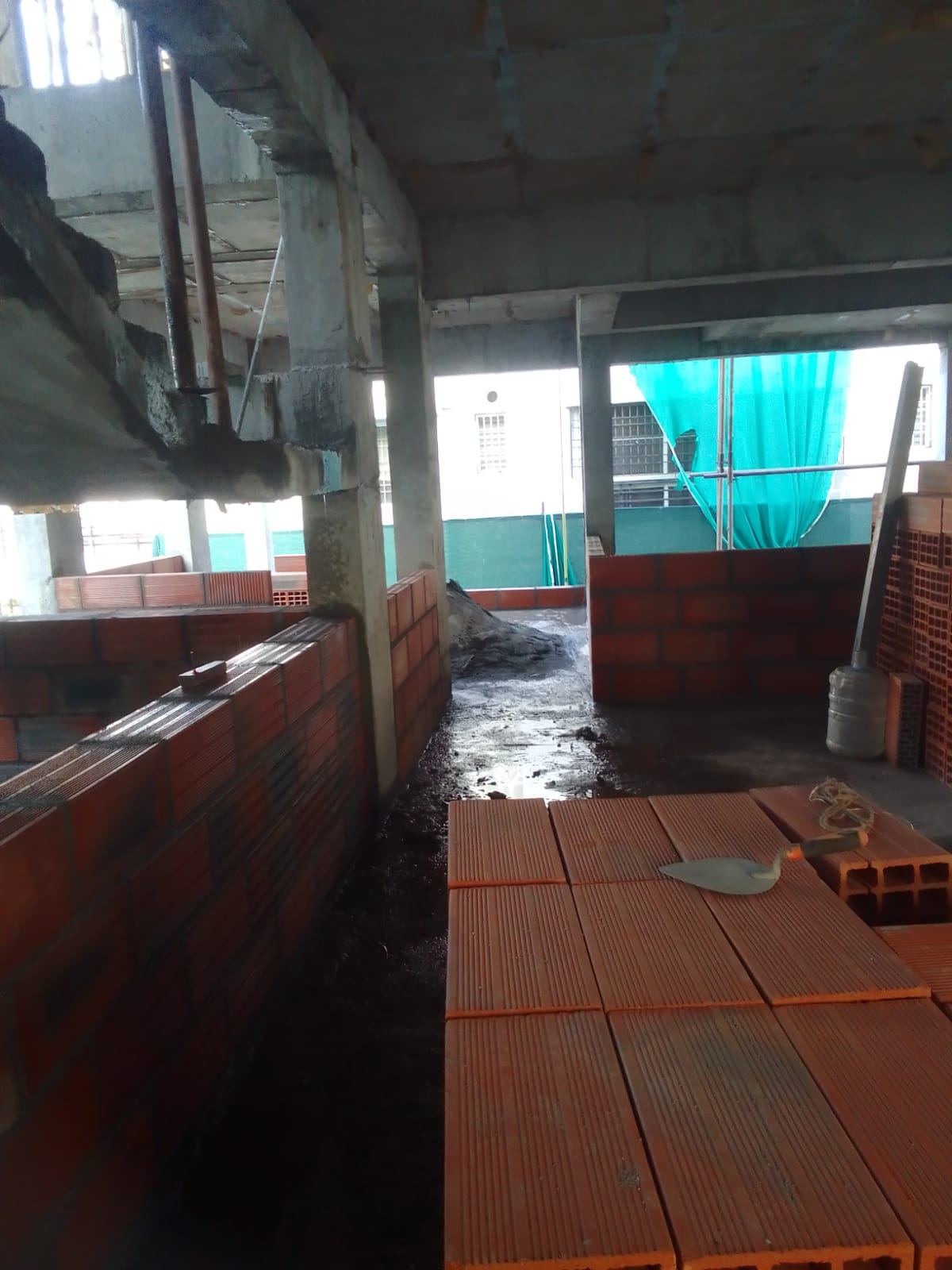

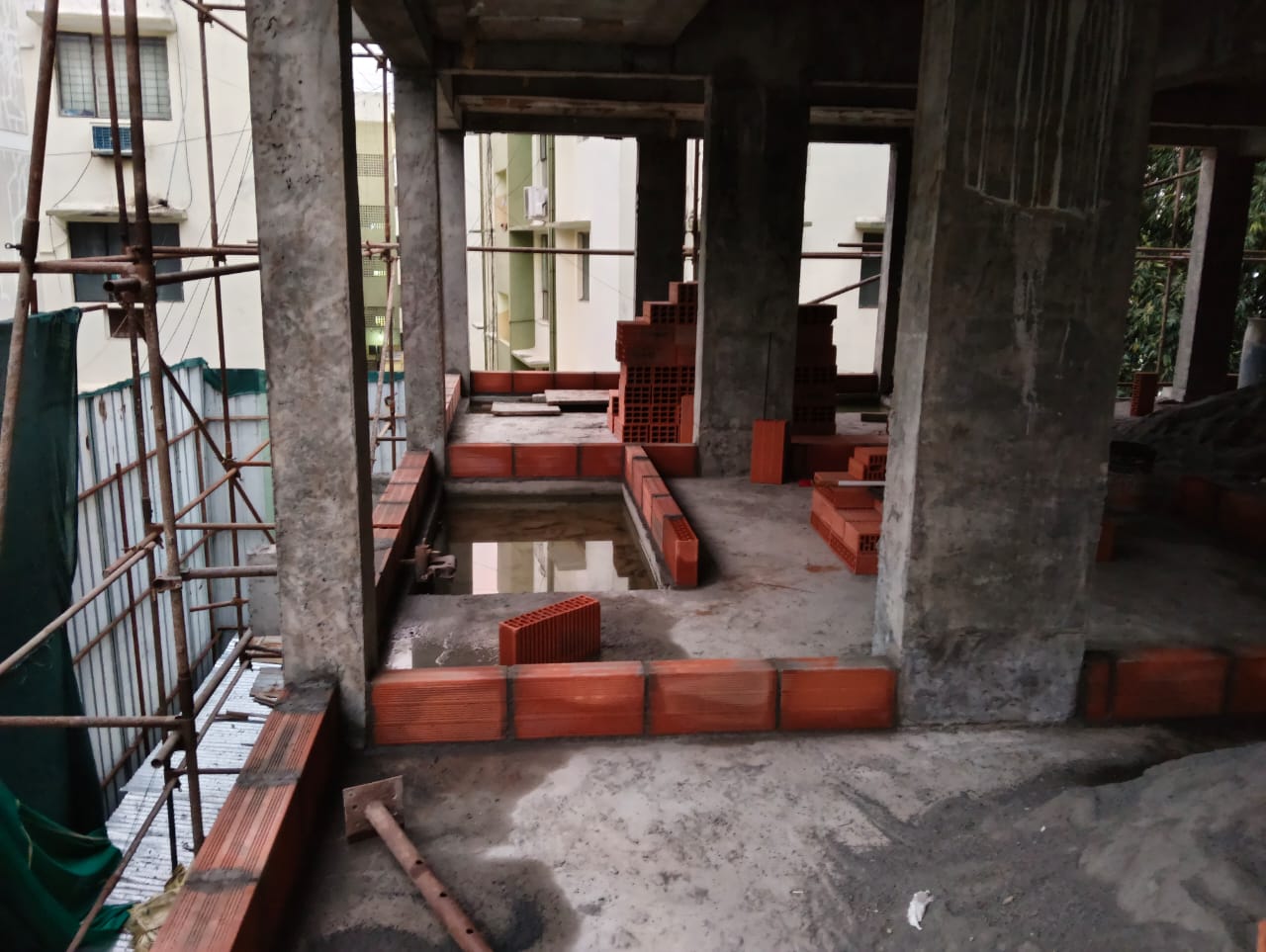

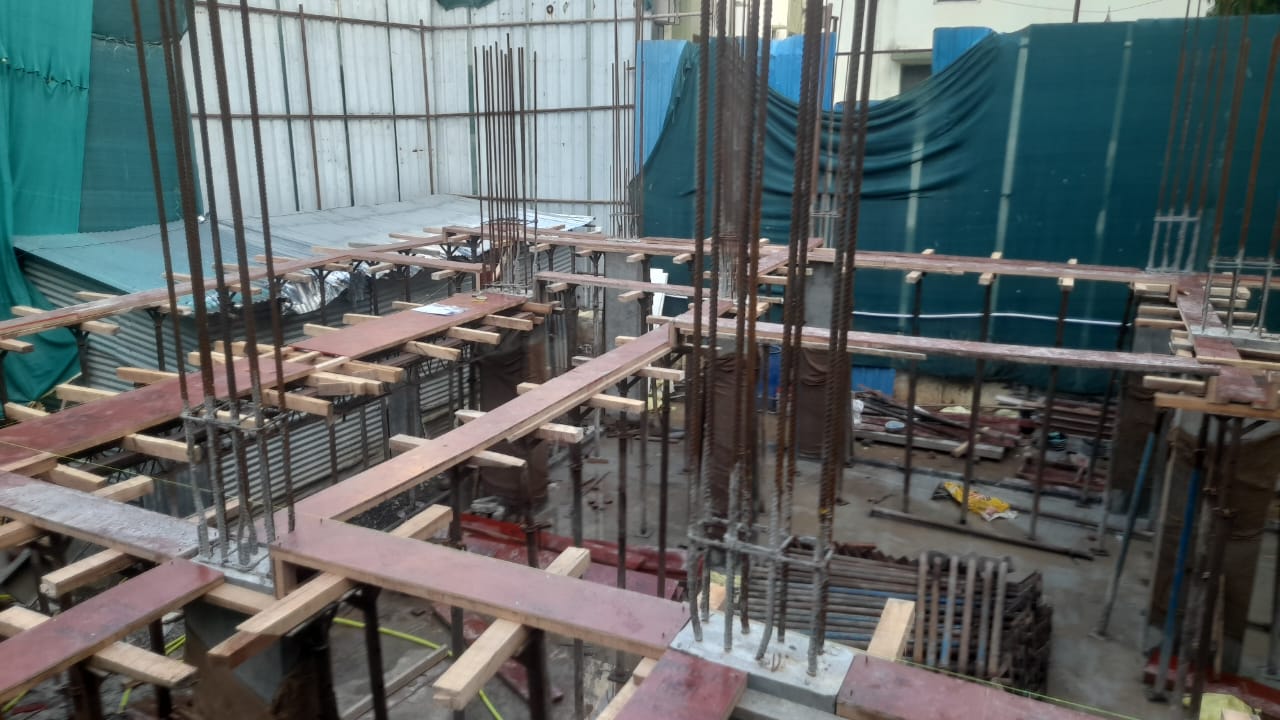

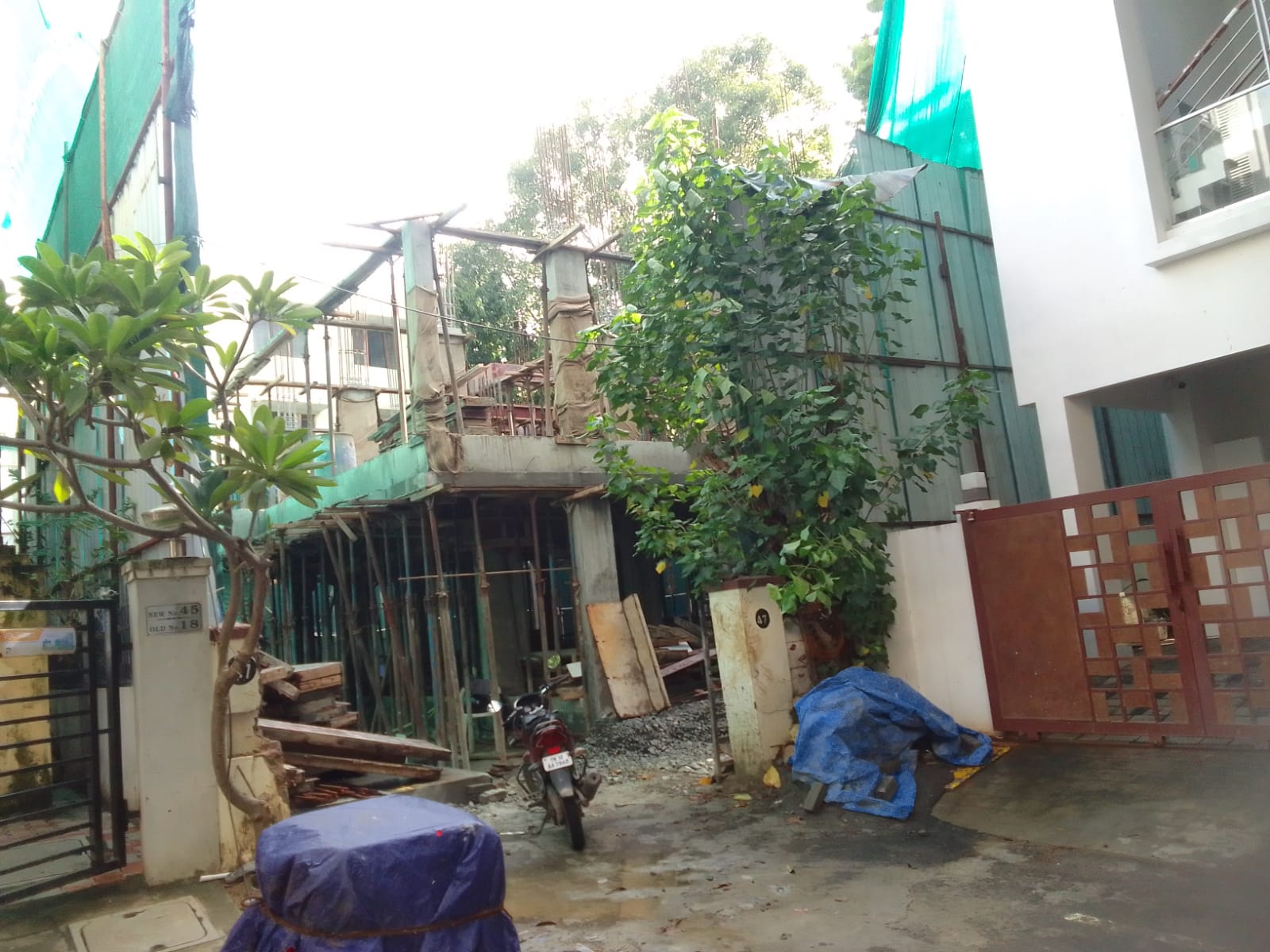

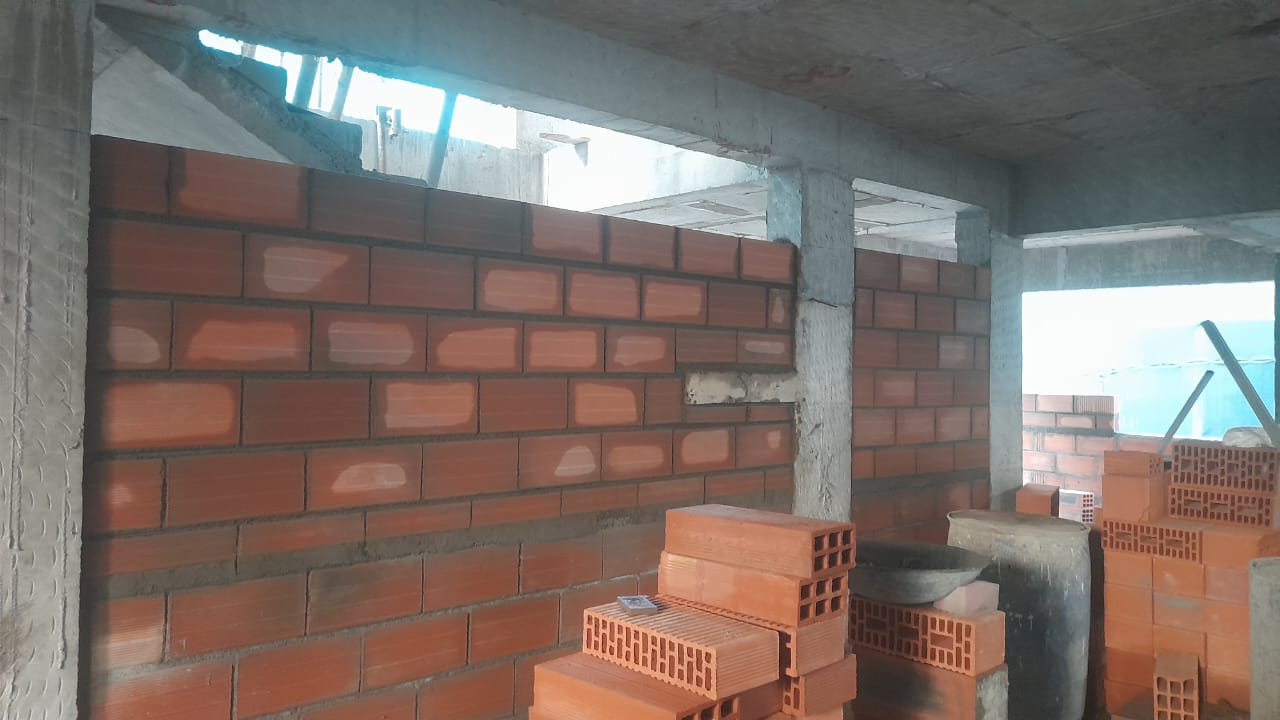

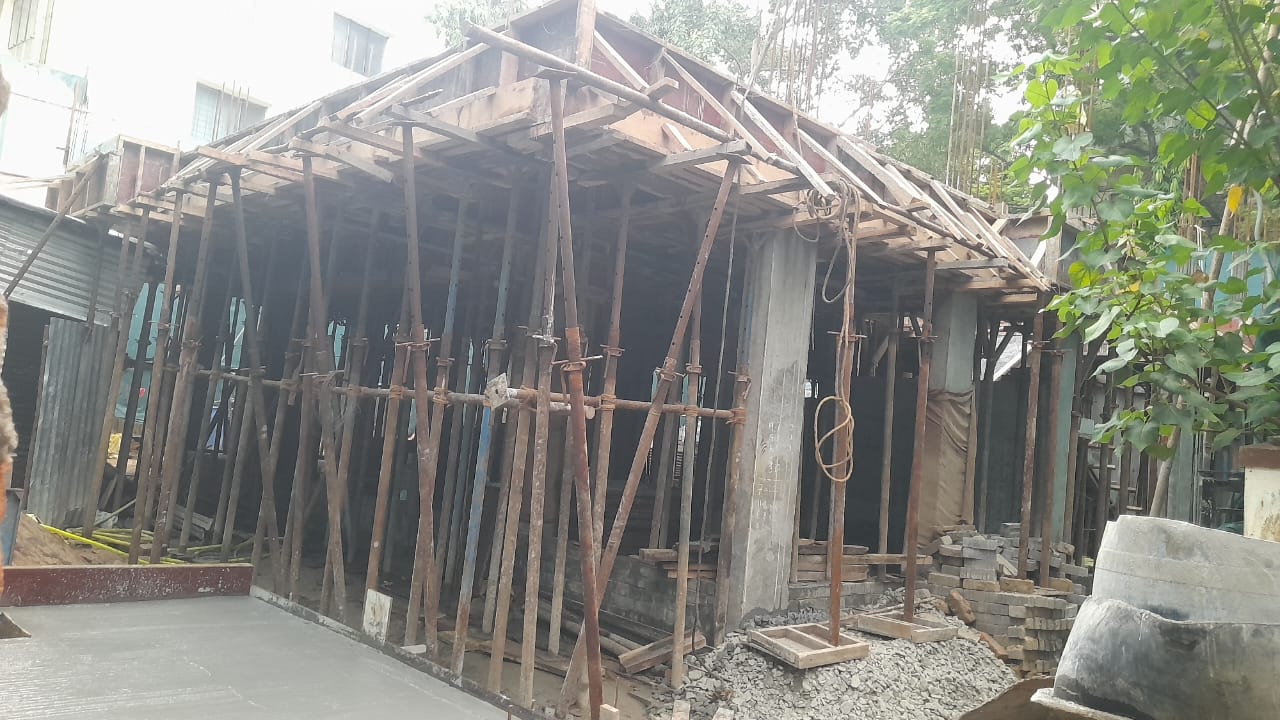

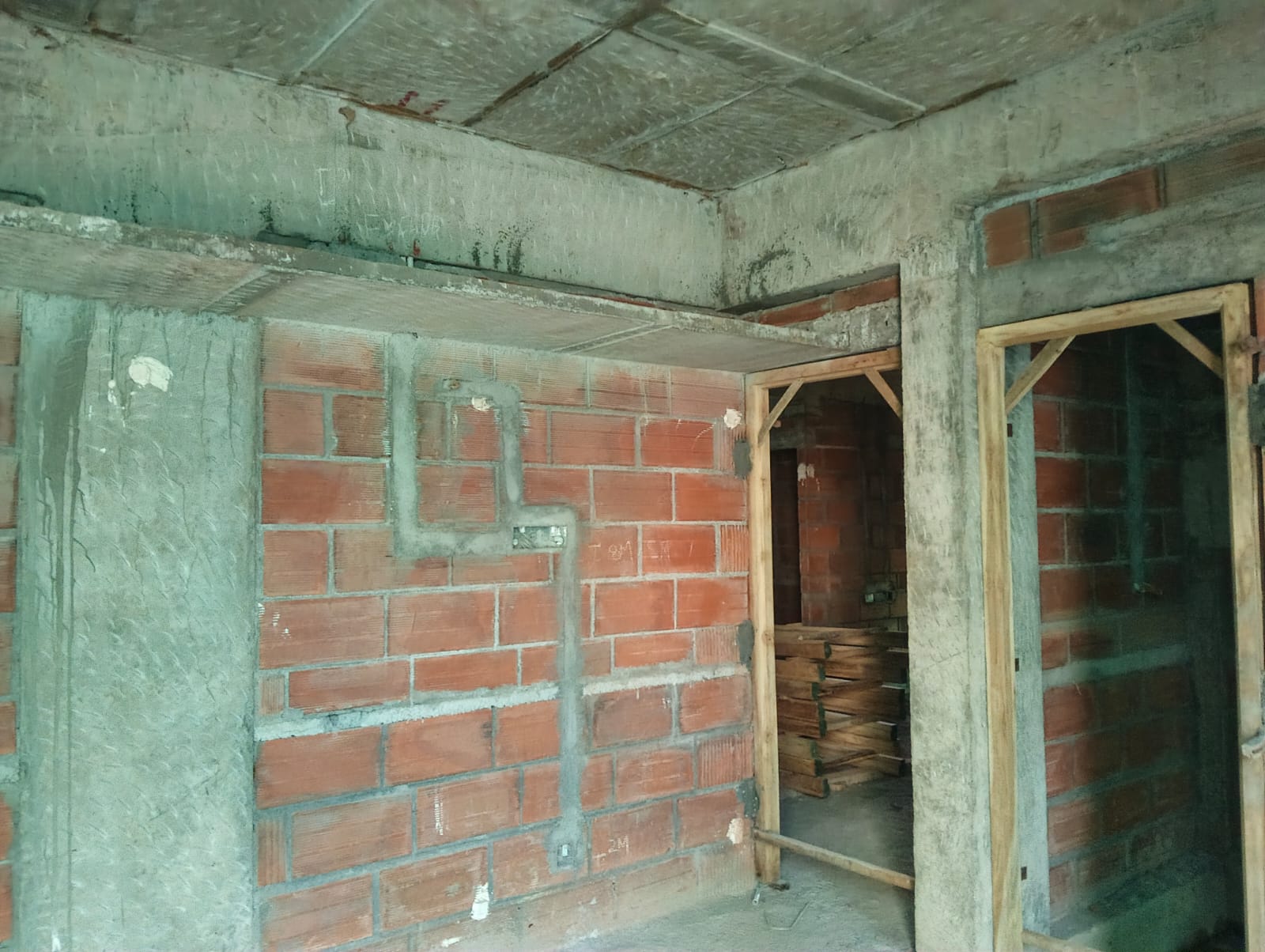

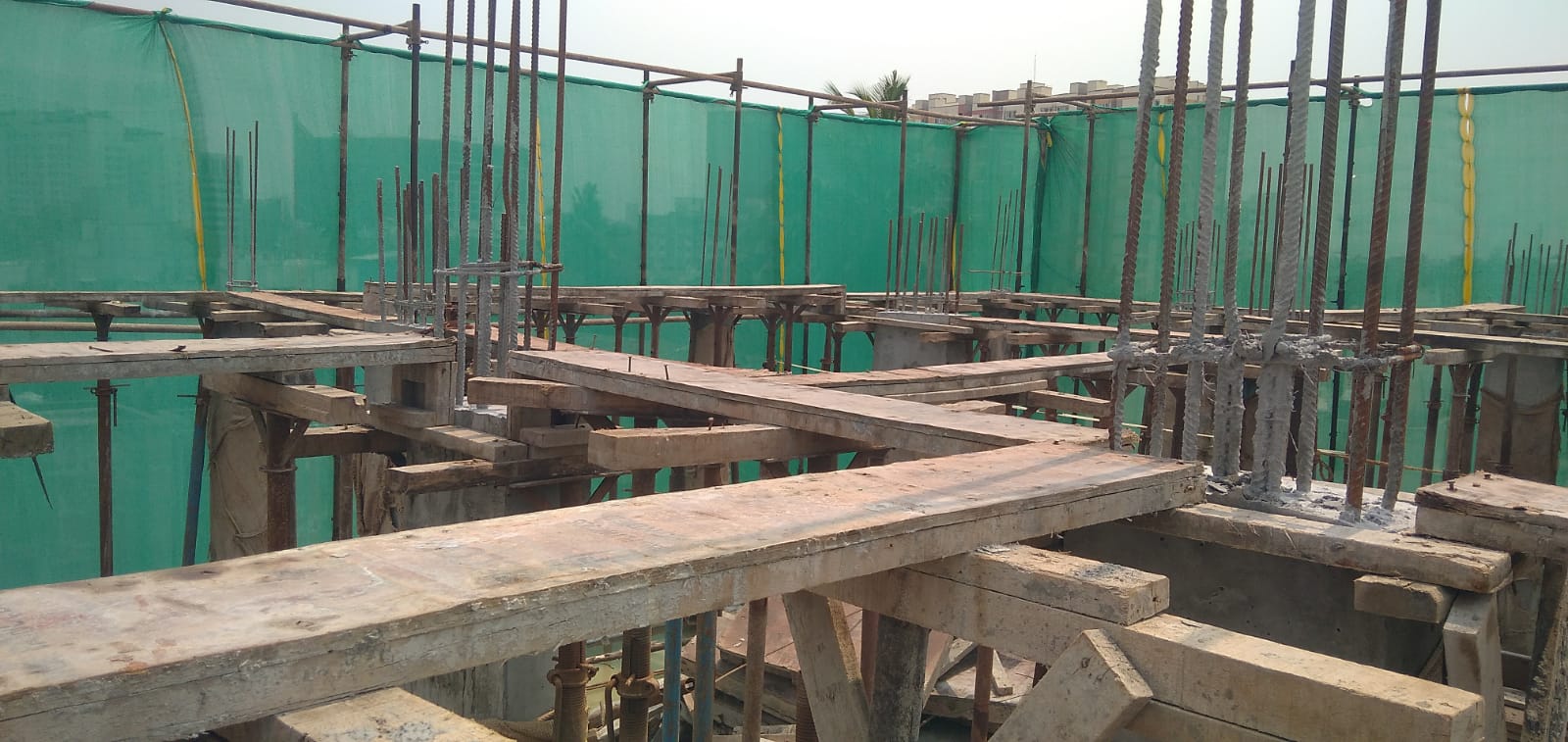

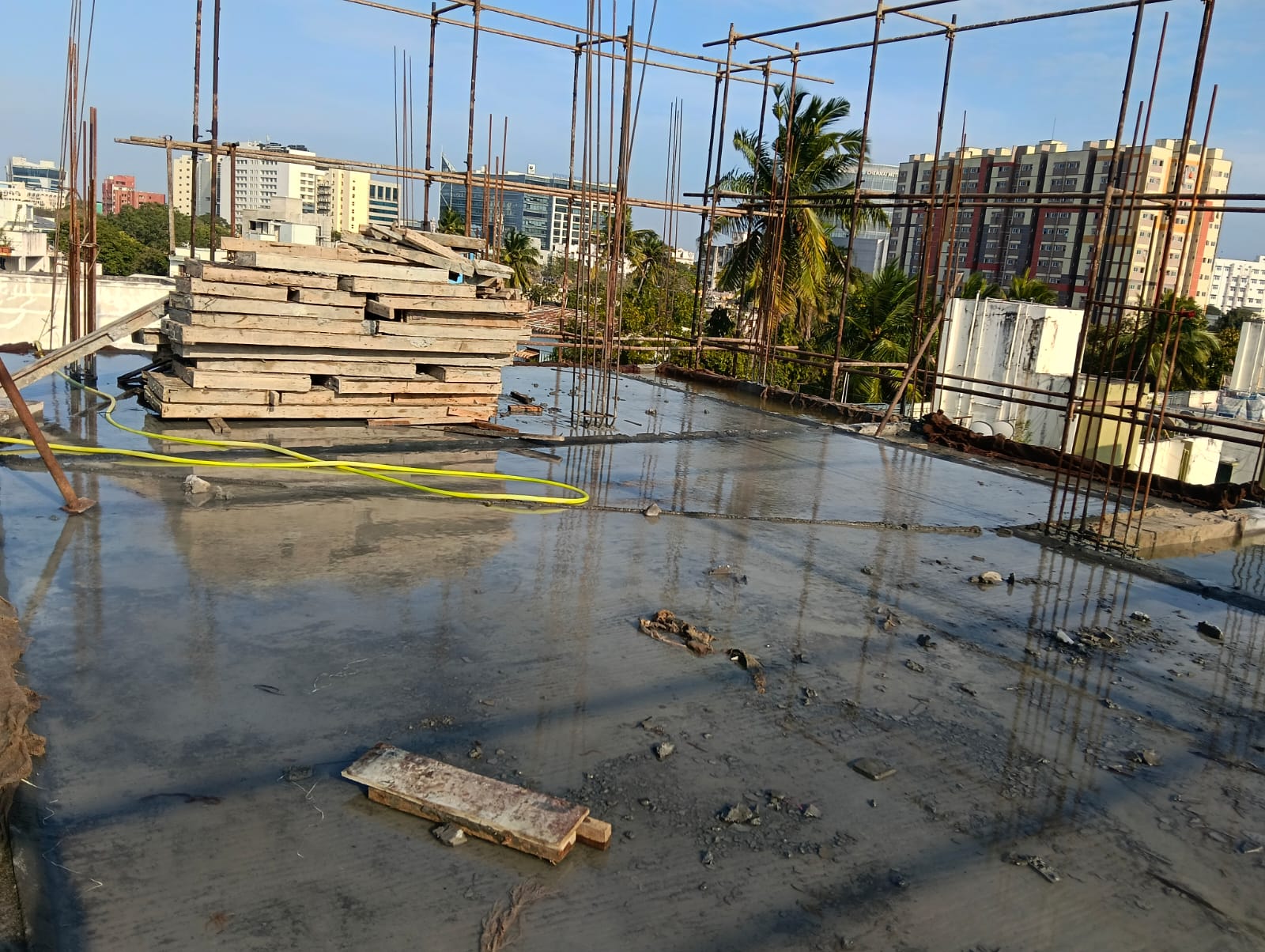

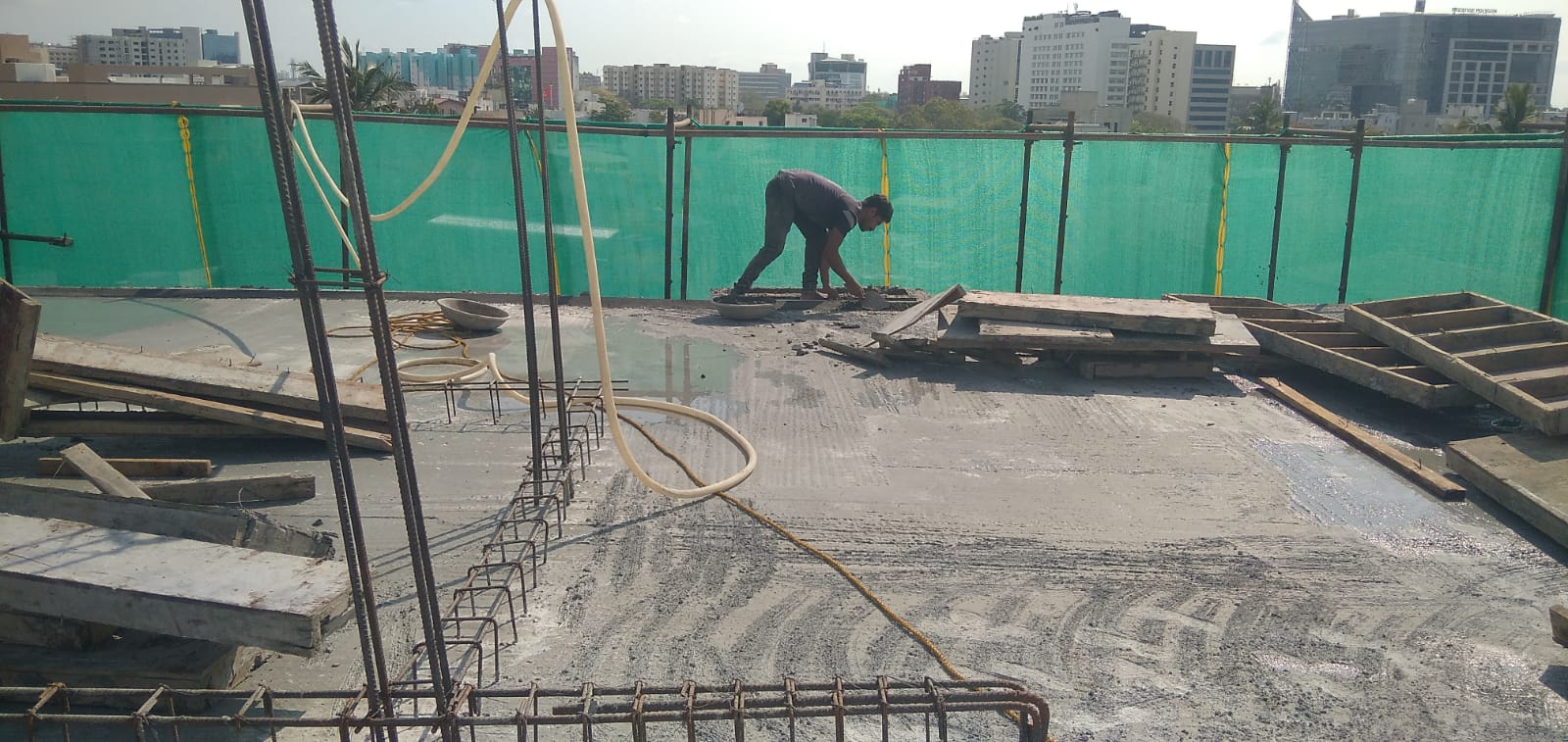

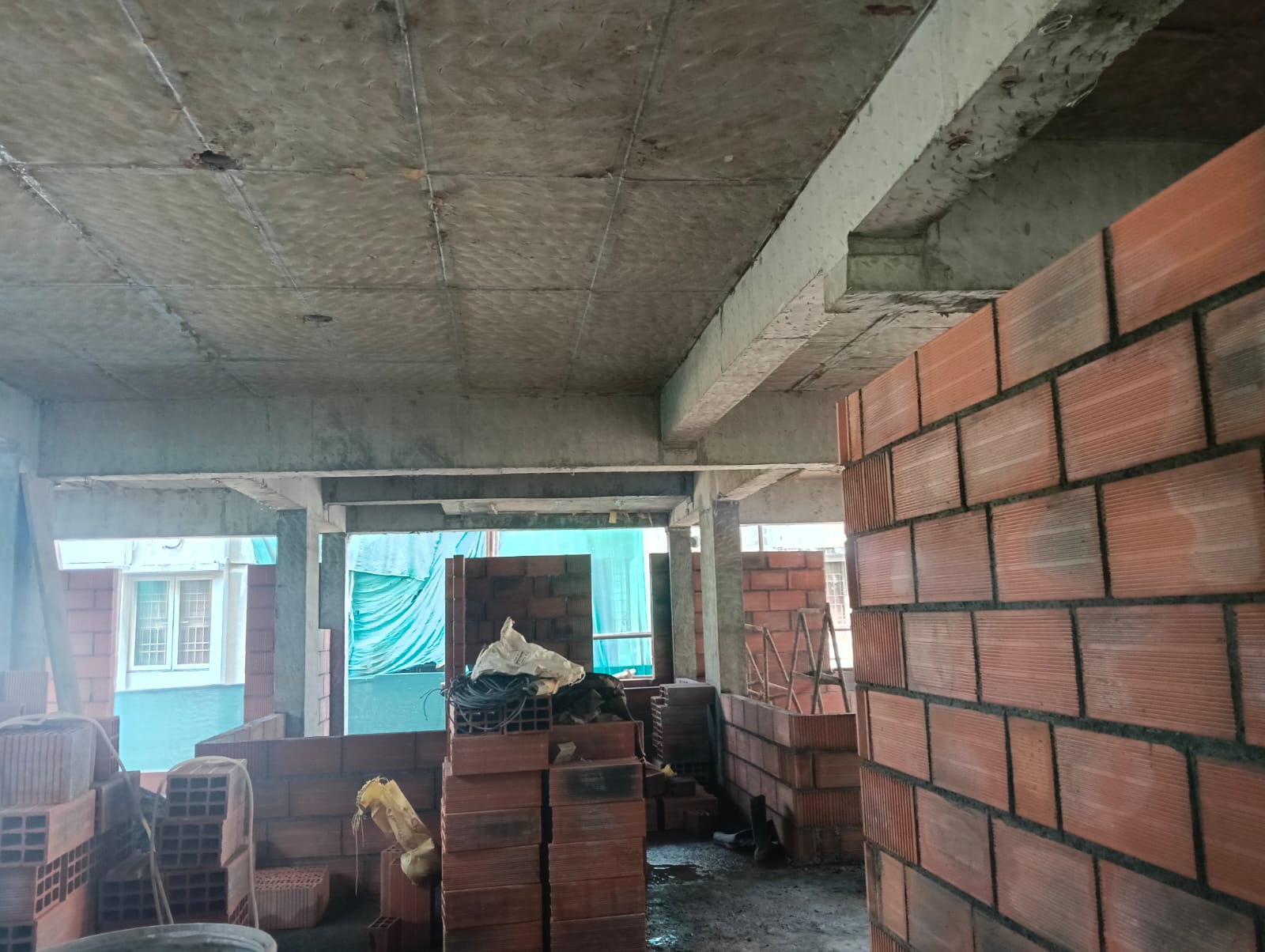

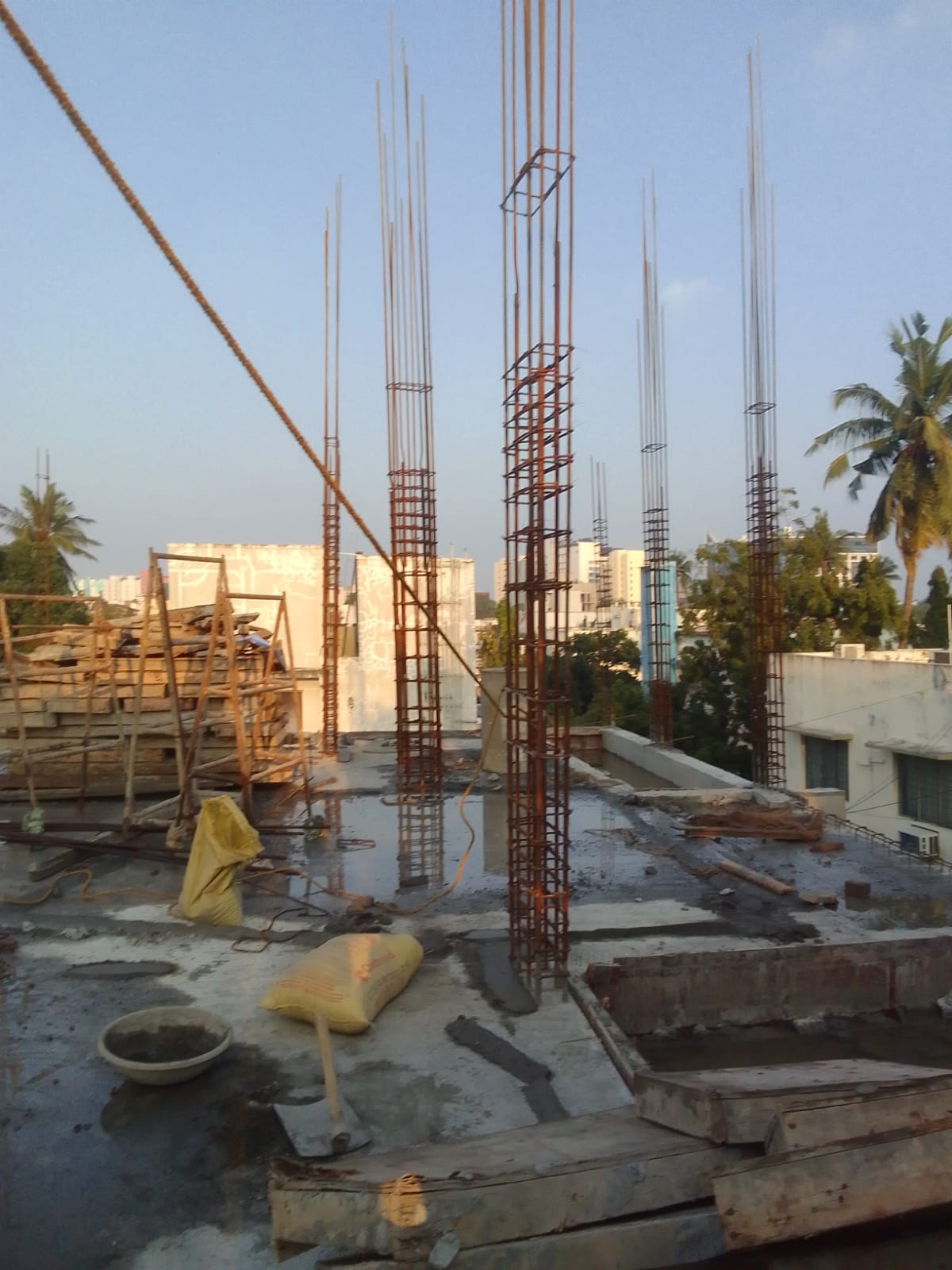

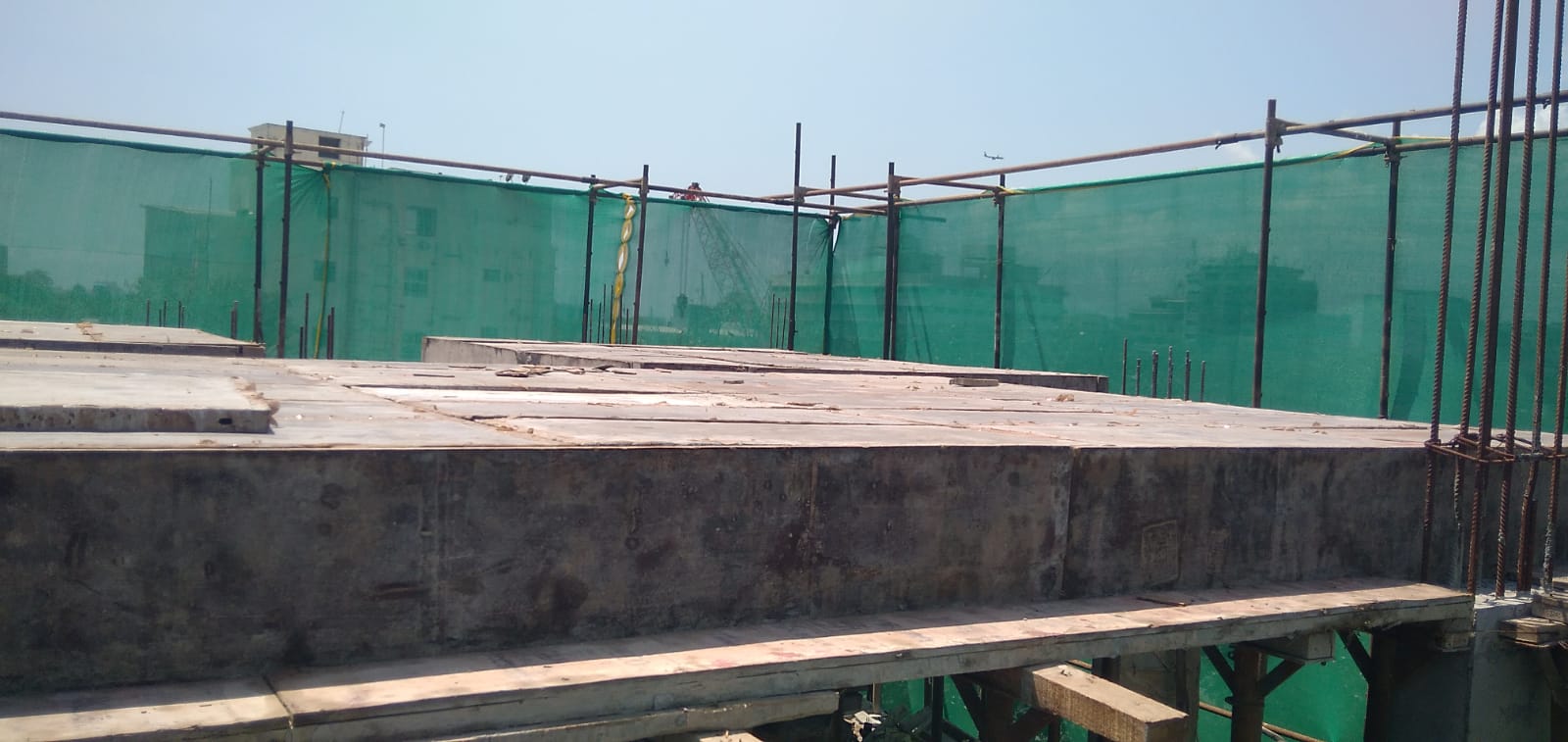

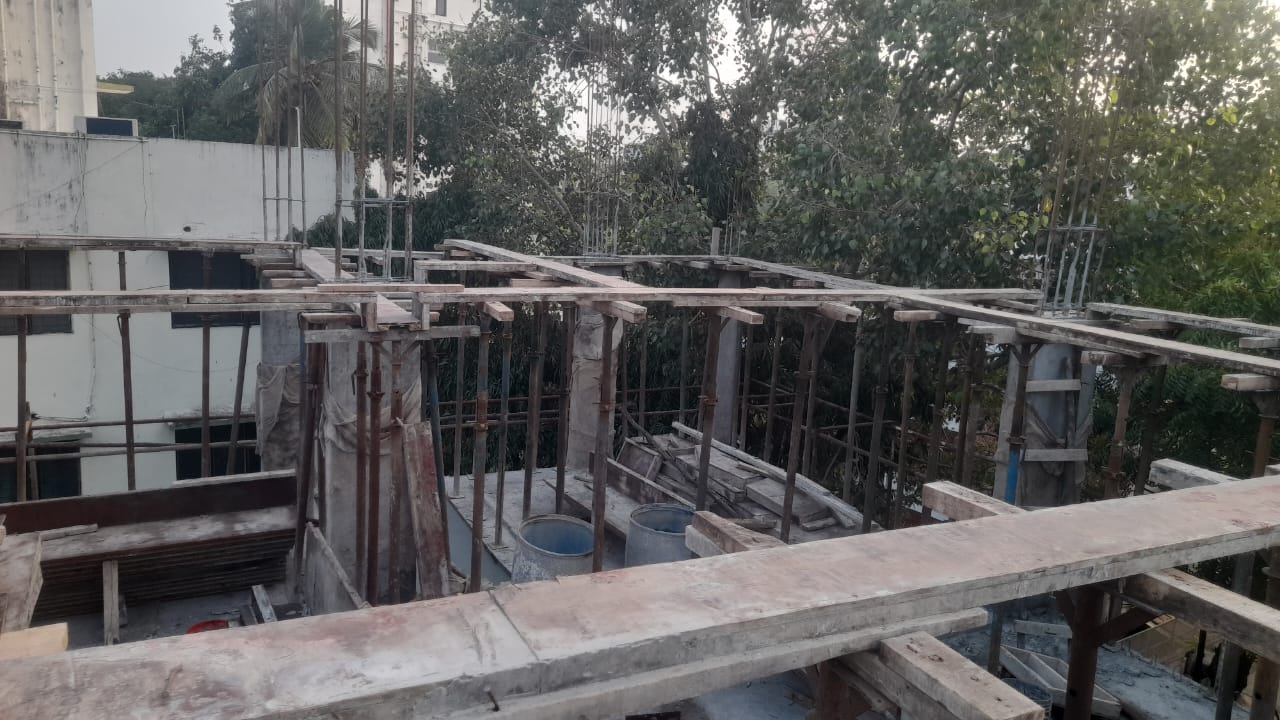

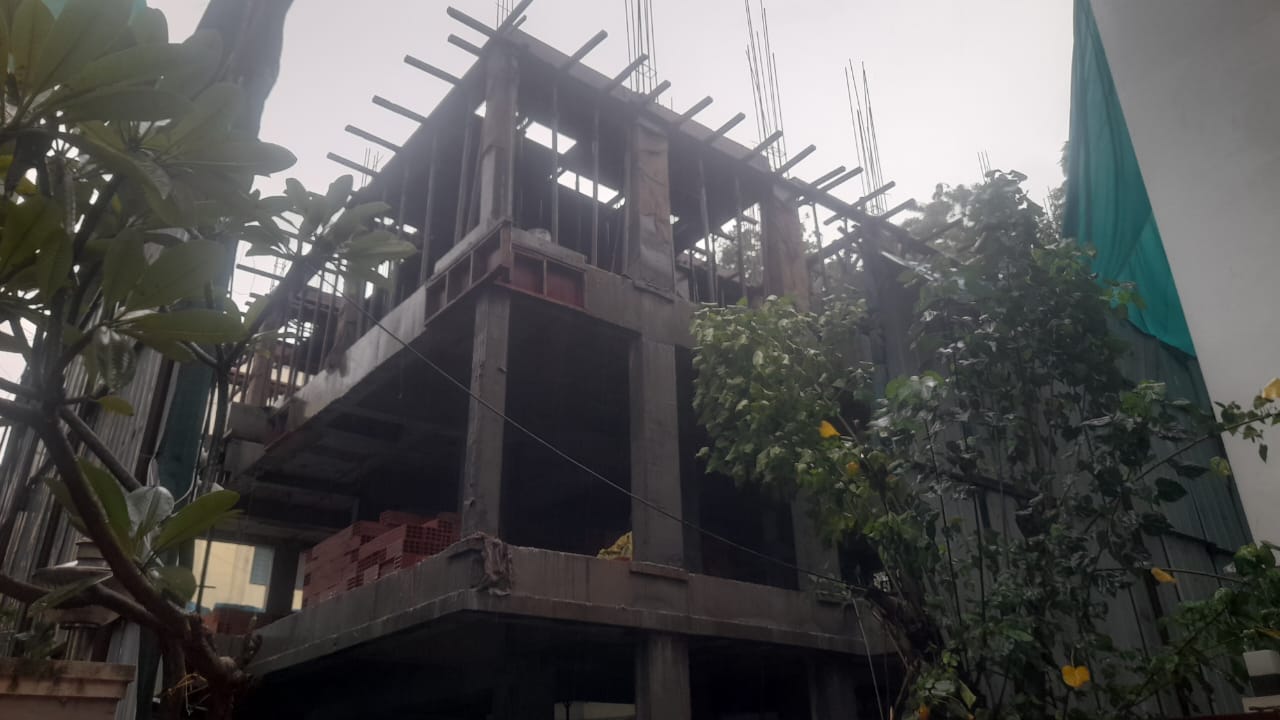

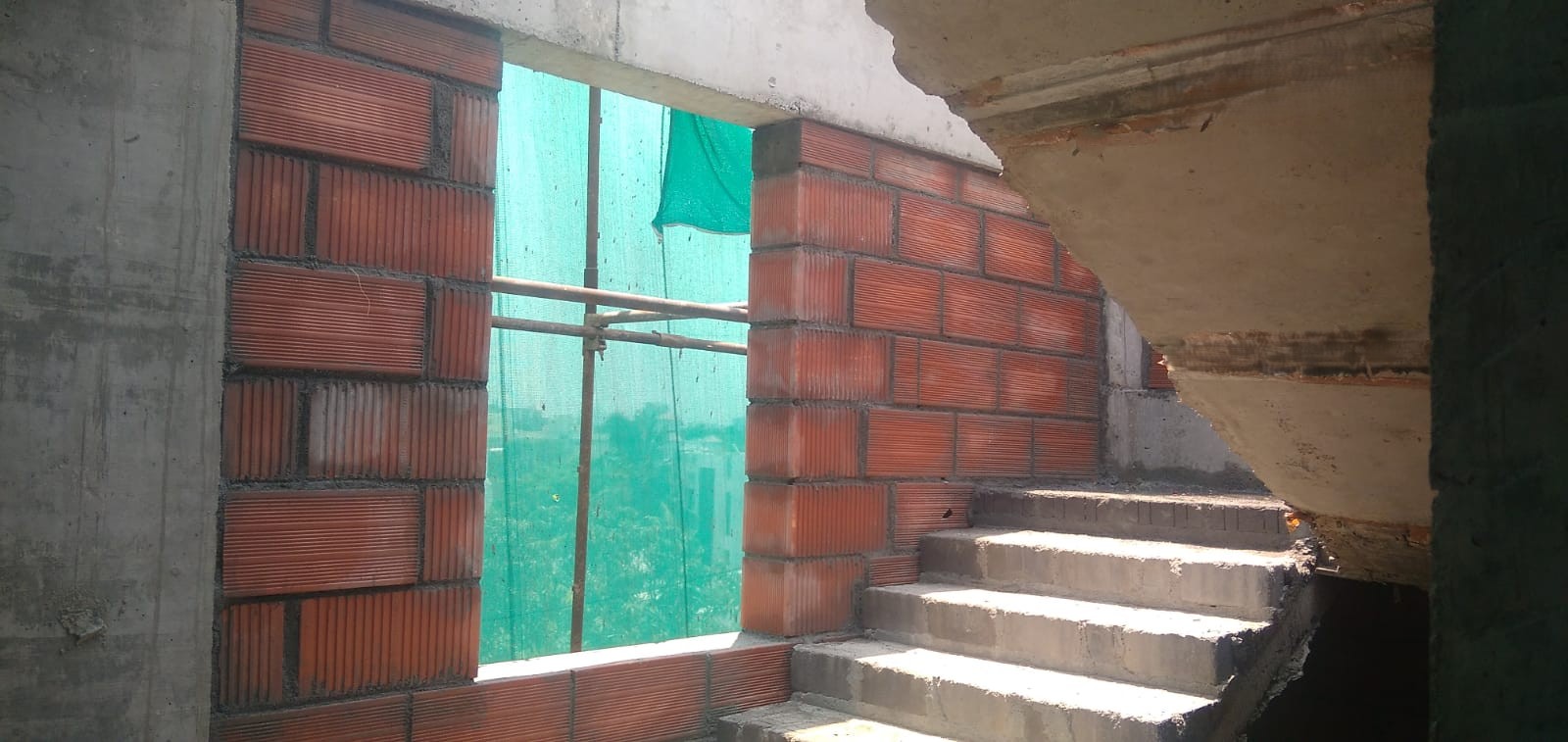

Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image

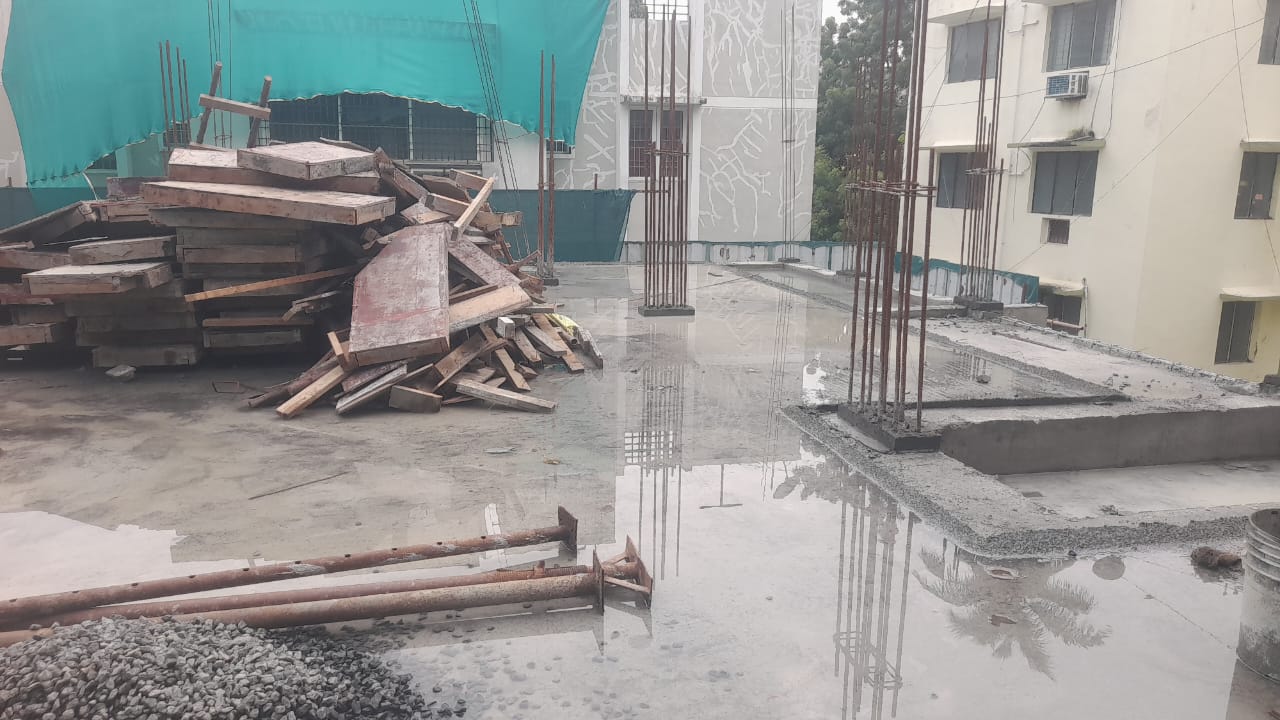

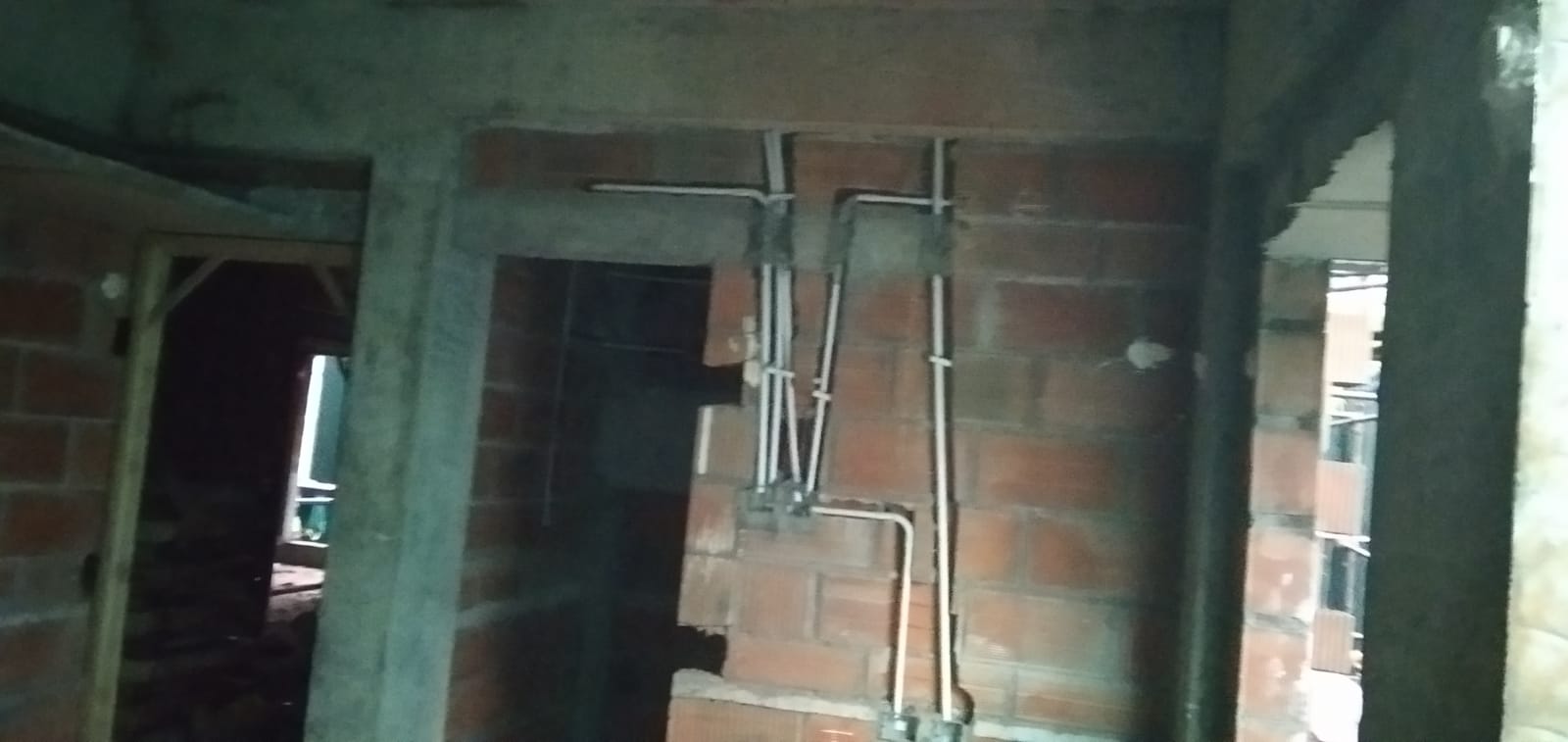

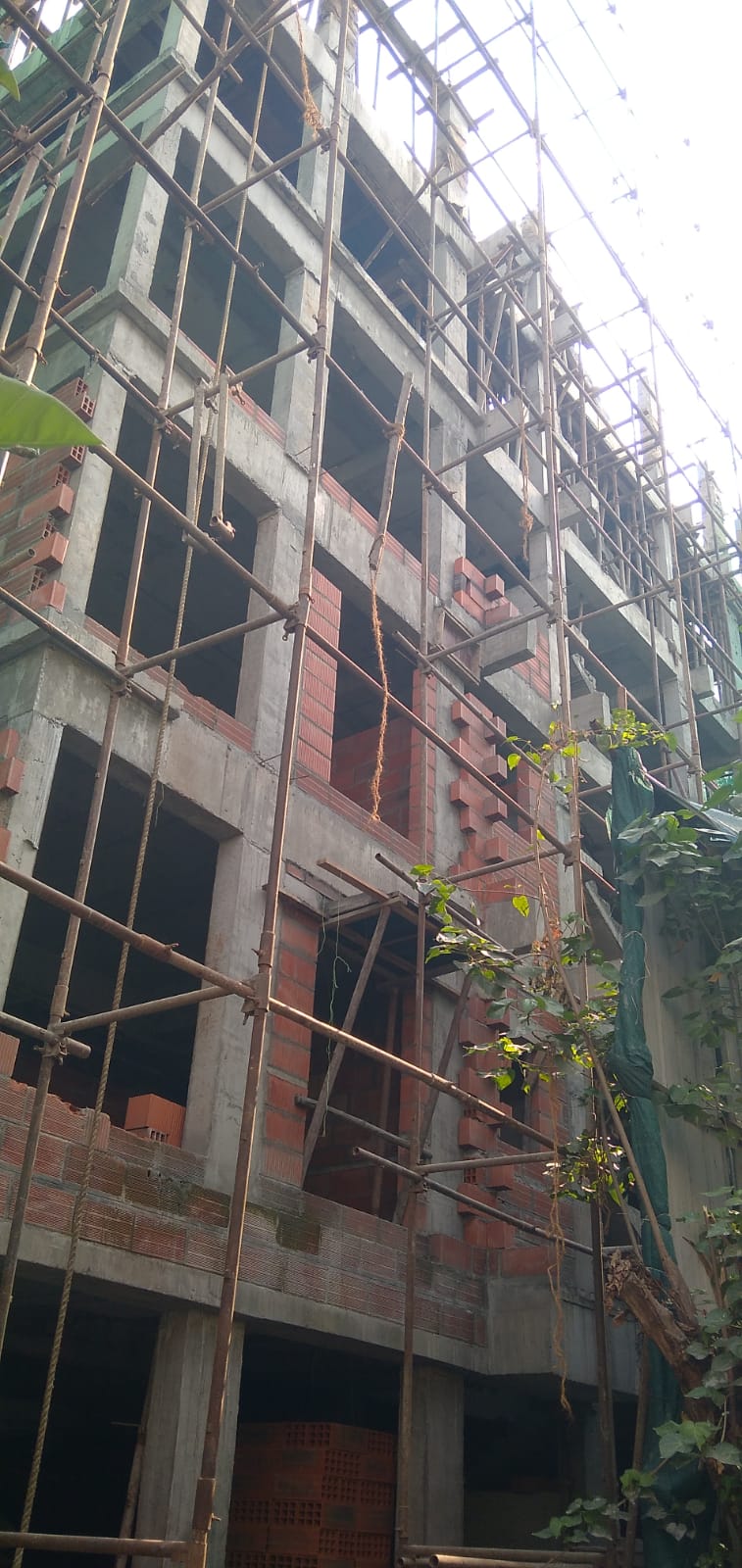

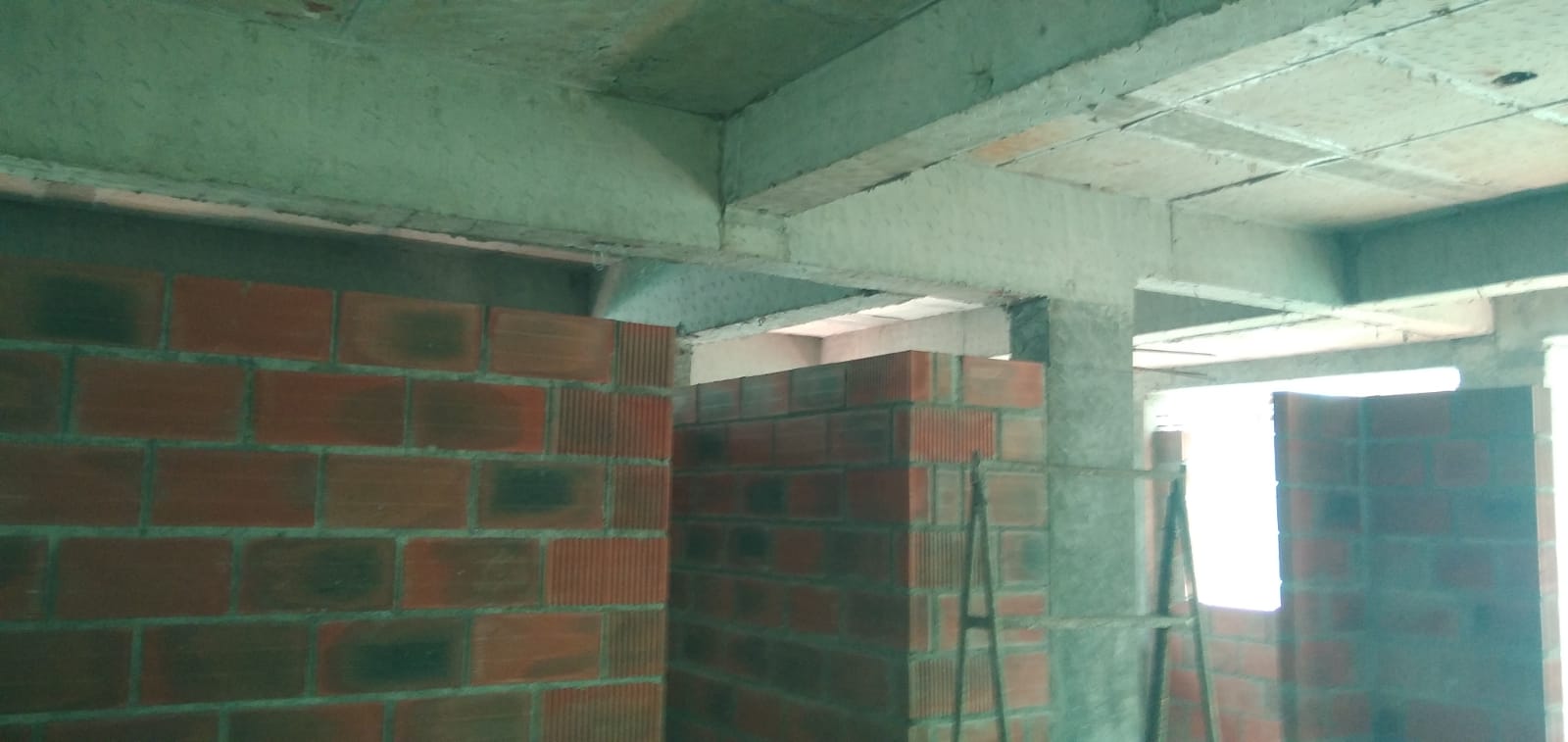

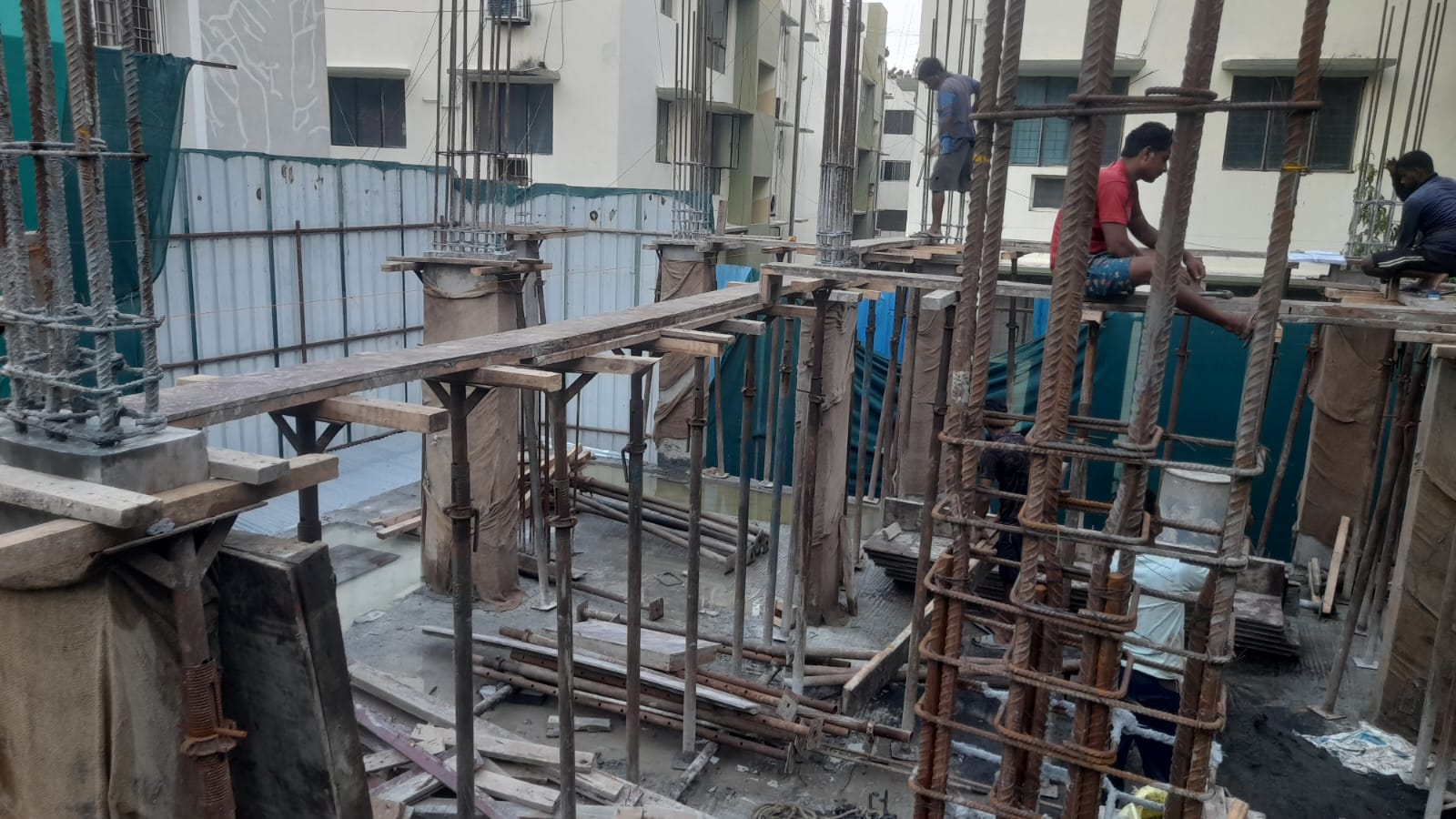

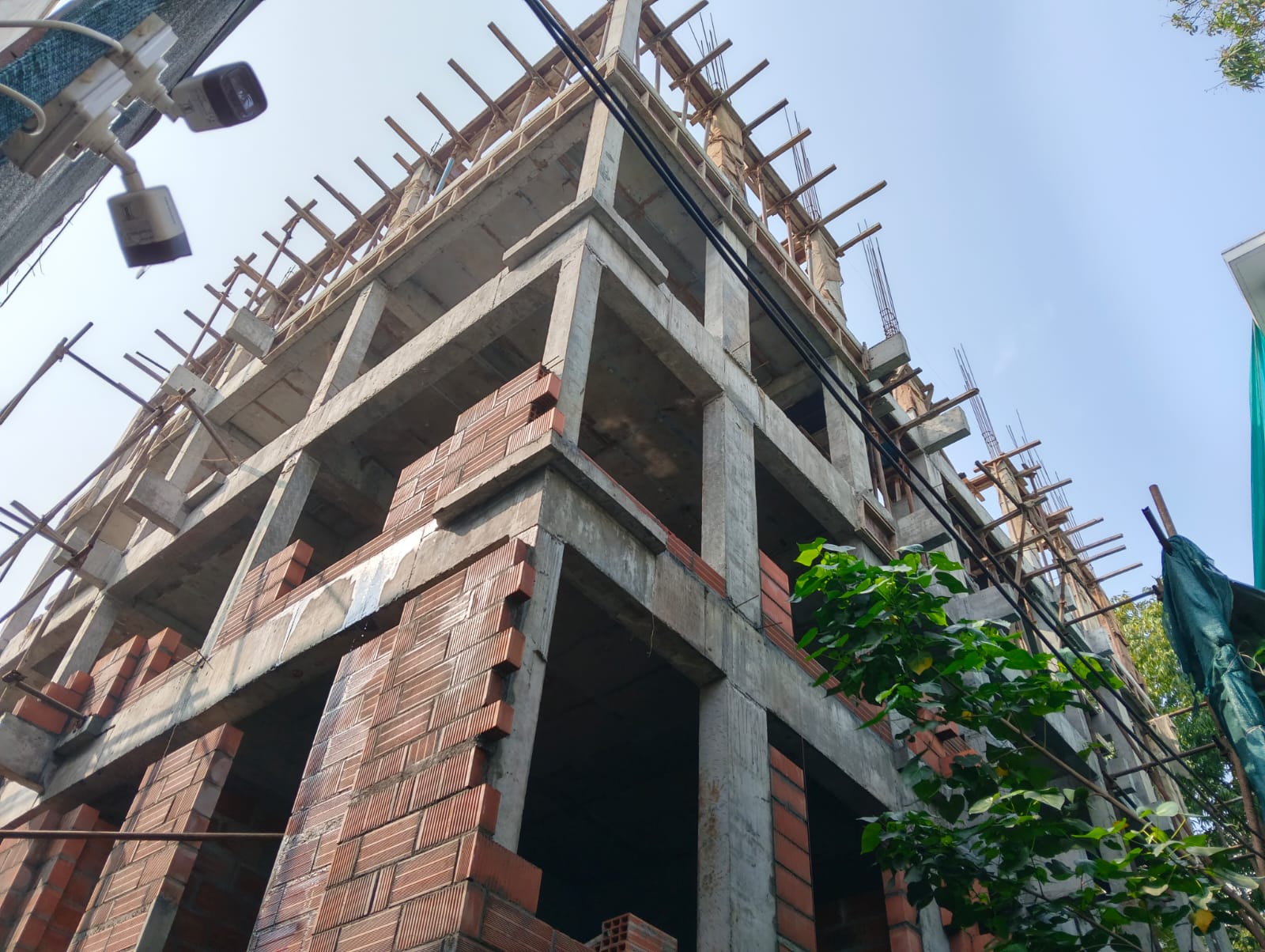

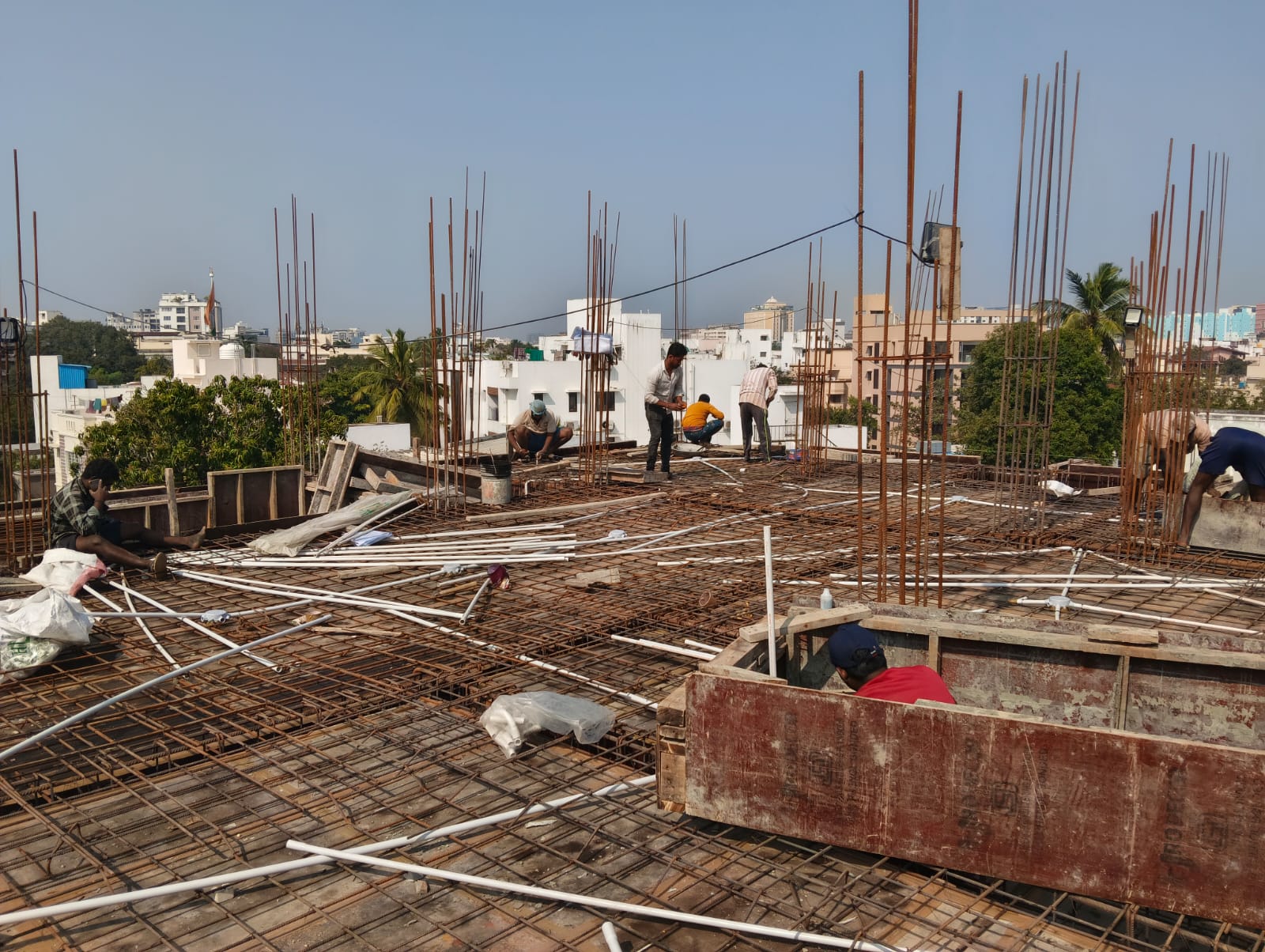

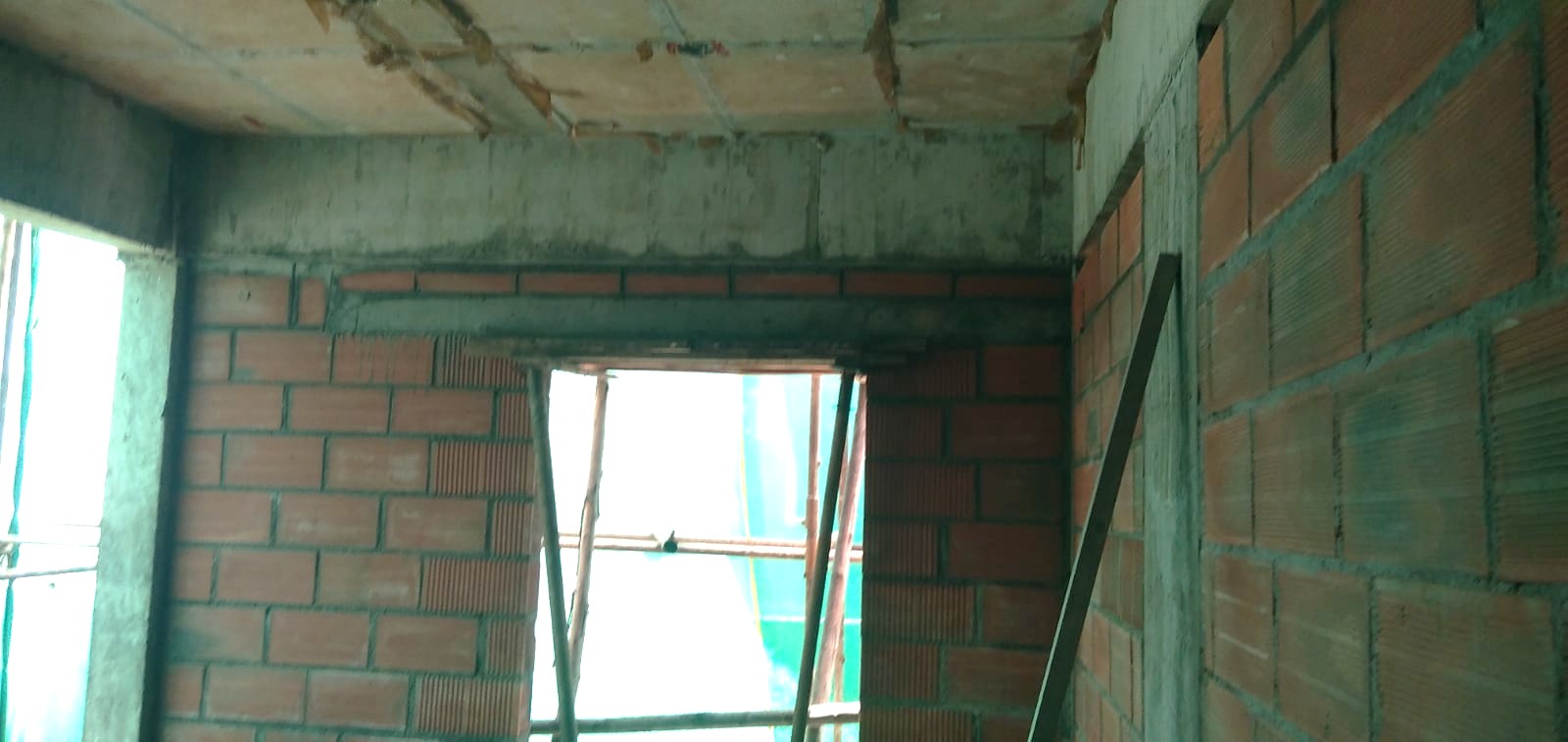

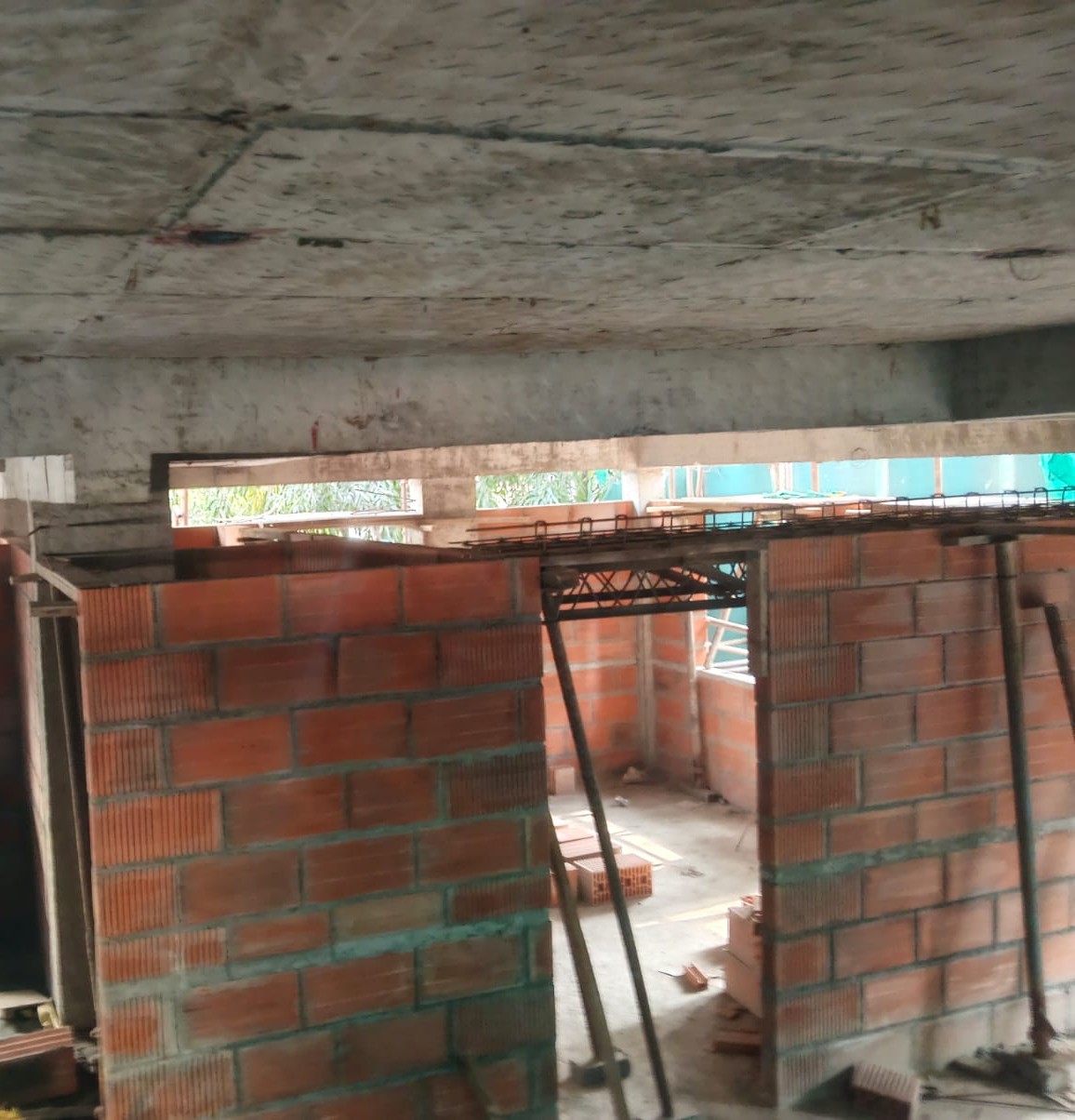

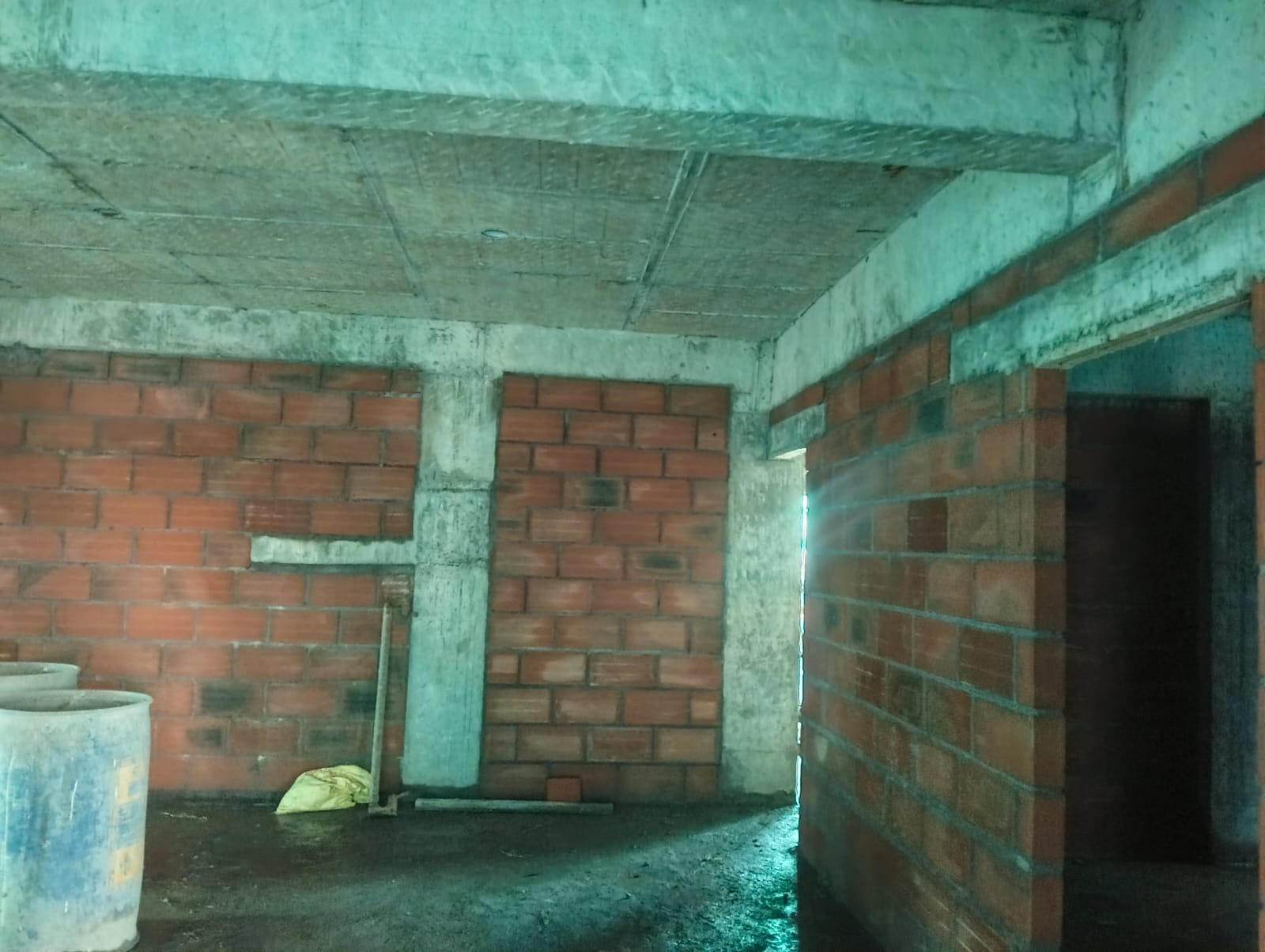

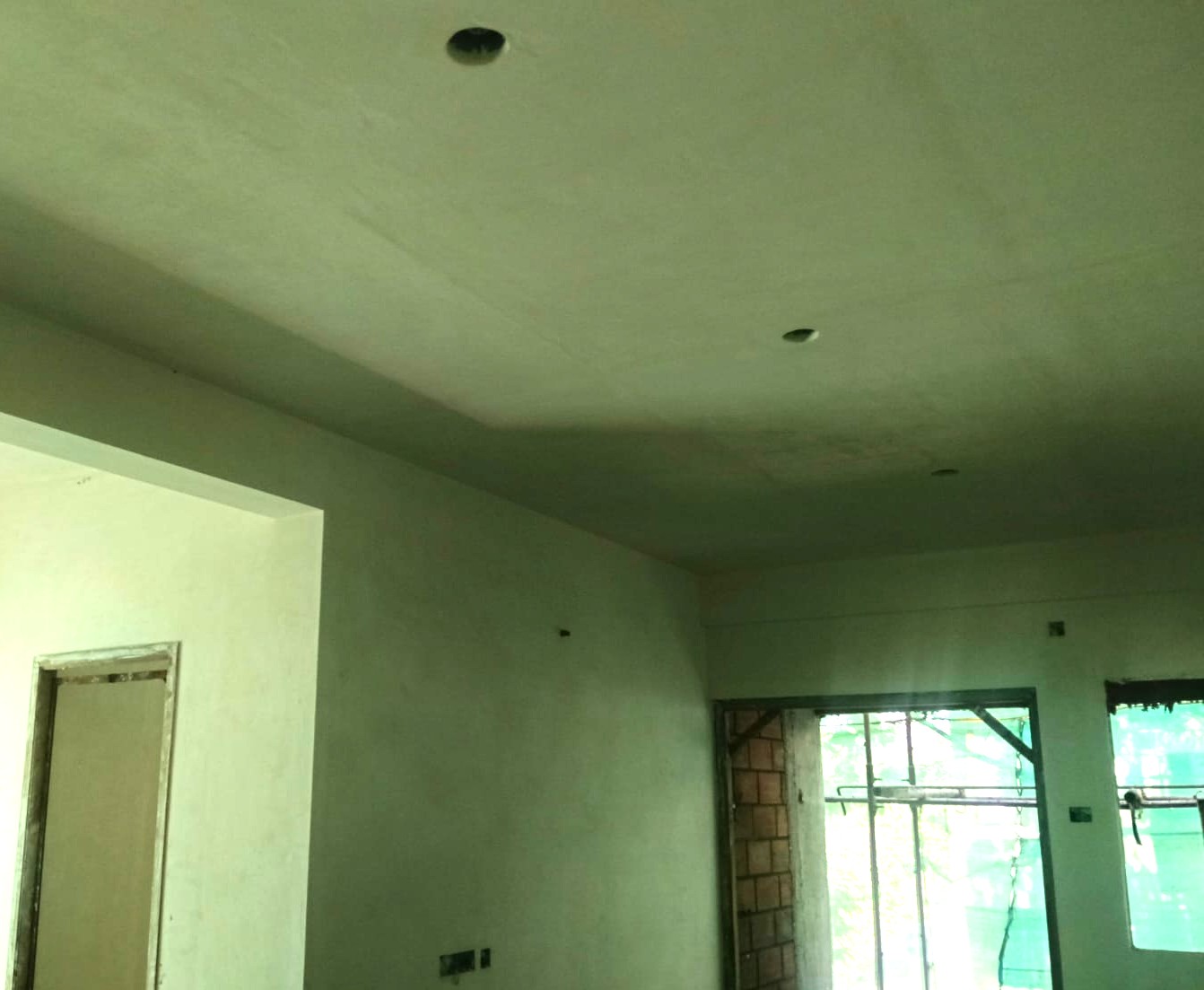

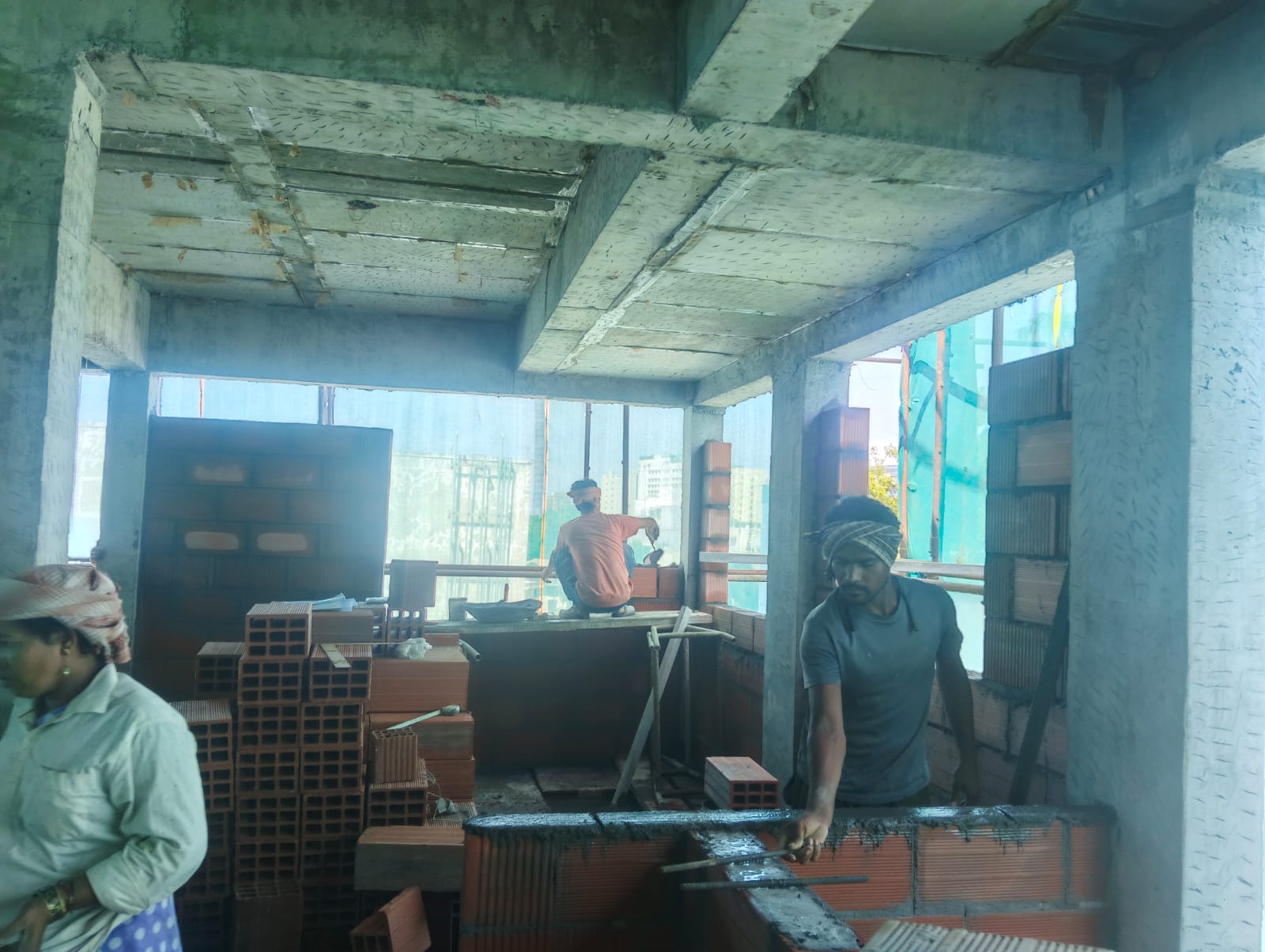

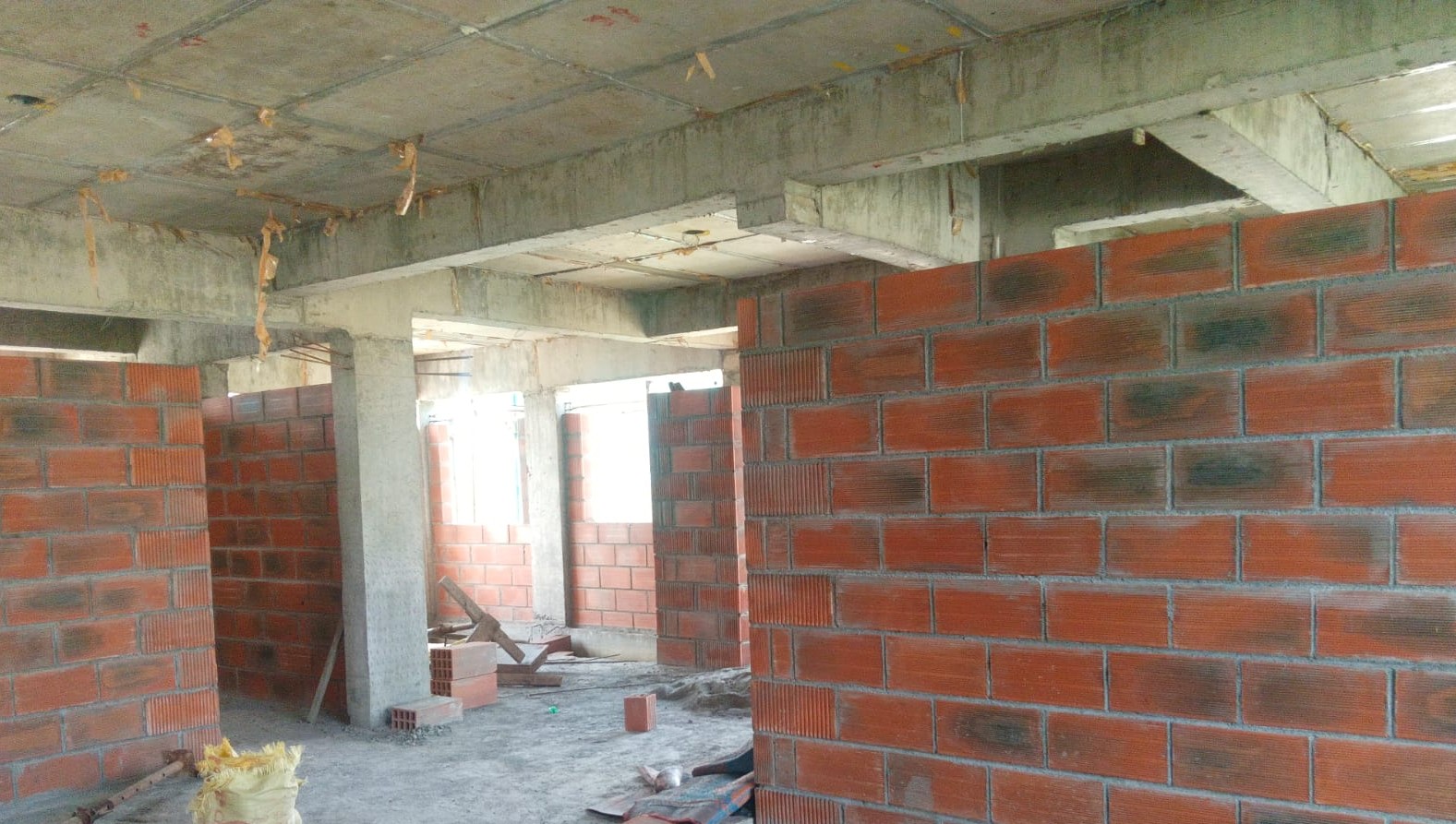

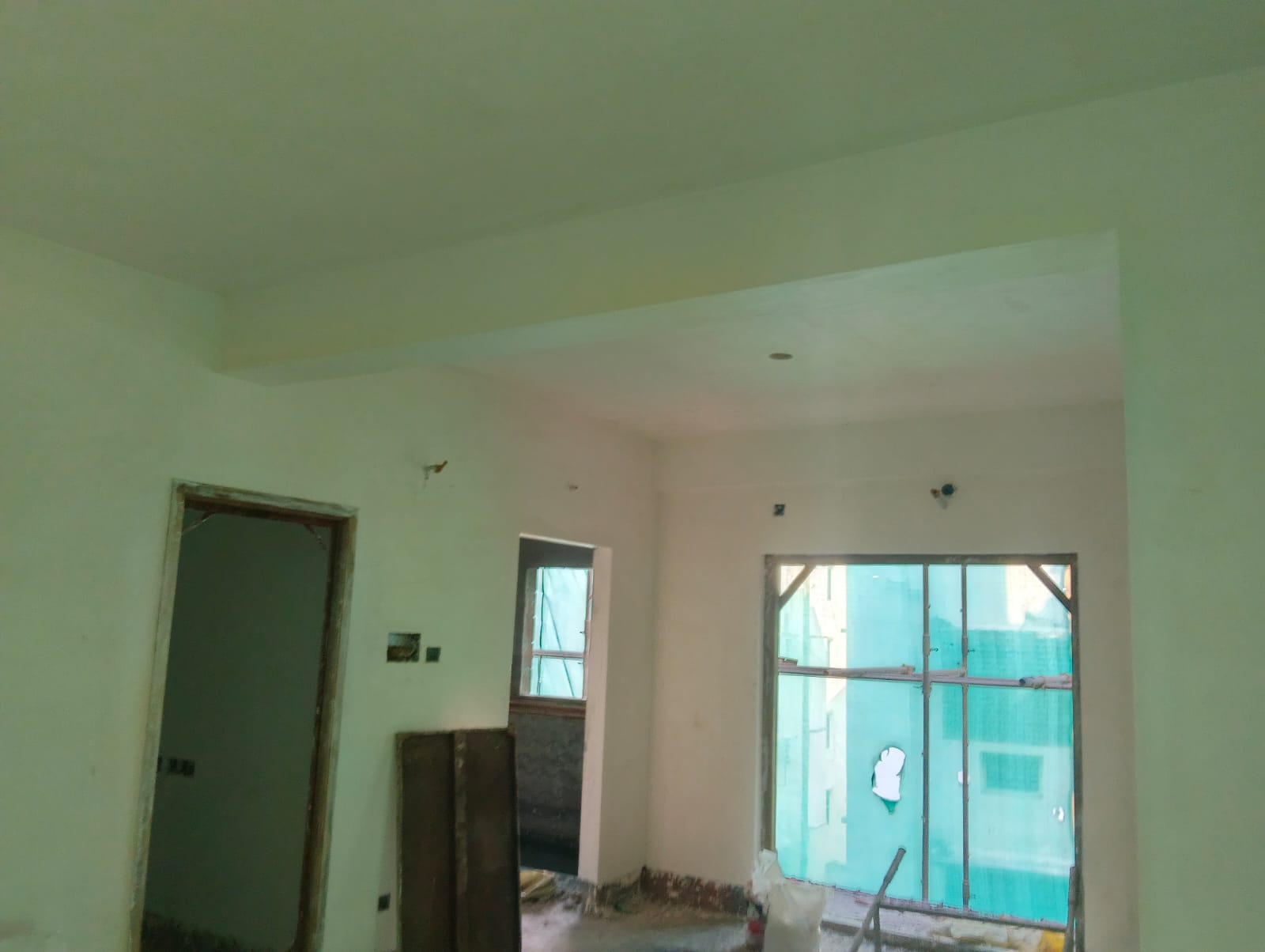

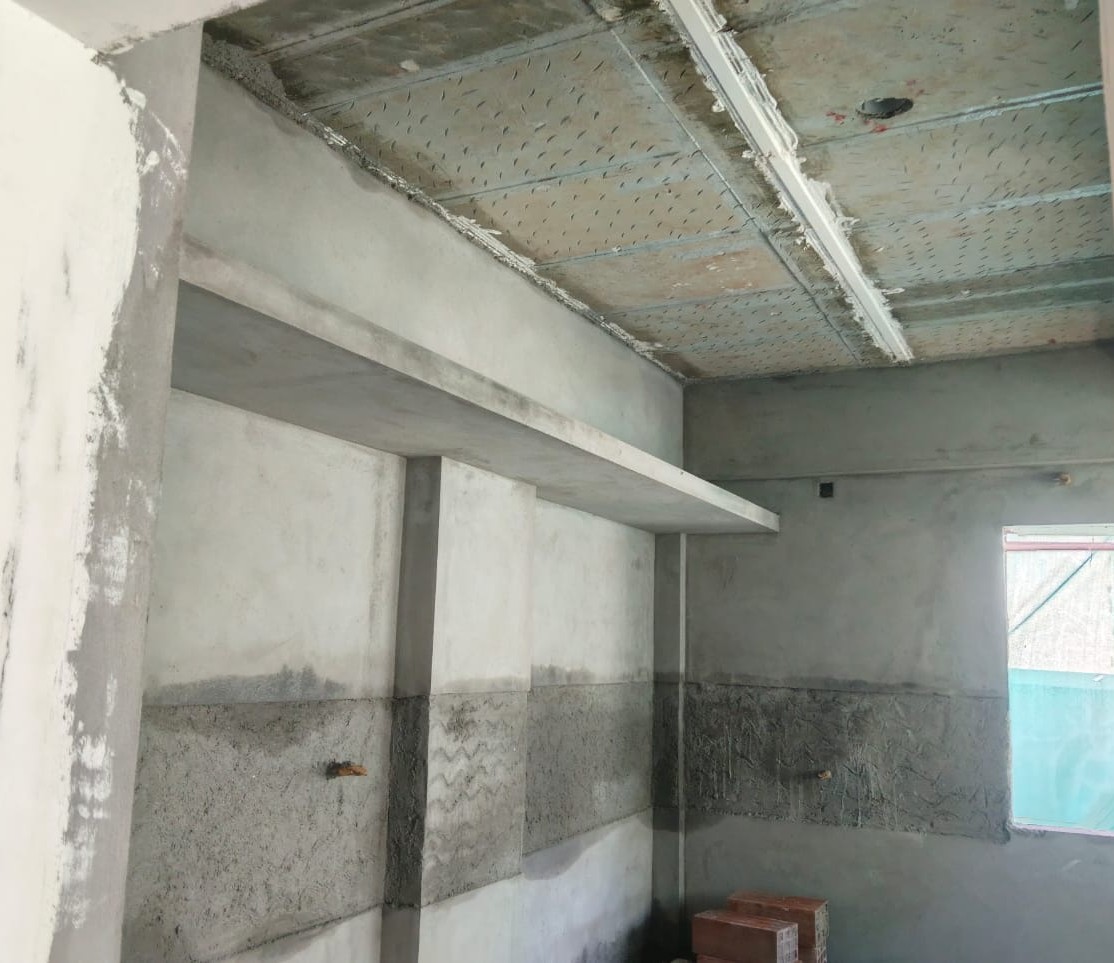

  • Up to 2nd Floor plastering work is completed.
  • 3rd Floor plastering work is in progress.(60% completed)

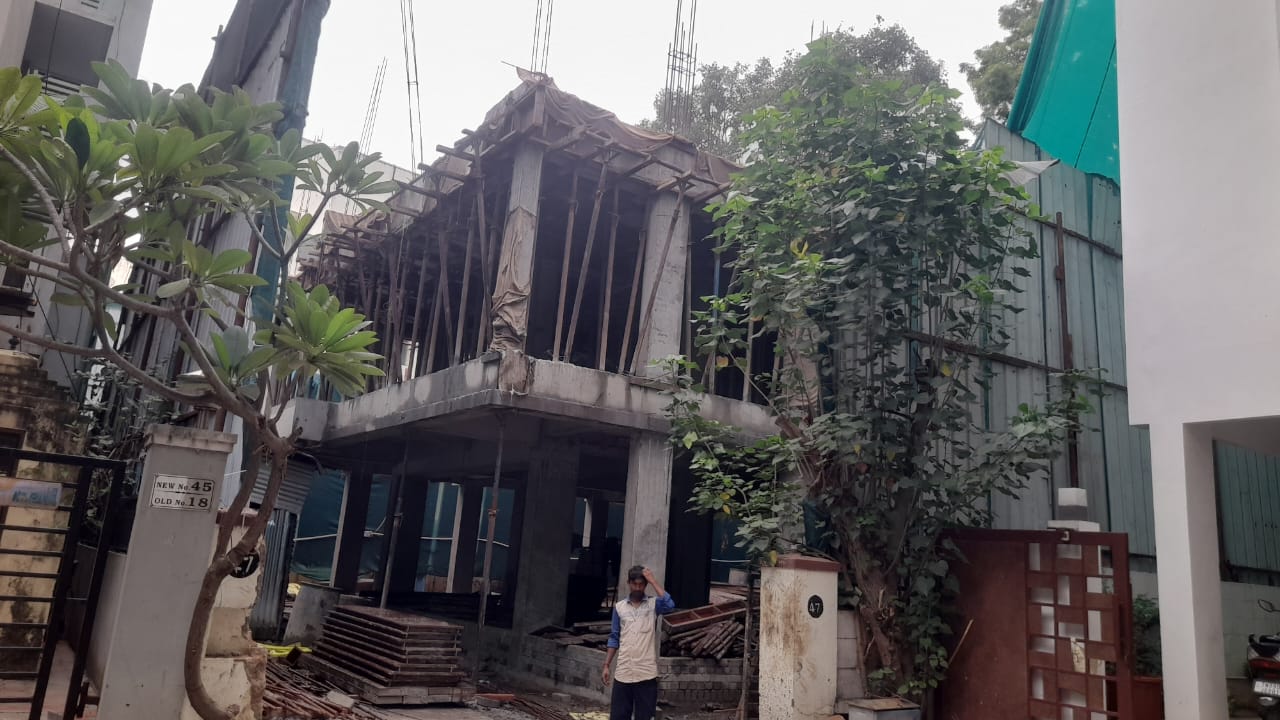

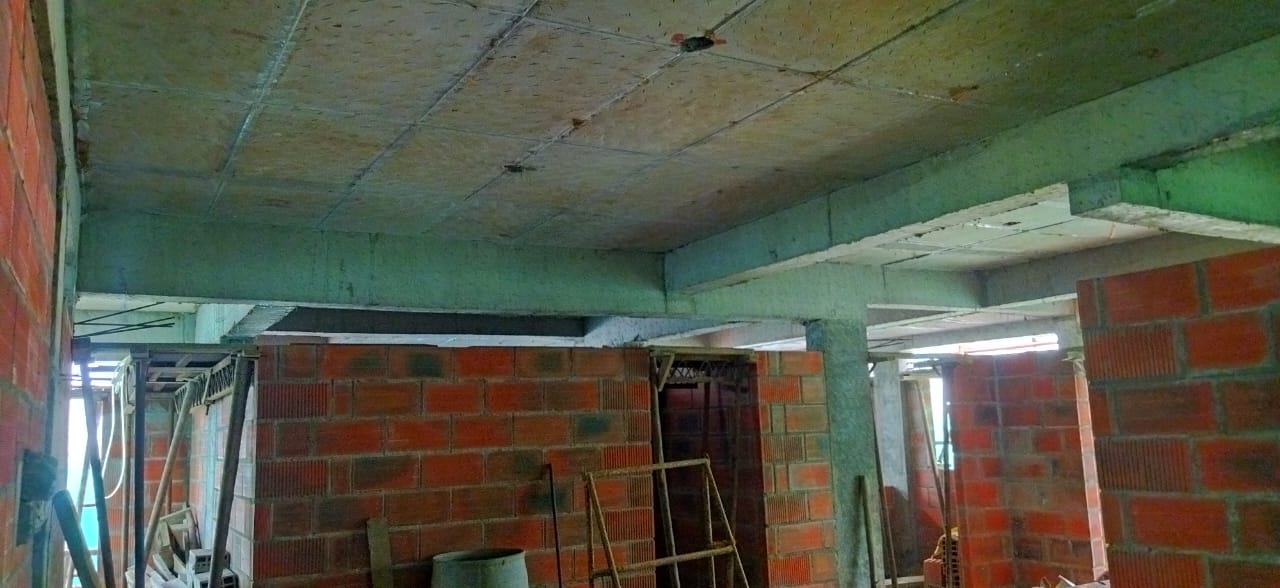

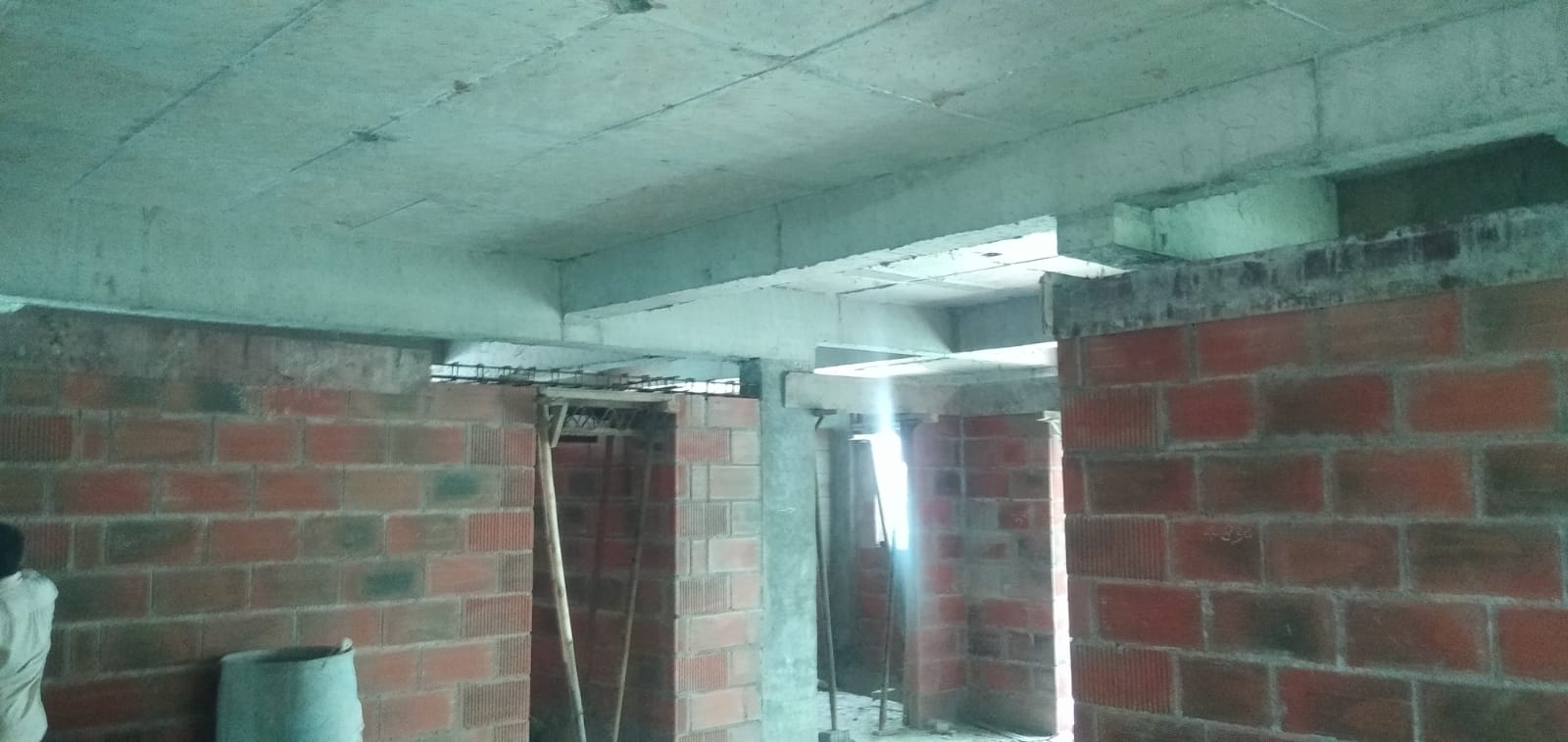

  • 4th floor plastering work is in progress.(Electrical wall chasing work completed)
  • 5th Floor block work is in progress. (70% completed)
  • Toilet plumbing work is in progress.(1st& 2nd floor progress).
  • Duct brick work is in progress.(80% completed)

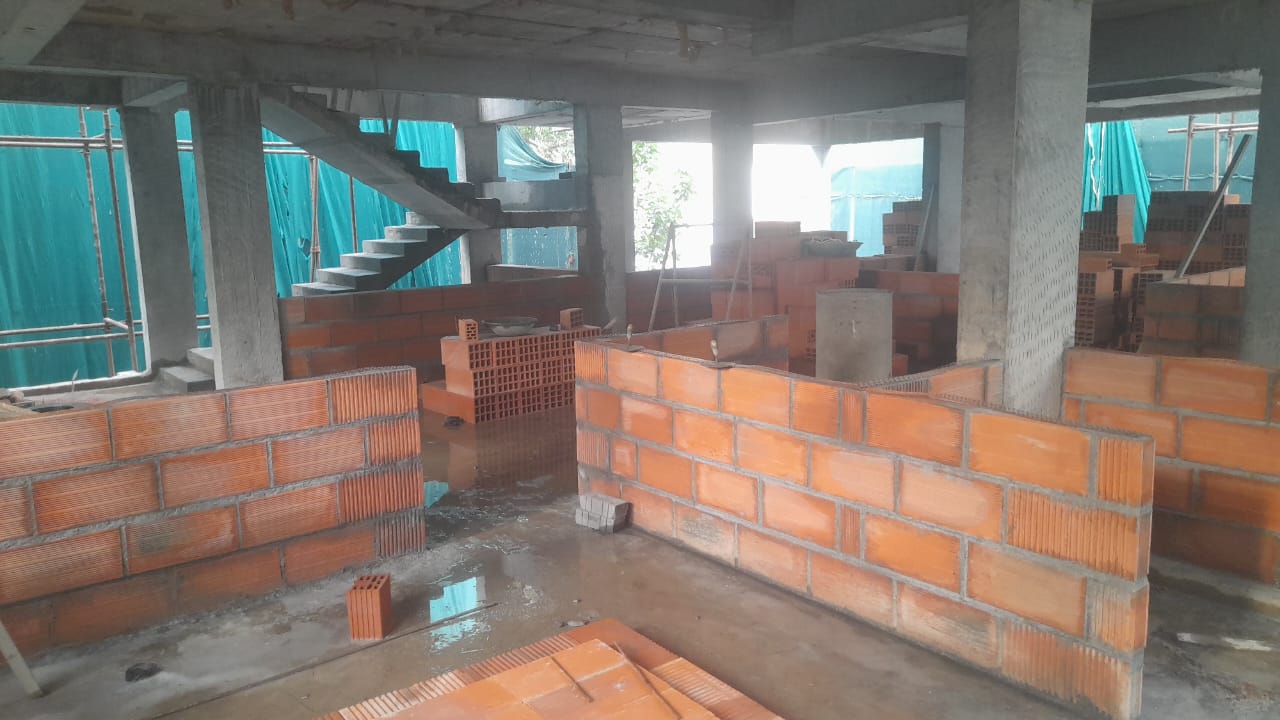

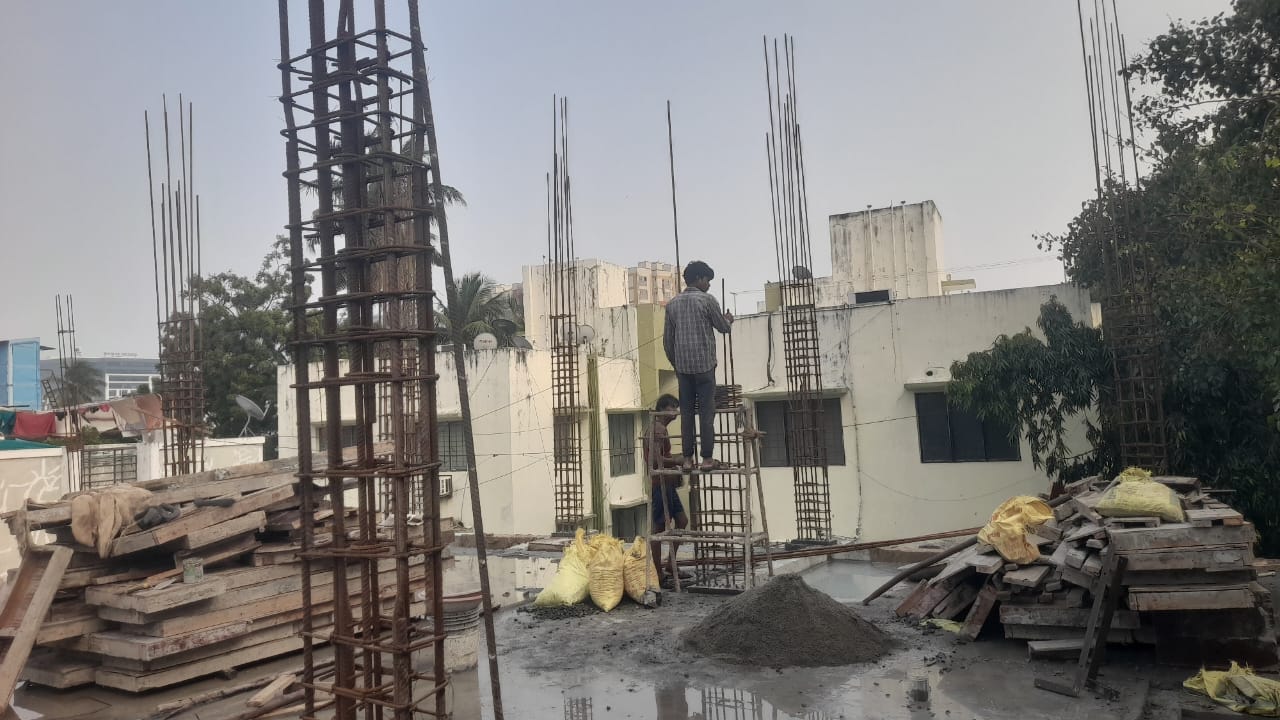

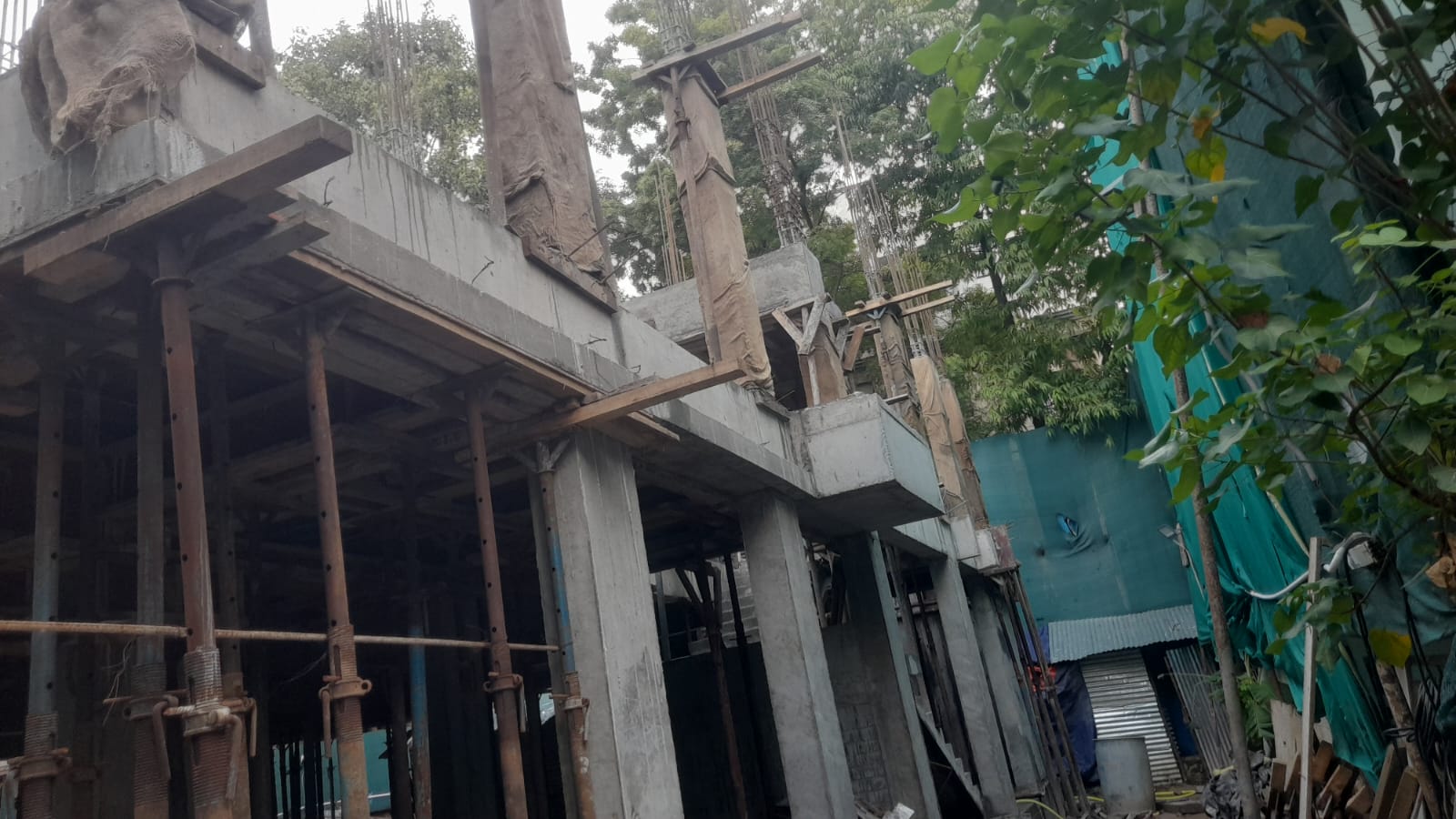

  • Head room brick work is in progress.

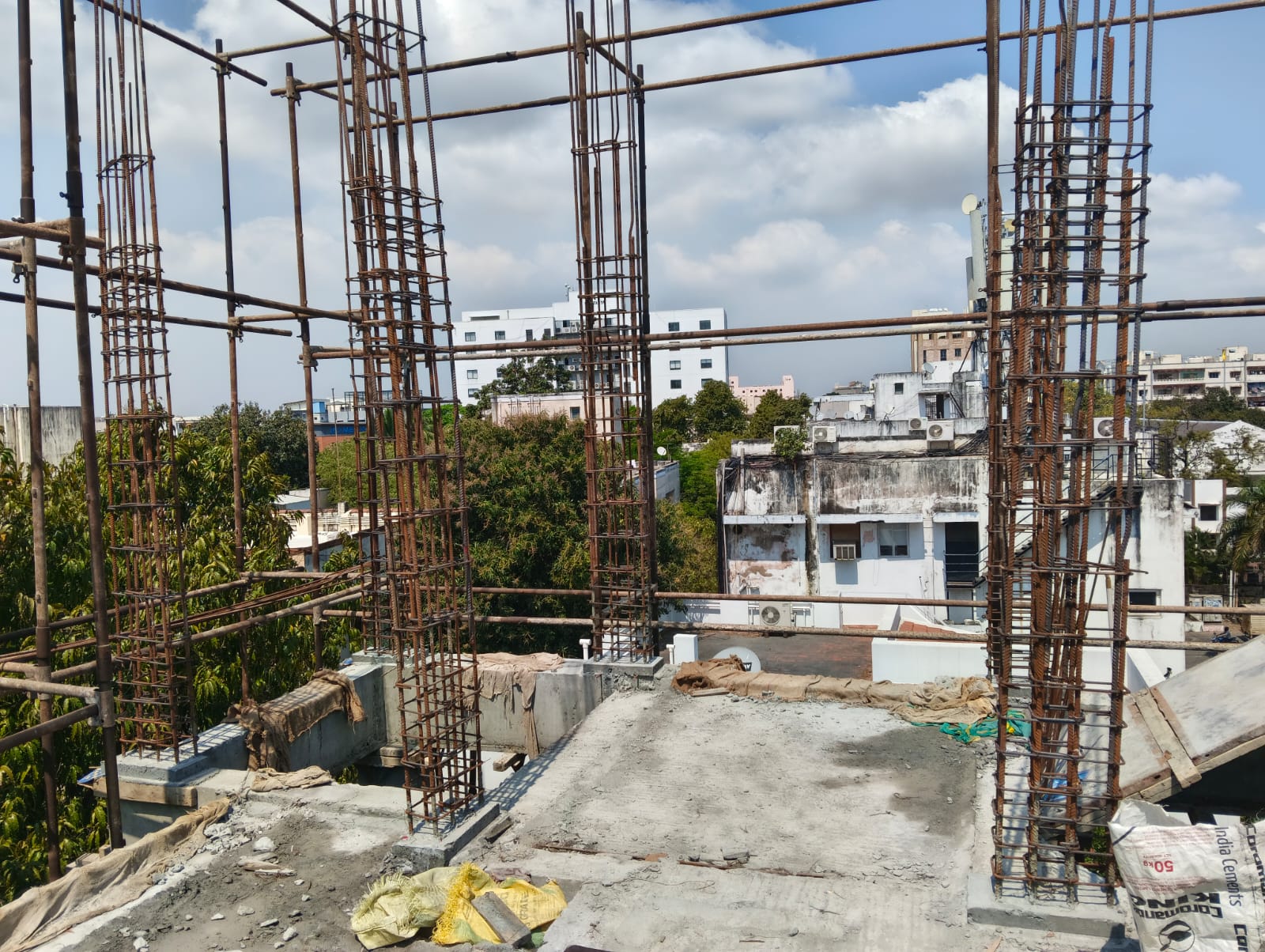

  • OHT base slab shuttering and bar bending work is in progress.

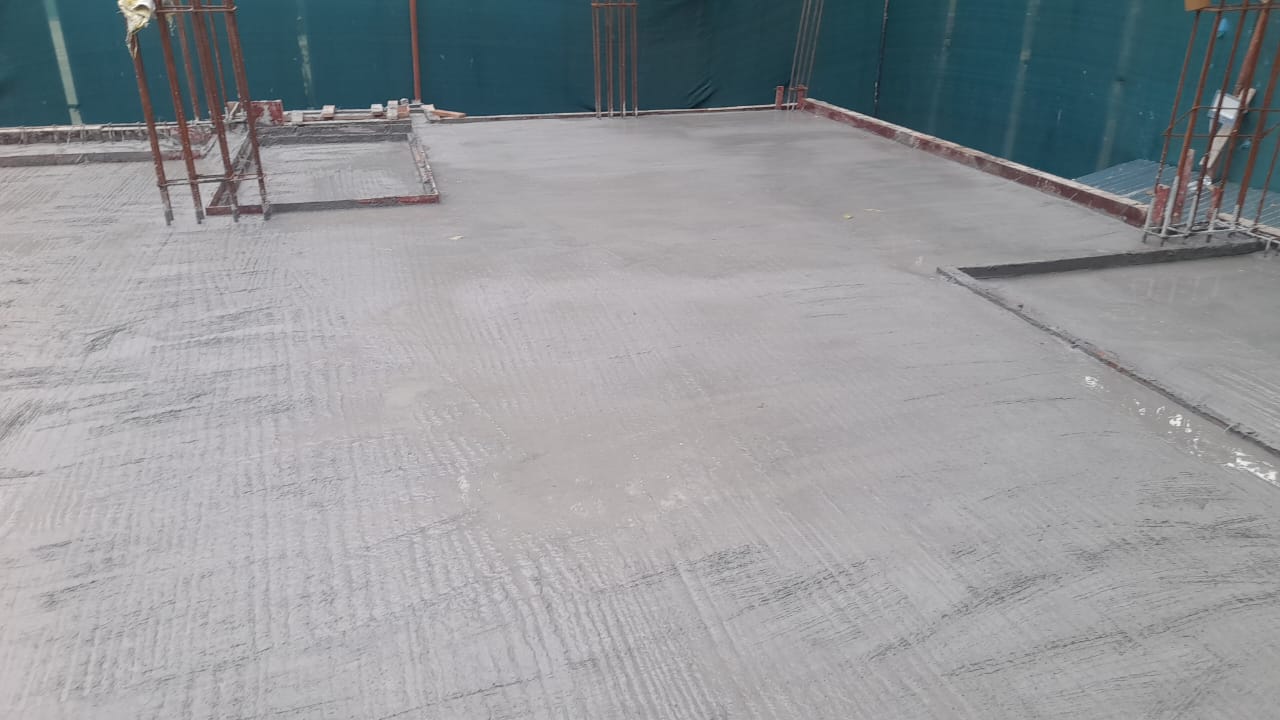

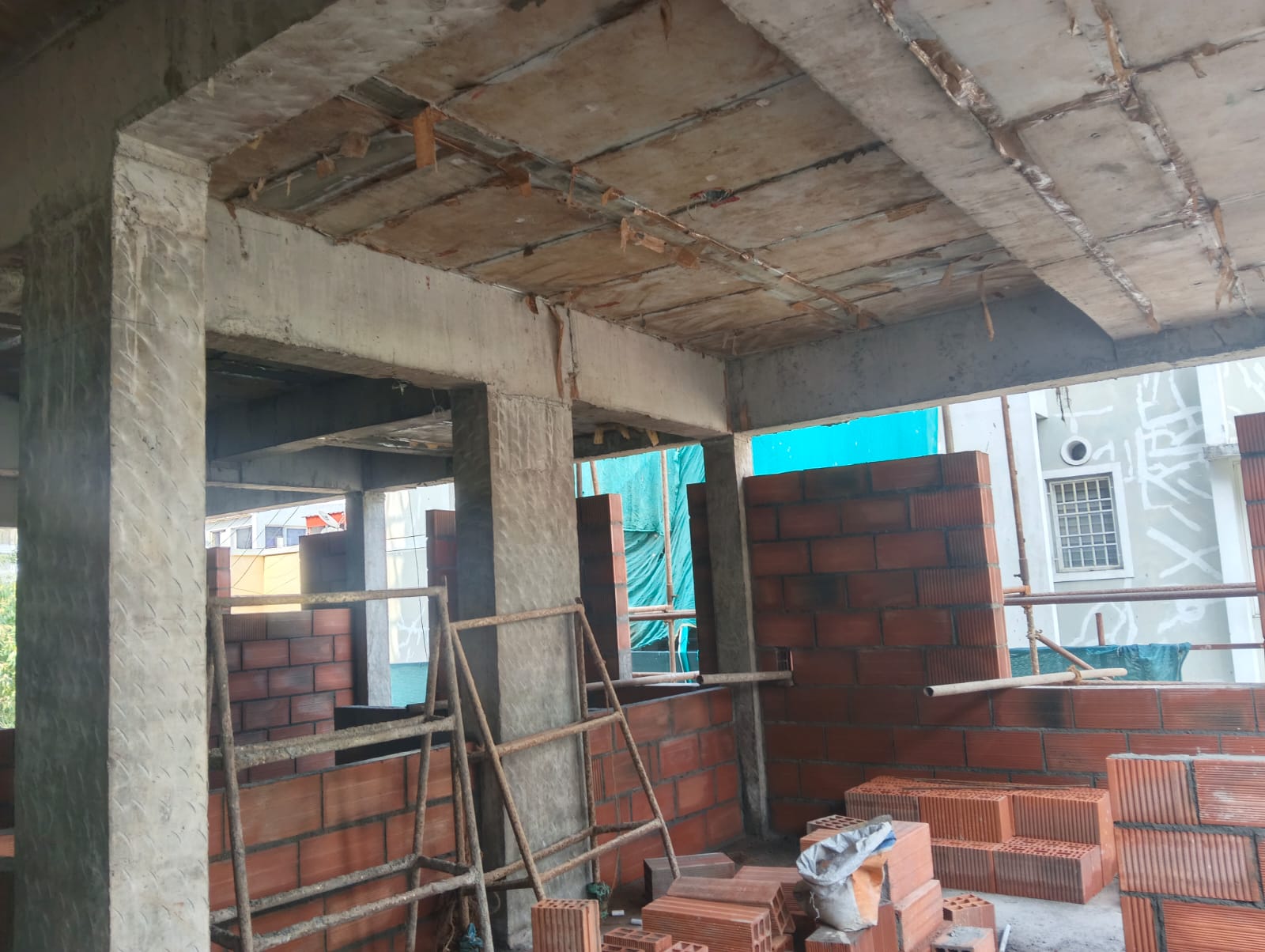

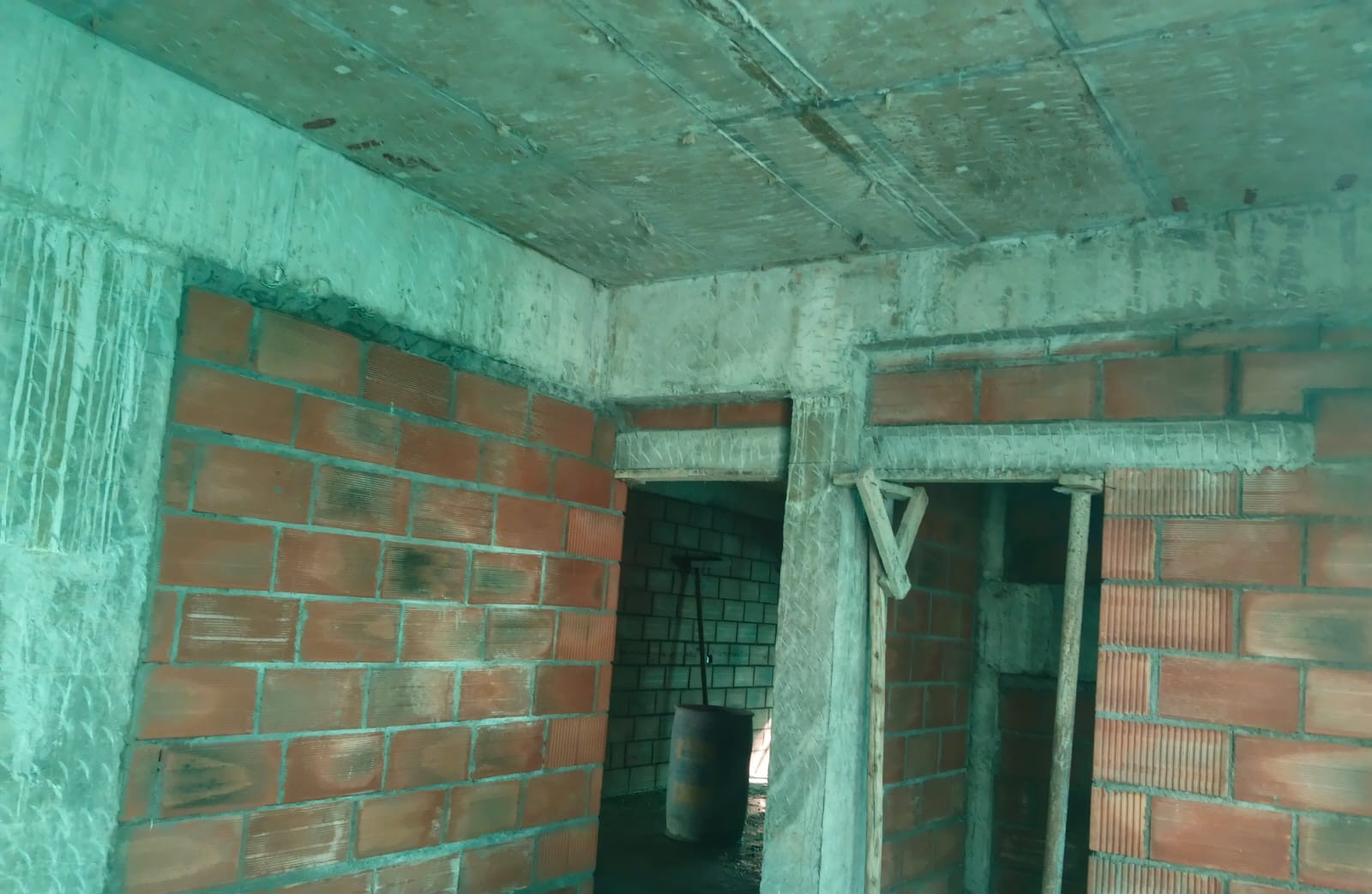

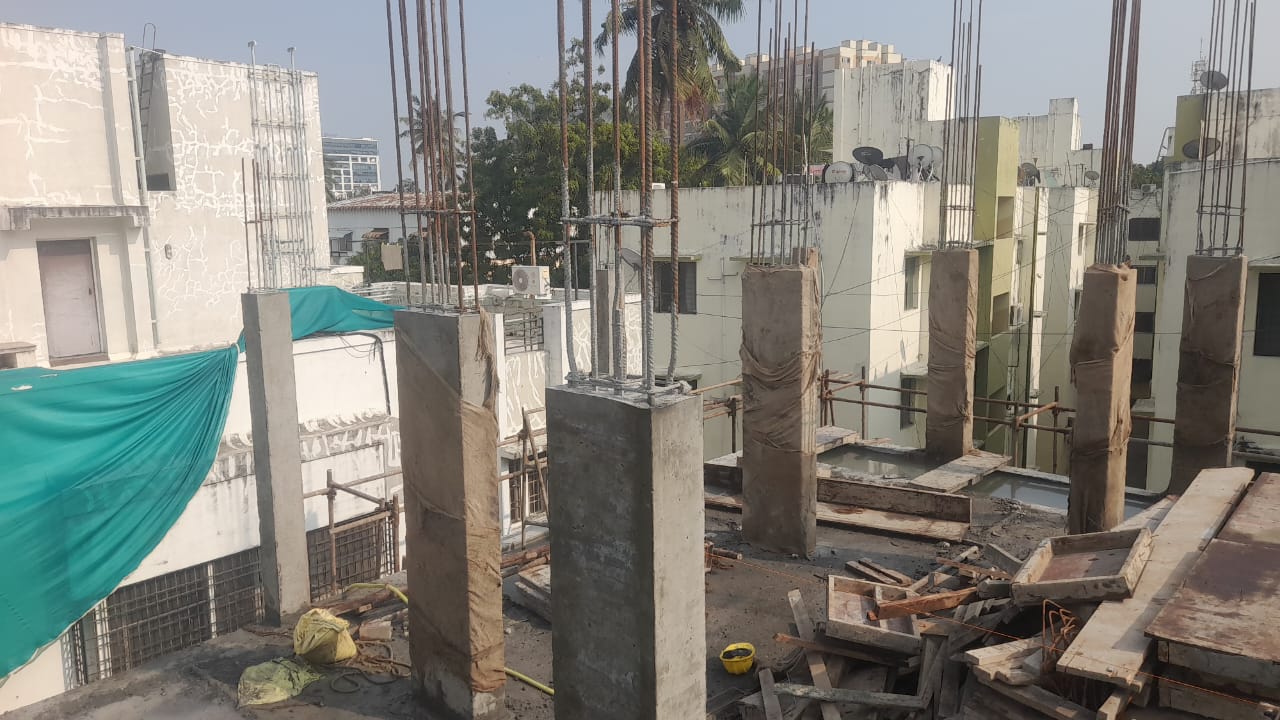

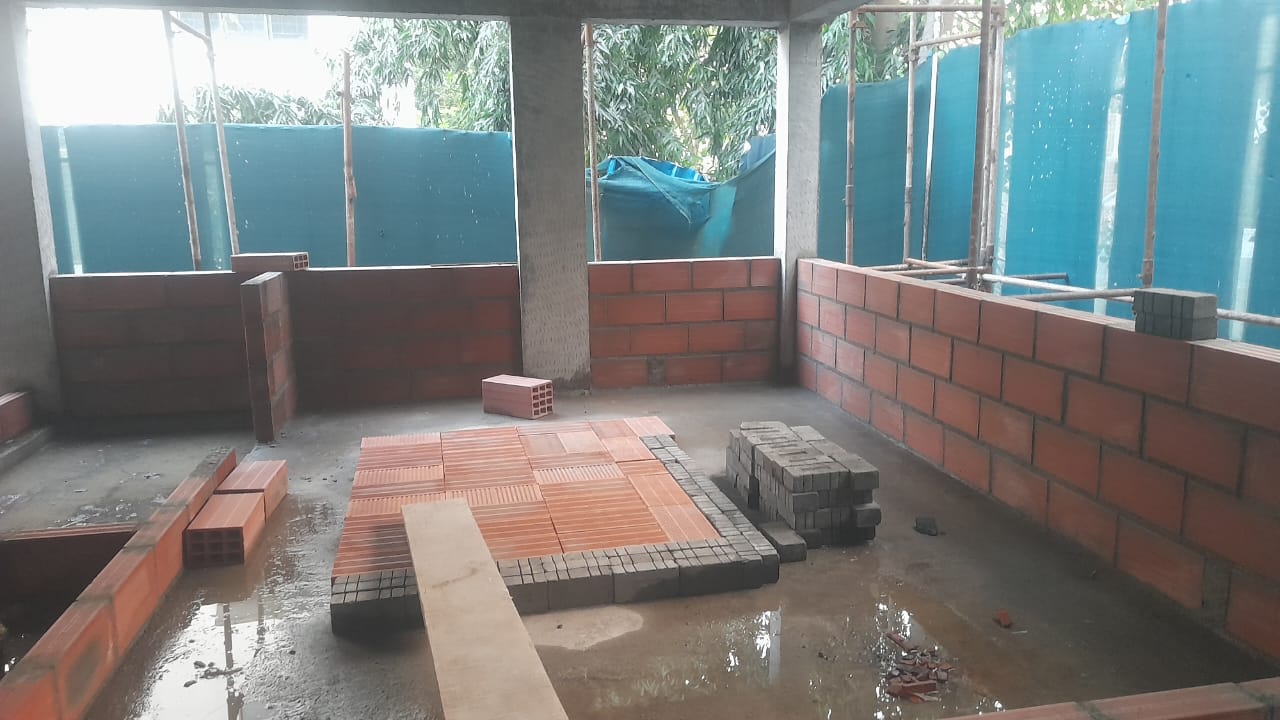

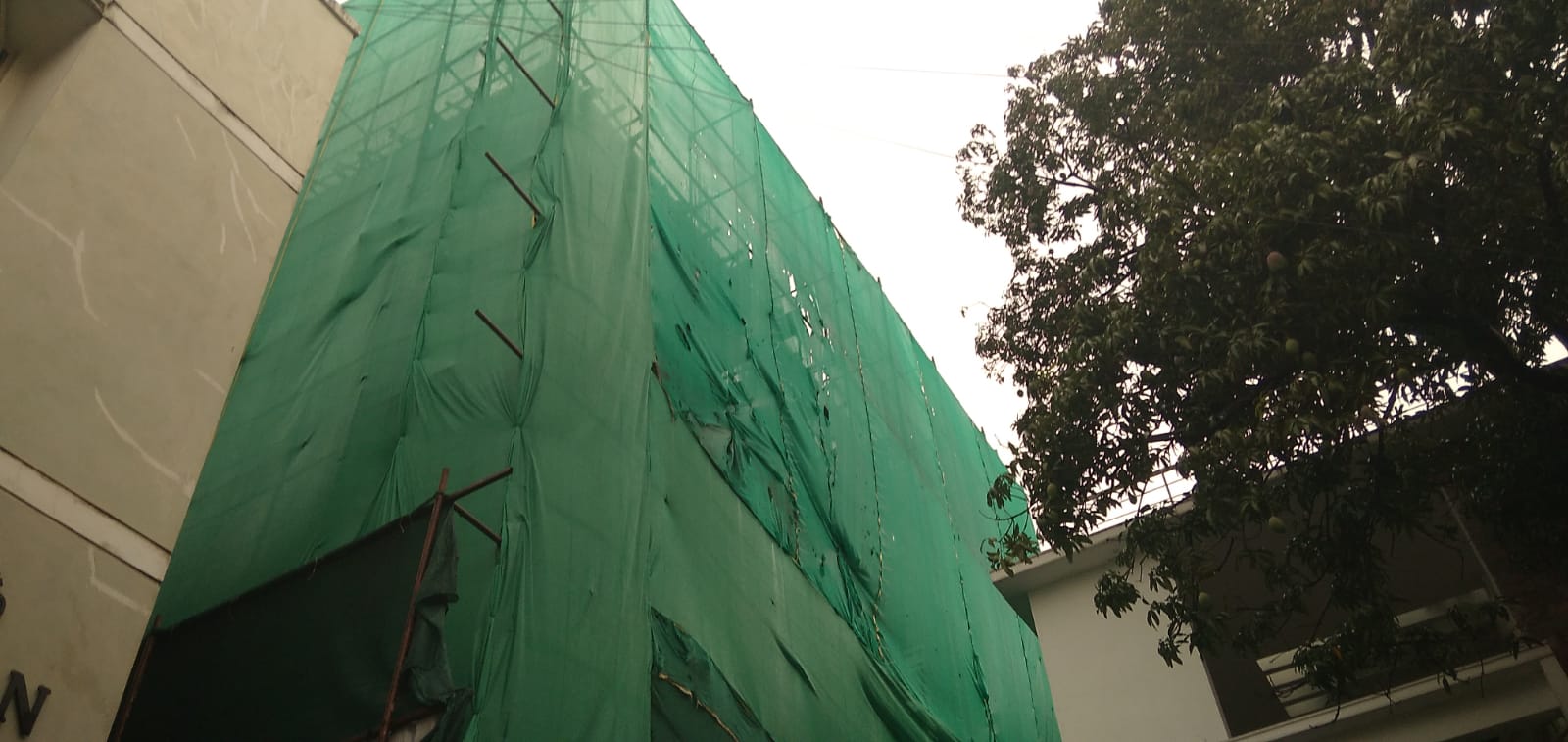

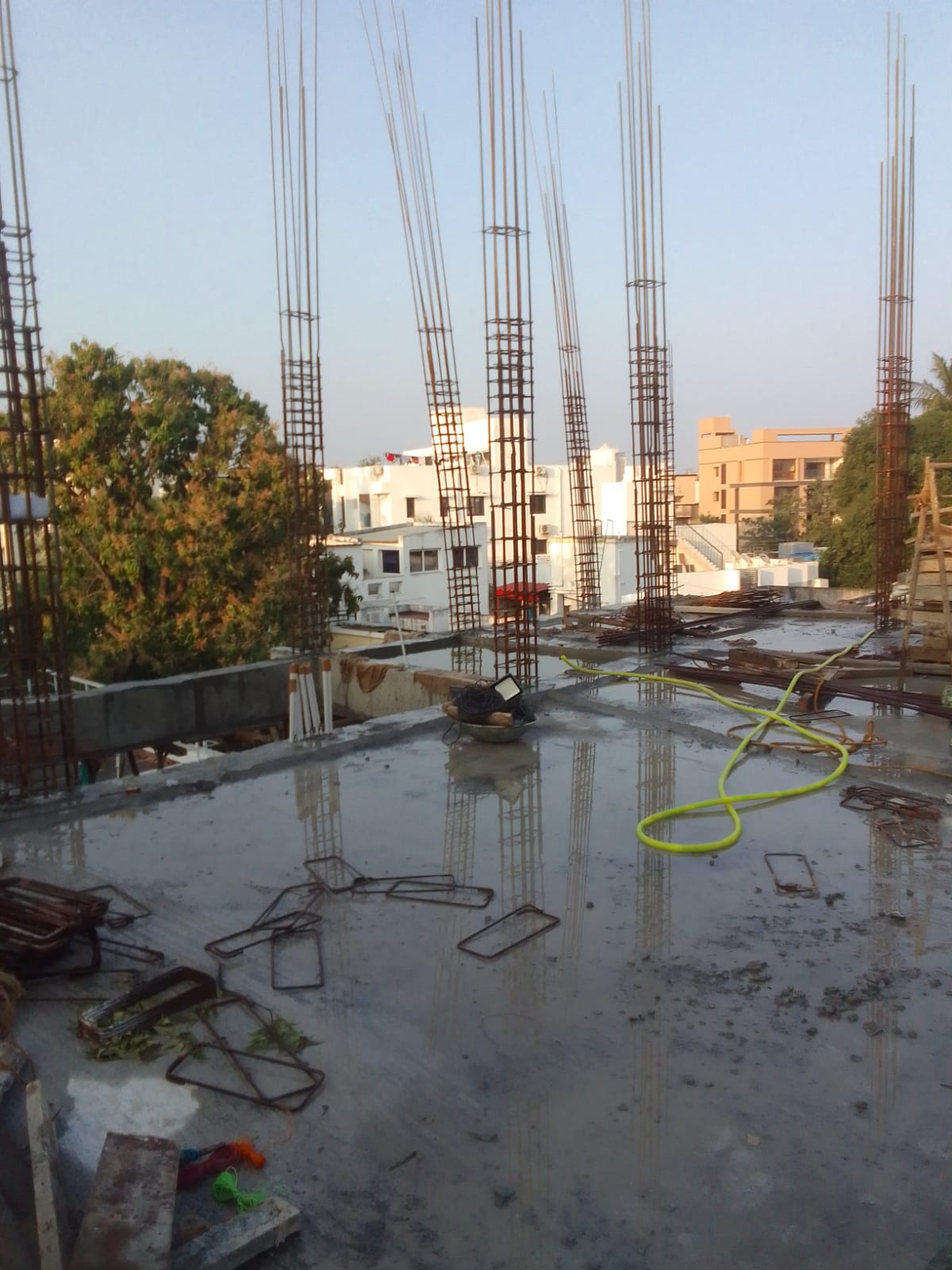

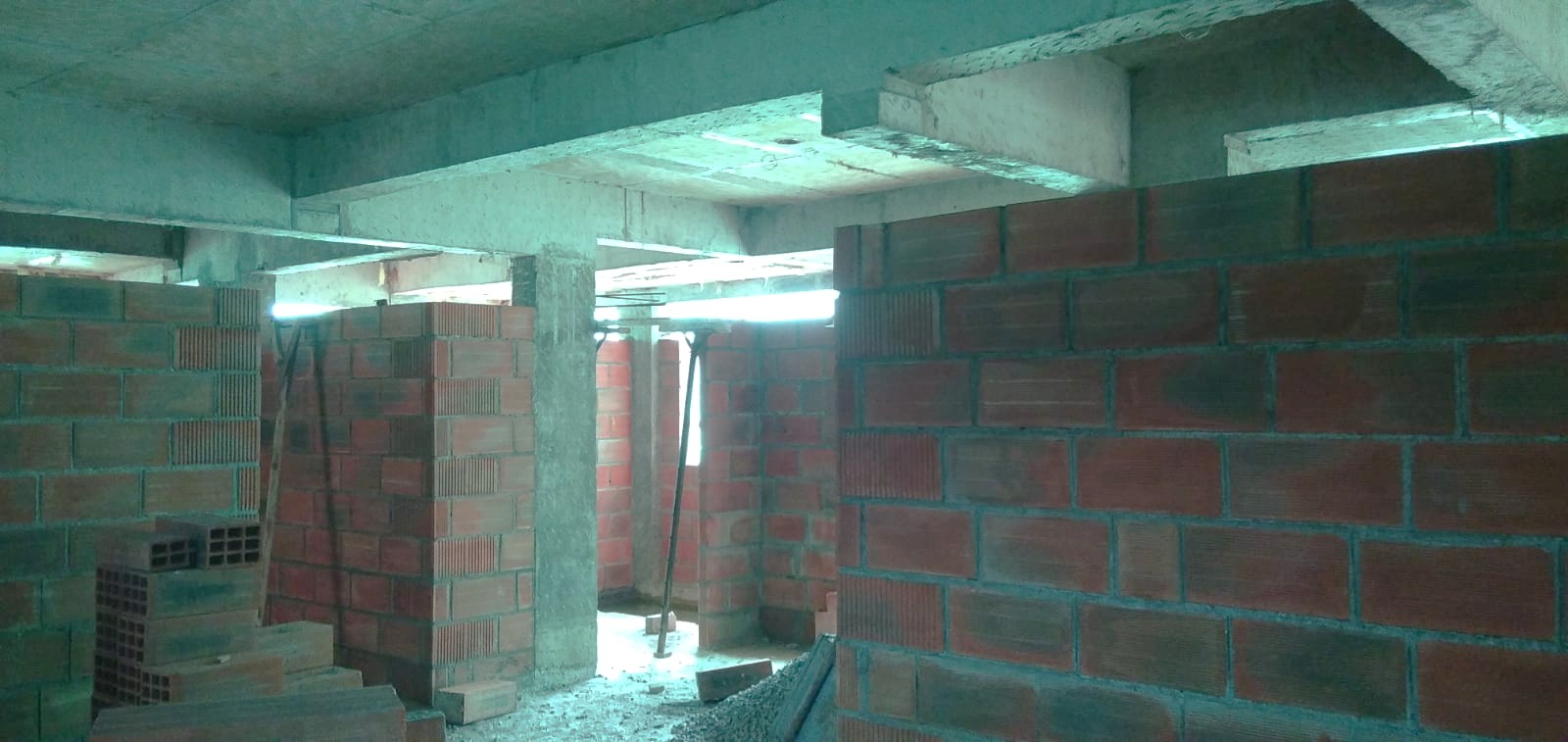

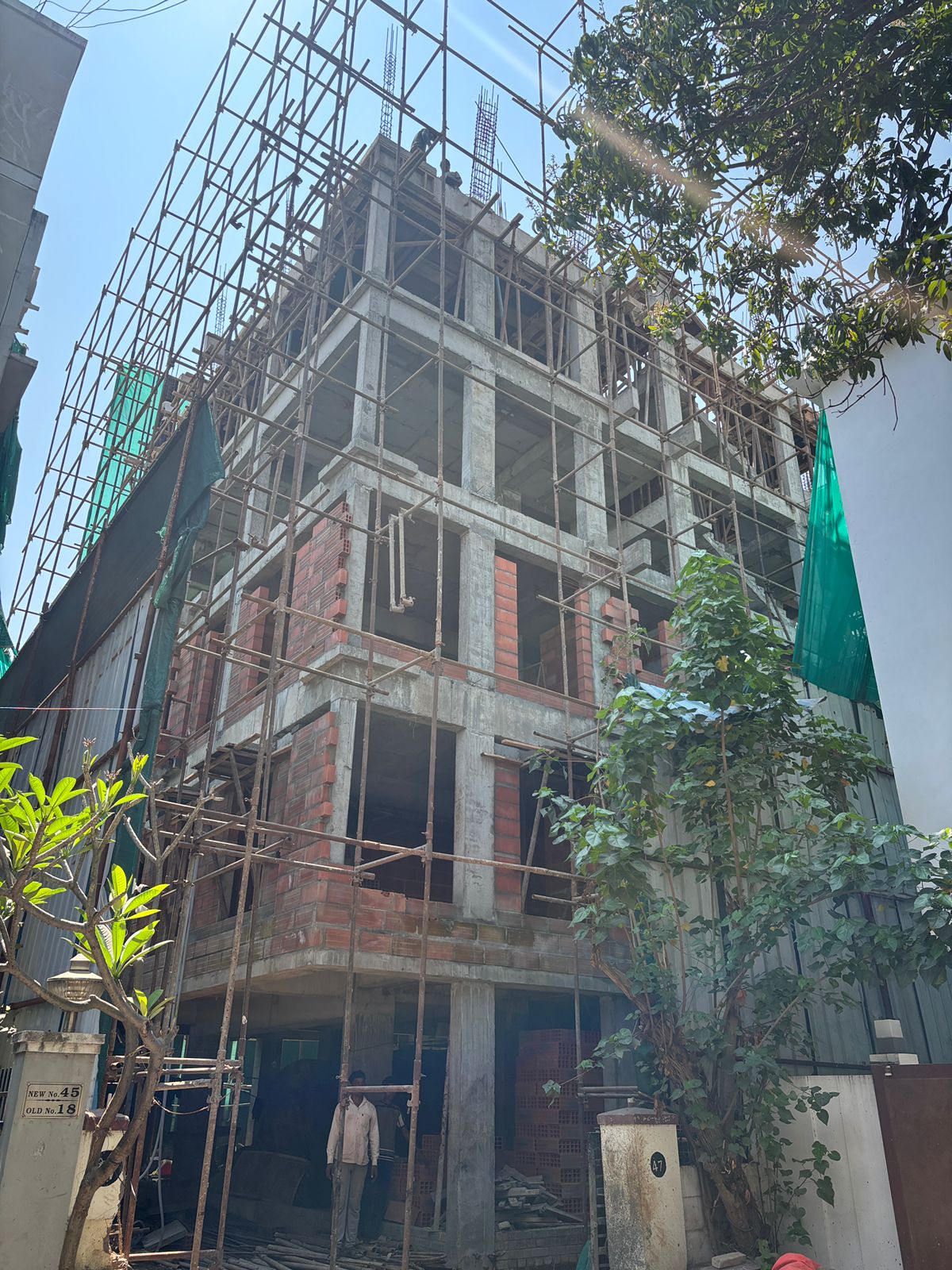

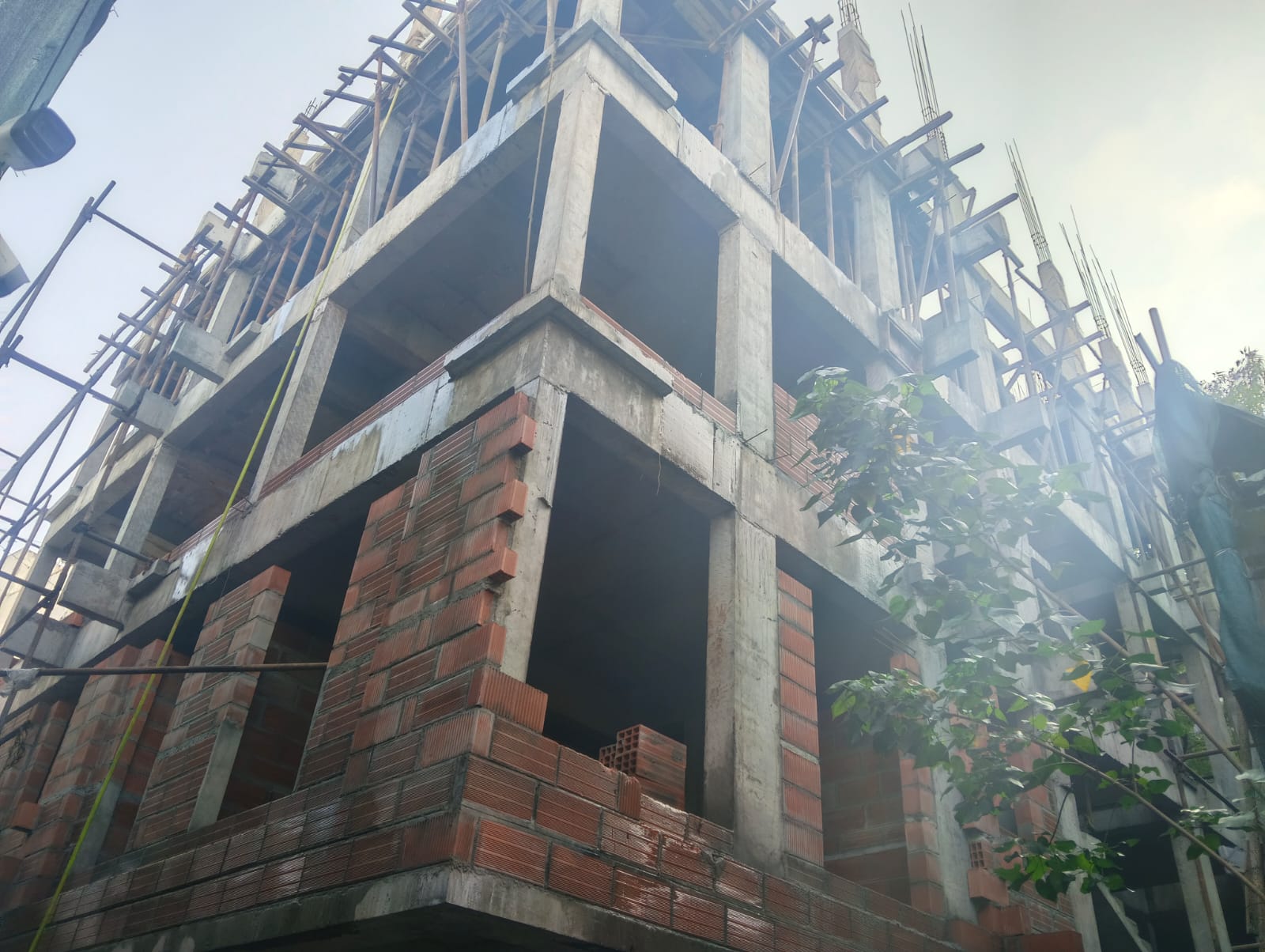

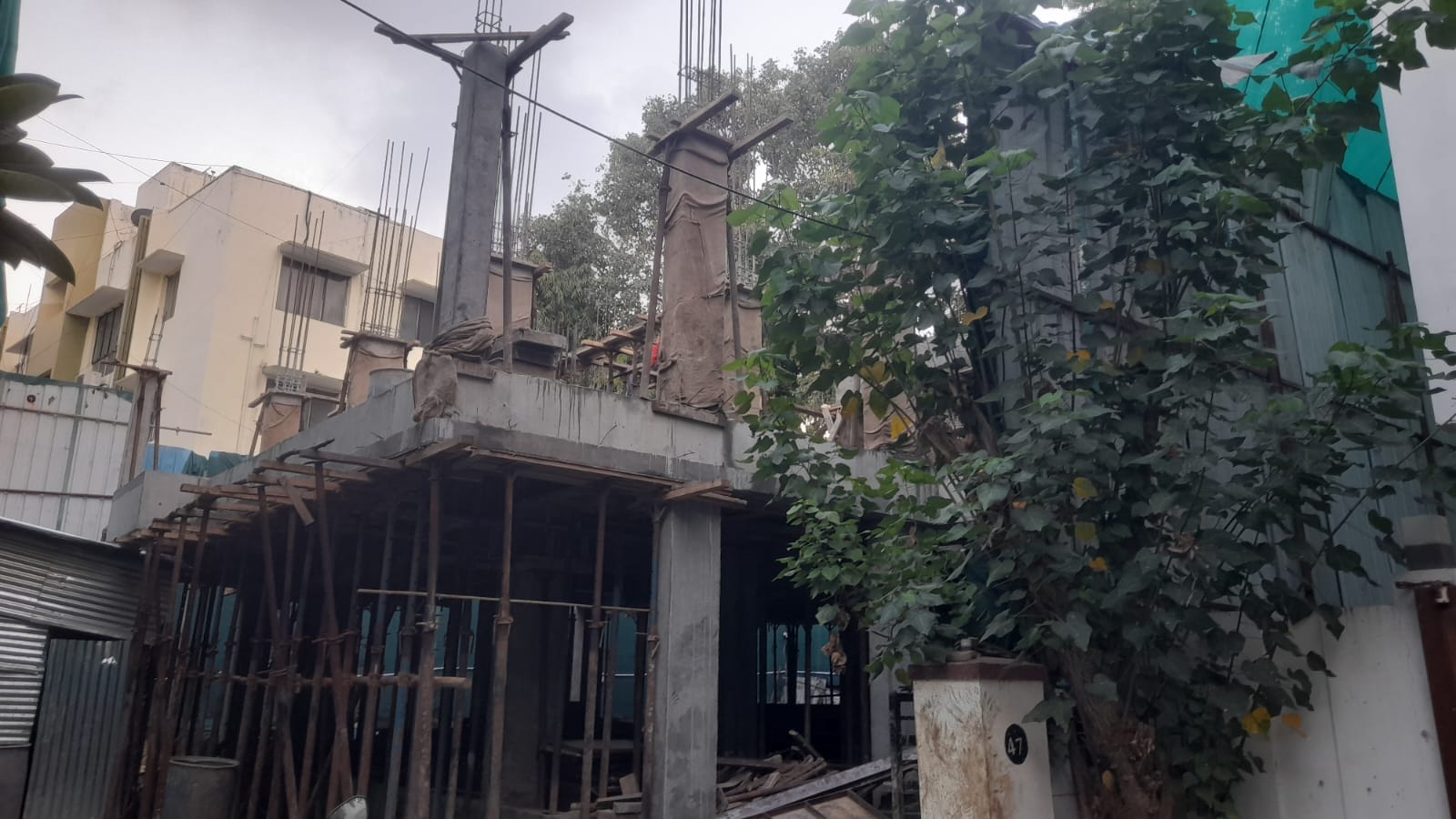

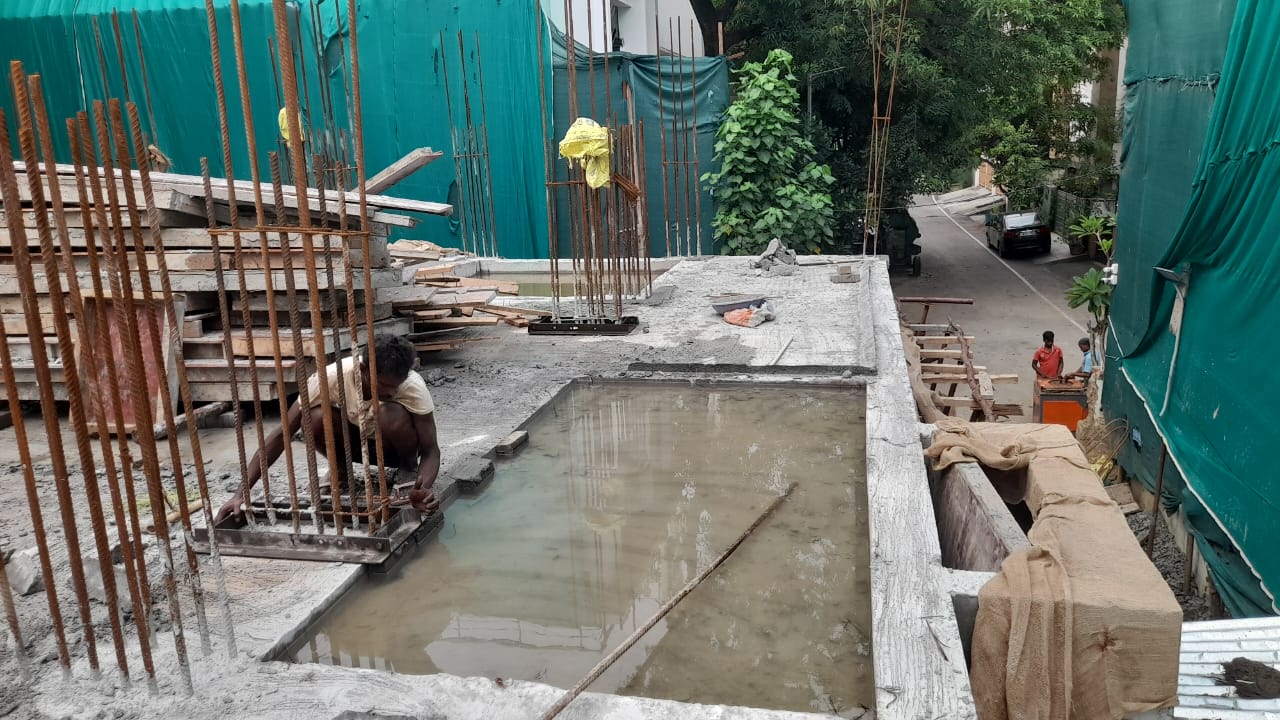

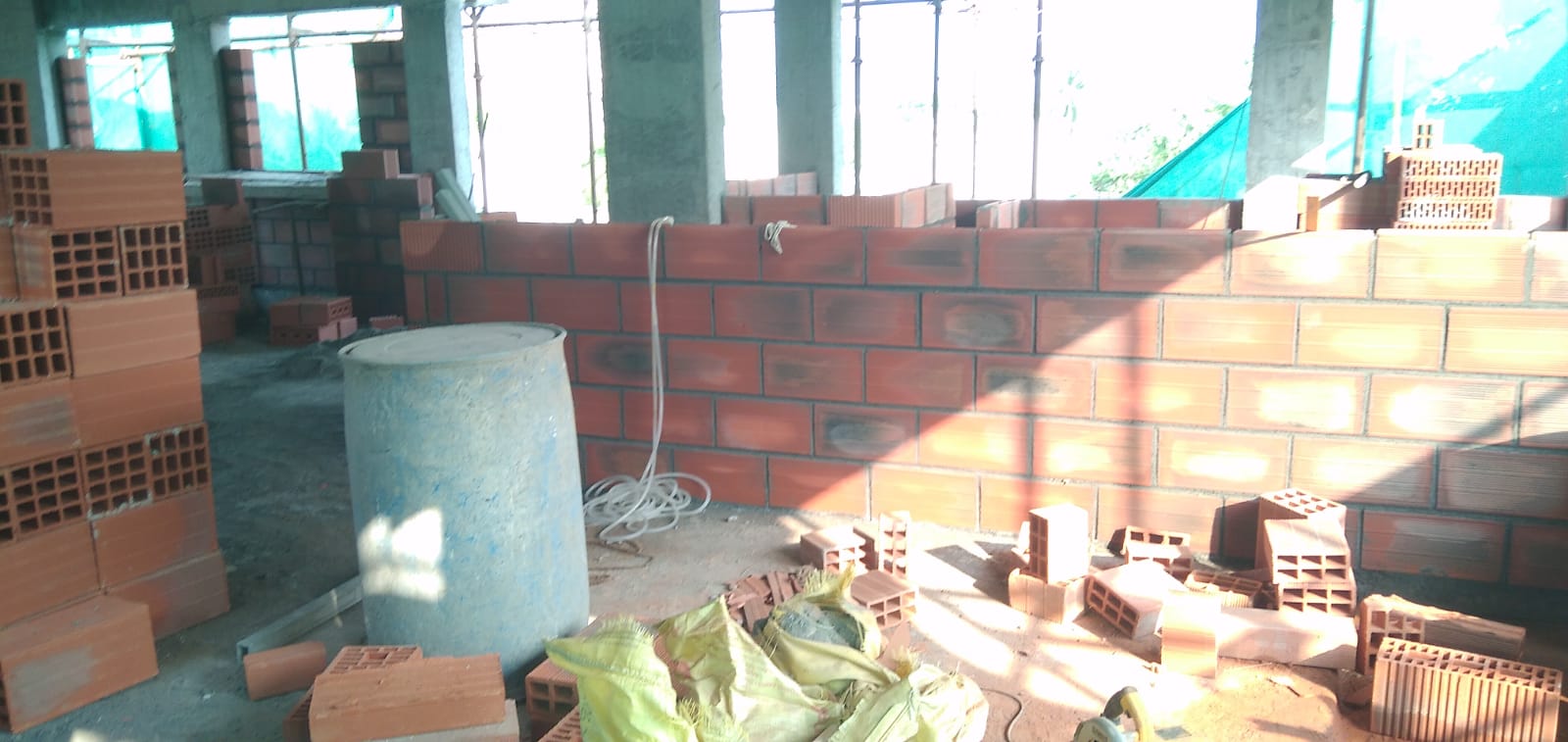

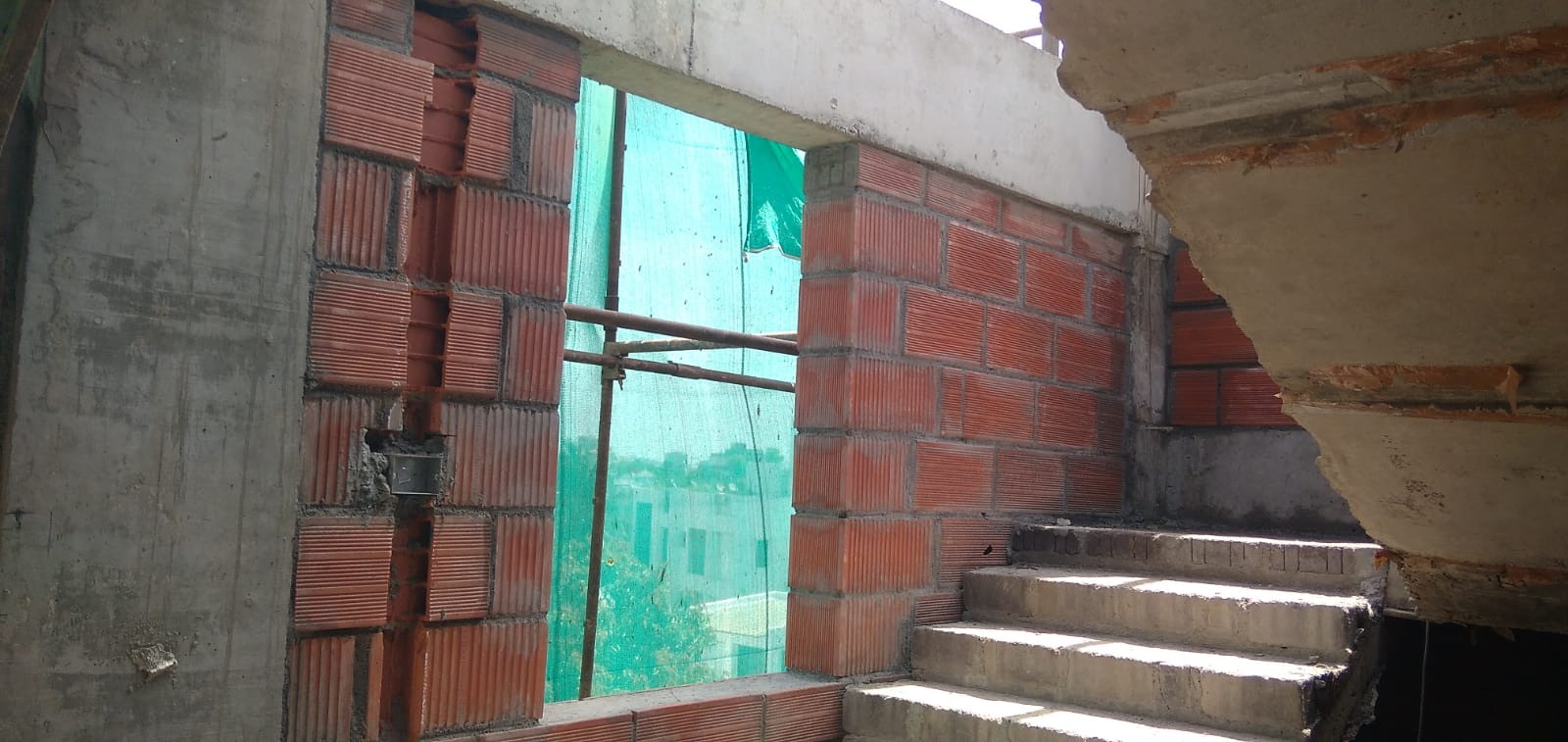

Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image

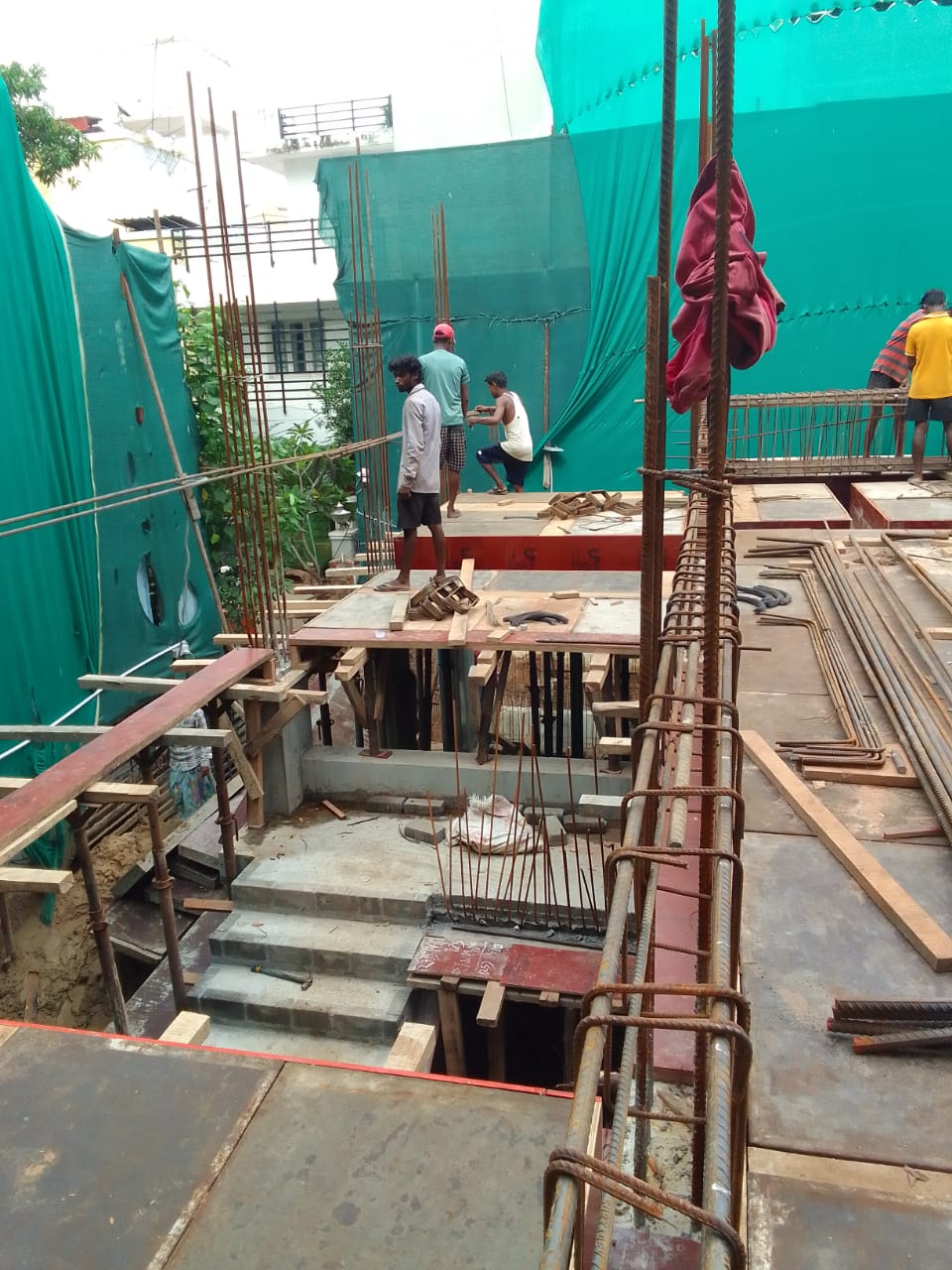

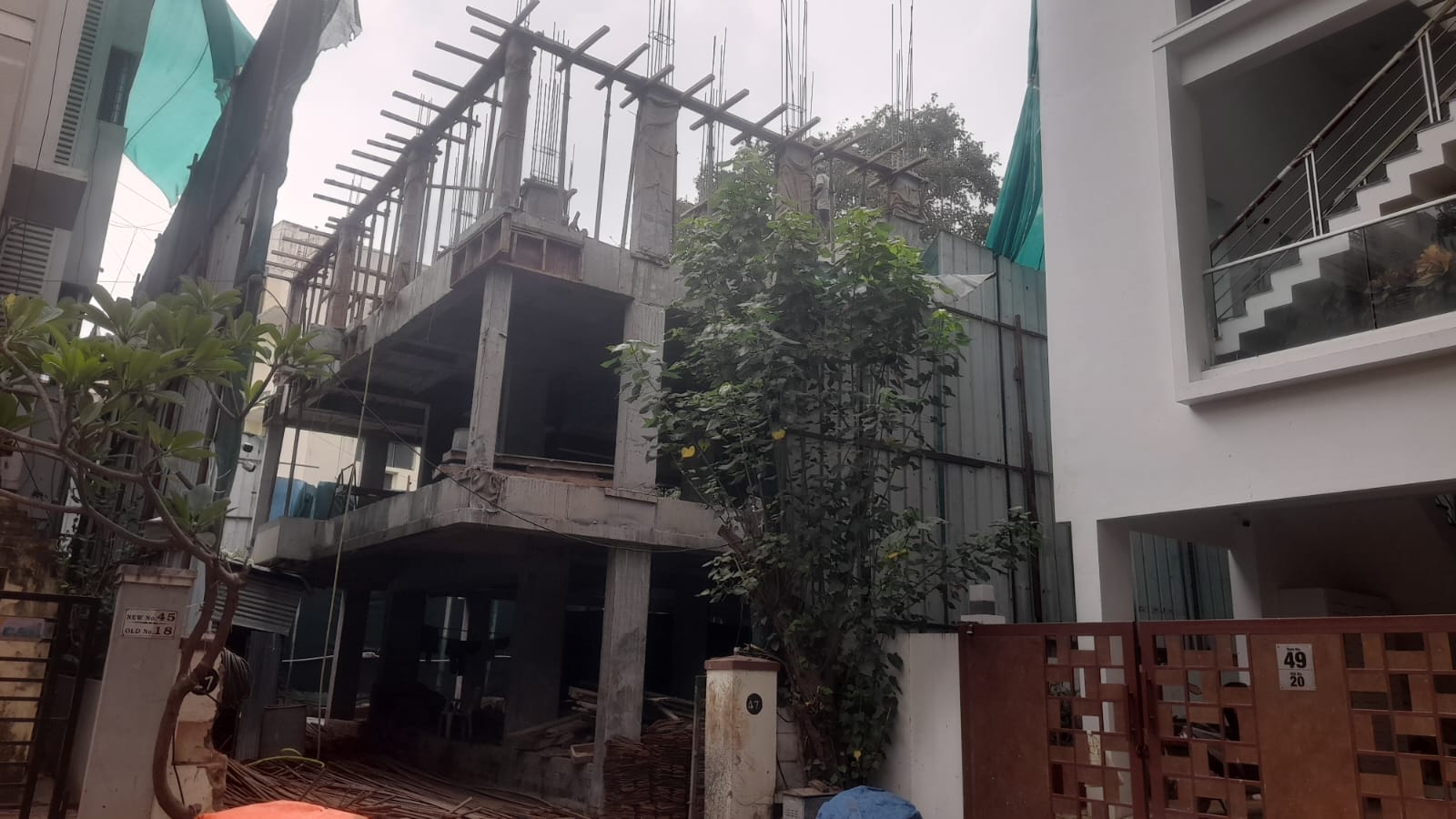

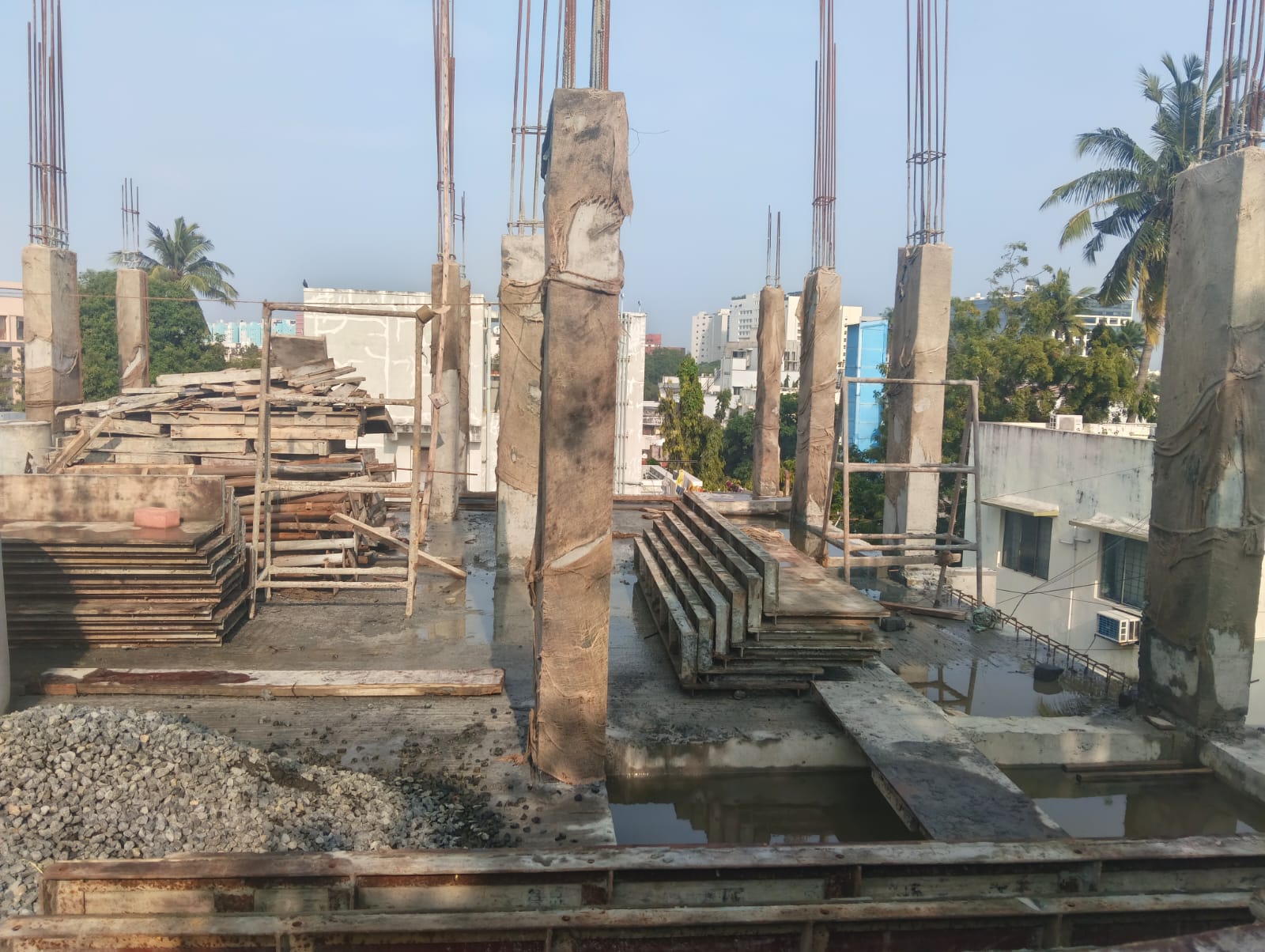

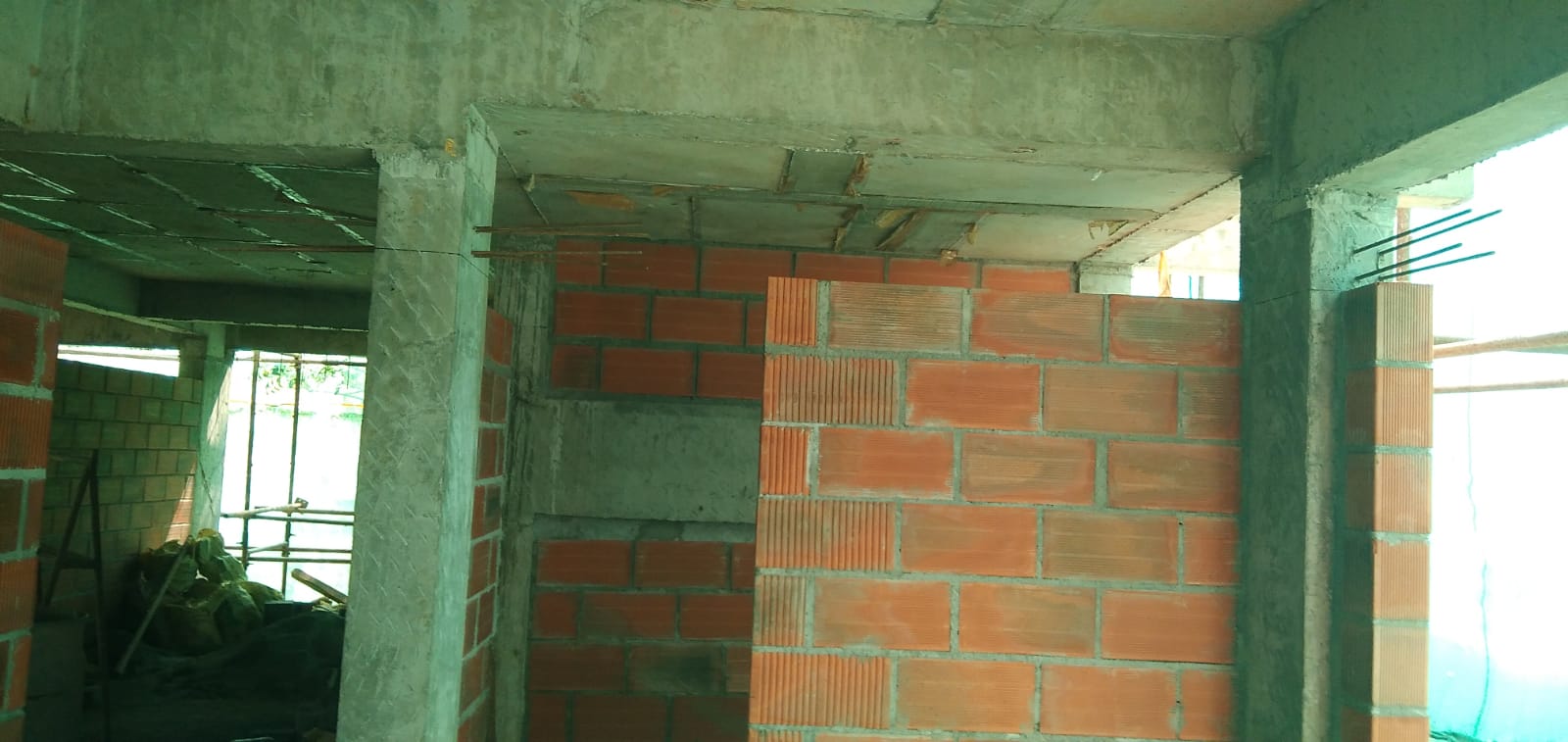

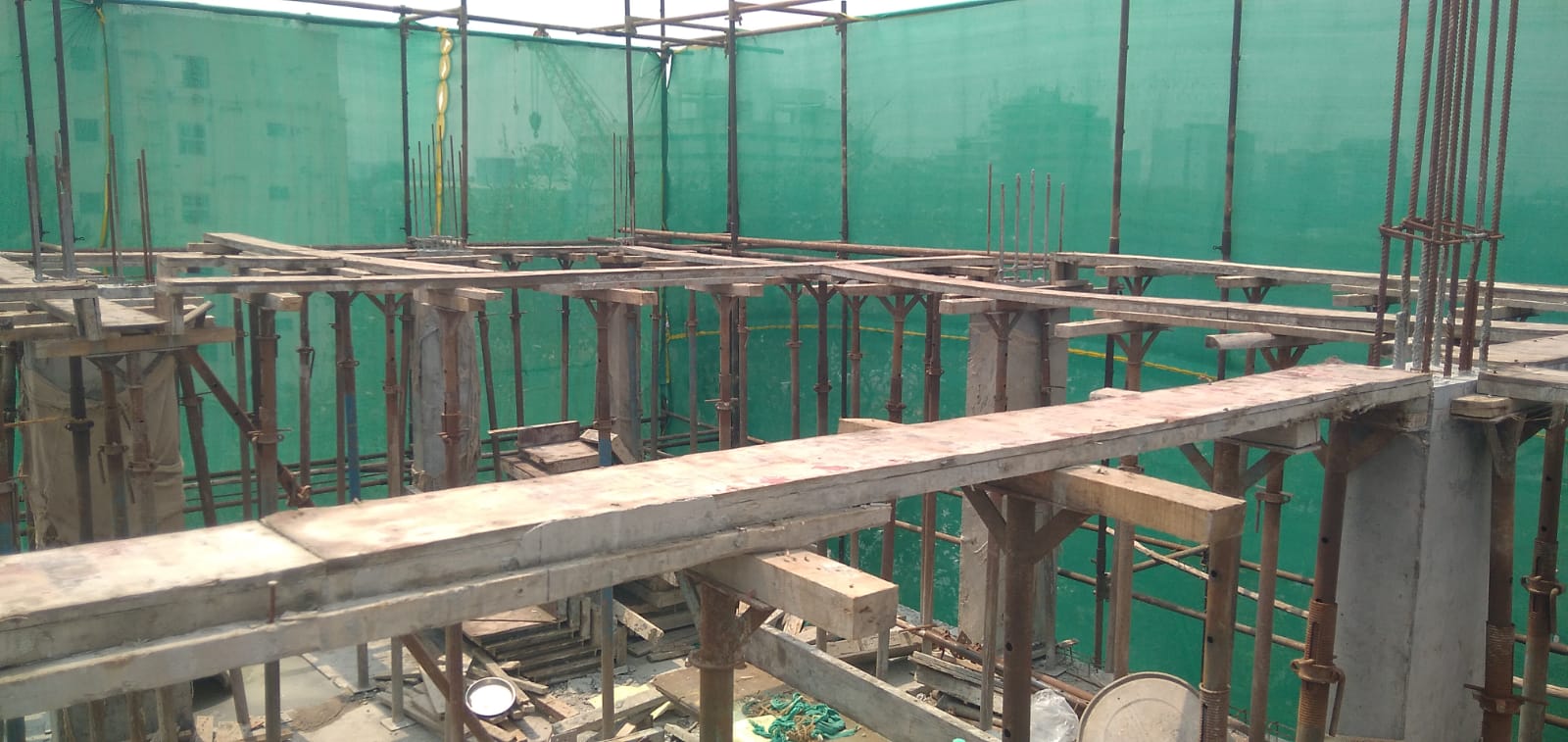

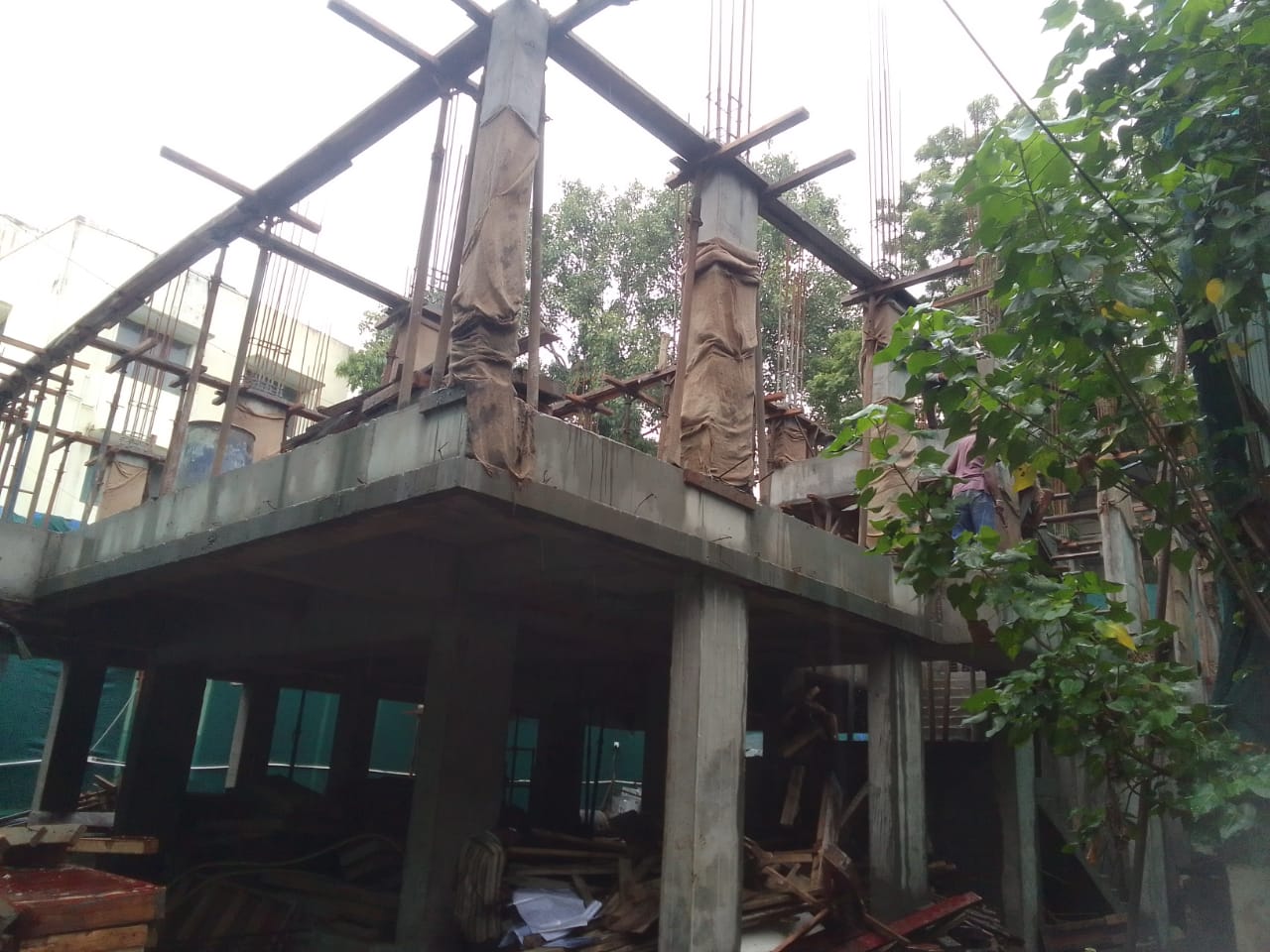

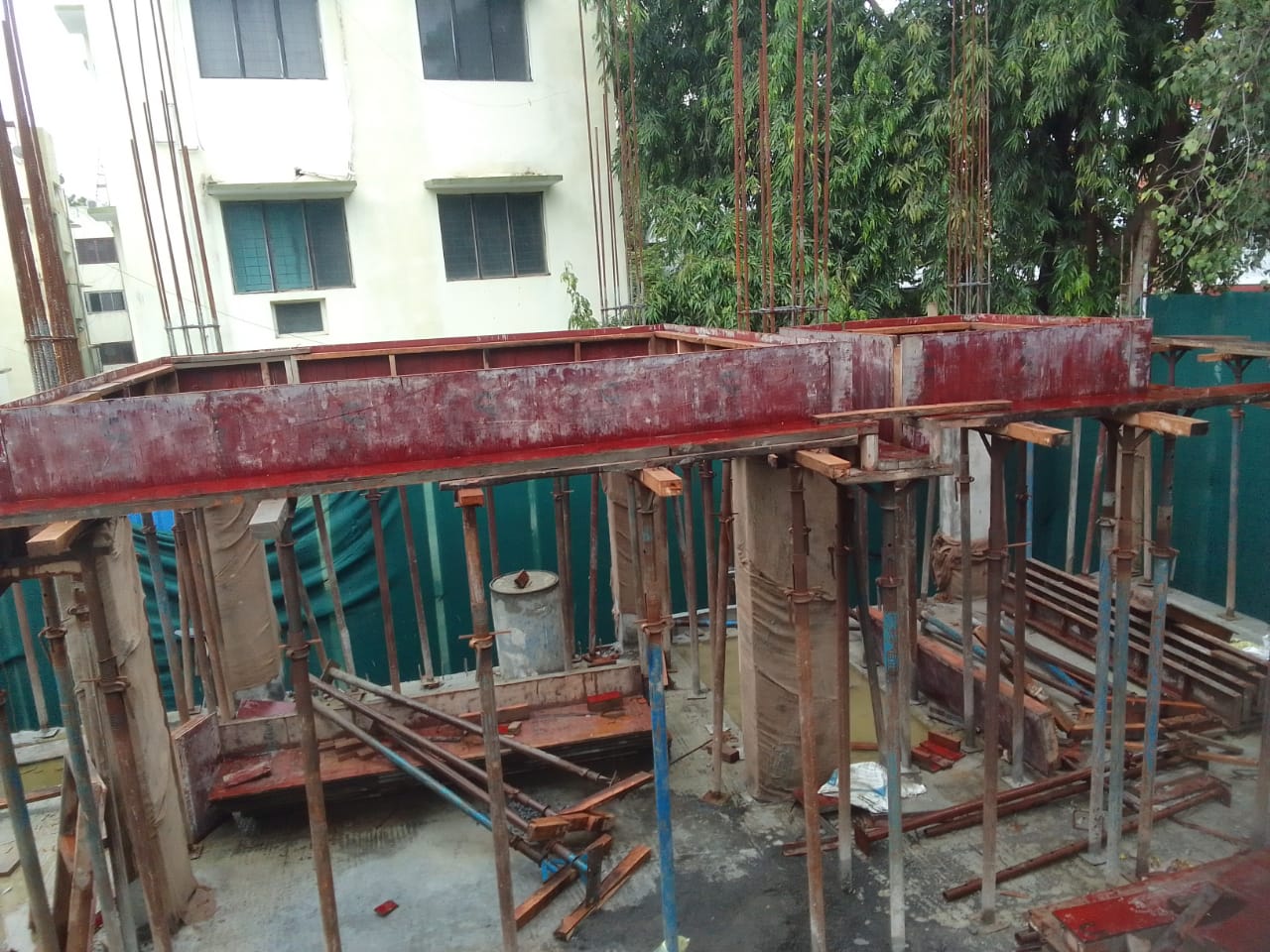

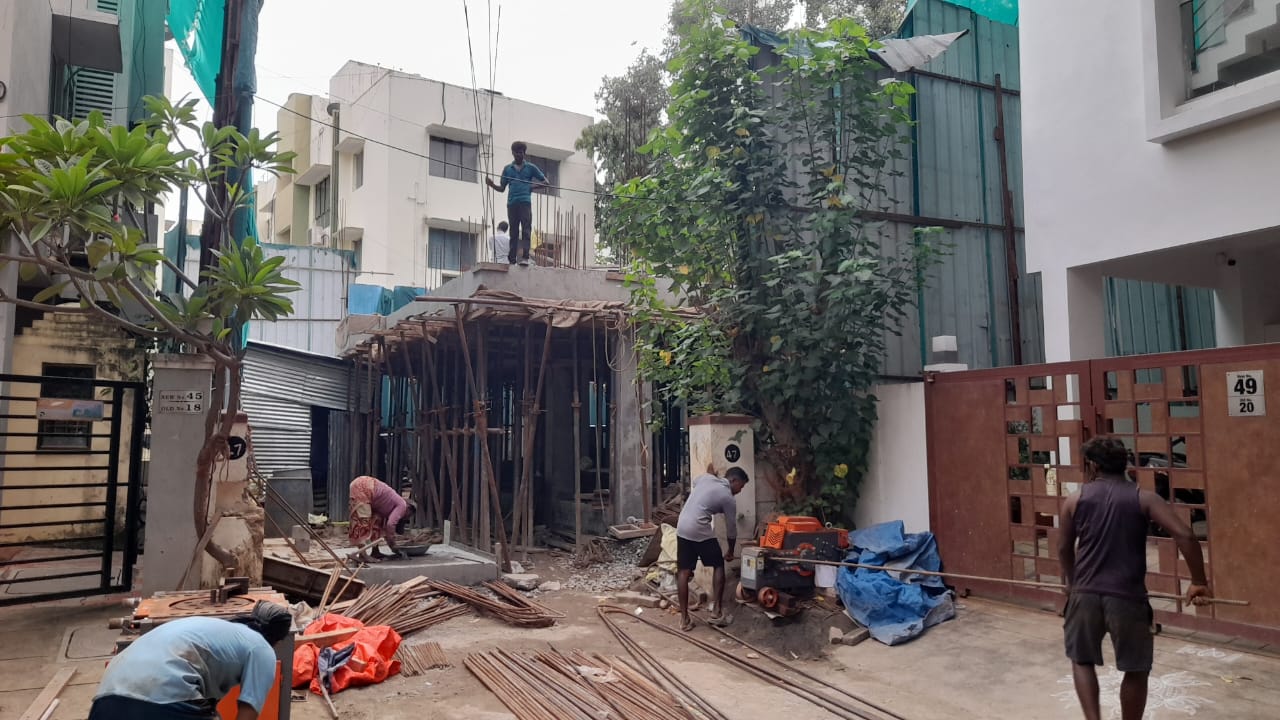

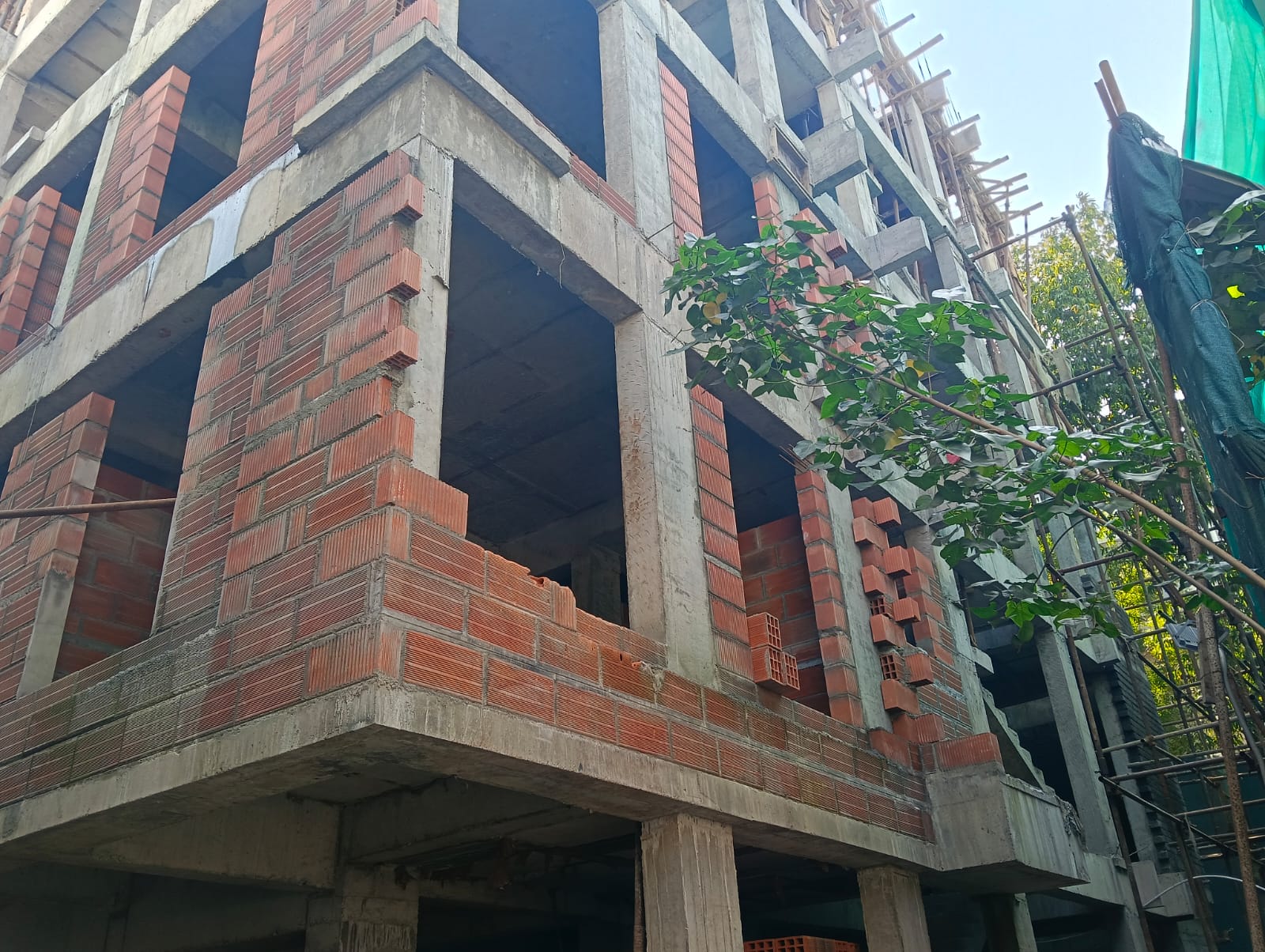

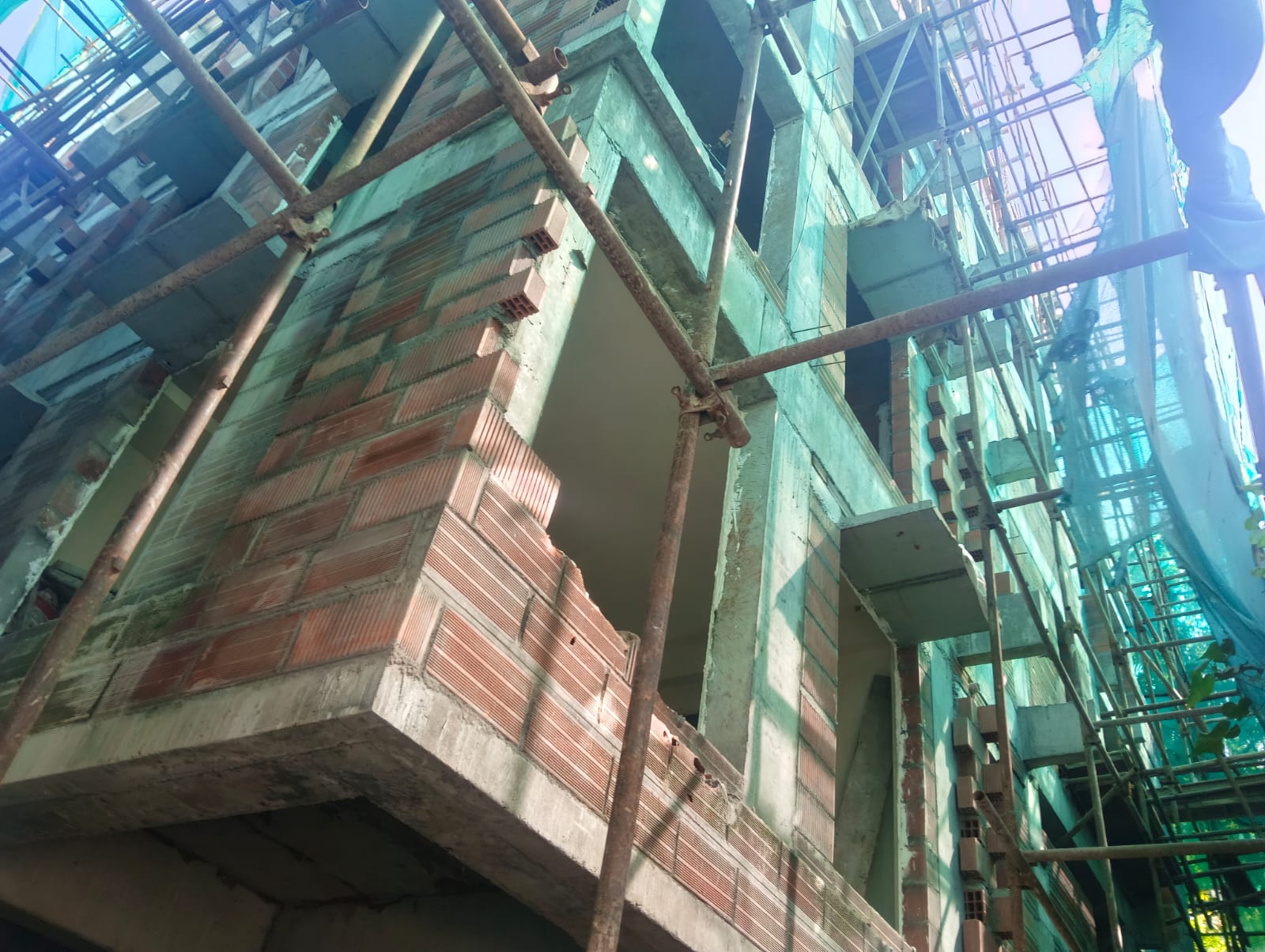

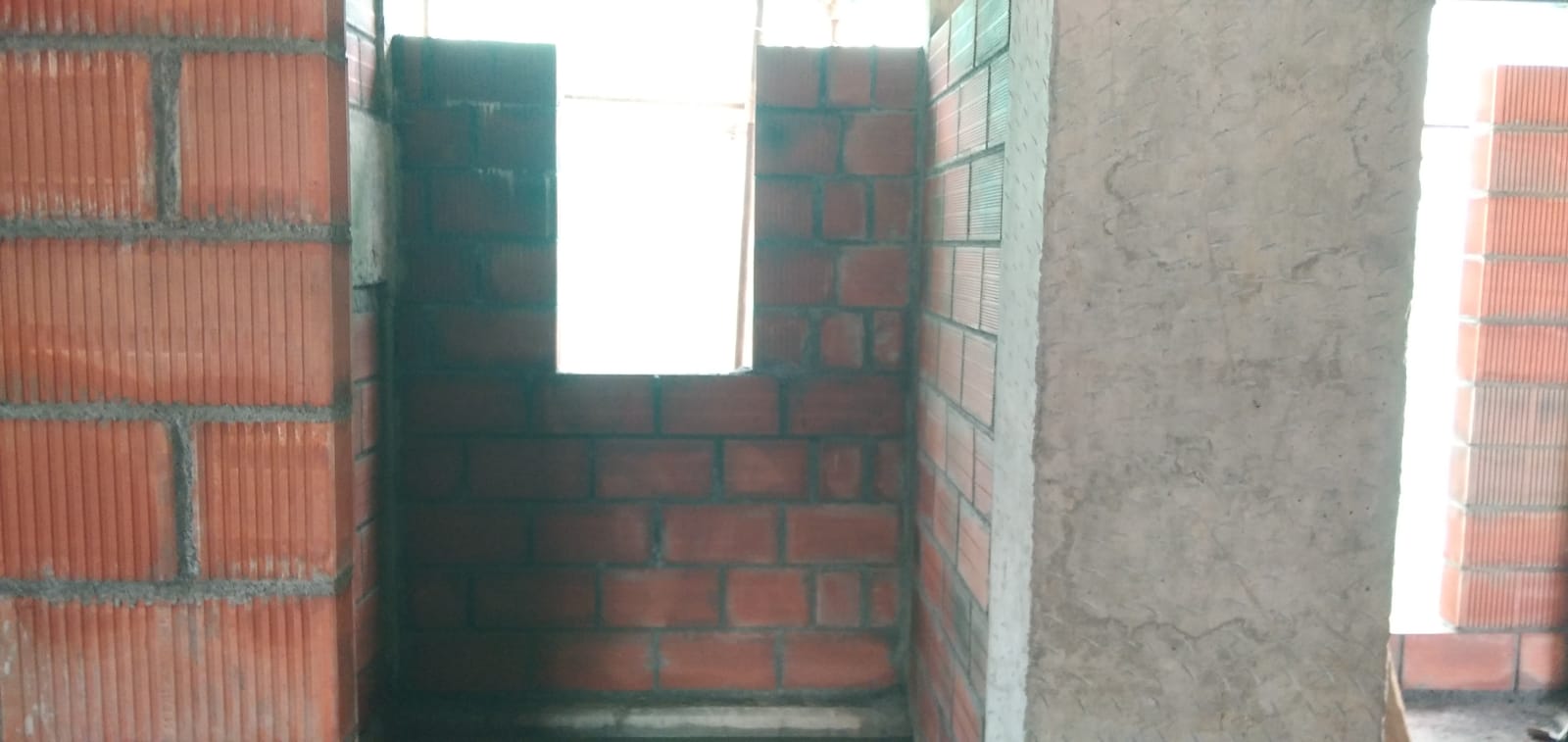

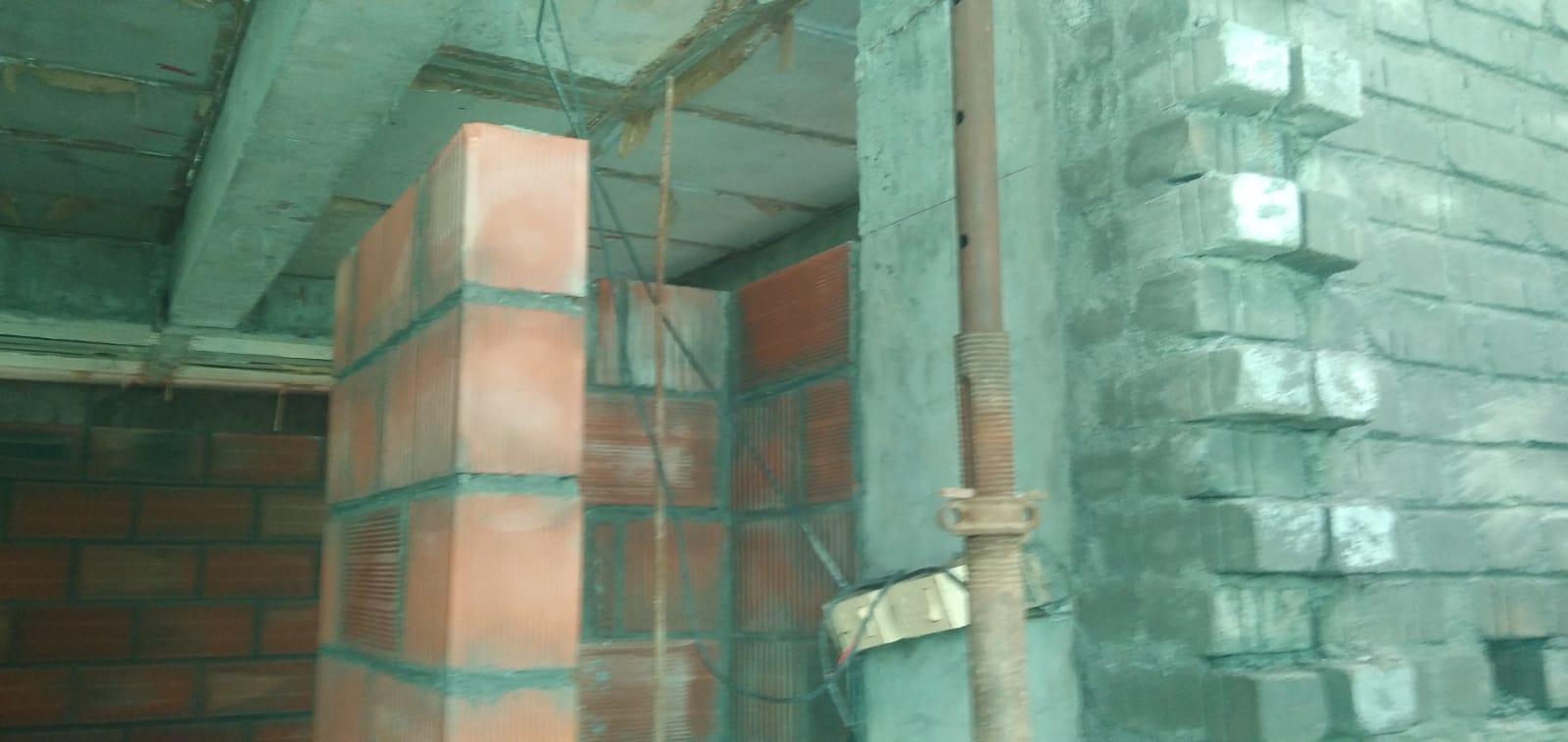

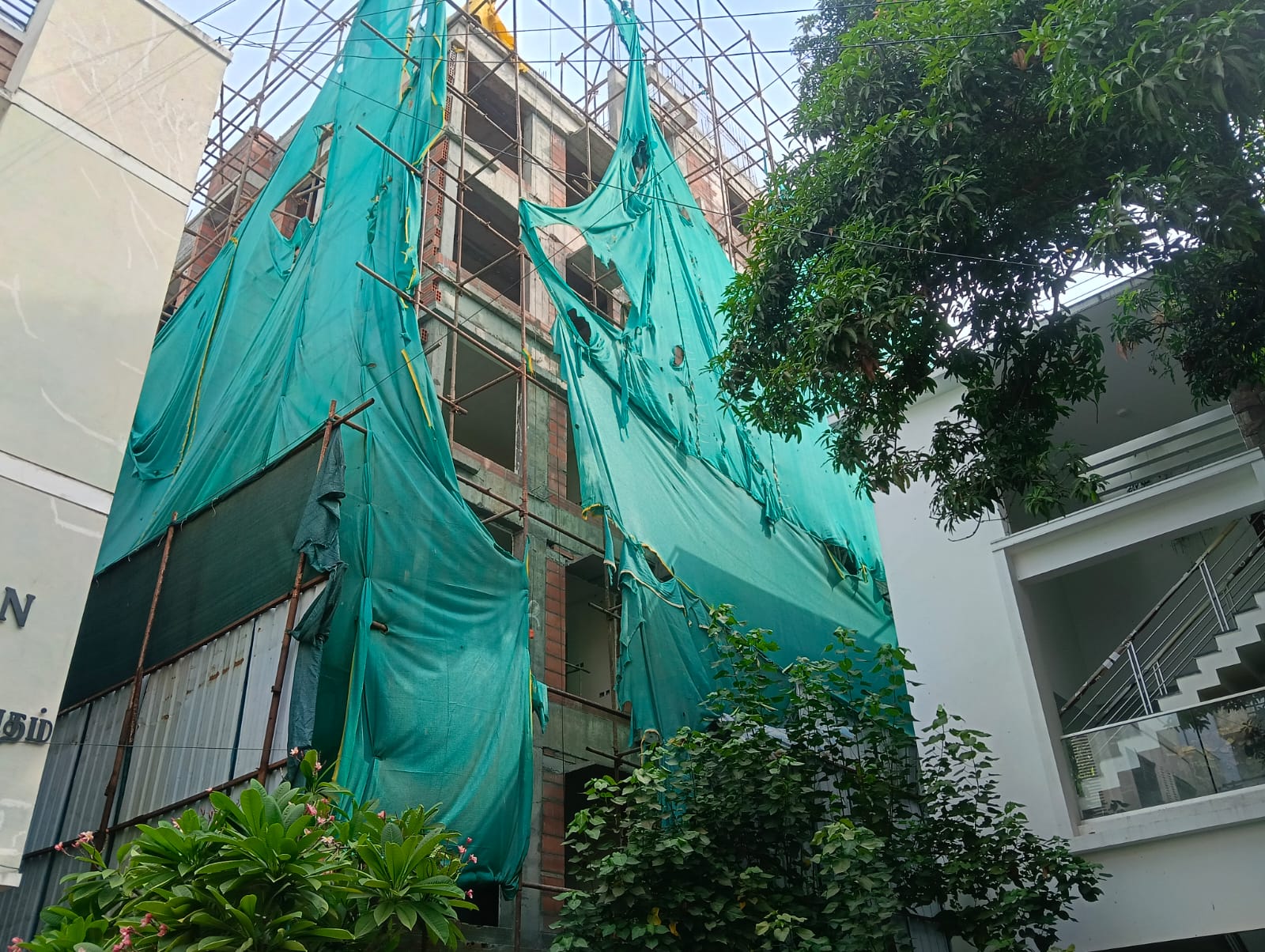

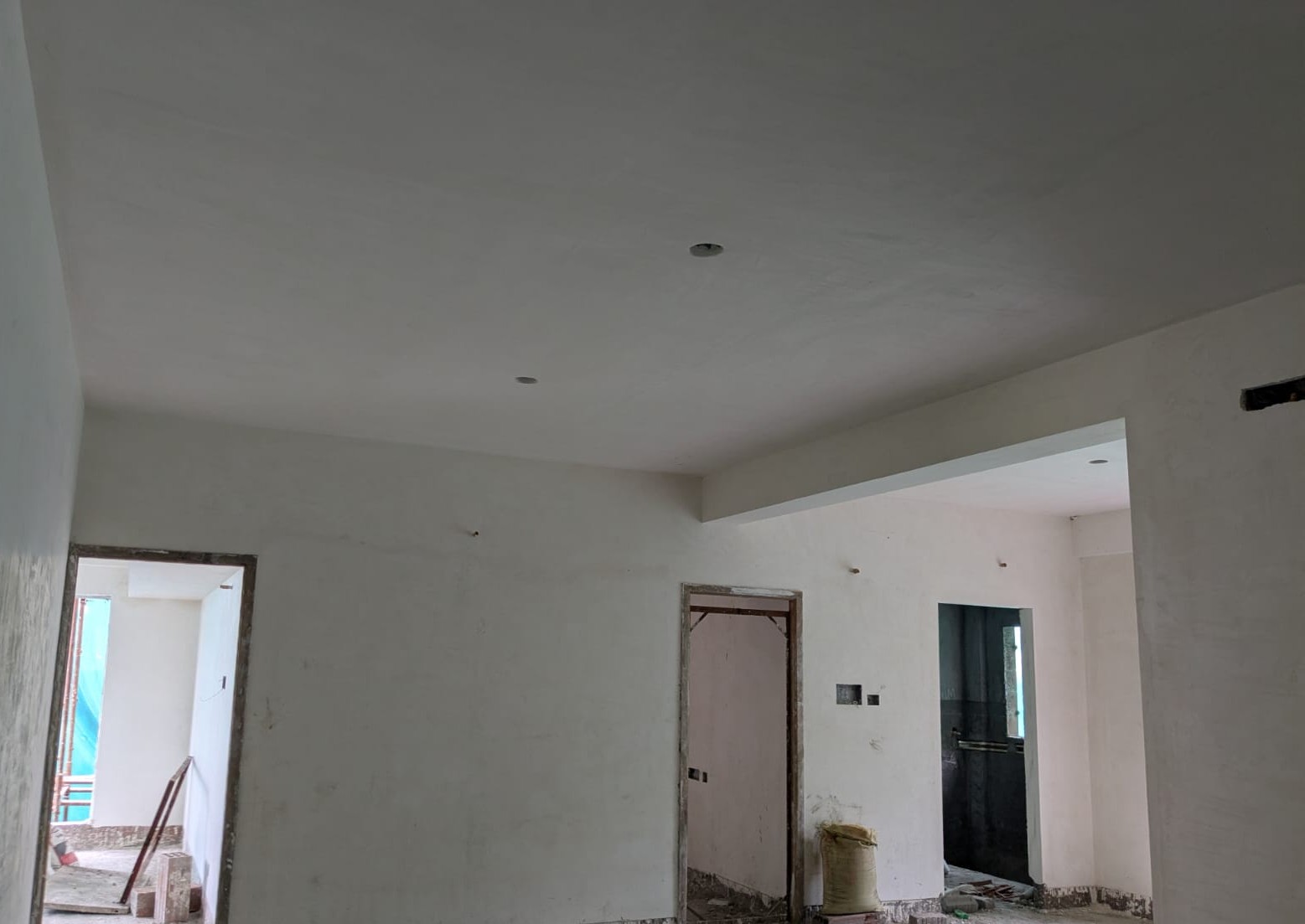

  • Up to 2nd Floor plastering work is completed.

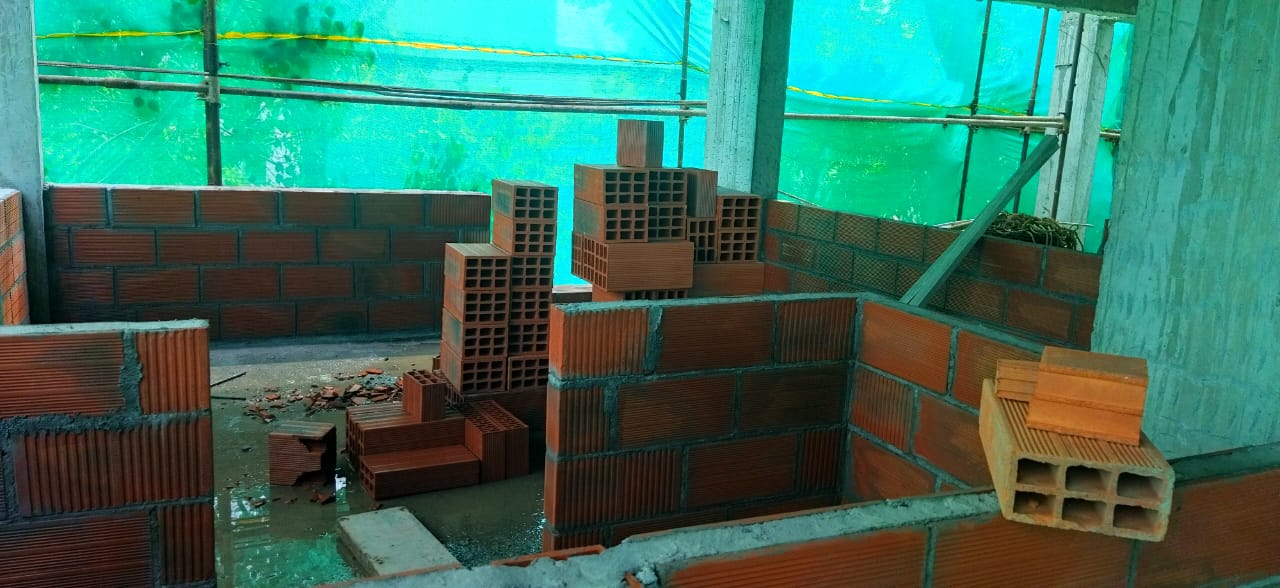

  • 3rd Floor plastering work is in progress.(90% completed)
  • 4th floor plastering work is in progress.

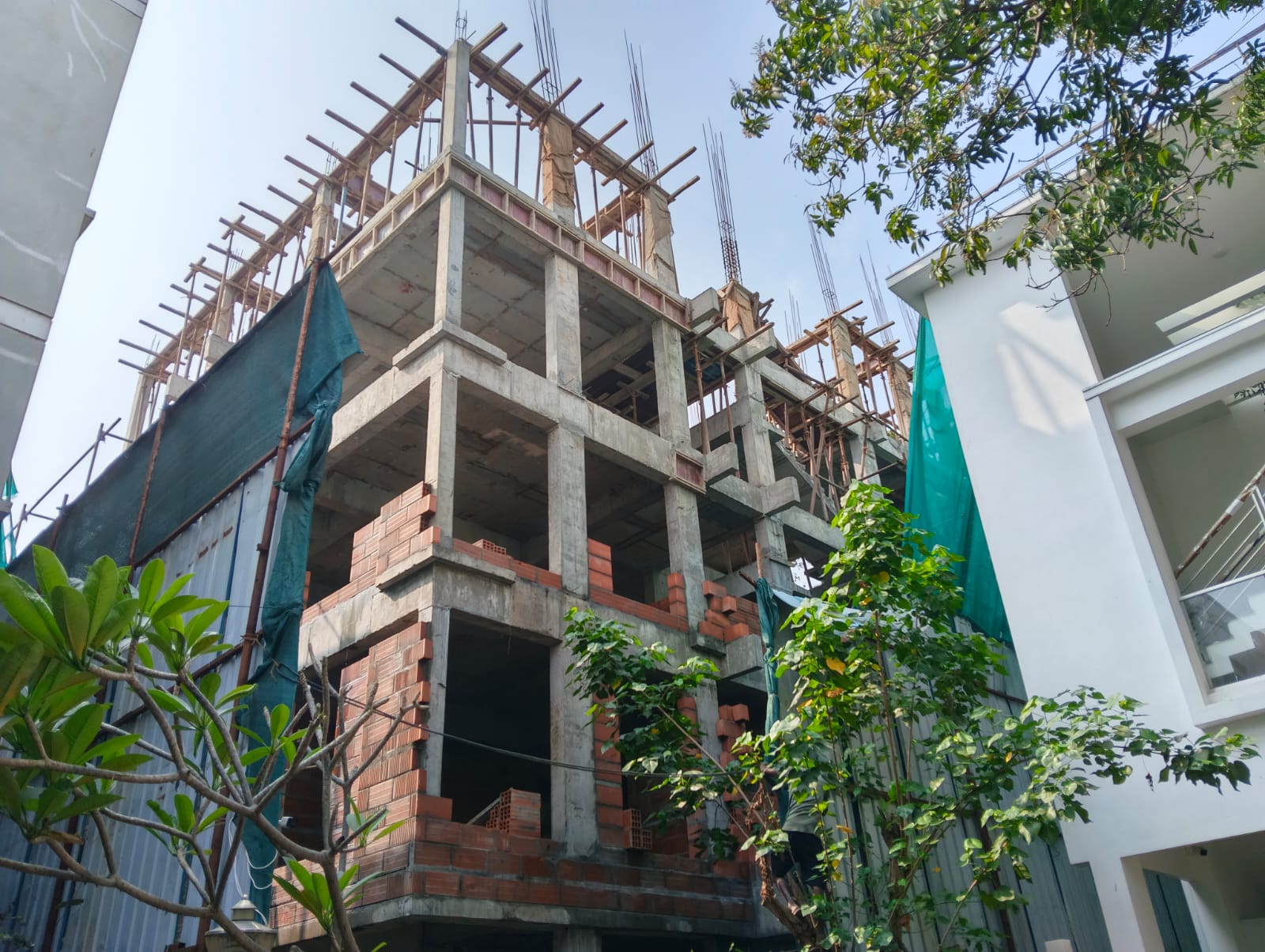

  • 5th Floor block work is completed.
  • Toilet plumbing work is in progress.(1st,2nd,3rd& 4thfloor progress)
  • Duct brick work is in progress.(80% completed)
  • Head room brick work is completed.

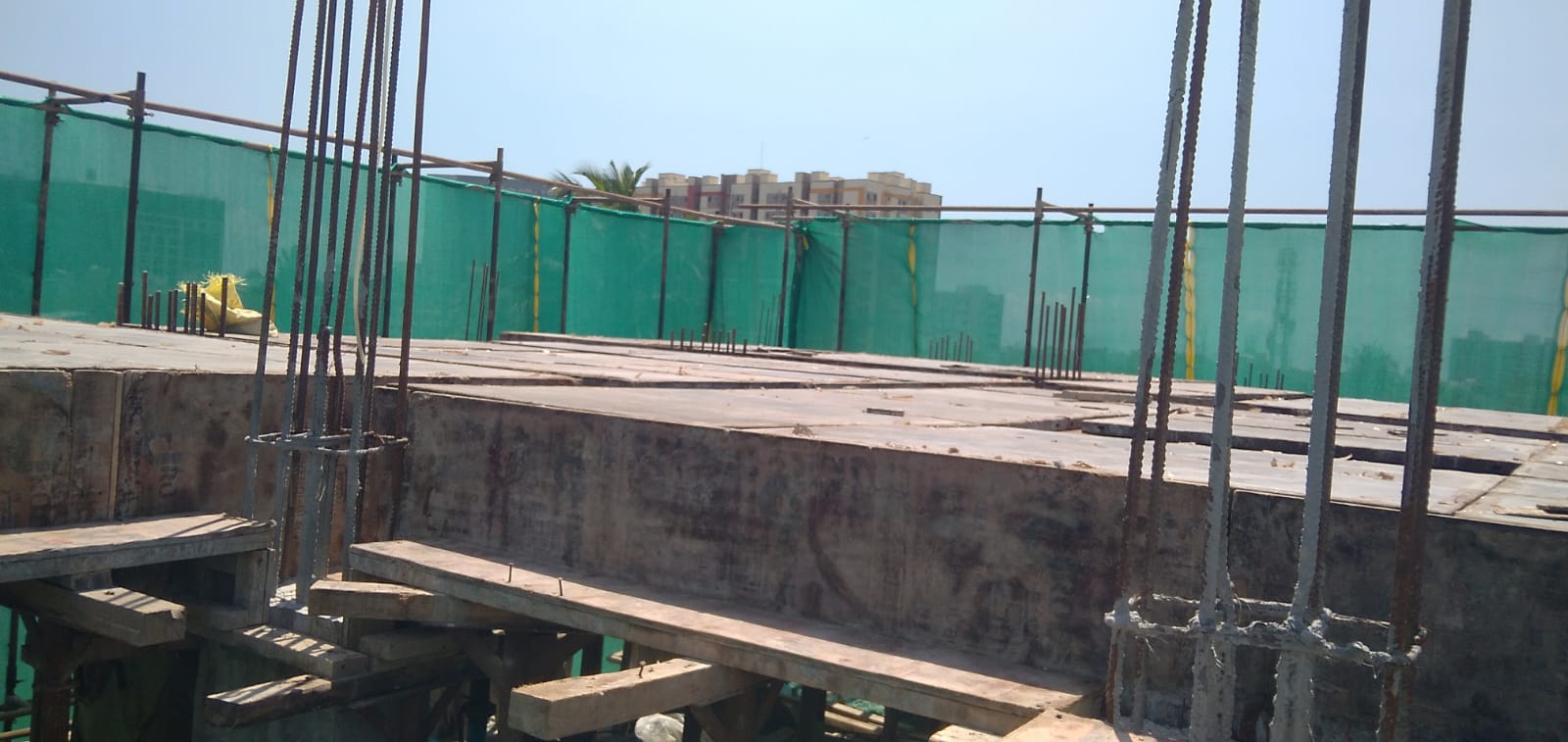

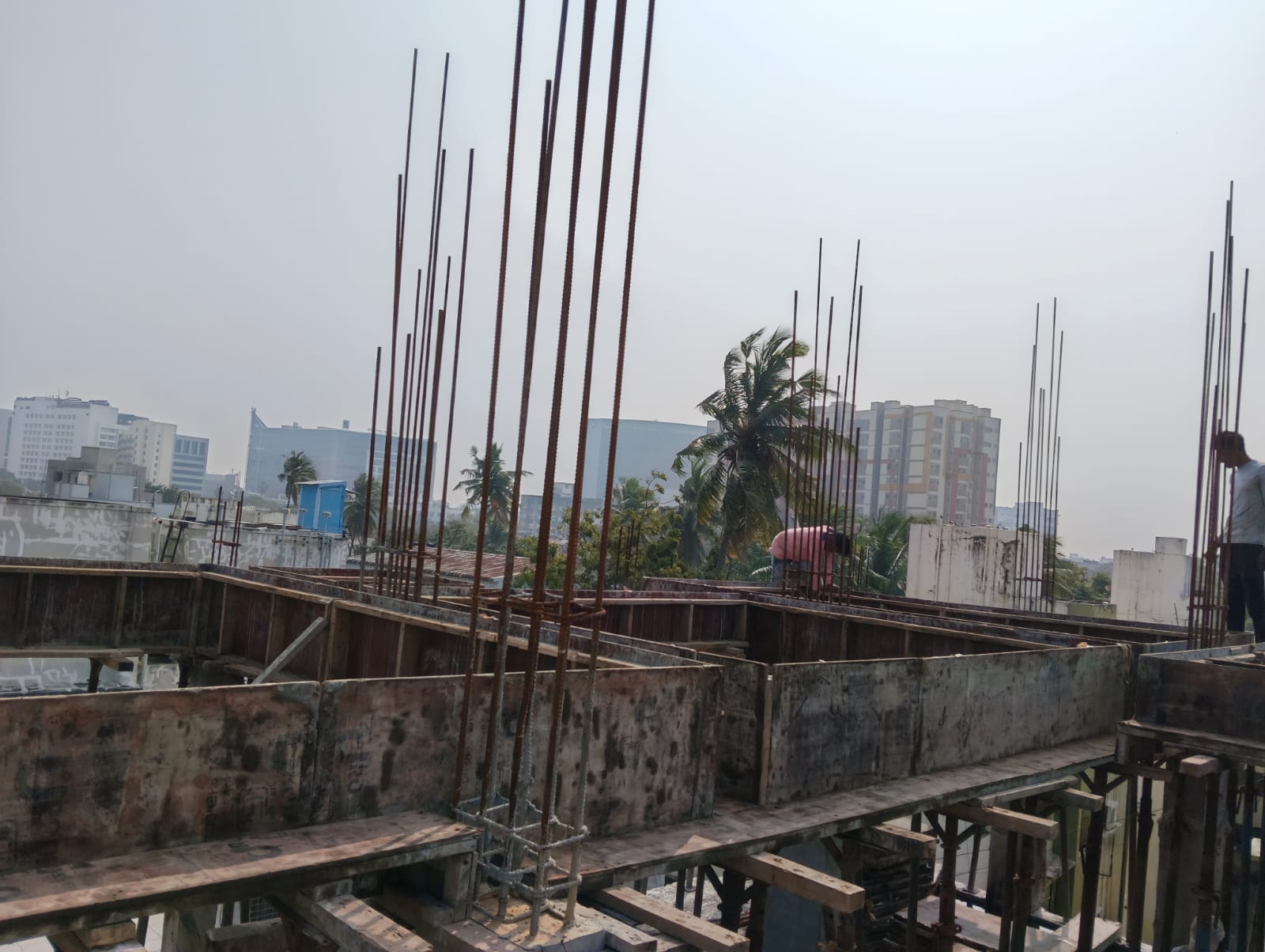

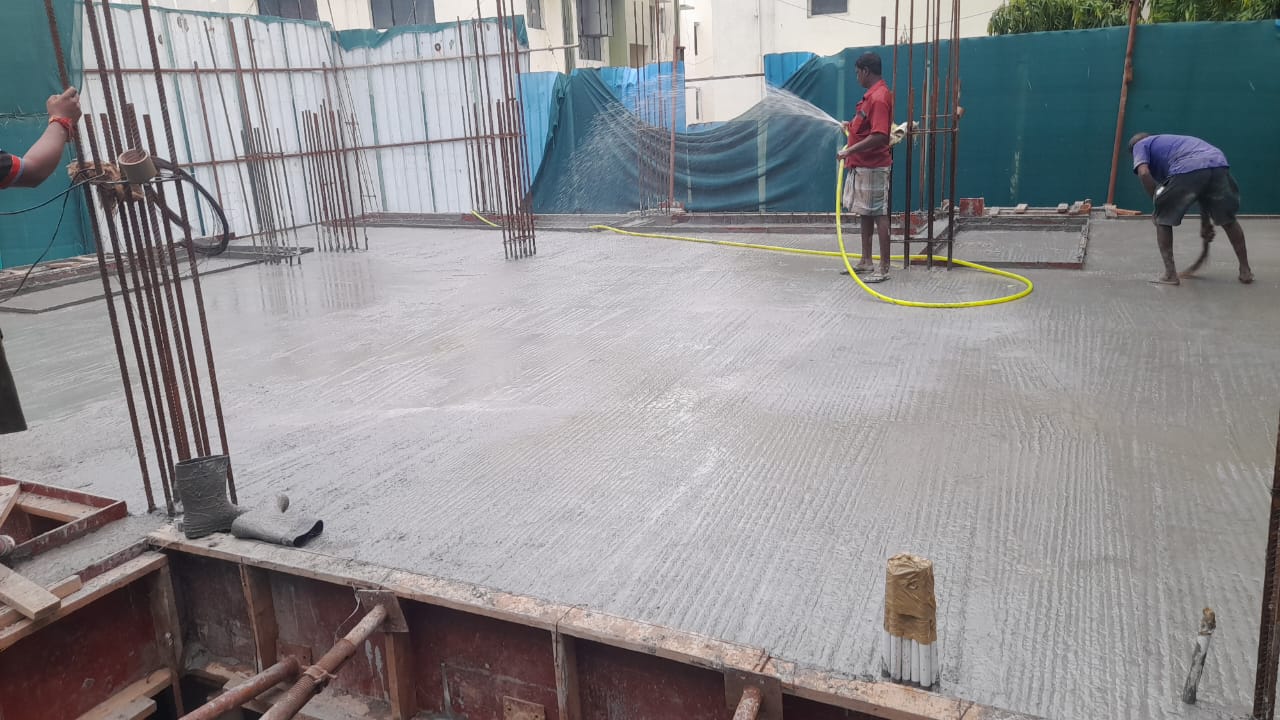

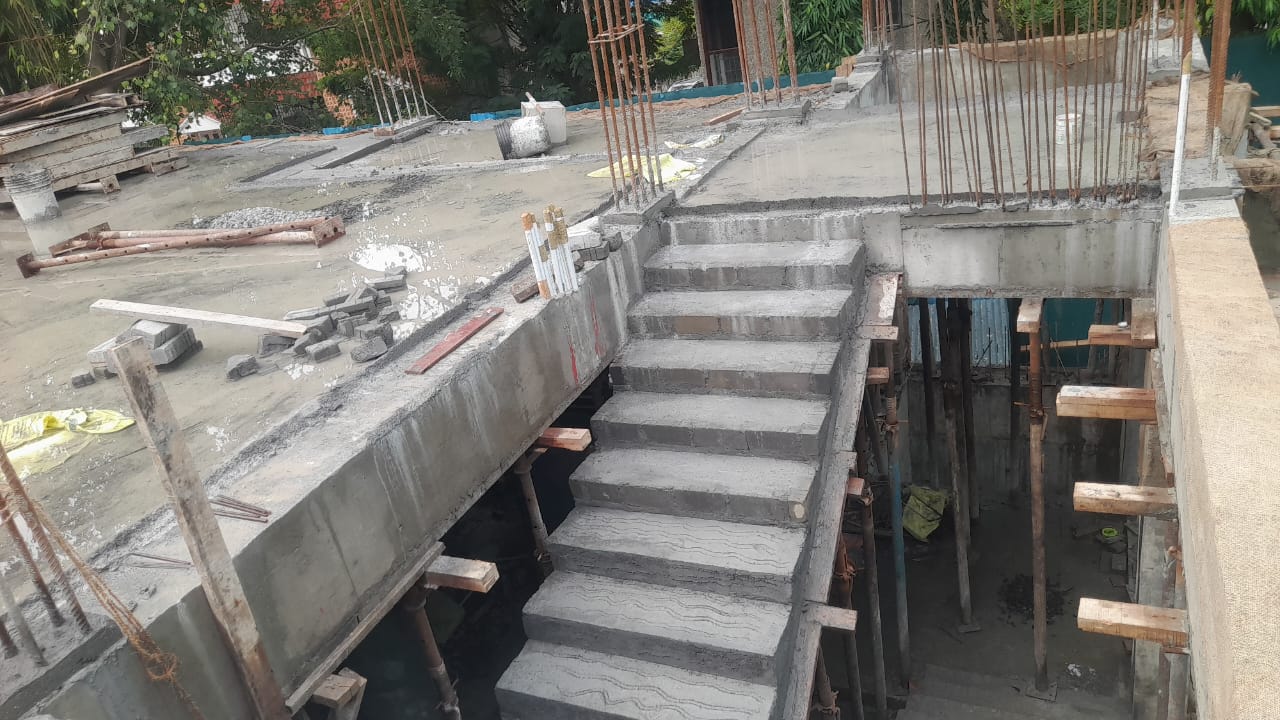

  • OHT base slab work is in progress.(Base slab work completed)

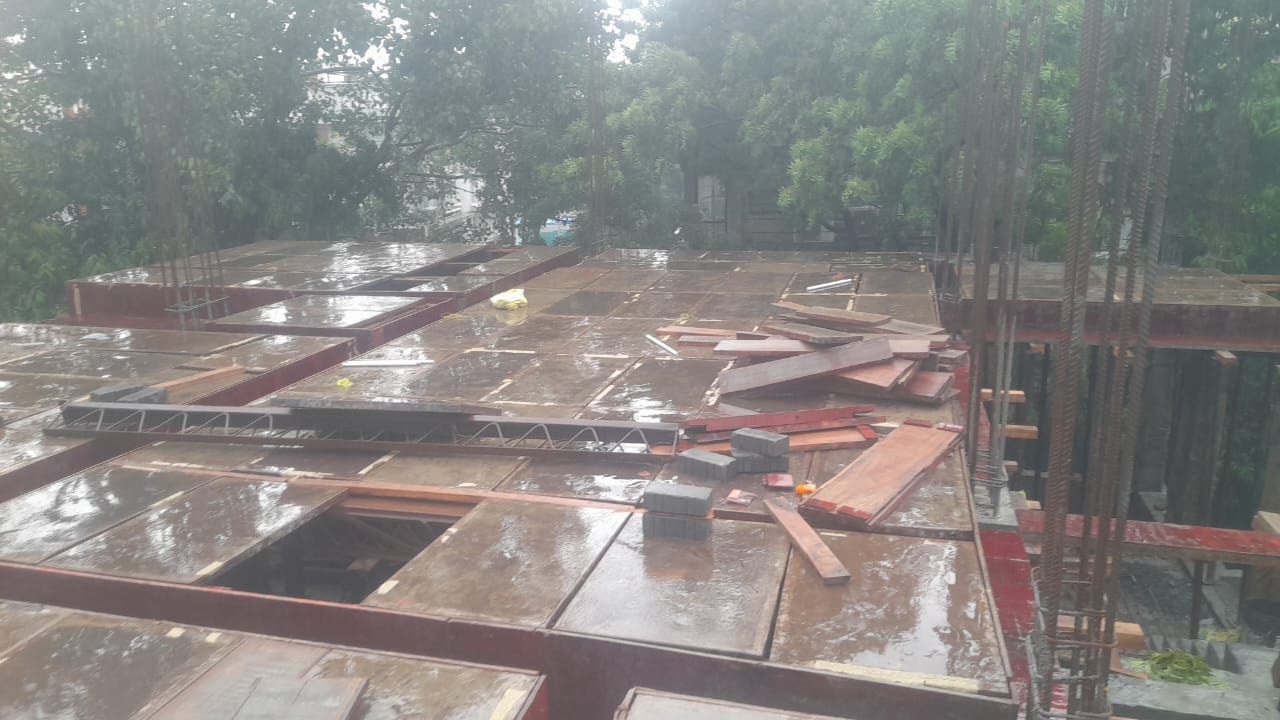

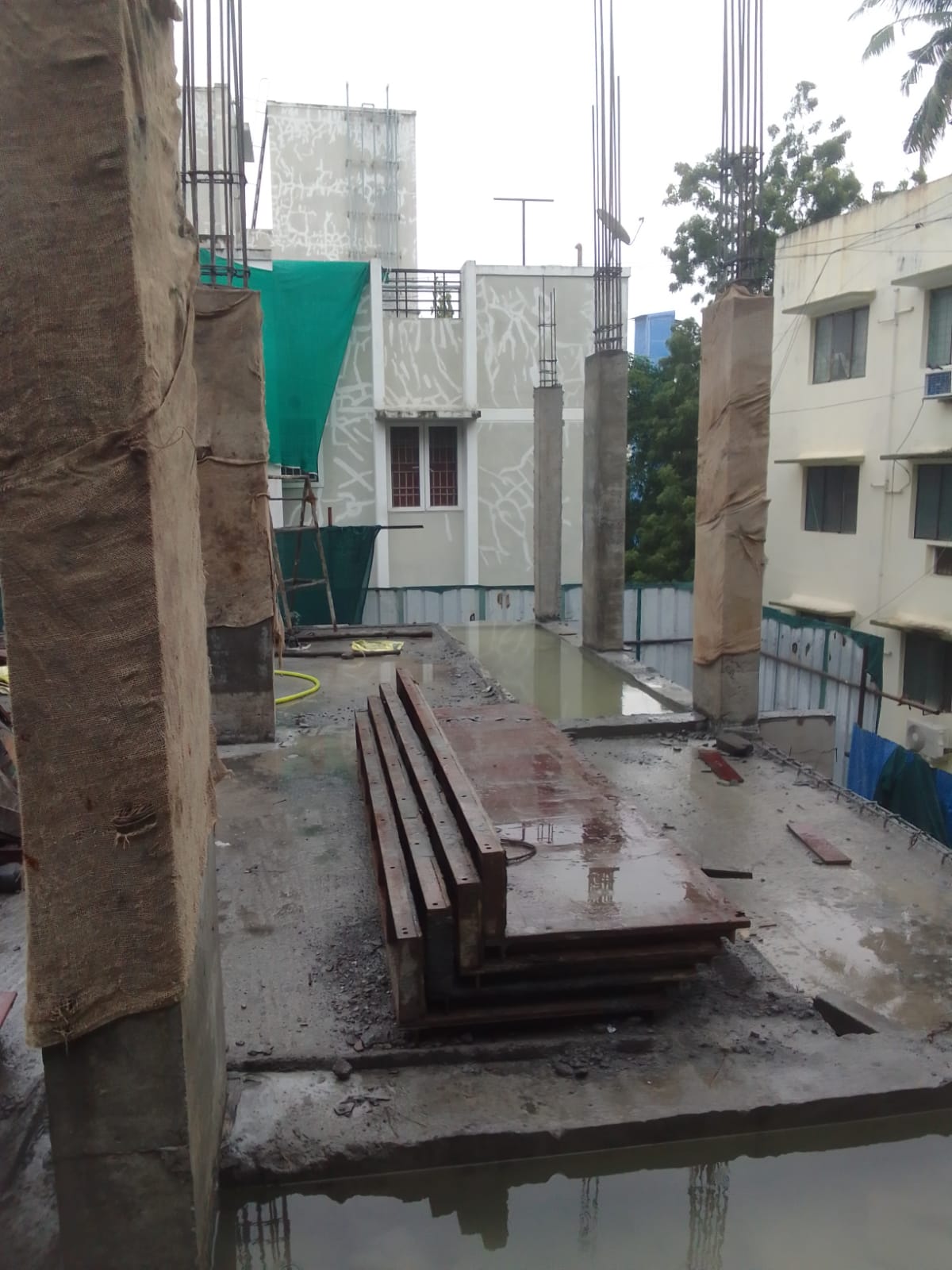

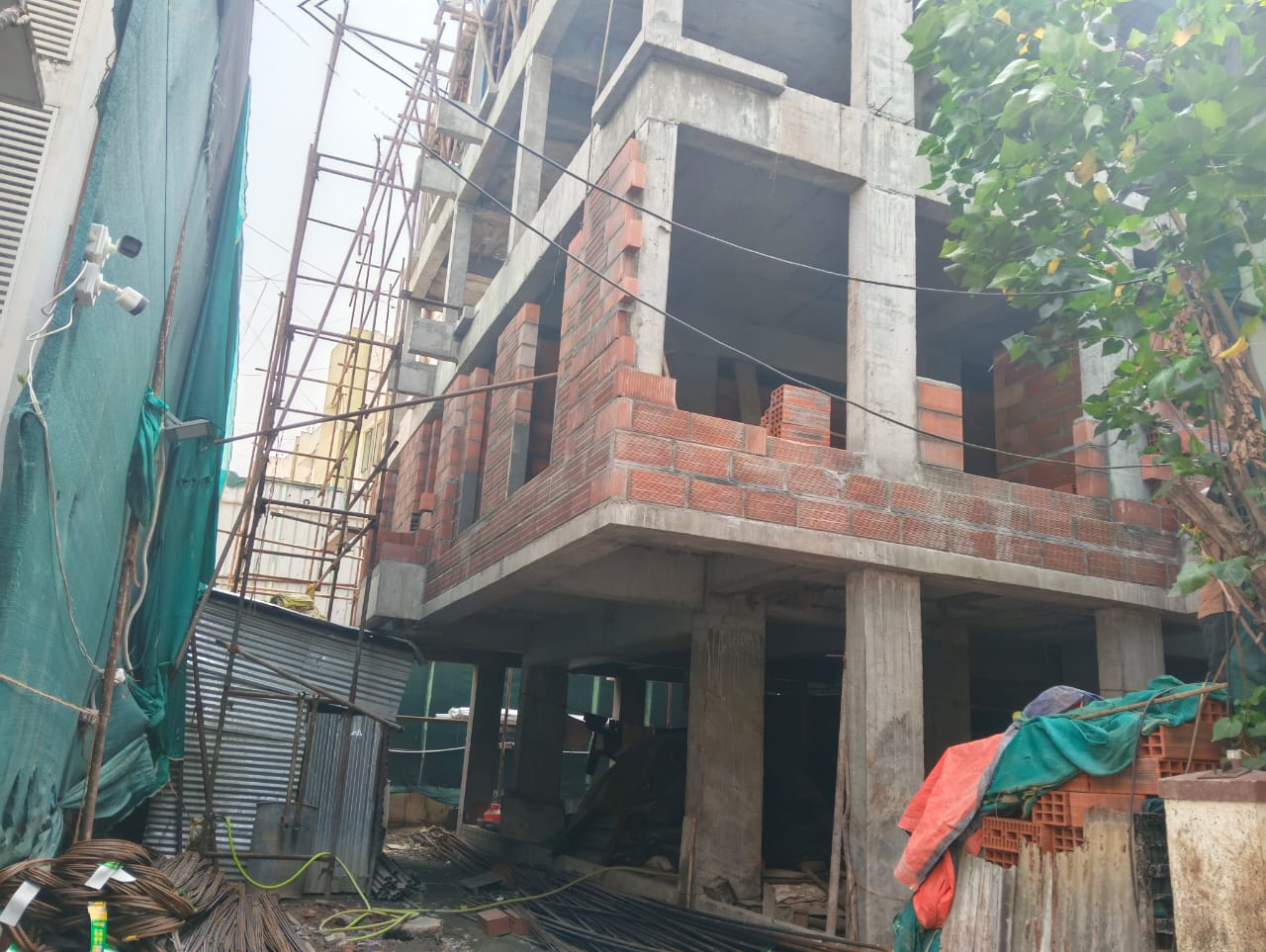

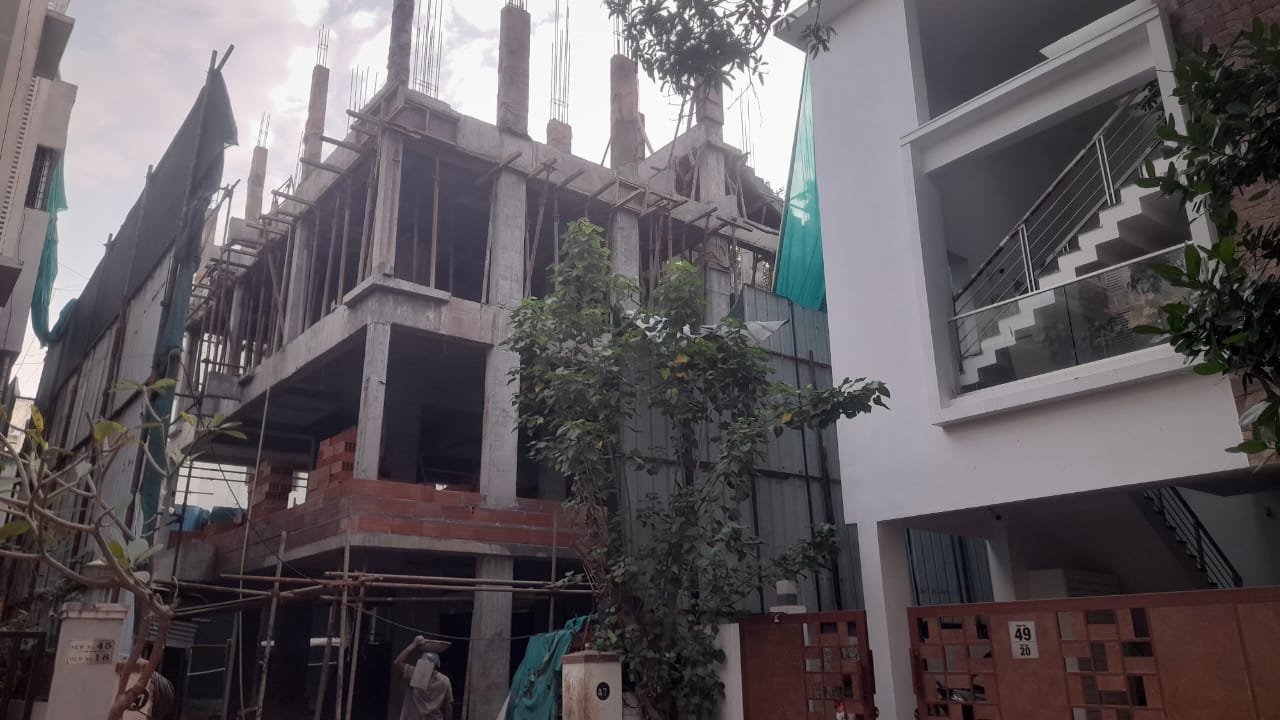

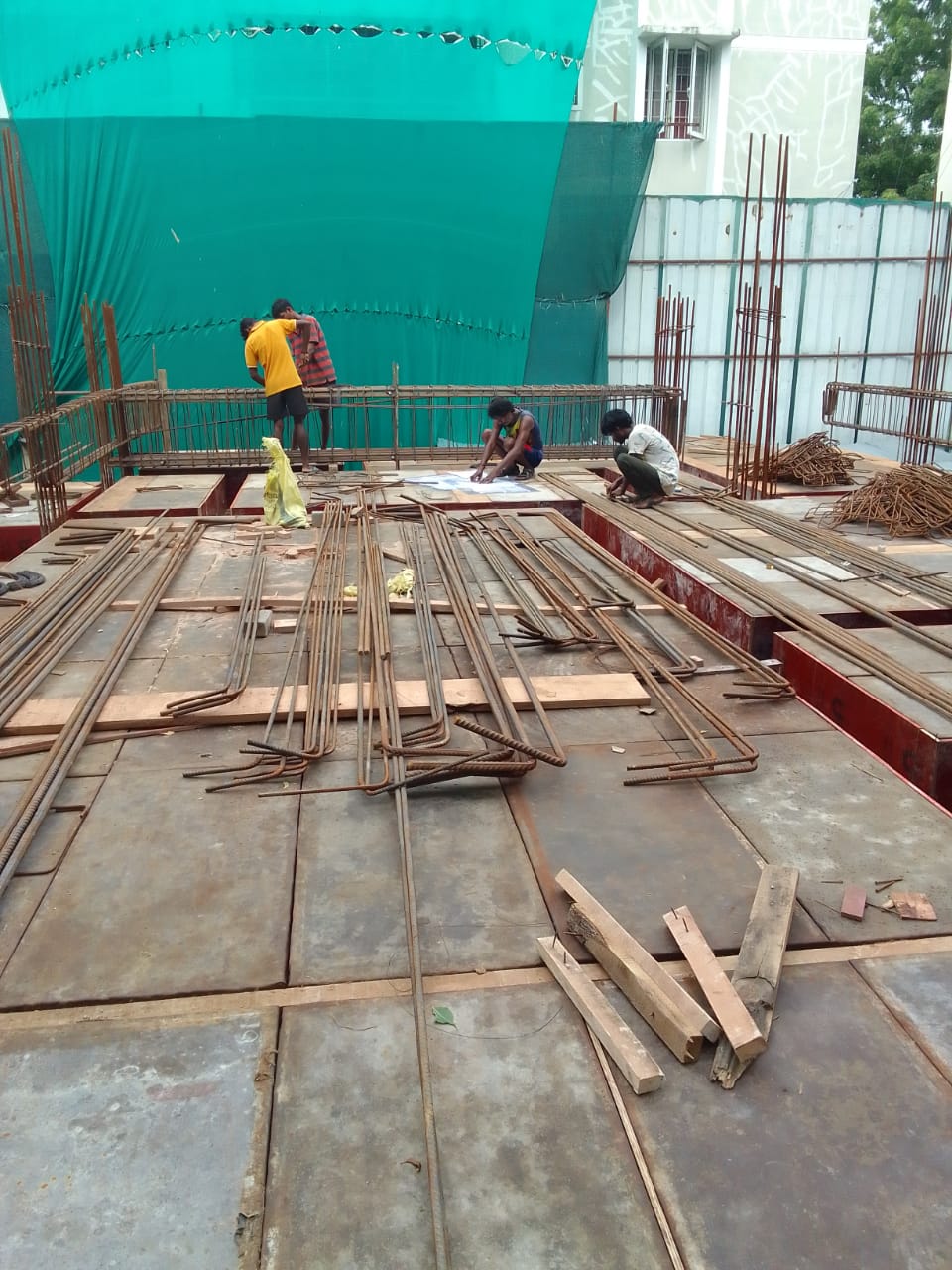

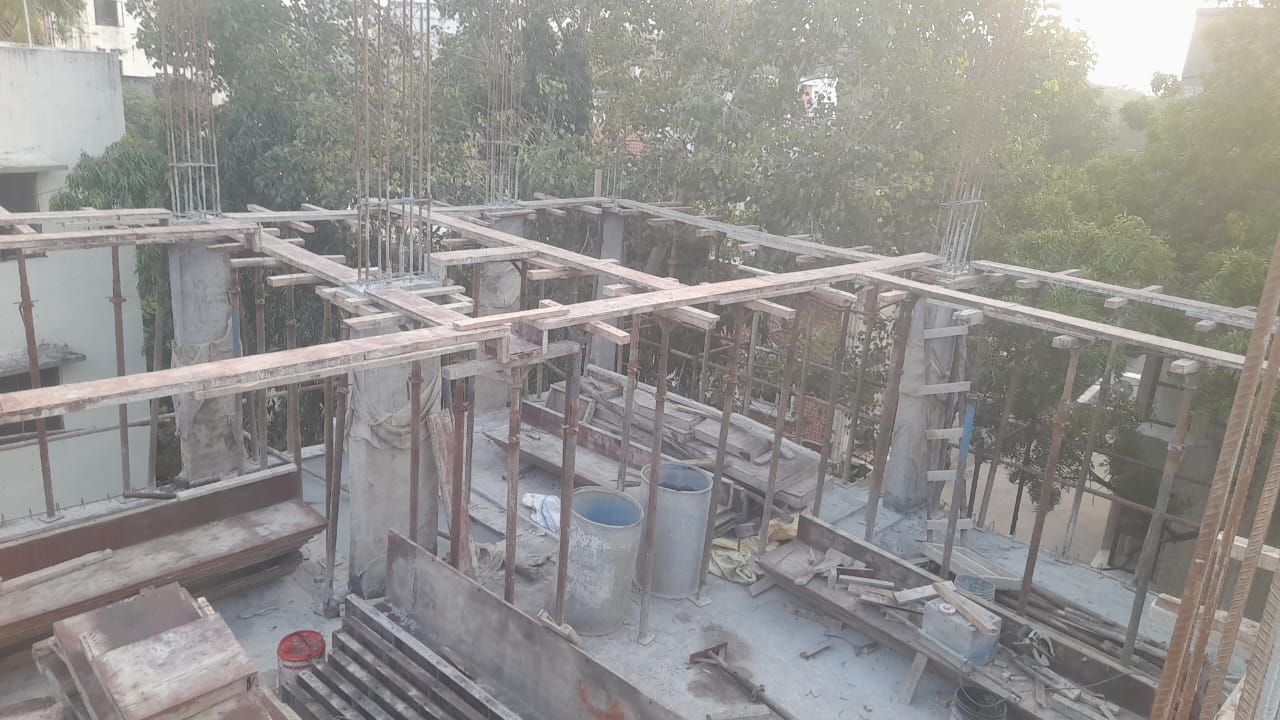

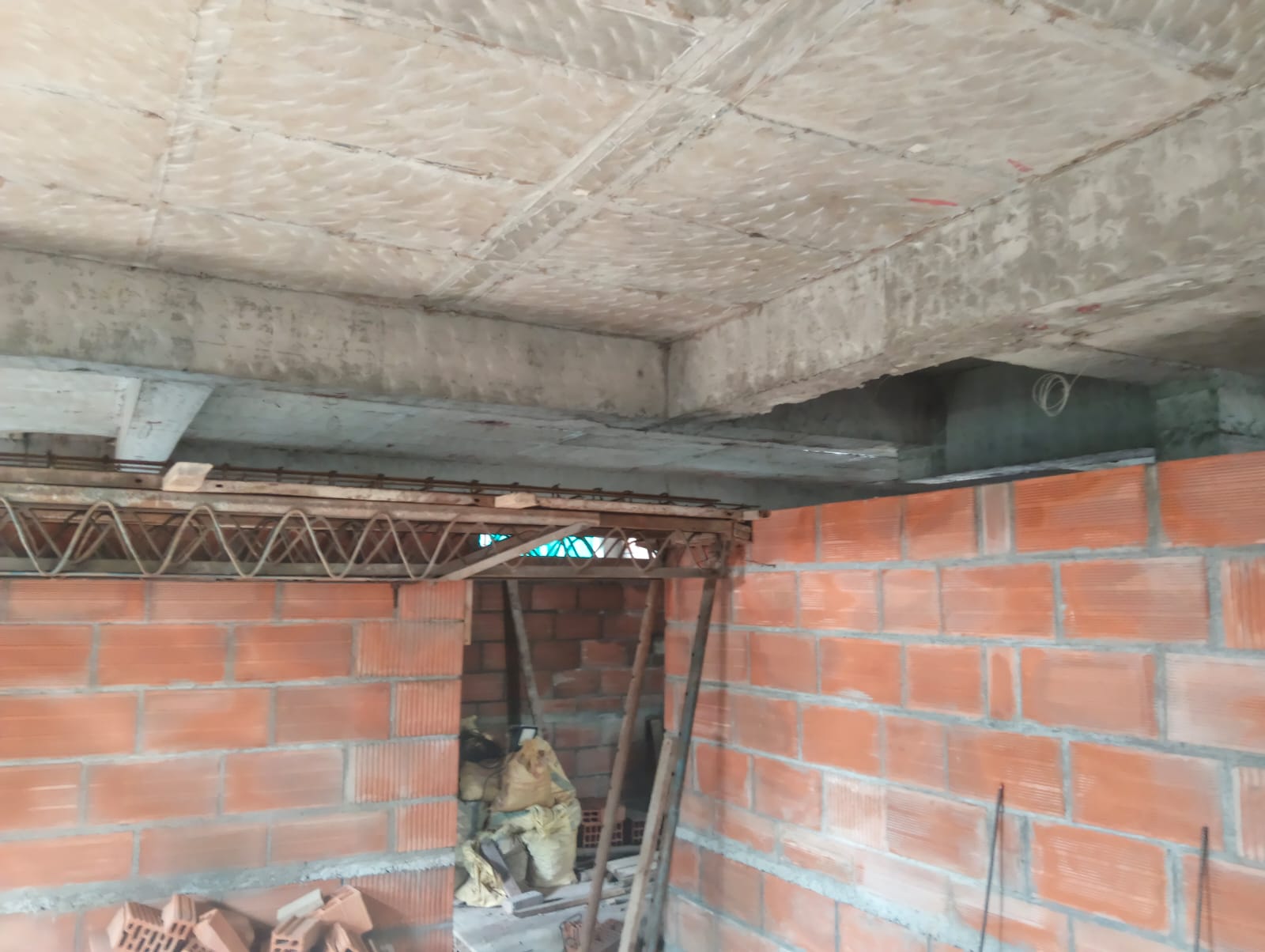

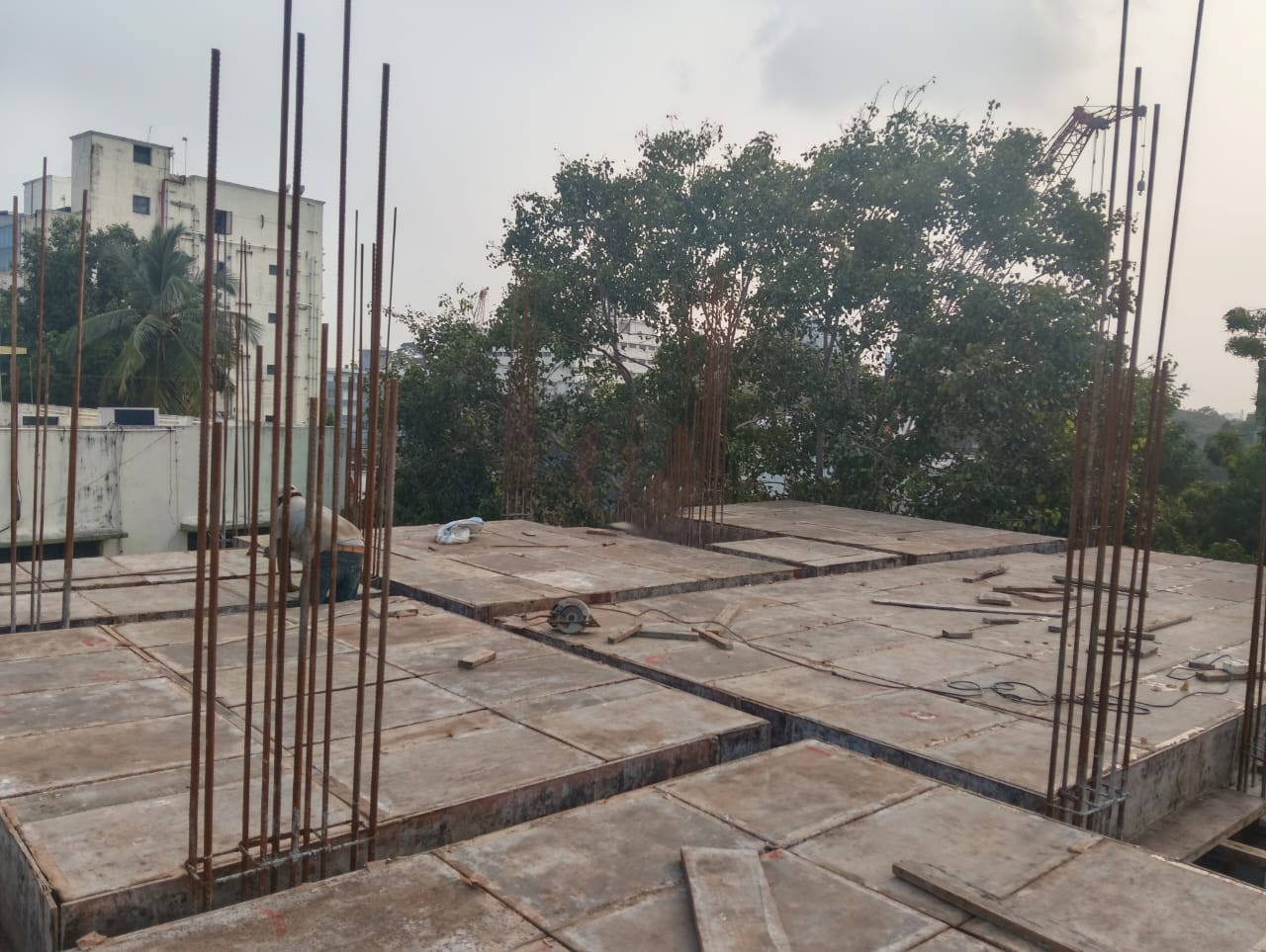

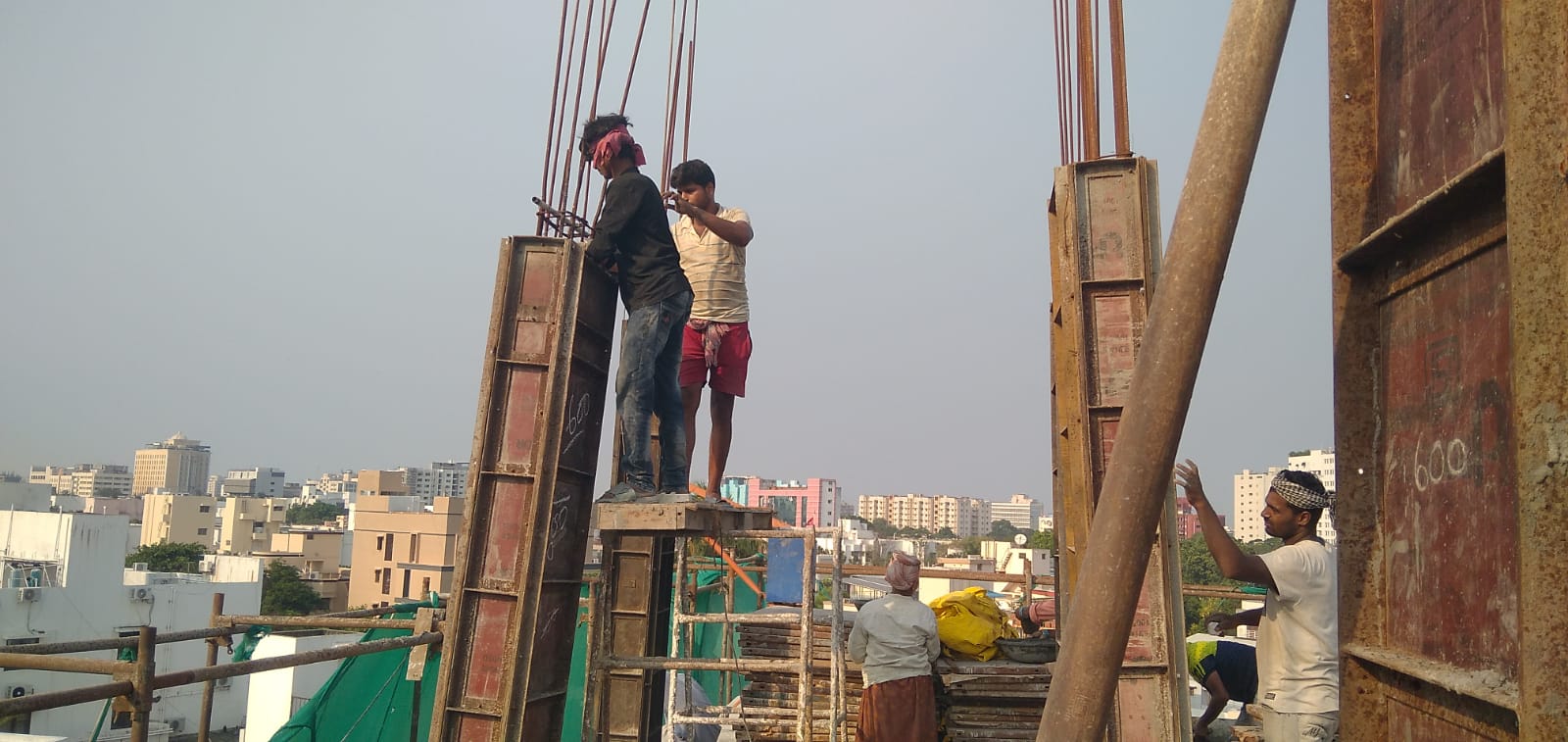

Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image Ponkamal Enclave Progress Image

Property Location

Let your dreams be our

next Project!

Include your country code — all international formats are accepted (e.g. +91, +1, +44, +971).
