Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Balaji

Alwarthirunagar

Download Brochure

Ramaniya - Files

Enquire Now

Amenities

Generator Backup Generator Backup
CCTV CCTV
Elevators Elevators

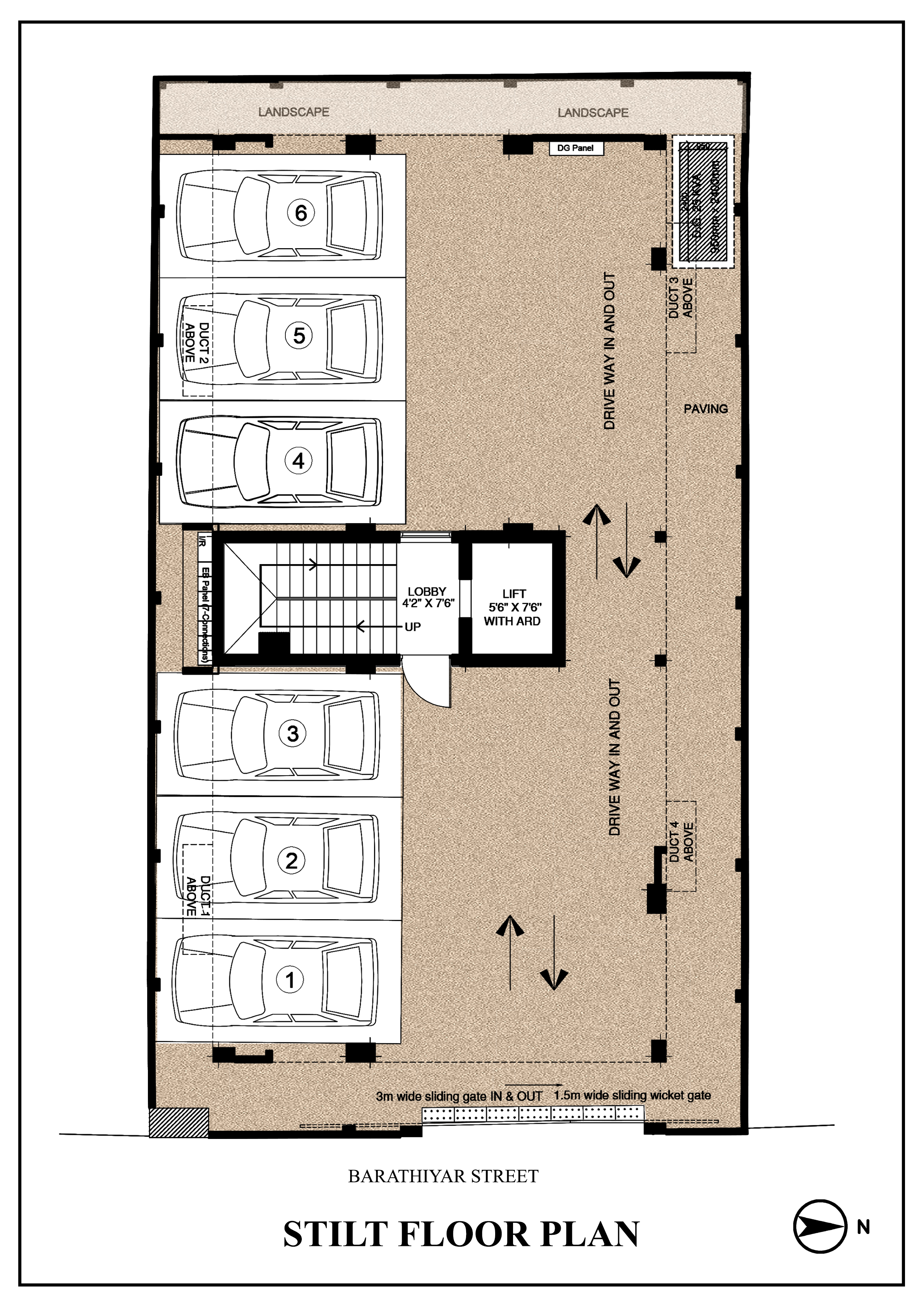

Master Layout Plan

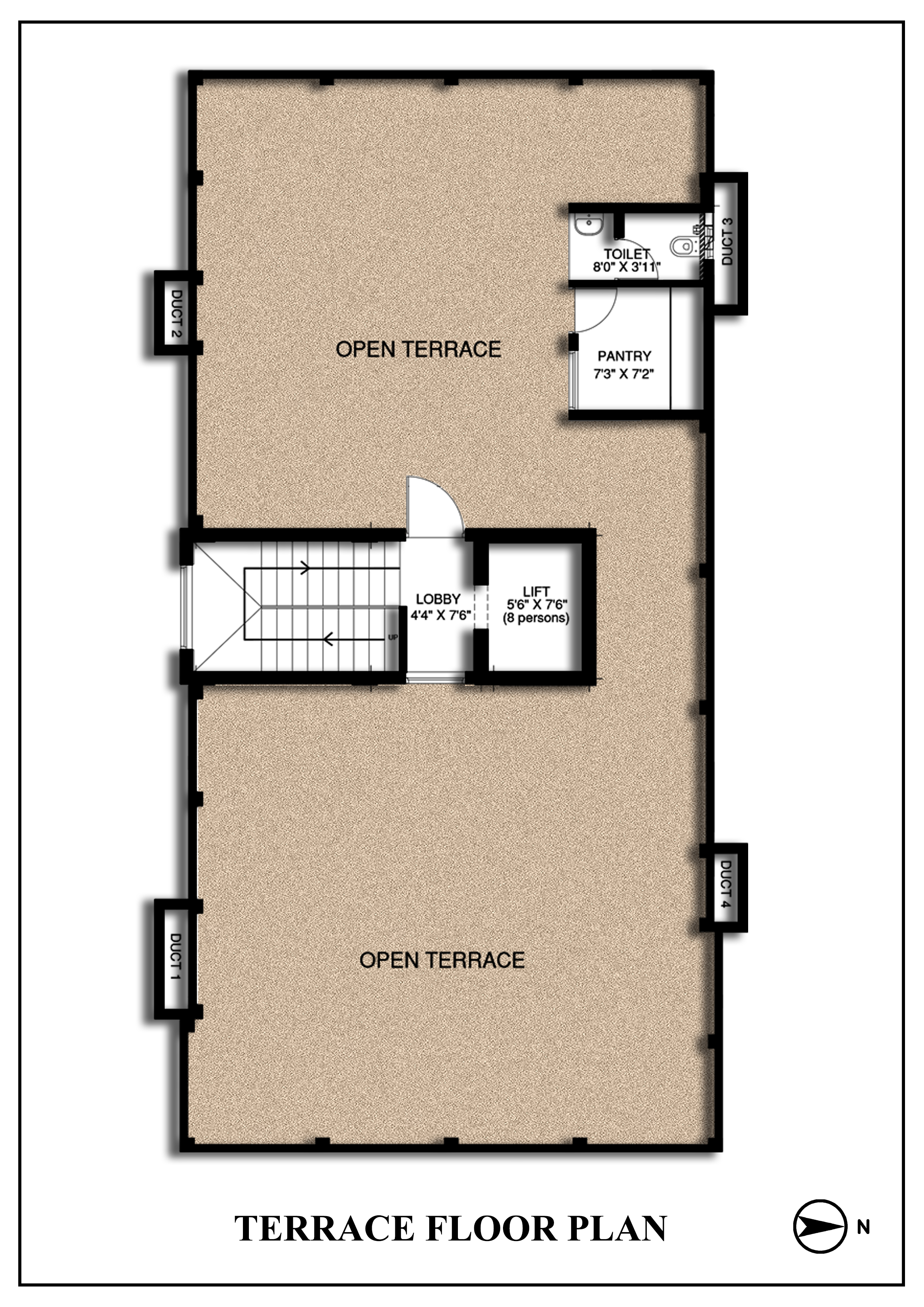

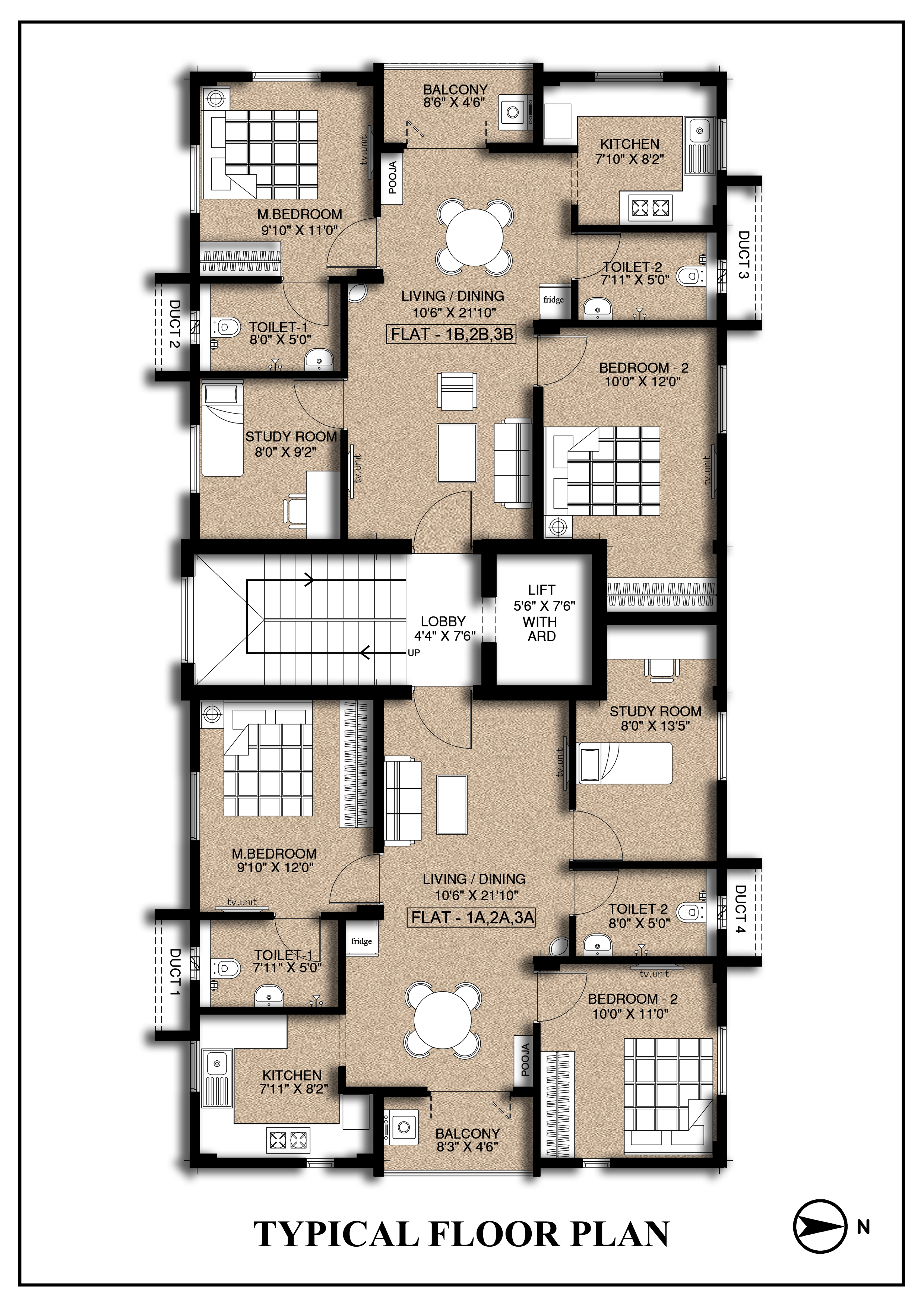

Balaji - Floor Plan
Balaji - Floor Plan
Balaji - Floor Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
2B 2 2BHK + 2T 1017 East Available

Approvals

Planning Permit No:

PPA/WDCN11/08021/2025

Date of Permit:

2025-12-18

Building Permission No:

BA/WDCN11/09503/2025

Date of Permit:

2025-12-18

Project Update Images

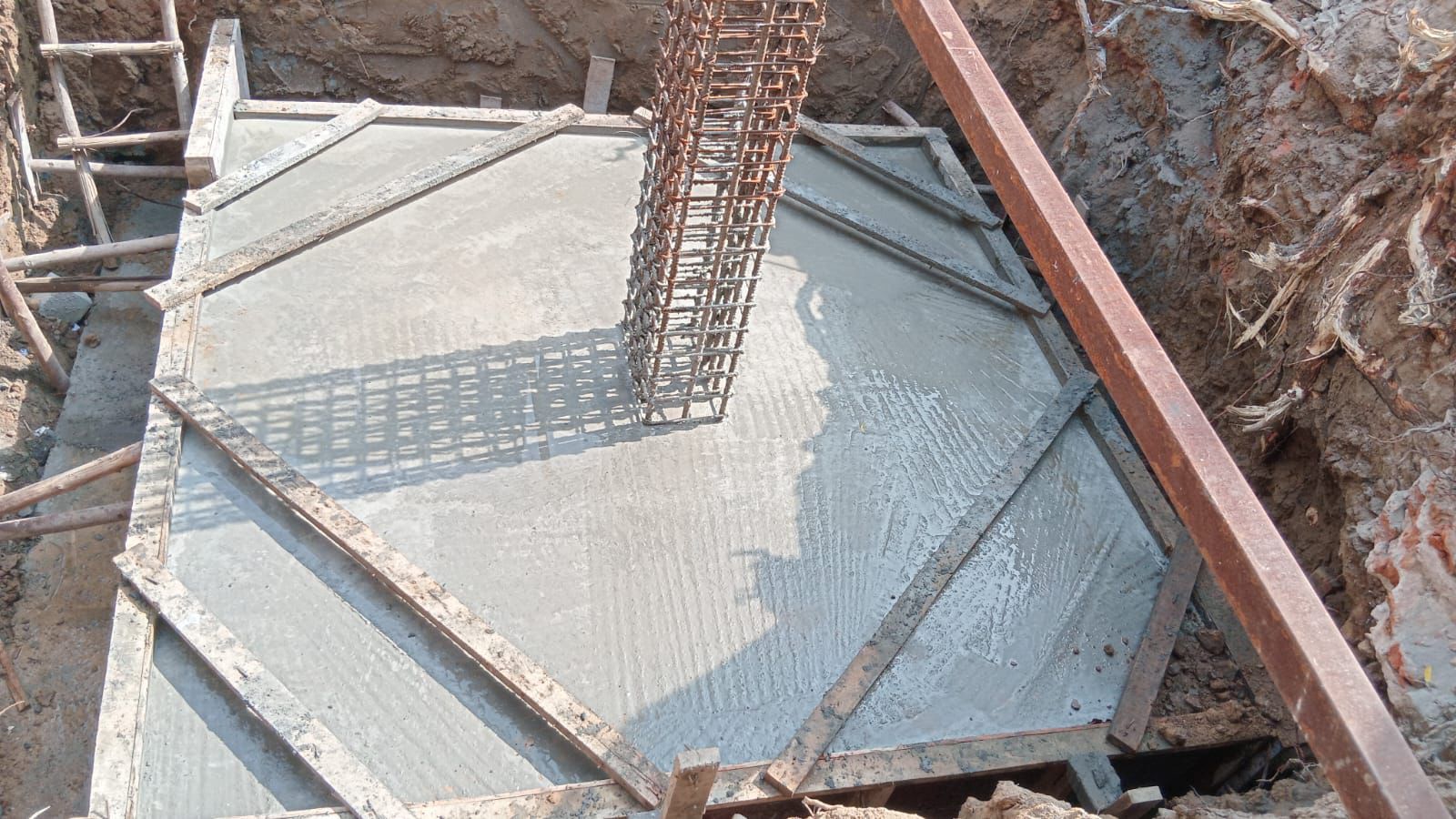

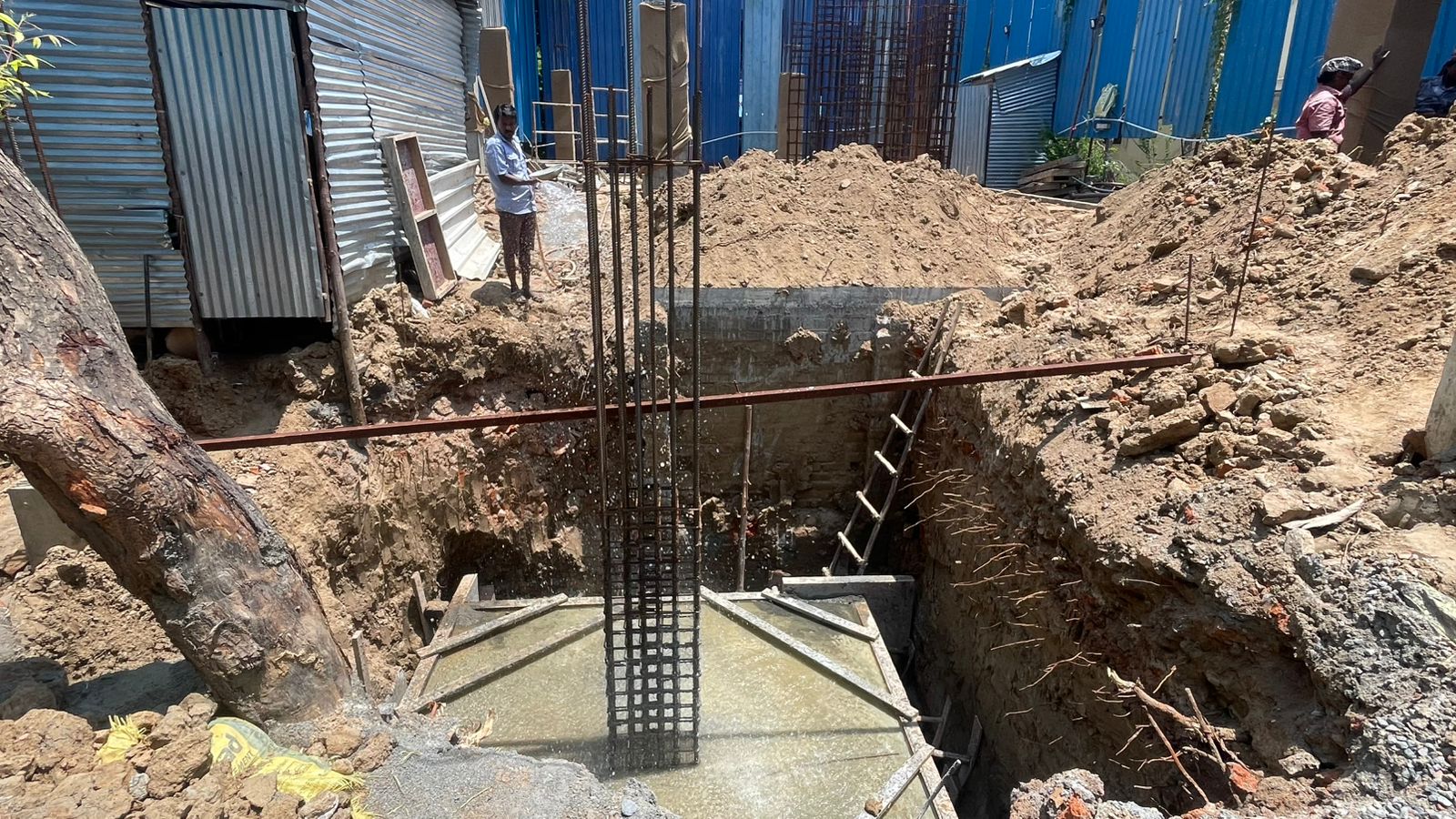

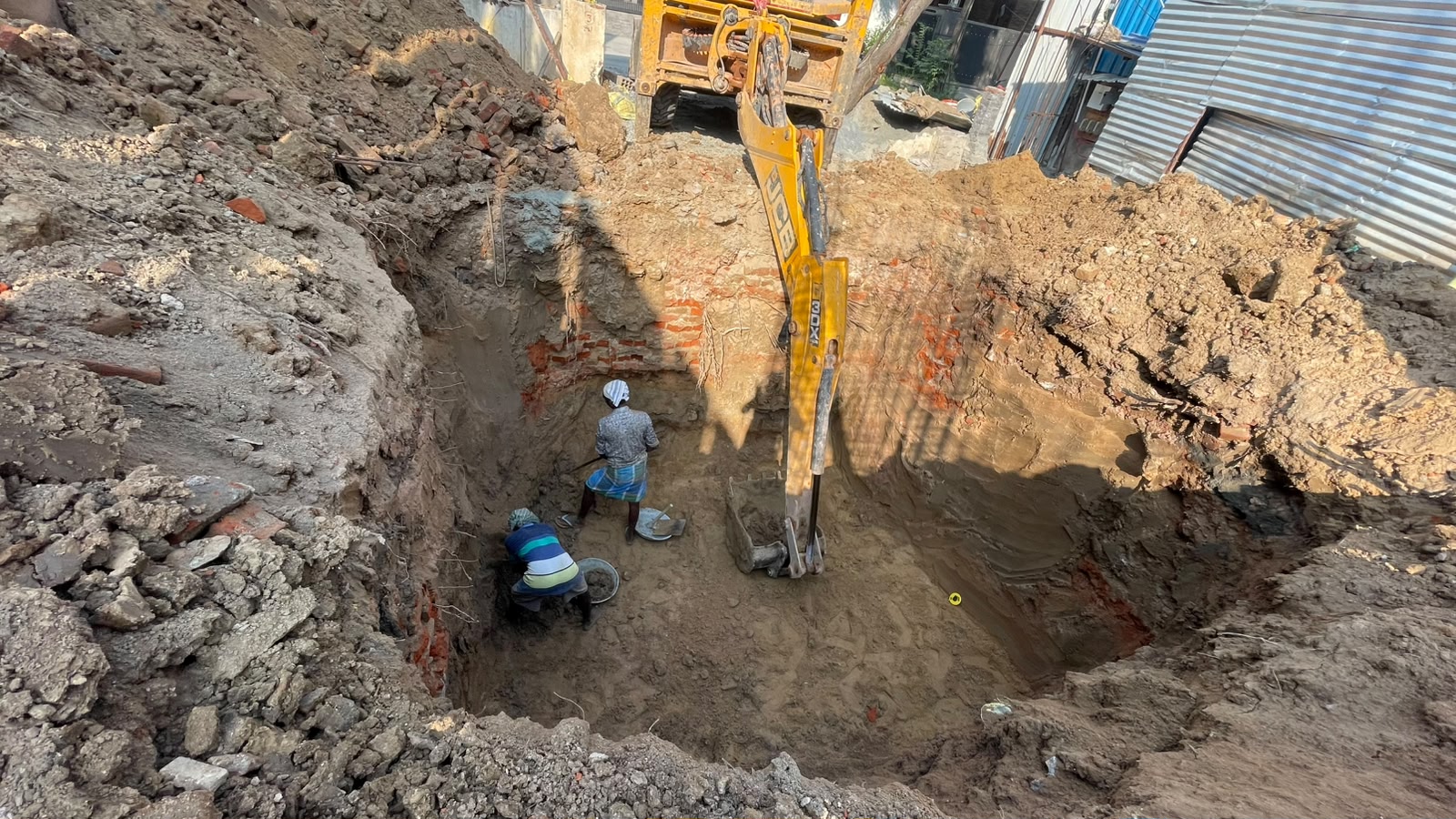

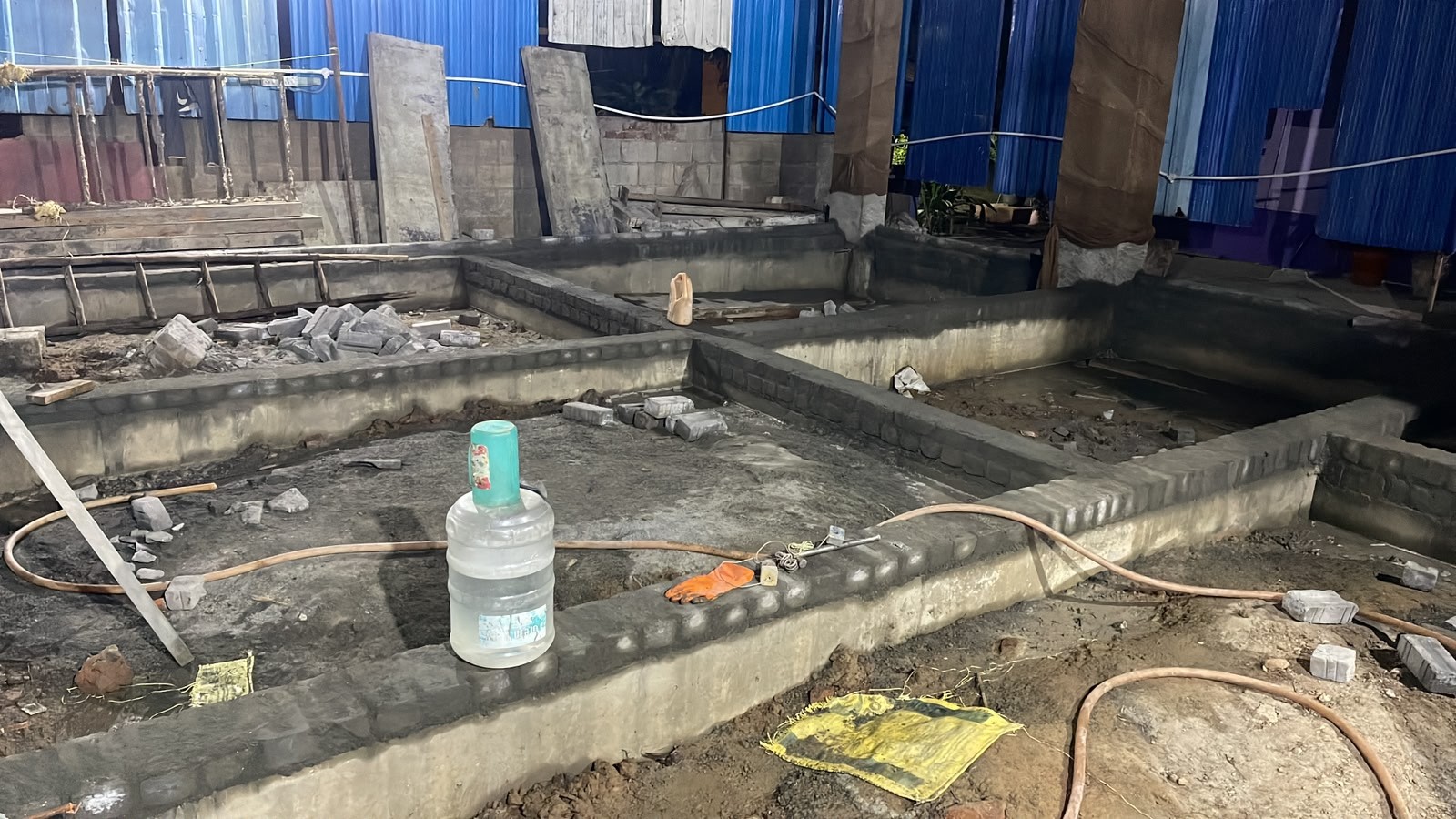

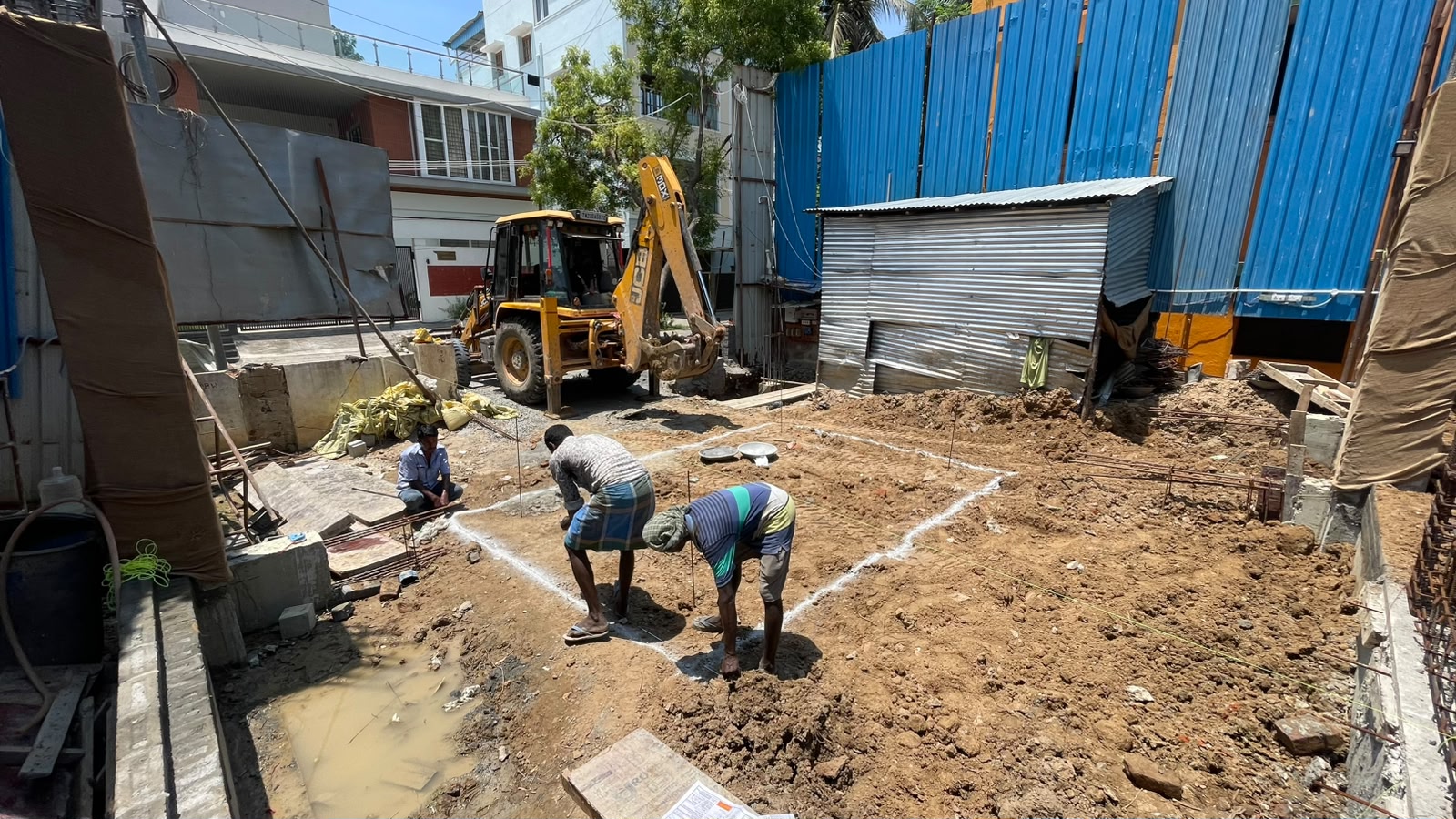

  • Footing concrete work is completed.

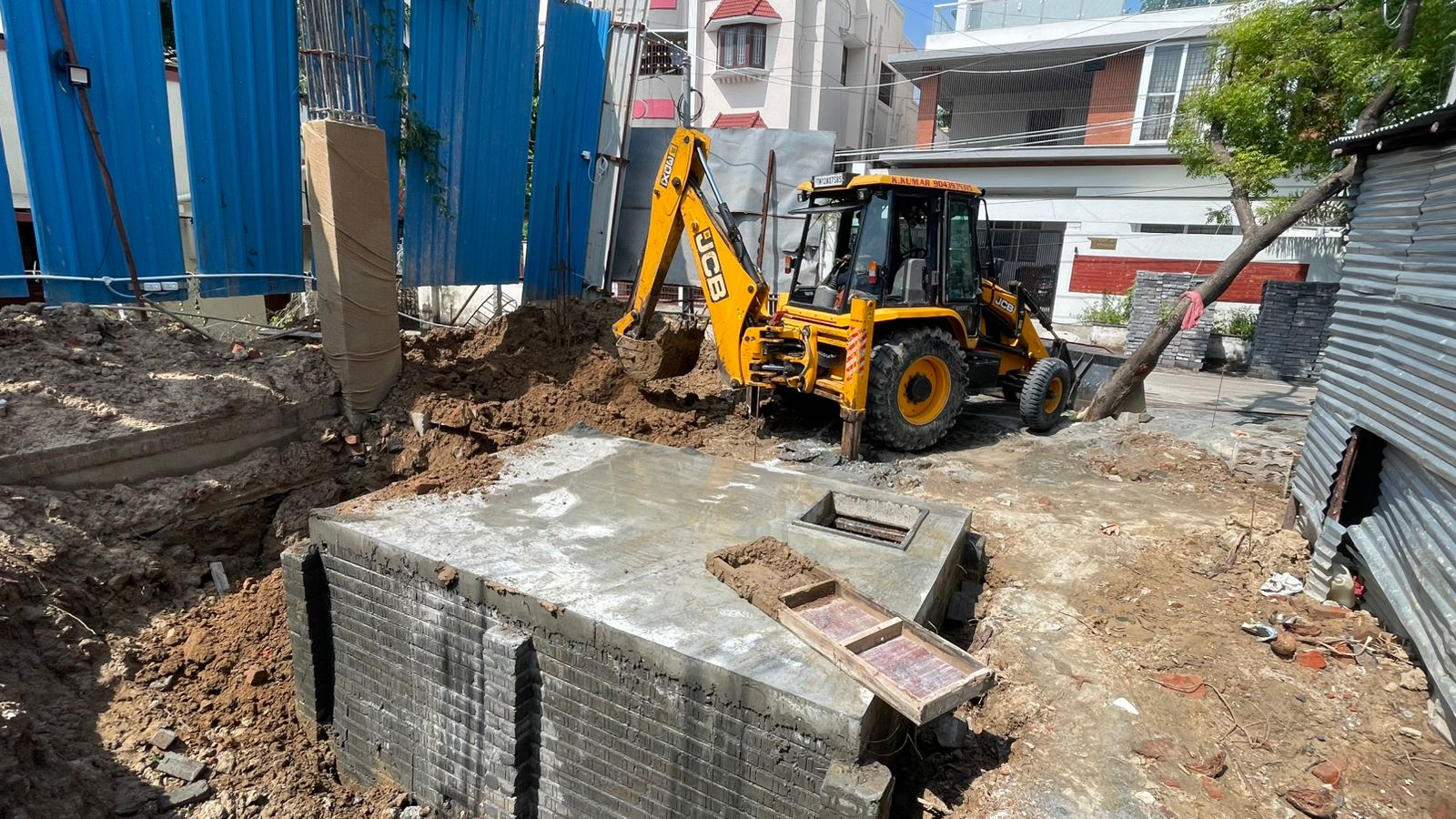

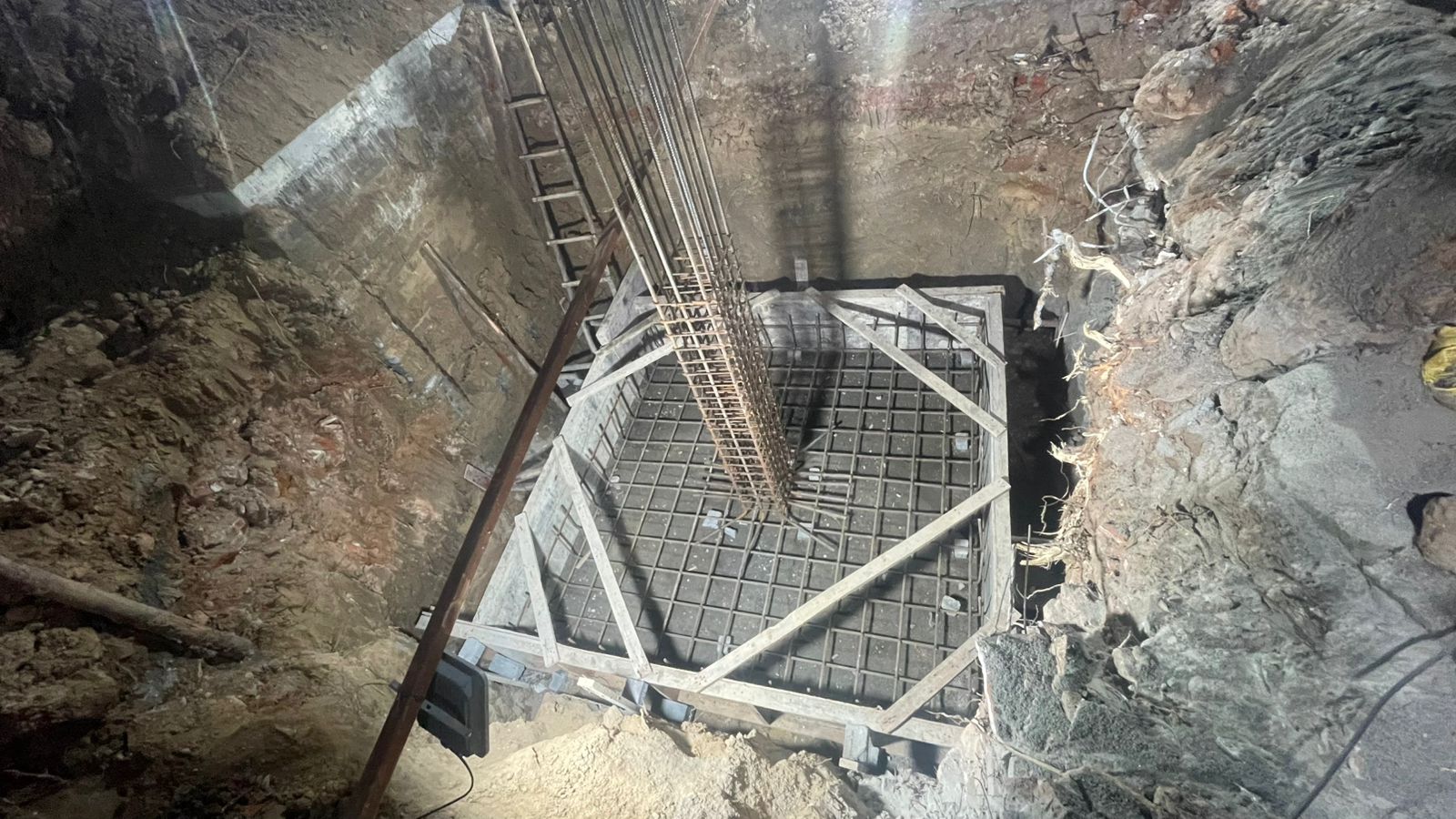

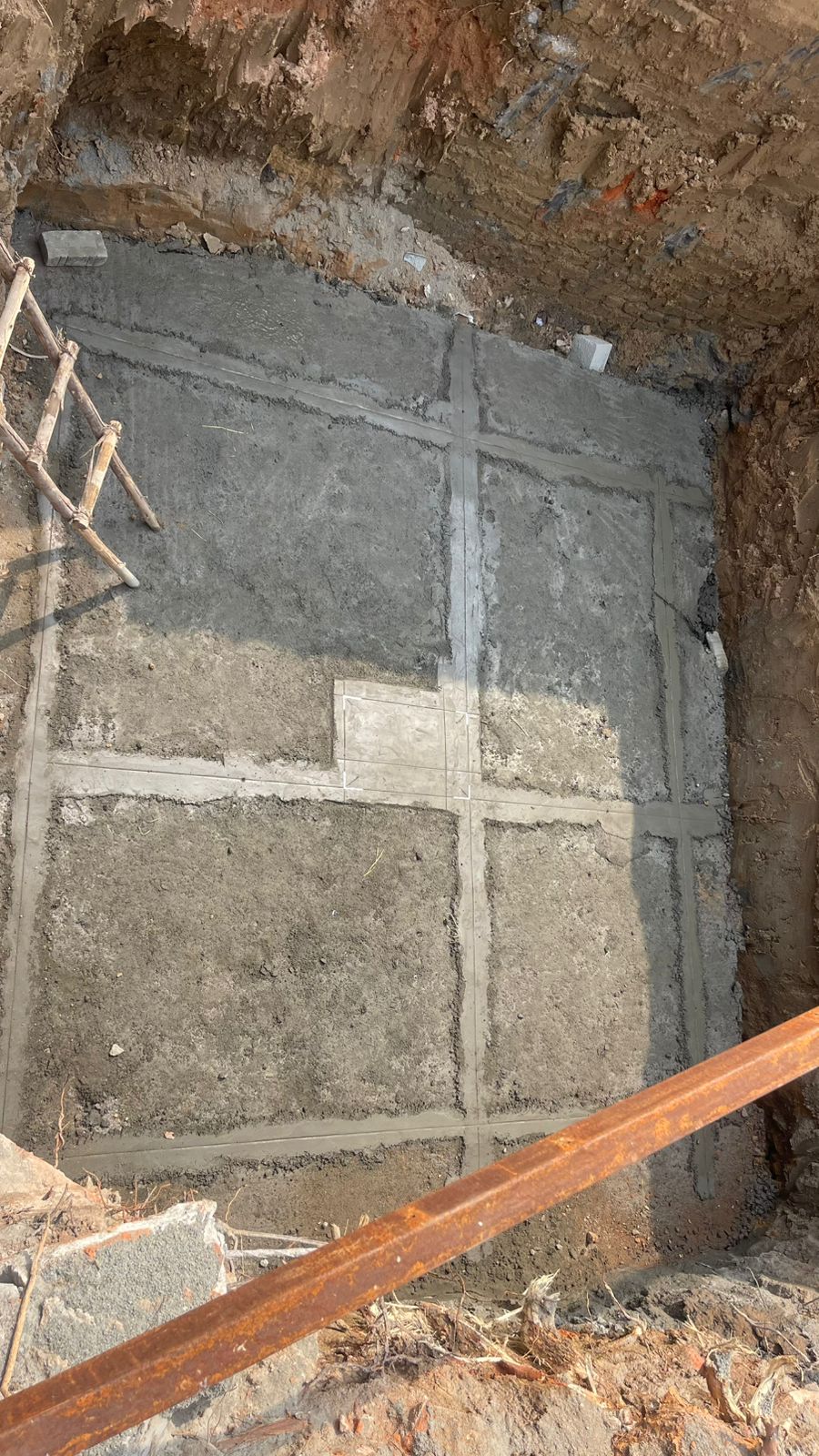

  • Stub column concrete work is completed.

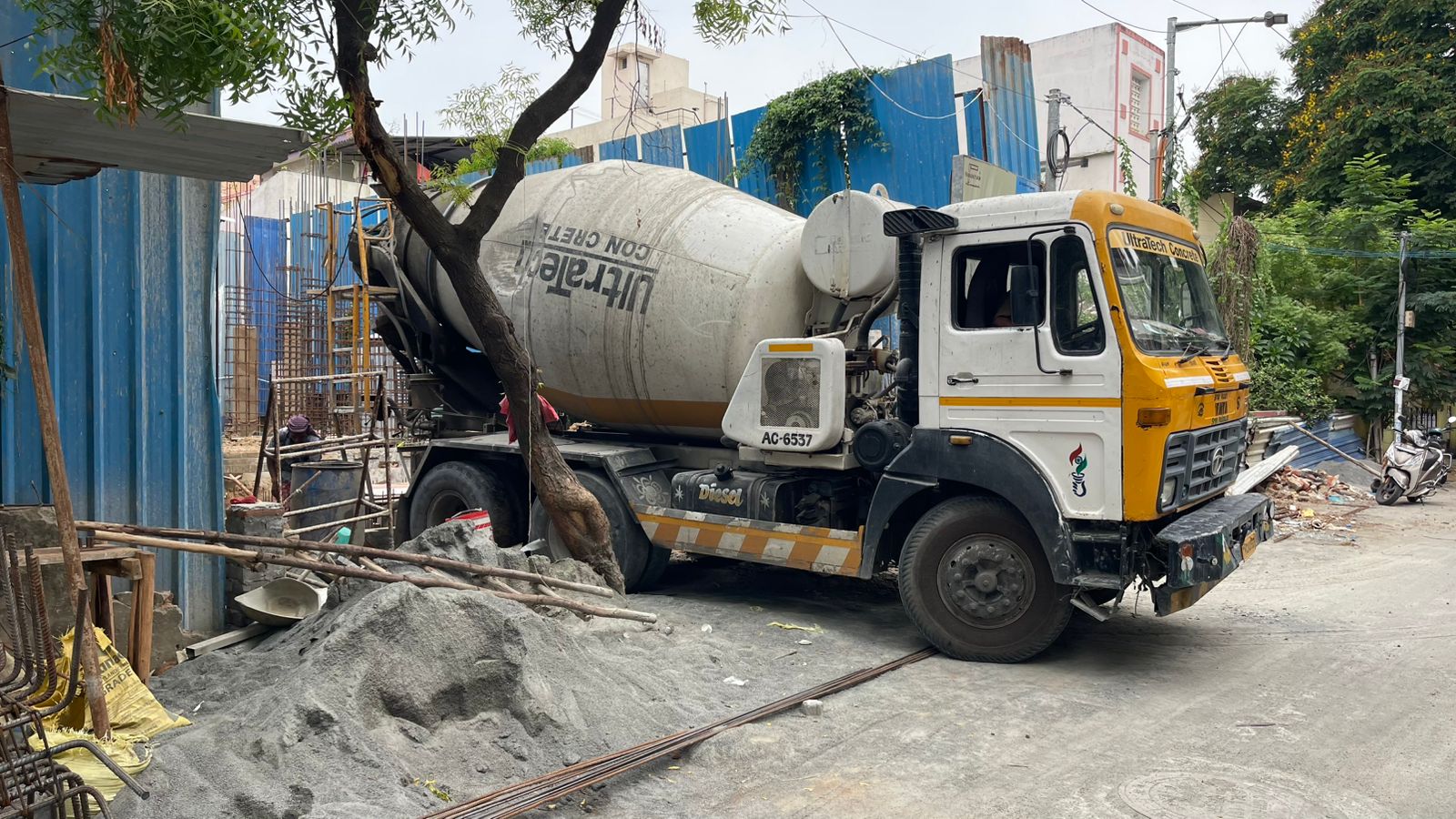

  • Plinth beam PCC work is in progress.(80% completed).

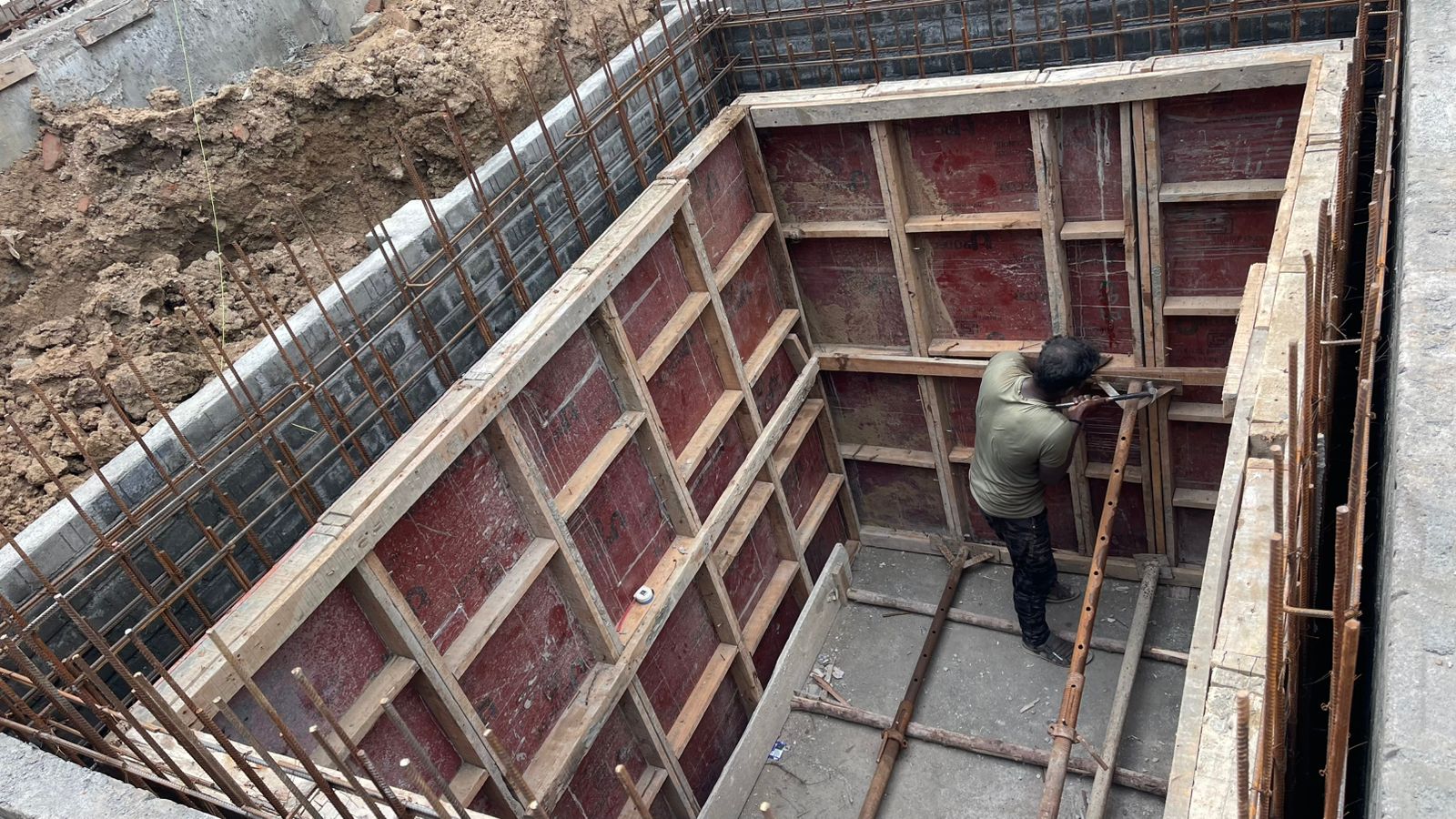

  • Plinth beam concrete work is in progress.(80% completed)
  • Stilt floor column concrete work is in progress.(10/13 completed)

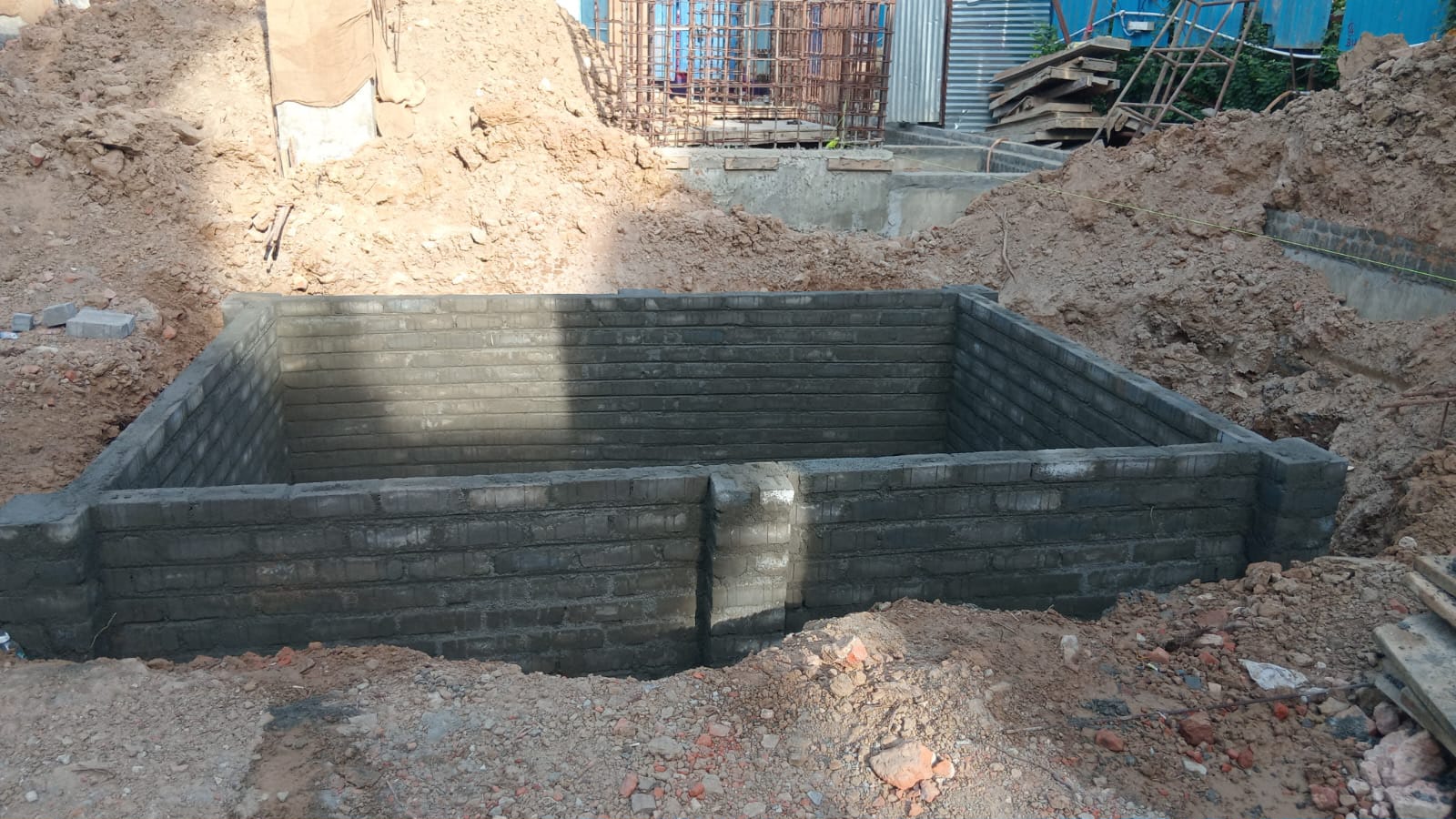

  • Basement brick work is in progress.(50% completed)

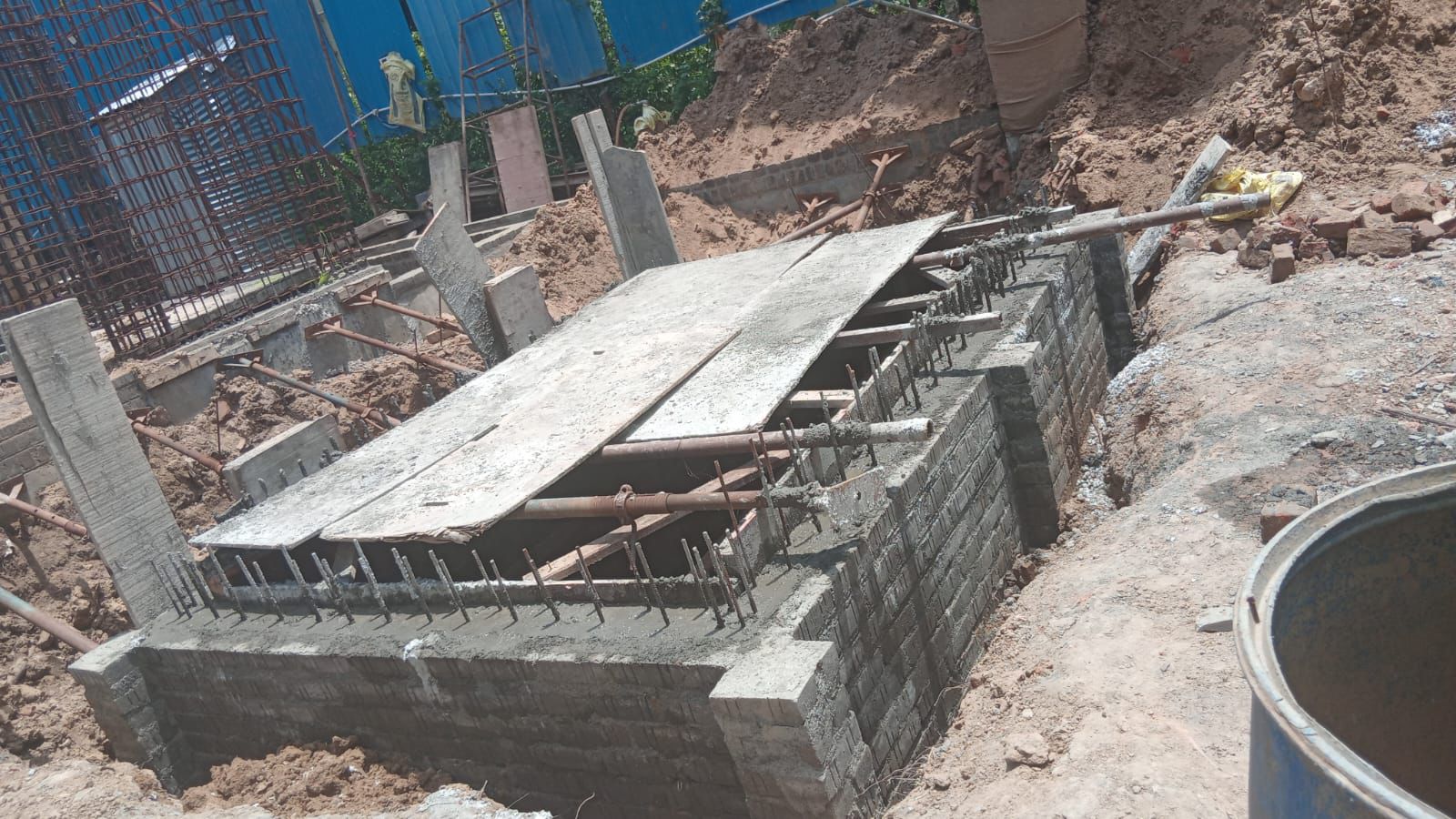

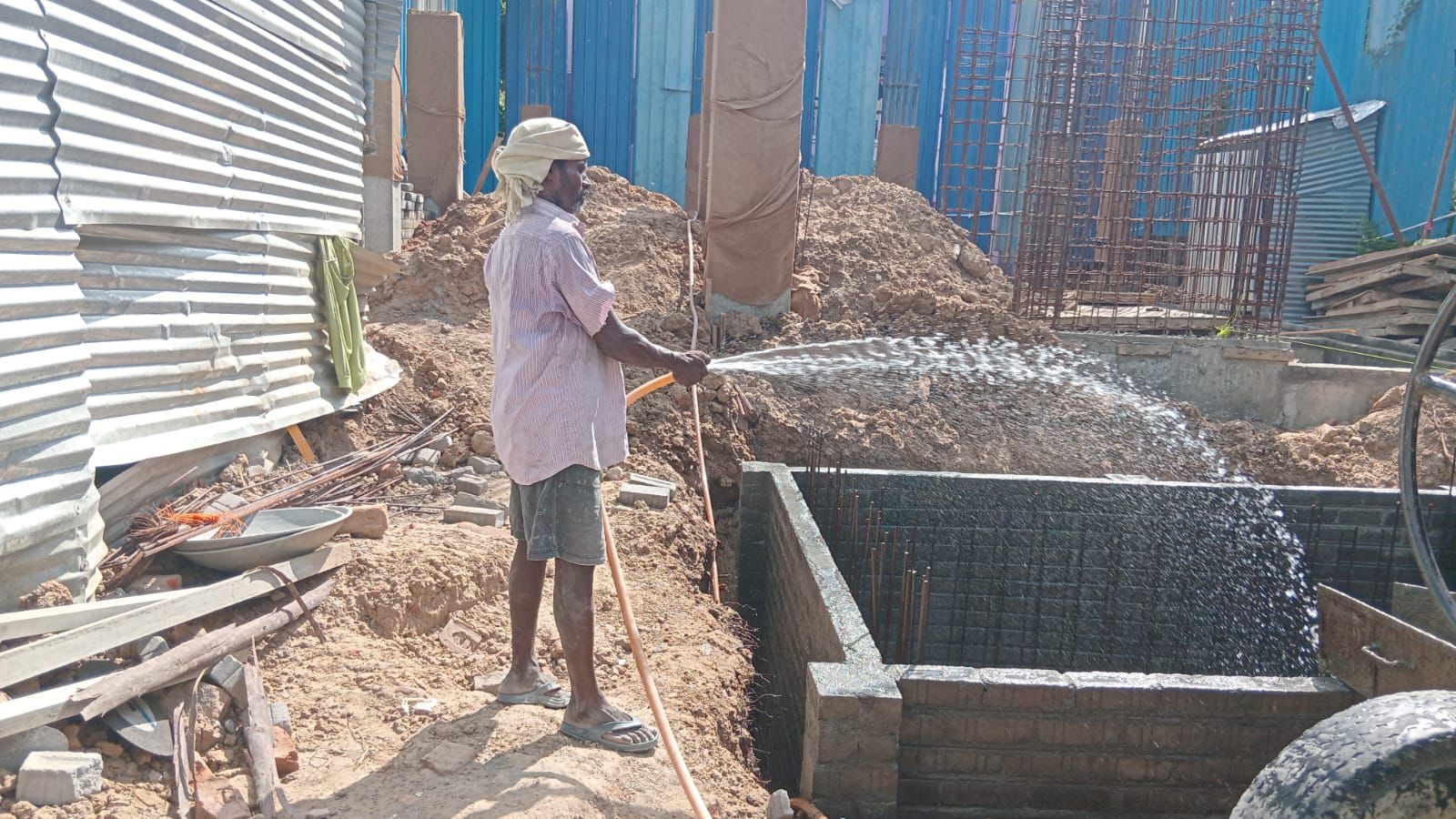

  • Sump work is completed.

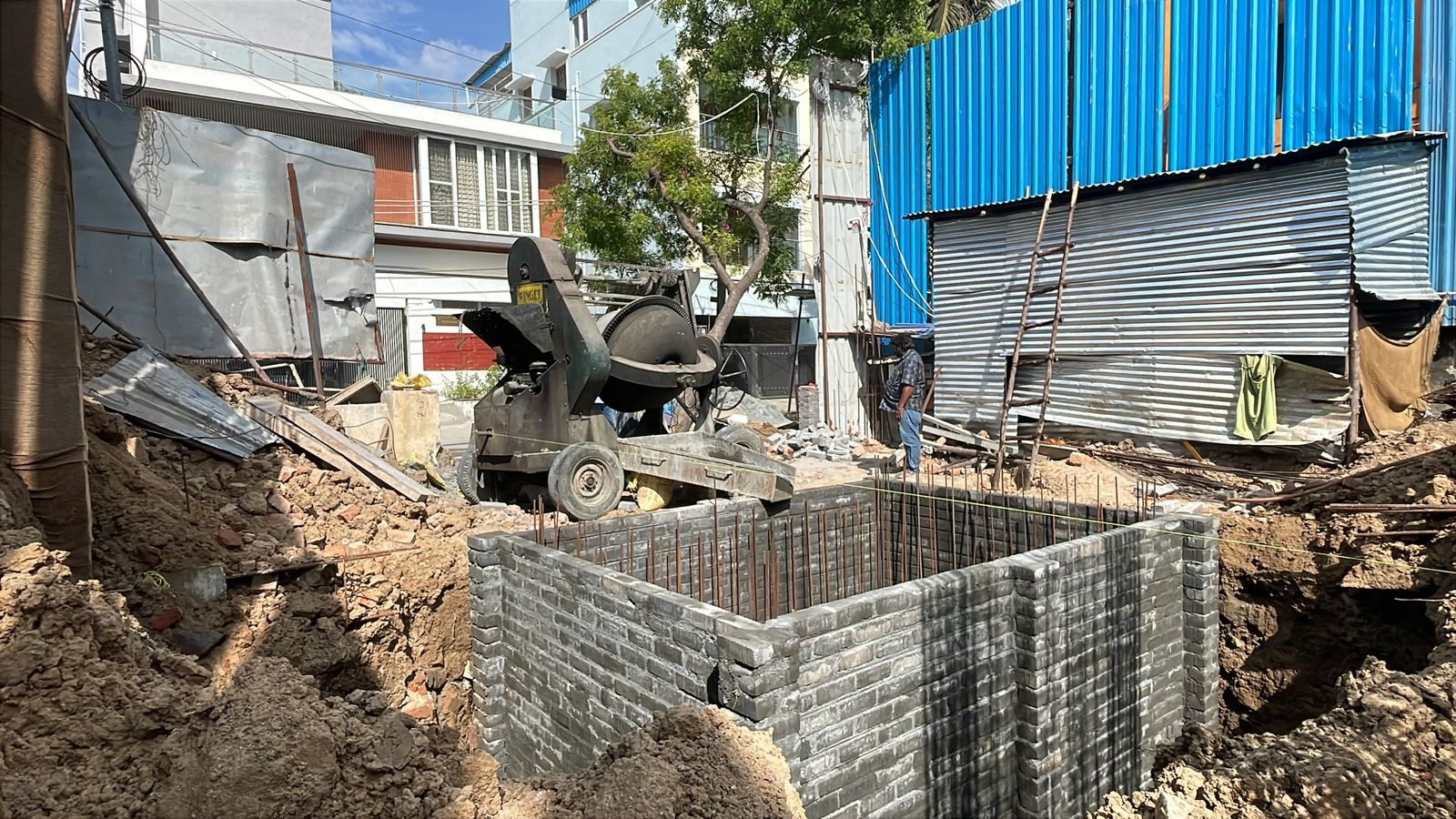

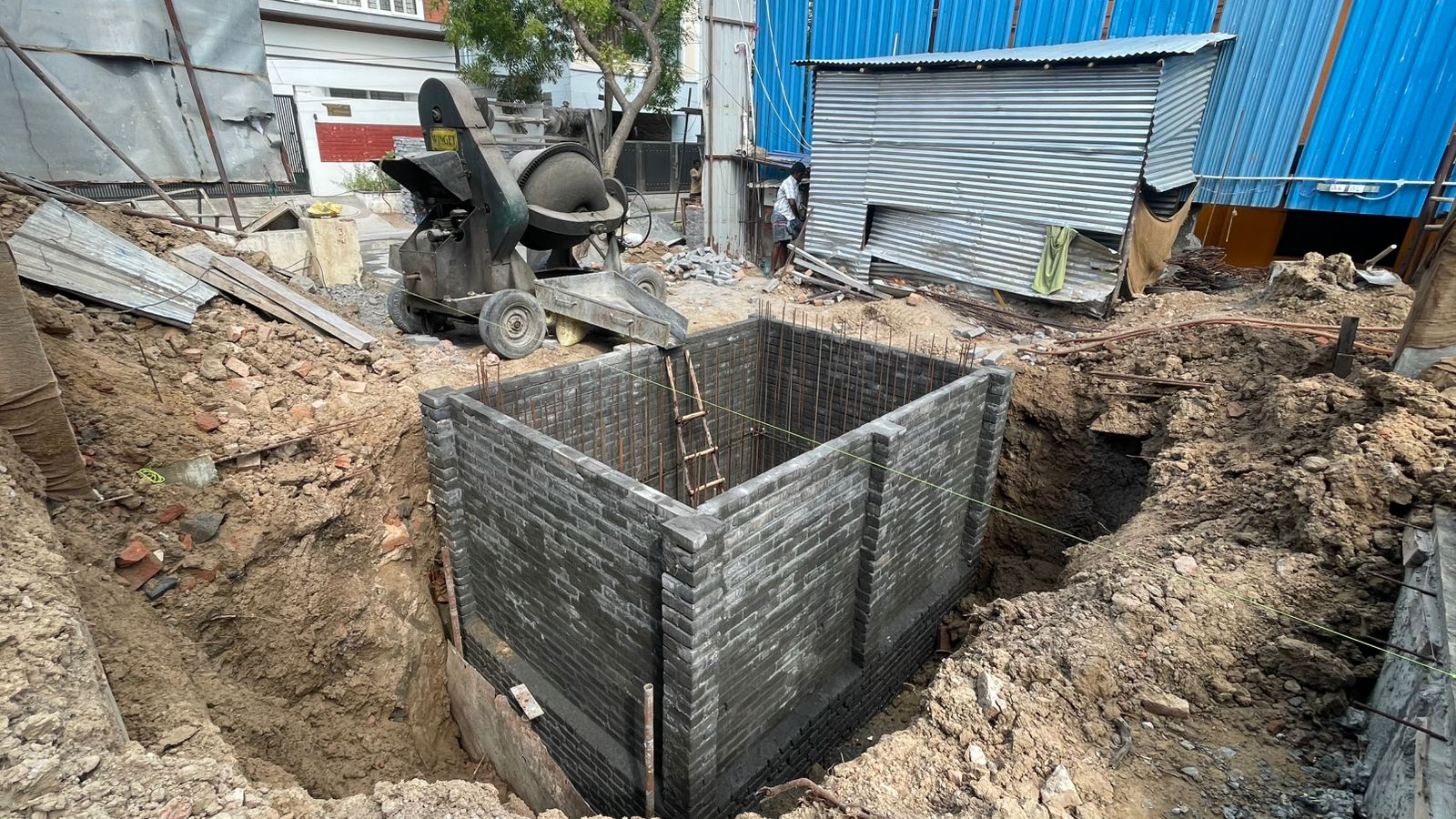

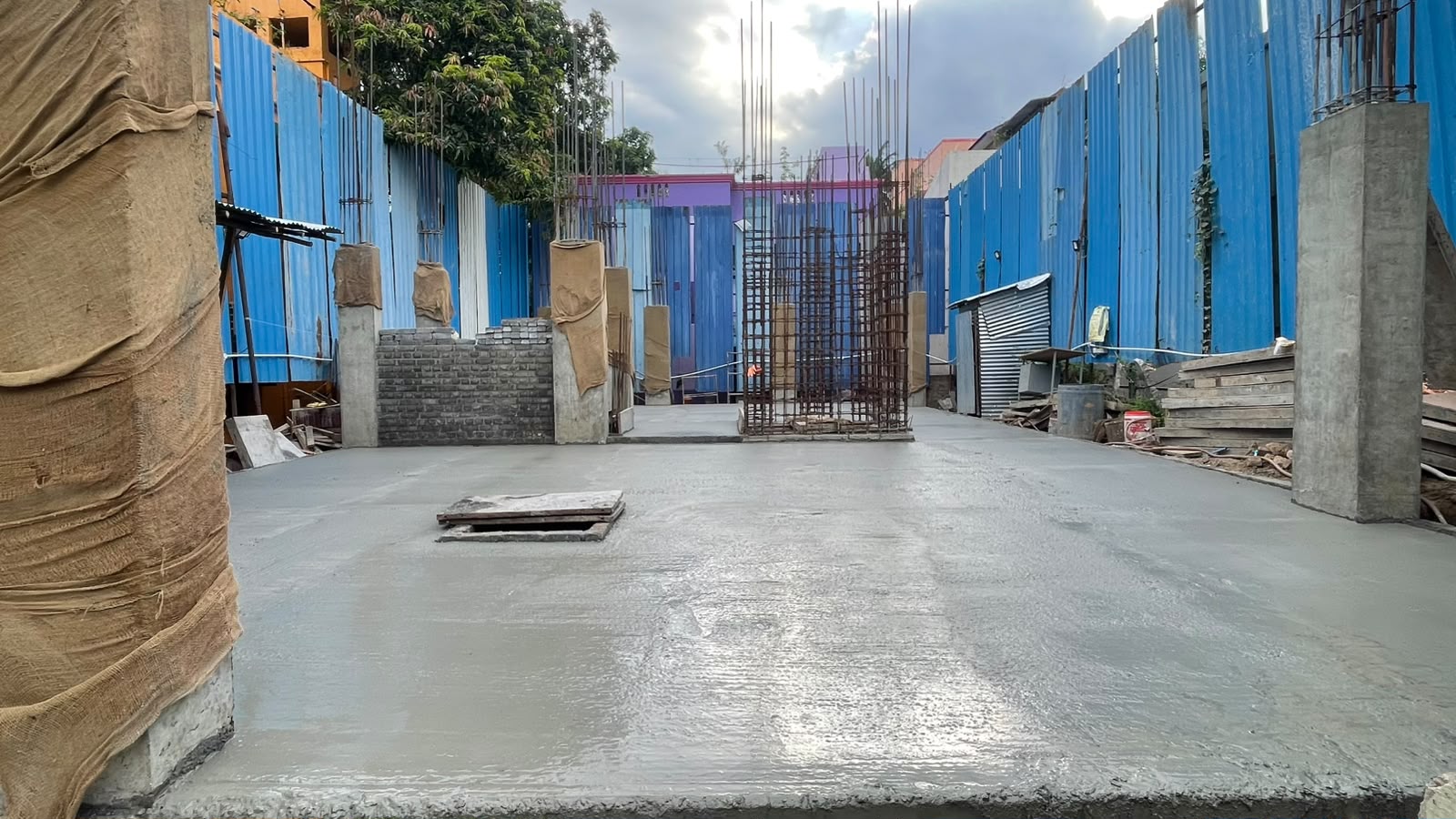

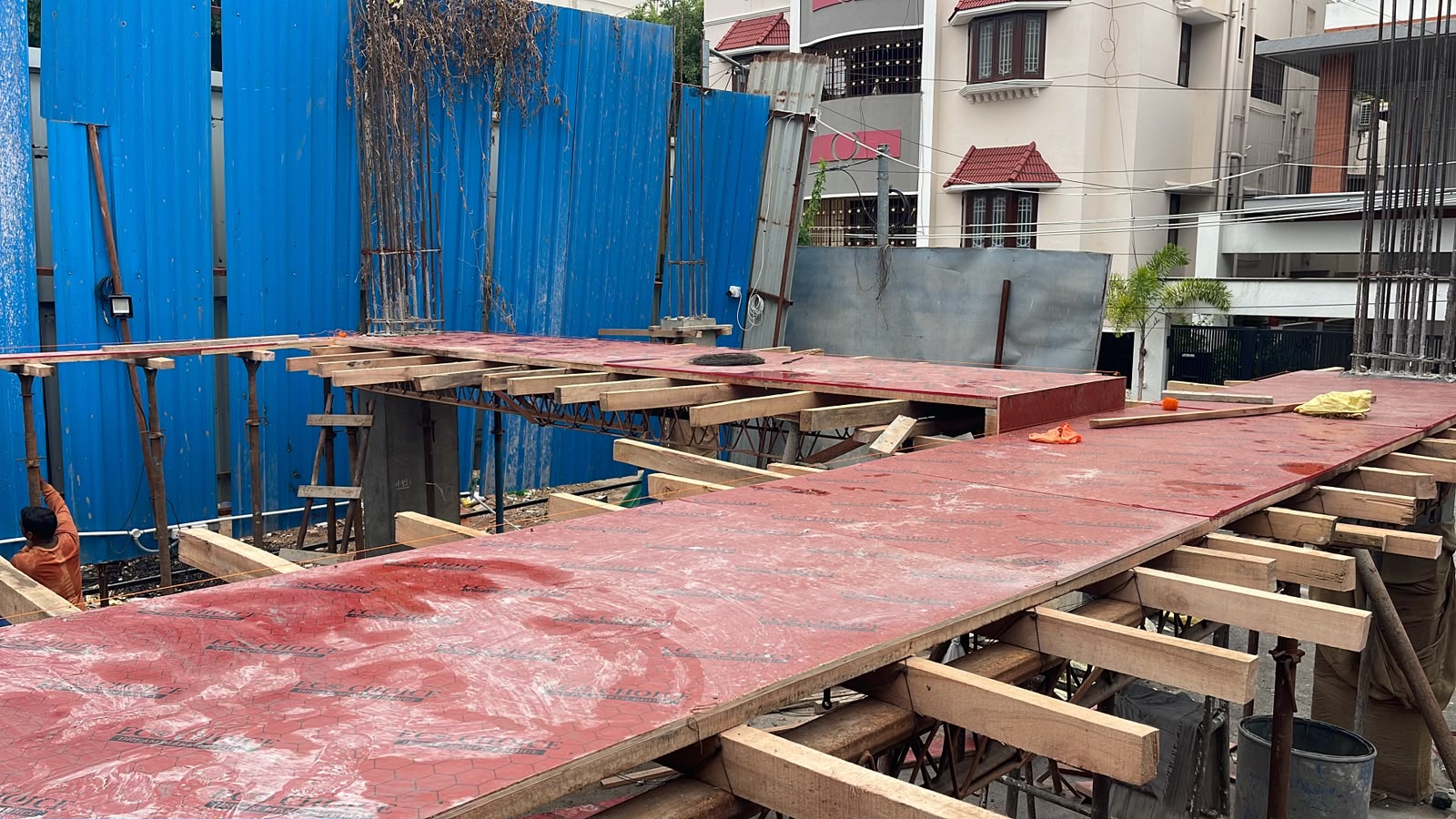

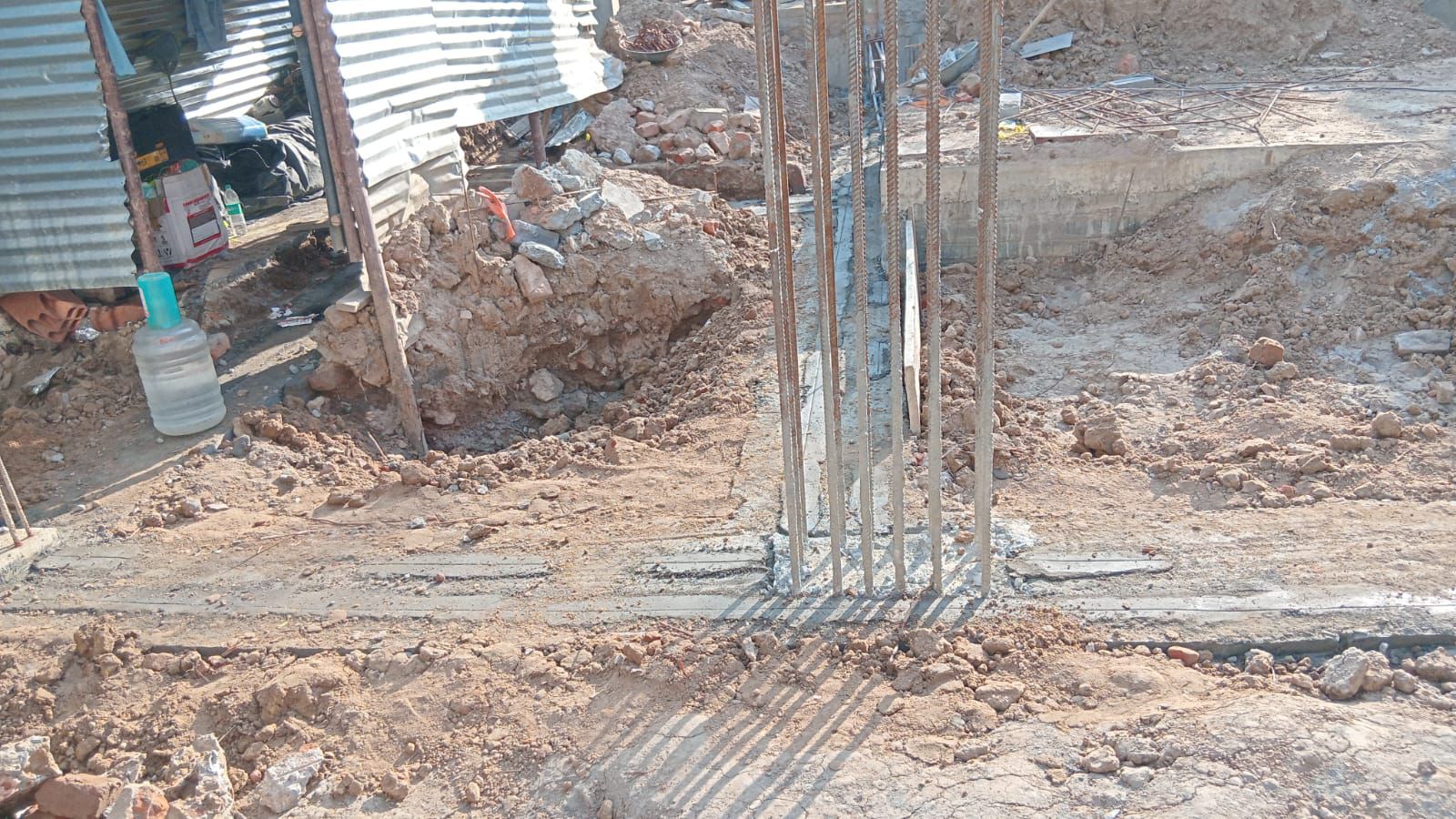

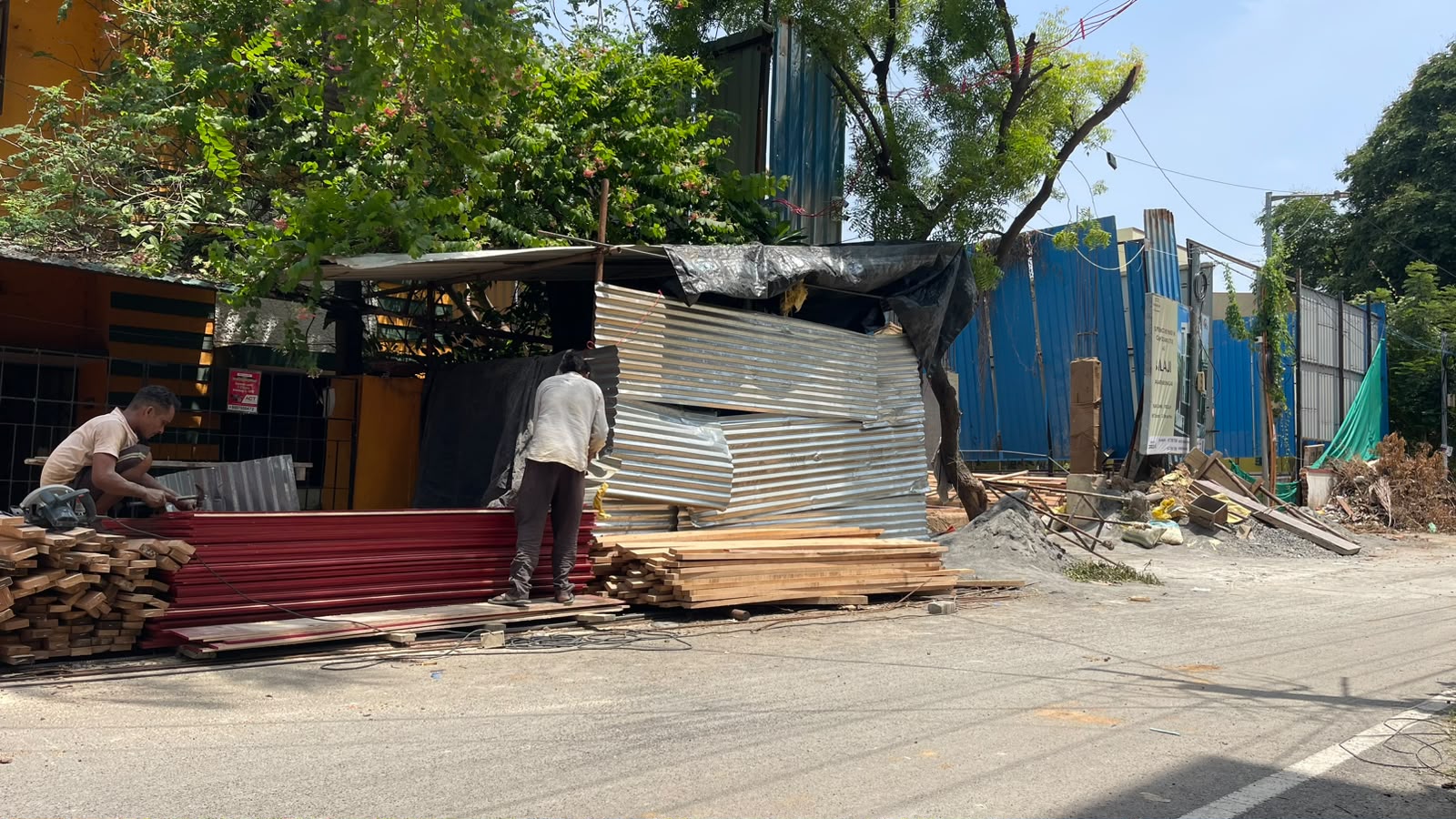

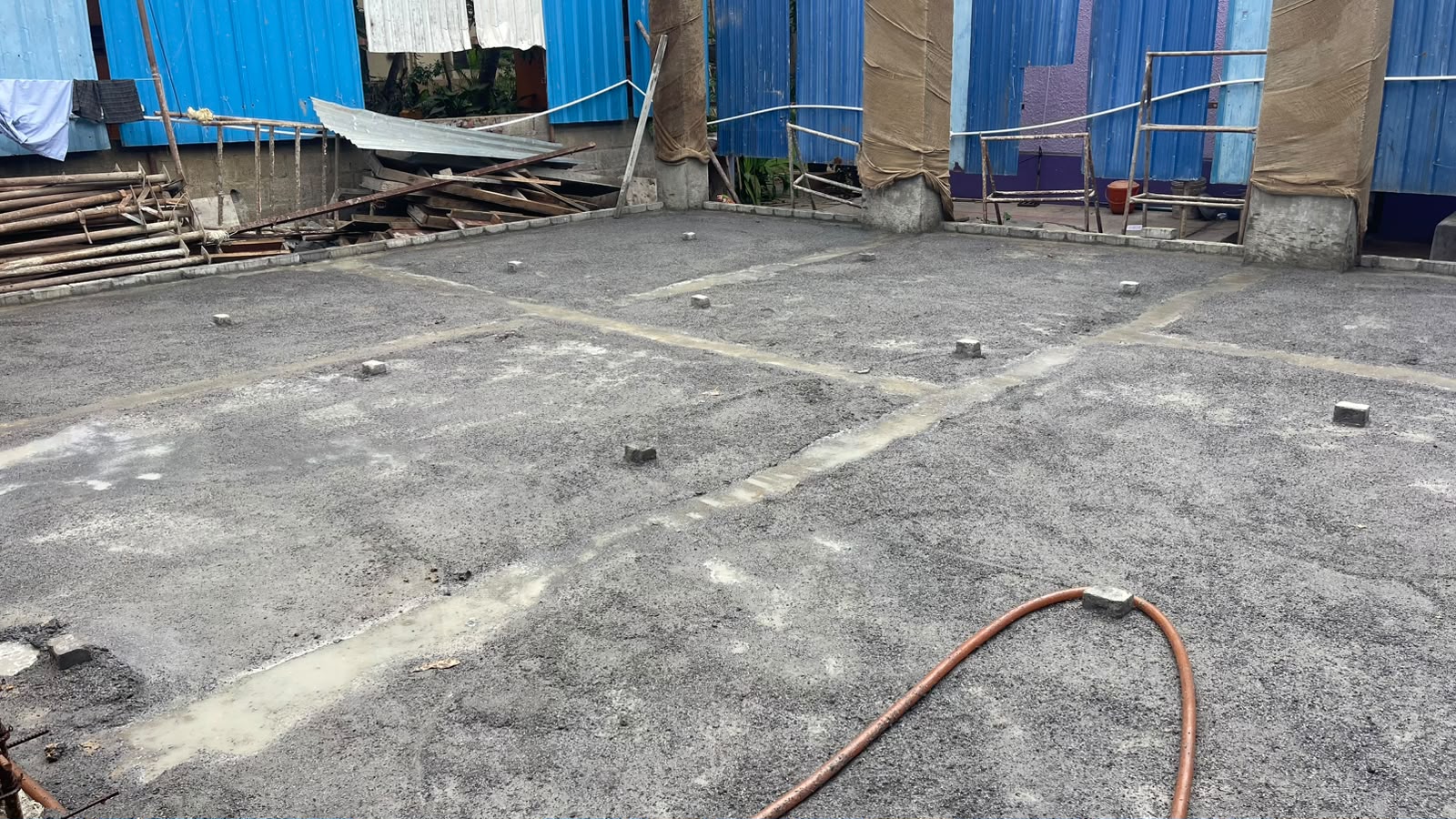

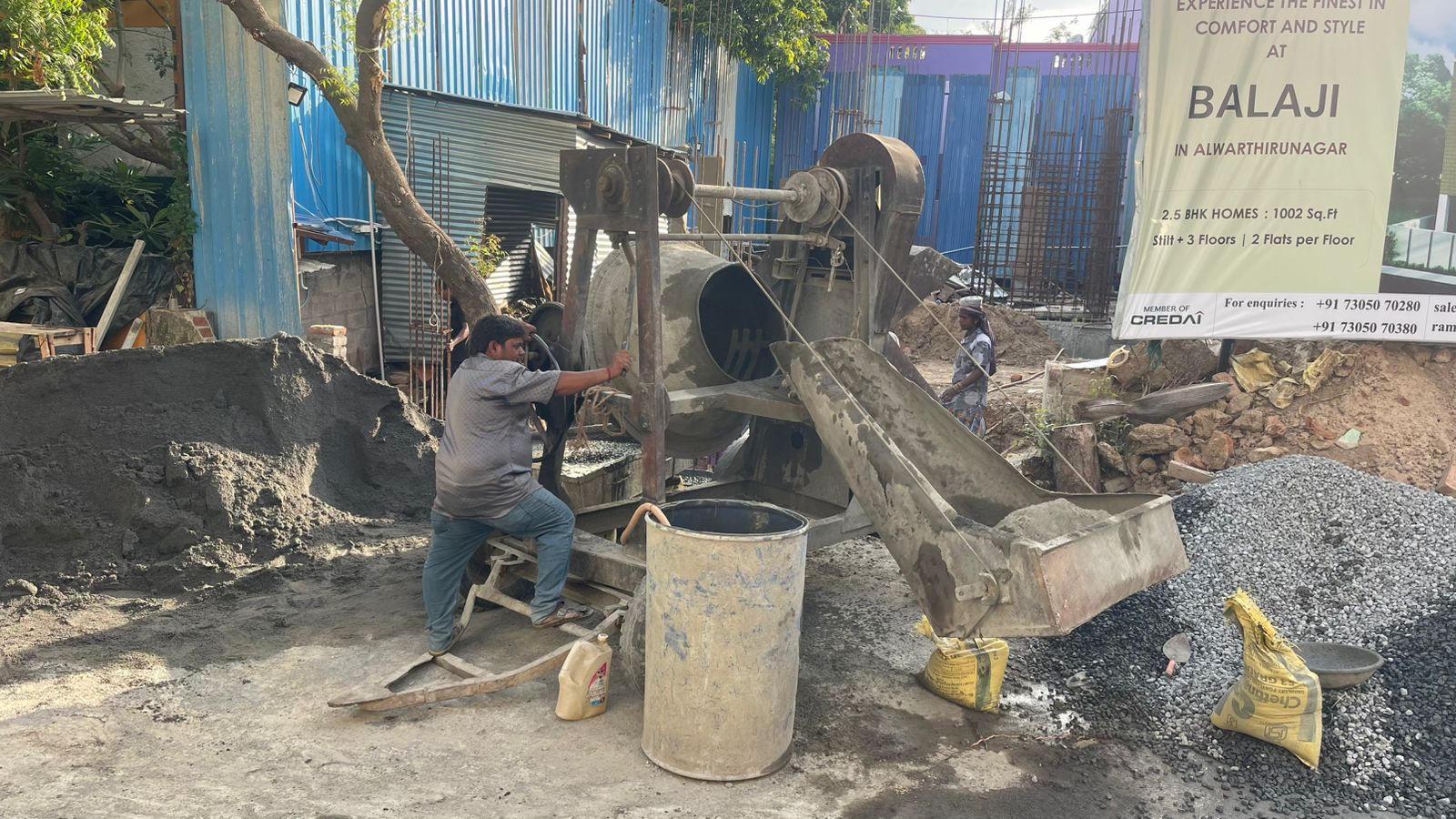

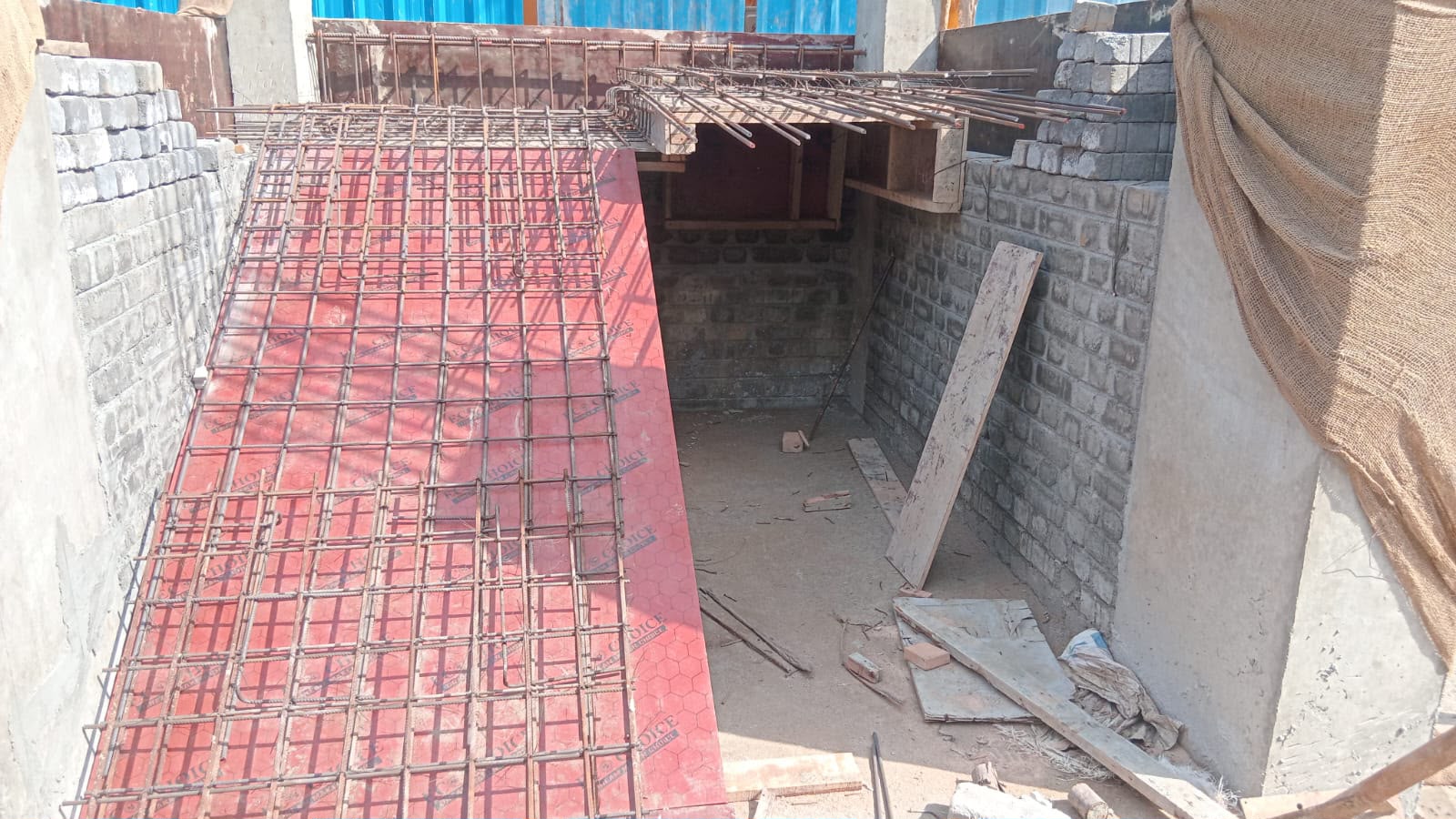

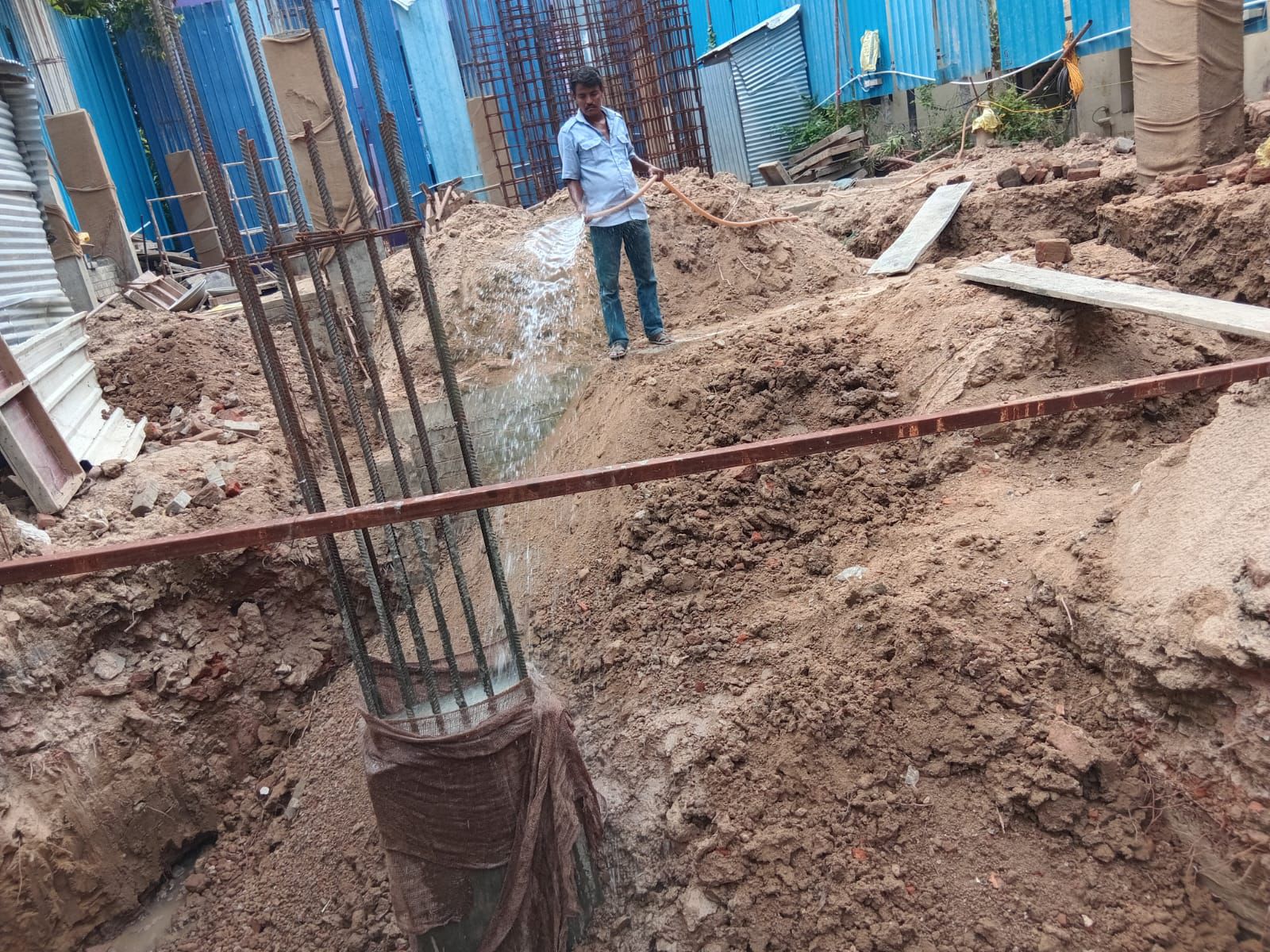

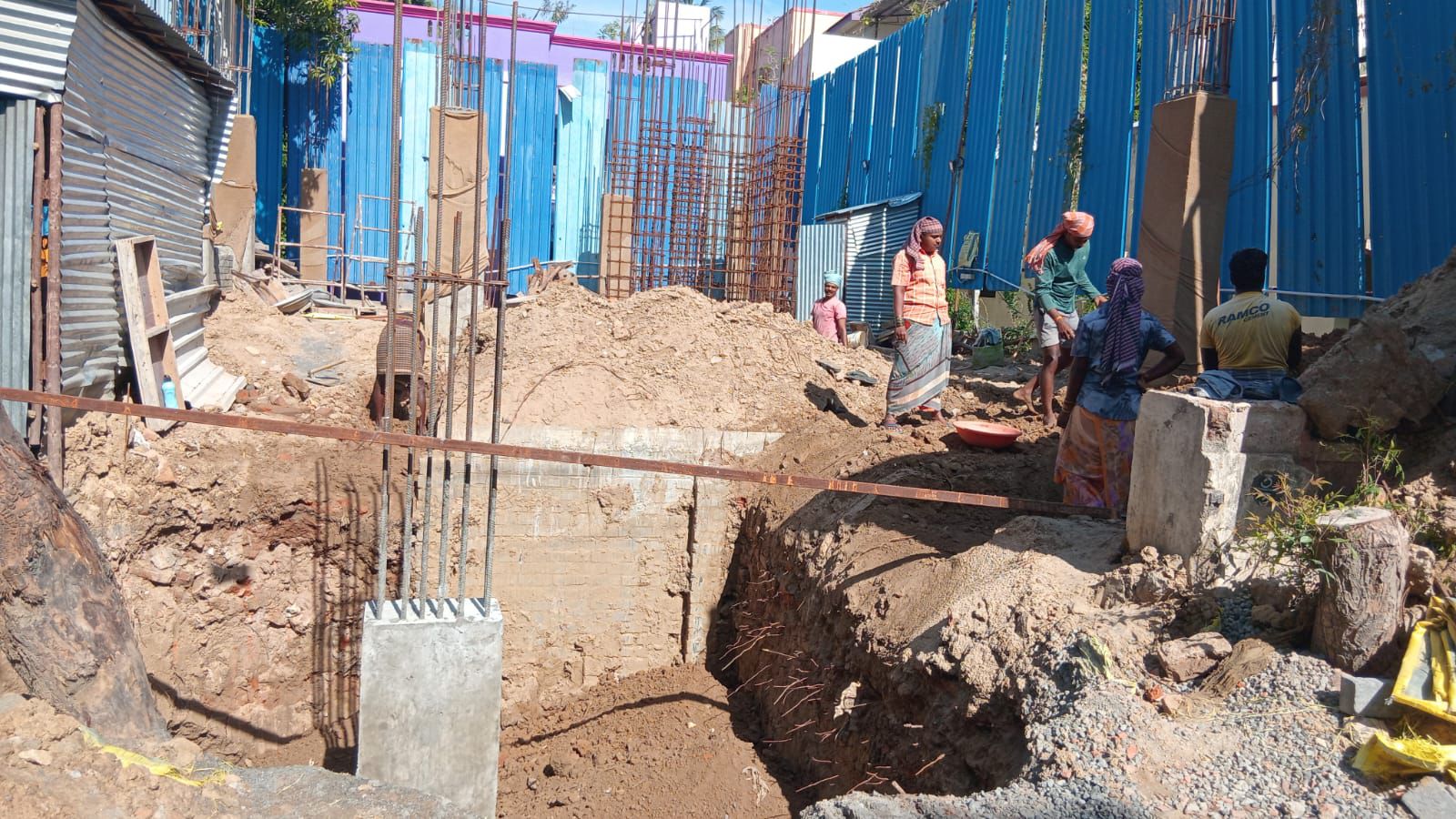

Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image
  • Footingconcrete work is completed.
  • Stub column concrete work is completed.
  • Plinth beam PCC work is completed.
  • Plinth beam concrete work is completed.
  • Stilt floor column concrete work is in progress.(10/13 completed)
  • Basement brick work is in progress.(80% completed)
  • Basement PCC work is in progress.
  • Sump work is completed.

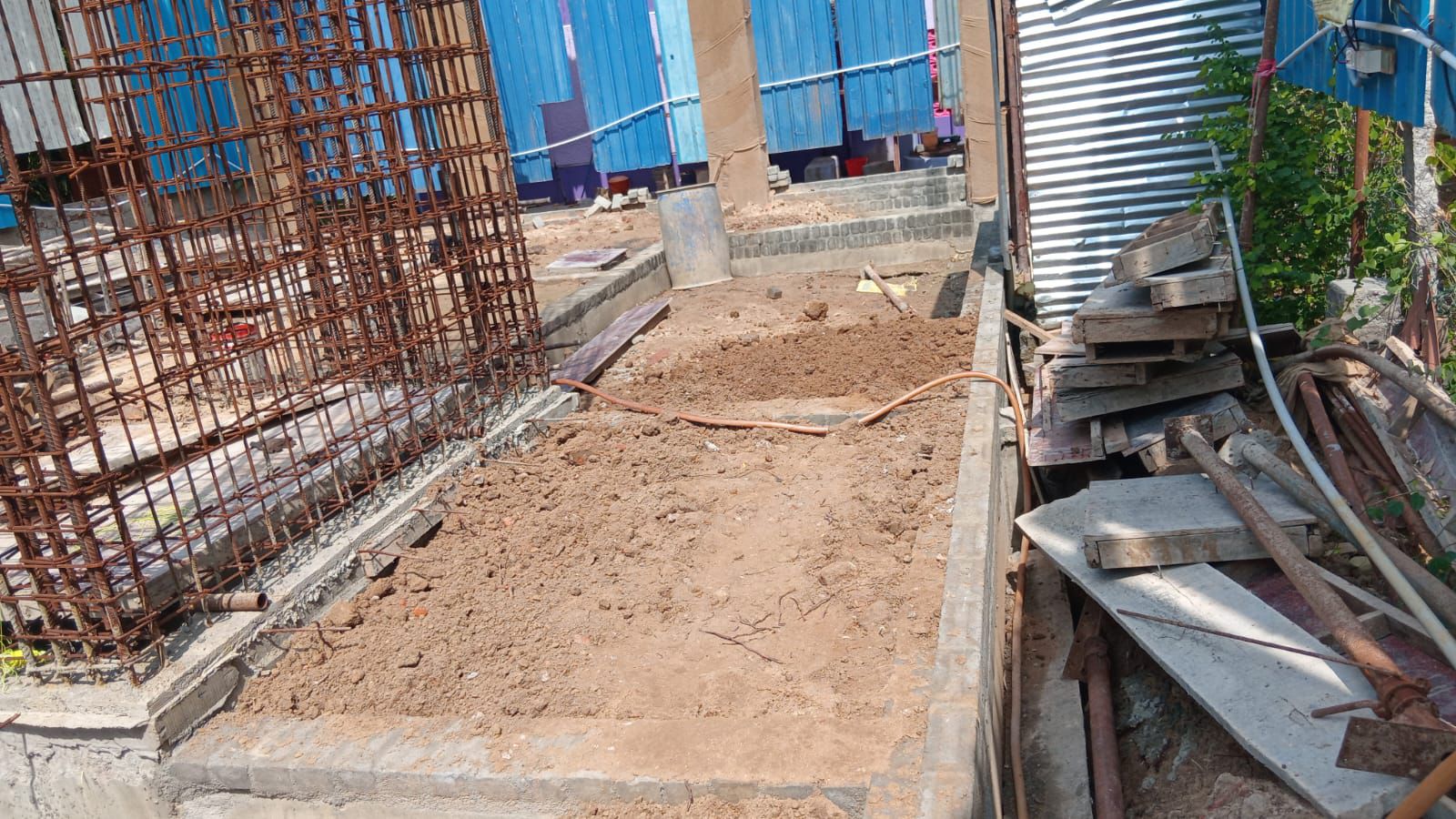

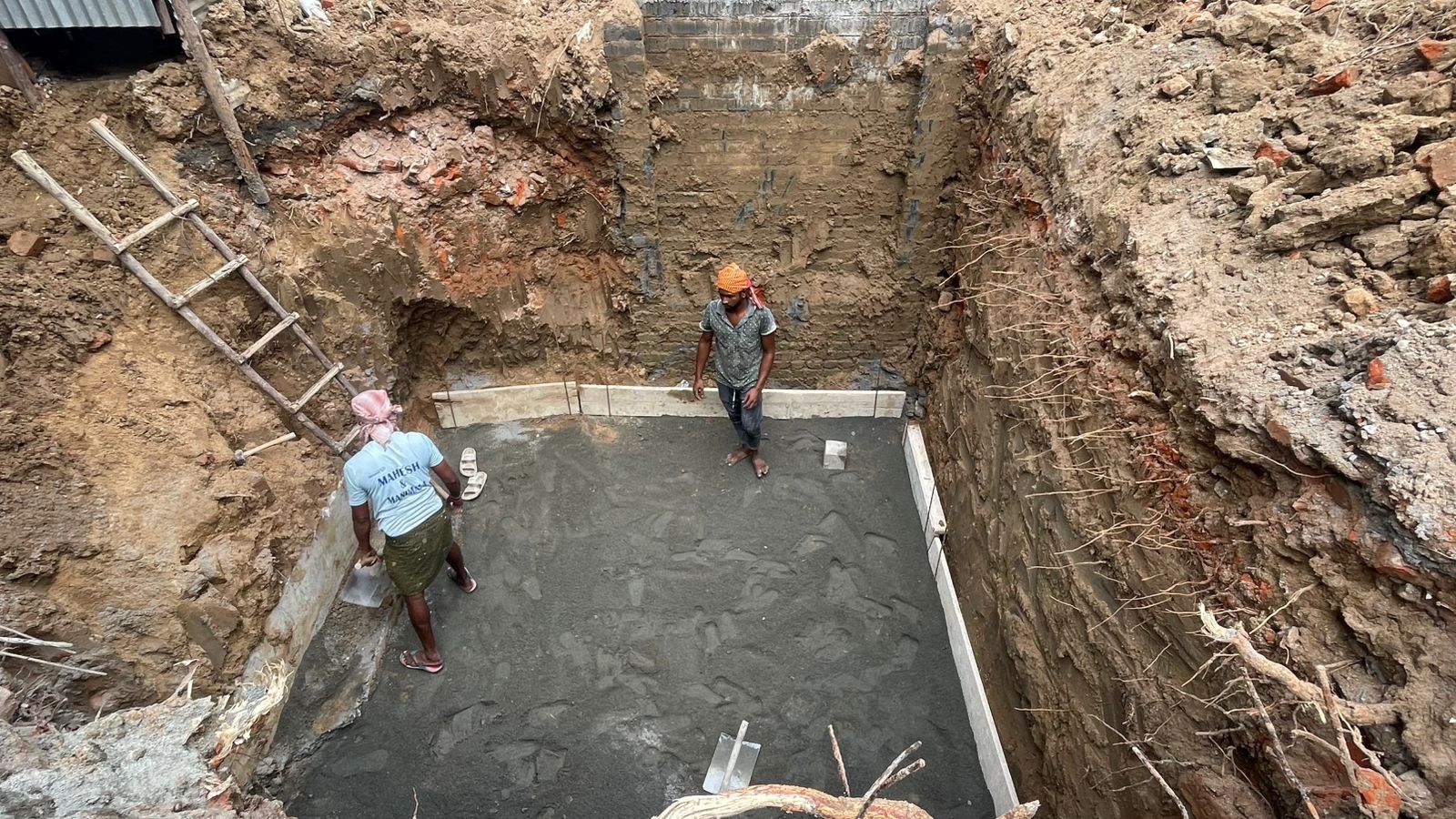

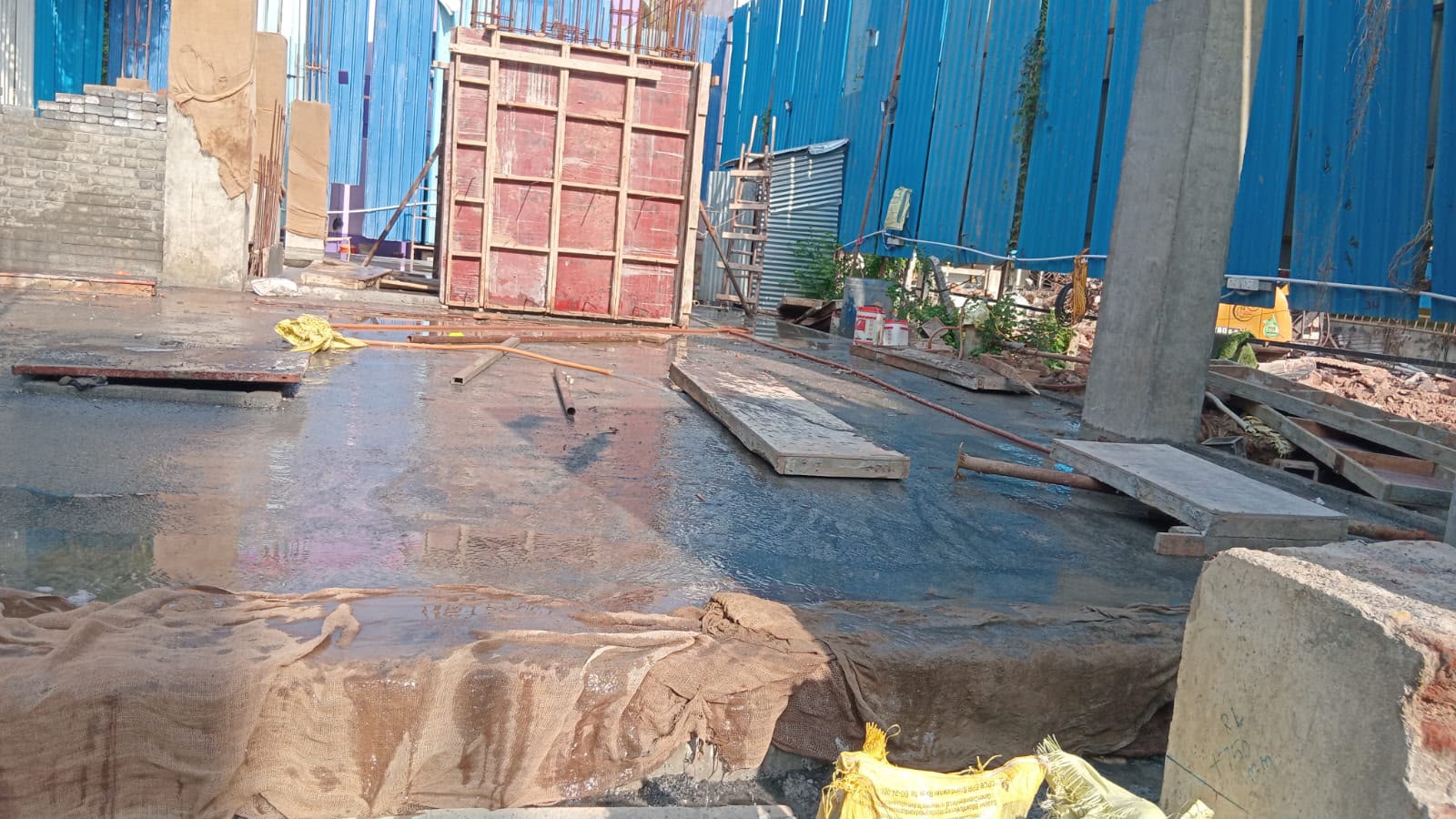

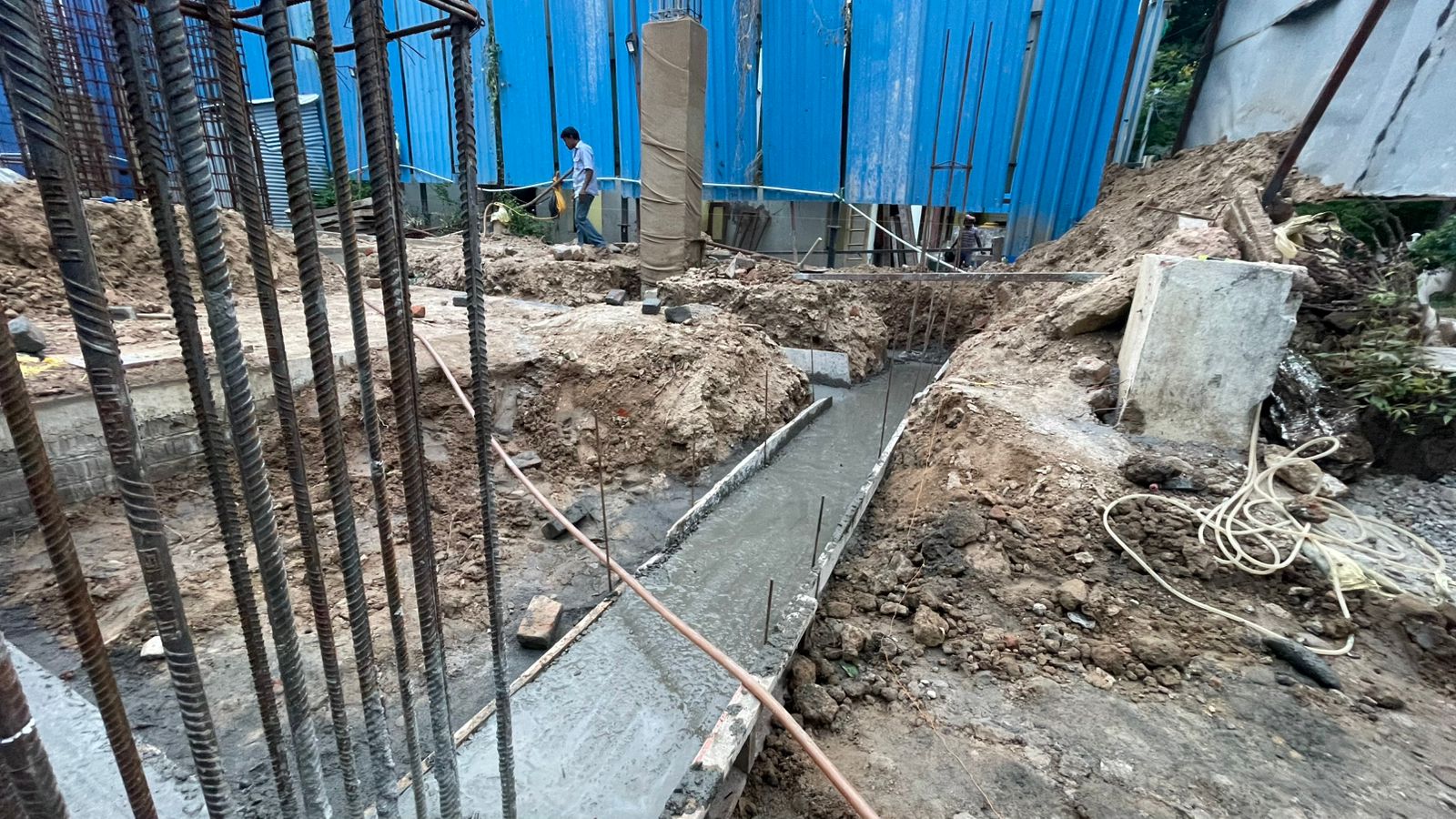

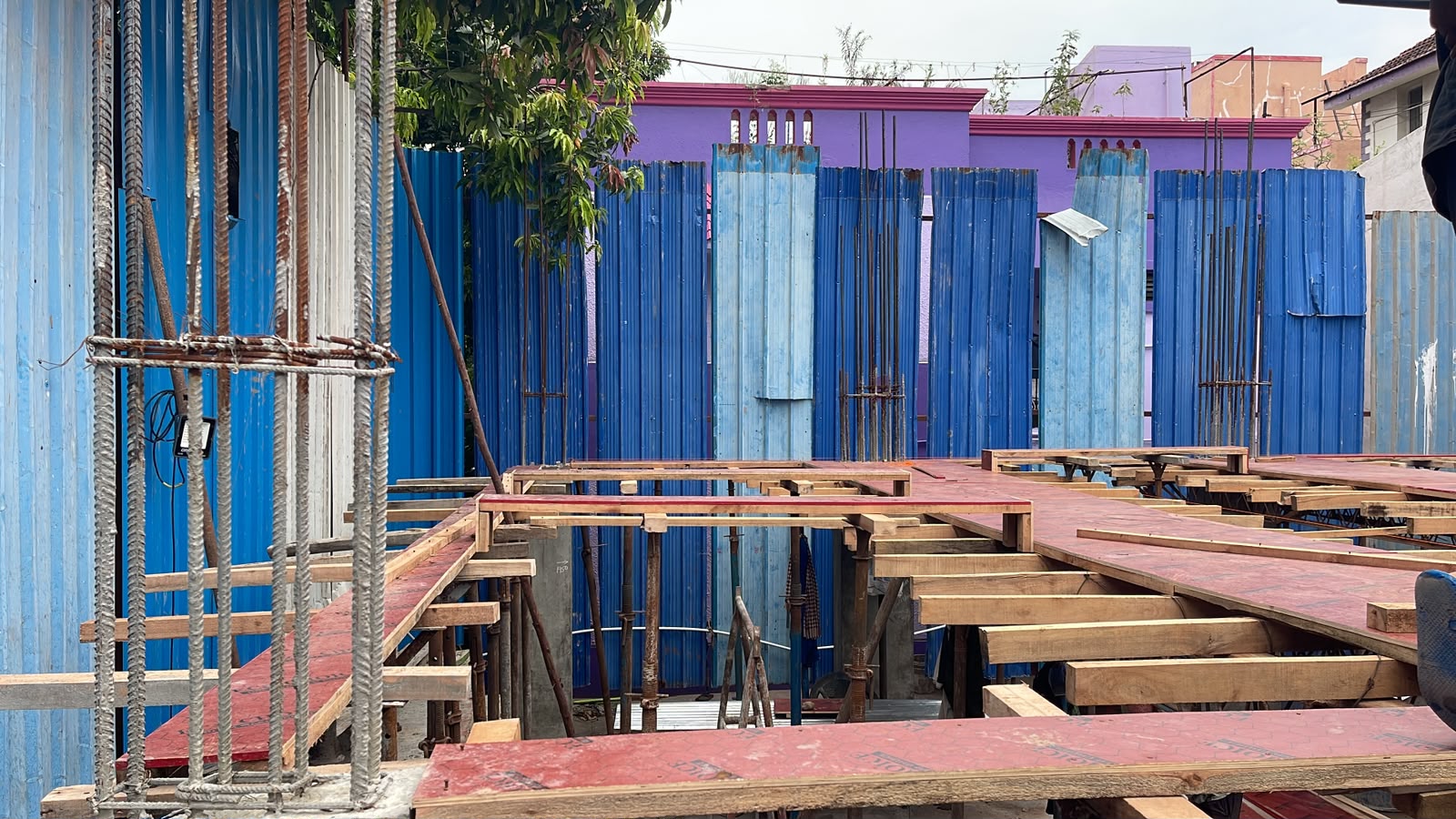

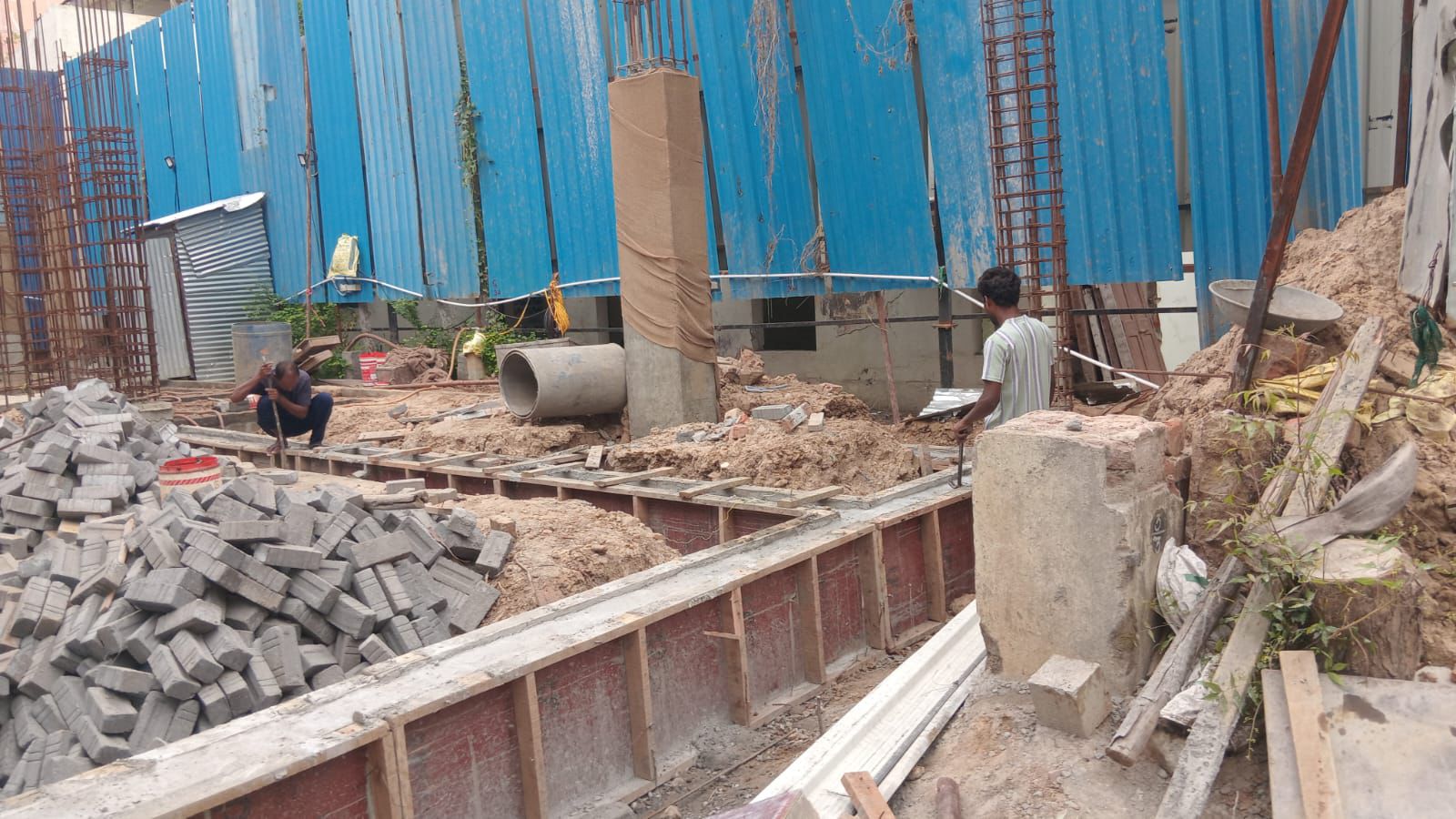

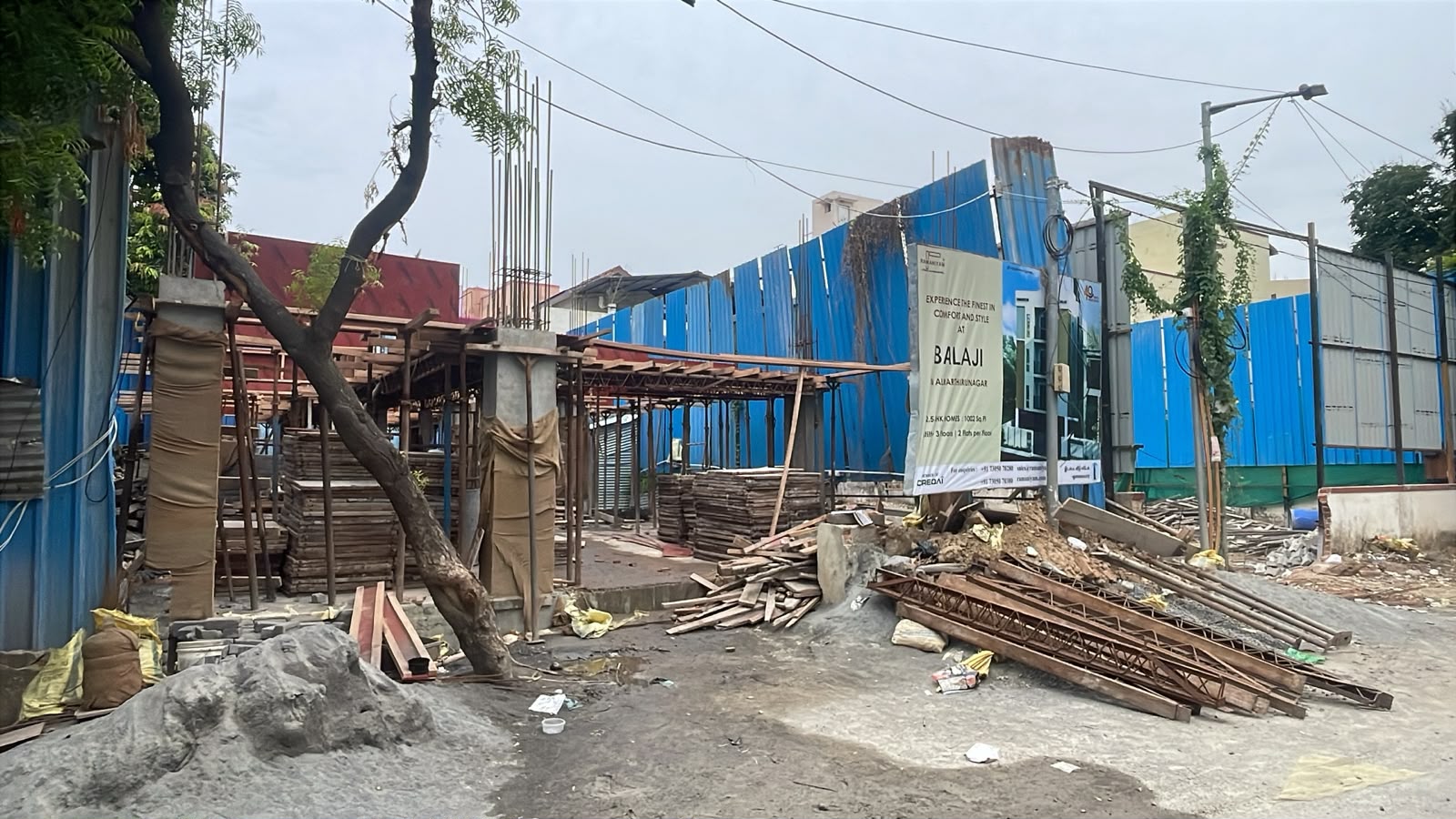

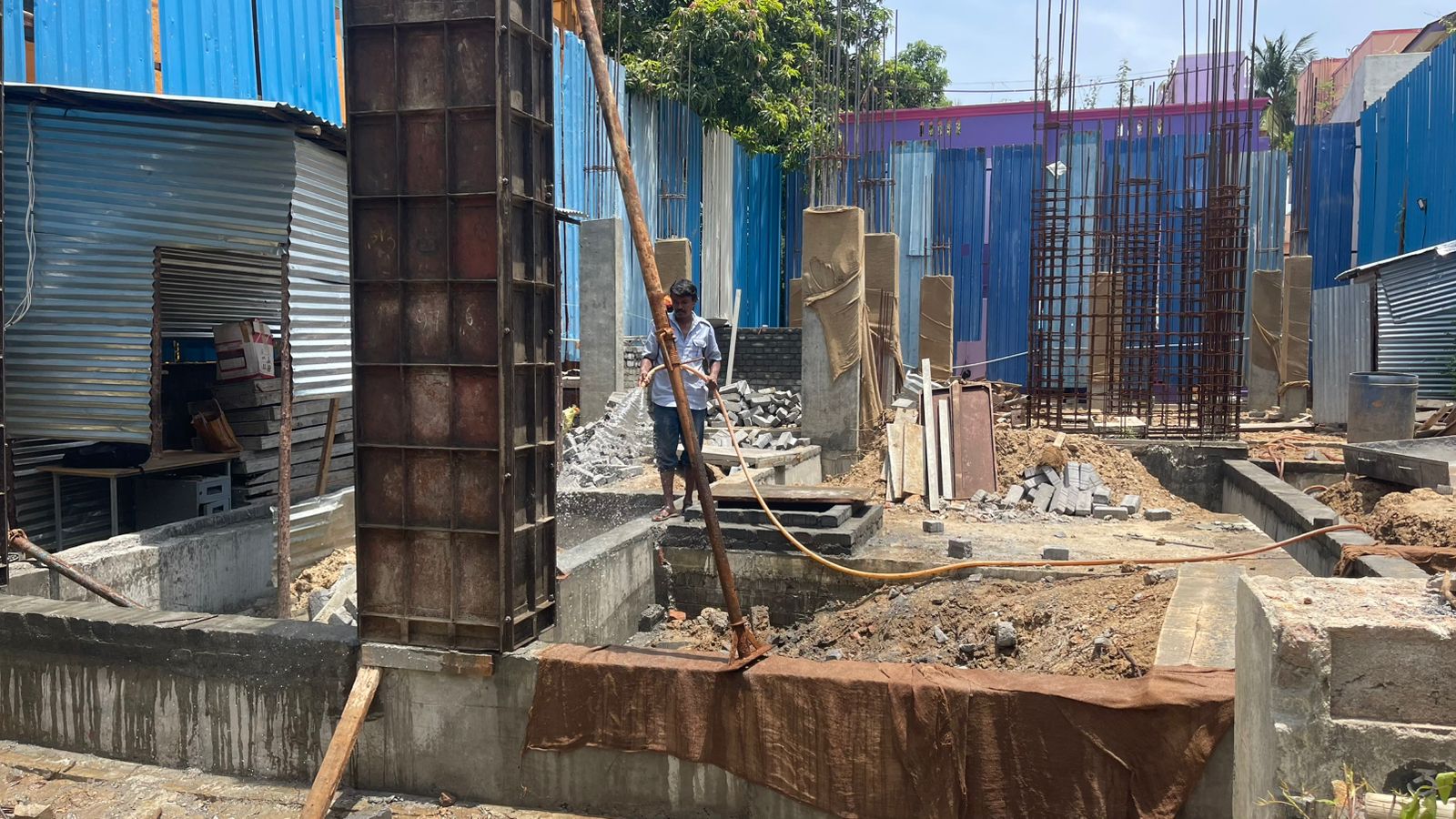

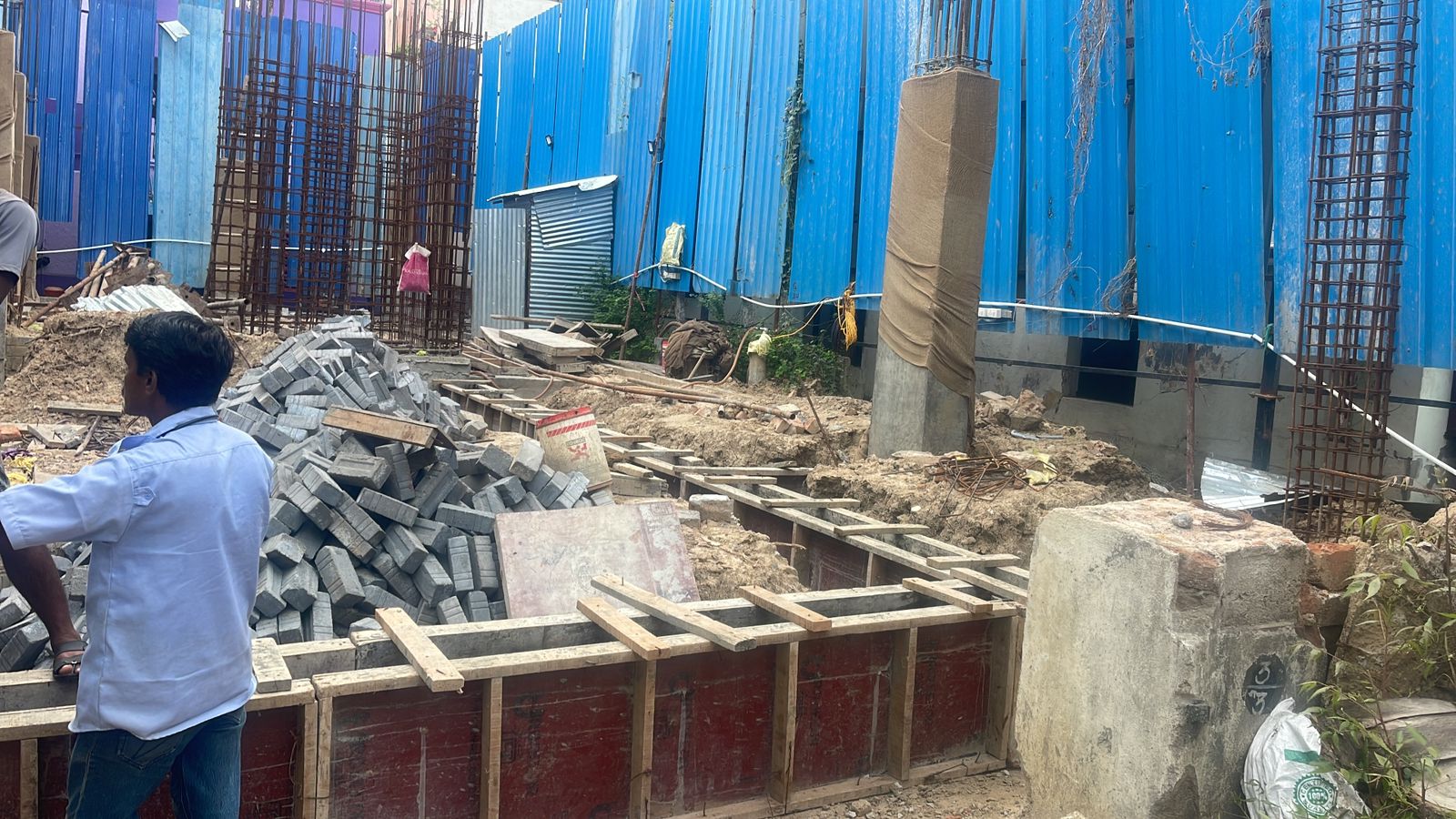

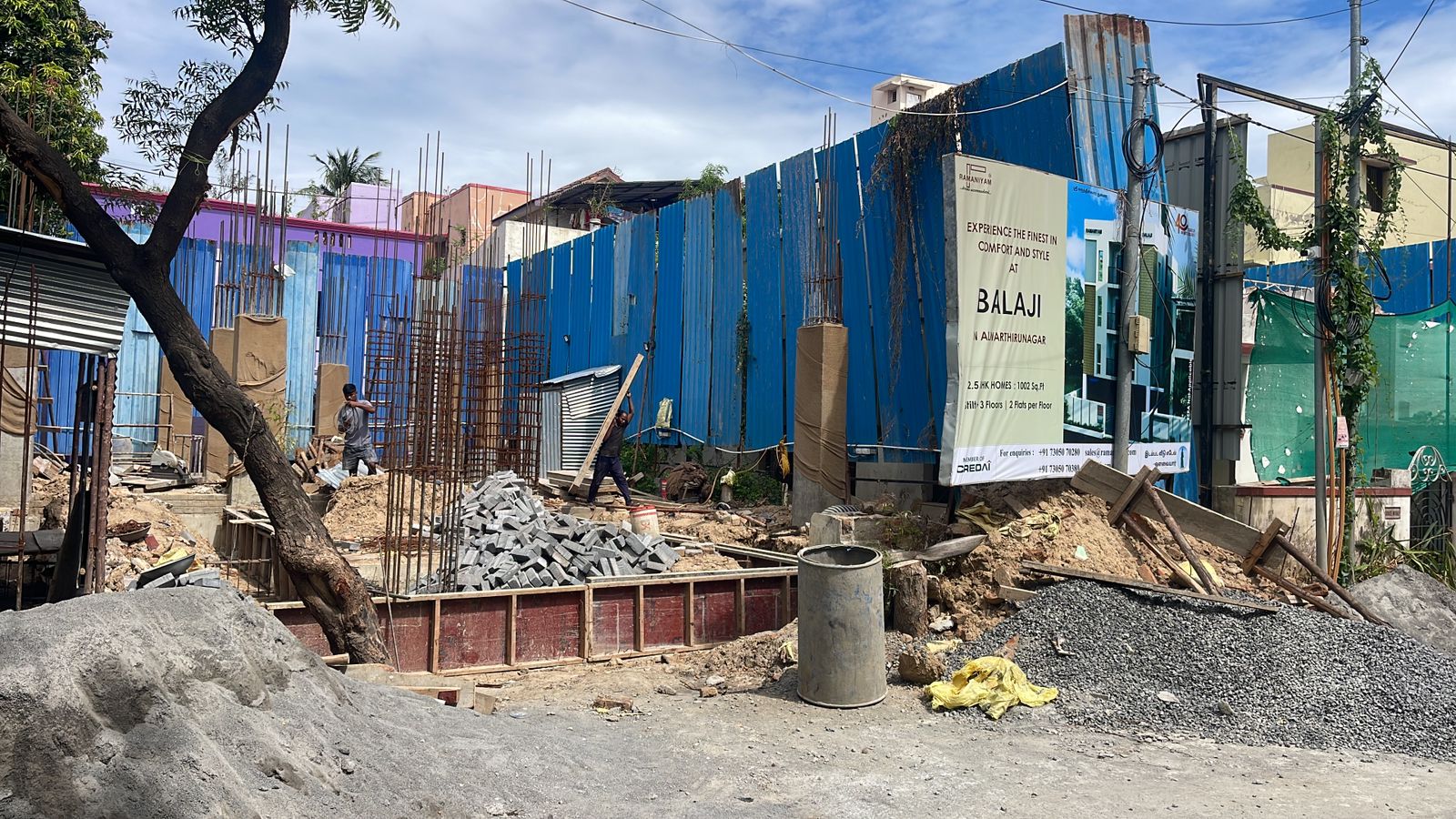

Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image
  • Plinth beam concrete work is completed.
  • Stilt floor column concrete work is completed.
  • Stilt floor roof shuttering and bar bending work is in progress.
  • Basement brick work is completed.
  • Basement PCC work is completed.
  • Sump work is completed.

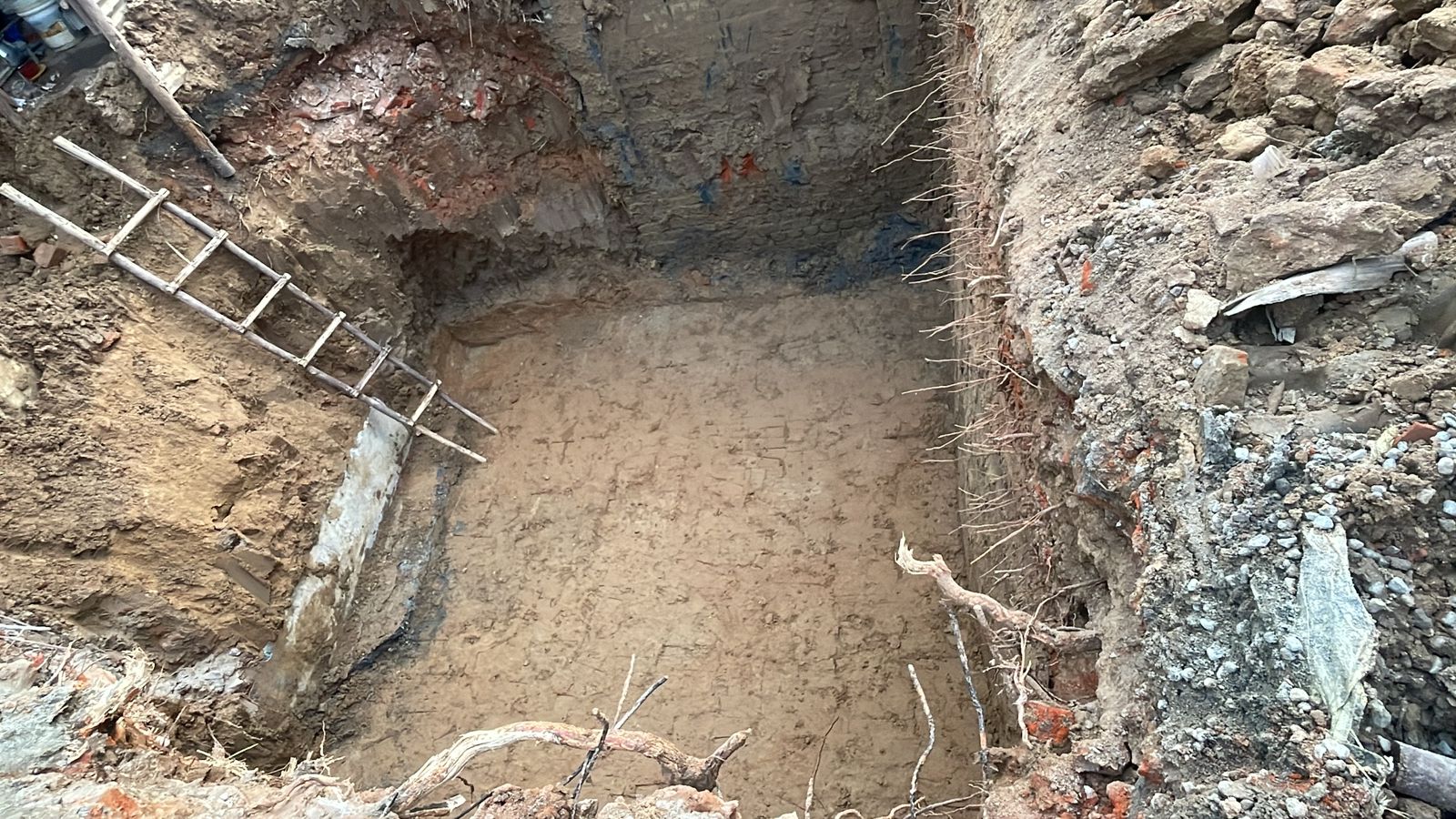

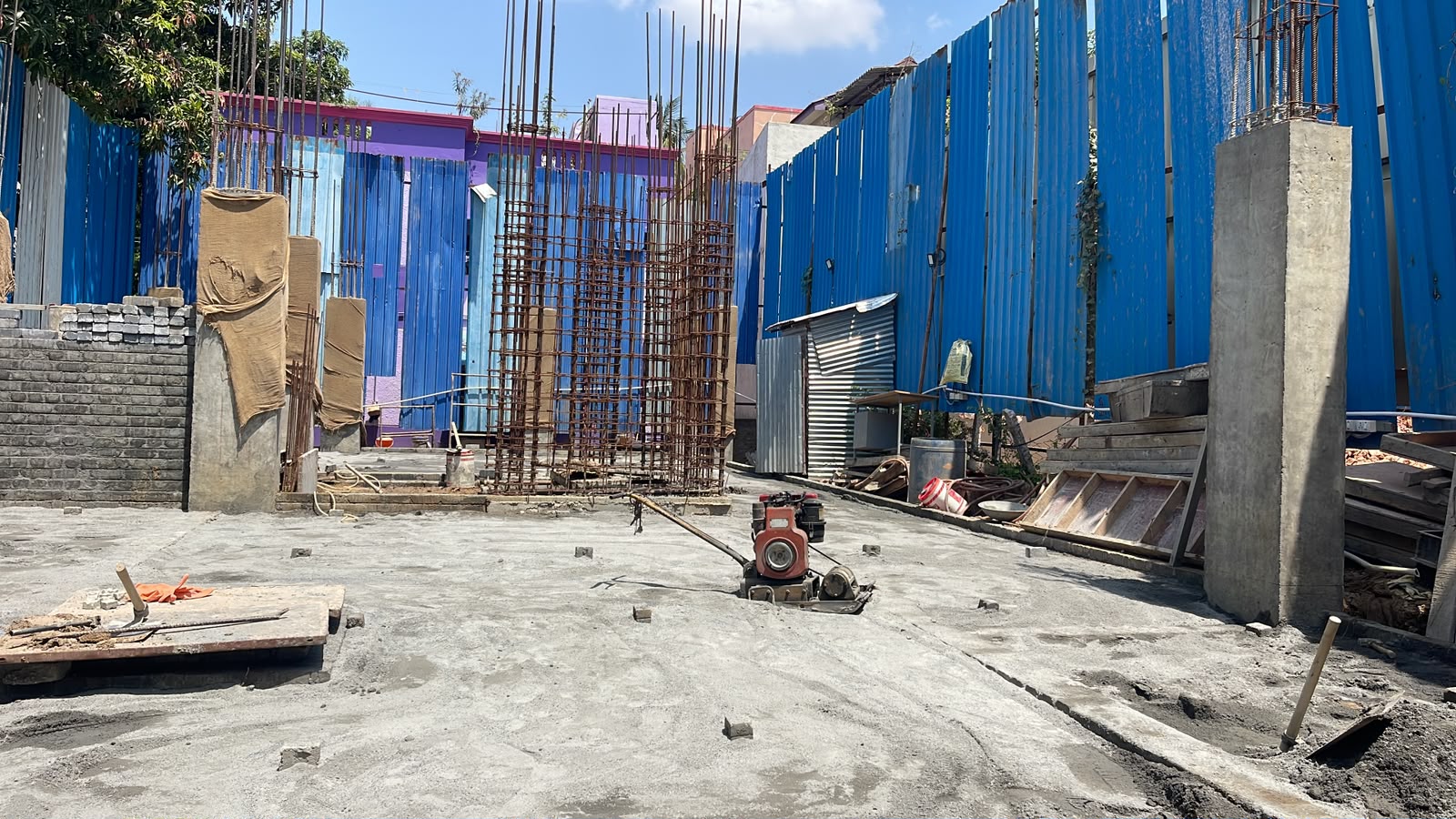

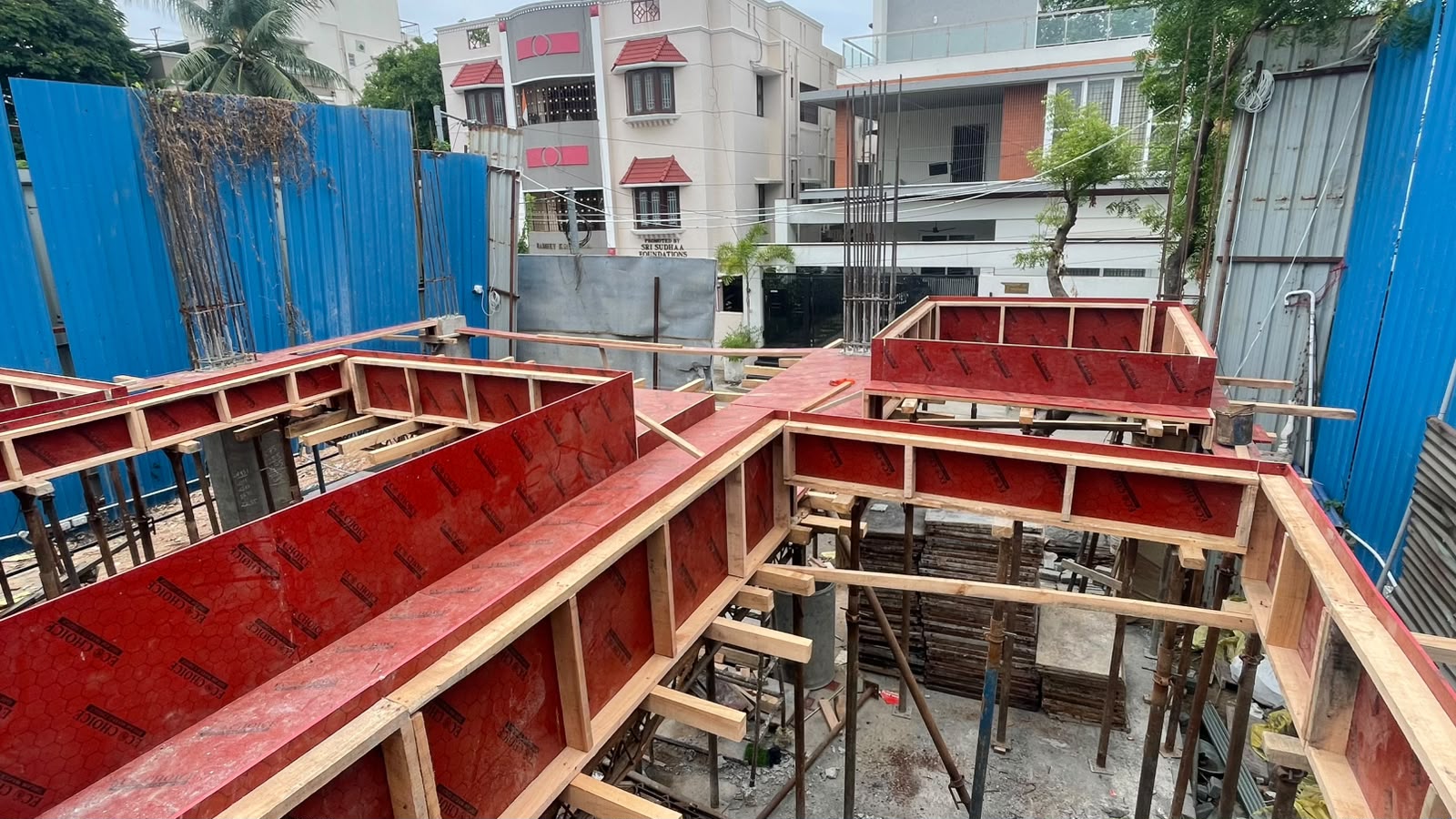

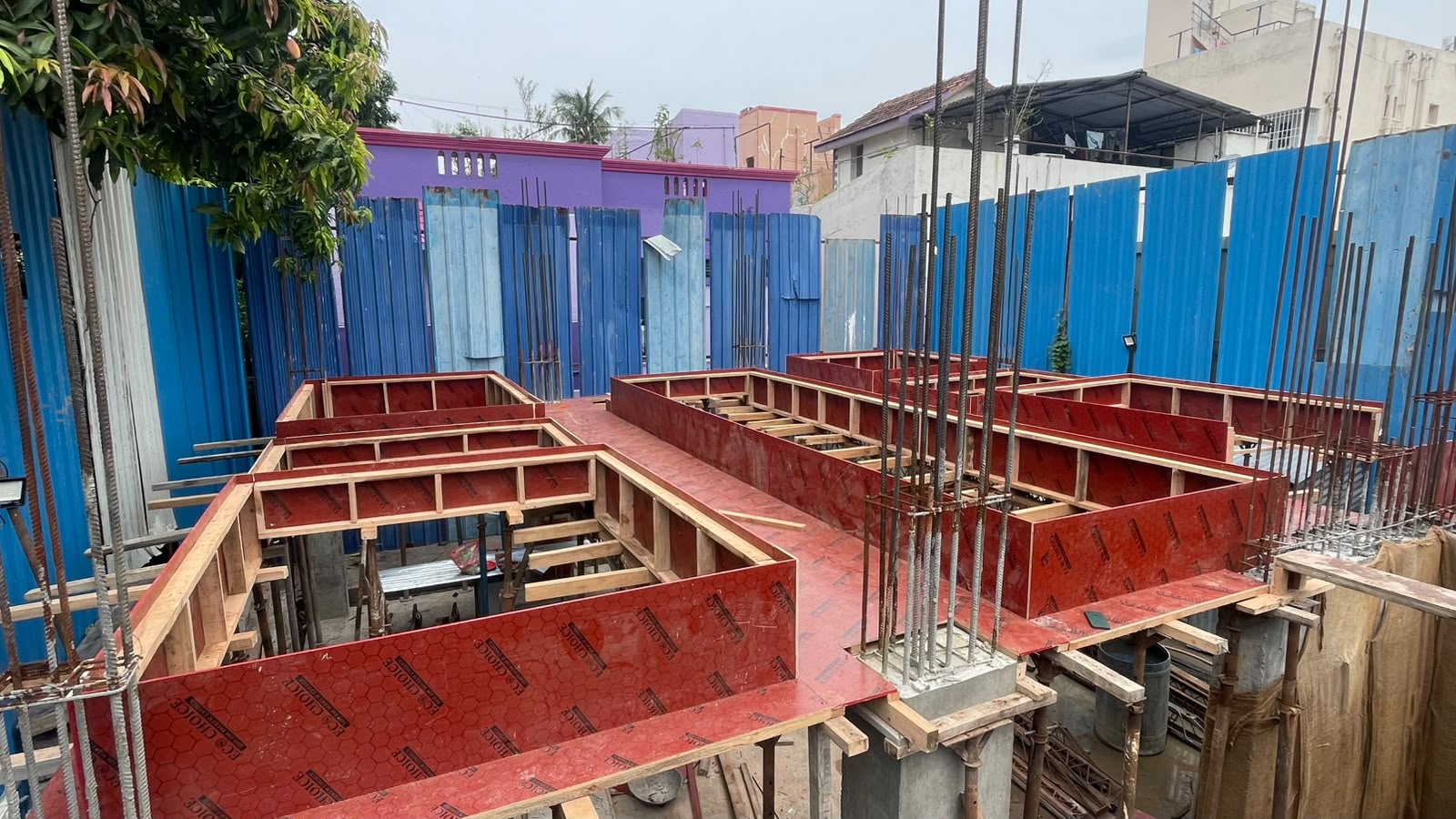

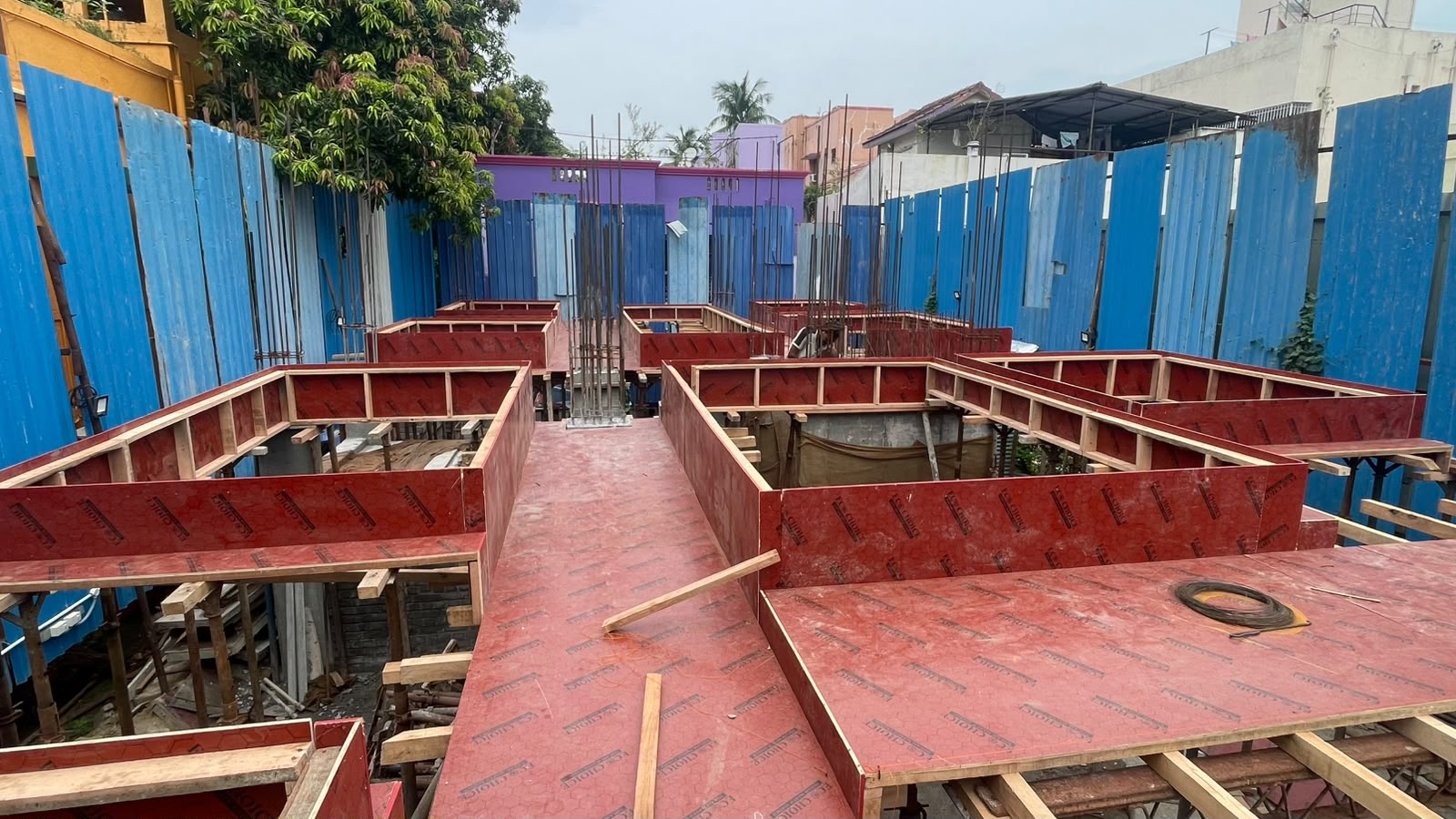

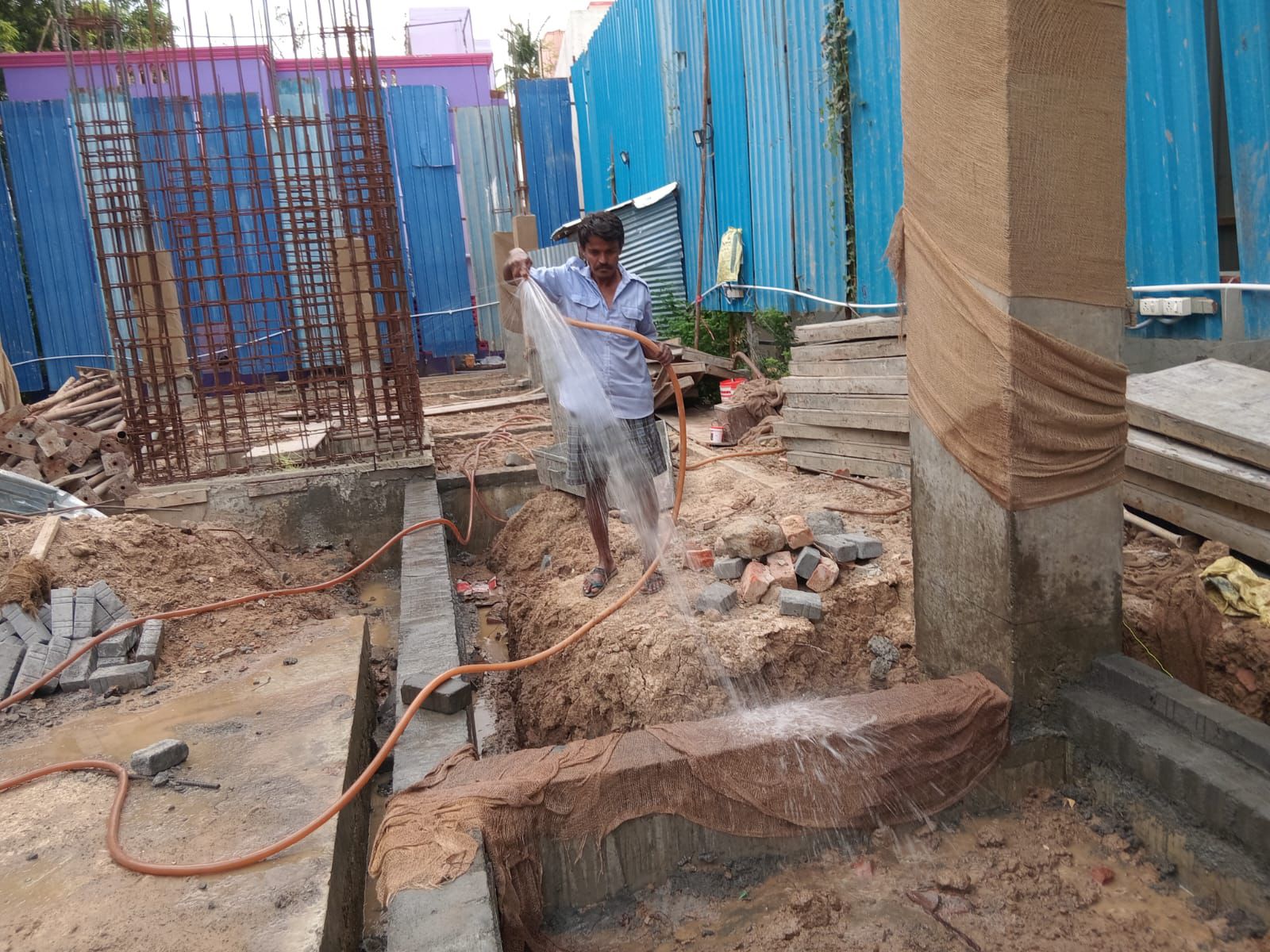

Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image
  • Stilt floor column concrete work is completed.
  • Stilt floor roof shuttering work is in progress.
  • Sump work is completed.

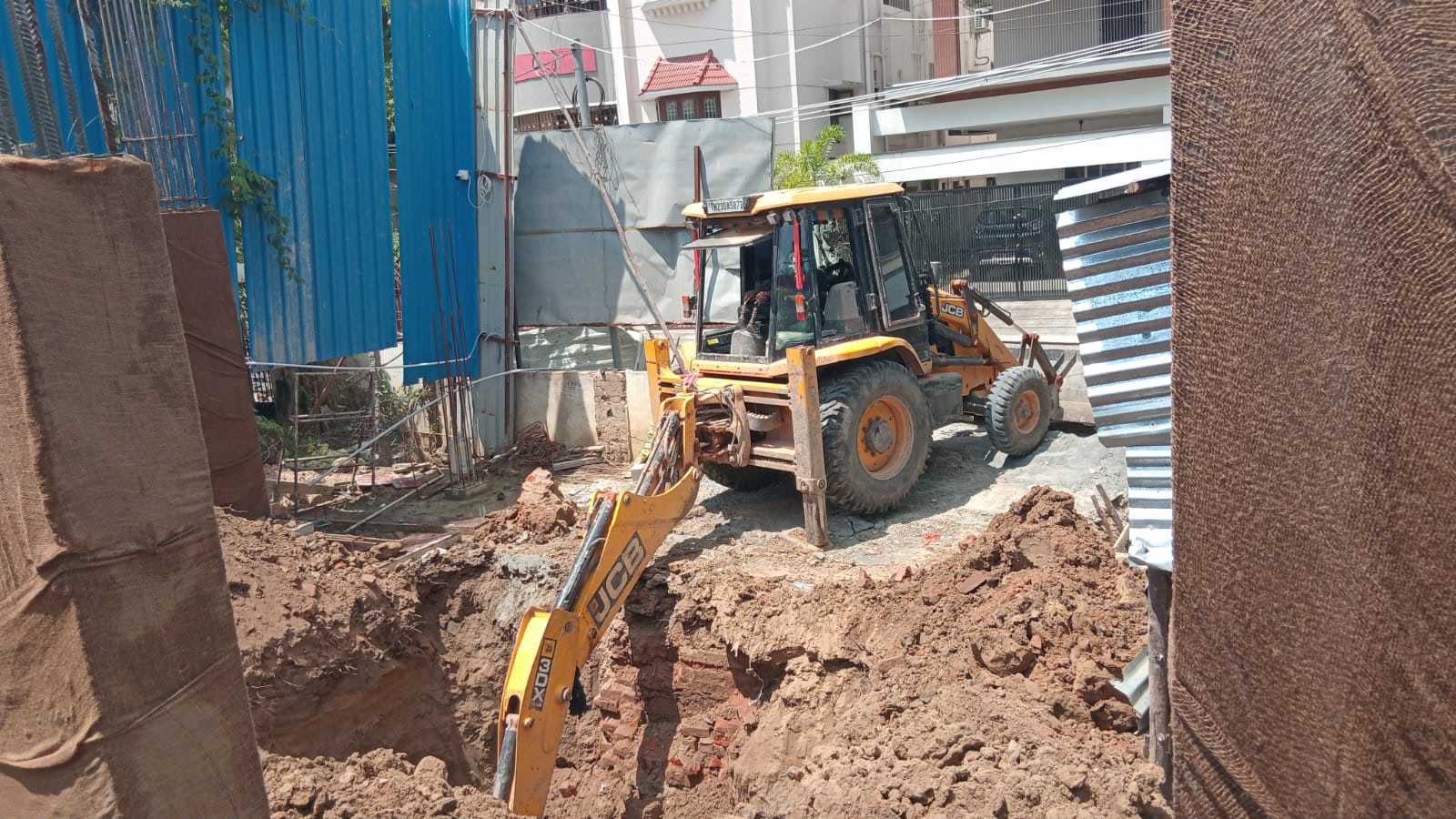

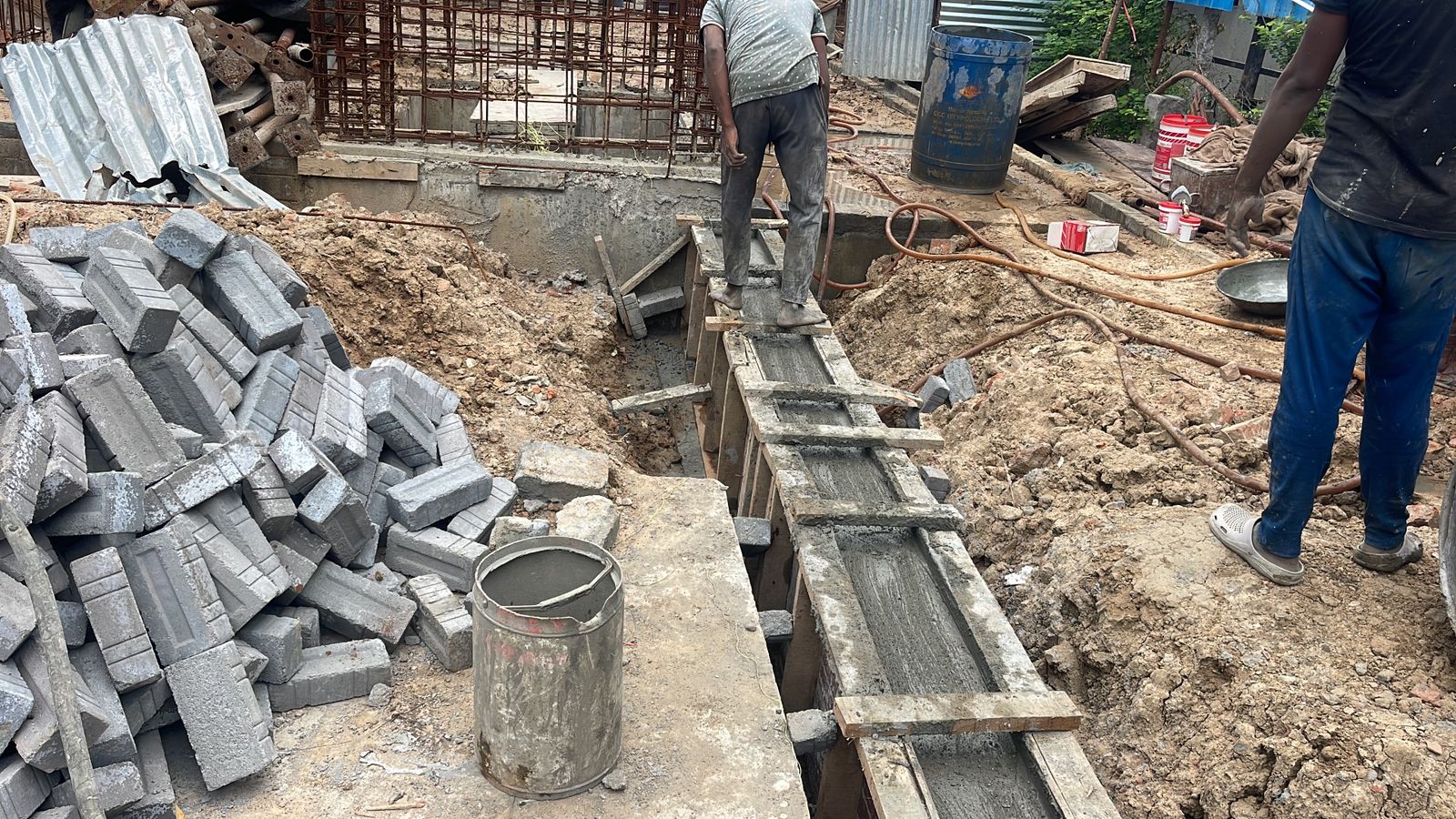

Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image Balaji Progress Image

Property Location

Let your dreams be our

next Project!

Include your country code — all international formats are accepted (e.g. +91, +1, +44, +971).
