Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Anantiya

Adyar

Download Brochure

Ramaniya - Files

Enquire Now

Amenities

Generator Backup Generator Backup
CCTV CCTV
Elevators Elevators

Master Layout Plan

Anantiya - Floor Plan
Anantiya - Floor Plan
Anantiya - Floor Plan
Anantiya - Floor Plan
Anantiya - Floor Plan
Anantiya - Floor Plan
Anantiya - Floor Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
103 1 3BHK + 2T 1288 East Available
104 1 2BHK + 2T 938 North Available
202 2 3BHK + 3T 1443 North Available

Approvals

Planning Permit No:

OL-PP/HRB/0013/2026

Date of Permit:

2026-04-02

Building Permission No:

CEBA / WDCN13 / 00161 / 2026

Date of Permit:

2026-04-13

TNRERA:

TNRERA/29/BLG/0188/2026

Dated:

2026-05-27

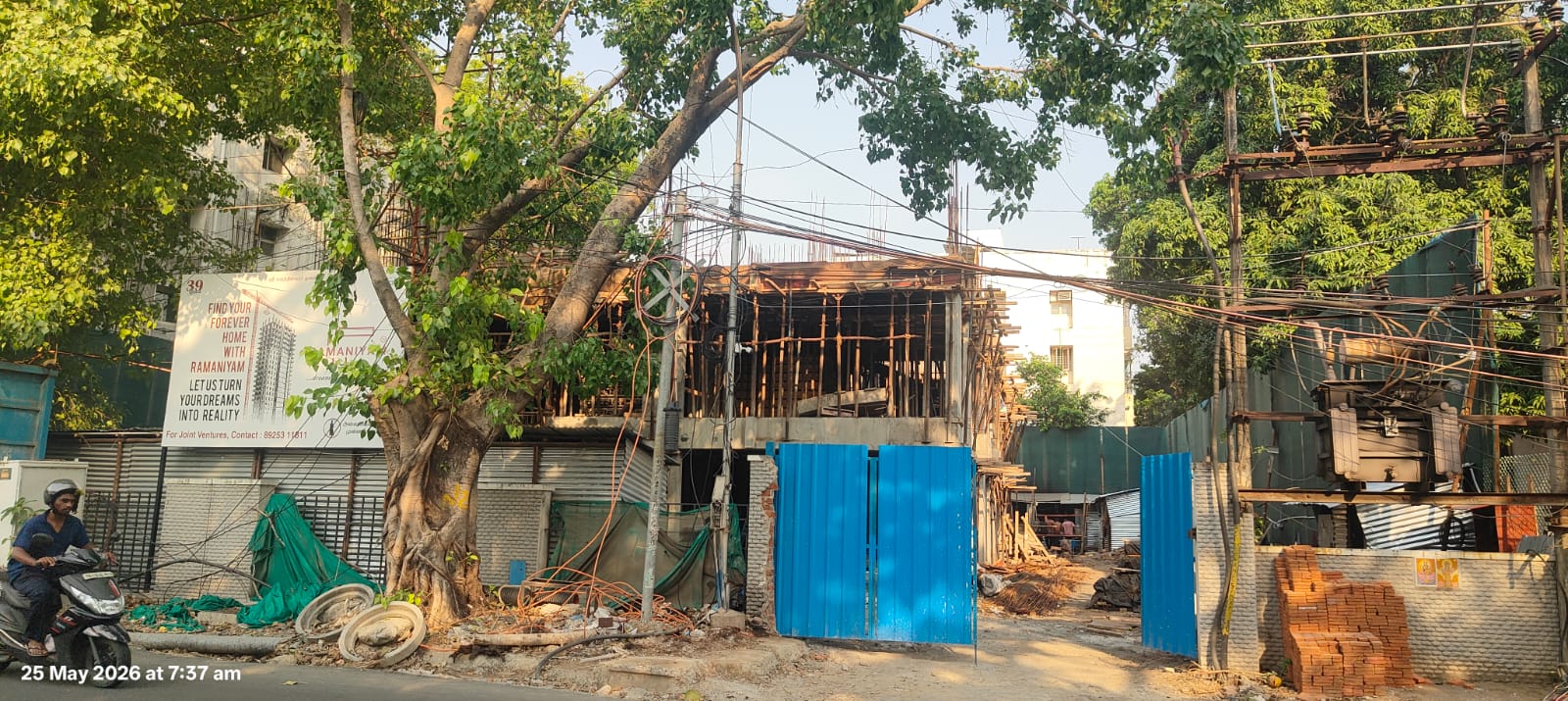

Project Update Images

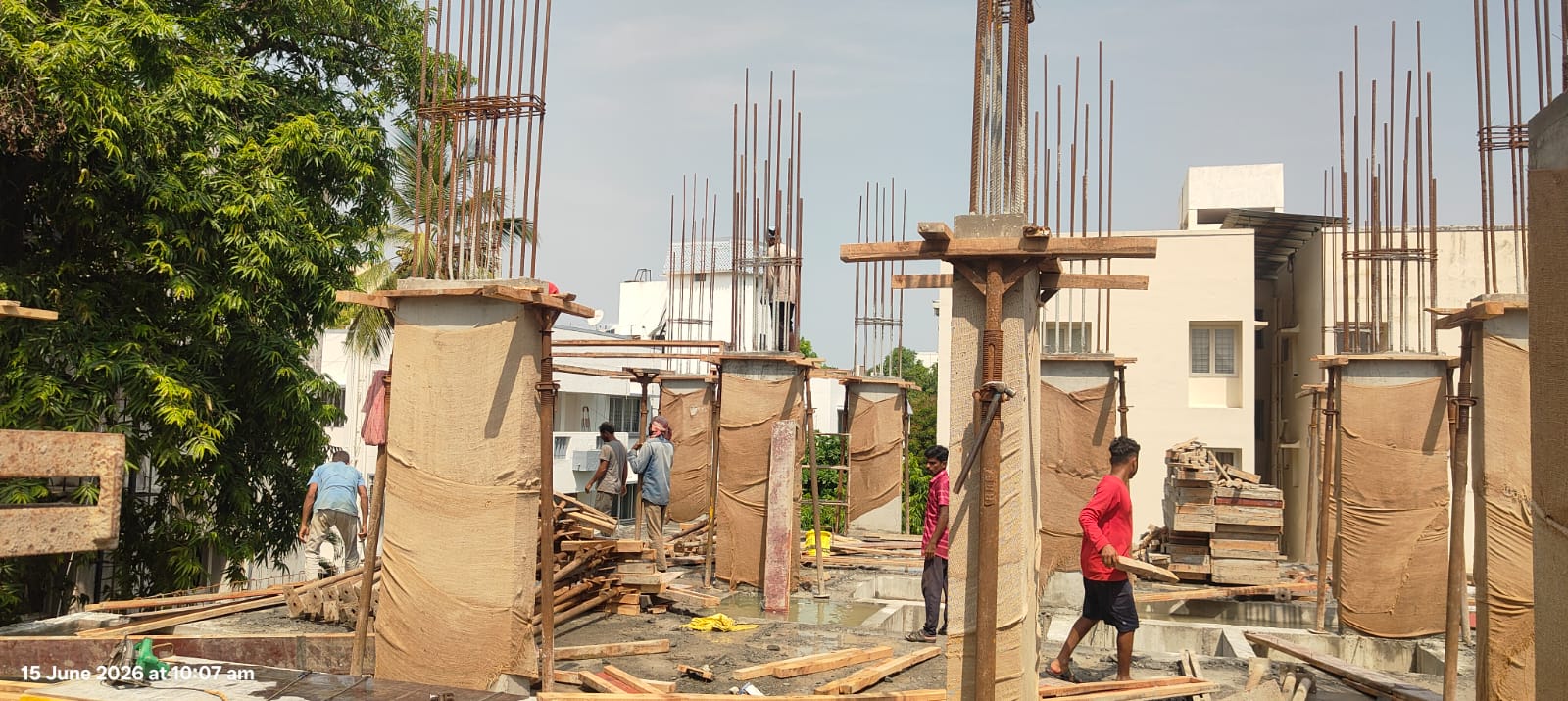

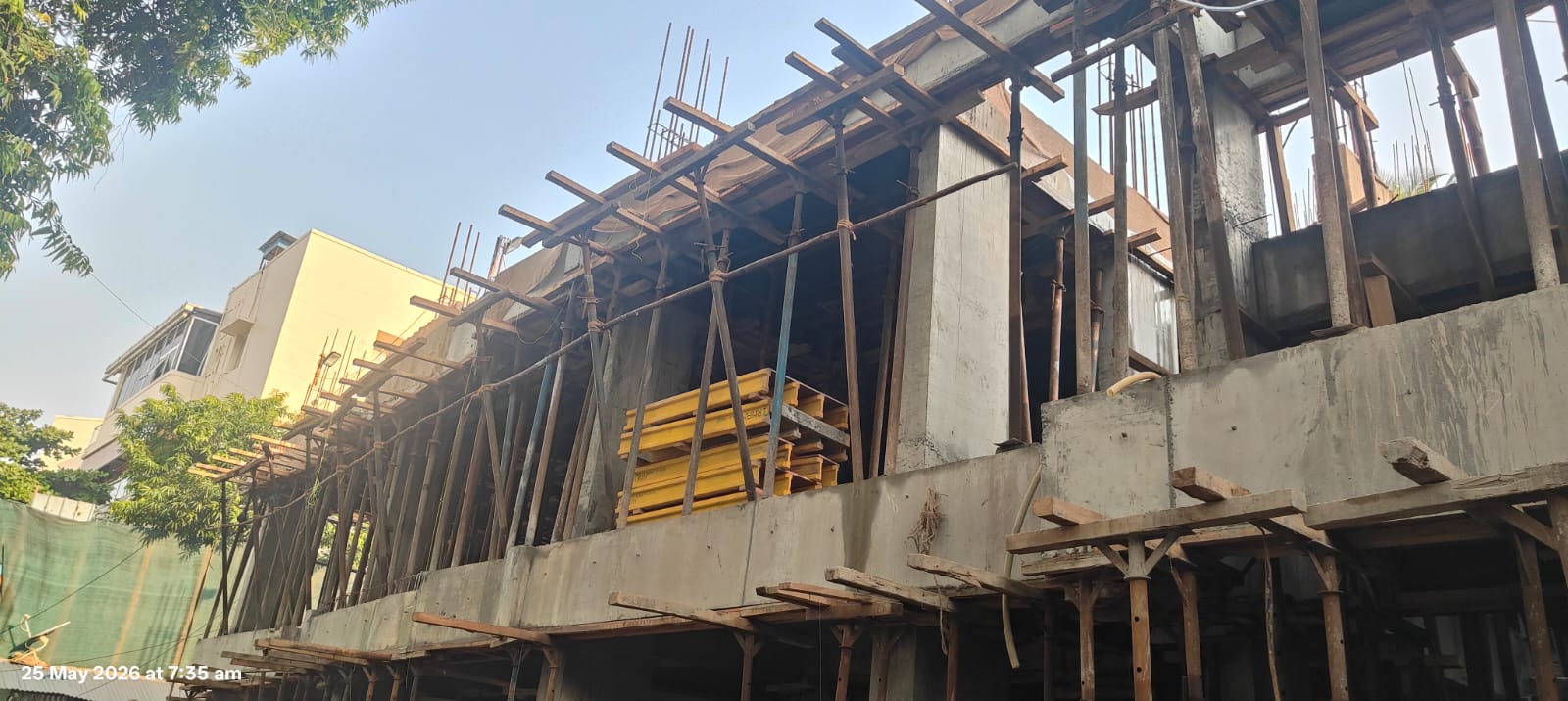

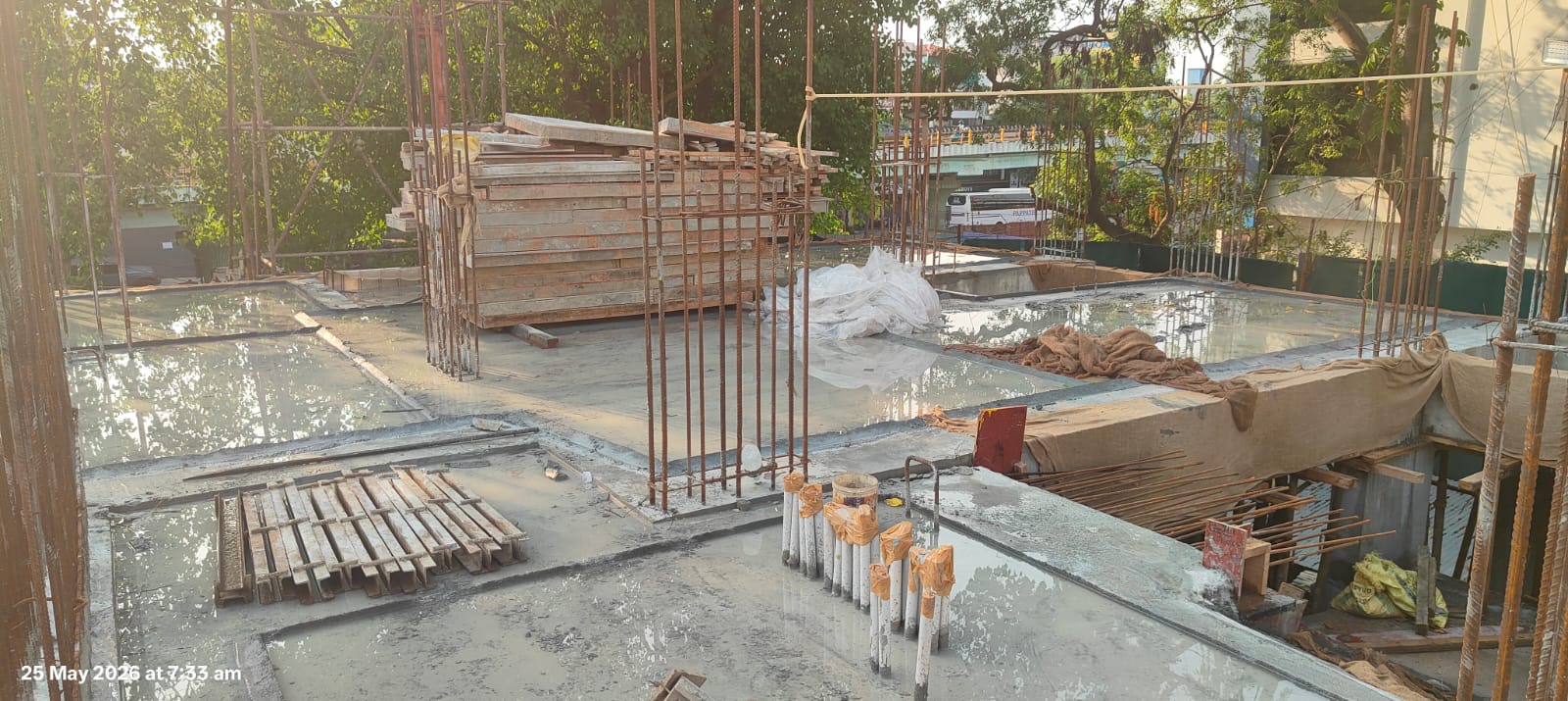

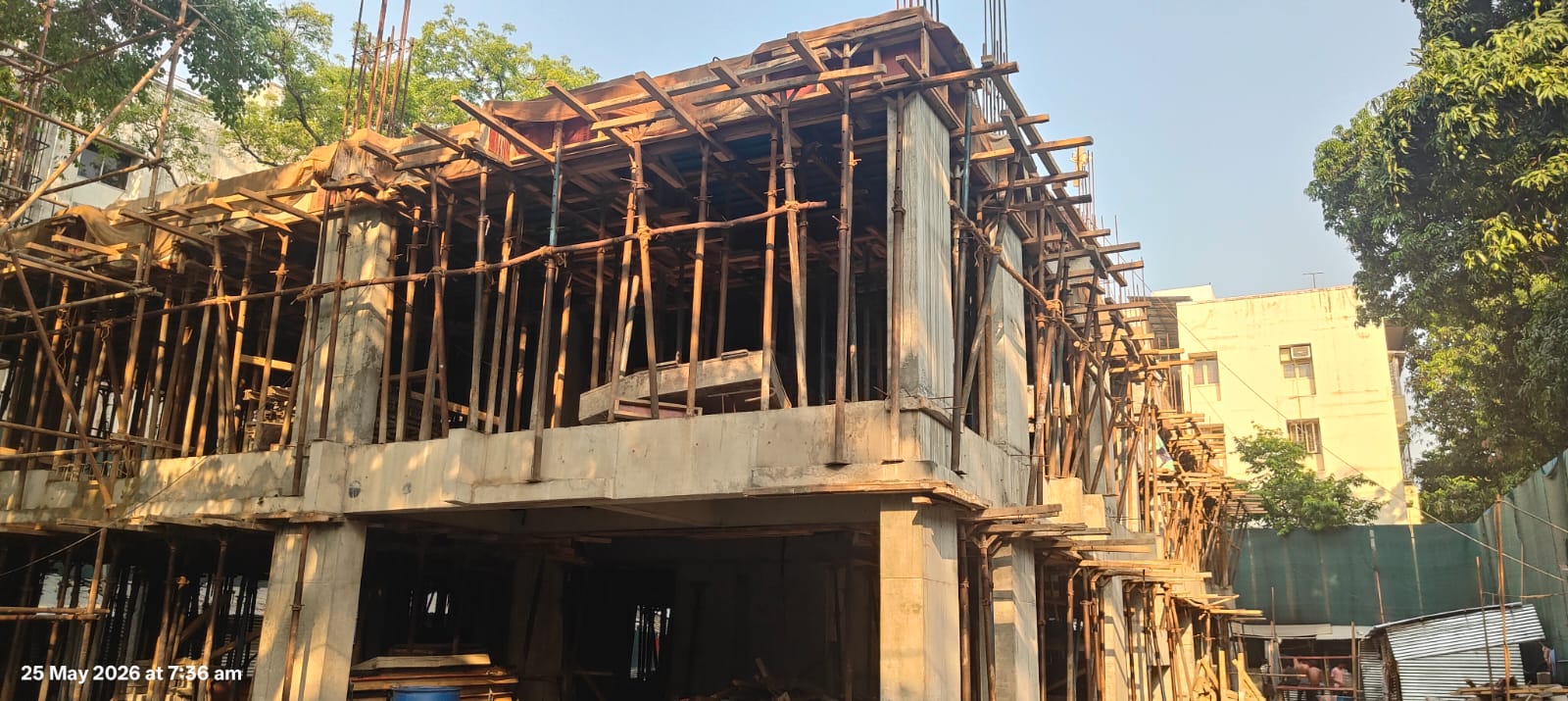

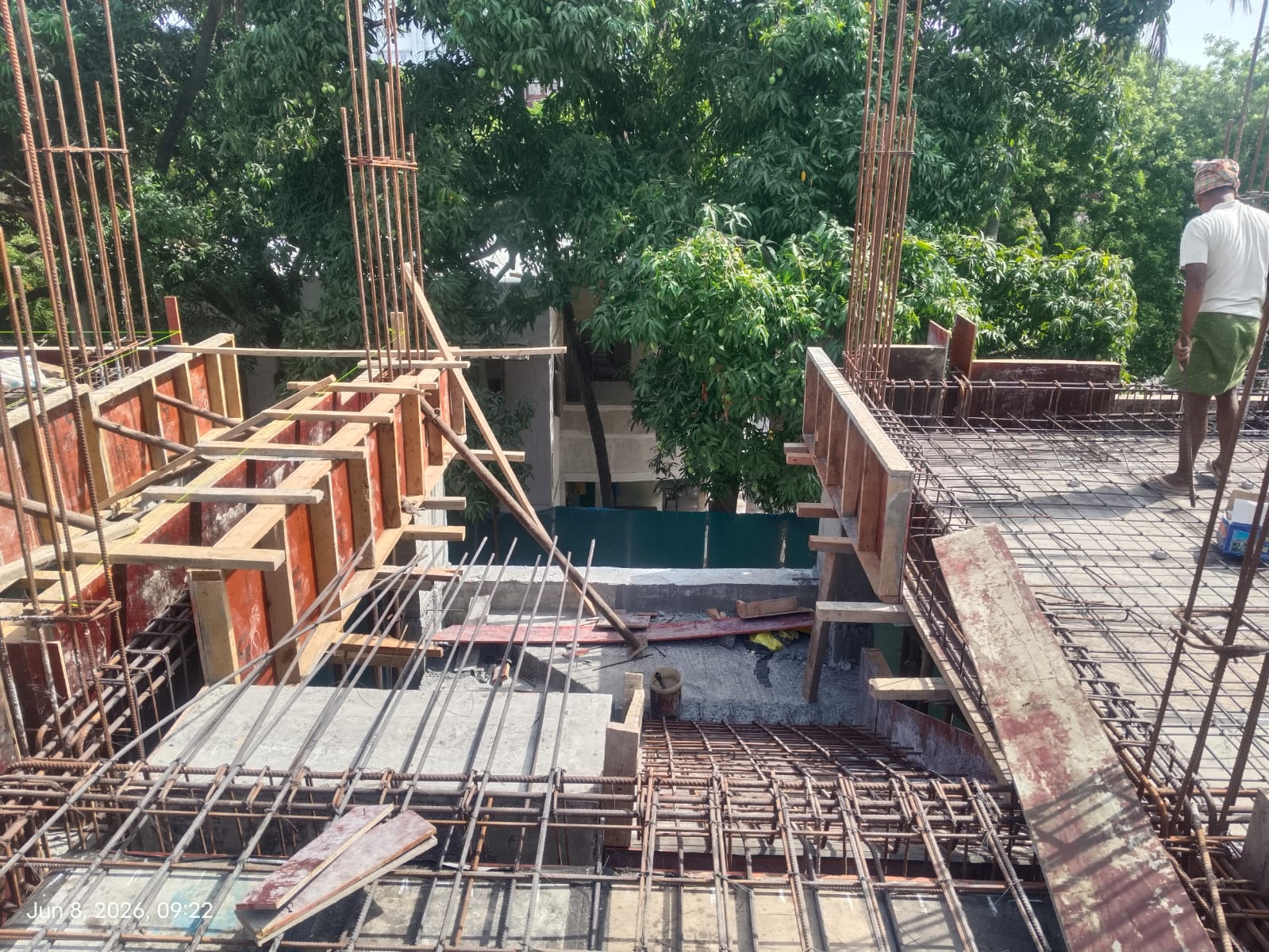

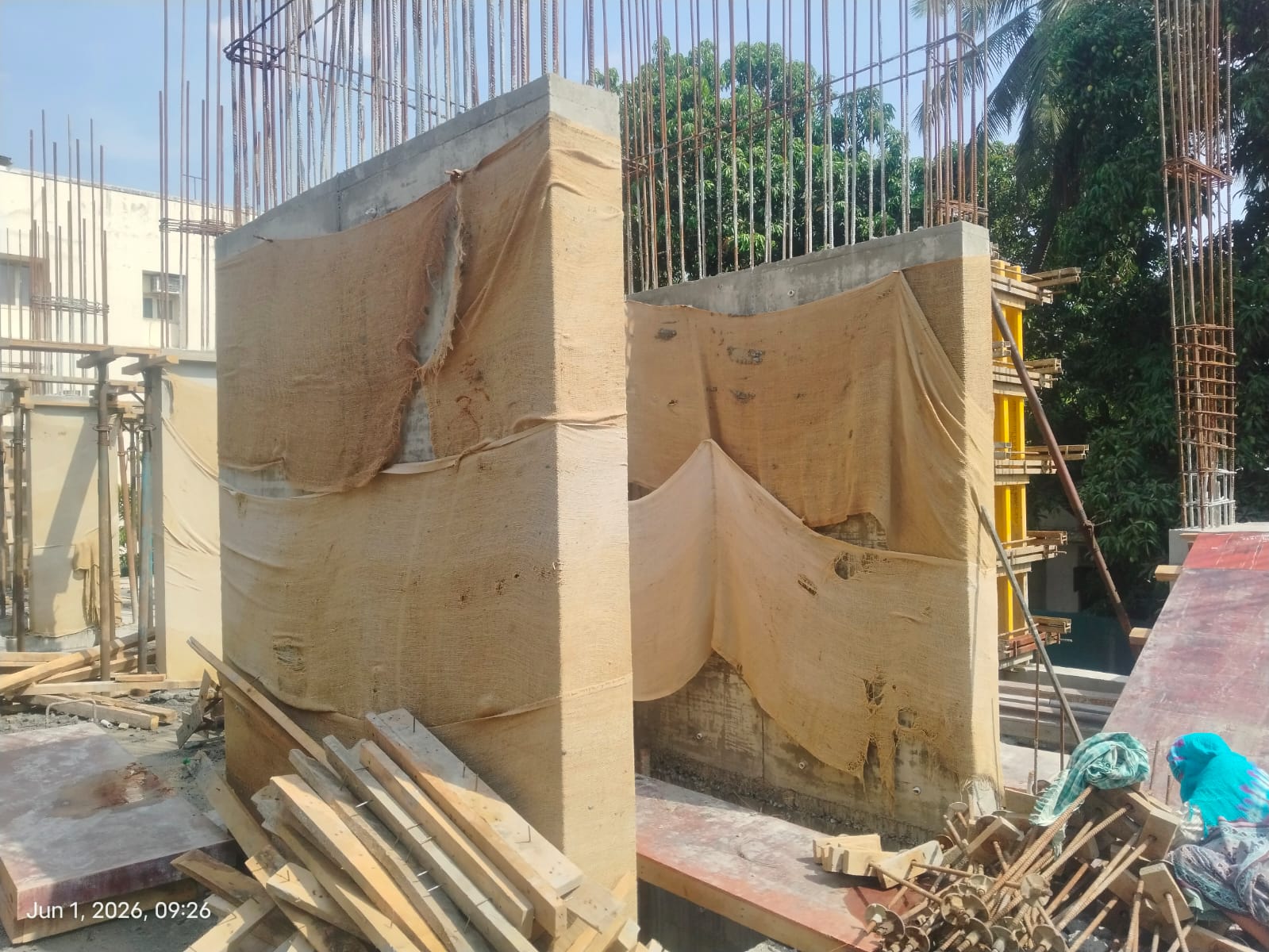

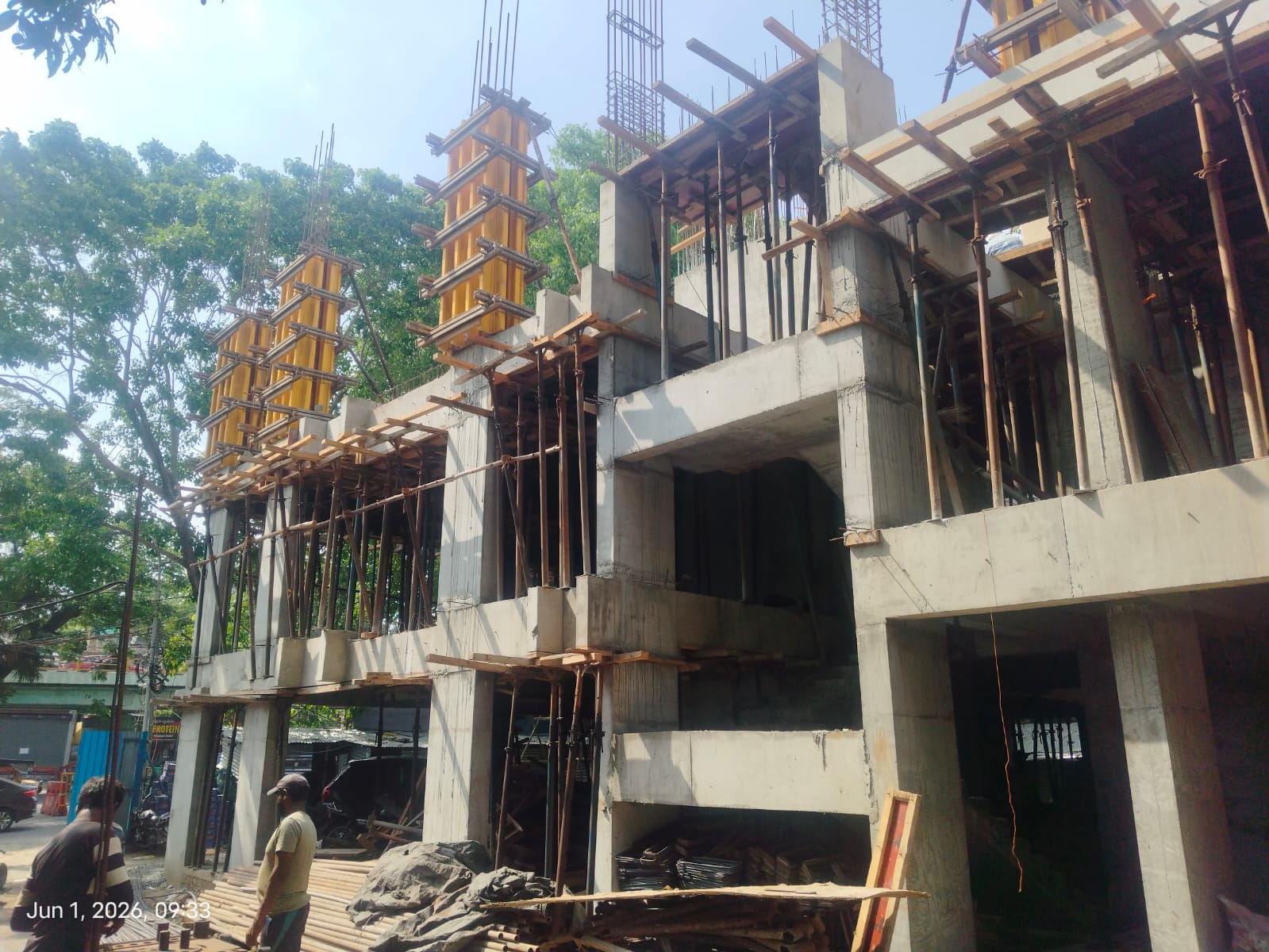

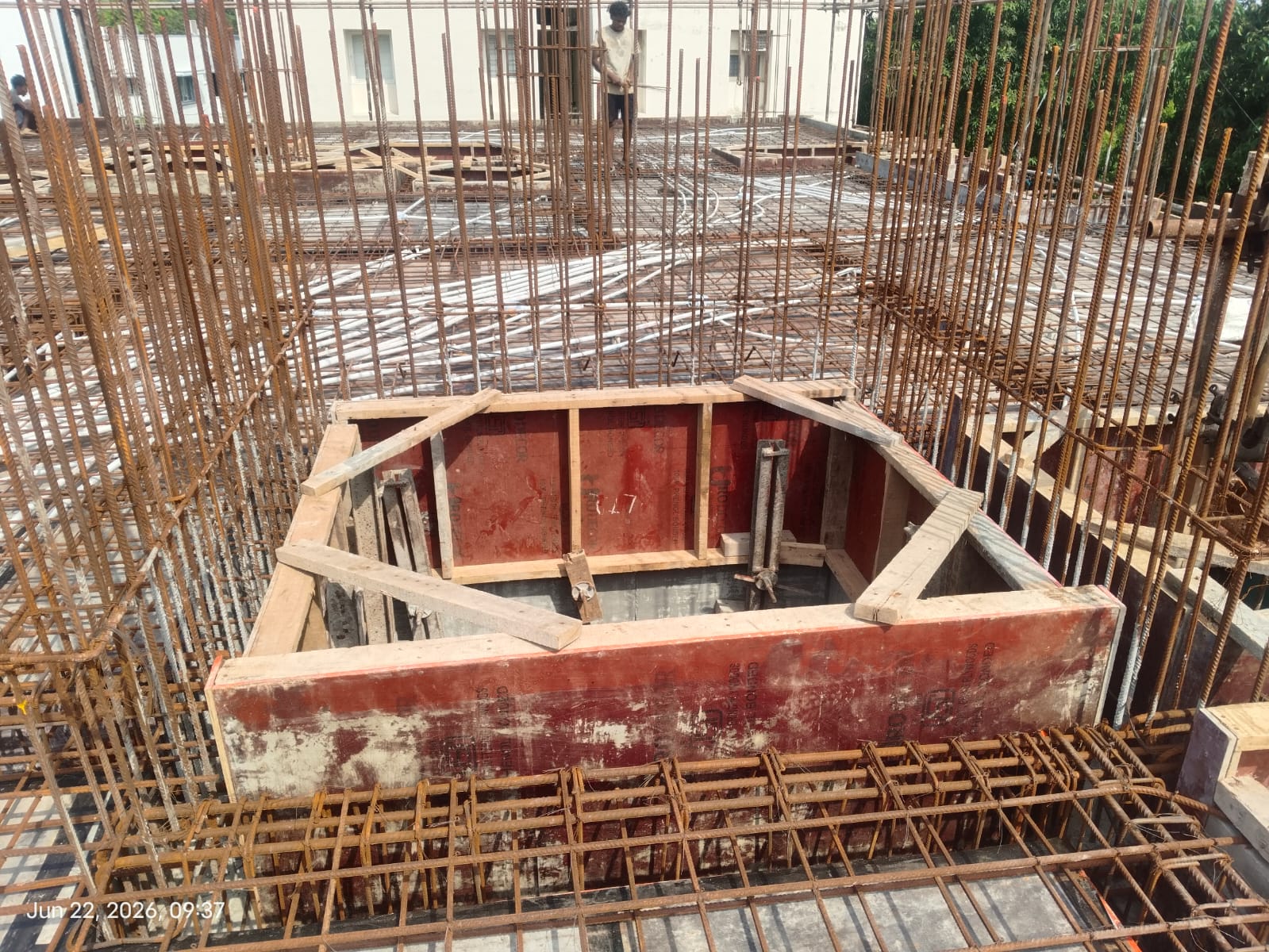

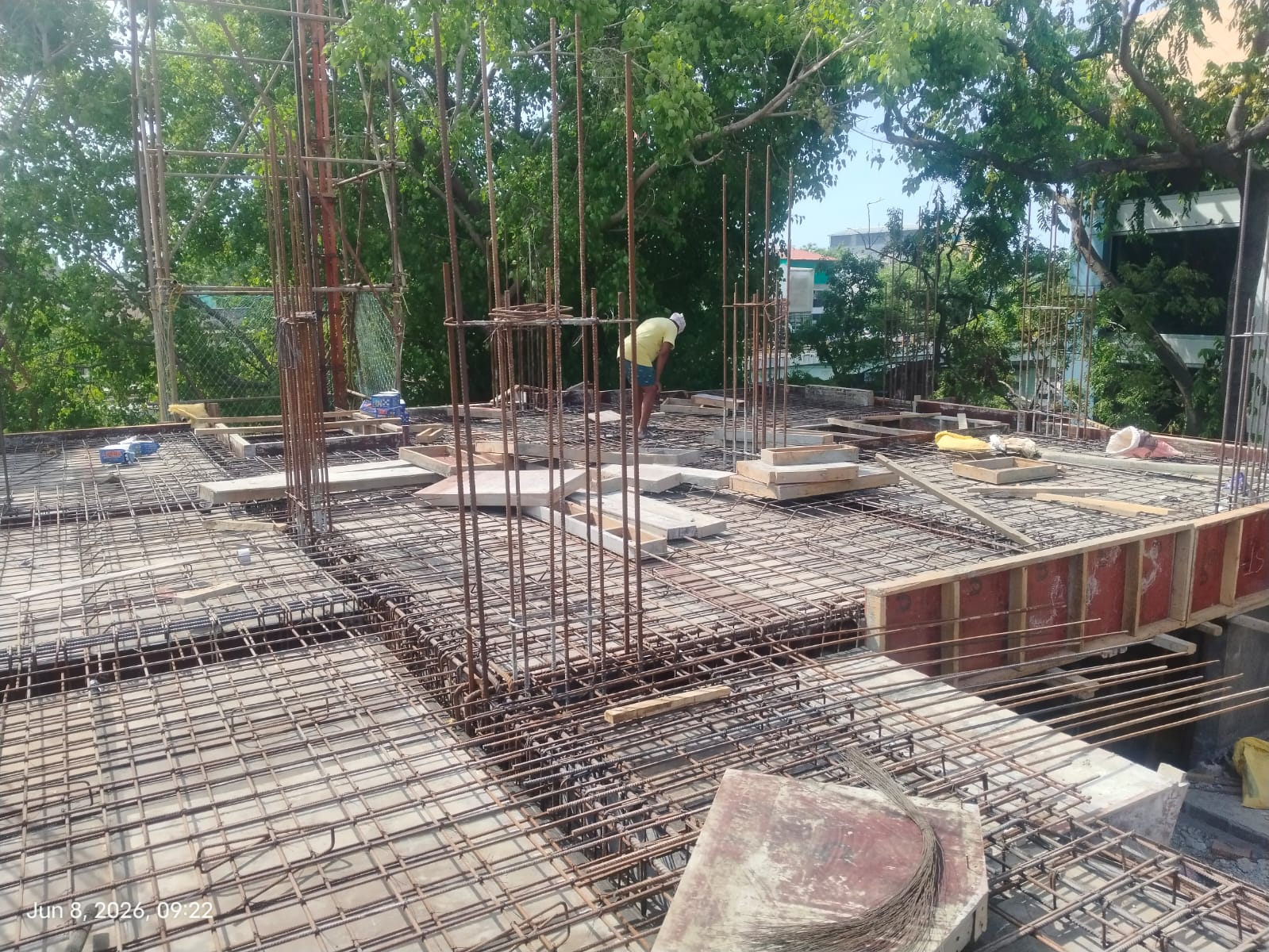

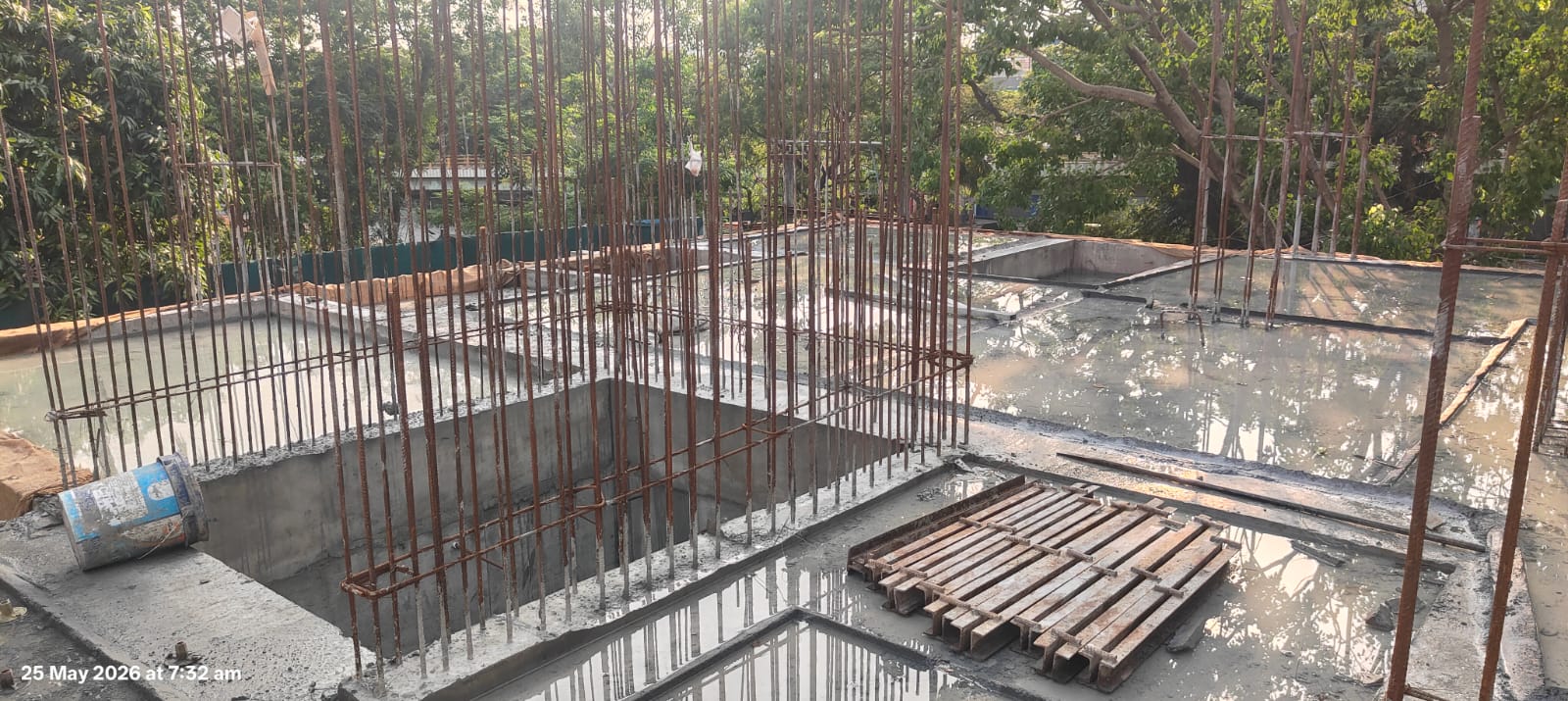

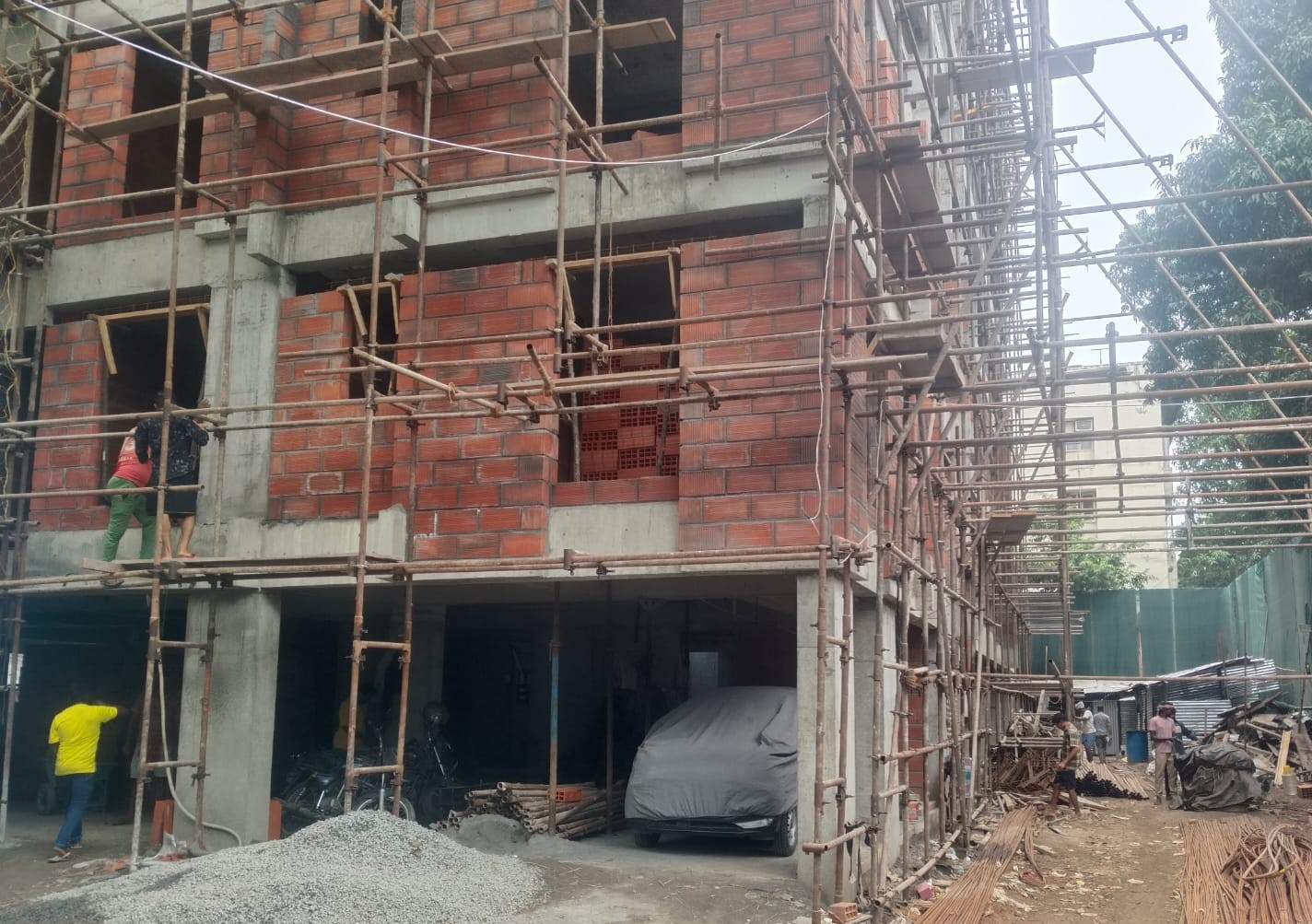

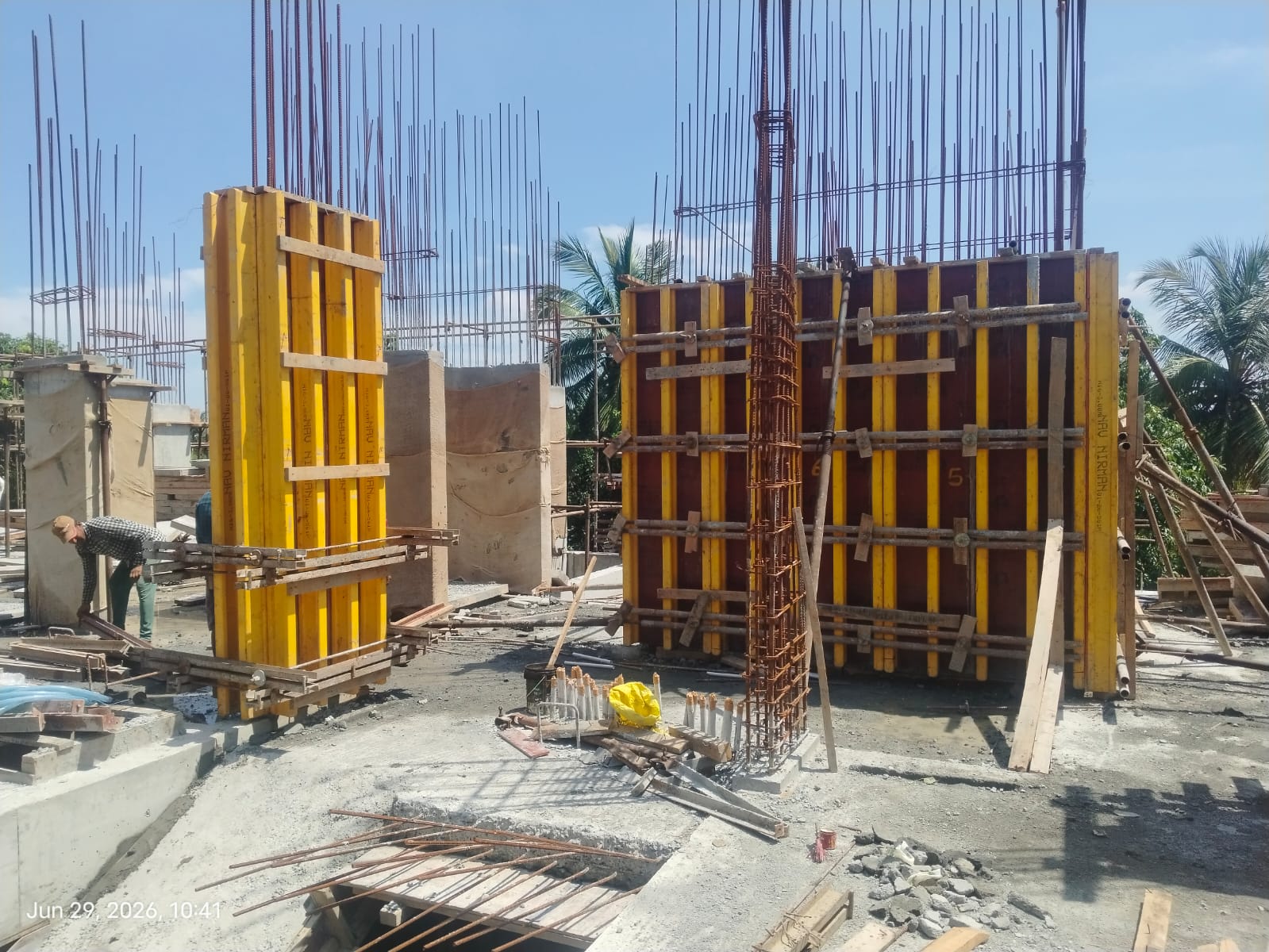

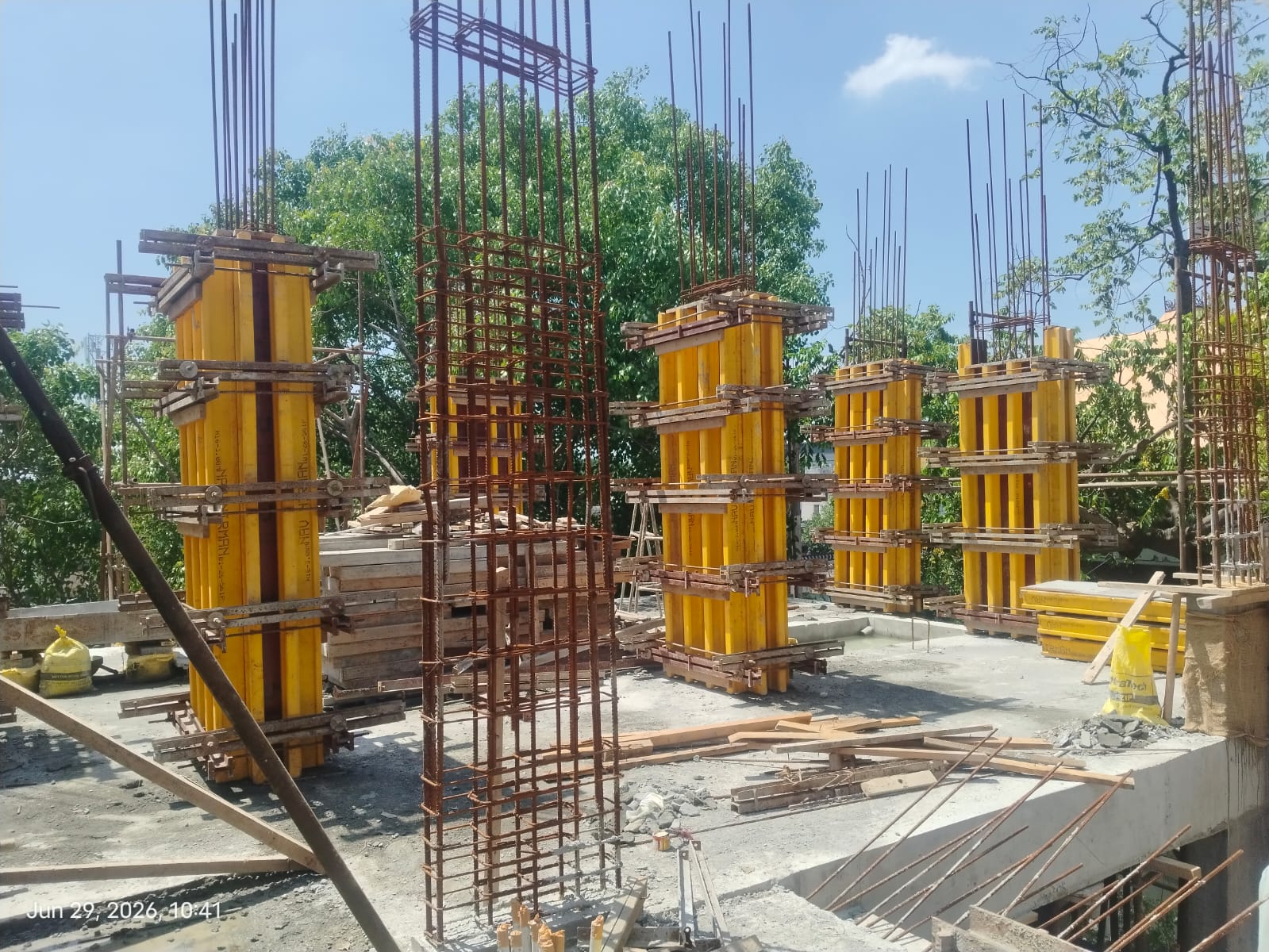

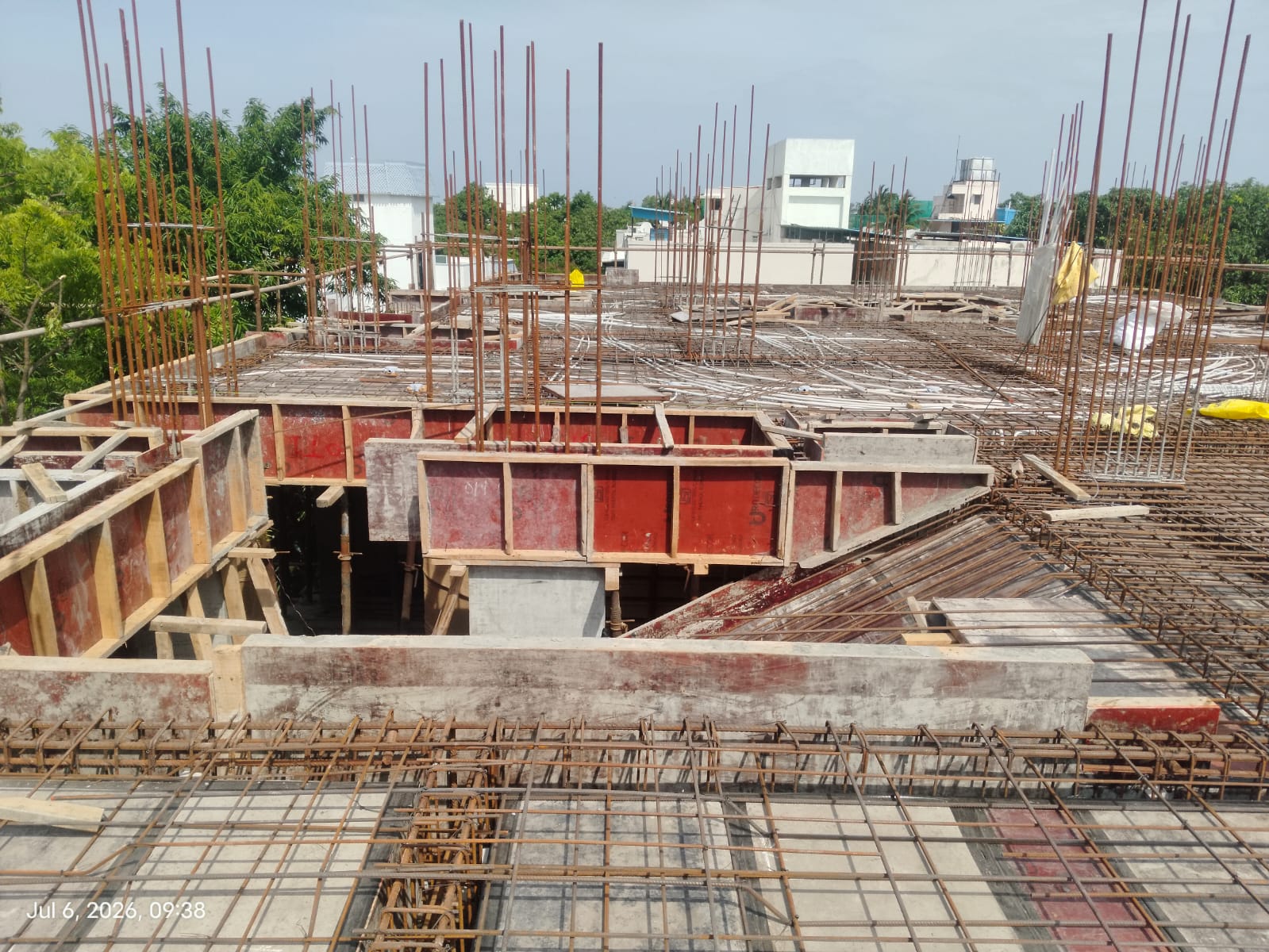

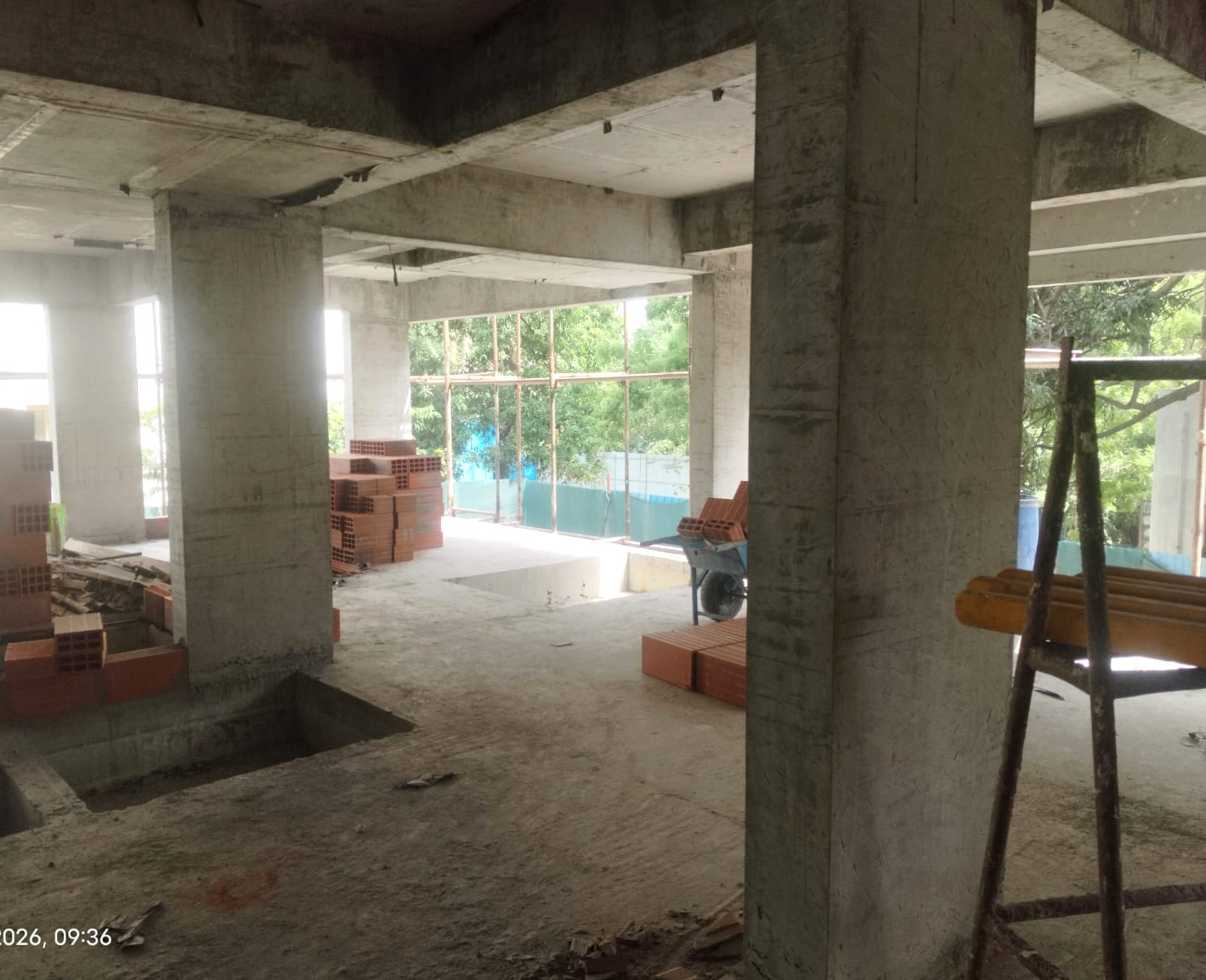

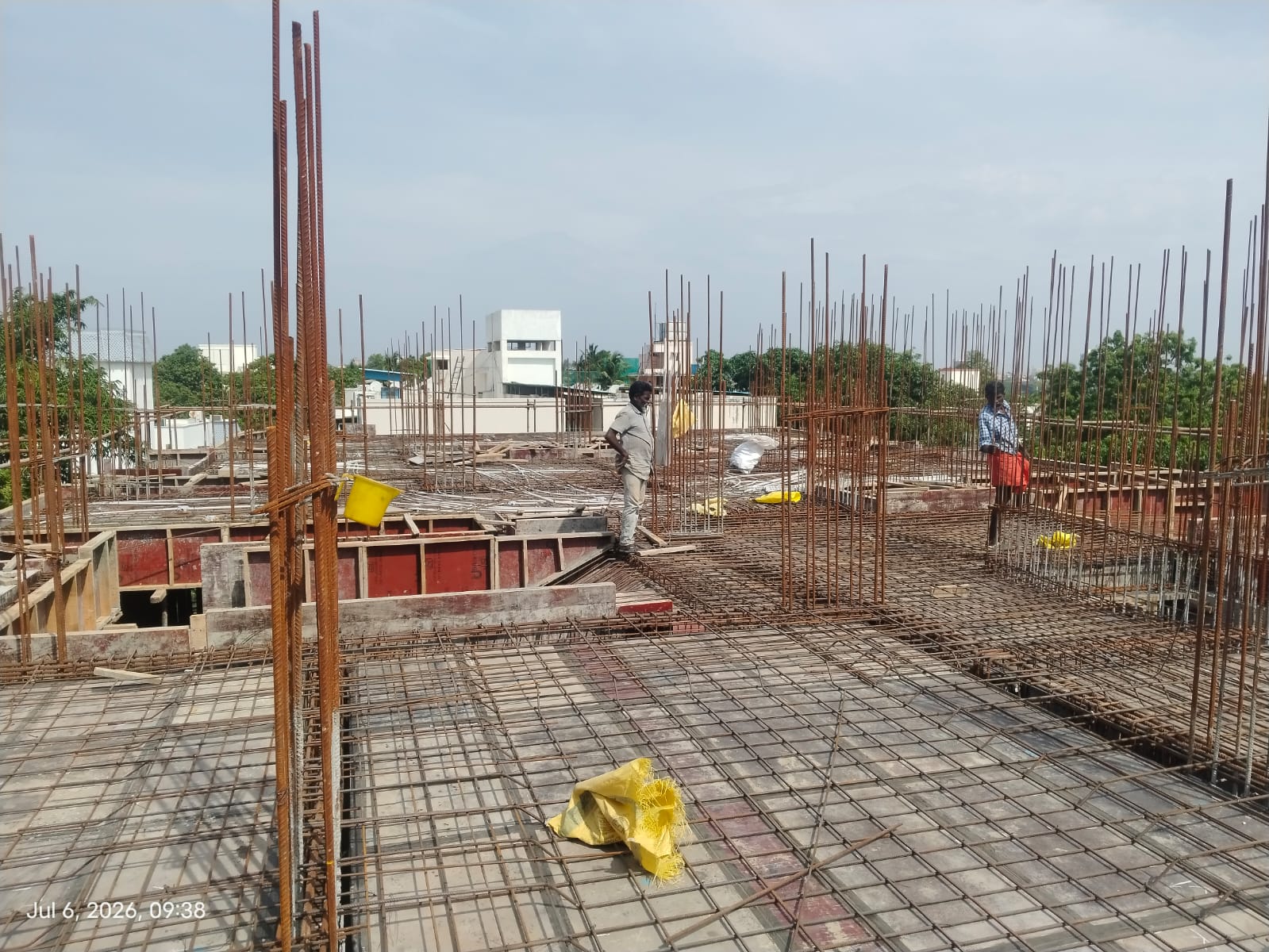

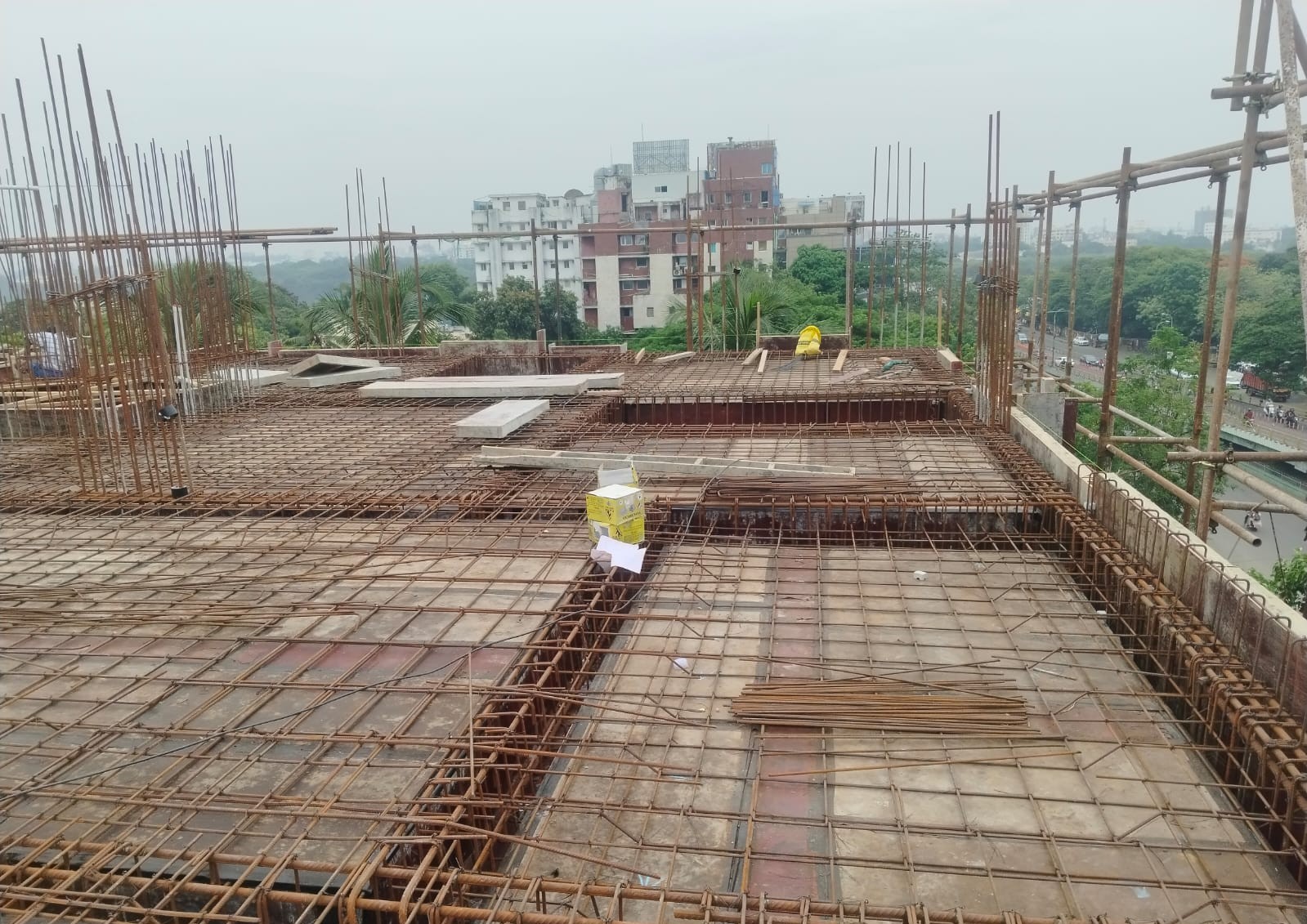

  • 3rd floor roof concrete work is completed.
  • 4th floor column concrete work is in progress.(50% completed)

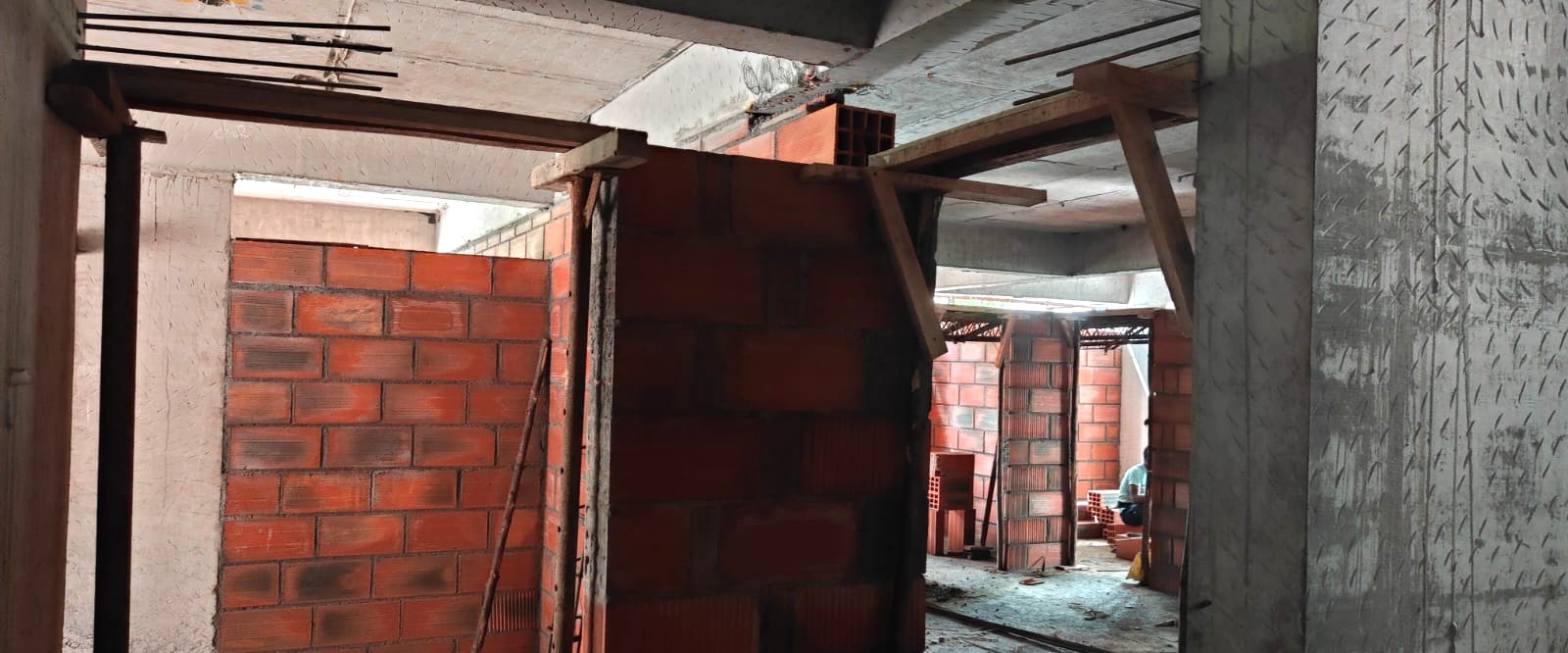

  • Ground floor block work is completed.

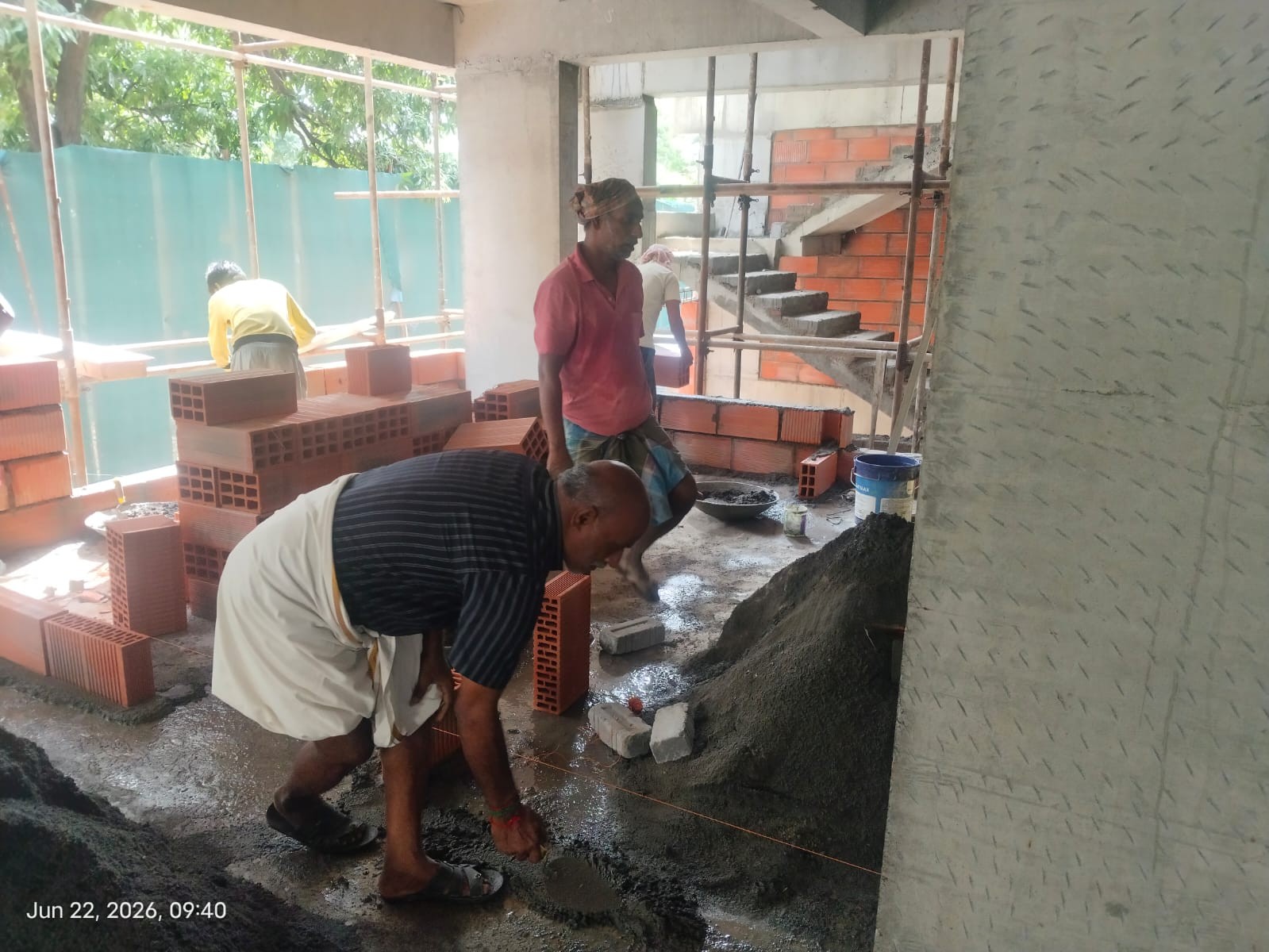

  • 1st floor brick work is in progress.(25% completed)

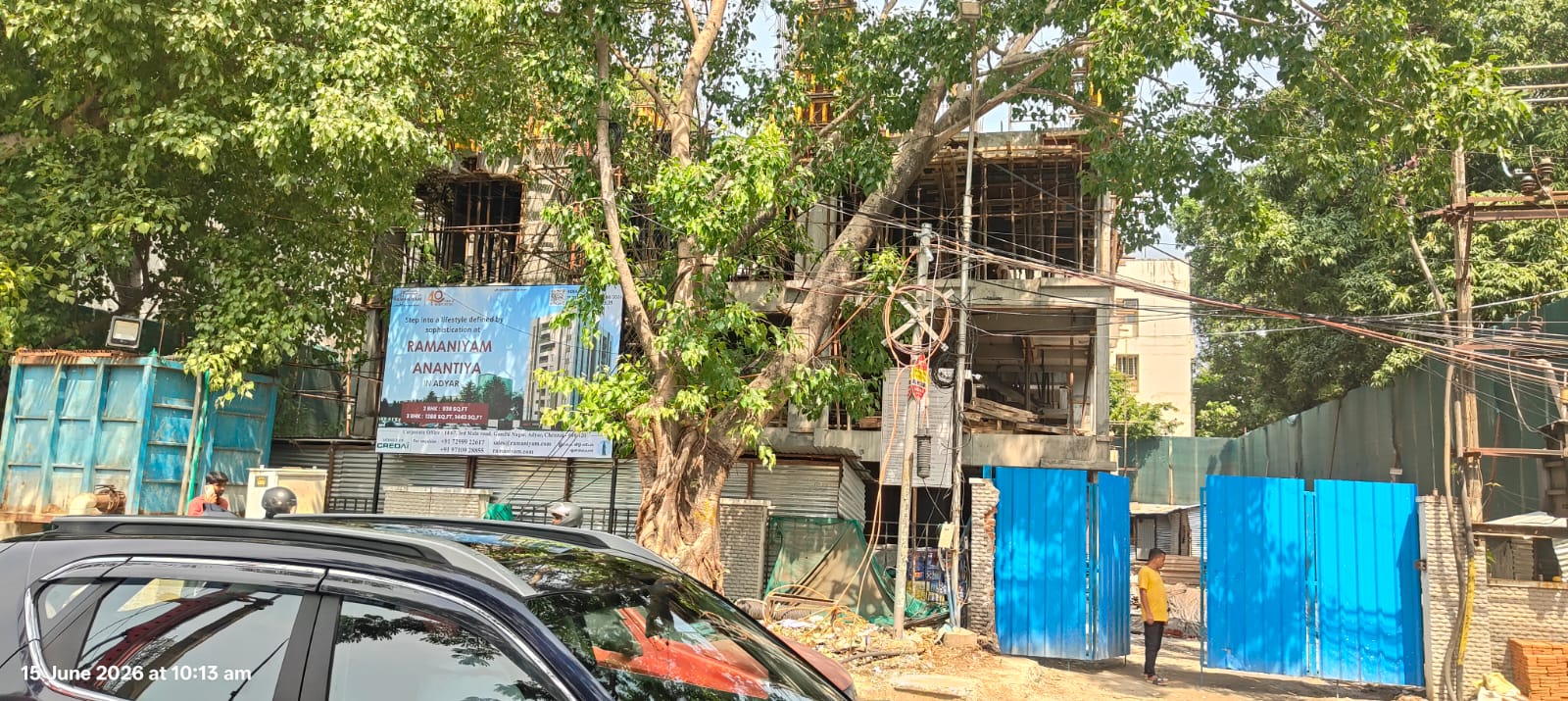

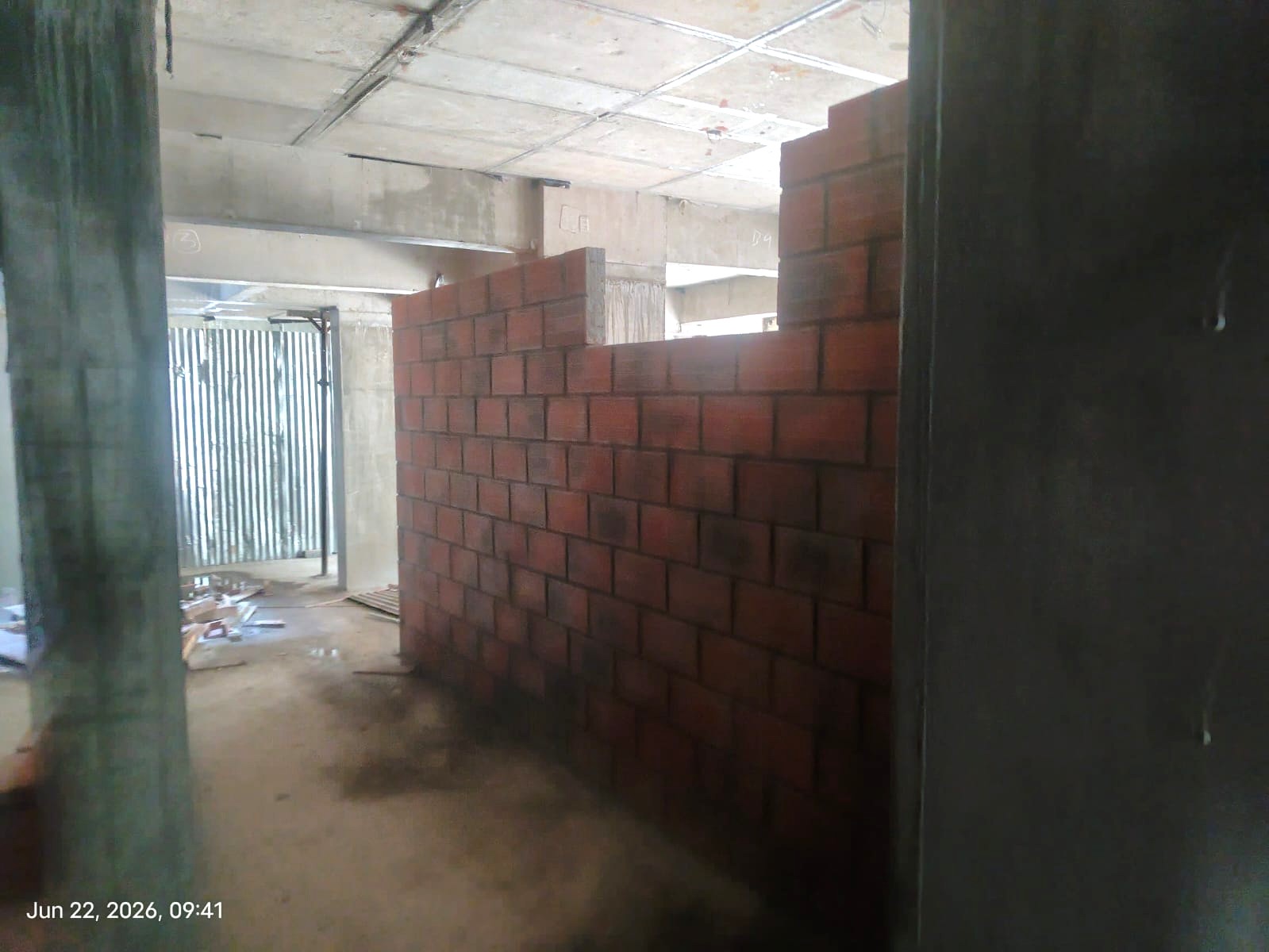

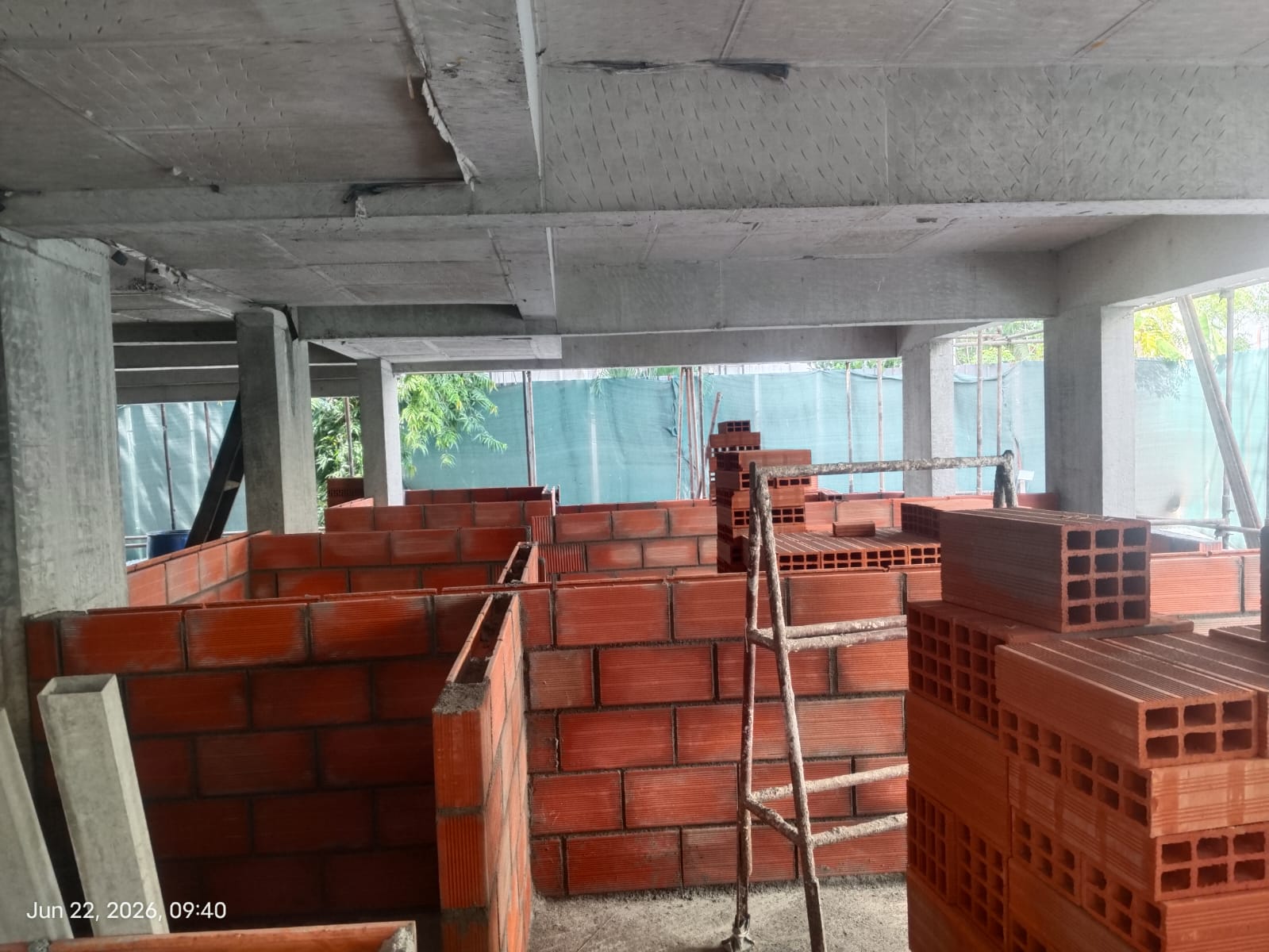

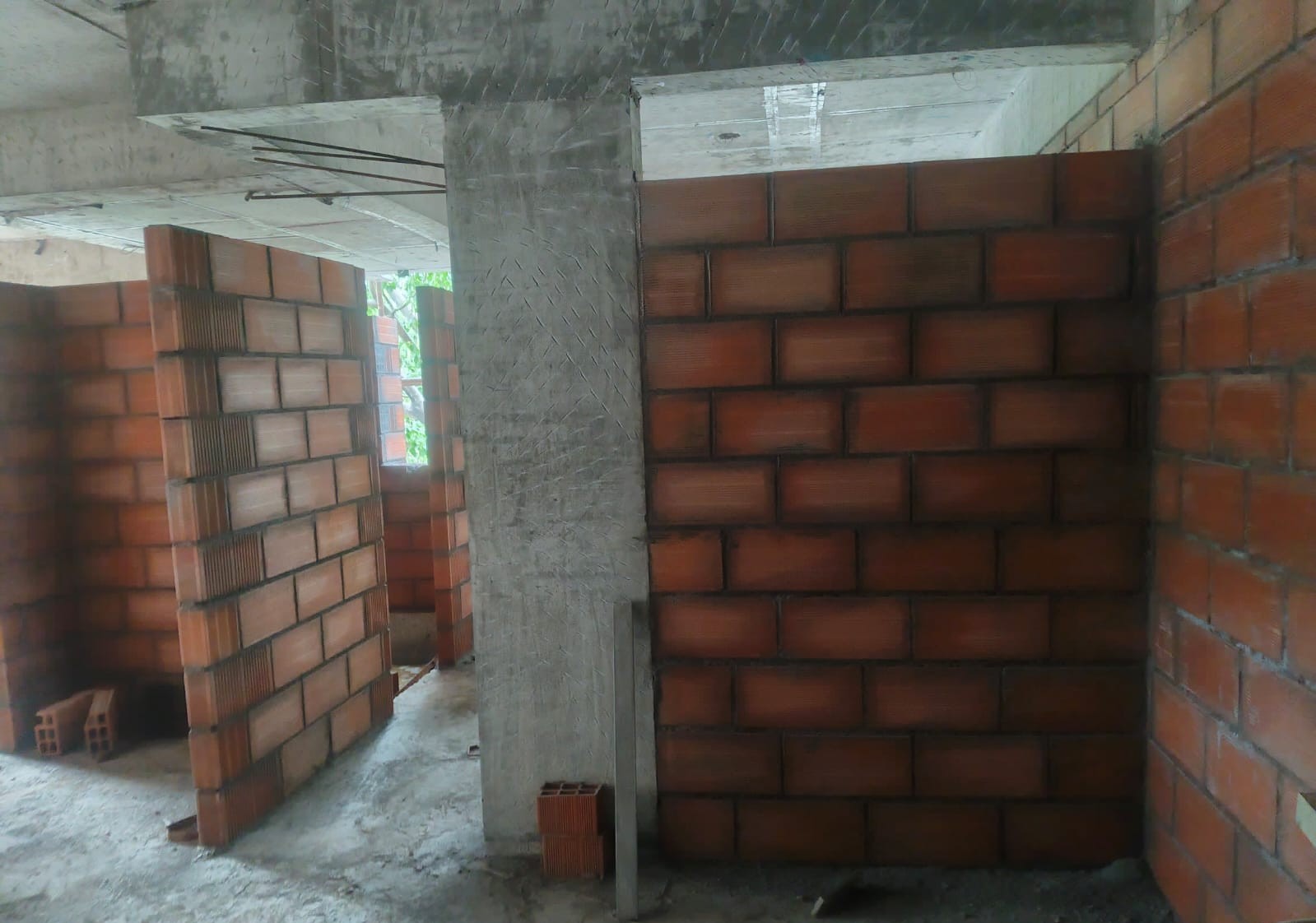

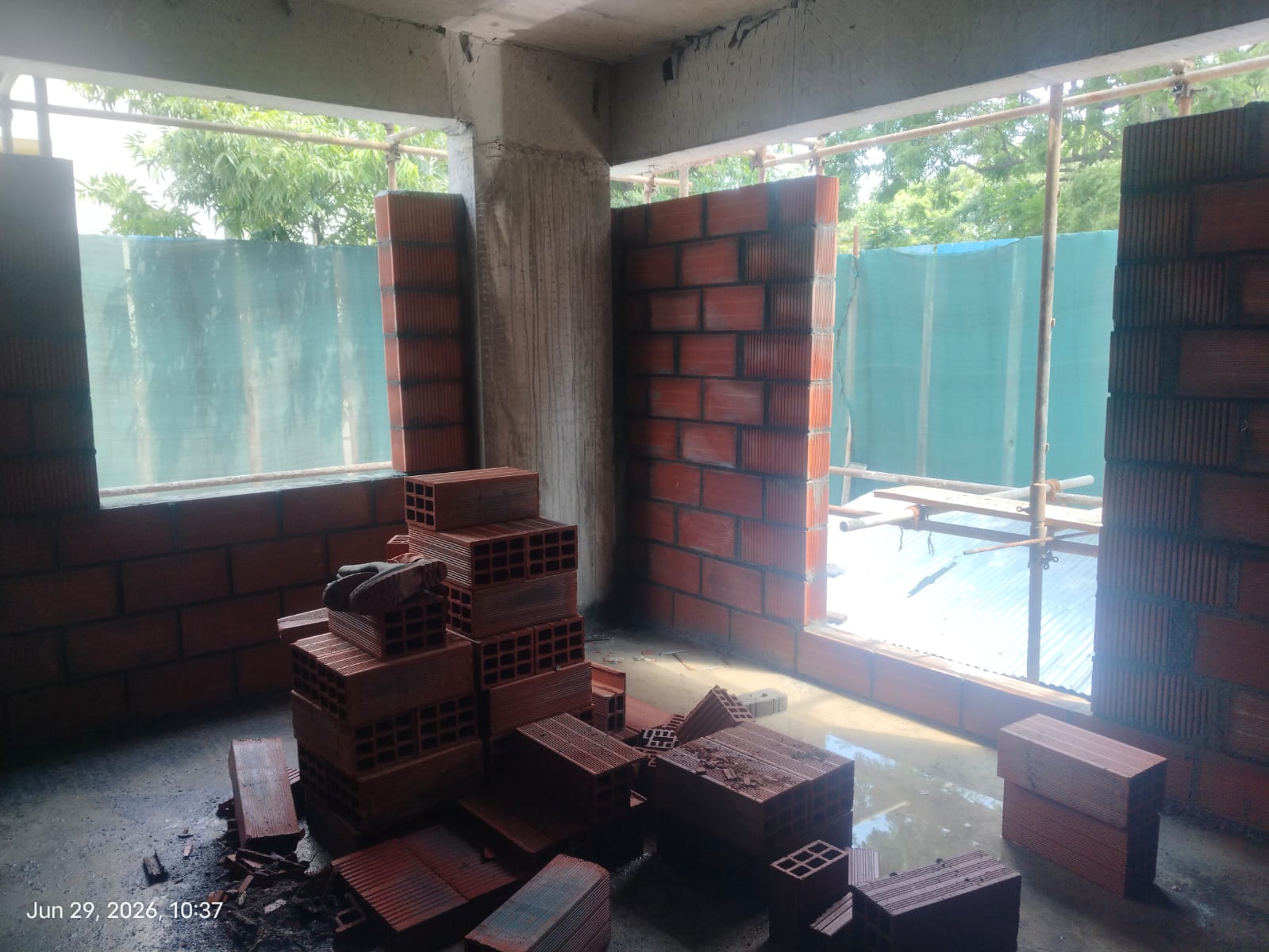

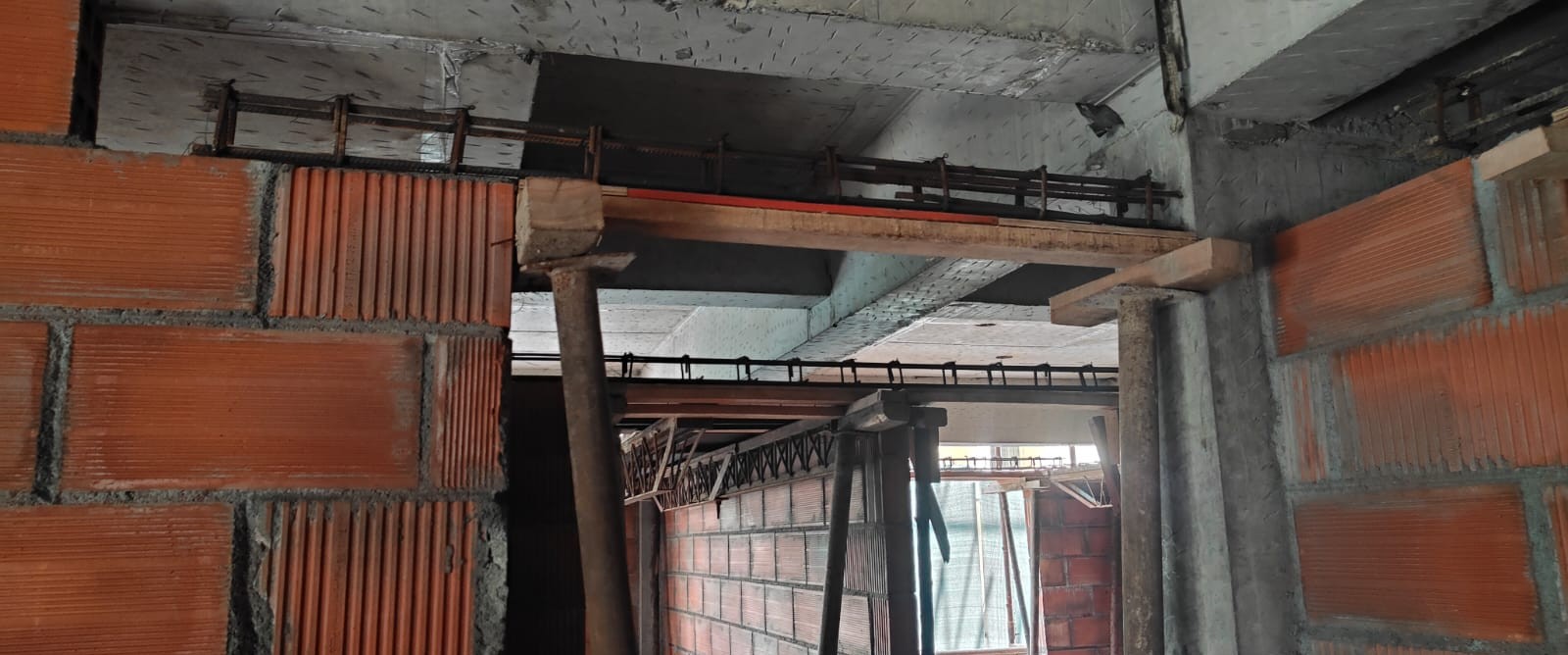

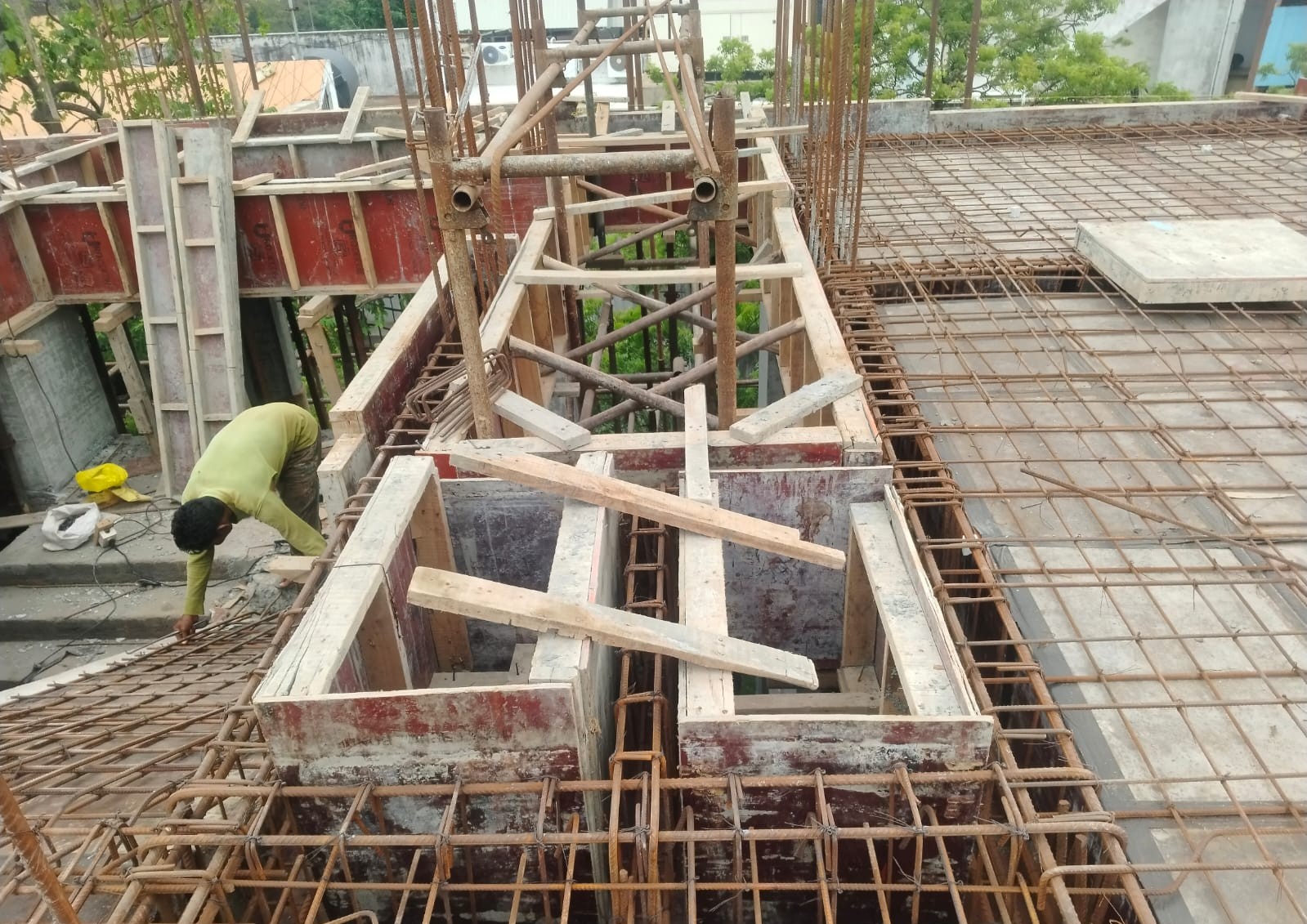

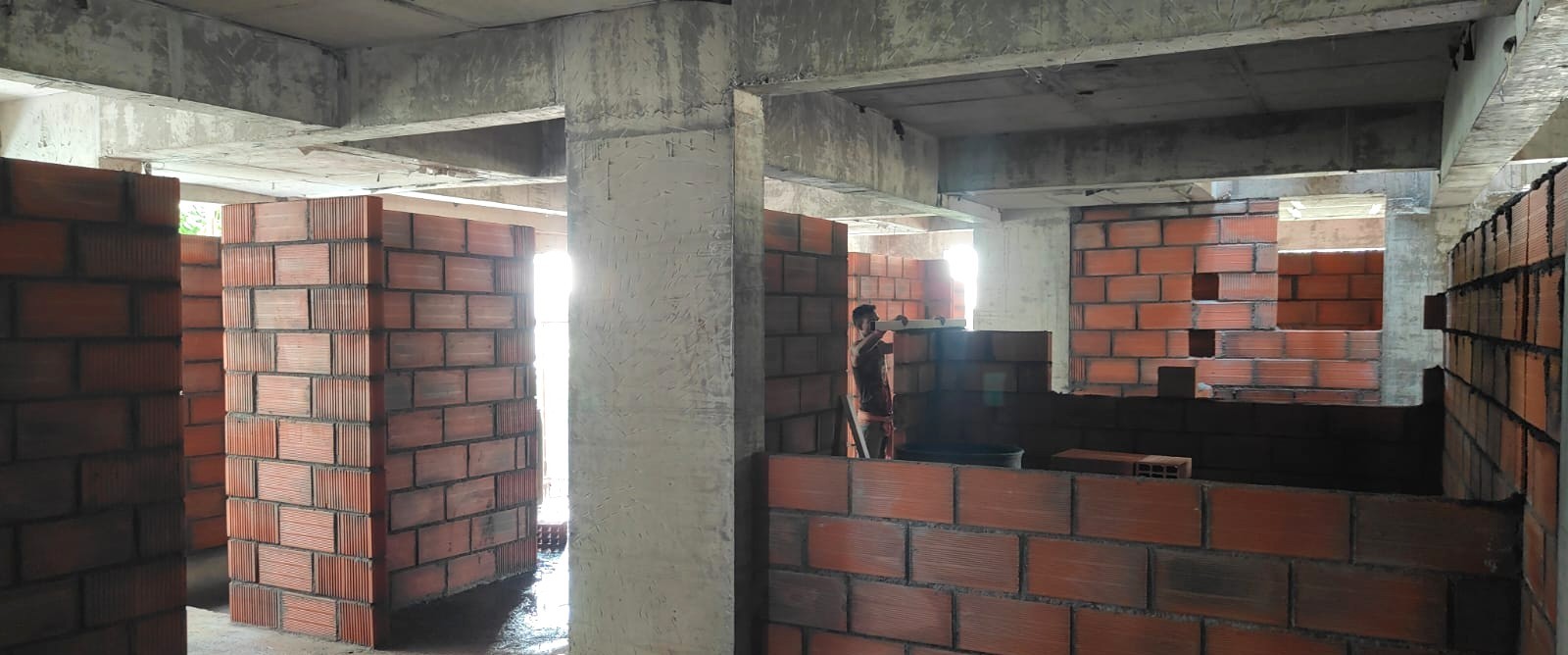

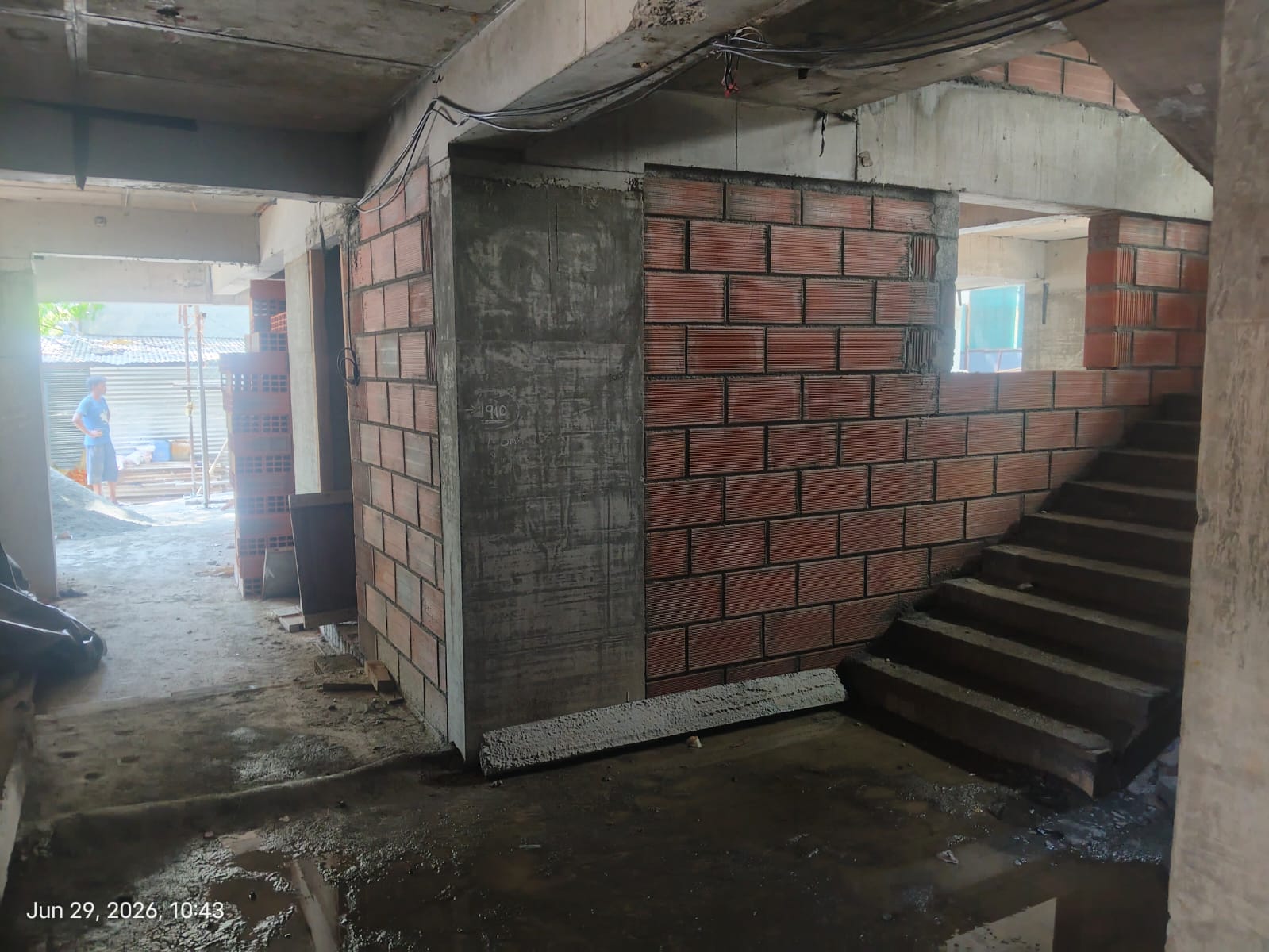

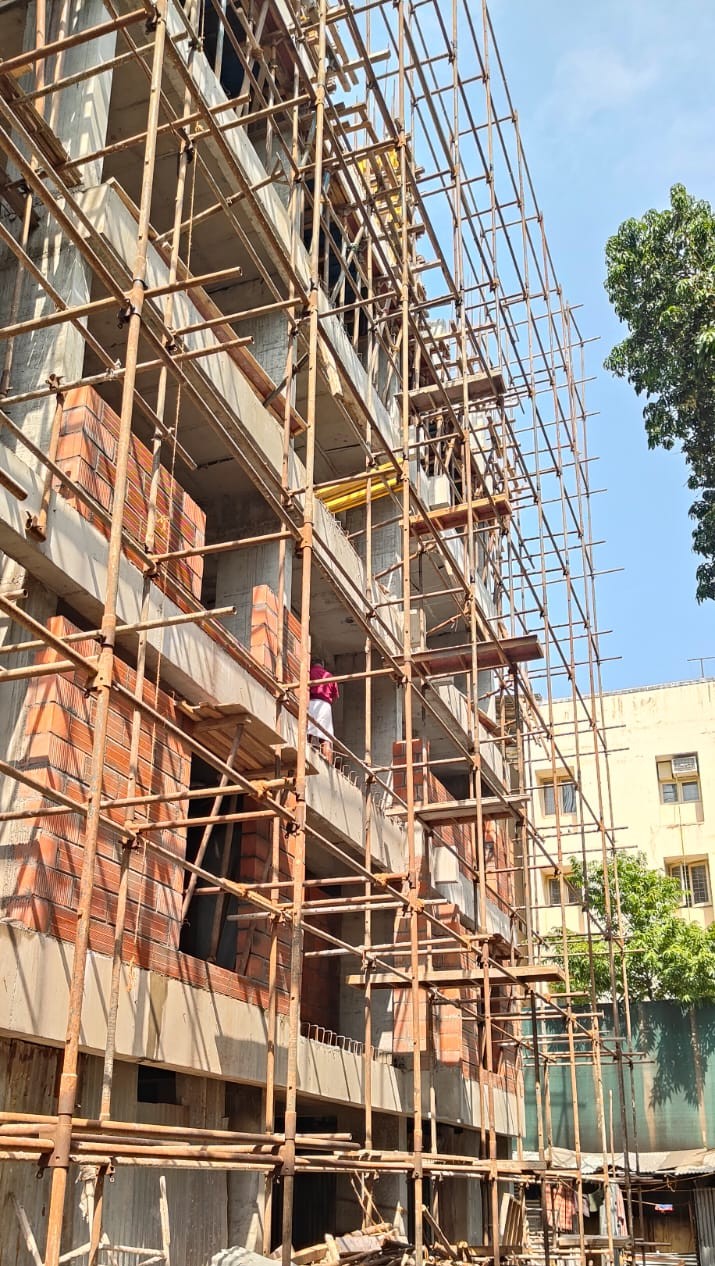

Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image

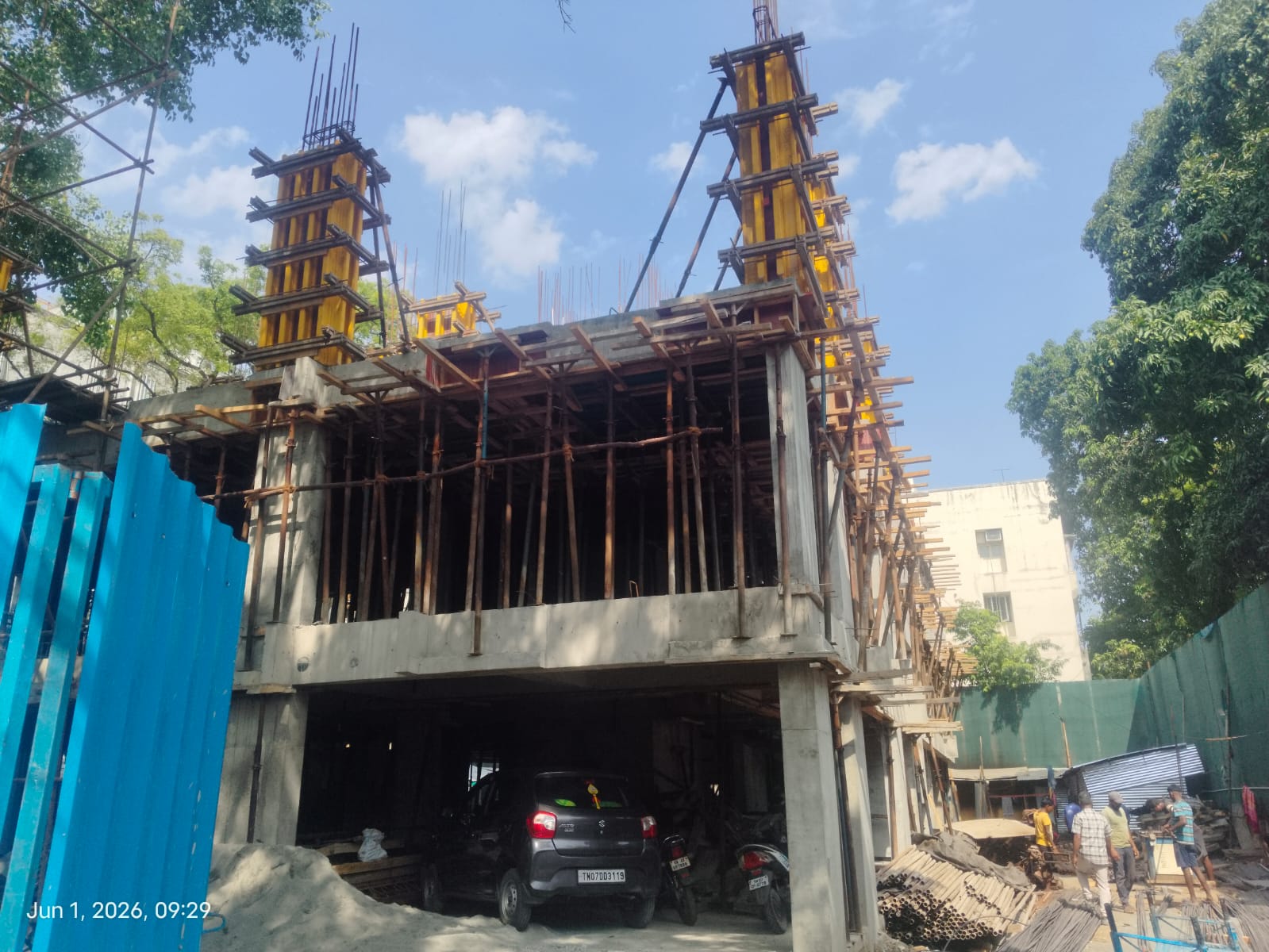

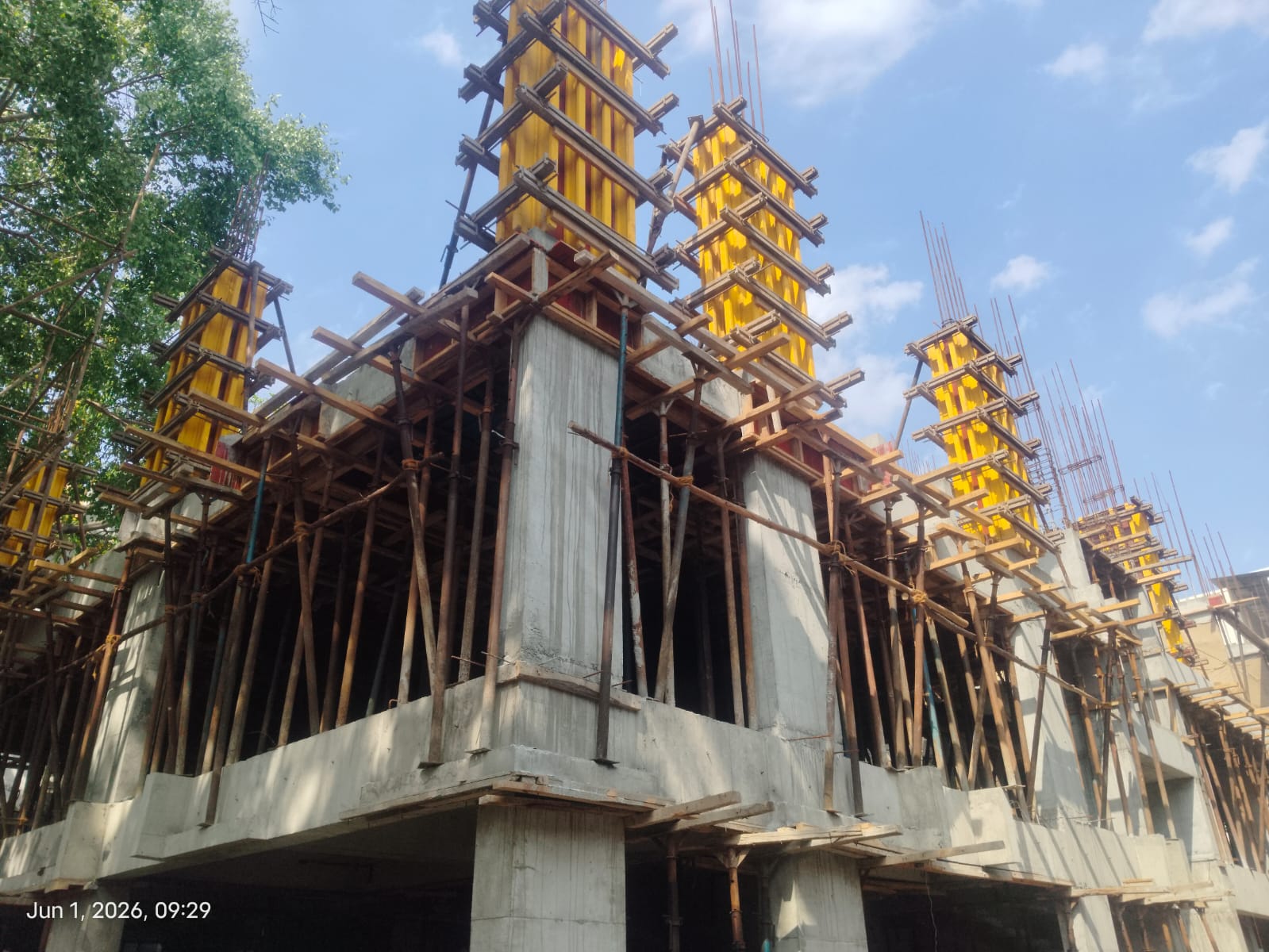

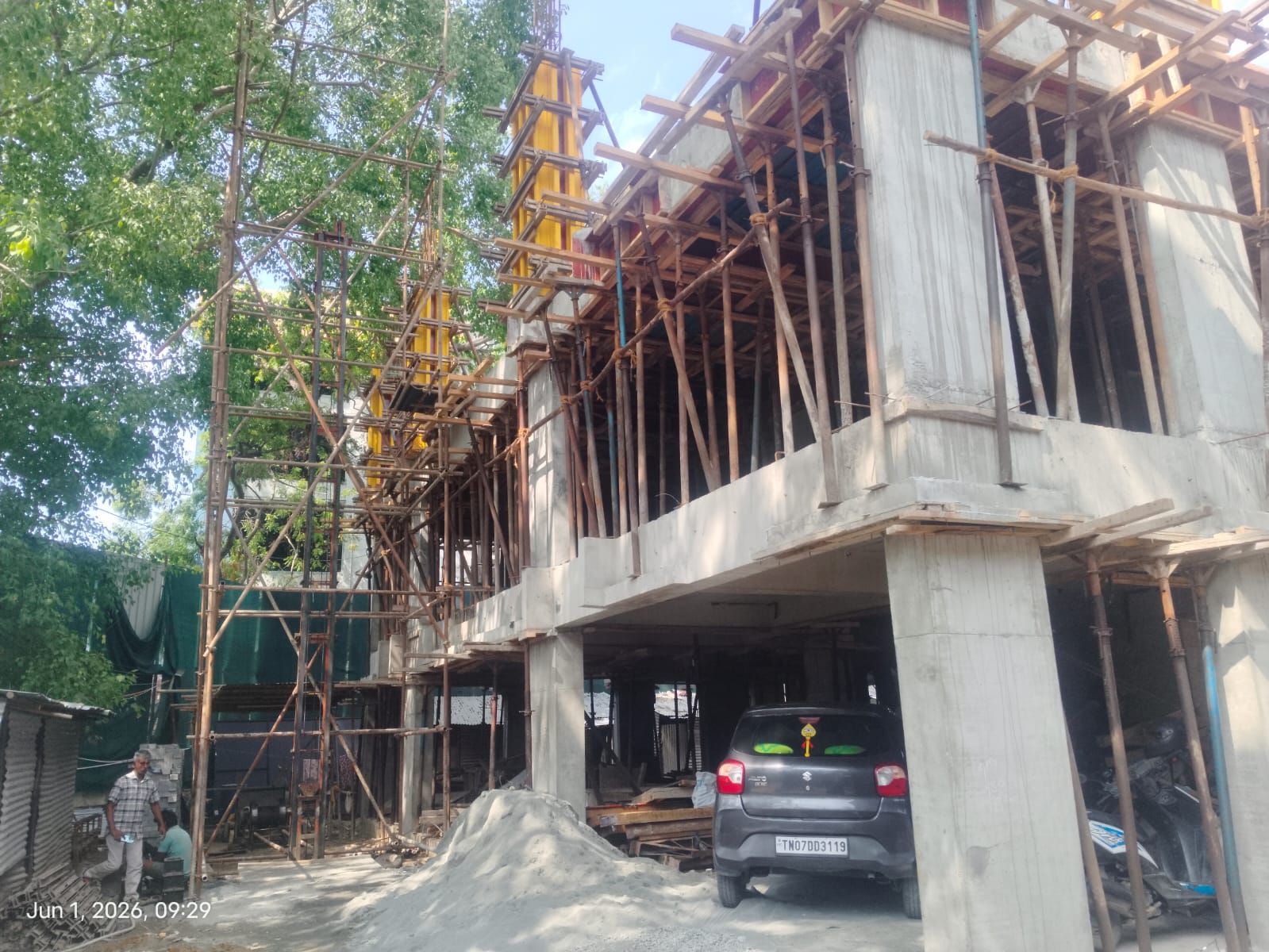

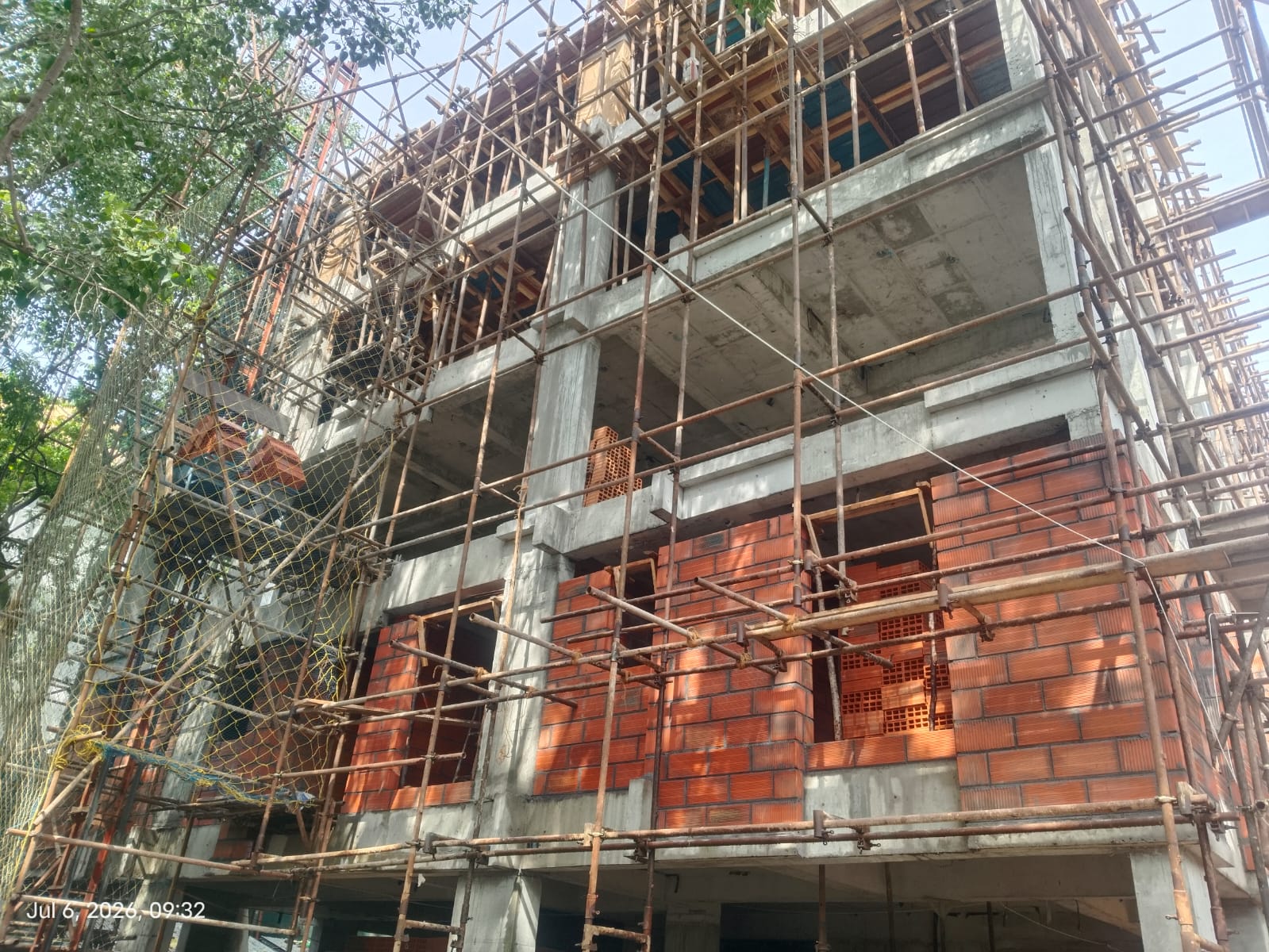

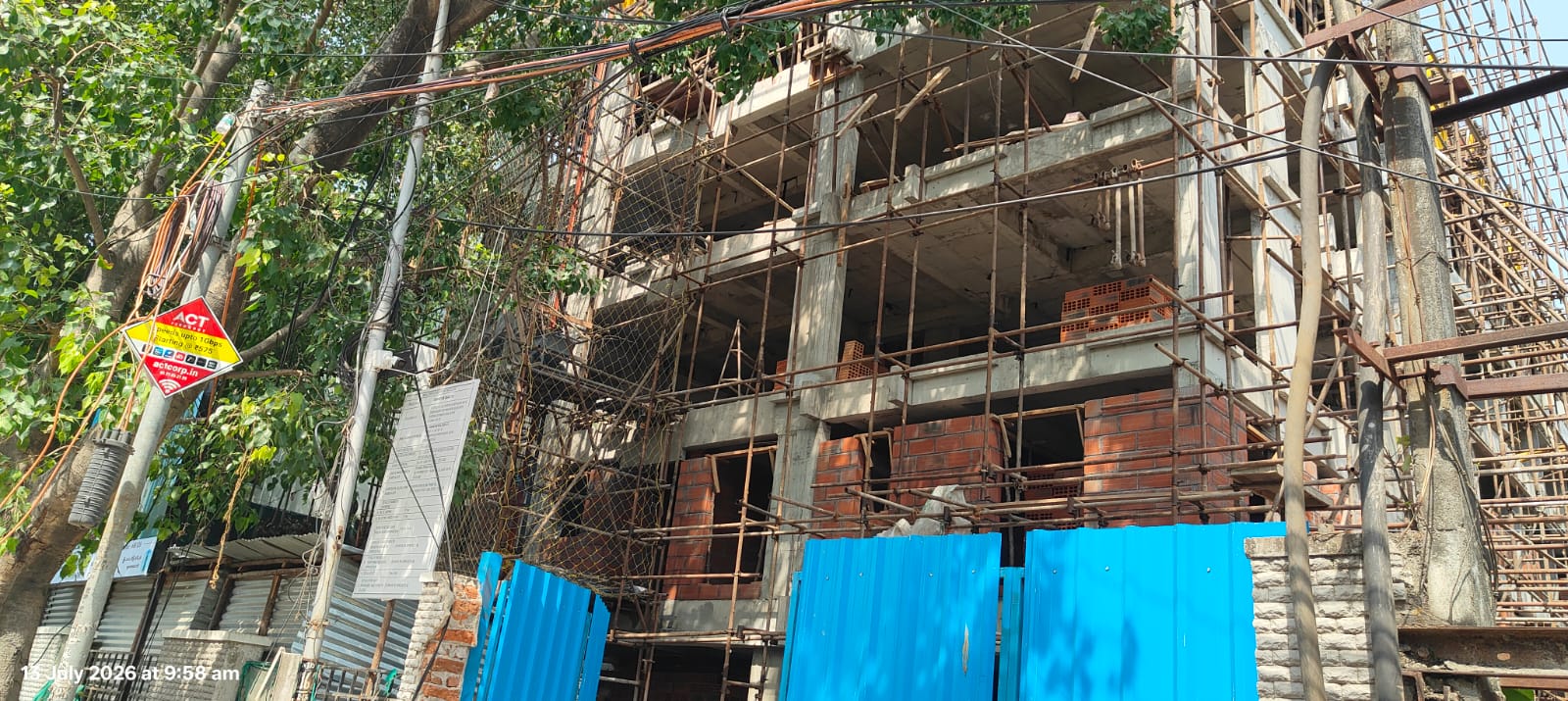

  • 3rd floor roof concrete work is completed.
  • 4th floor column concrete work is completed.
  • 4th floor roof shuttering and bar bending work is in progress.

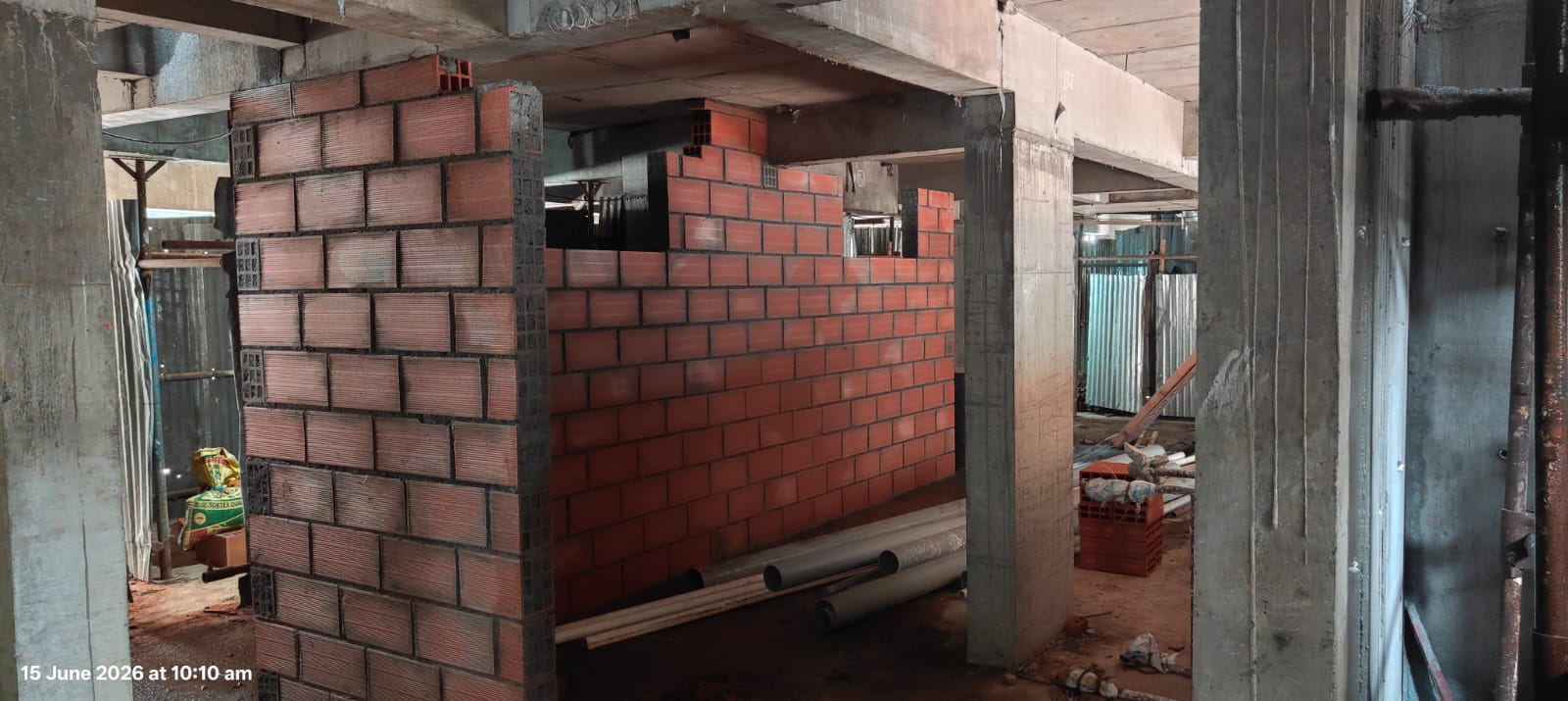

  • Groundfloor block work is completed.
  • 1st floor brick work is in progress.(60% completed)

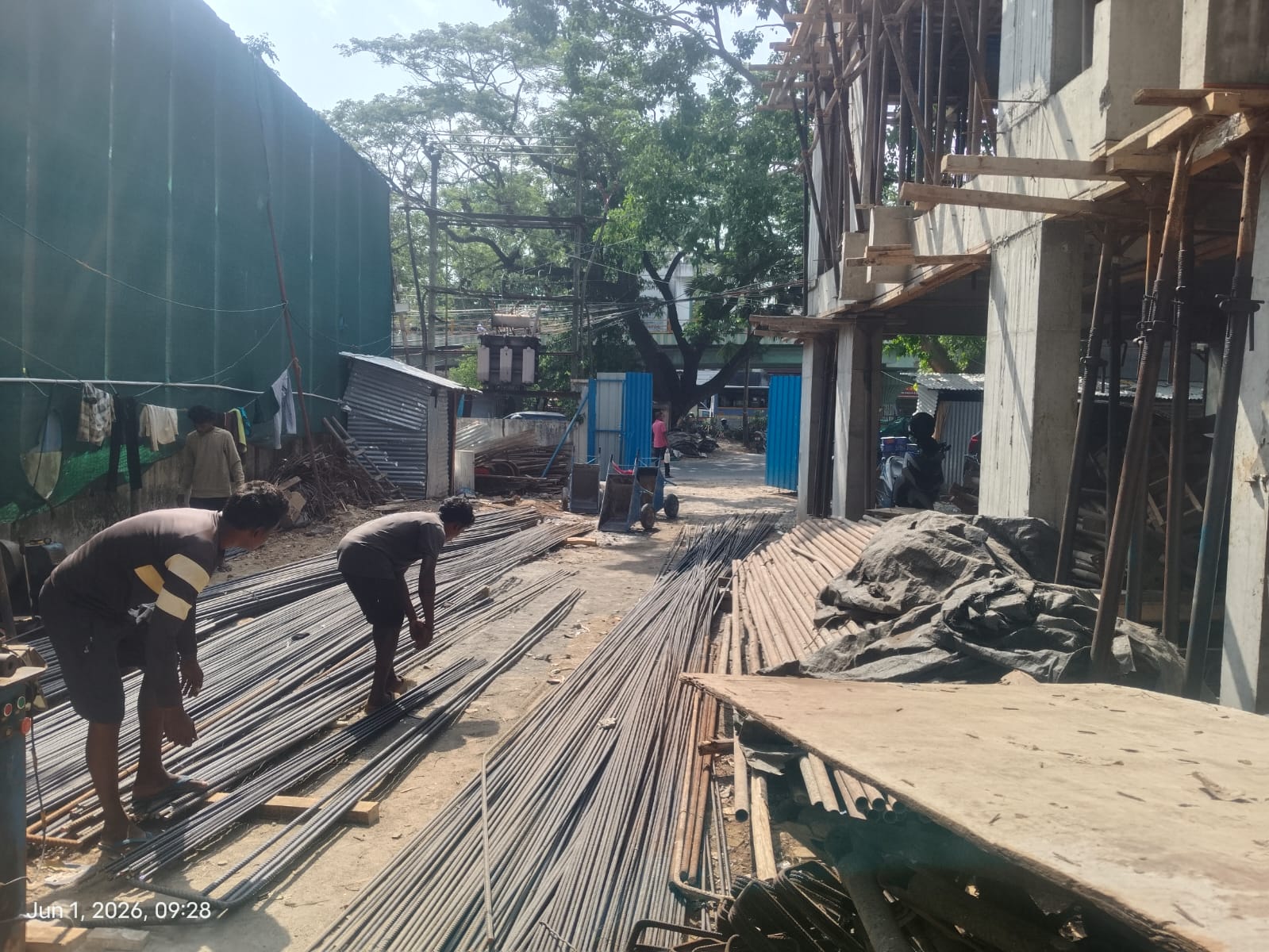

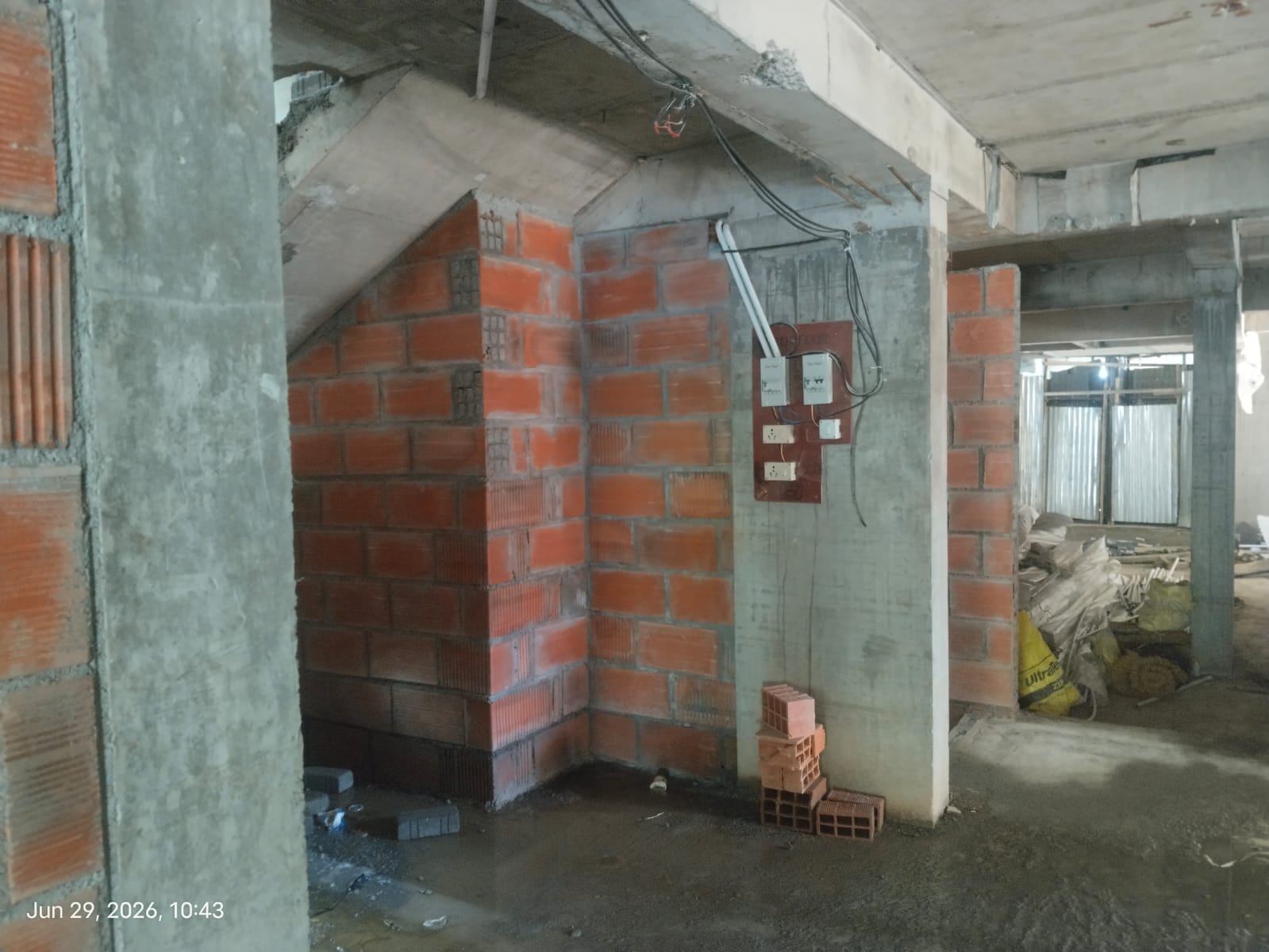

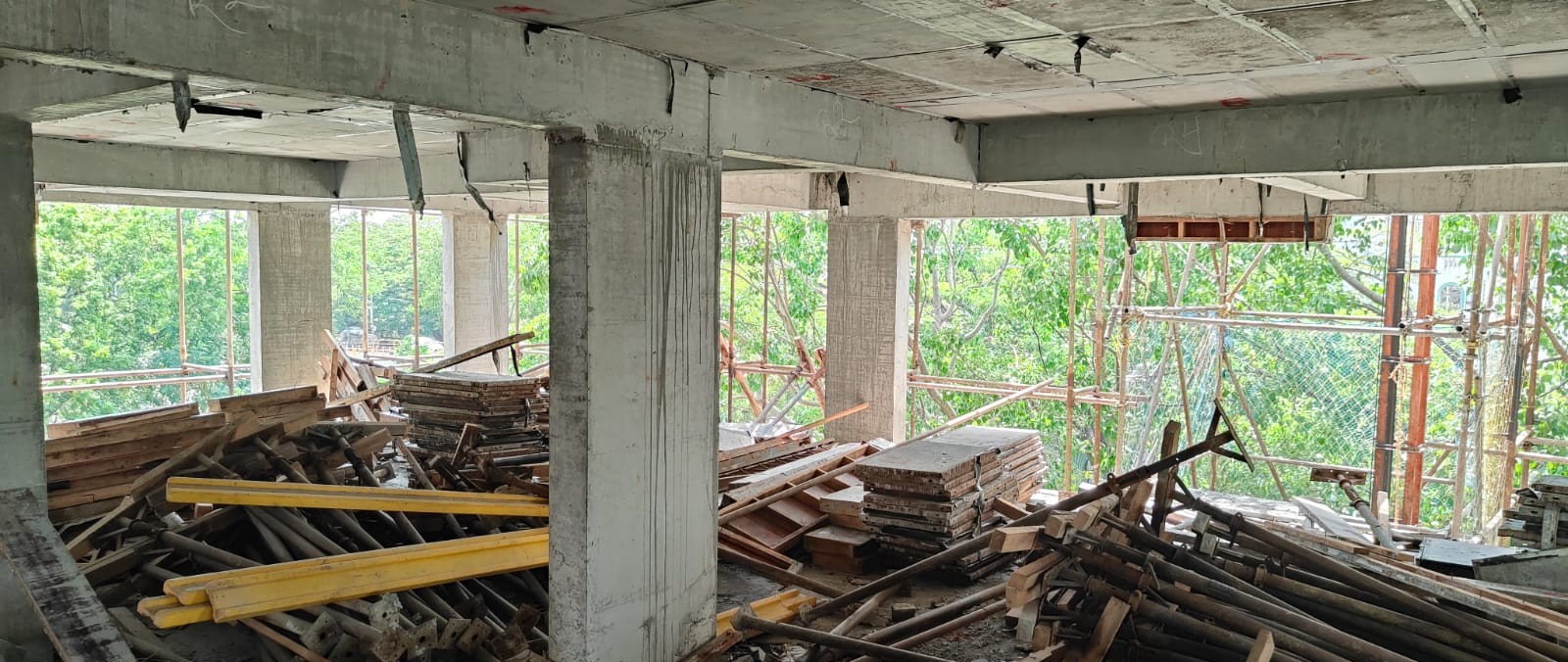

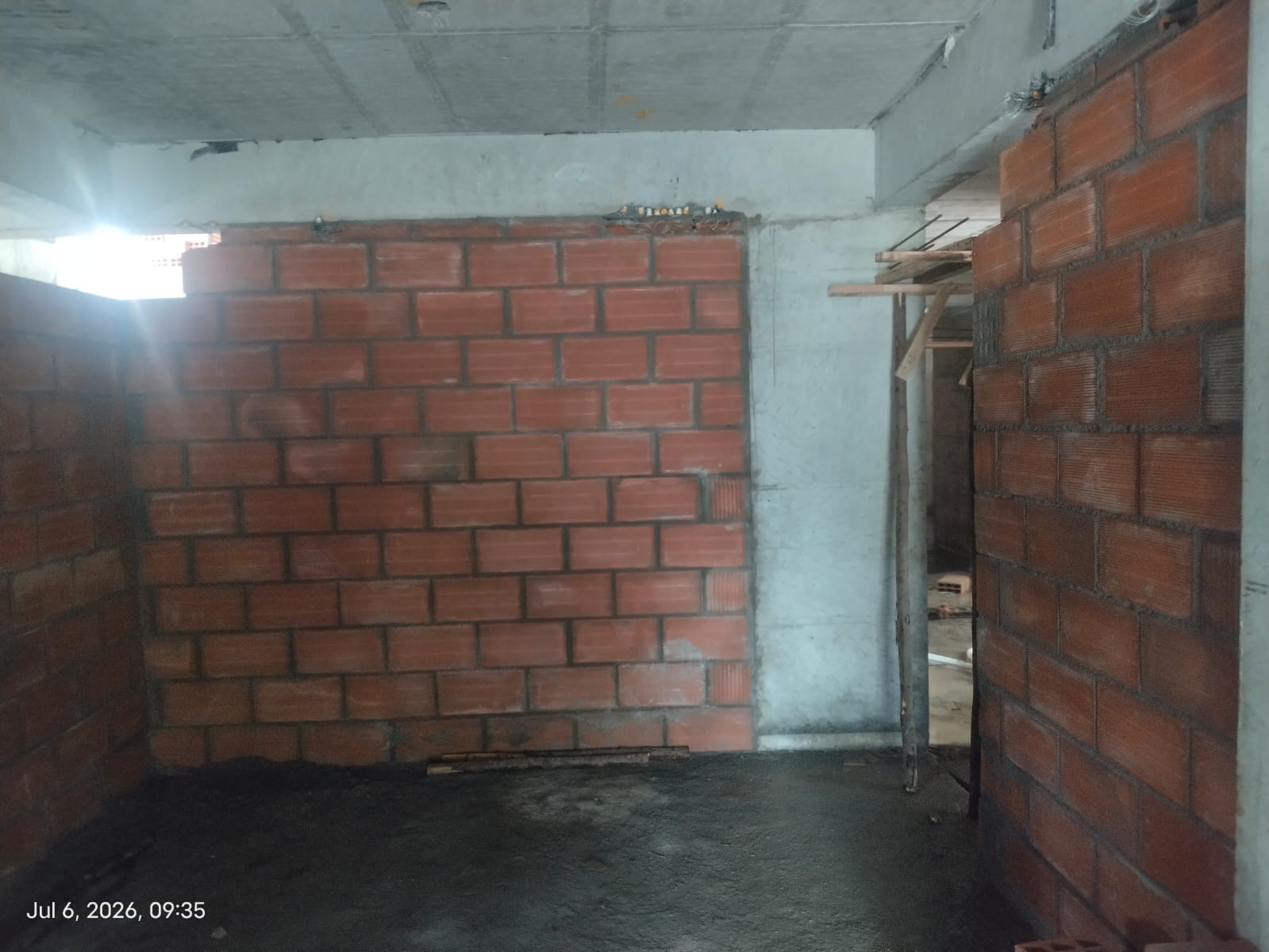

Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image

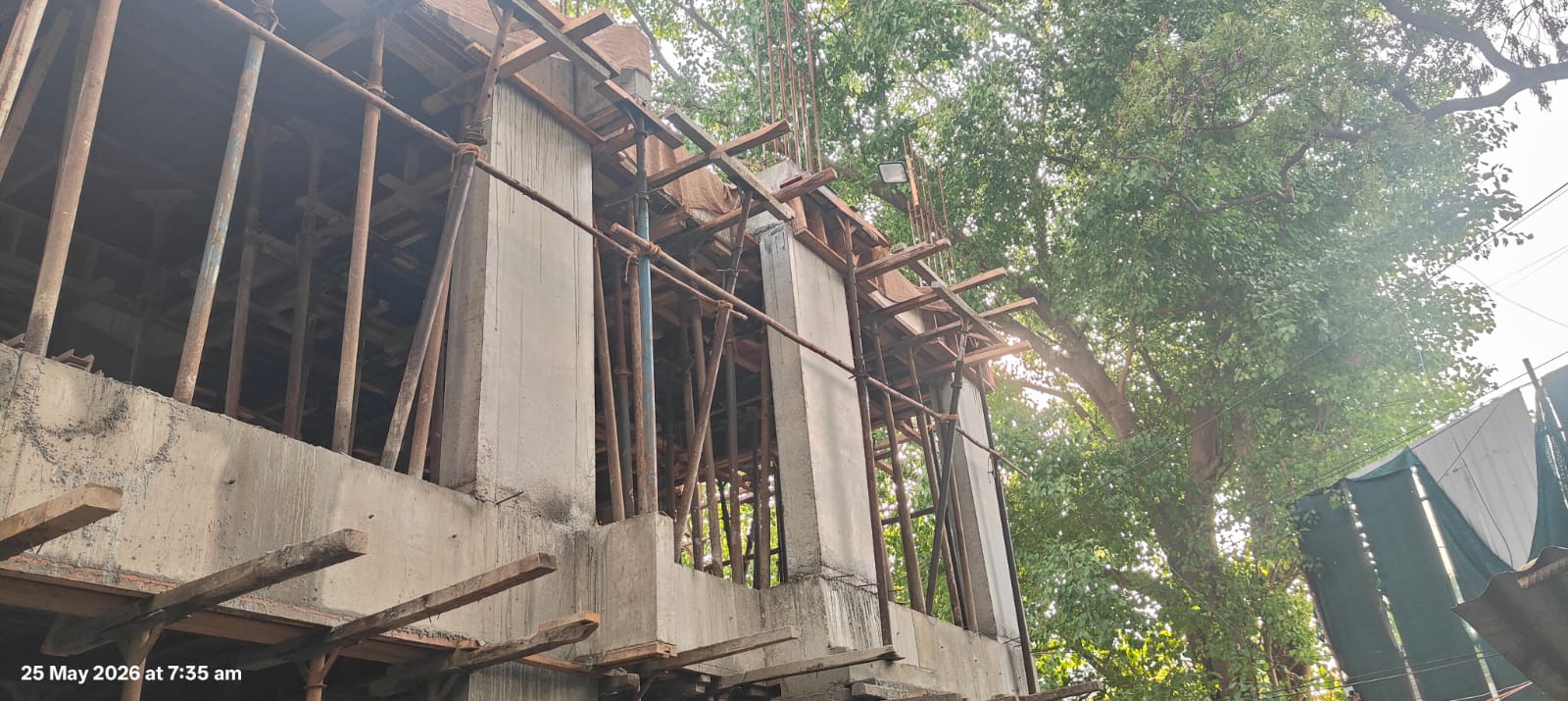

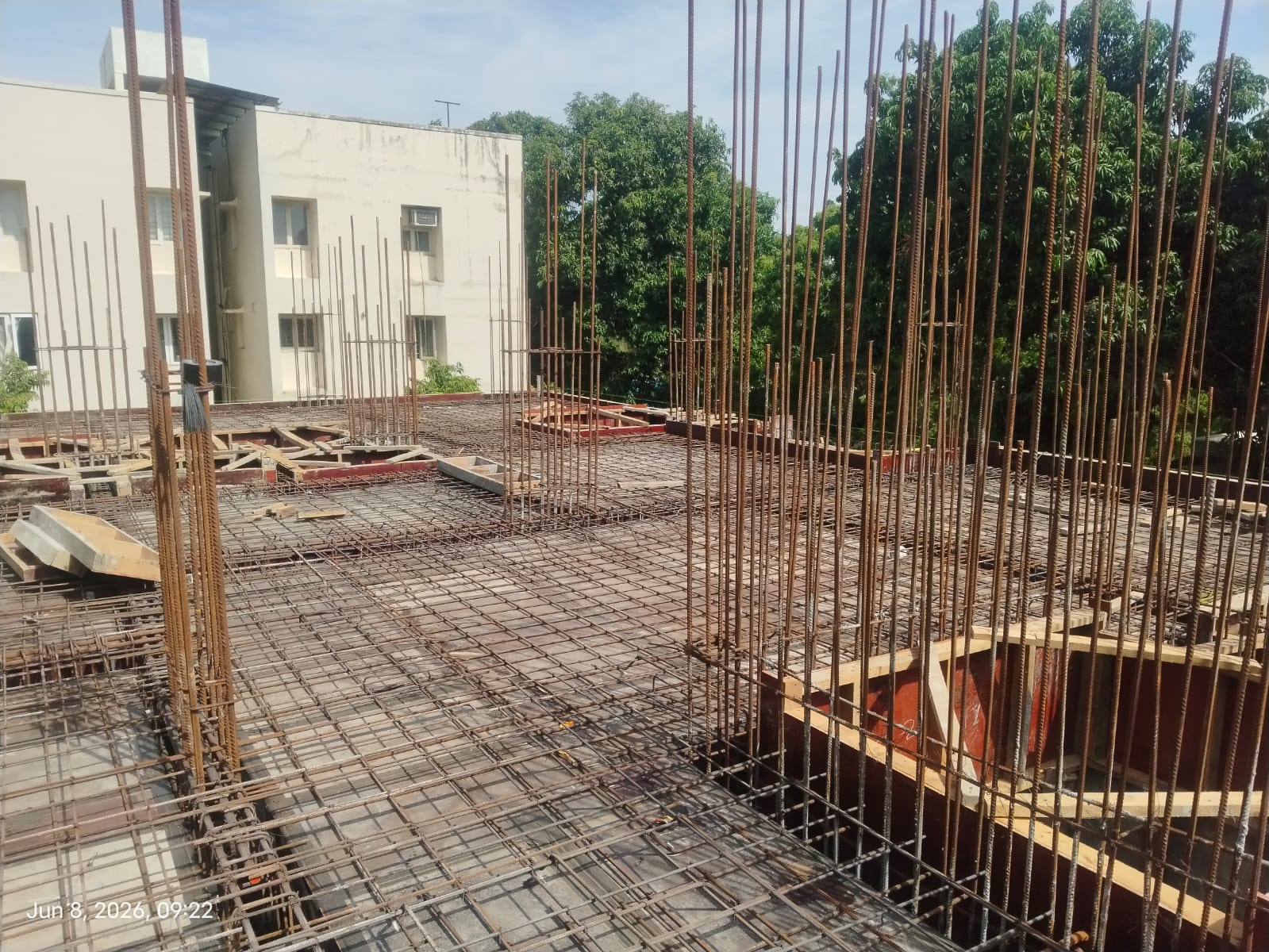

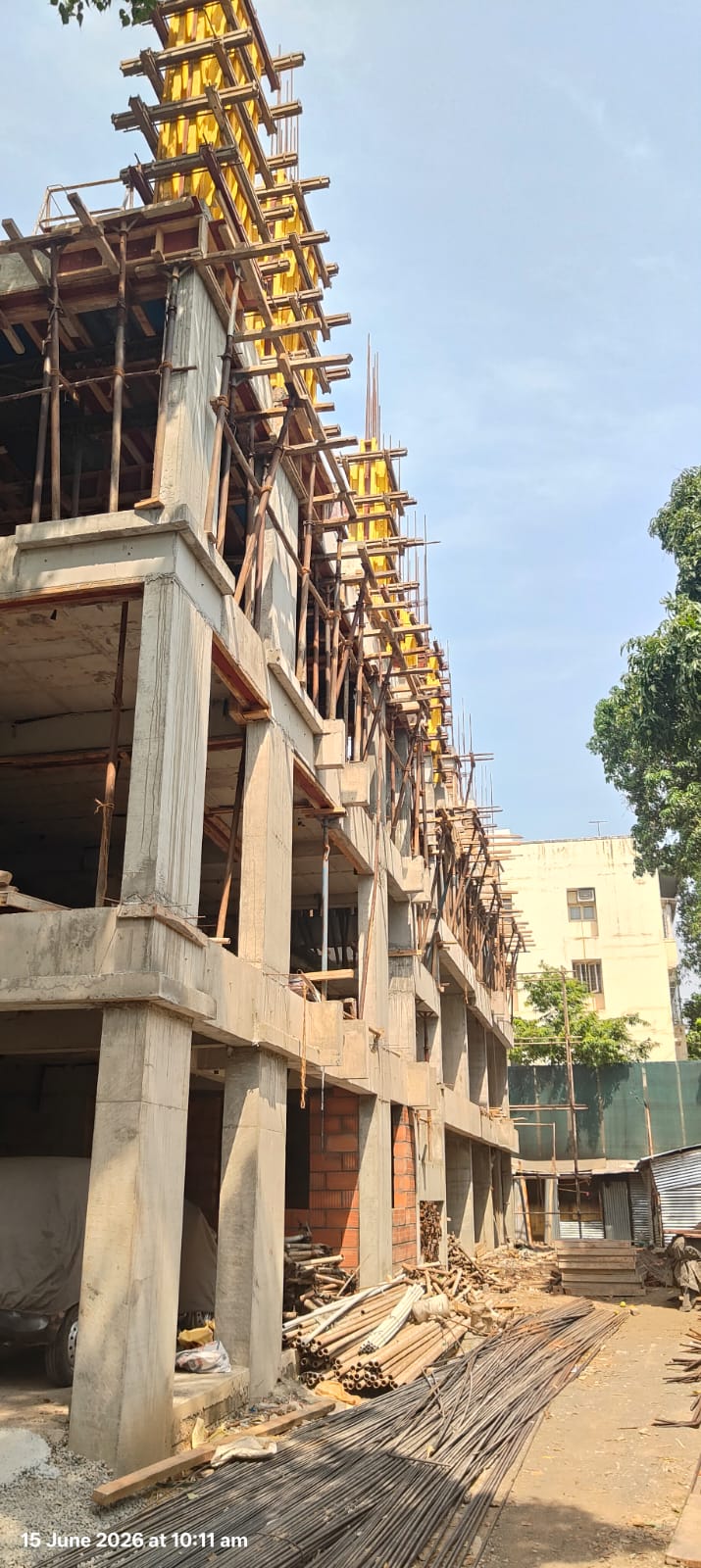

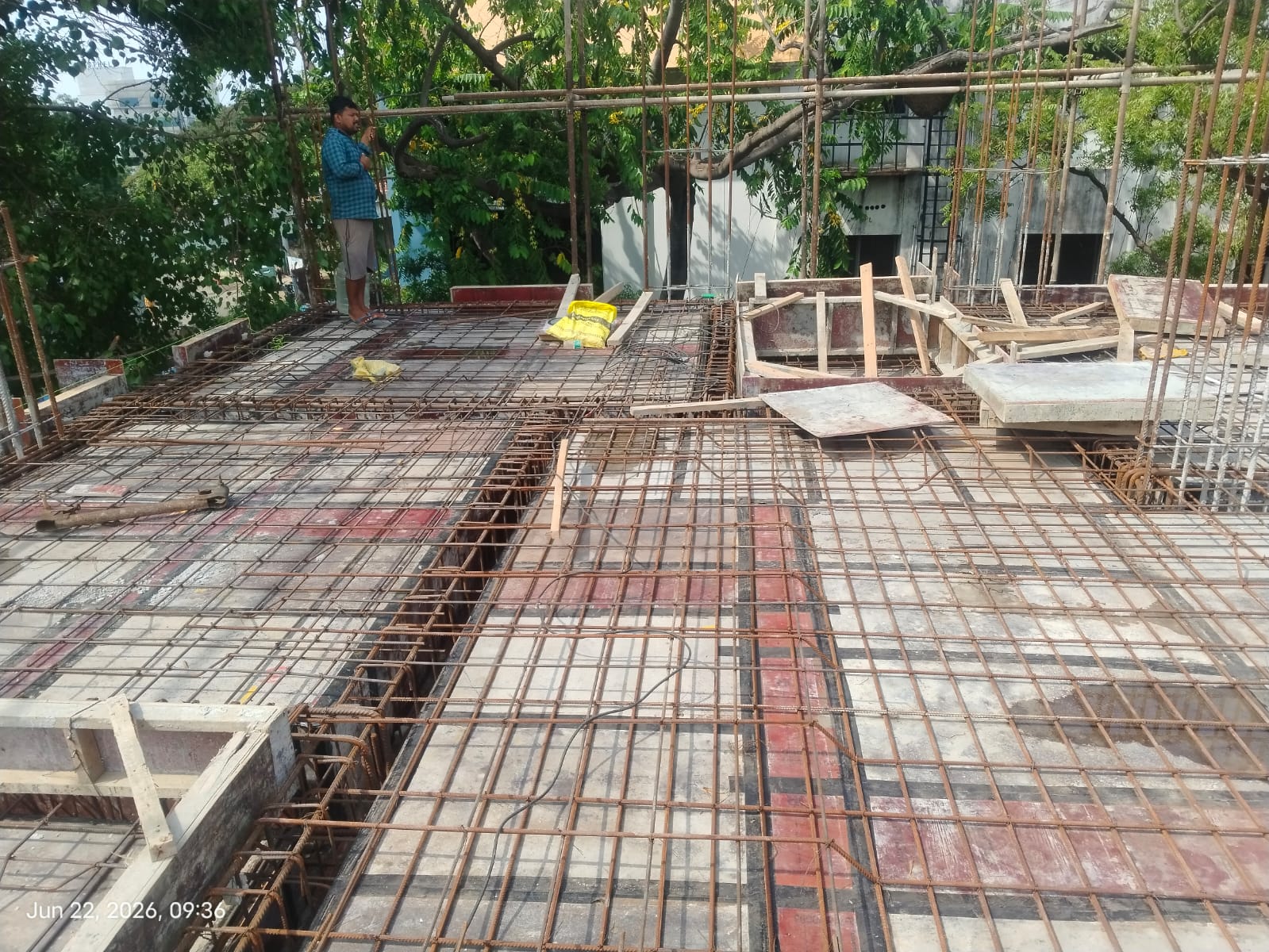

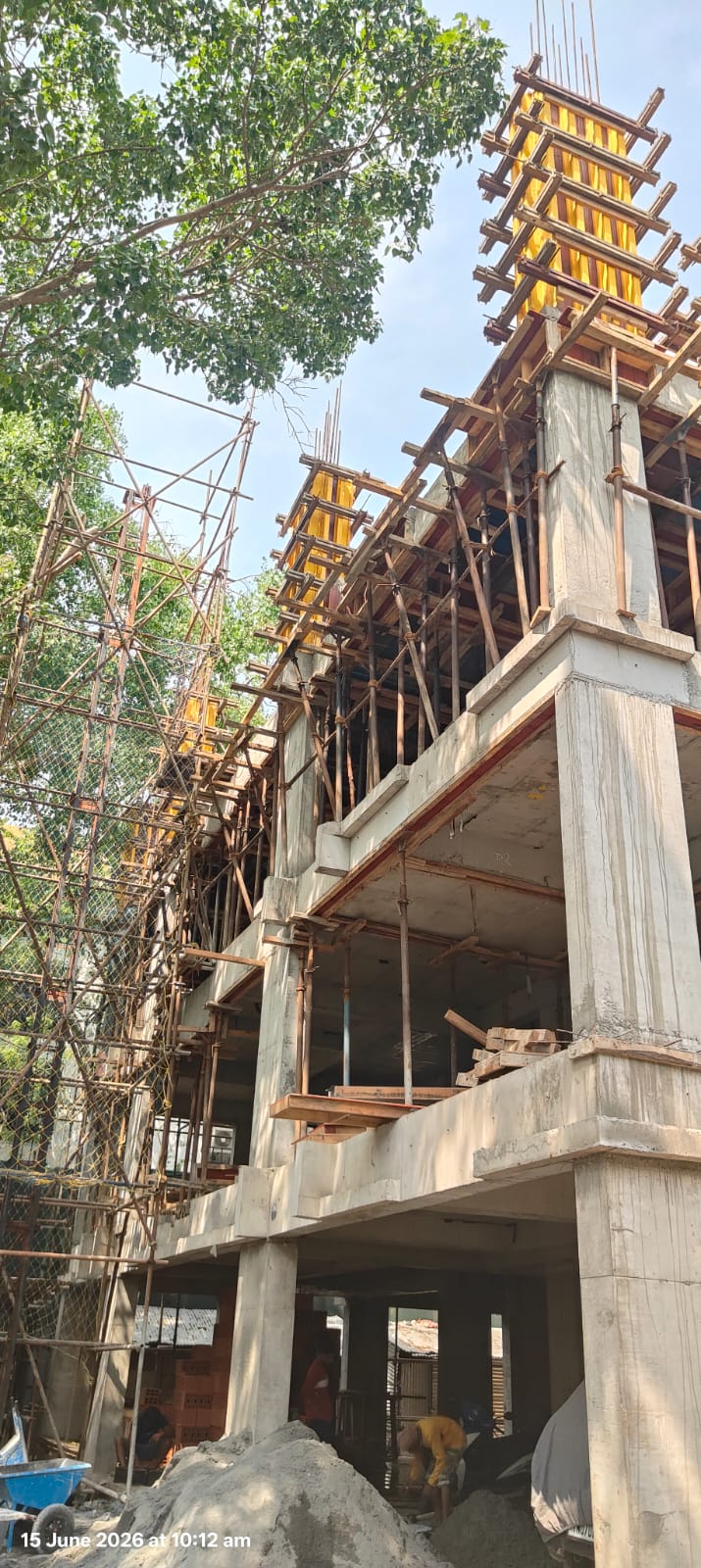

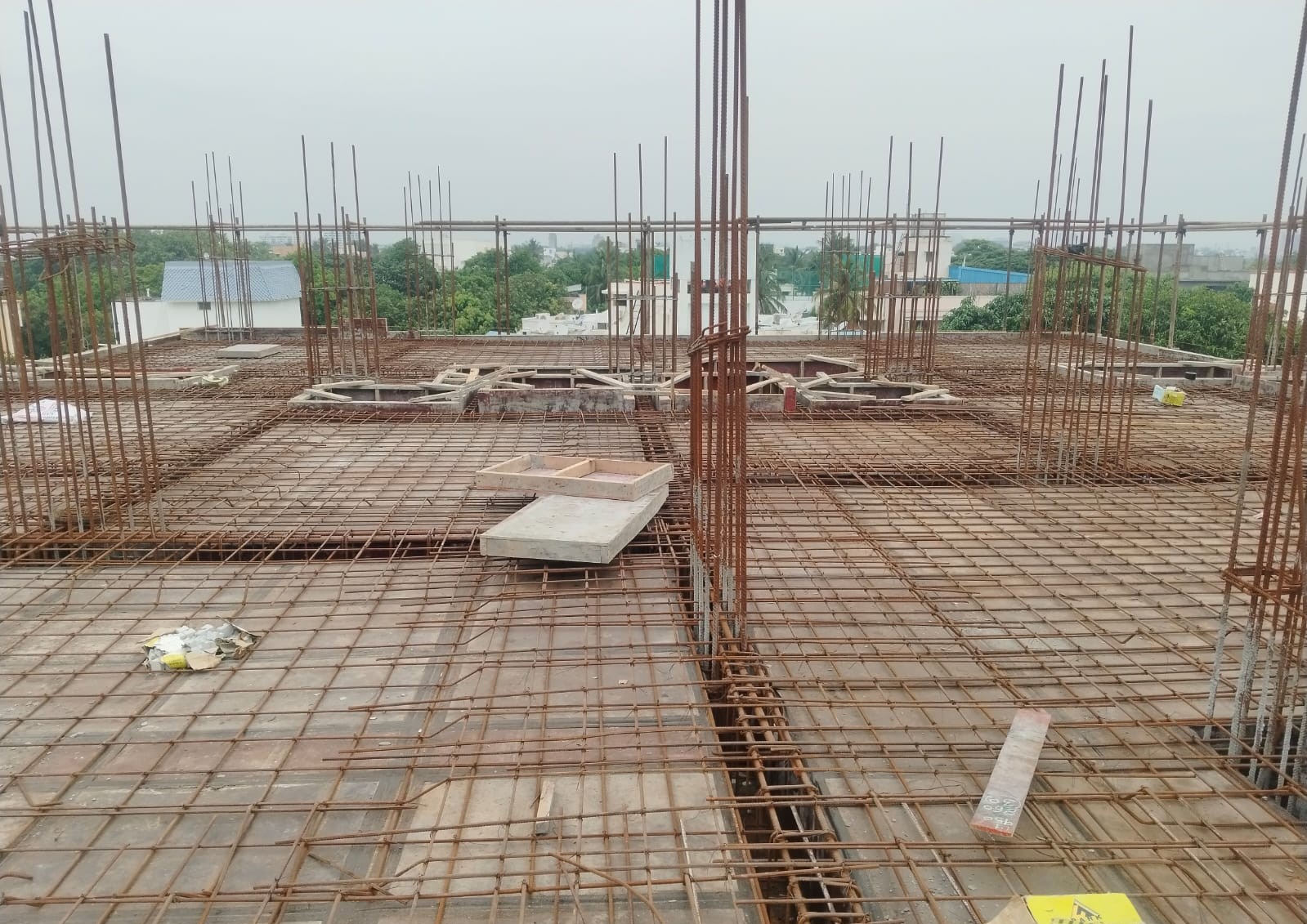

  • 4th floor roof concrete work is completed.
  • 5th floor column shuttering and bar bending work is in progress.
  • Groundfloor block work is completed.
  • 1st floor brick work is in progress.(70% completed)
  • 2nd floor brick work is in progress.

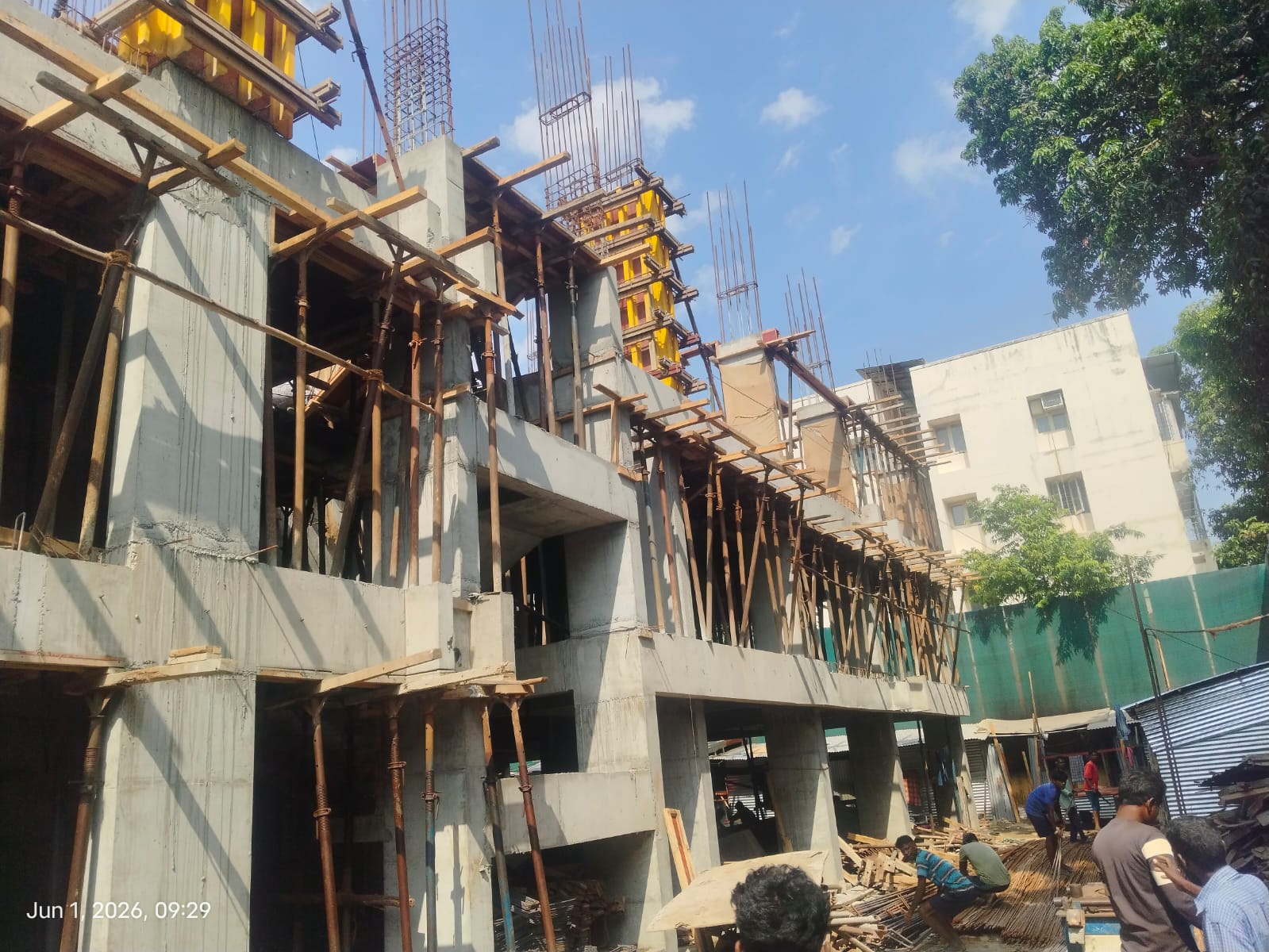

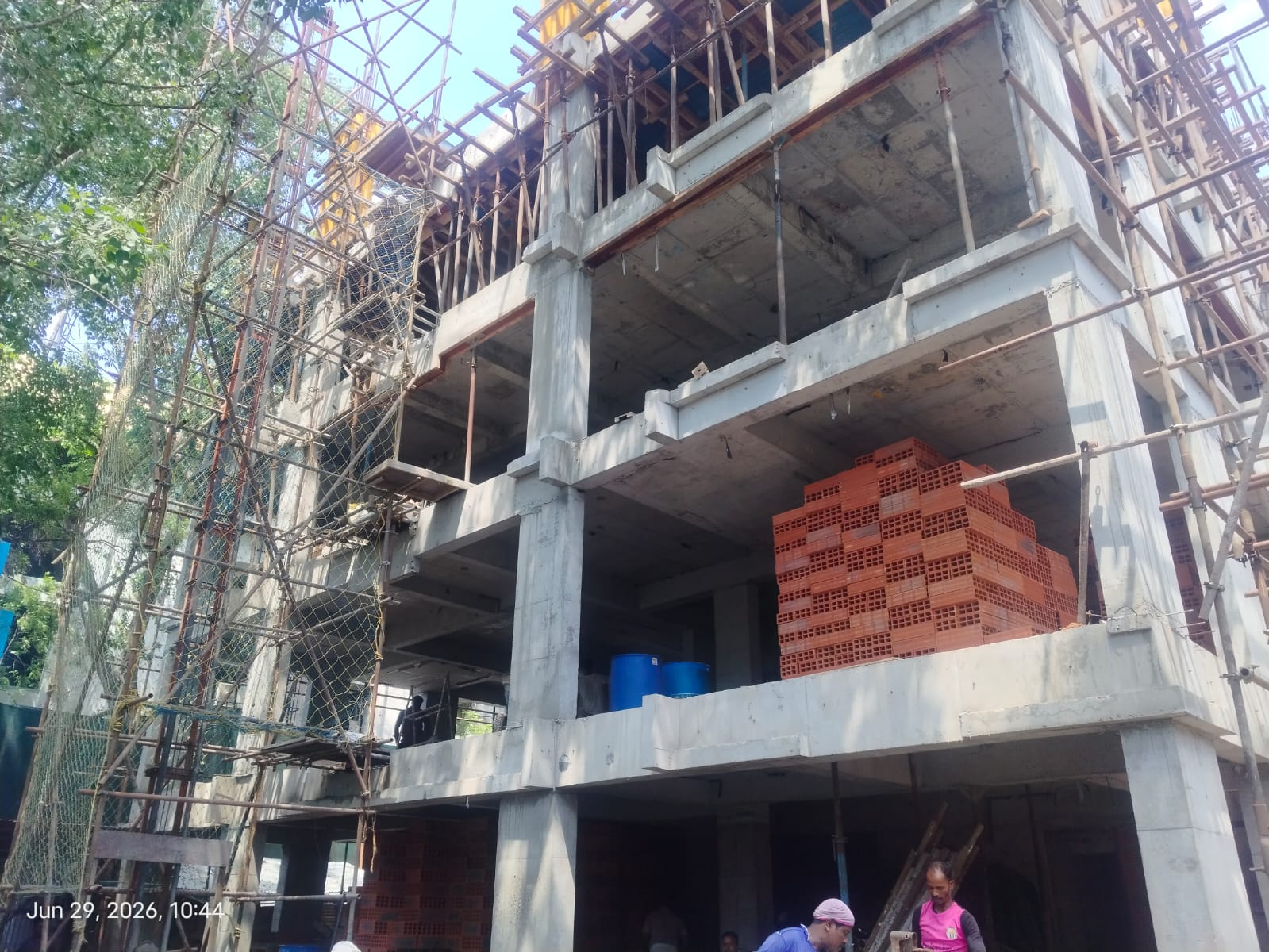

Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image

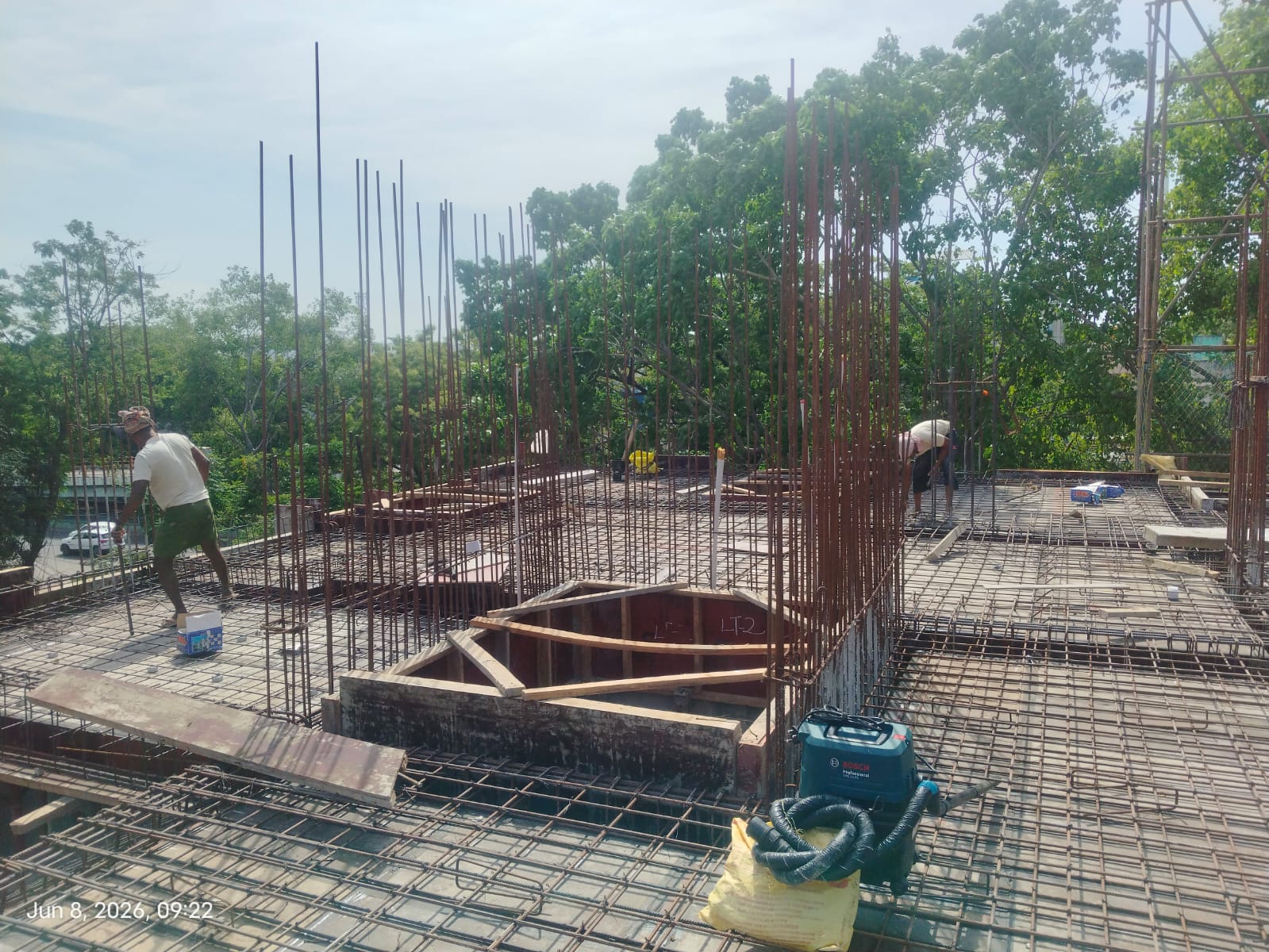

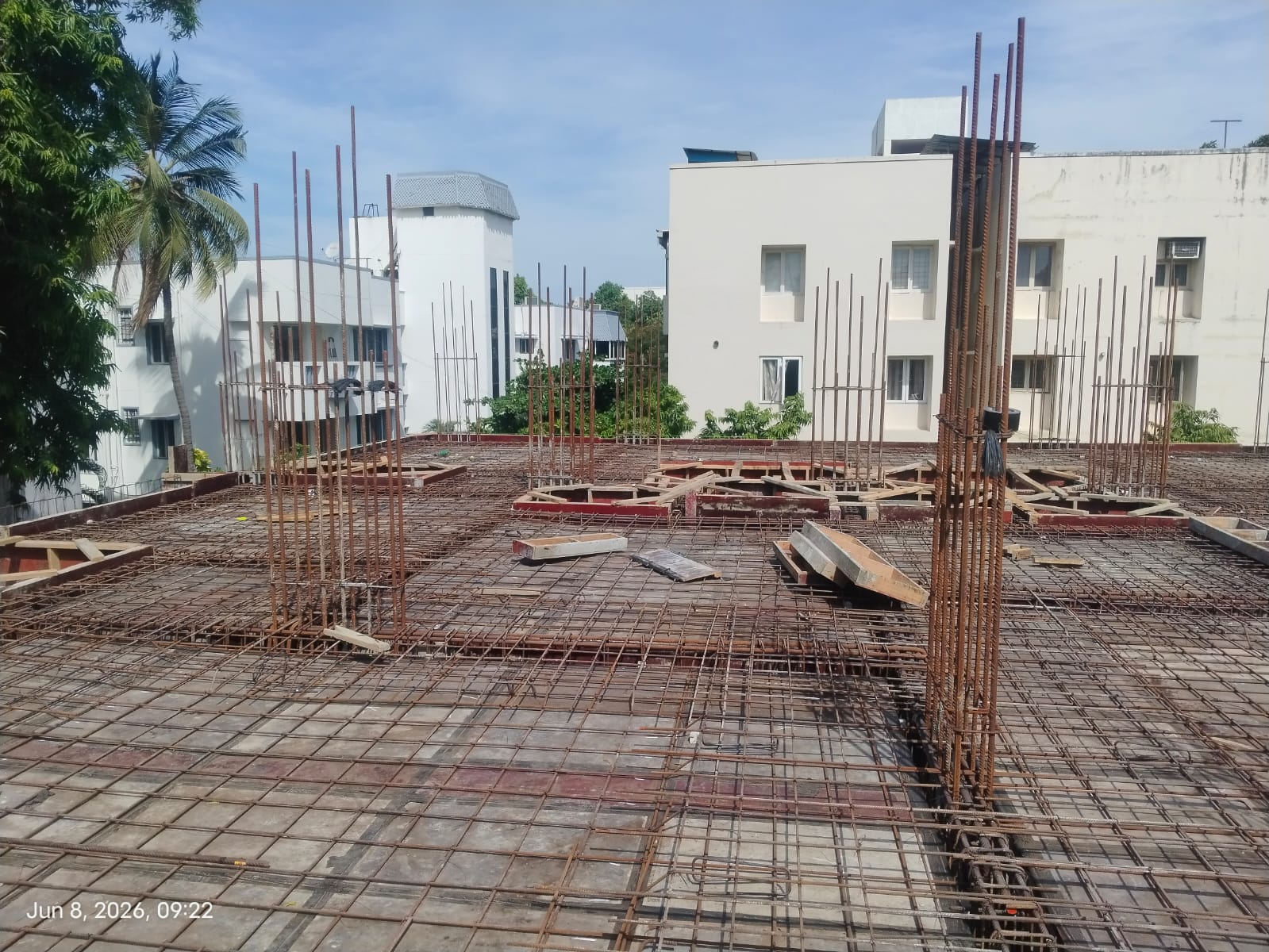

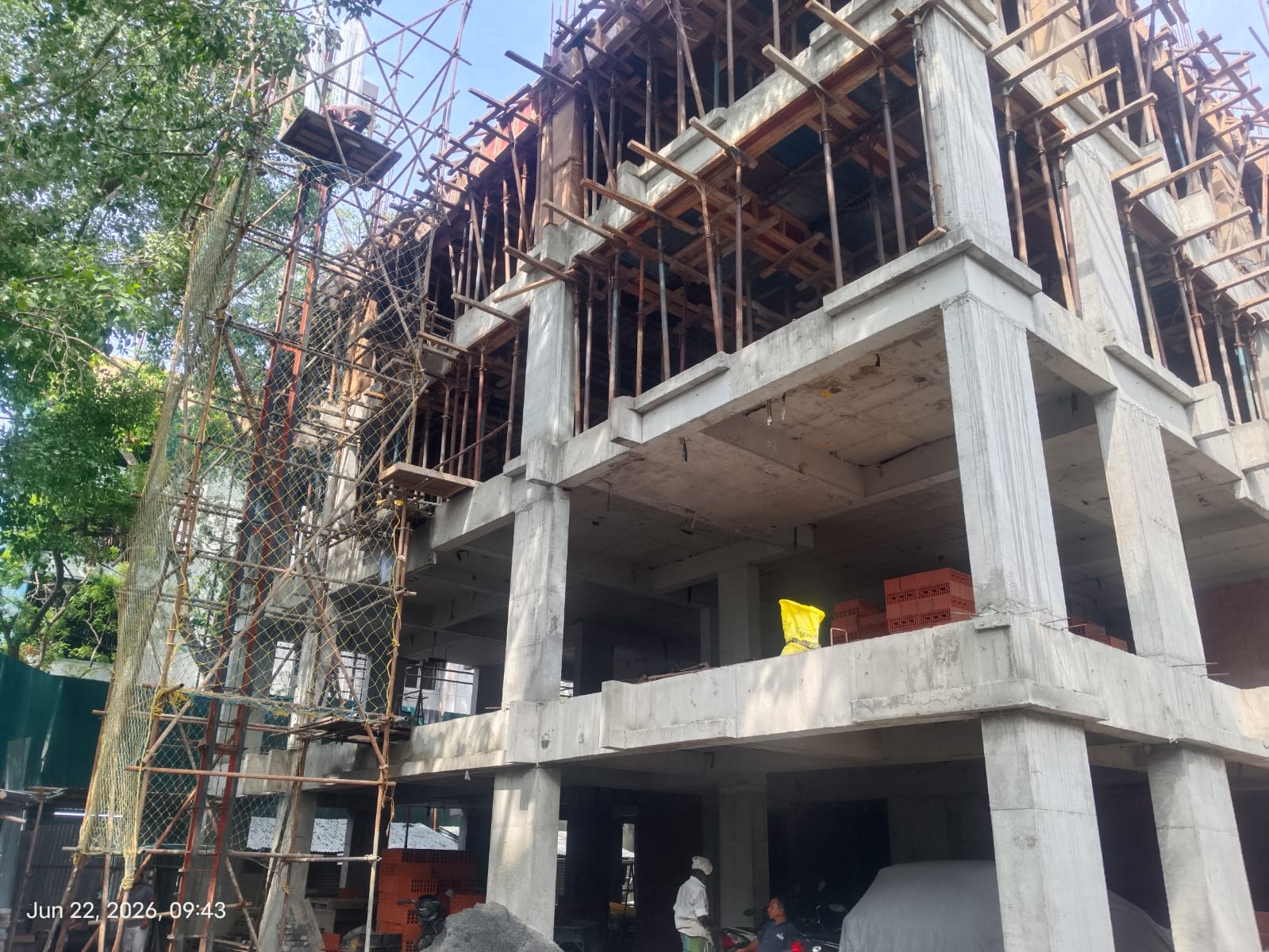

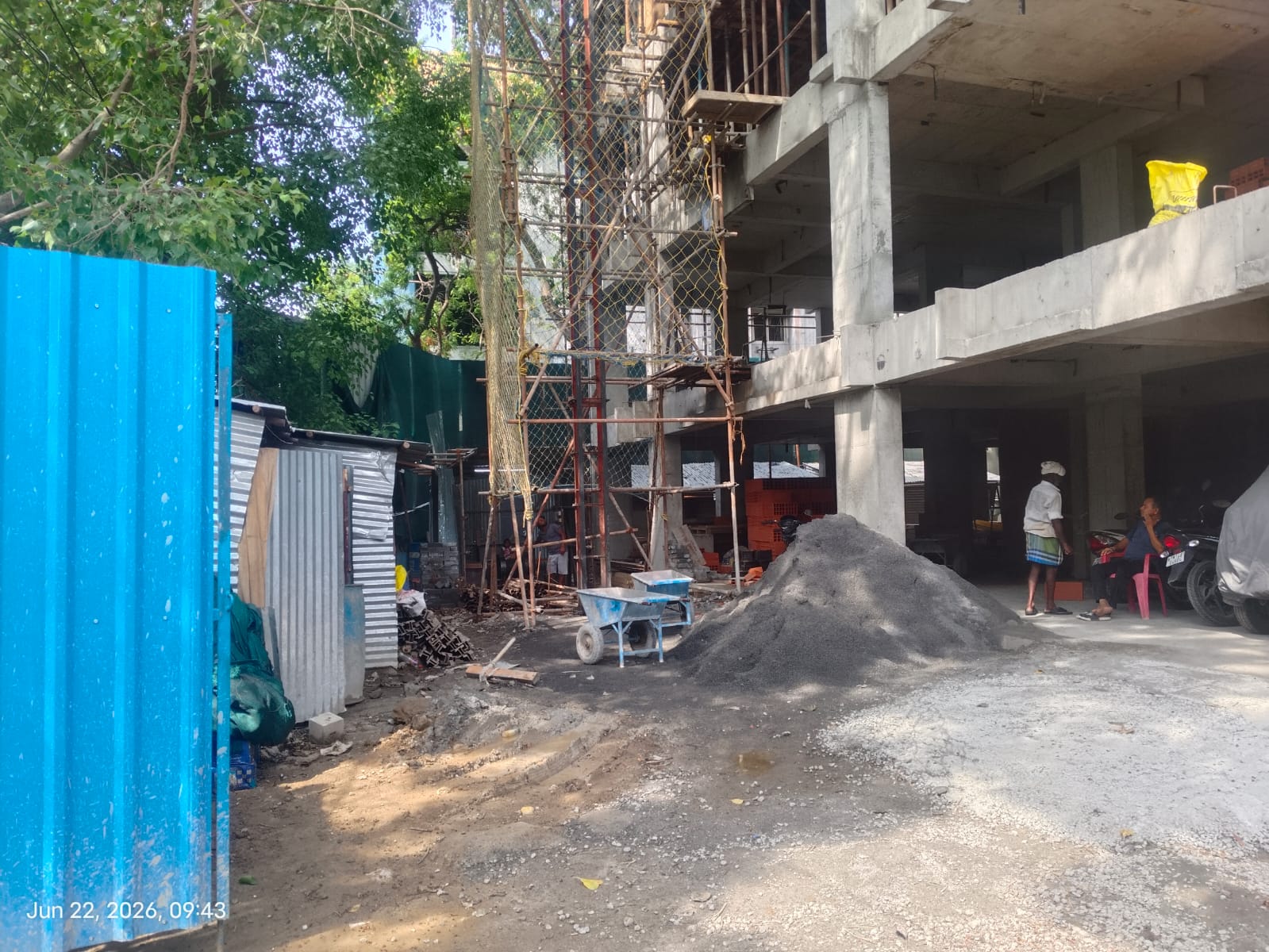

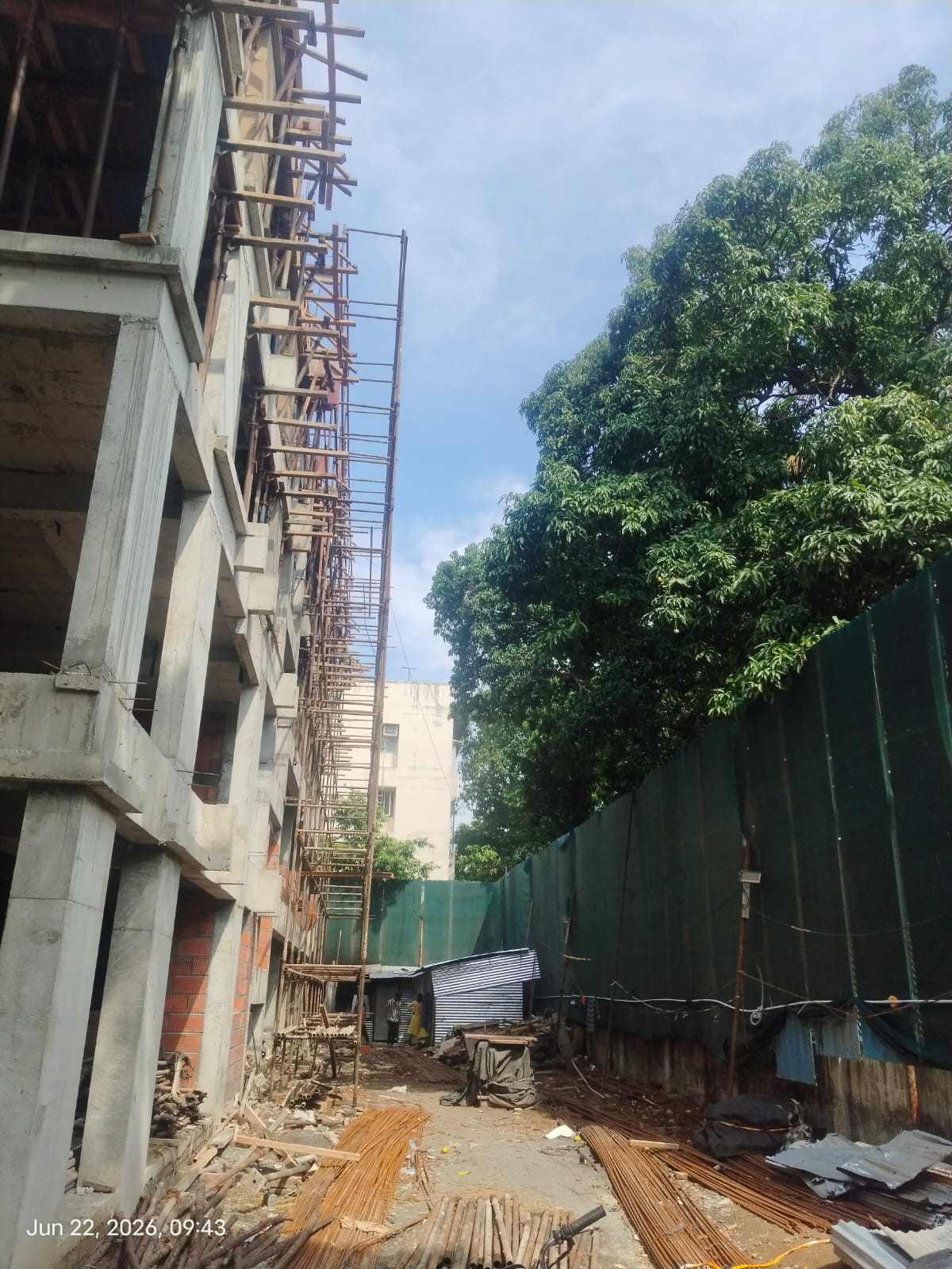

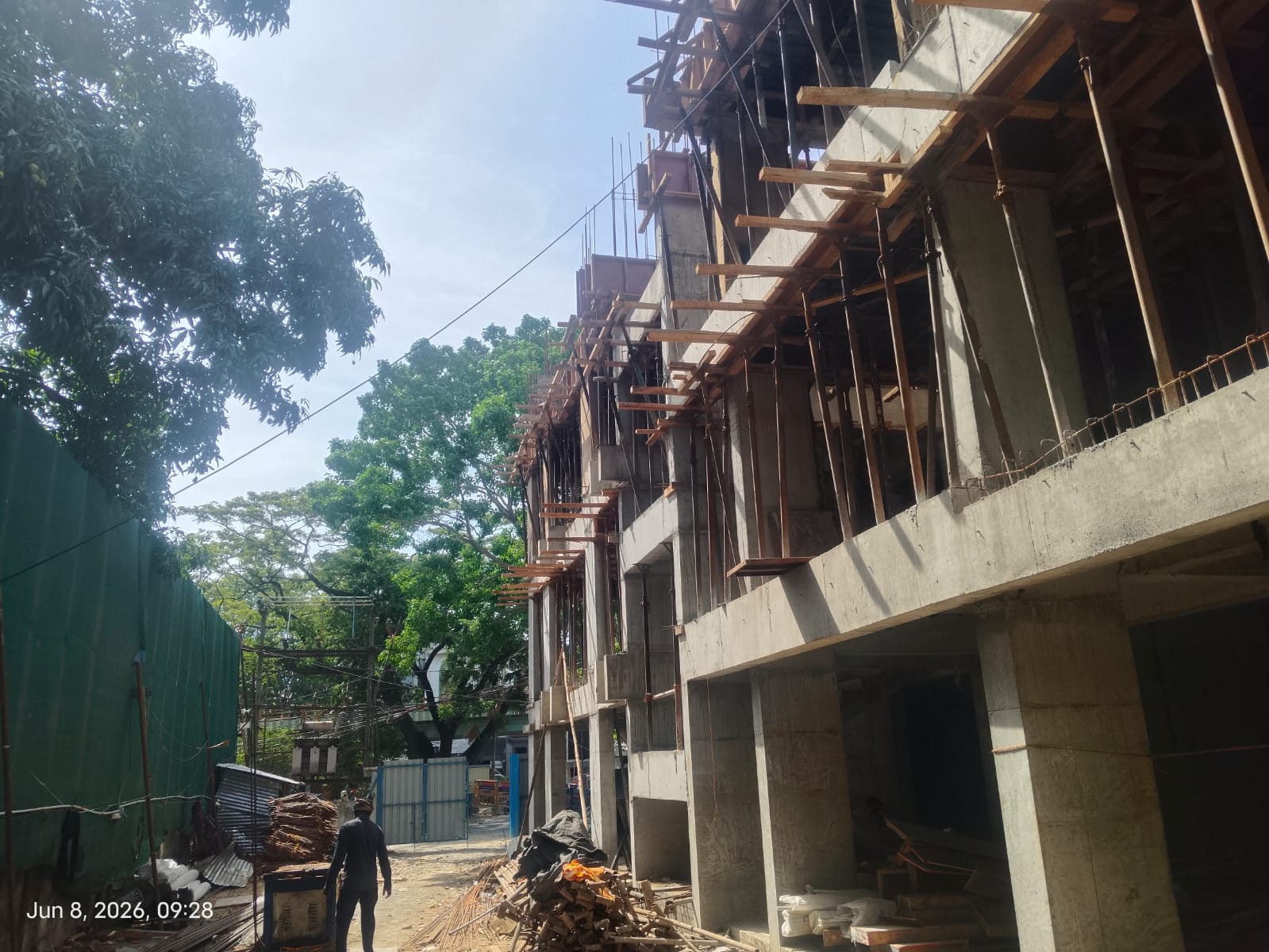

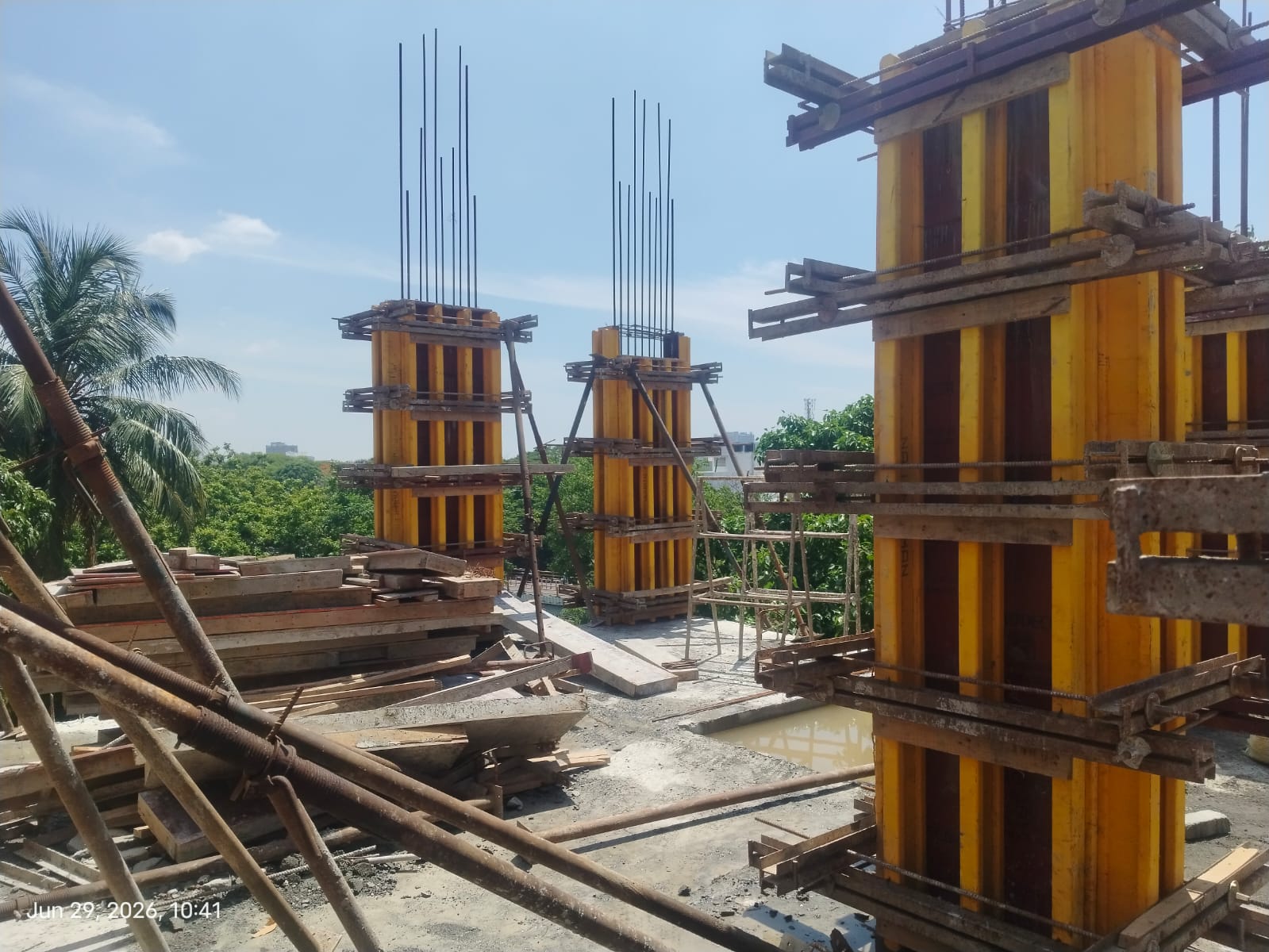

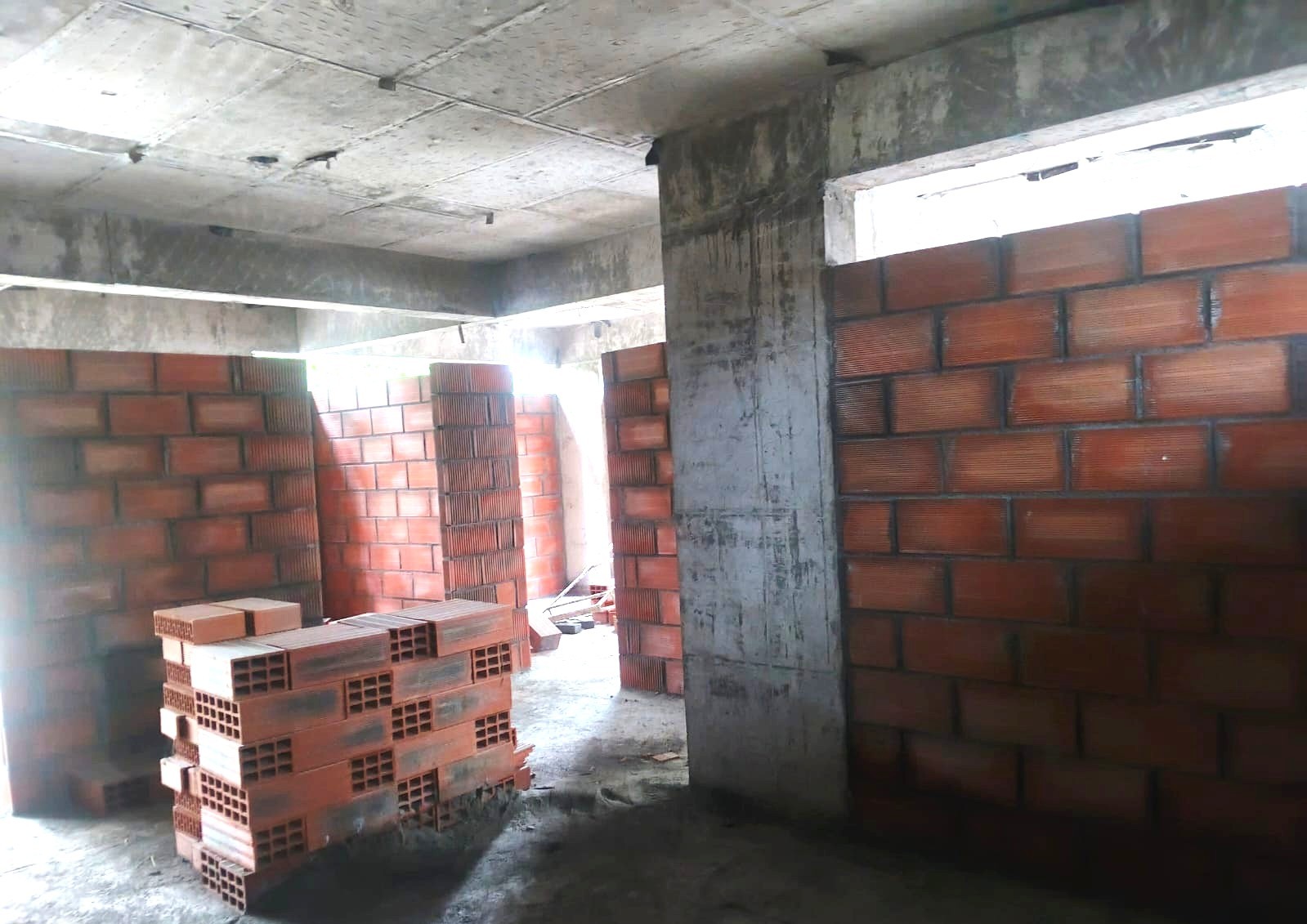

  • 5th floor column concrete work is completed.
  • 5th floor roof shuttering and bar bending work is in progress.
  • Ground floor block work is completed.
  • 1st floor block work is in progress.(70% completed)
  • 2nd floor block work is in progress.(70% completed)
  • 3rd floor block work is in progress.

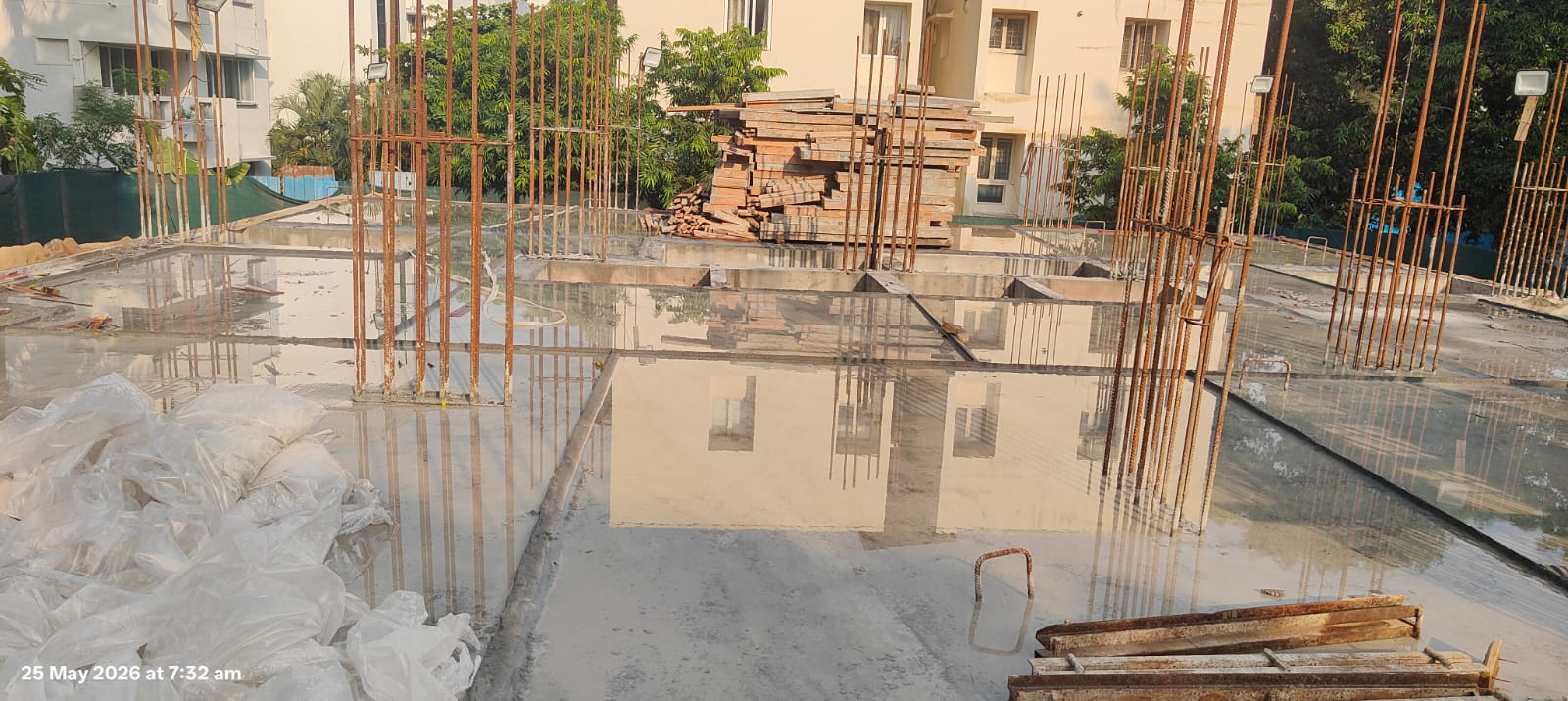

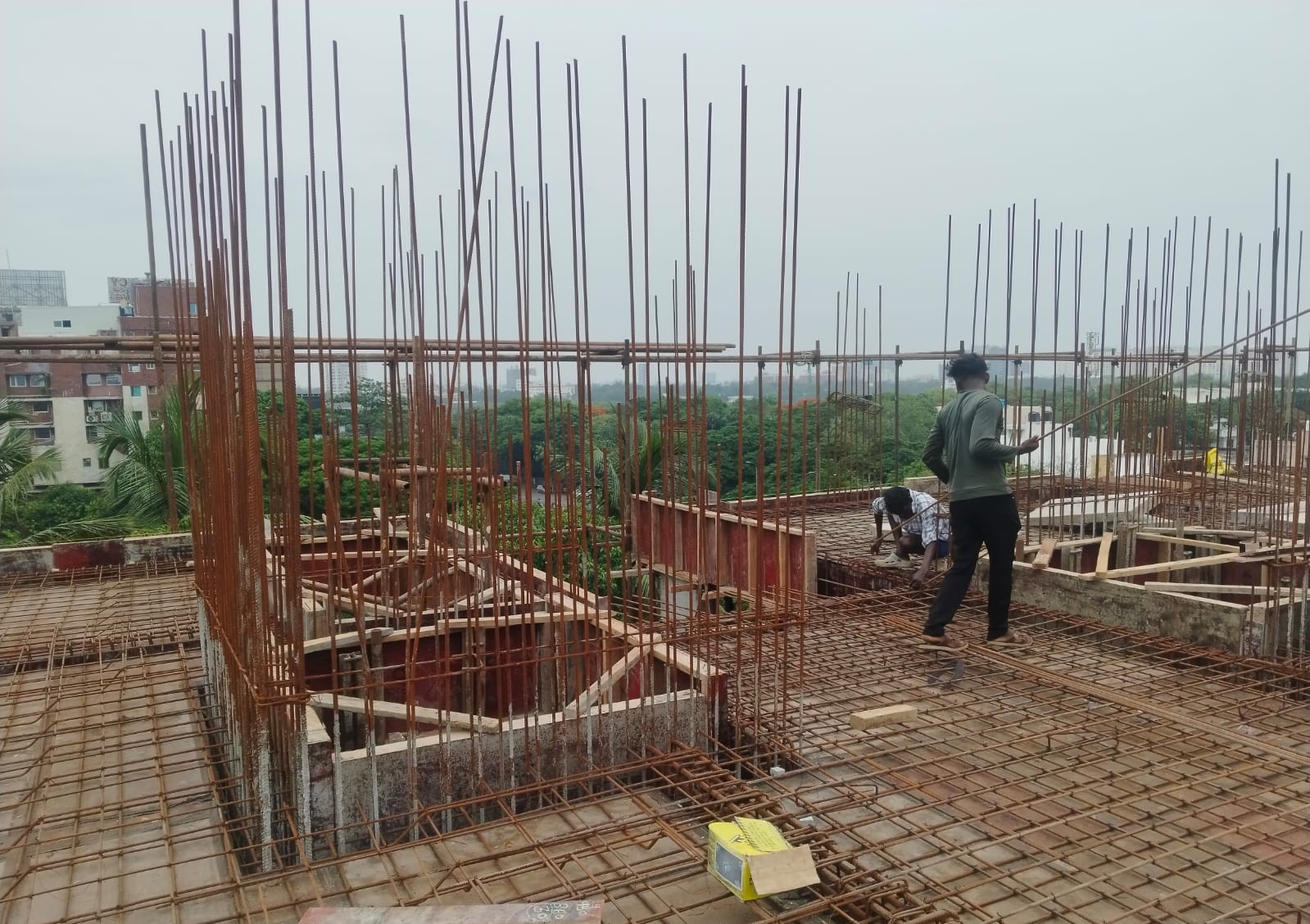

Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image Anantiya Progress Image

Property Location

Let your dreams be our

next Project!

Include your country code — all international formats are accepted (e.g. +91, +1, +44, +971).
